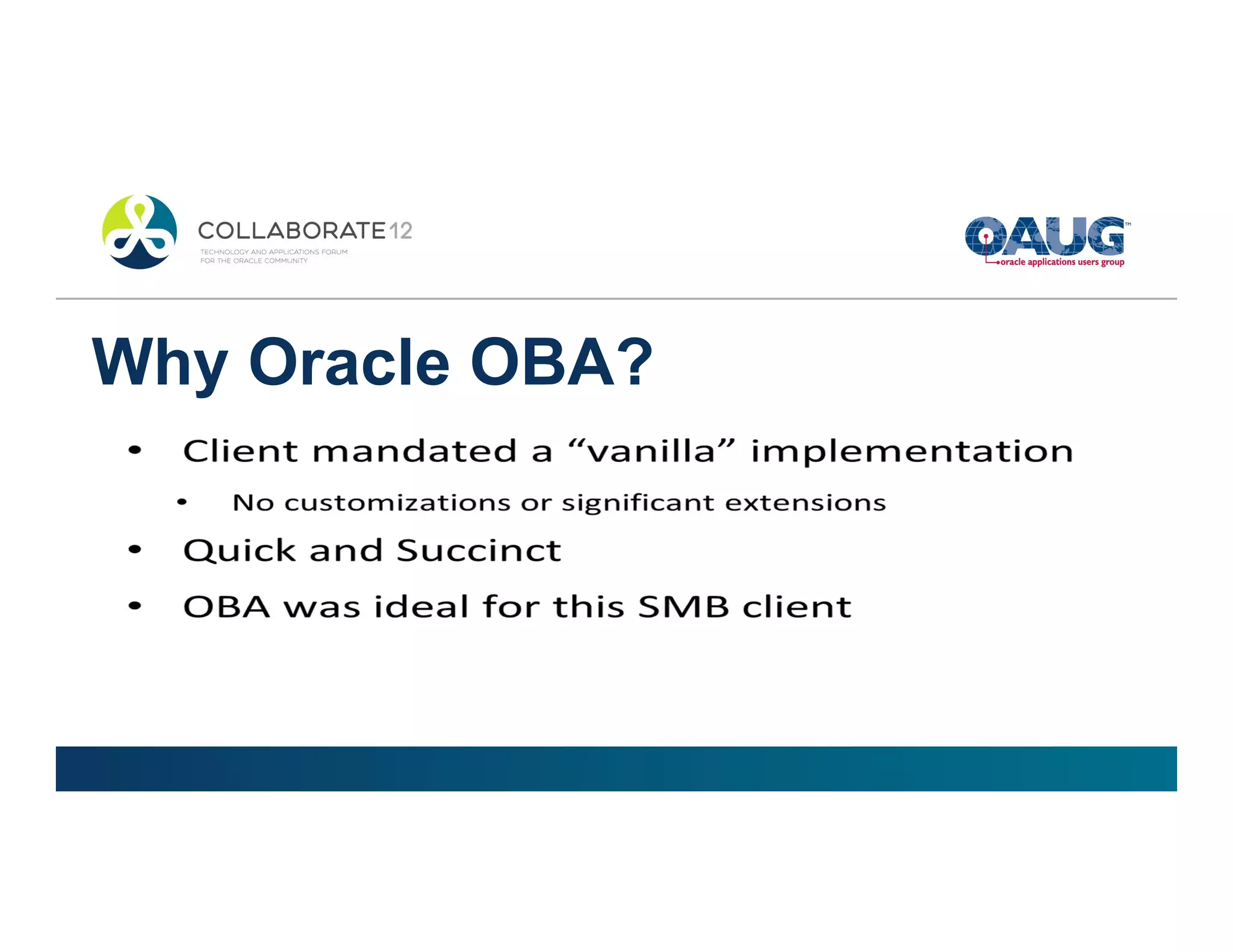

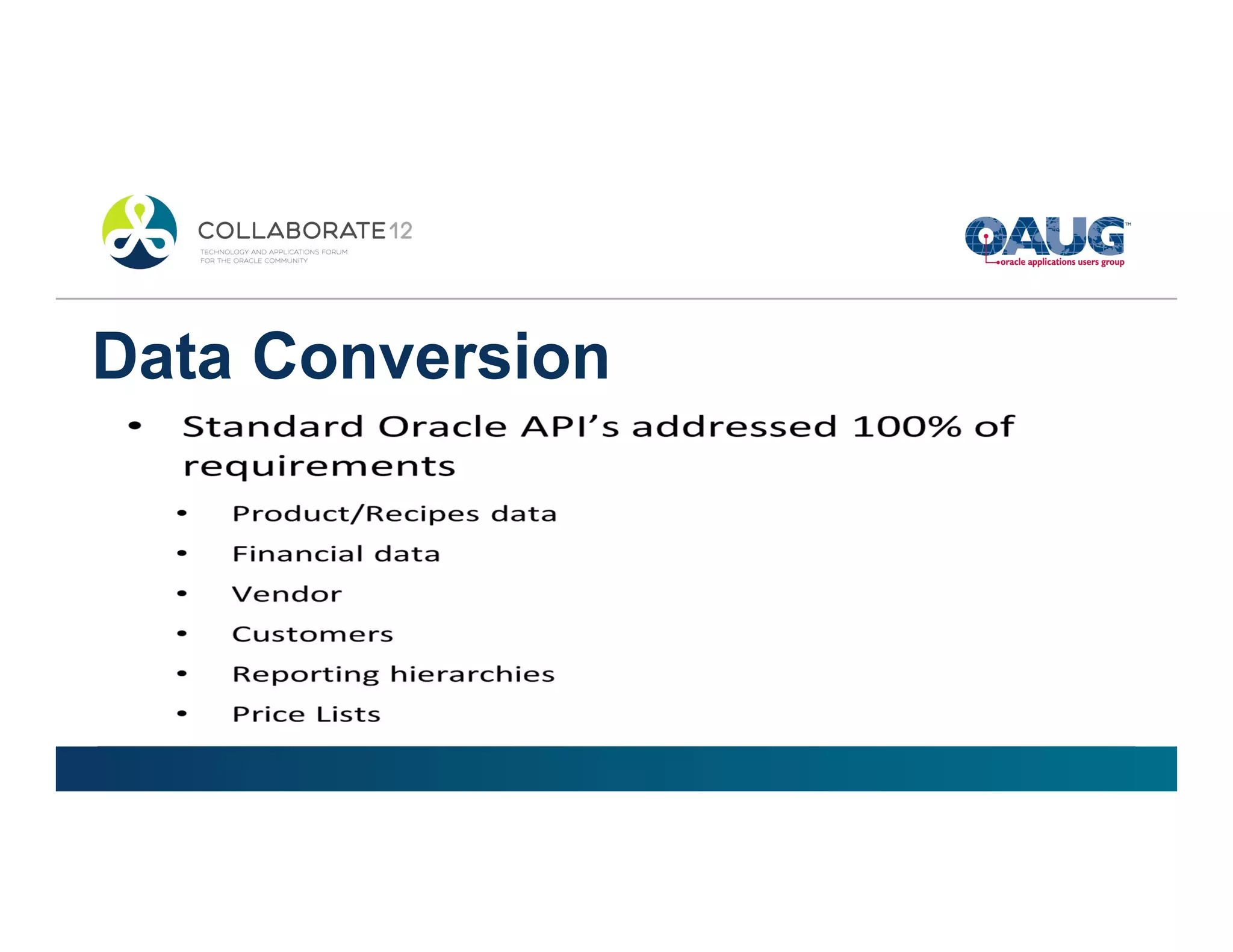

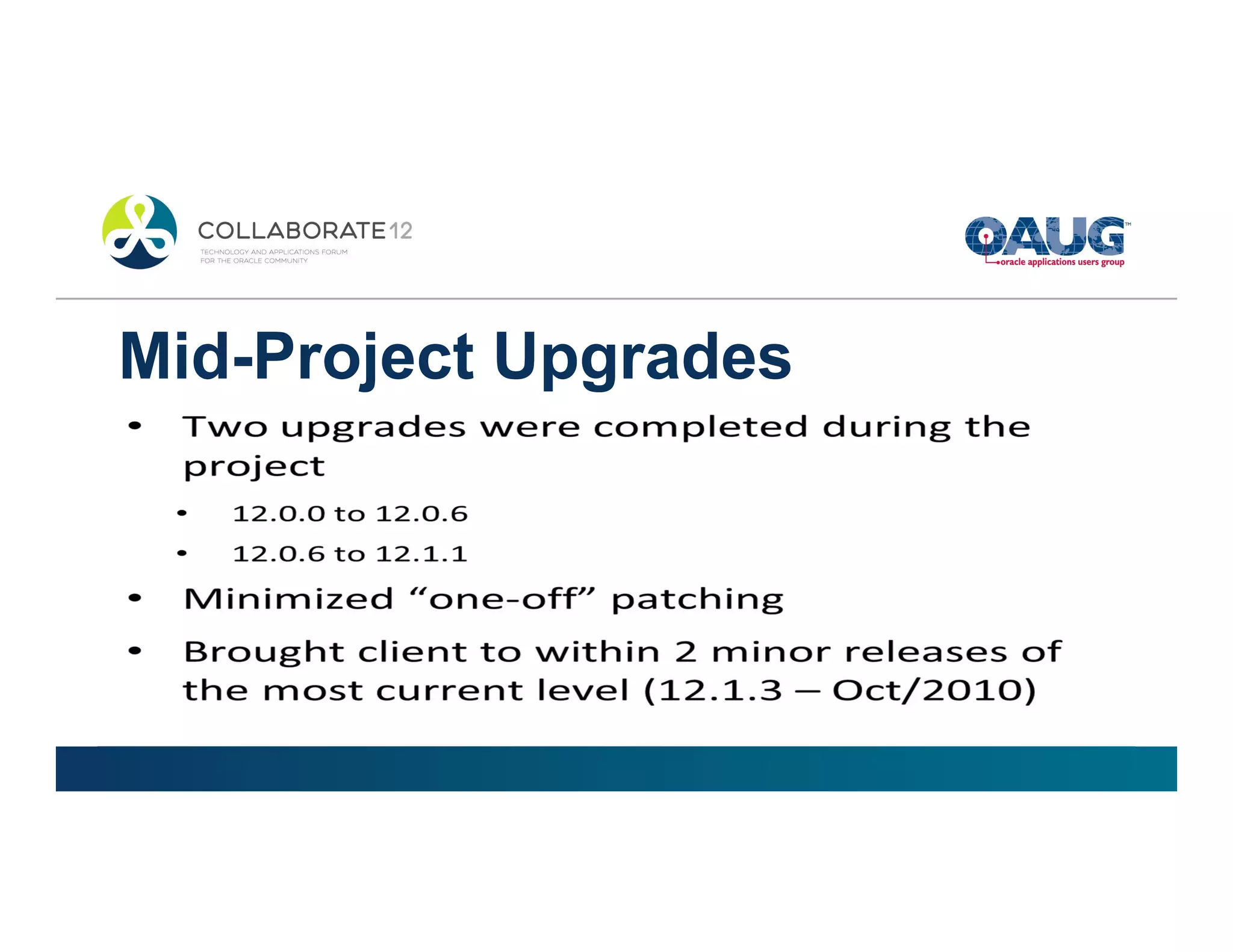

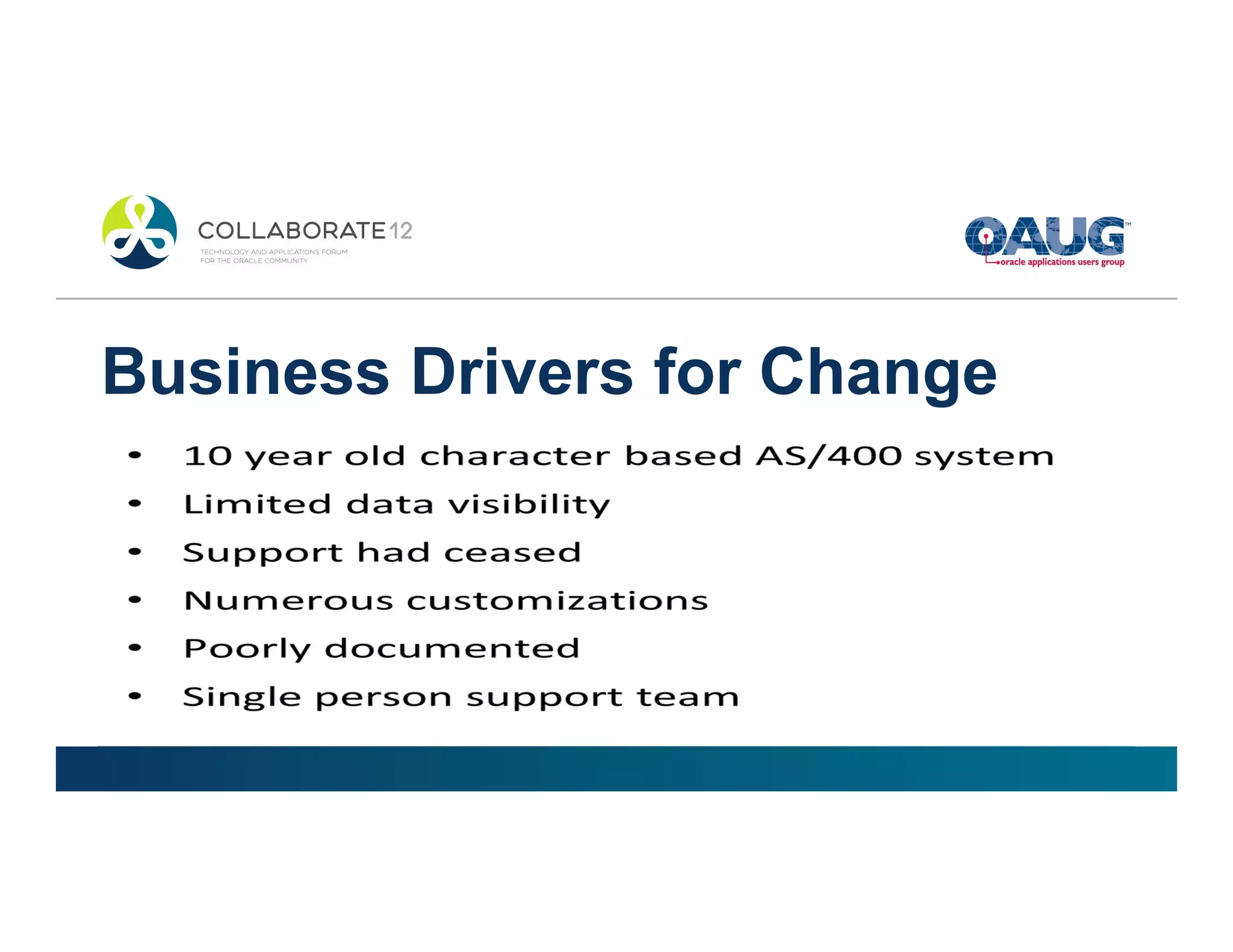

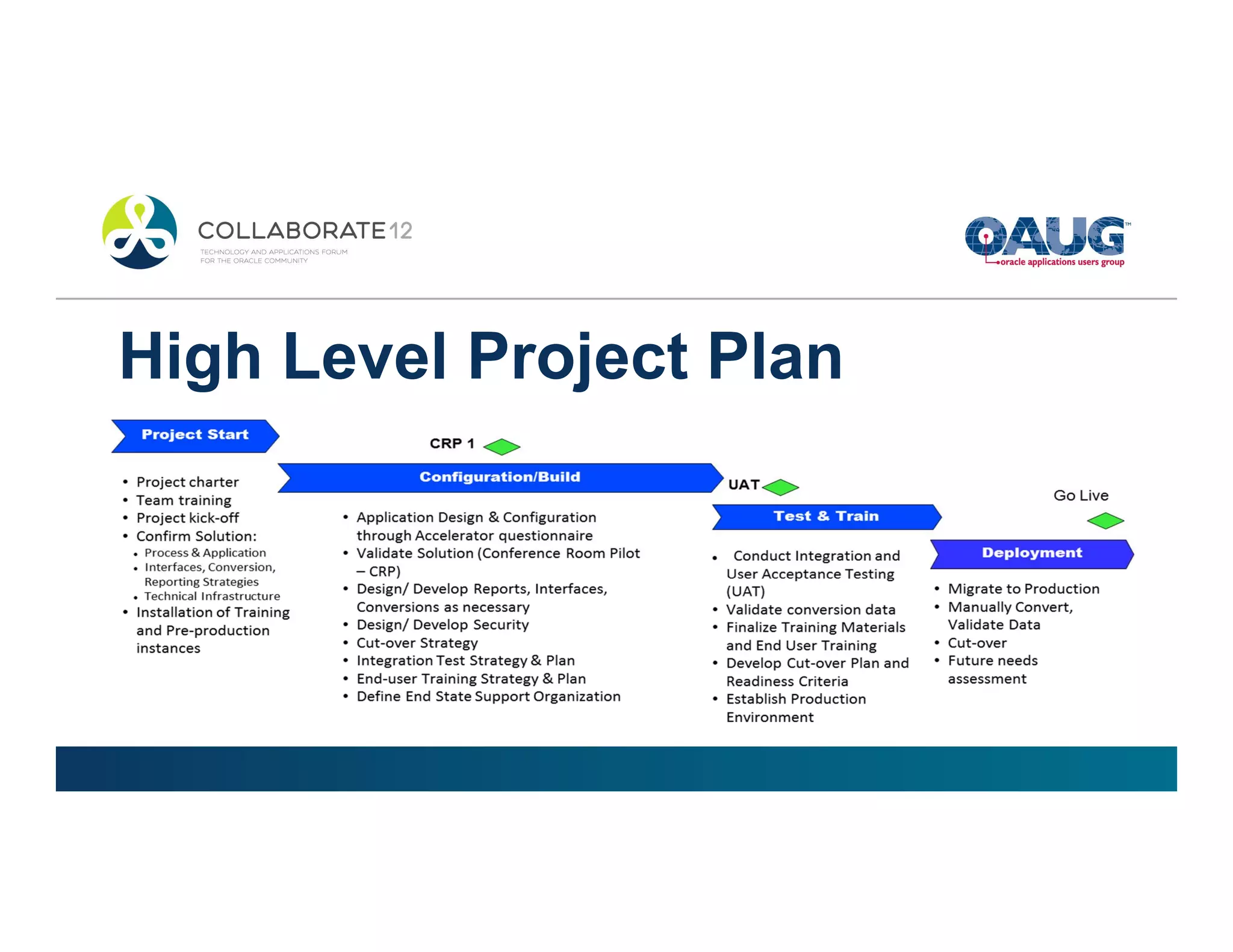

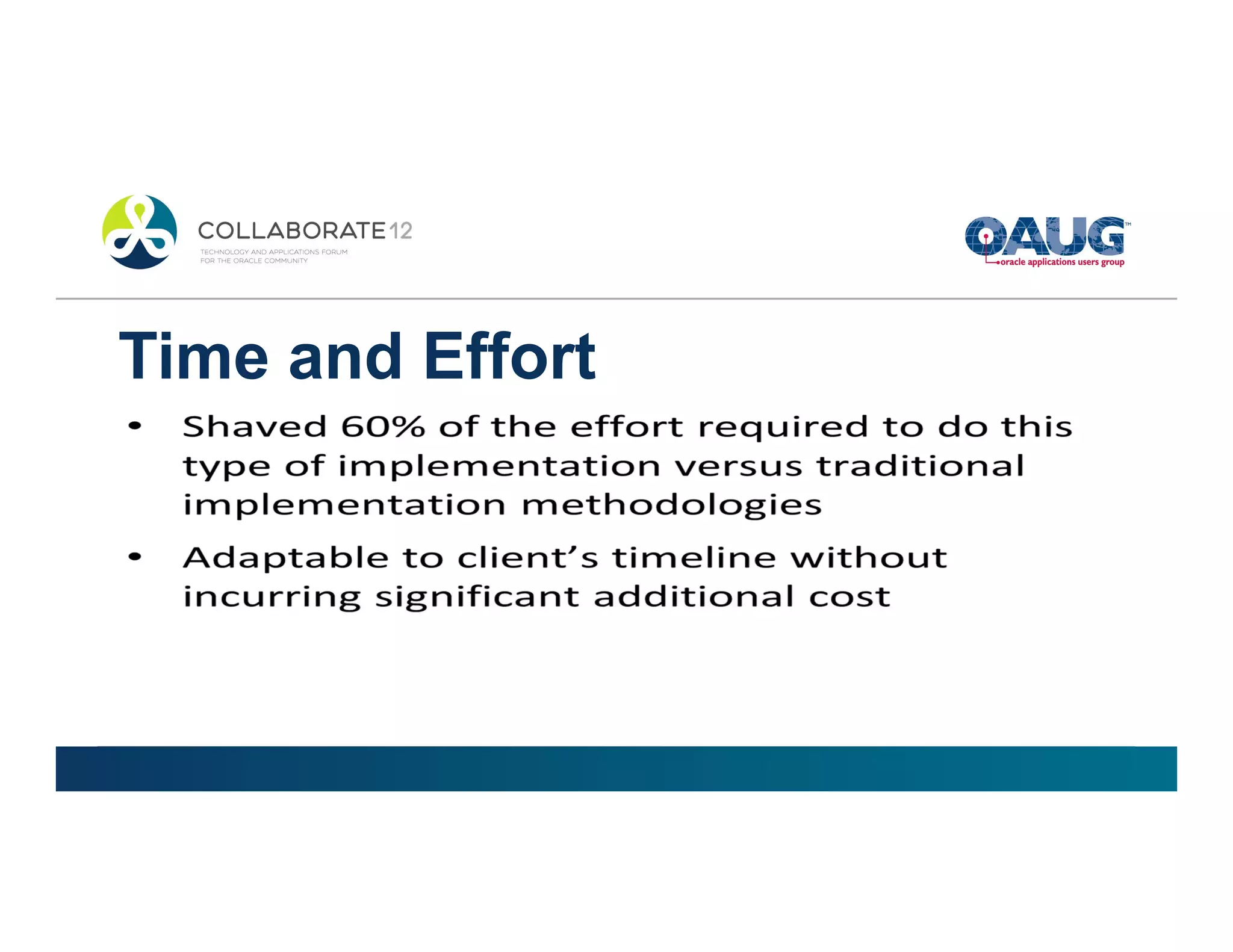

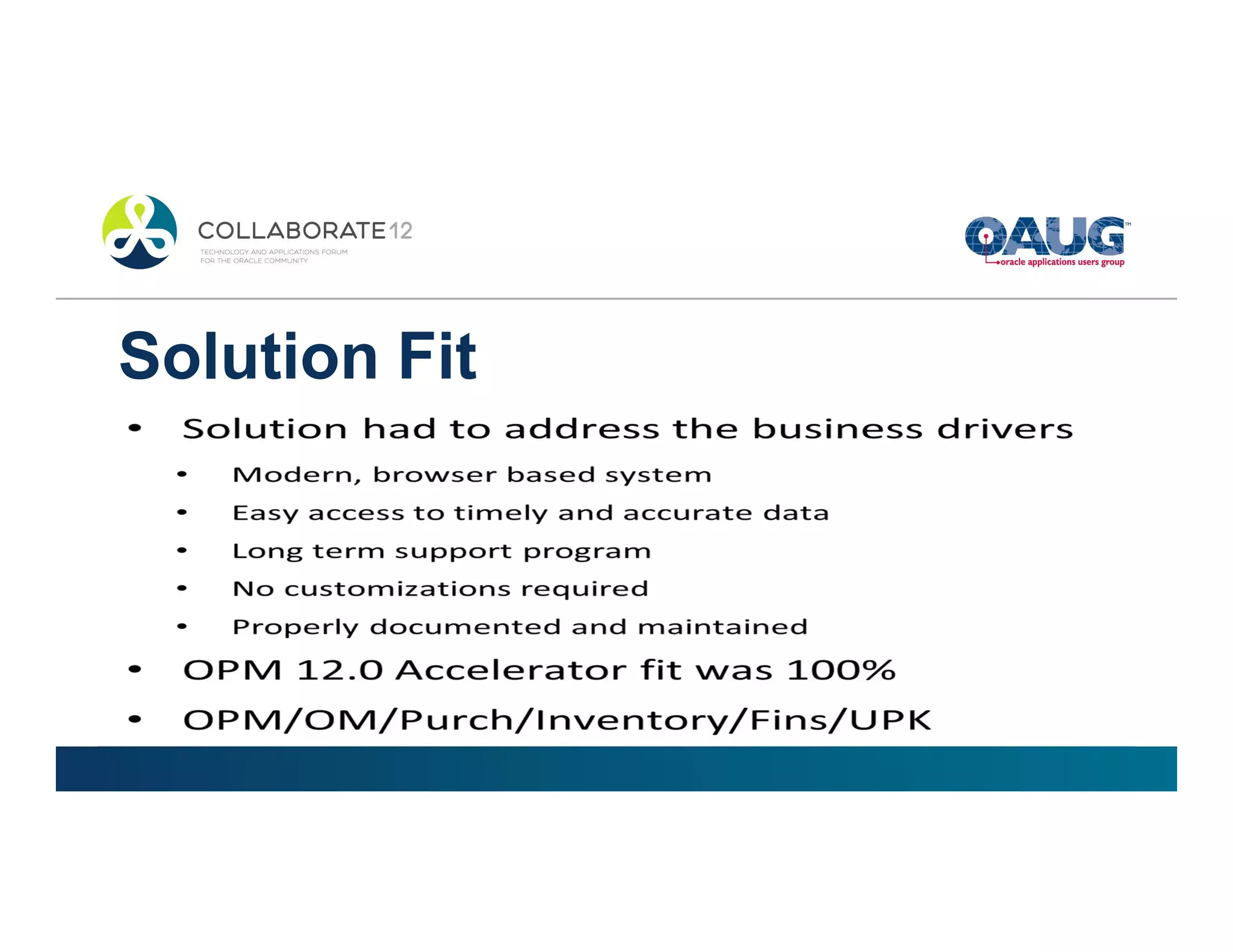

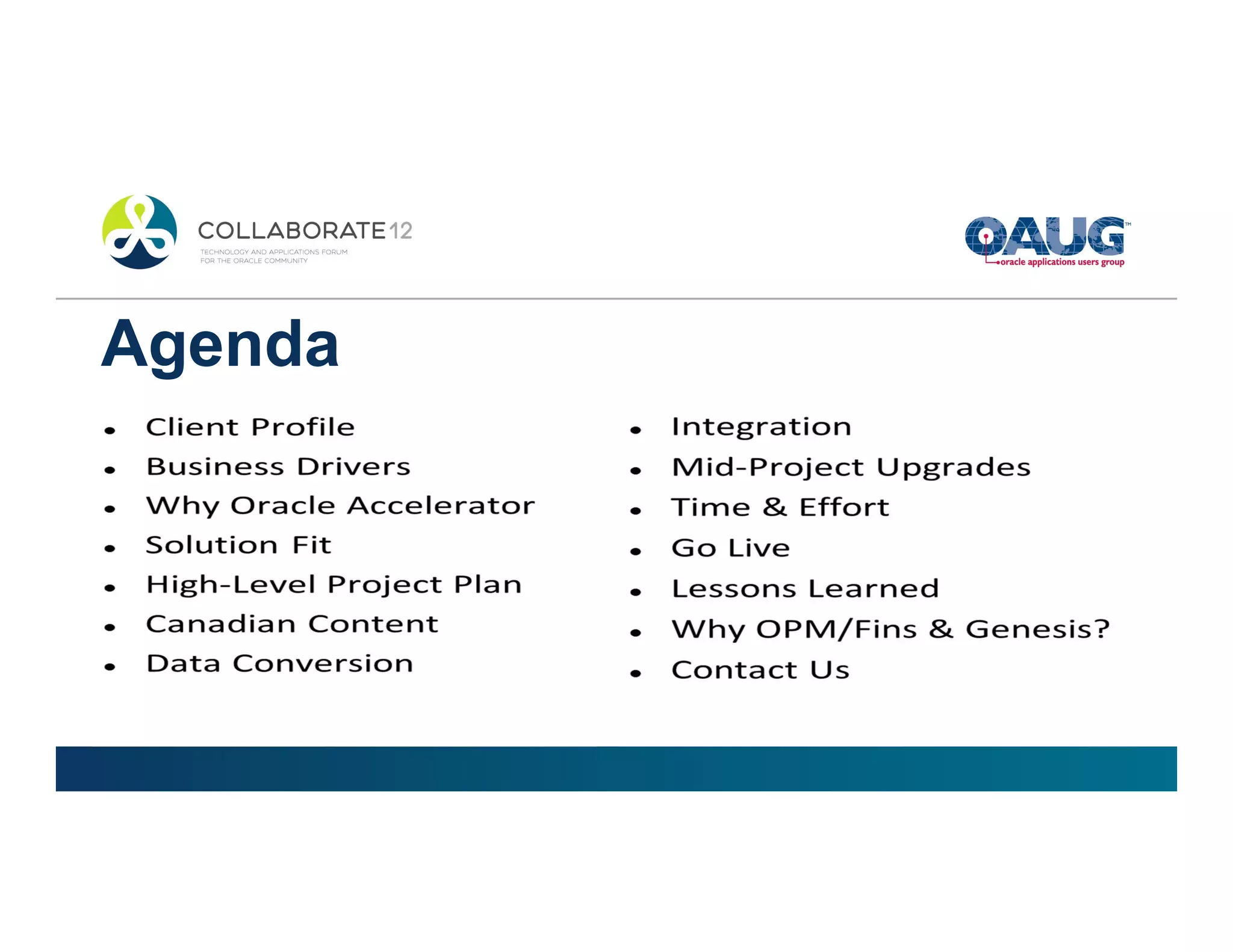

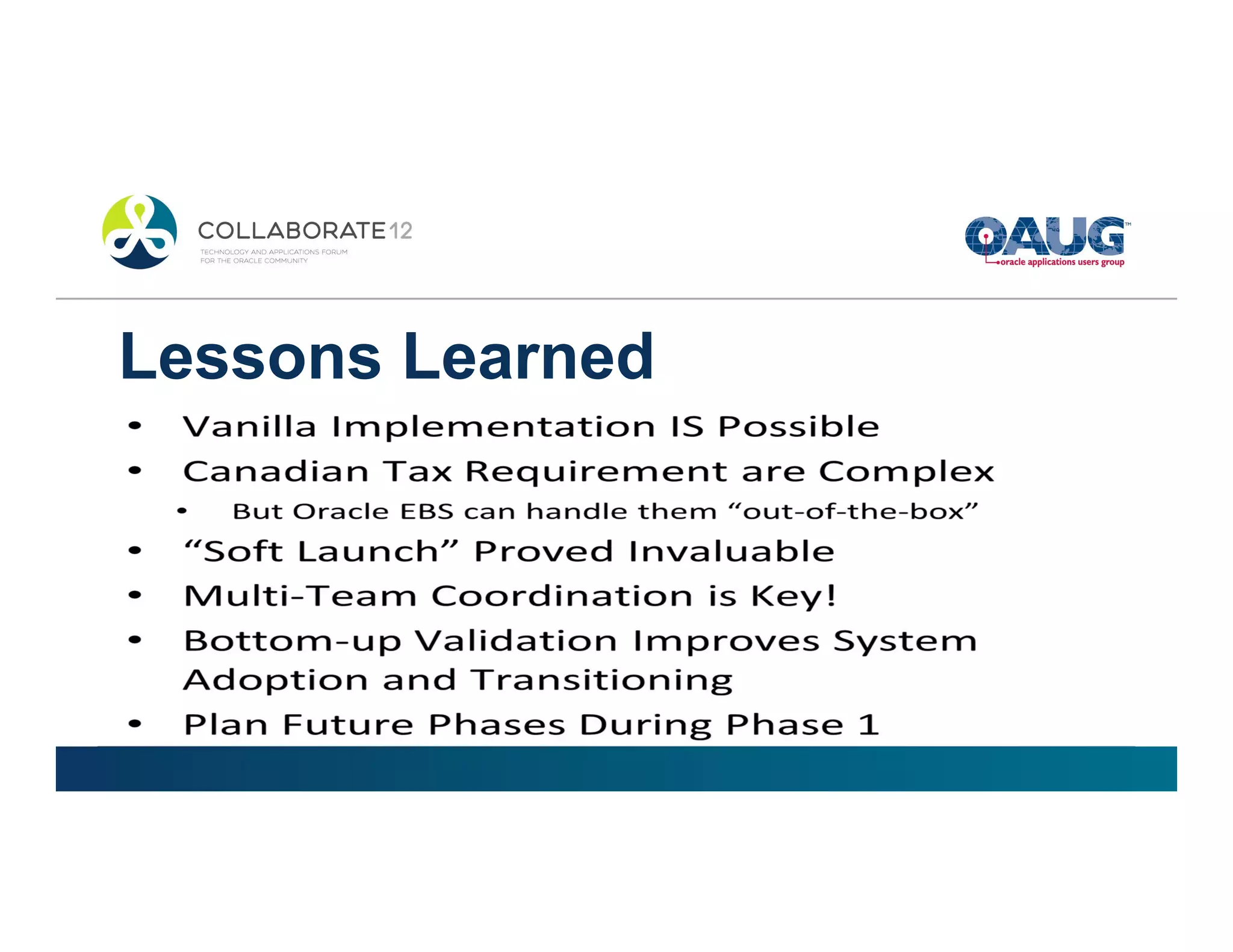

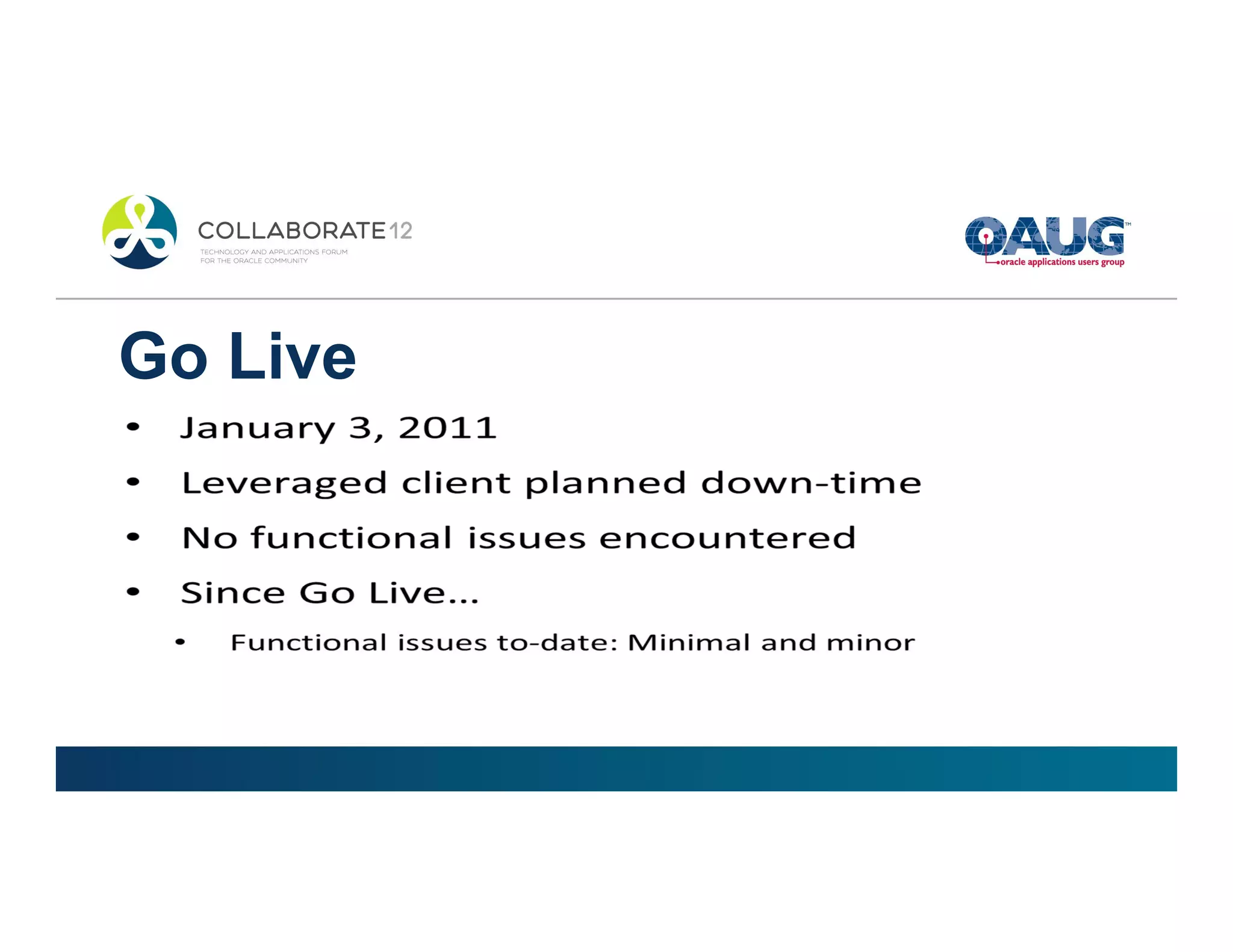

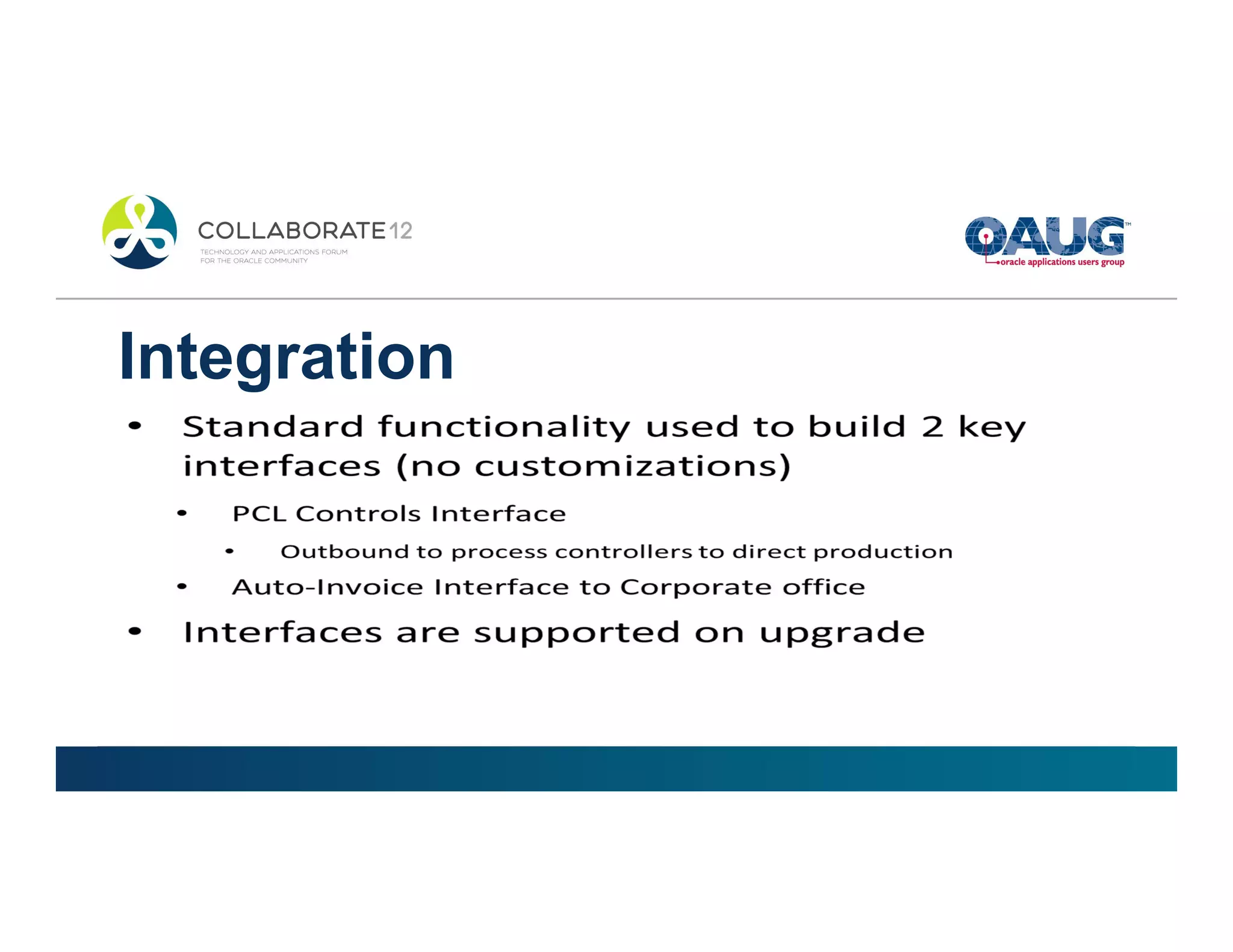

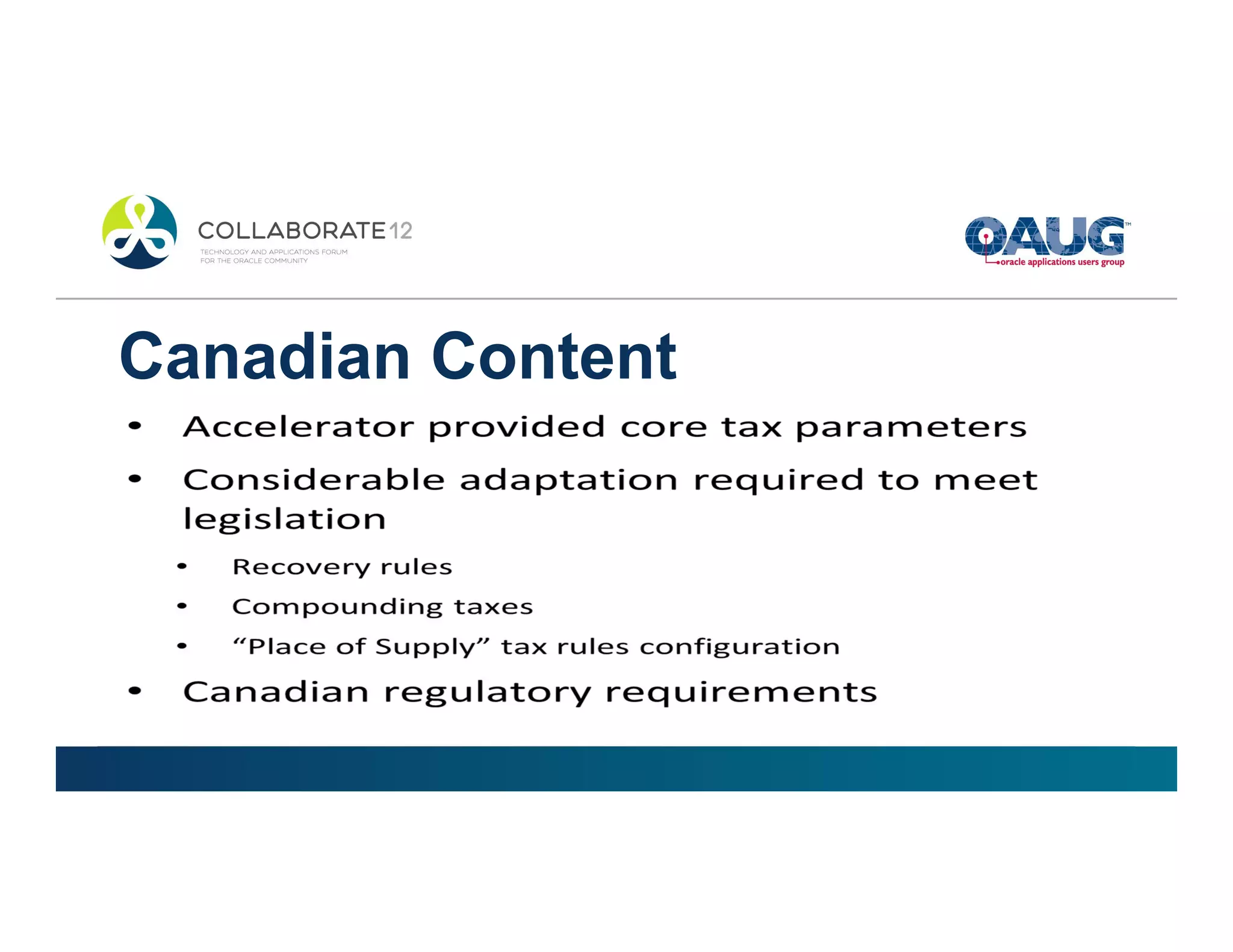

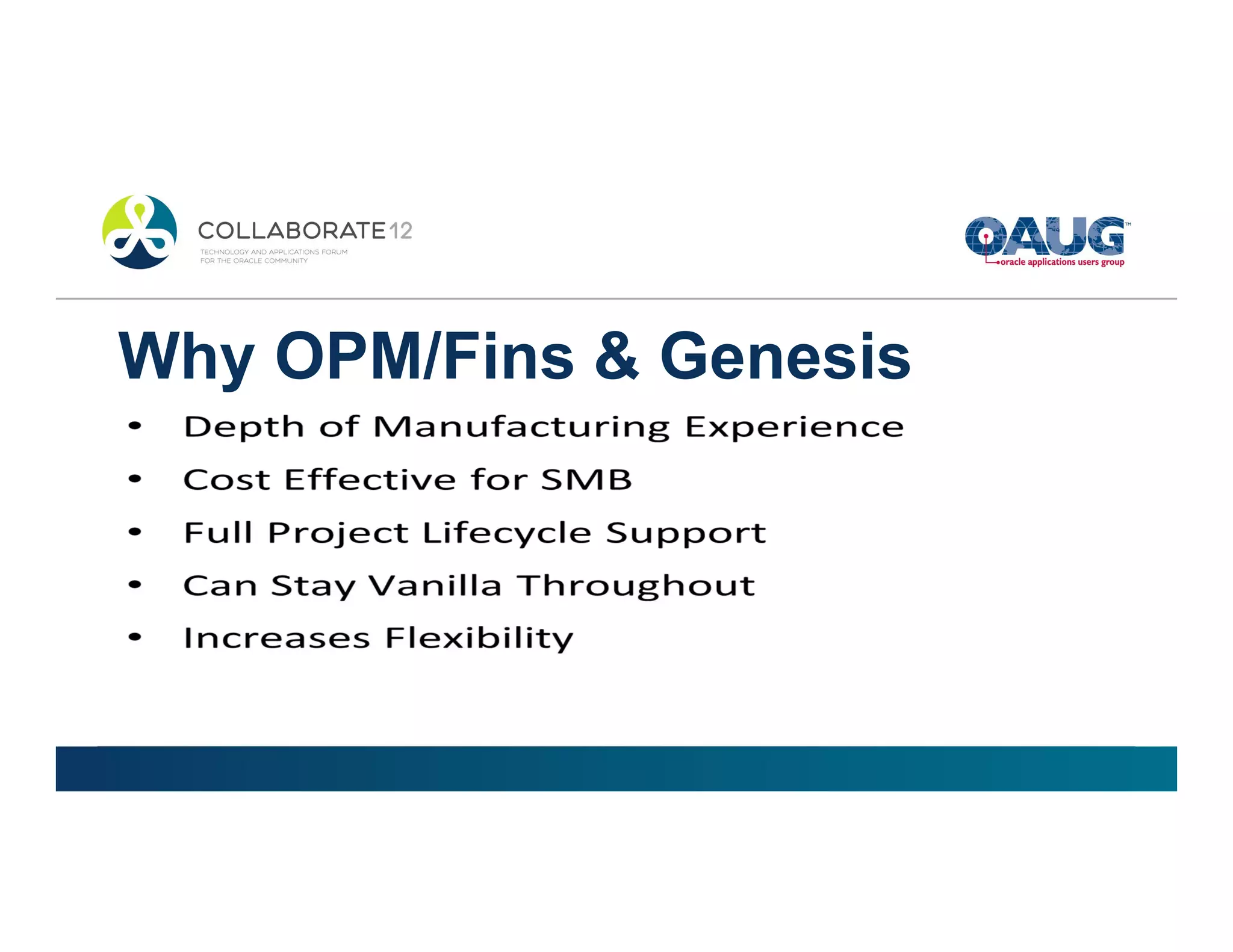

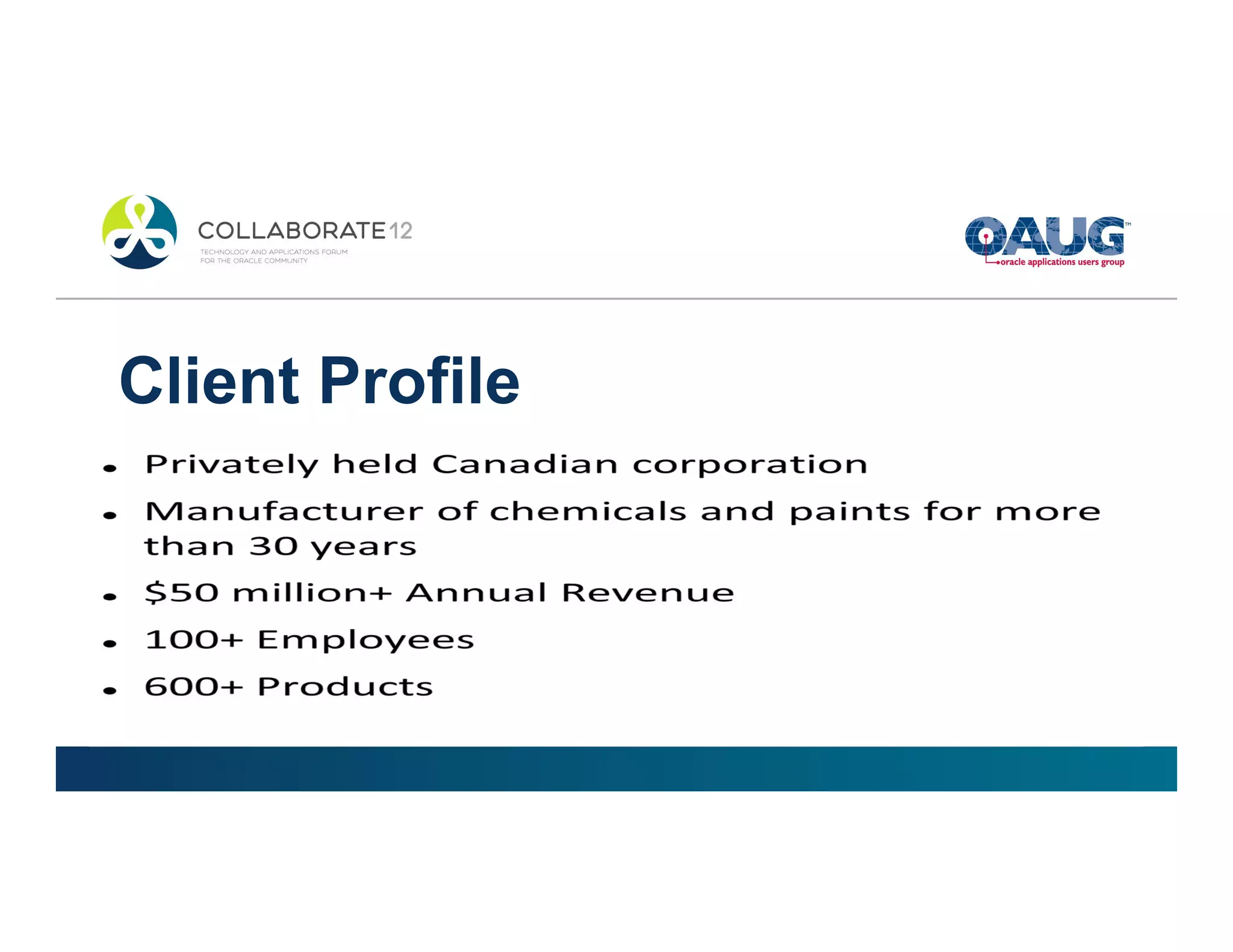

This presentation discusses lessons learned from an Oracle Process Manufacturing (OPM) implementation for a client using Oracle Billing Accelerator (OBA) on Oracle E-Business Suite Release 12. It covers the client profile, business drivers for change, reasons for choosing Oracle OBA, project plan, data conversion, integration, upgrades during the project, go-live, and lessons learned. Contact information is provided for the presenter and his company.
