Managing Changes to the Database Across the
Project Life Cycle
2. WHO AM I
The short version
• « the guy who has written a lot of answers
on the eZPublish forums »
• Working at Kaliop in London since 2014
• Principal consultant at eZ Systems for 7 years
• Love coffee and bicycles ?
• @gggeek
VOTRE SCHEMA

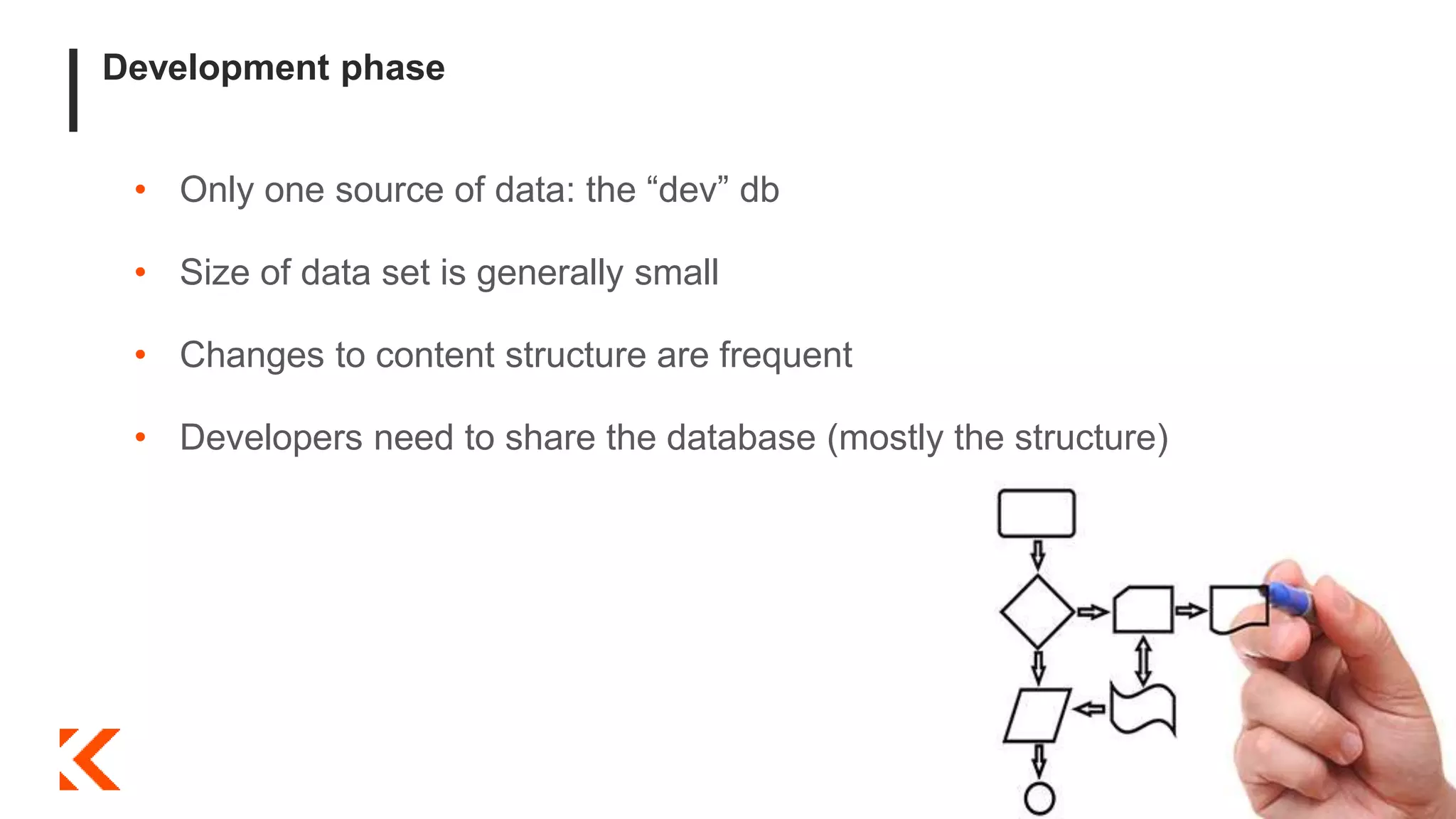

6. Development phase
• Only one source of data: the “dev” db
• Size of data set is generally small
• Changes to content structure are frequent
• Developers need to share the database (mostly the structure)

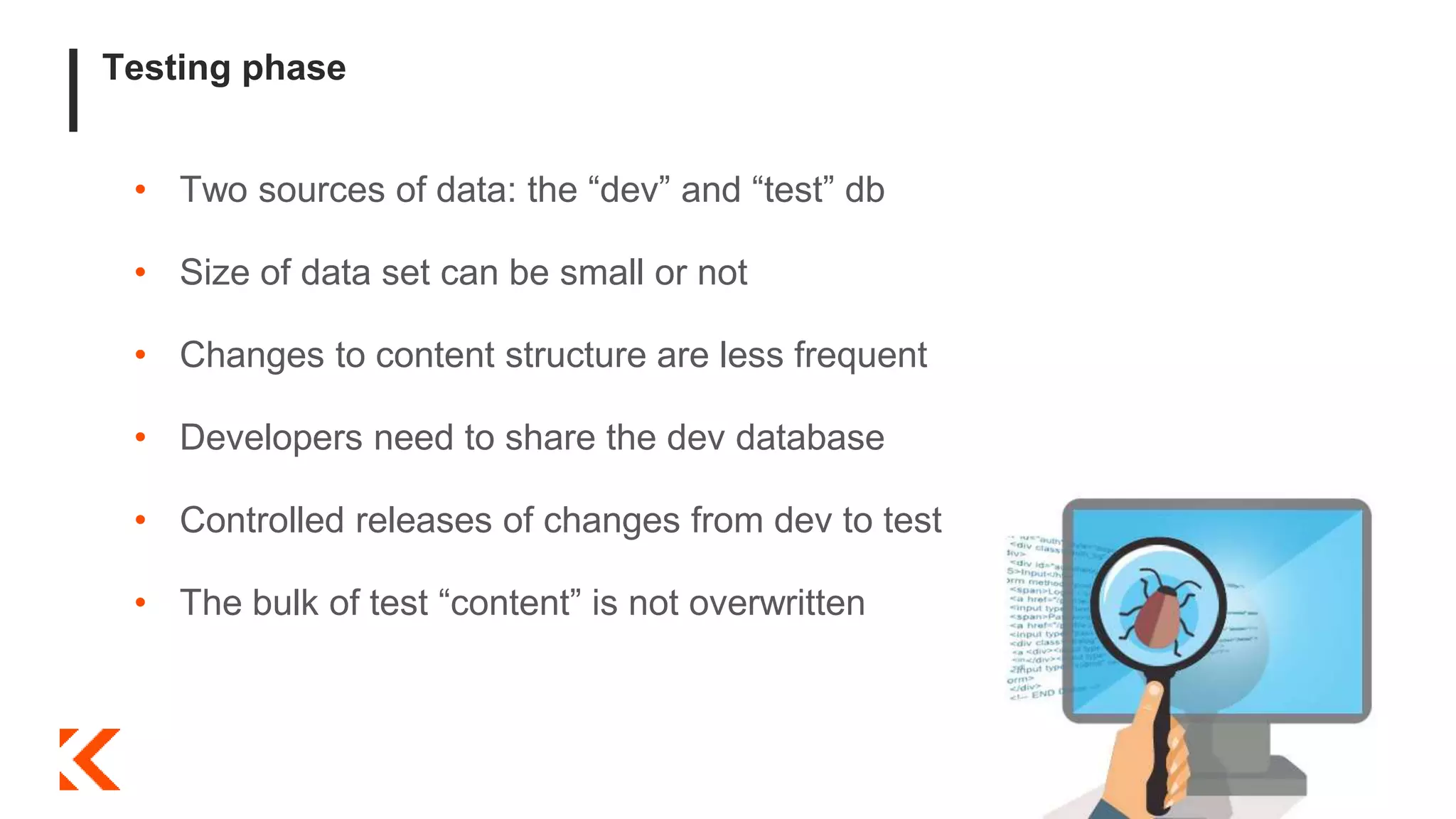

7. Testing phase
• Two sources of data: the “dev” and “test” db
• Size of data set can be small or not
• Changes to content structure are less frequent
• Developers need to share the dev database
• Controlled releases of changes from dev to test
• The bulk of test “content” is not overwritten

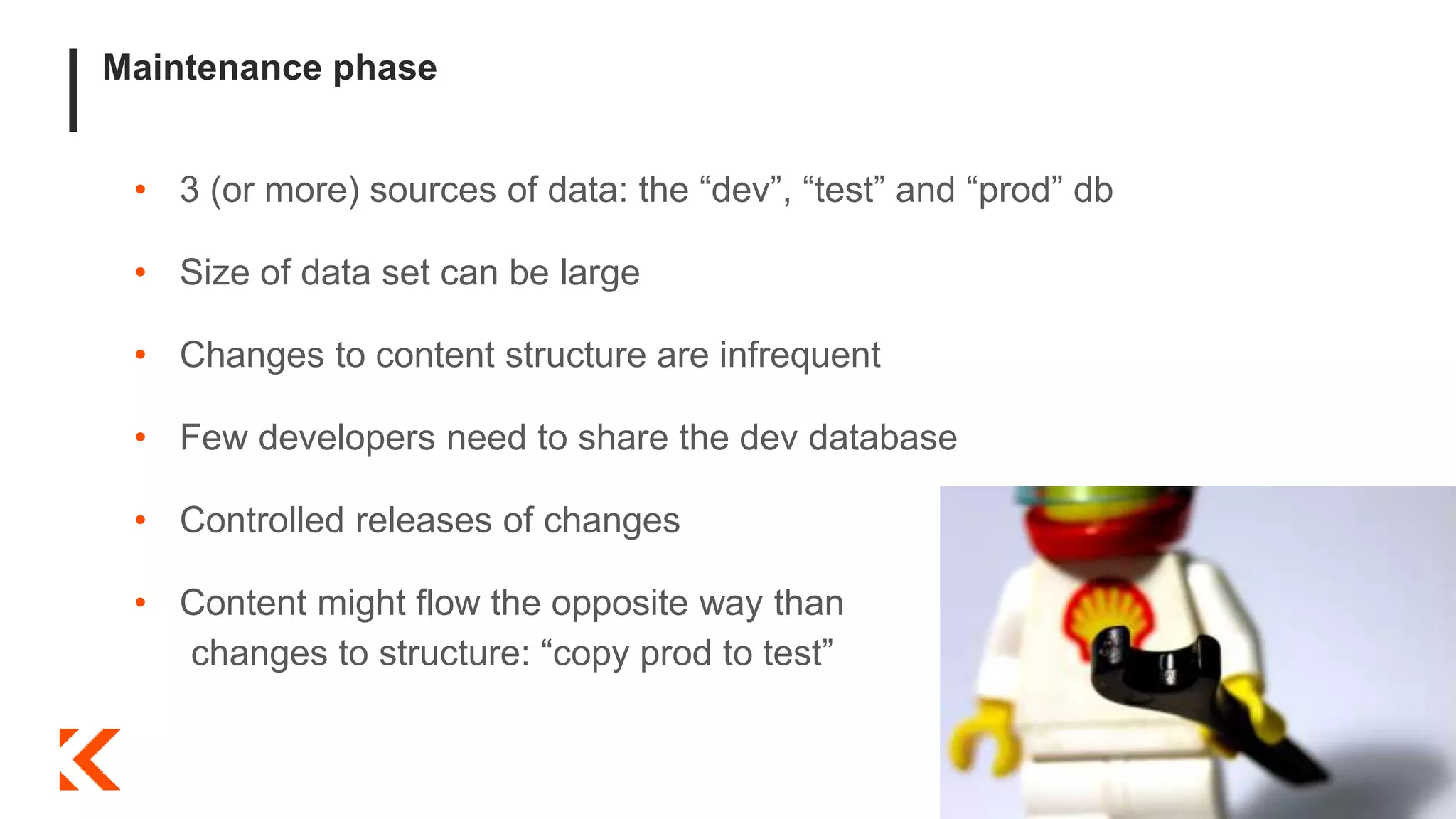

8. Maintenance phase
• 3 (or more) sources of data: the “dev”, “test” and “prod” db
• Size of data set can be large
• Changes to content structure are infrequent
• Few developers need to share the dev database
• Controlled releases of changes
• Content might flow the opposite way than
changes to structure: “copy prod to test”

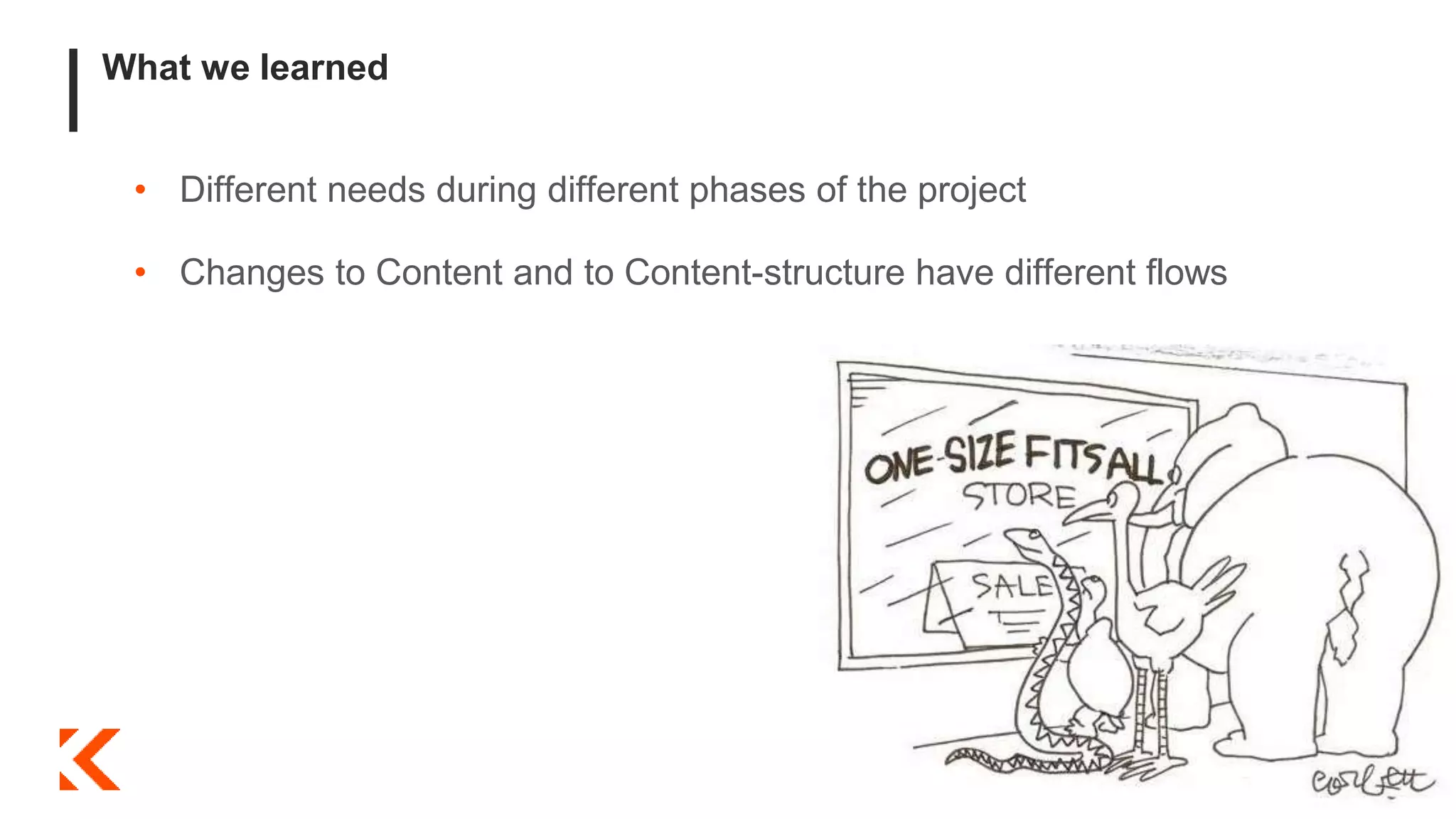

9. What we learned
• Different needs during different phases of the project
• Changes to Content and to Content-structure have different flows
10. What the CMS brings in
• Content structure can be modified via the GUI!
• Many tables, with many relations
• No foreign keys
(import scripts can break referential integrity)
• Some data is tied to files stored on disk
(take care when doing backups!)
• Impossible to replicate / sync single tables
11. Is it all for the better?
• Easy to deploy changes to Content Structure after go live
Unless the changes takes hours to apply
Will never cover 100% of the cases
• Hard to automate
• Hard to verify
13. Keeping Databases in sync
Many possibilities:
A. All developers connect to the same db
B. Managing changes manually
C. The database is committed to git
D. Managing changes via scripts
E. Live DB replication (really ???)
F. More ?
15. Connecting to a shared database
• good for teams which are *not* geographically distributed
• works when developers do not blow up the database with junk
content: needs some developer discipline
• works only up to the 1st deployment to TEST env;
then 2 dbs have to be managed anyway
17. Managing database changes manually
• Changes to be applied are documented and applied via GUI
• Most Unsafe Option (TM)
• Some tools to help you to keep mental sanity:

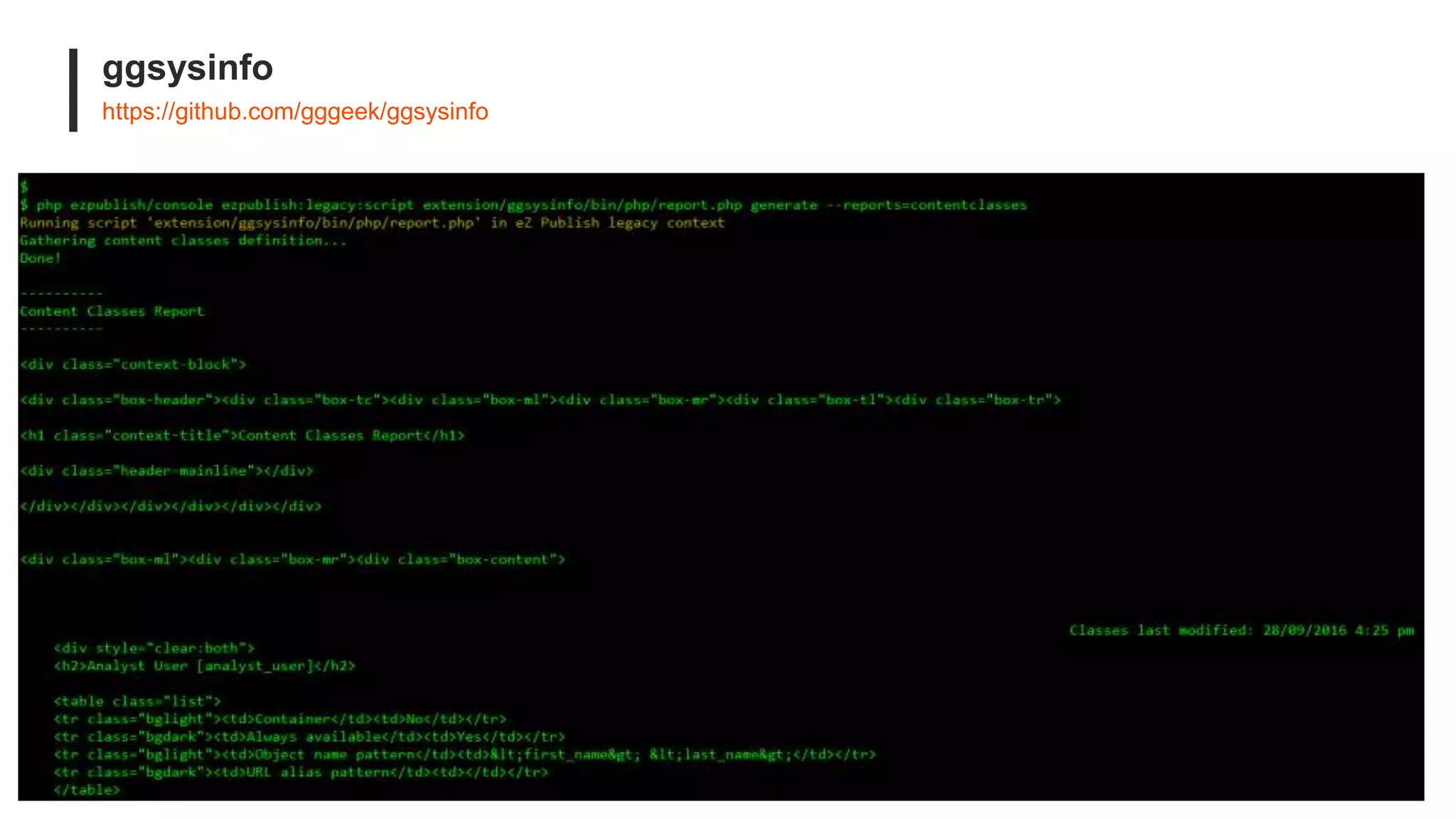

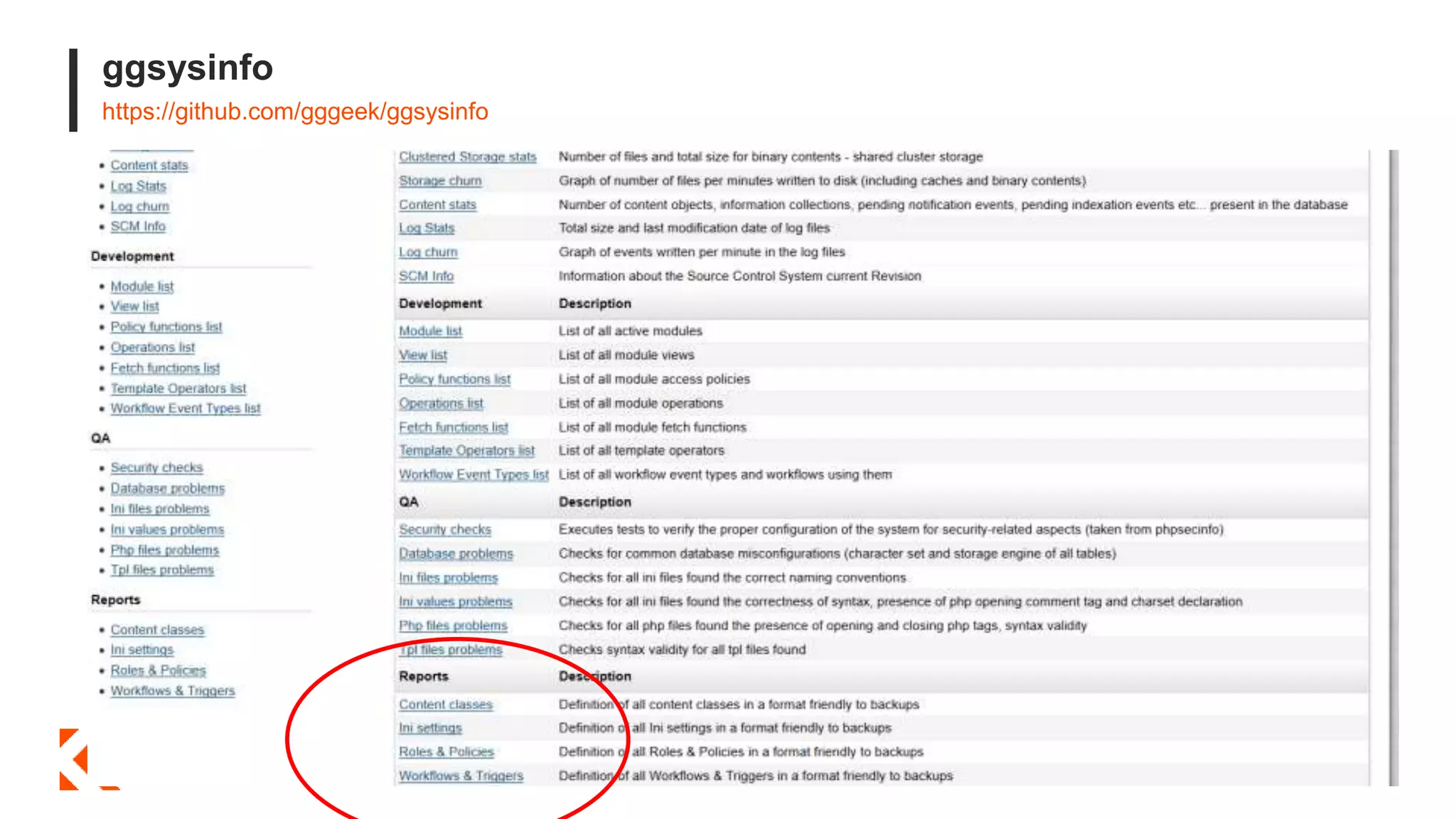

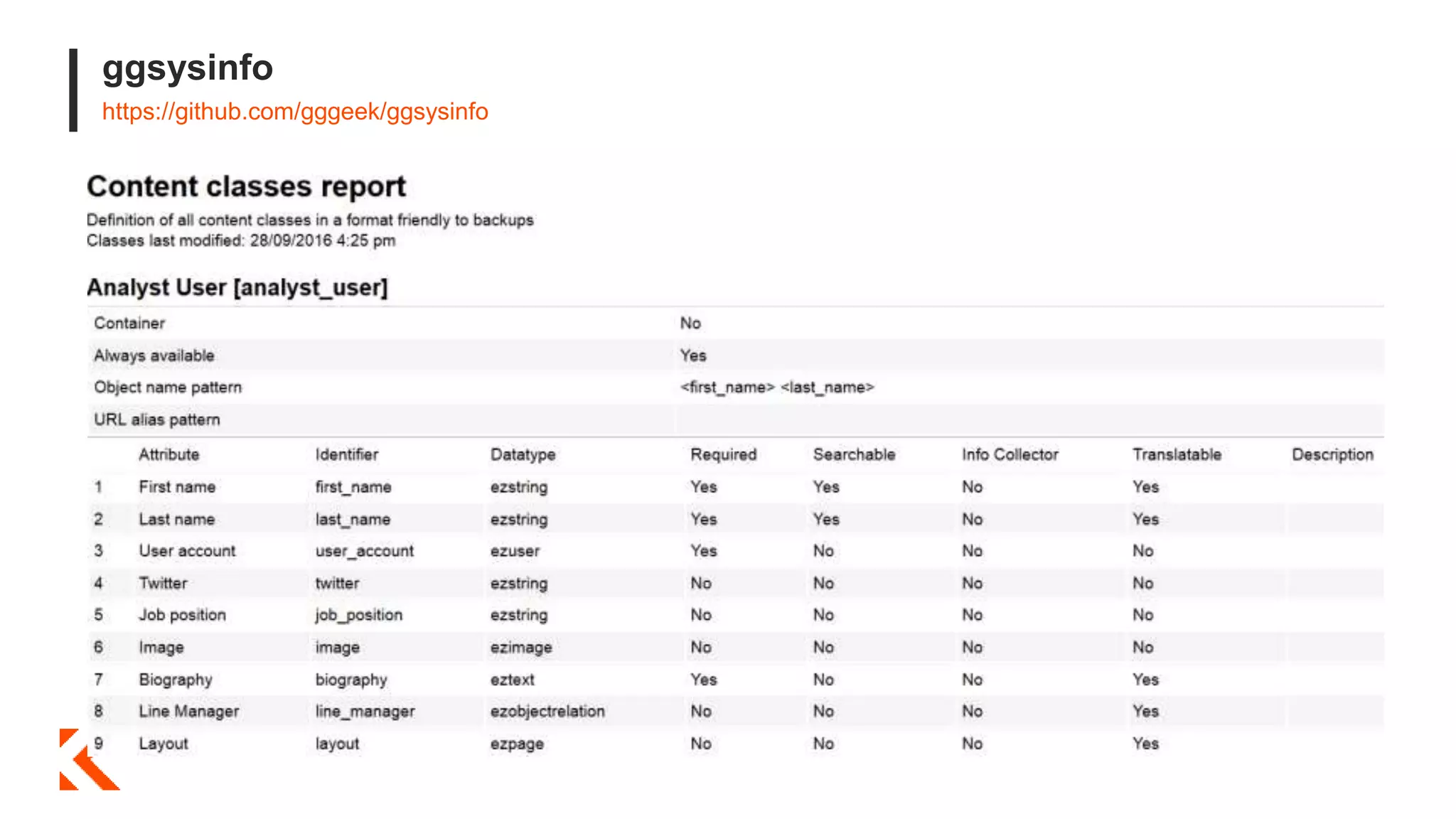

ggsysinfo

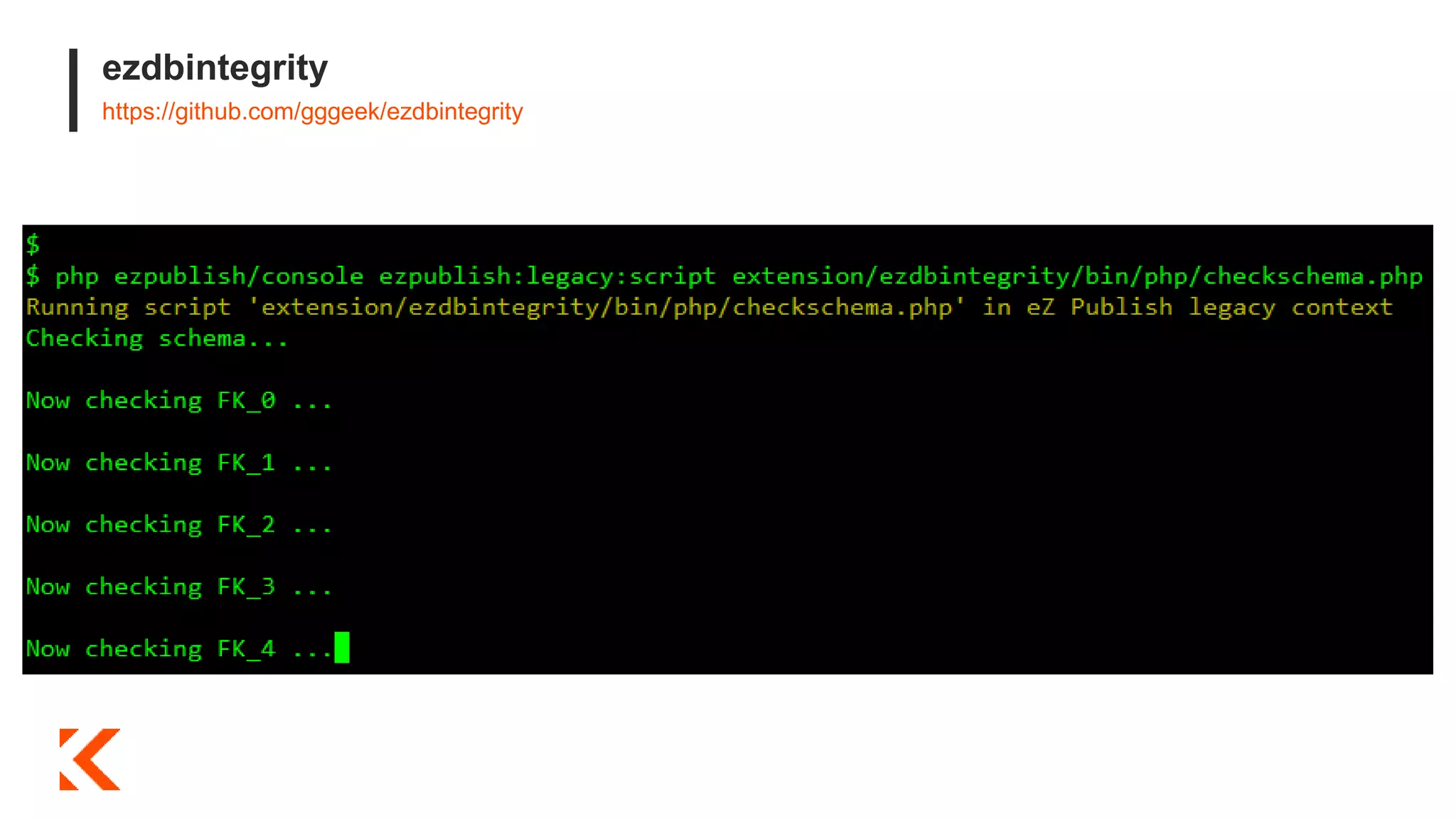

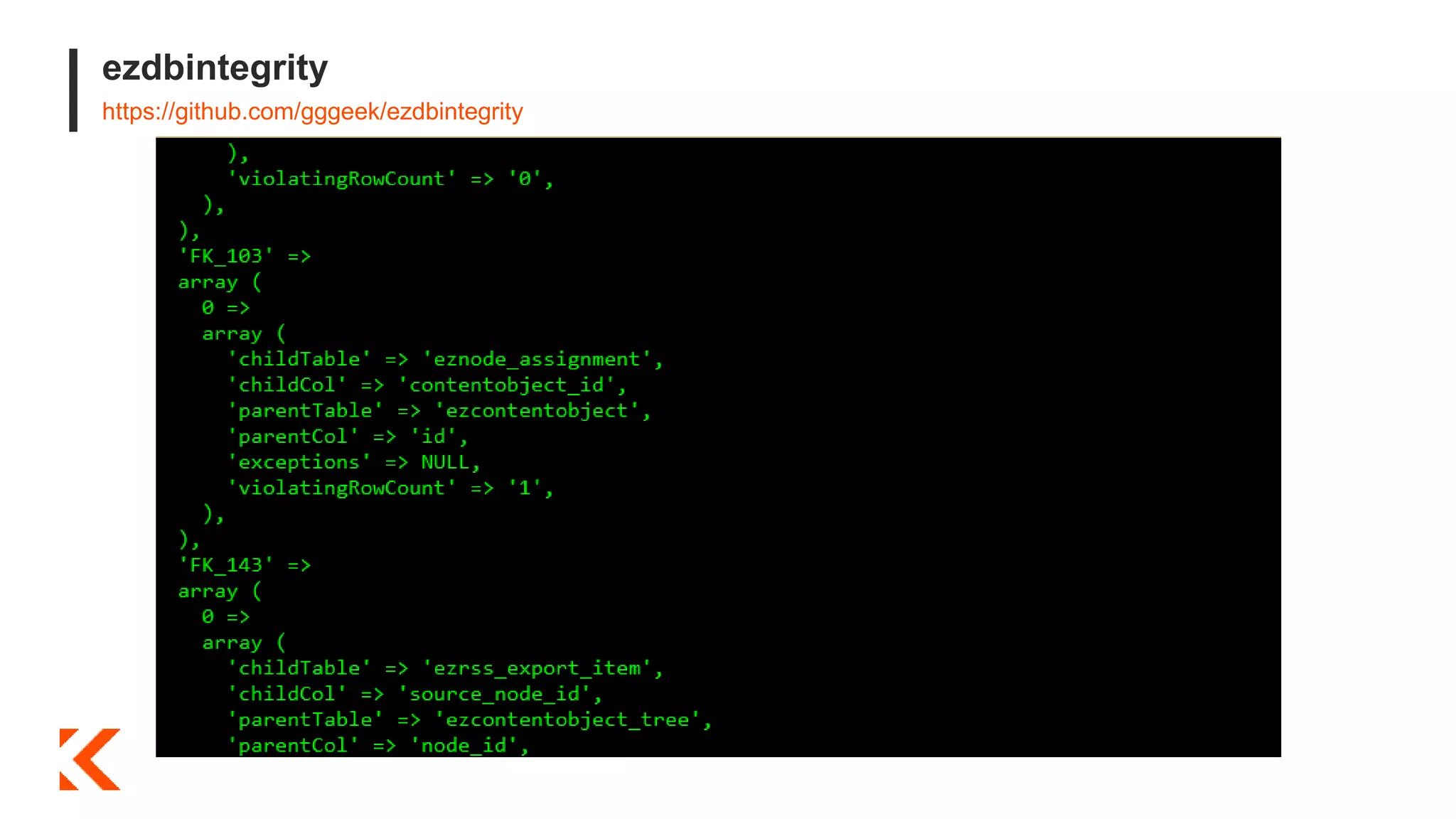

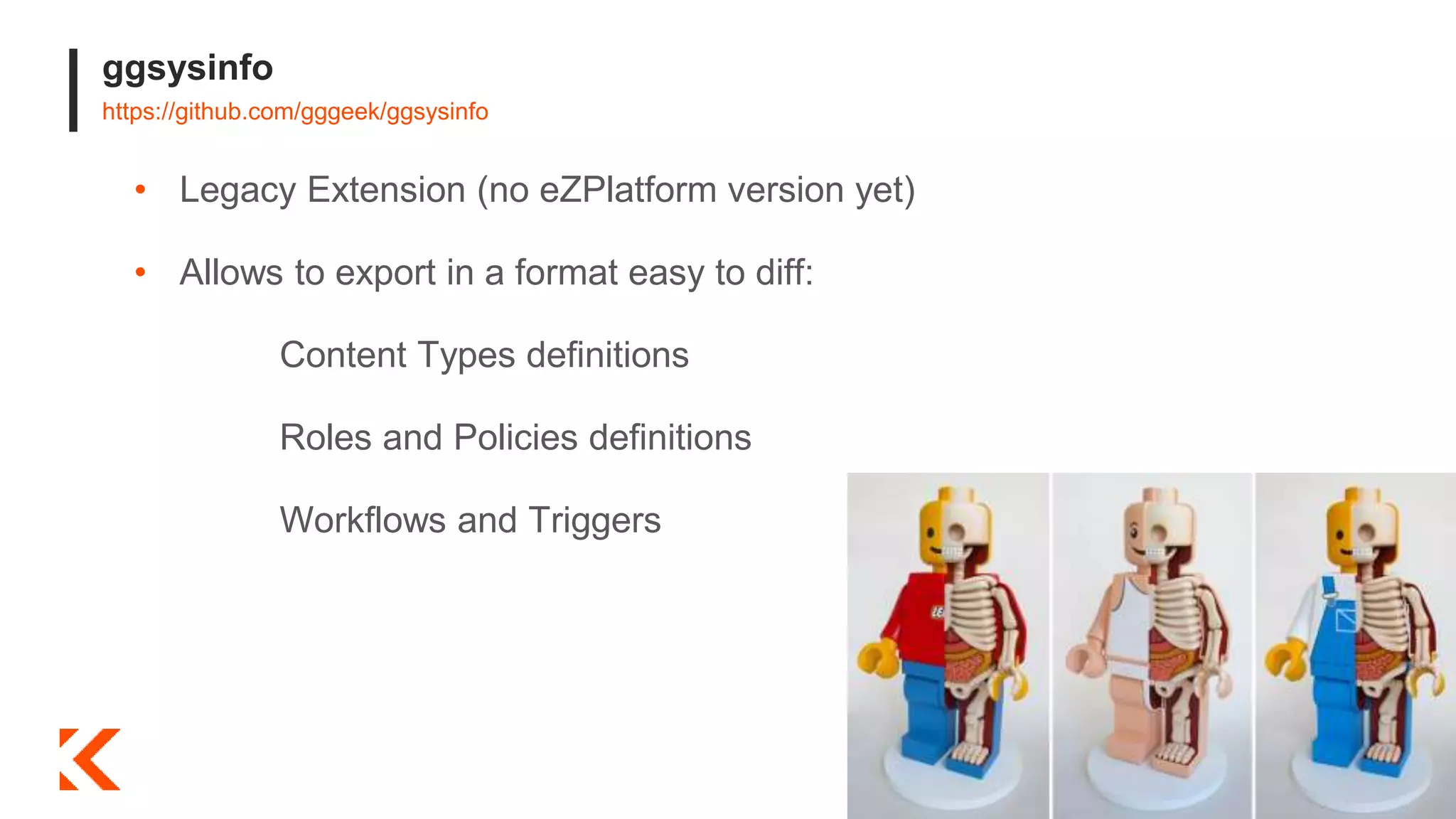

ezdbintegrity

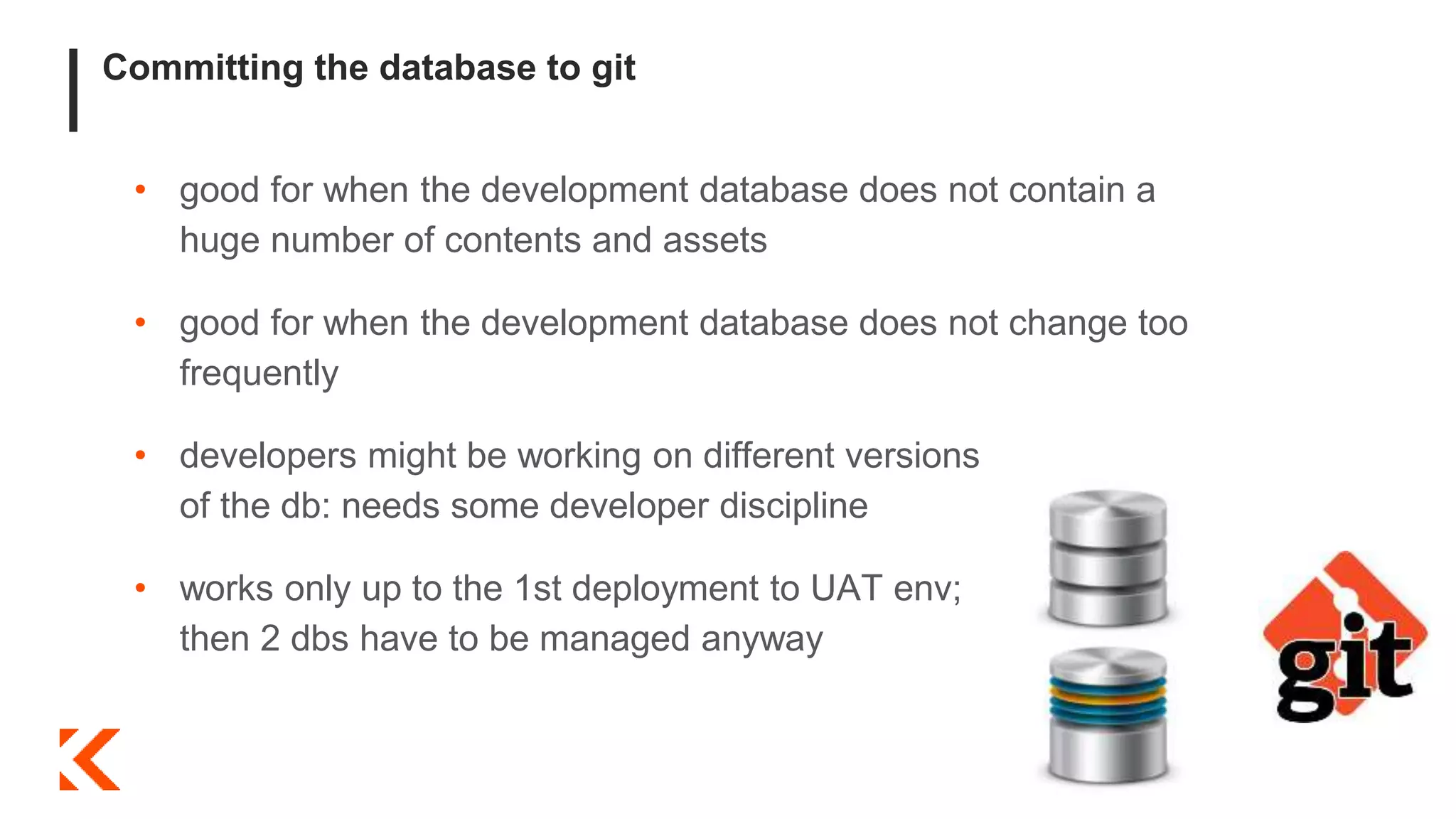

26. Committing the database to git
• good for when the development database does not contain a
huge number of contents and assets
• good for when the development database does not change too
frequently
• developers might be working on different versions
of the db: needs some developer discipline
• works only up to the 1st deployment to UAT env;
then 2 dbs have to be managed anyway
27. Committing the database to git

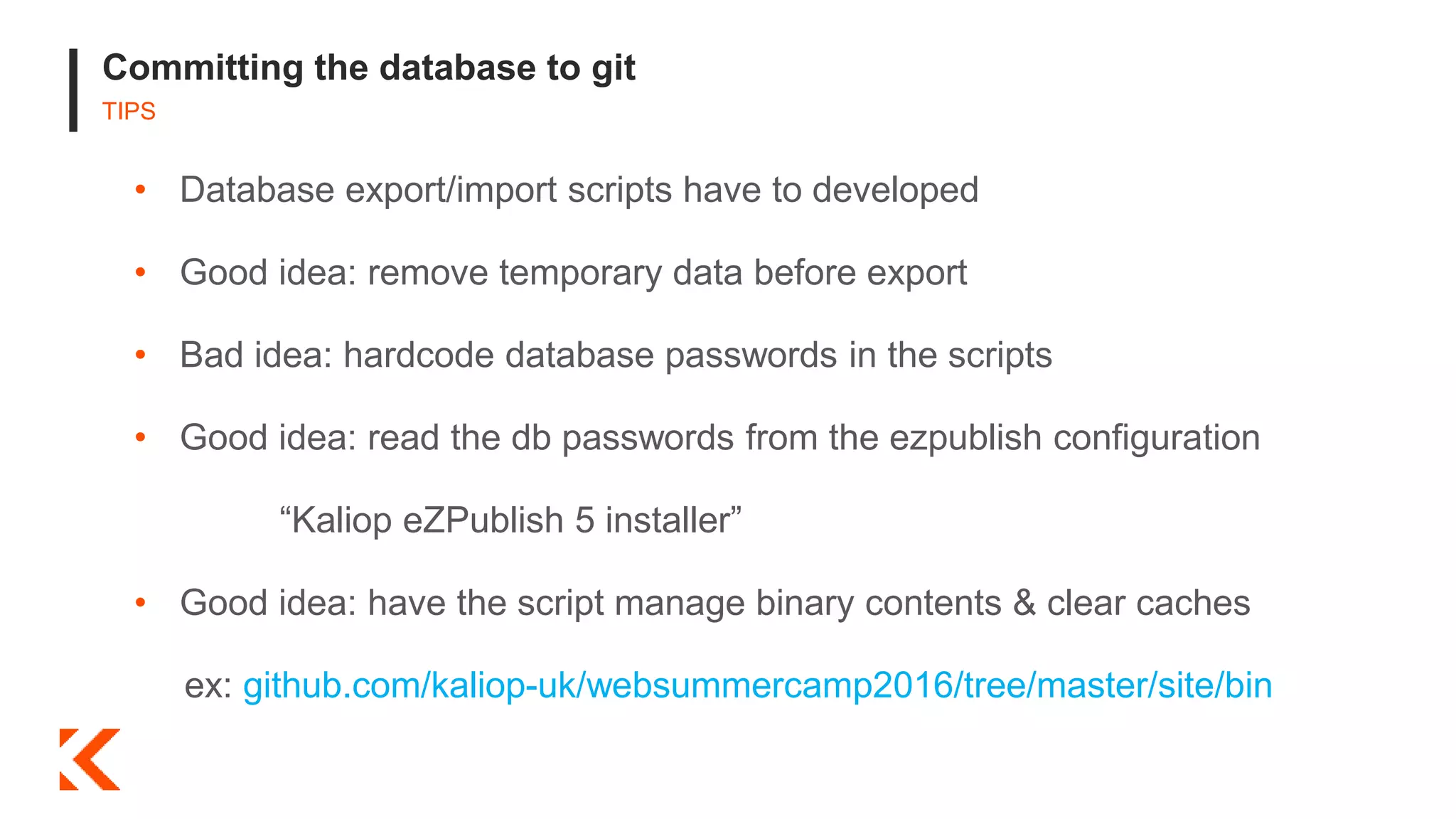

TIPS
• Database export/import scripts have to developed
• Good idea: remove temporary data before export
• Bad idea: hardcode database passwords in the scripts
• Good idea: read the db passwords from the ezpublish configuration
“Kaliop eZPublish 5 installer”
• Good idea: have the script manage binary contents & clear caches
ex: github.com/kaliop-uk/websummercamp2016/tree/master/site/bin
29. Managing database changes via script
• Safest option
• Good for when the development database does not change too
frequently
• Perfect after deployment to TEST/PROD
• kaliop/ezmigrationbundle

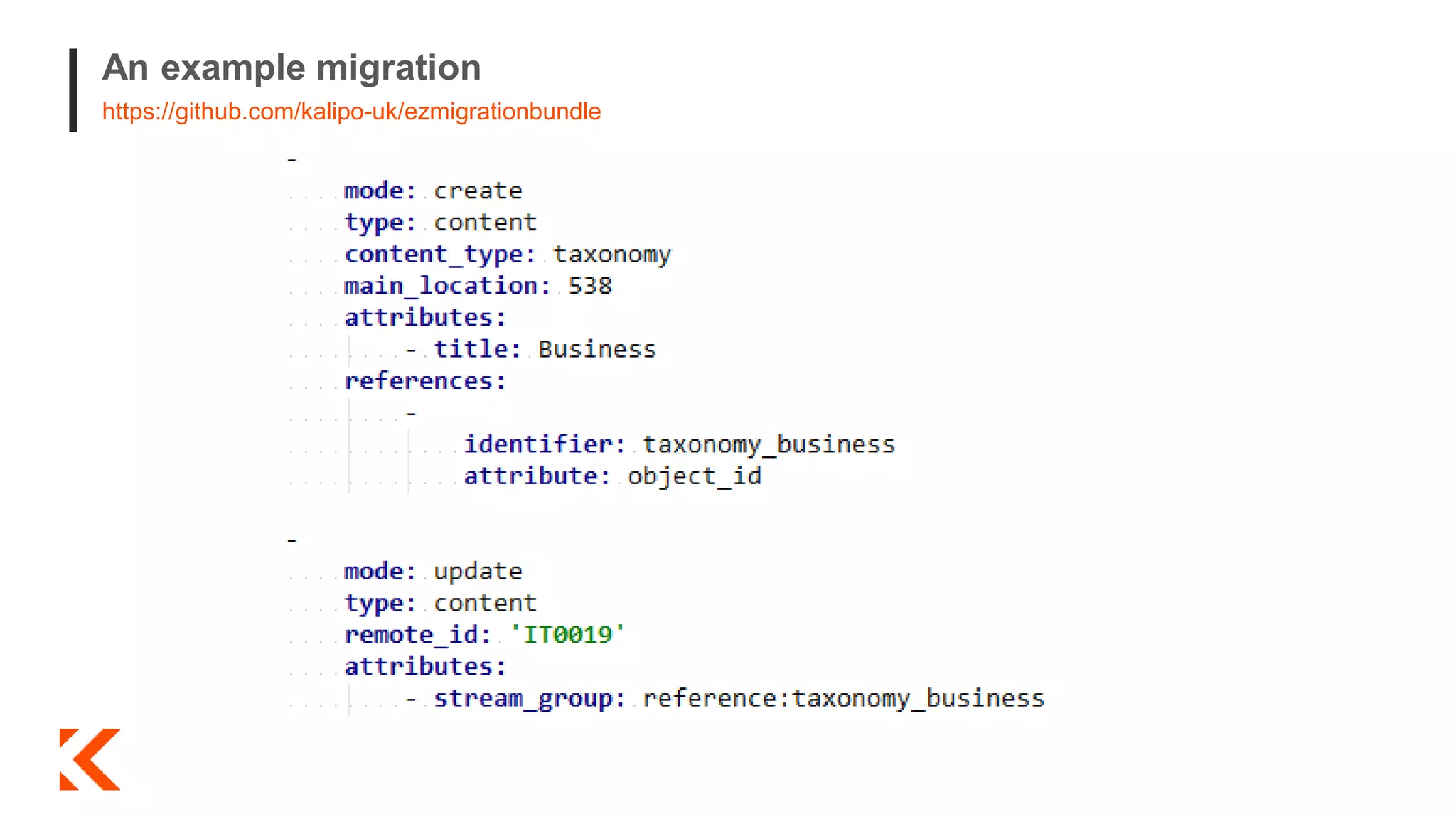

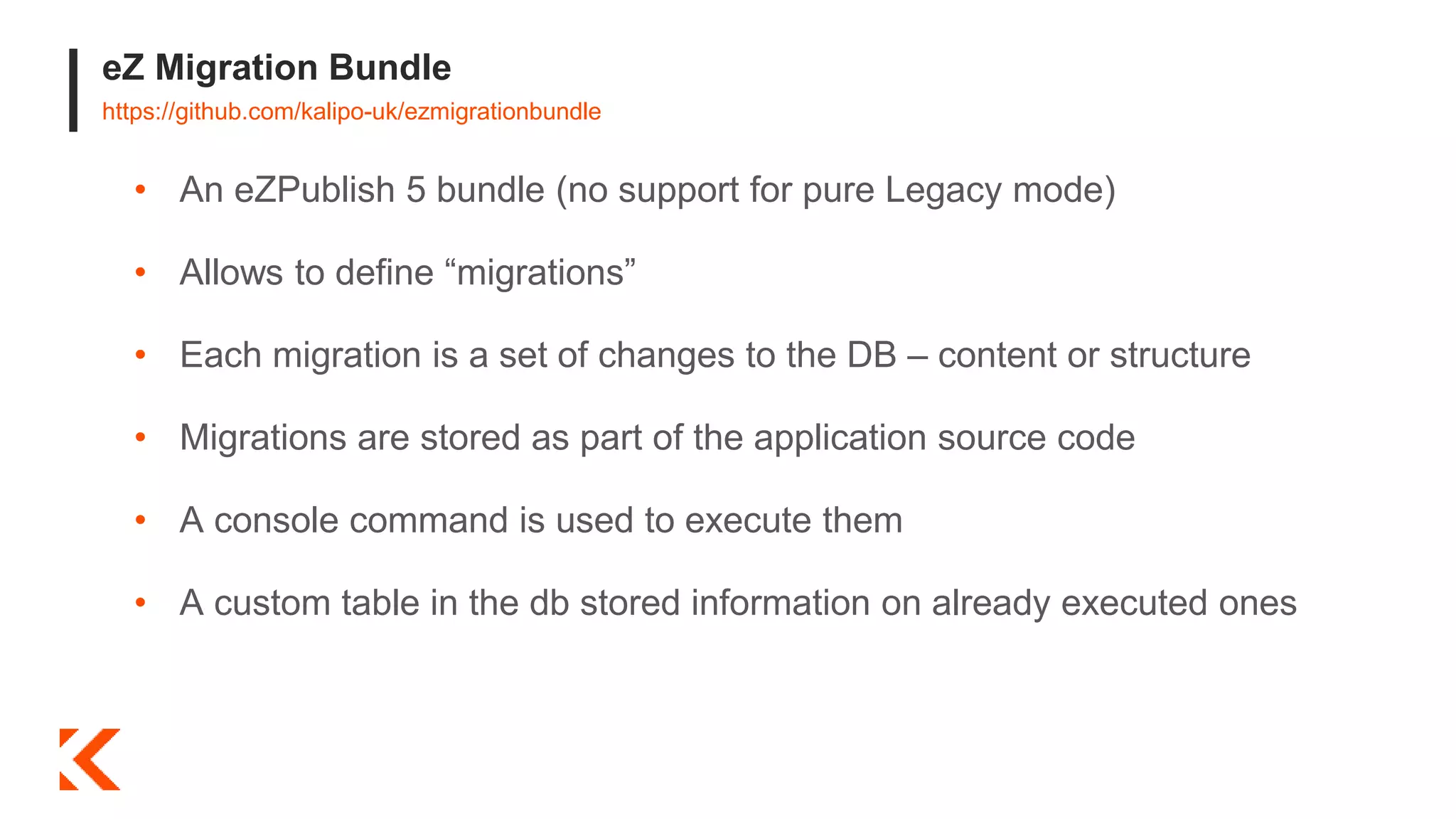

30. eZ Migration Bundle
https://github.com/kalipo-uk/ezmigrationbundle
• An eZPublish 5 bundle (no support for pure Legacy mode)
• Allows to define “migrations”
• Each migration is a set of changes to the DB – content or structure
• Migrations are stored as part of the application source code
• A console command is used to execute them
• A custom table in the db stored information on already executed ones

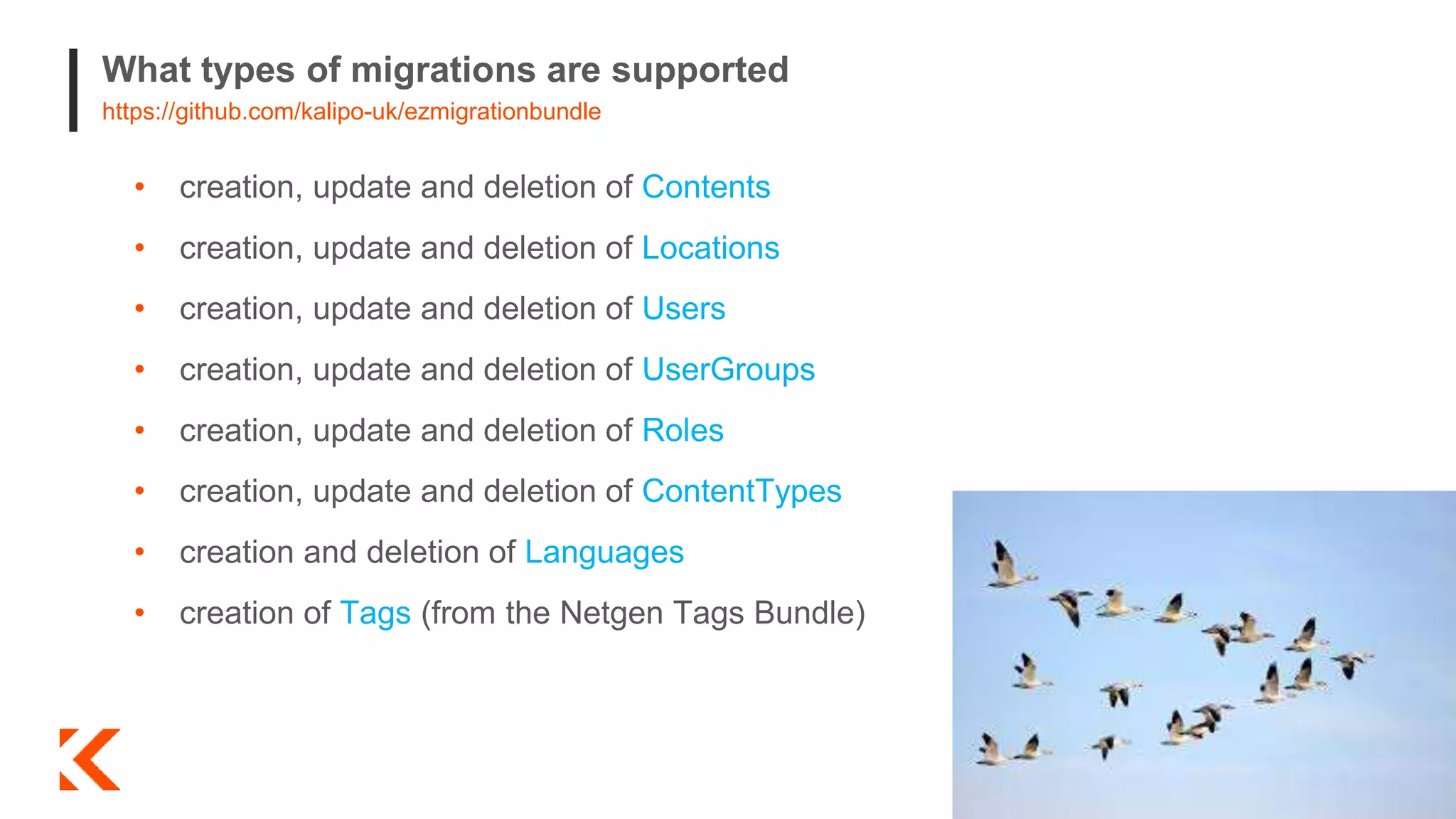

32. What types of migrations are supported
https://github.com/kalipo-uk/ezmigrationbundle
• creation, update and deletion of Contents
• creation, update and deletion of Locations
• creation, update and deletion of Users
• creation, update and deletion of UserGroups
• creation, update and deletion of Roles
• creation, update and deletion of ContentTypes
• creation and deletion of Languages
• creation of Tags (from the Netgen Tags Bundle)
34. Cool features II
https://github.com/kalipo-uk/ezmigrationbundle
• Supports ids, identifiers and remote-ids to match elements
• Supports the concept of ‘references’ to anything which has just been
created/updated
• Update and delete operations can affect a whole set of
elements in a single pass
35. Cool features III
https://github.com/kalipo-uk/ezmigrationbundle
For more complex needs, two types of custom migrations:
• SQL files
• PHP classes with a simple Interface
Fully extensible using standard Symfony mechanisms
• Event listeners
• Tagged services
• Service definition takeover
38. Version 3 released today!
https://github.com/kalipo-uk/ezmigrationbundle
If the demo effect does not strike now…
39. Is your favourite feature missing?
https://github.com/kalipo-uk/ezmigrationbundle
The first brick is laid, many scenarios are possible
ex: allow a full ETL process / migrate across eZ installations
Feature requests and Bugs are managed on Github
Pull Requests are welcome
(thanks Lolautruche!)
