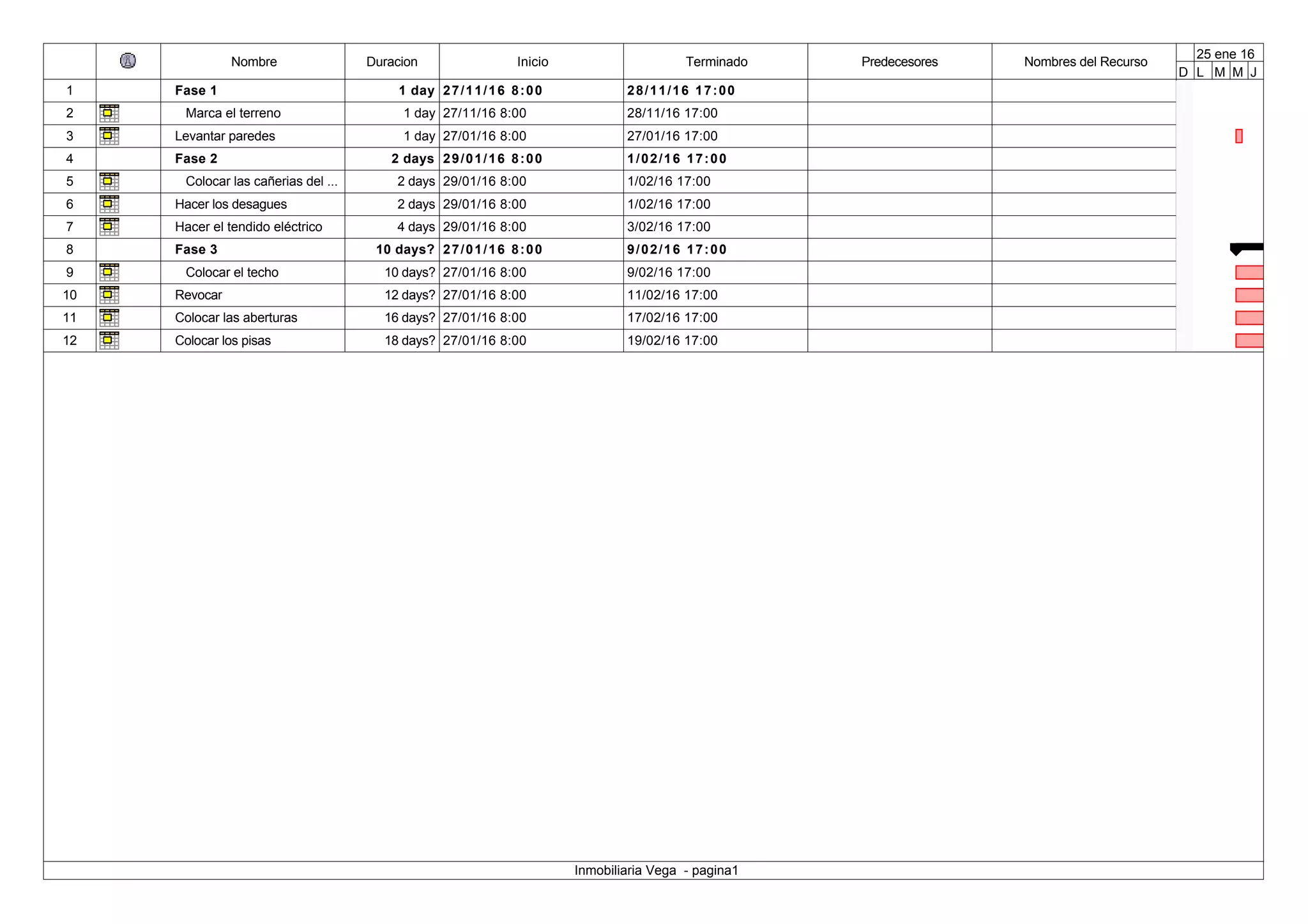

The document contains a schedule for the construction of a building broken into 12 phases with start and end dates. It lists each phase, its duration in days, start and end dates, any predecessor phases it depends on, and resources needed. The phases include laying the foundation, erecting walls, installing pipes, electrical work, roofing, plastering, installing doors and windows, and laying floors. The full schedule spans from November 2016 to February 2017.
