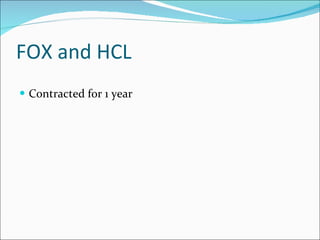

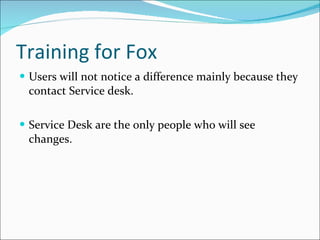

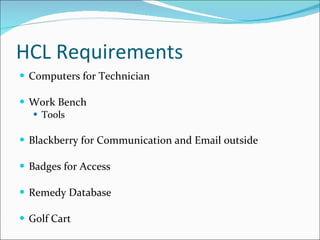

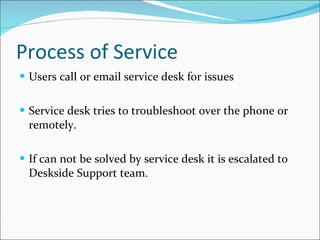

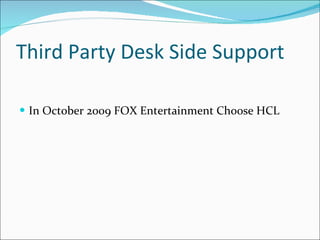

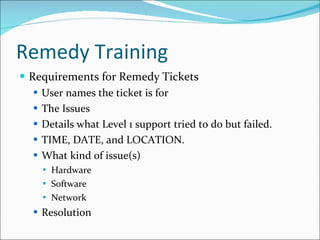

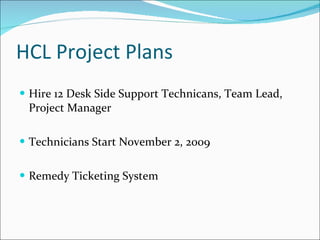

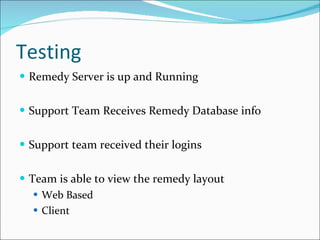

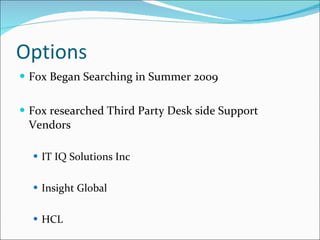

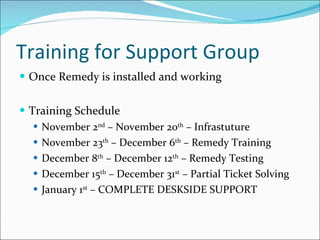

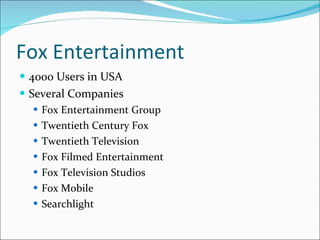

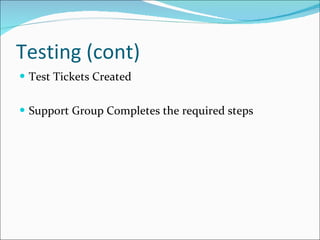

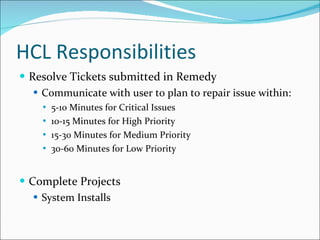

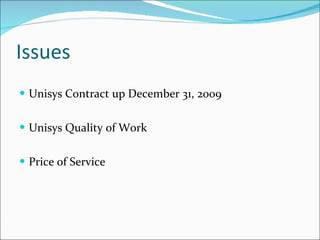

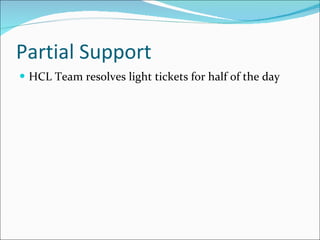

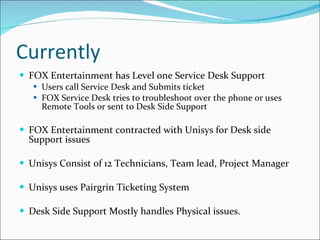

The document discusses Fox Entertainment's transition from using Unisys for deskside support to contracting with HCL. It outlines Fox's various divisions and user base, the issues with Unisys, Fox's search for a new vendor, and its selection of HCL. It then details HCL's plans to provide deskside support through a team of technicians using Remedy ticketing software starting in November 2009.
