Fixed Distributed Agile
The way to do it right!




Shlomi Otmazgin
Head of Java & Internet, Matrix Global

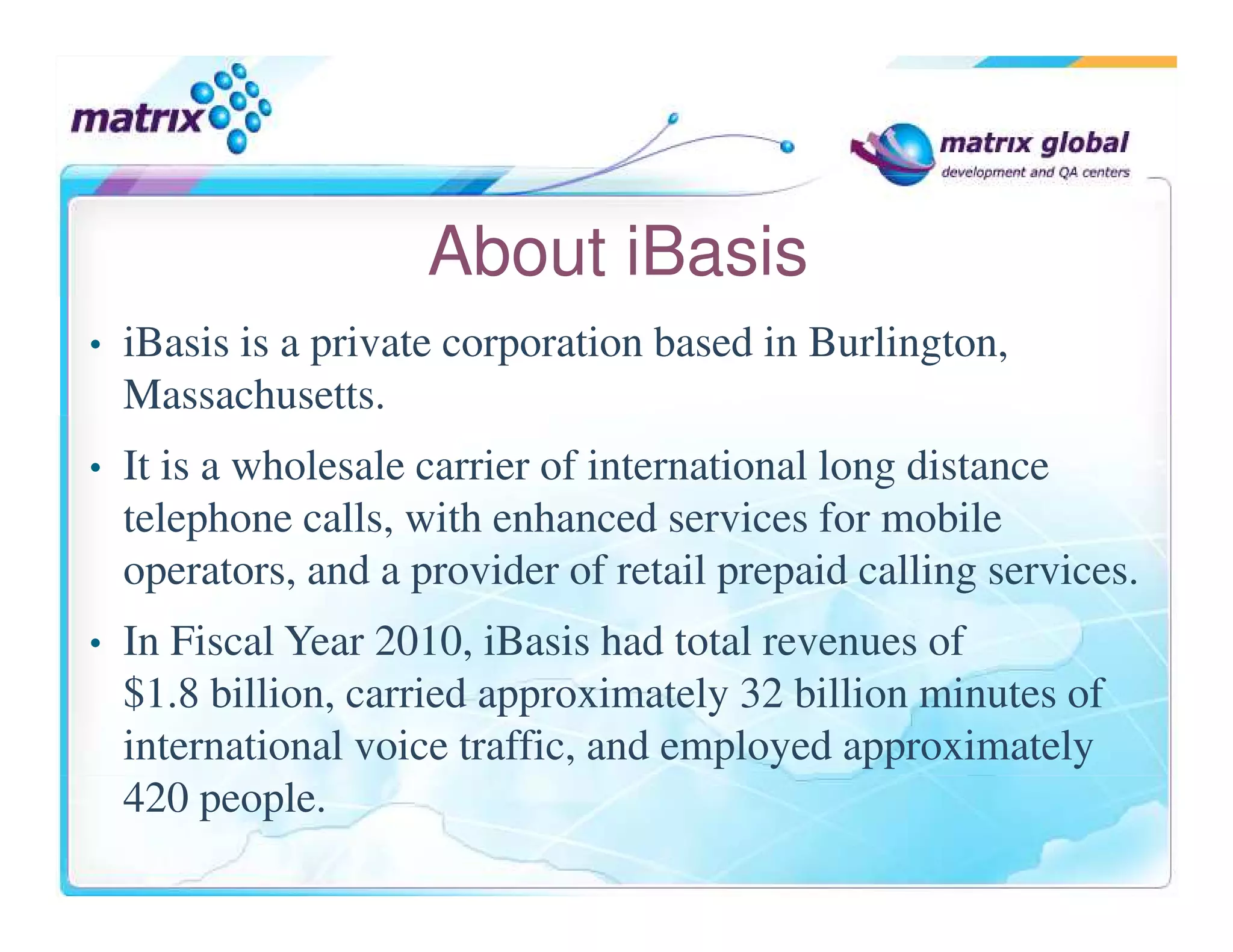

About iBasis
•   iBasis is a private corporation based in Burlington,
    Massachusetts.
•   It is a wholesale carrier of international long distance
    telephone calls, with enhanced services for mobile
    operators, and a provider of retail prepaid calling services.
•   In Fiscal Year 2010, iBasis had total revenues of
    $1.8 billion, carried approximately 32 billion minutes of
    international voice traffic, and employed approximately
    420 people.
Bilateral project
Bilateral system connects between iBasis clients &
 vendors that don’t share any commercial
 relationship, or are able to find better rates with
 iBasis, for example:




                       Bilateral
Building the team
The team structure:
  •   1 Project Manager
       »   Development Team
                1 Senior Java Developer
                4 junior Java developers
       »   QA team
                1 QA team leader
                2 QA testers
Choosing the Frameworks
Supports MVC Model.
Written in Java 6 upon eclipse.
All HTTP calls are pure Ajax.
Uses ExtJS to draw RIA.
Uses DWR engine to allow simple asynchronous server-client data transfer.
ORM by Hibernate annotations to Oracle 10 DB.
Object initialization by Spring IoC & Spring Injection.
Automated testing by JUnit 4.
Logging support by Log4j.
Reports support using JXL for Excel & iText for PDF.
Build by Maven 2 & deployed on Tomcat 6 using Hudson.
Cross browser application.
Screen shots
Desktop environment
   A drag & drop resizable windows environment.
   Clean, rich, fast, flexible & very intuitive.


Smart search screens
   Auto complete paginated combo boxes.
   All actions are very fast using Ajax.
Go!
1.   Project manager was recruited.
2.   Senior developer and junior developers recruited (by project manager).
3.   Project manager traveled to customer (2 weeks):
     •   Learned the current system.
     •   Wrote HLD & SDD.
     •   Review and authorization of above.
4.   In parallel – developers trained in relevant technologies.
5.   Development begins within one month.
     •   First release on schedule - after 4 months.
     •   Second release (iterative) - after 3 months.
     •   Third release - no travel - after 3 months.
Fixed Distributed Agile
               Step 1 – HLD & SDD     With no estimations!


•   Write the HLD & SDD to the whole project.
•   Build the product backlog.
•   Was done at the client’s site.


     Duration: 1-2 weeks
Fixed Distributed Agile
                       Step 2 - Artifacts
•   Meet the team and held ALL the sprint planning meetings
    one after the other.
•   Get the precise estimations for each task
    using scrum poker cards.
•   Build the sprint backlogs for the entire project.
•   Add 15%-20% time as a fix project safety net – WHY?
•   The team members pick the tasks & the team leader build
    the project gantt.         Duration: 1 week
Fixed Distributed Agile
                  Step 3 – SOW


•   With accurate estimation for the whole project
    write the SOW.
•   Negotiate the estimations with the client & get
    the final approval.
                   Duration: 1 day
Fixed Distributed Agile
                   Step 4 – Work begins!
•   Work begins with a daily stand up meeting.
•   Weekly meeting with the client to review the progress &
    solve open questions.
•   After each sprint (3-4 weeks) – sprint review meeting with
    the client.
•   Retrospective team meetings from current sprint for the
    next ones.
•   1 week max for client’s sprint review.
Fixed Distributed Agile
                 Step 5 – The Finish Line
   •   Release the final version after 4 months & 5 sprints.
   •   Because of 15%-20% extra time the CR’s along the
       way languish into the initial specifications.


1 week max for client’s sprint review.
The Agile Aspect

The client is aware of the team status on a daily basis.
He MUST review the project status on each of every sprint.
The client can notice misunderstandings or can just modify
 the design while developing to suit his will, up to a certain
 level – huh?!?.
Development is very flexible because changes are made in
 an early stage thus rewriting is an easy effort.
The Agile Aspect

Product & design change along with development to create
  a product that is suitable to client’s expectations.
If CR is too big we usually postpone it to the next phase.
Use of scrum concepts as: stand up/weekly/sprint meetings,
 product backlog scrum poker cards, XP.


       There are 0 “bad surprises” on delivery – UAT
Scary? Don’t call it Agile!
                Typical Agile reactions
•   Low ceiling for new ideas - the angry monkey
    experiment.
•   Our product/structure/management is too complex for
    Agile.
•   We started and than backed off.
     o   Was your client/management/colleague devoted?
•   I do want but I can’t get my manager’s approval.
•   I don’t know where to start!
Scary? Don’t call it Agile!

1.   Start using agile without shouting it.
2.   Use what fits you.
3.   Go for quick wins.
4.   When showing your managers it helps you, talk about
     ROI (it makes them feel cozy…)
5.   Add more & more Agile routines to the team.
6.   One day you’ll wake up with an Agile sleeping next to
     you :-)
Finally,
 we must remember that our
mail goal was & always will be

    Adjusting to our client
        expectations
Even if they seem odd…
Q&A
Thanks

Fixed distributed agile

  • 1.
    Fixed Distributed Agile Theway to do it right! Shlomi Otmazgin Head of Java & Internet, Matrix Global
  • 2.
    About iBasis • iBasis is a private corporation based in Burlington, Massachusetts. • It is a wholesale carrier of international long distance telephone calls, with enhanced services for mobile operators, and a provider of retail prepaid calling services. • In Fiscal Year 2010, iBasis had total revenues of $1.8 billion, carried approximately 32 billion minutes of international voice traffic, and employed approximately 420 people.
  • 3.
    Bilateral project Bilateral systemconnects between iBasis clients & vendors that don’t share any commercial relationship, or are able to find better rates with iBasis, for example: Bilateral
  • 4.
    Building the team Theteam structure: • 1 Project Manager » Development Team 1 Senior Java Developer 4 junior Java developers » QA team 1 QA team leader 2 QA testers
  • 5.
    Choosing the Frameworks SupportsMVC Model. Written in Java 6 upon eclipse. All HTTP calls are pure Ajax. Uses ExtJS to draw RIA. Uses DWR engine to allow simple asynchronous server-client data transfer. ORM by Hibernate annotations to Oracle 10 DB. Object initialization by Spring IoC & Spring Injection. Automated testing by JUnit 4. Logging support by Log4j. Reports support using JXL for Excel & iText for PDF. Build by Maven 2 & deployed on Tomcat 6 using Hudson. Cross browser application.
  • 6.
    Screen shots Desktop environment A drag & drop resizable windows environment. Clean, rich, fast, flexible & very intuitive. Smart search screens Auto complete paginated combo boxes. All actions are very fast using Ajax.
  • 7.
    Go! 1. Project manager was recruited. 2. Senior developer and junior developers recruited (by project manager). 3. Project manager traveled to customer (2 weeks): • Learned the current system. • Wrote HLD & SDD. • Review and authorization of above. 4. In parallel – developers trained in relevant technologies. 5. Development begins within one month. • First release on schedule - after 4 months. • Second release (iterative) - after 3 months. • Third release - no travel - after 3 months.
  • 8.
    Fixed Distributed Agile Step 1 – HLD & SDD With no estimations! • Write the HLD & SDD to the whole project. • Build the product backlog. • Was done at the client’s site. Duration: 1-2 weeks
  • 9.
    Fixed Distributed Agile Step 2 - Artifacts • Meet the team and held ALL the sprint planning meetings one after the other. • Get the precise estimations for each task using scrum poker cards. • Build the sprint backlogs for the entire project. • Add 15%-20% time as a fix project safety net – WHY? • The team members pick the tasks & the team leader build the project gantt. Duration: 1 week
  • 10.
    Fixed Distributed Agile Step 3 – SOW • With accurate estimation for the whole project write the SOW. • Negotiate the estimations with the client & get the final approval. Duration: 1 day
  • 11.
    Fixed Distributed Agile Step 4 – Work begins! • Work begins with a daily stand up meeting. • Weekly meeting with the client to review the progress & solve open questions. • After each sprint (3-4 weeks) – sprint review meeting with the client. • Retrospective team meetings from current sprint for the next ones. • 1 week max for client’s sprint review.
  • 12.
    Fixed Distributed Agile Step 5 – The Finish Line • Release the final version after 4 months & 5 sprints. • Because of 15%-20% extra time the CR’s along the way languish into the initial specifications. 1 week max for client’s sprint review.
  • 13.
    The Agile Aspect Theclient is aware of the team status on a daily basis. He MUST review the project status on each of every sprint. The client can notice misunderstandings or can just modify the design while developing to suit his will, up to a certain level – huh?!?. Development is very flexible because changes are made in an early stage thus rewriting is an easy effort.
  • 14.
    The Agile Aspect Product& design change along with development to create a product that is suitable to client’s expectations. If CR is too big we usually postpone it to the next phase. Use of scrum concepts as: stand up/weekly/sprint meetings, product backlog scrum poker cards, XP. There are 0 “bad surprises” on delivery – UAT
  • 15.
    Scary? Don’t callit Agile! Typical Agile reactions • Low ceiling for new ideas - the angry monkey experiment. • Our product/structure/management is too complex for Agile. • We started and than backed off. o Was your client/management/colleague devoted? • I do want but I can’t get my manager’s approval. • I don’t know where to start!
  • 16.
    Scary? Don’t callit Agile! 1. Start using agile without shouting it. 2. Use what fits you. 3. Go for quick wins. 4. When showing your managers it helps you, talk about ROI (it makes them feel cozy…) 5. Add more & more Agile routines to the team. 6. One day you’ll wake up with an Agile sleeping next to you :-)
  • 17.
    Finally, we mustremember that our mail goal was & always will be Adjusting to our client expectations
  • 18.
    Even if theyseem odd…
  • 19.
  • 20.
