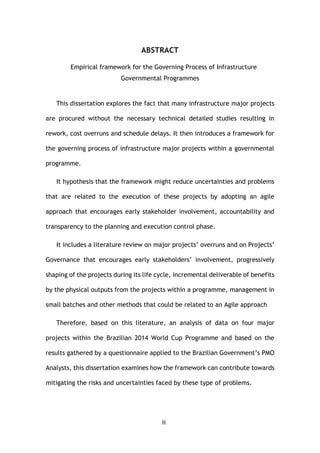

This document provides a 9989-word dissertation submitted in partial fulfillment of a Master of Science in Major Programme Management. The dissertation explores creating a framework to govern infrastructure projects procured without necessary studies, which can cause cost overruns and delays. It analyzes data from four major projects in Brazil's 2014 World Cup program and a questionnaire of Brazilian government project managers. The goal is to determine if adopting an agile approach with early stakeholder involvement can reduce risks and uncertainties for projects procured without full construction designs. The framework is based on literature about project overruns and governance encouraging stakeholder involvement and benefits delivery in smaller batches like agile methods.
