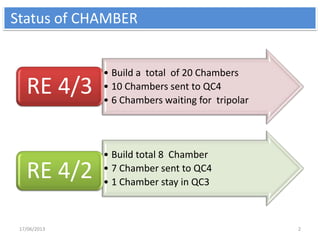

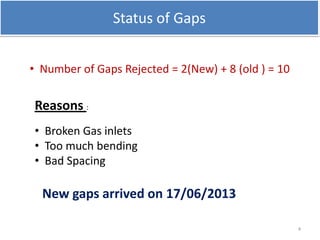

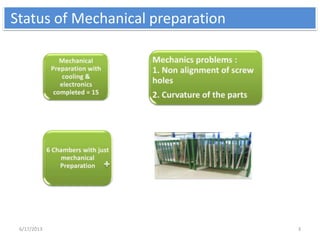

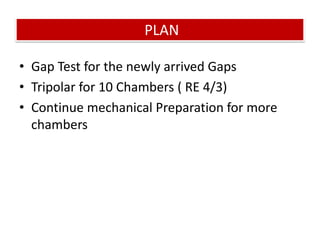

The document summarizes the status of chamber production at CERN 904. It reports that 20 chambers have been built for RE 4/2, with 10 sent to QC4 and 6 waiting for tripolar installation. For RE 4/3, 8 chambers have been built total, with 7 sent to QC4 and 1 remaining in QC3. It also notes that mechanical preparations are ongoing, with 10 gaps rejected due to issues like broken gas inlets or bending, and new gaps having arrived on June 17th.
