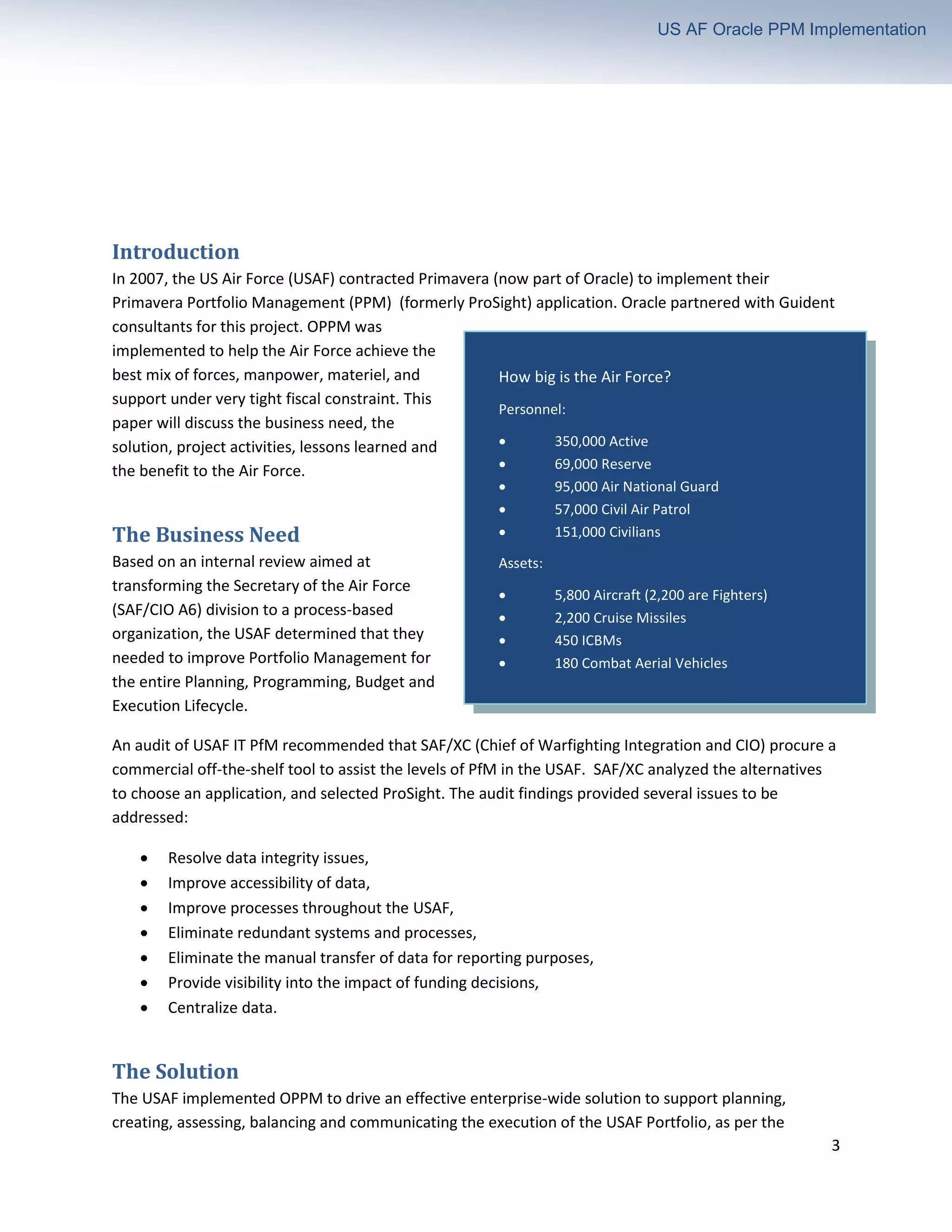

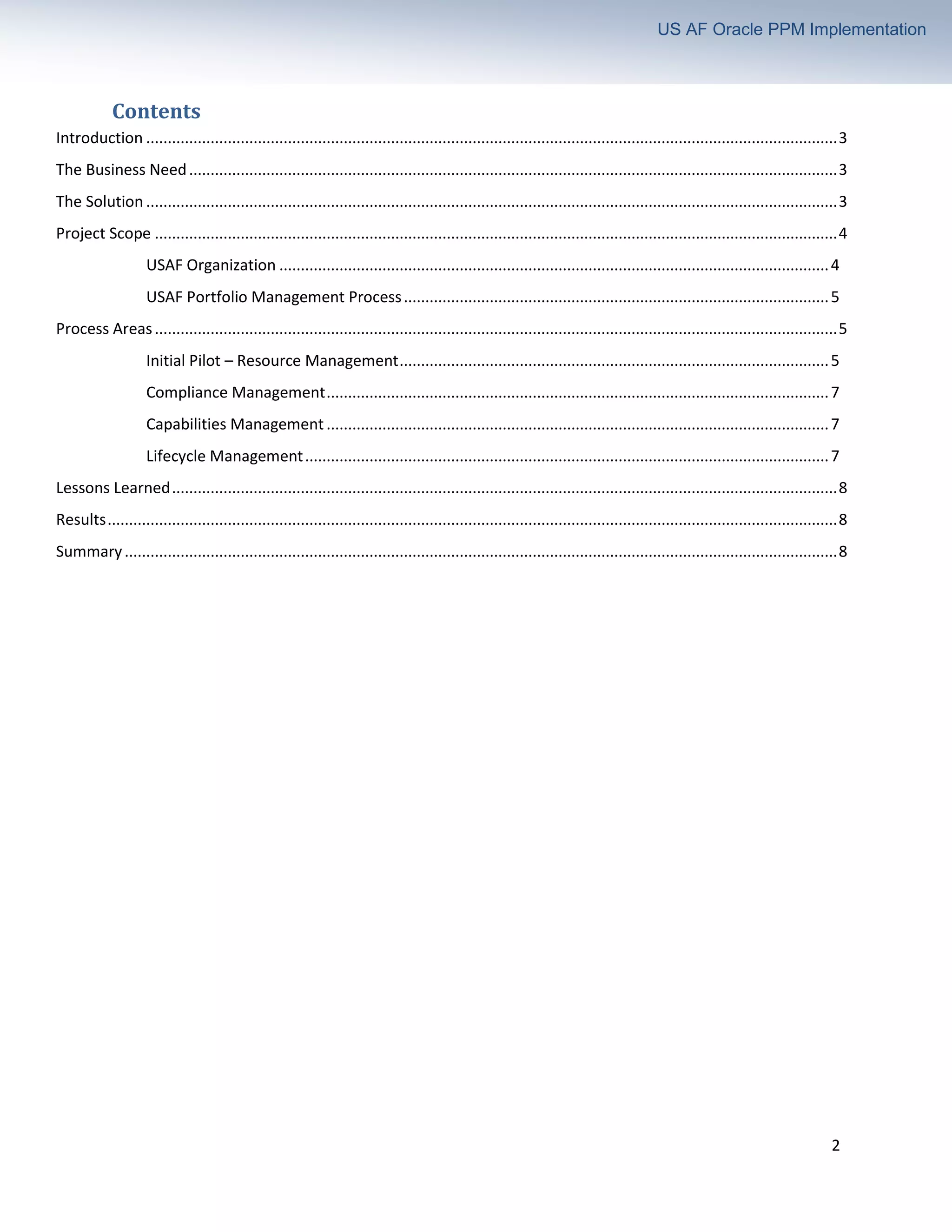

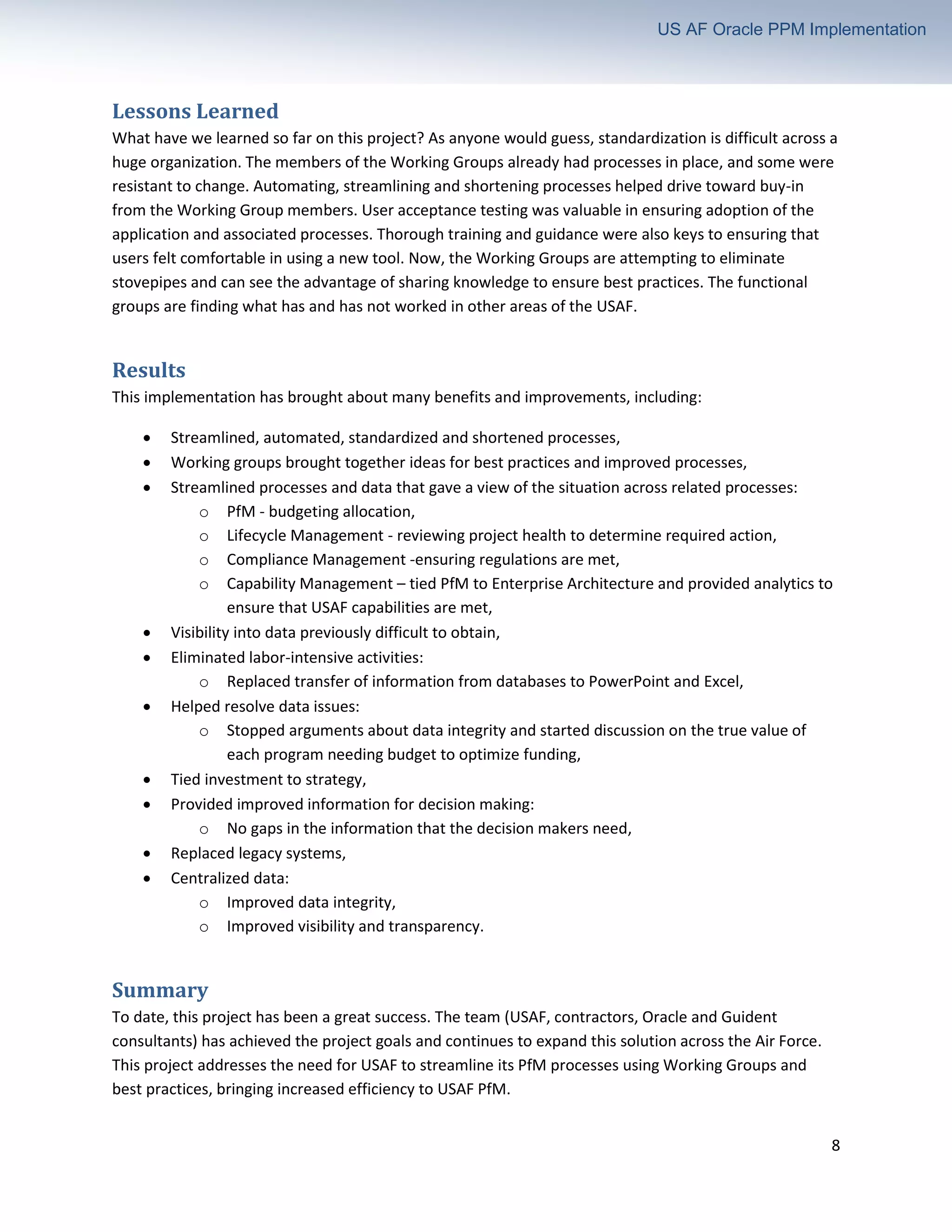

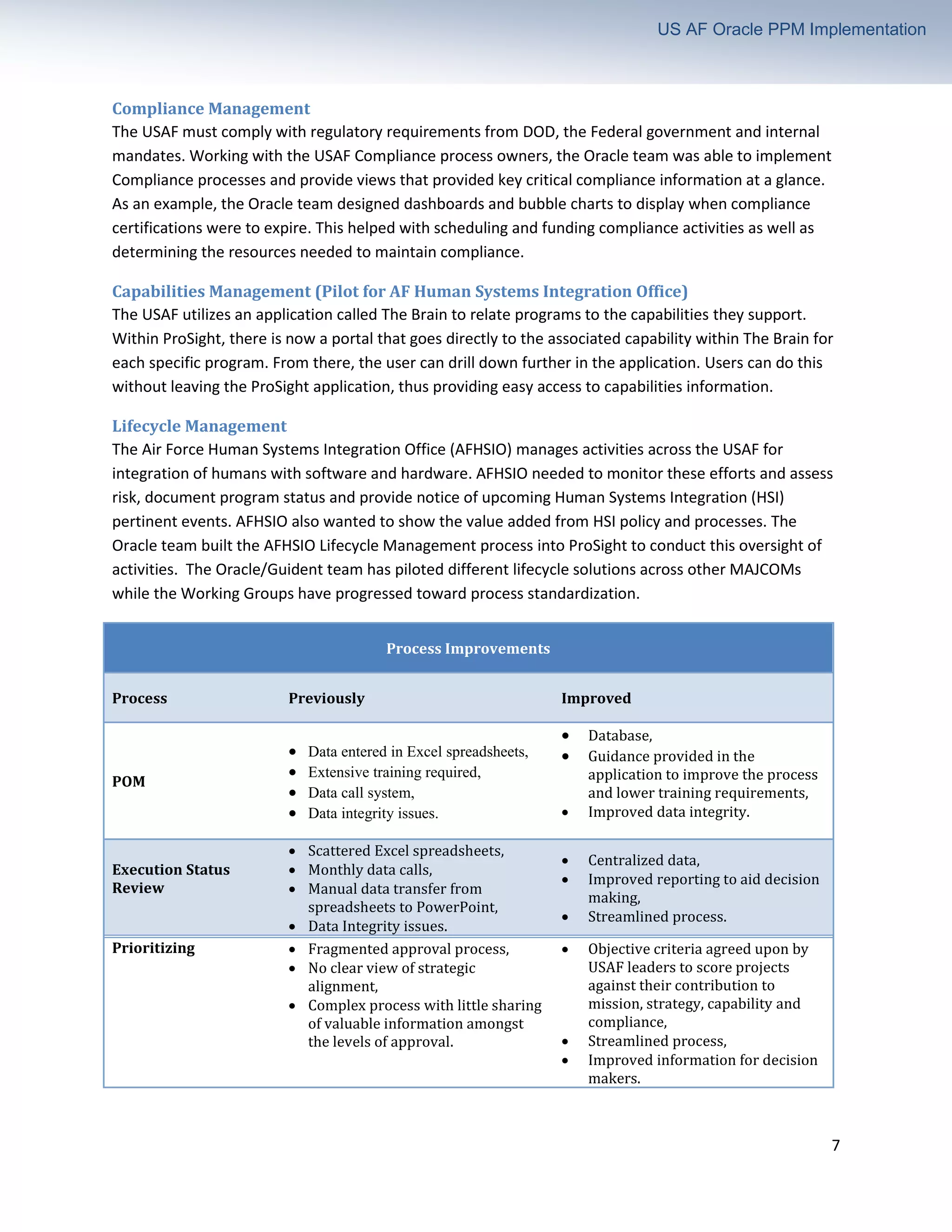

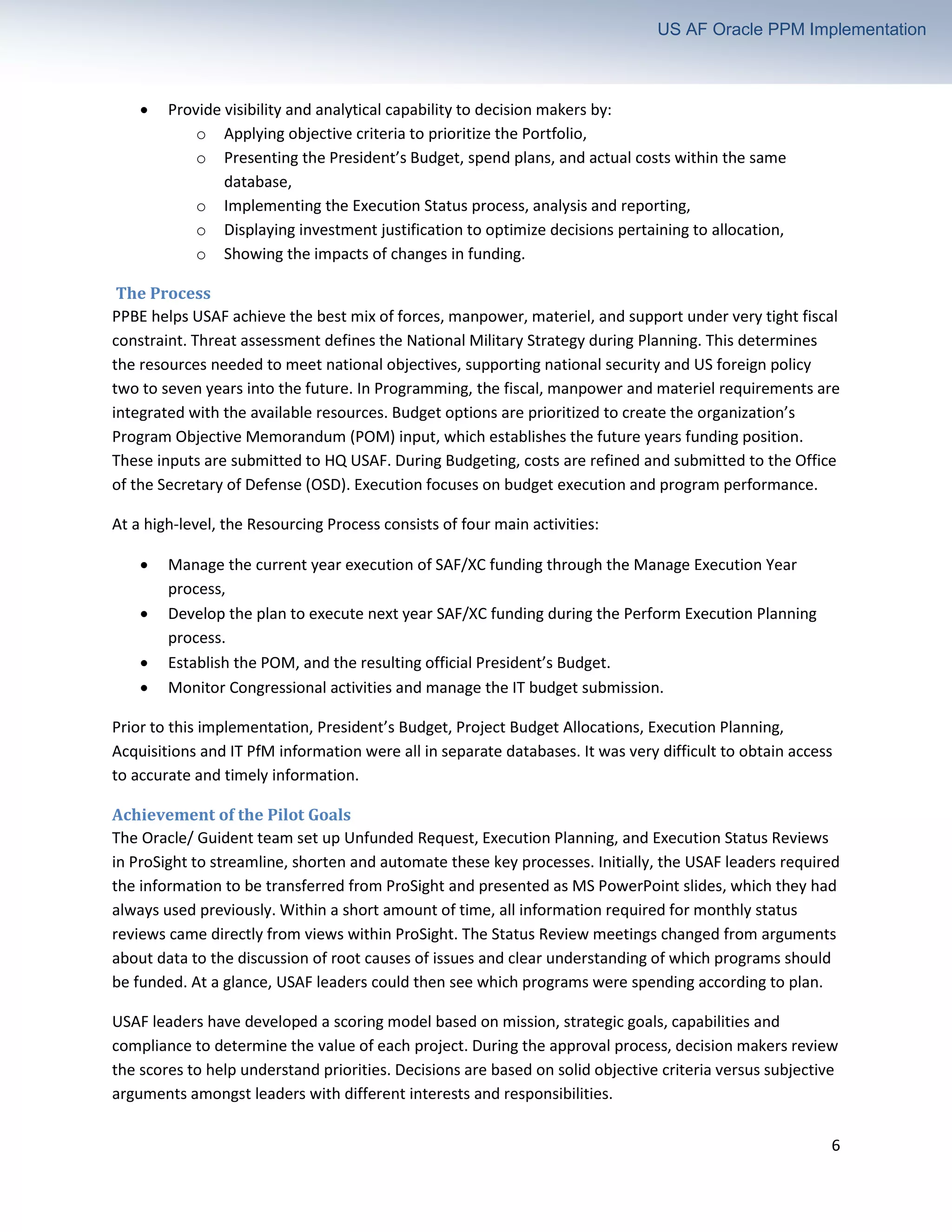

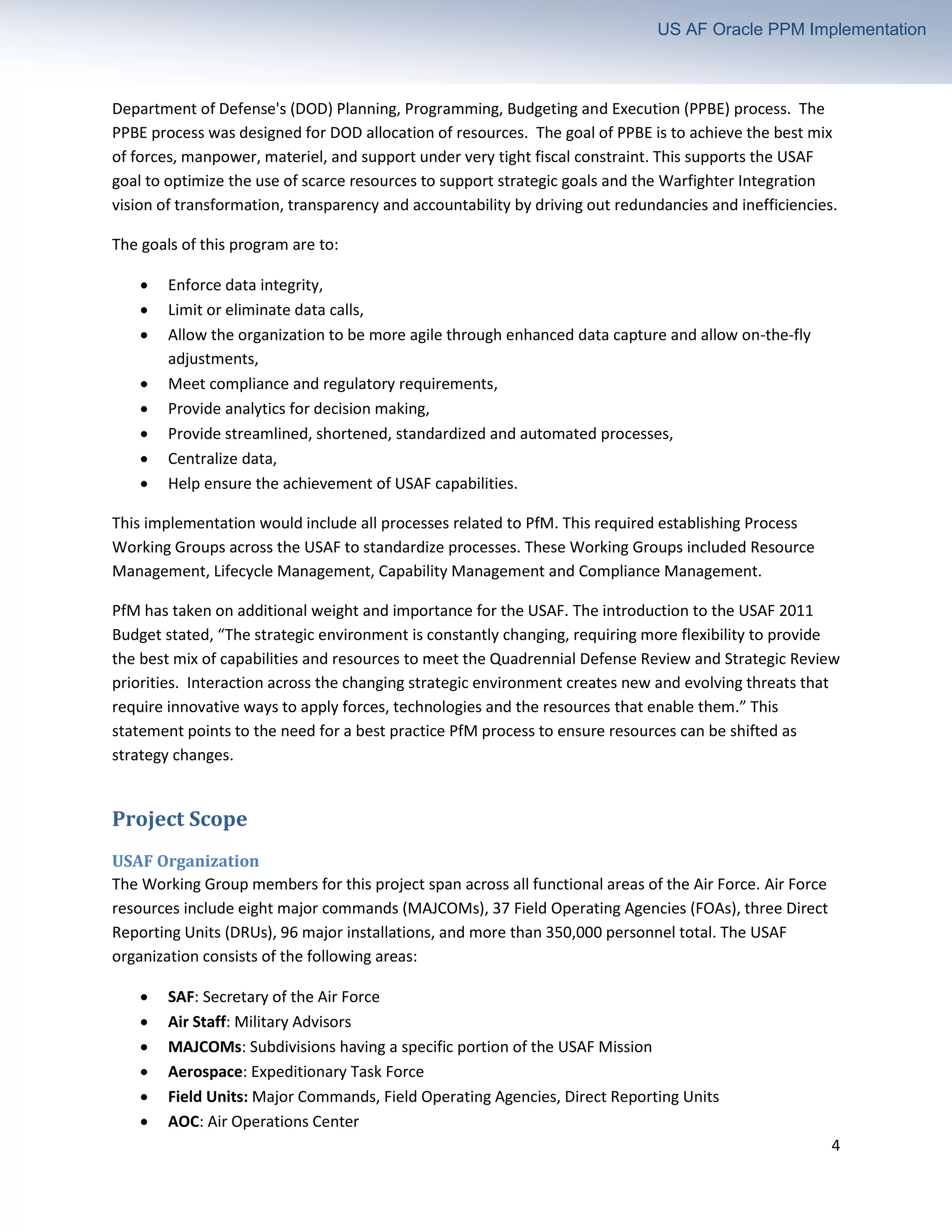

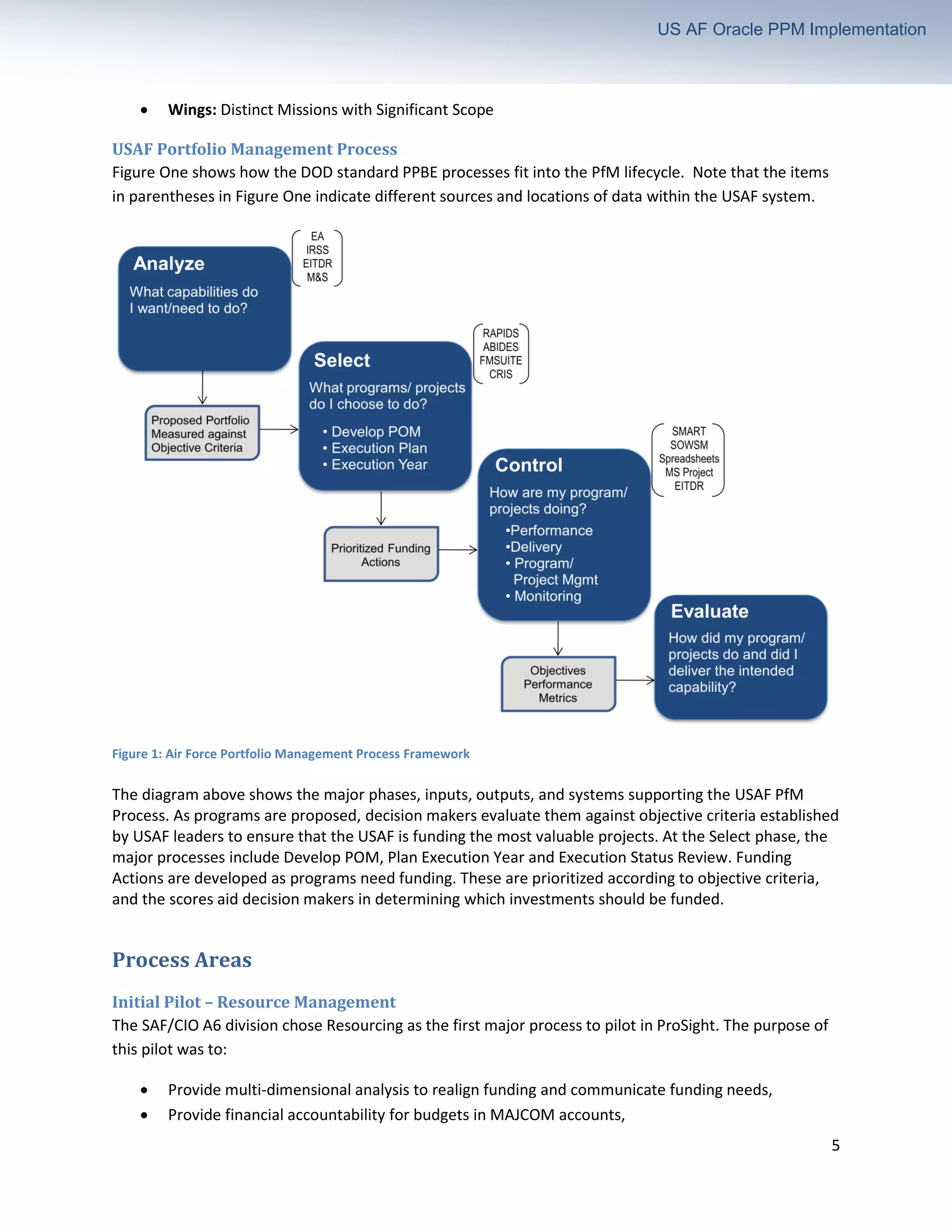

The document outlines the U.S. Air Force's implementation of an Oracle Primavera Portfolio Management (PPM) solution initiated in 2007 to enhance portfolio management across the organization under tight fiscal constraints. It discusses the business need for improved data integrity, process standardization, and compliance management, along with insights on the project's scope, implementation processes, lessons learned, and the results achieved. Ultimately, the implementation aims to streamline processes, improve decision-making capabilities, and enhance the overall efficiency of the U.S. Air Force's planning, programming, budgeting, and execution lifecycle.
