Mecklenburg County Public Schools
2009 Annual Report to the School Board
Comprehensive Technology Plan 2003-2009
(Includes Required Update and Alignment Reports)
2009-2010: Vision, Review, Plans and Projections

            Company
            LOGO

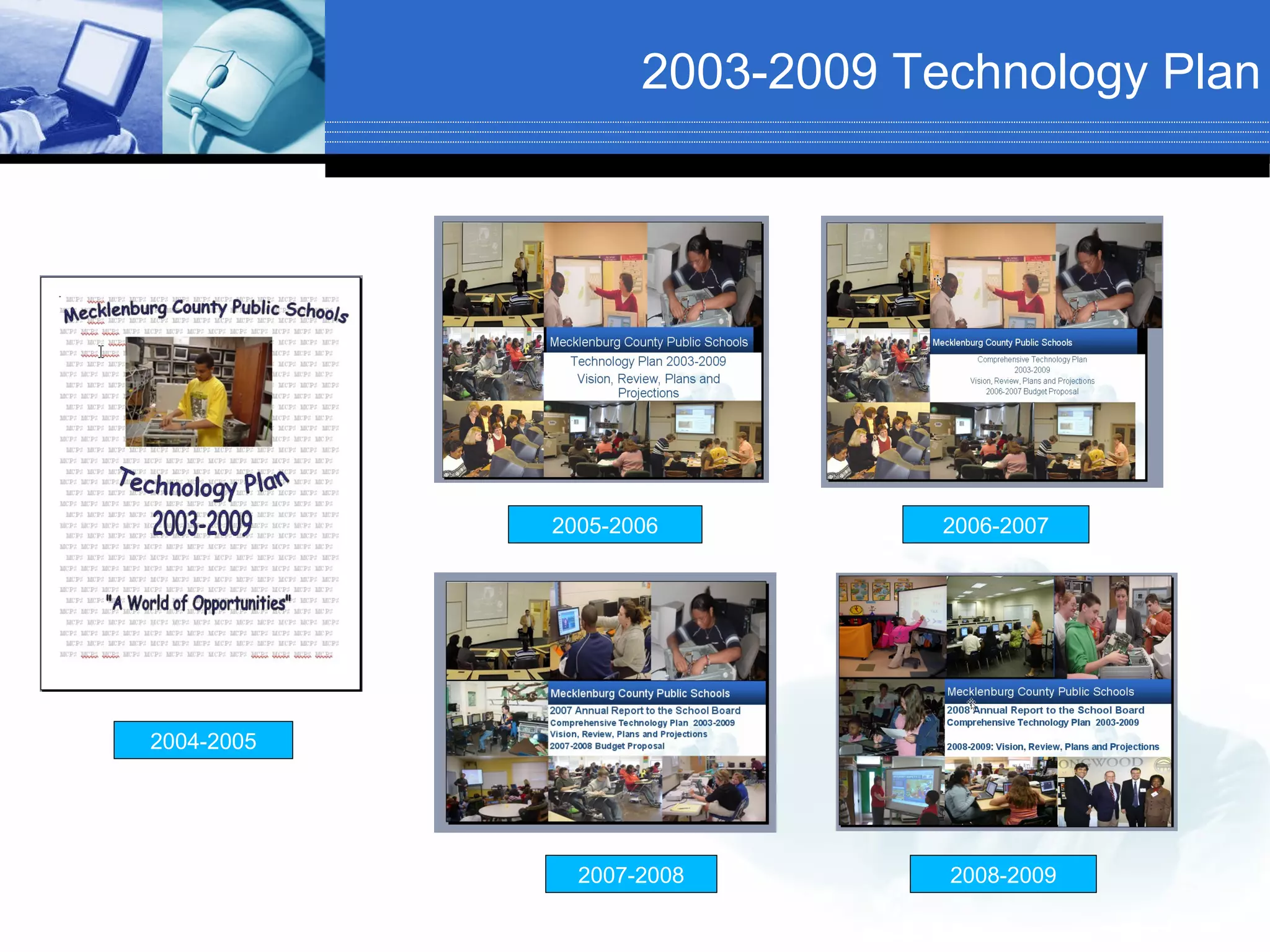

2003-2009 Technology Plan

            2005-2006          2006-2007

2004-2005

              2007-2008        2008-2009
Technology Plan 2009-2010

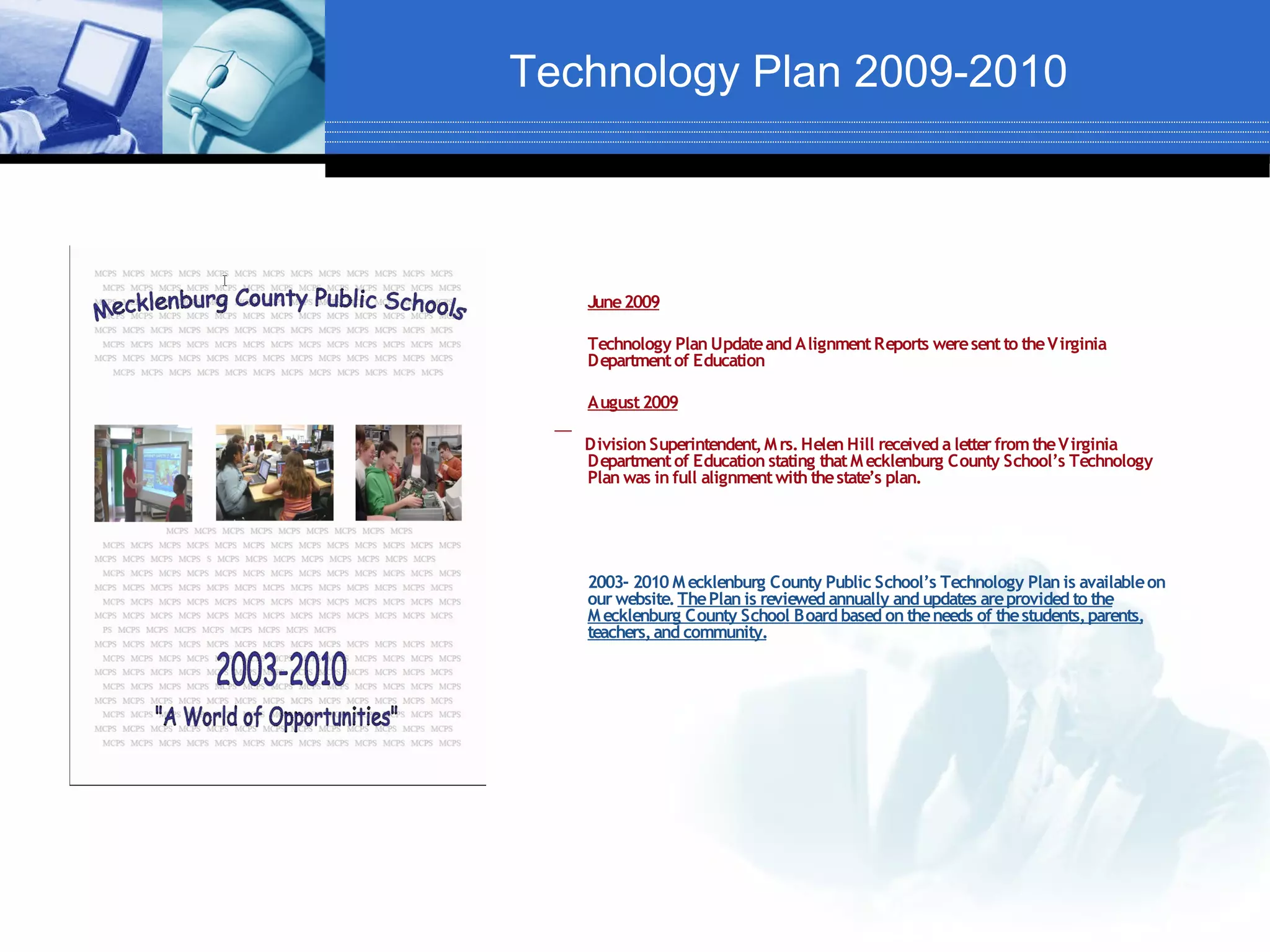

   June 2009

   Technology Plan Update and Alignment Reports were sent to the Virginia
   Department of Education

   August 2009

   Division Superintendent, M rs. Helen Hill received a letter from the Virginia
   Department of Education stating that M ecklenburg County School’s Technology
   Plan was in full alignment with the state’s plan.

   2003- 2010 M ecklenburg County Public School’s Technology Plan is available on
   our website. The Plan is reviewed annually and updates are provided to the
   M ecklenburg County School Board based on the needs of the students, parents,
   teachers, and community.
2003-2010 Technology Integration Plan of Action

      1. 2008 - 2009 Status Report

2. 2009 - 2010 Plan of Action

3. 2010 - 2011 New State and Local Plan Alignment
INSTRUCTIONAL AND
ADMINISTRATIVE TECHNOLOGY

   2008-2009

   Company
   LOGO
2008-2009 Instructional and Administrative
                                        Technology

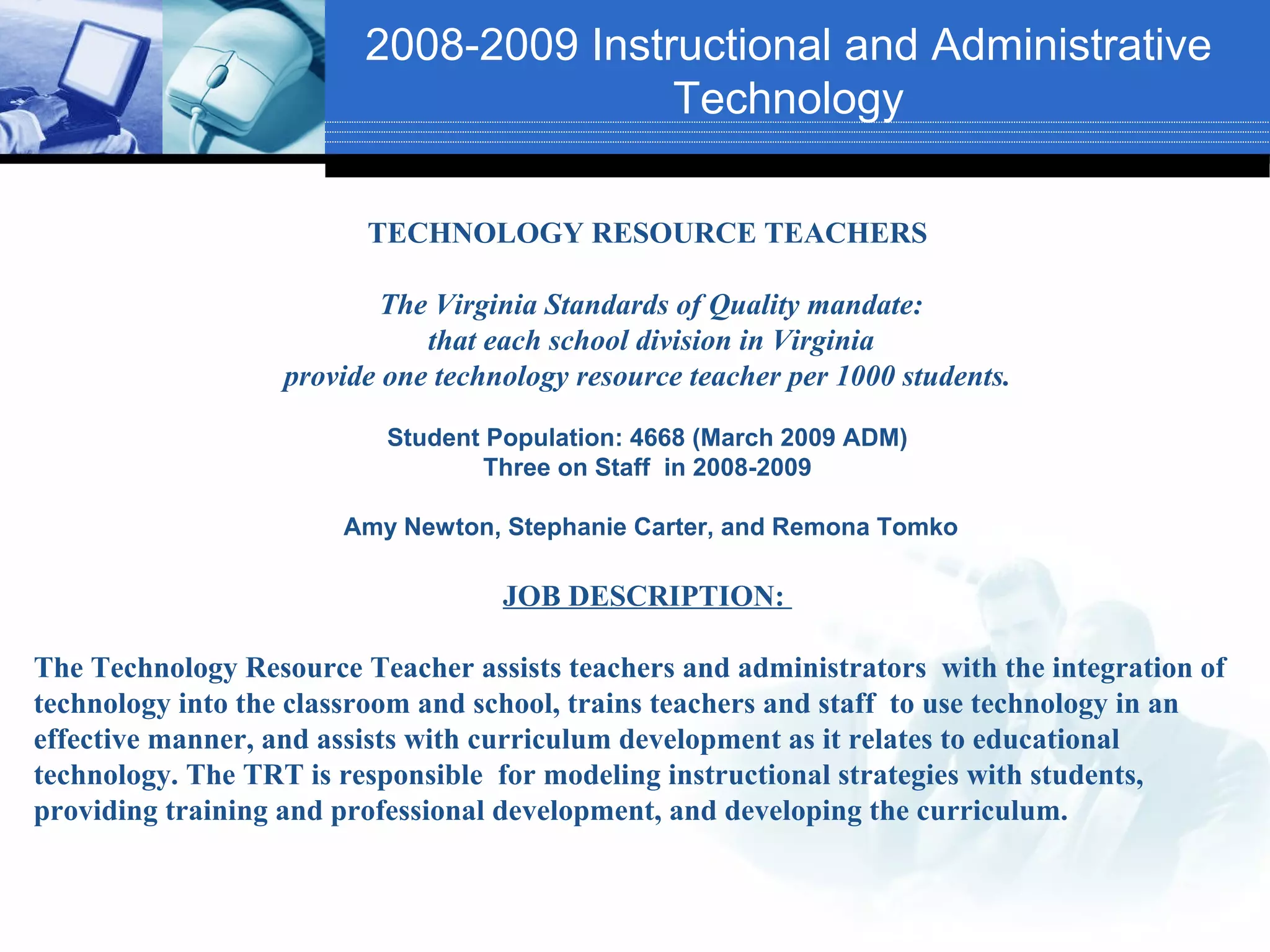

                         TECHNOLOGY RESOURCE TEACHERS

                           The Virginia Standards of Quality mandate:
                              that each school division in Virginia
                   provide one technology resource teacher per 1000 students.

                           Student Population: 4668 (March 2009 ADM)
                                   Three on Staff in 2008-2009

                       Amy Newton, Stephanie Carter, and Remona Tomko

                                    JOB DESCRIPTION:

The Technology Resource Teacher assists teachers and administrators with the integration of
technology into the classroom and school, trains teachers and staff to use technology in an
effective manner, and assists with curriculum development as it relates to educational
technology. The TRT is responsible for modeling instructional strategies with students,
providing training and professional development, and developing the curriculum.
2008-2009 Instructional and Administrative
                                        Technology

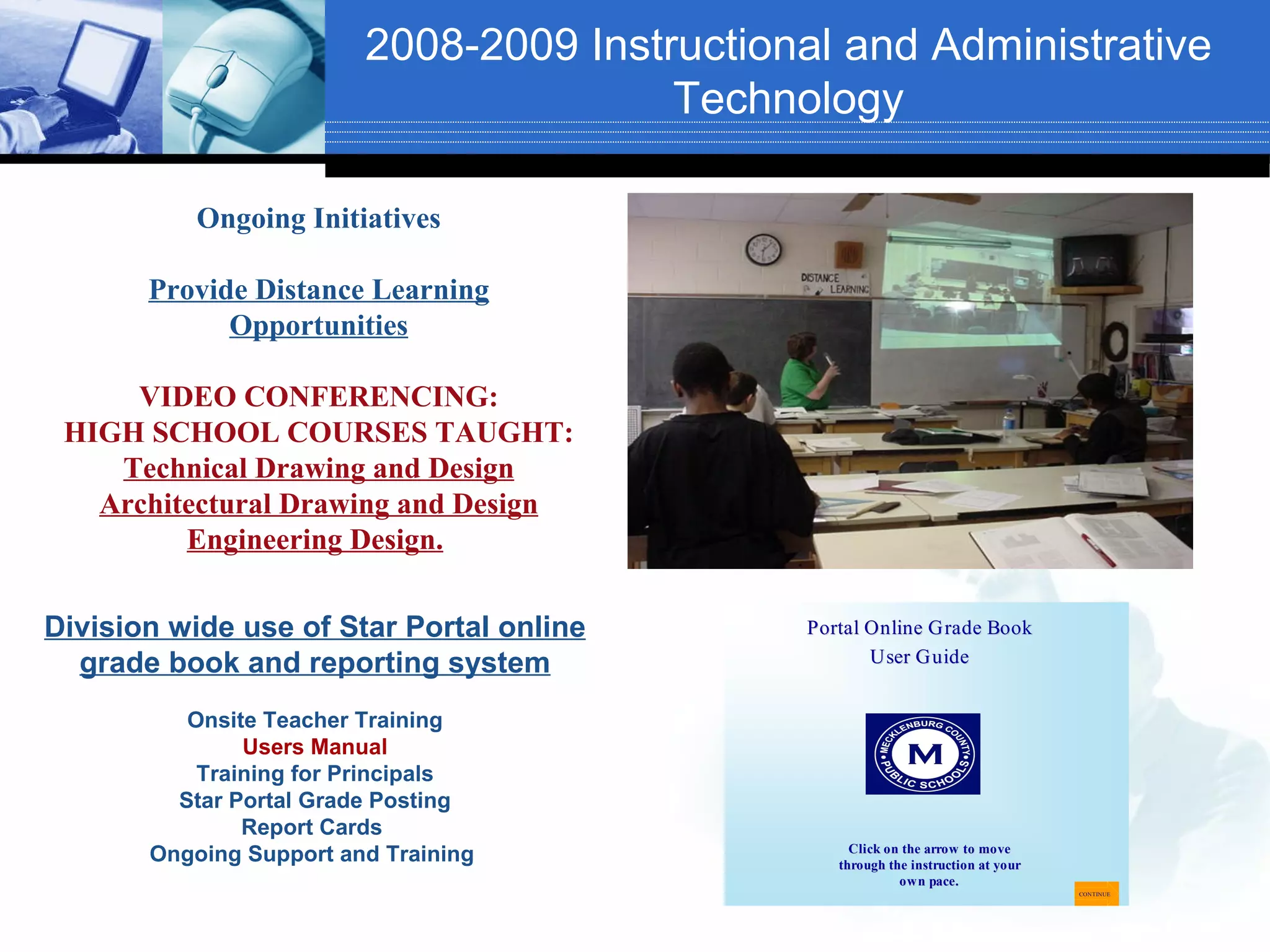

           Ongoing Initiatives

       Provide Distance Learning
             Opportunities

     VIDEO CONFERENCING:
 HIGH SCHOOL COURSES TAUGHT:
    Technical Drawing and Design
   Architectural Drawing and Design
         Engineering Design.

Division wide use of Star Portal online       Portal Online Grade Book
  grade book and reporting system                    User Guide

          Onsite Teacher Training
               Users Manual
           Training for Principals
         Star Portal Grade Posting
               Report Cards
                                                   Click on the arrow to move
       Ongoing Support and Training              through the instruction at your
                                                           own pace.
                                                                                   CONTINUE
2008-2009
                                   Instructional and Administrative Technology

           Ongoing Initiatives

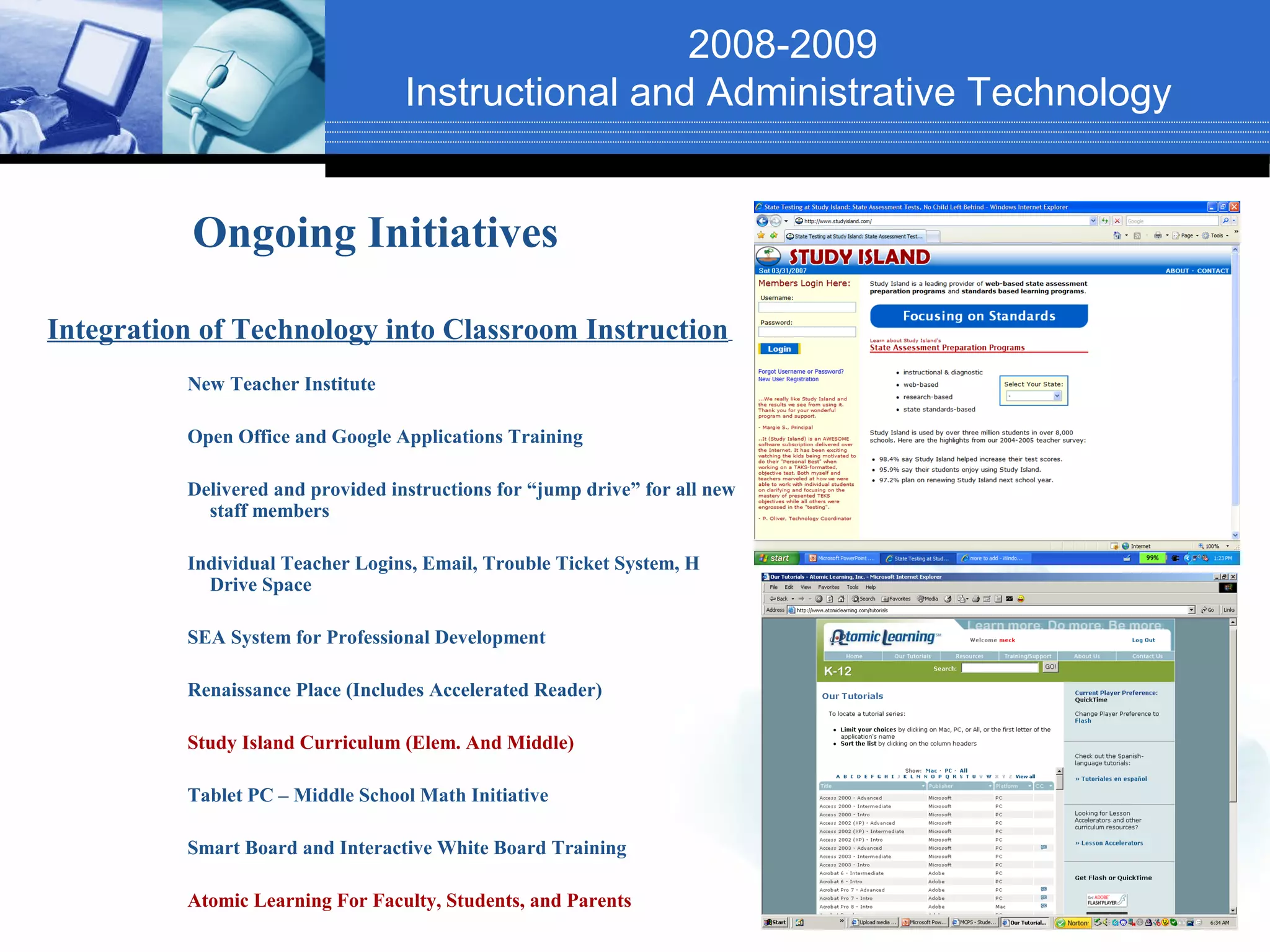

Integration of Technology into Classroom Instruction
          New Teacher Institute

          Open Office and Google Applications Training

          Delivered and provided instructions for “jump drive” for all new
            staff members

          Individual Teacher Logins, Email, Trouble Ticket System, H
            Drive Space

          SEA System for Professional Development

          Renaissance Place (Includes Accelerated Reader)

          Study Island Curriculum (Elem. And Middle)

          Tablet PC – Middle School Math Initiative

          Smart Board and Interactive White Board Training

          Atomic Learning For Faculty, Students, and Parents
2008-2009
                                          Instructional and Administrative Technology

          Integration of Technology into
          Classroom Instruction (Cont.)

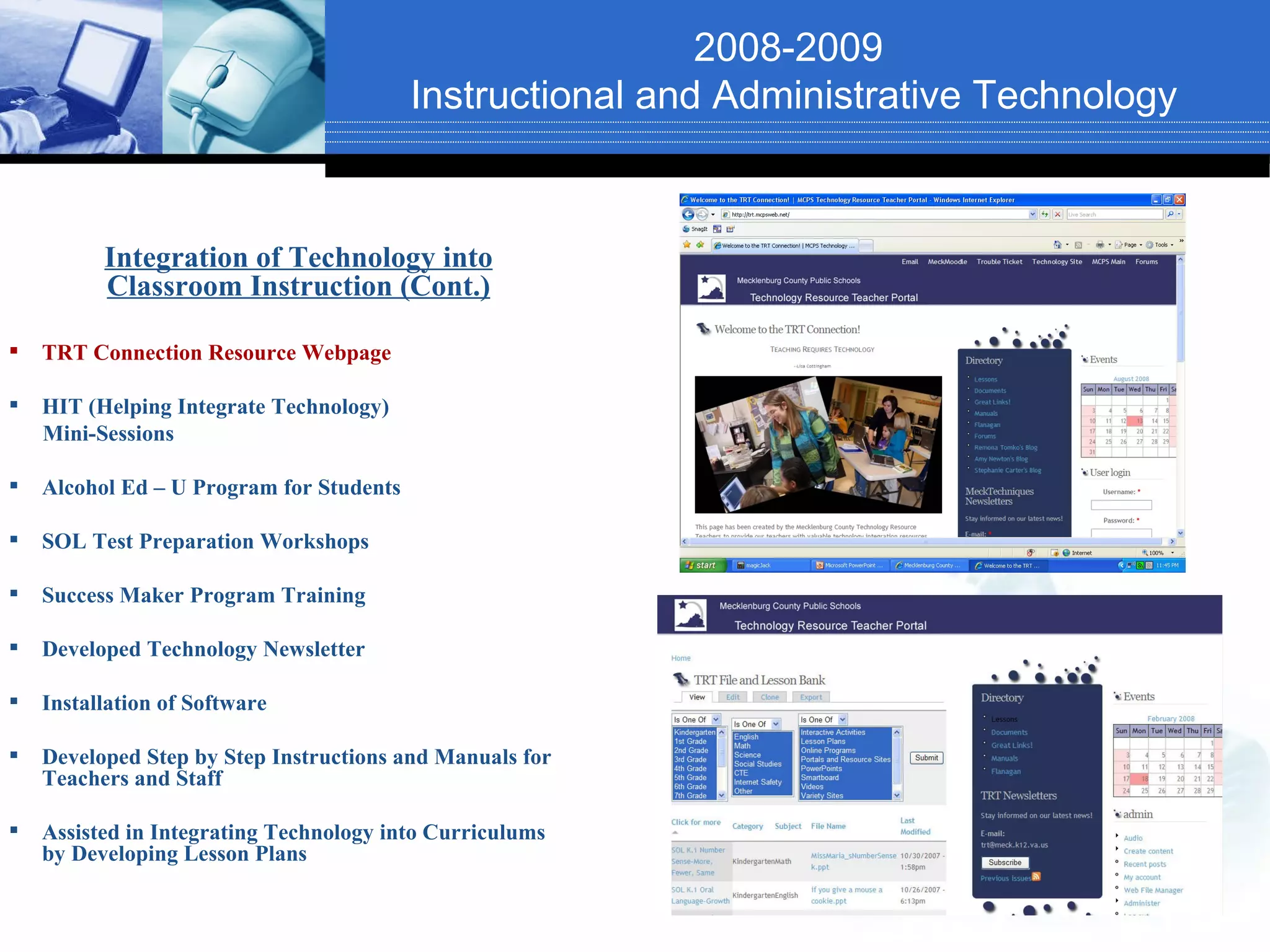

   TRT Connection Resource Webpage

   HIT (Helping Integrate Technology)
    Mini-Sessions

   Alcohol Ed – U Program for Students

   SOL Test Preparation Workshops

   Success Maker Program Training

   Developed Technology Newsletter

   Installation of Software

   Developed Step by Step Instructions and Manuals for
    Teachers and Staff

   Assisted in Integrating Technology into Curriculums
    by Developing Lesson Plans
2008-2009 Instructional and Administrative
                                                 Technology

           Ongoing Initiatives

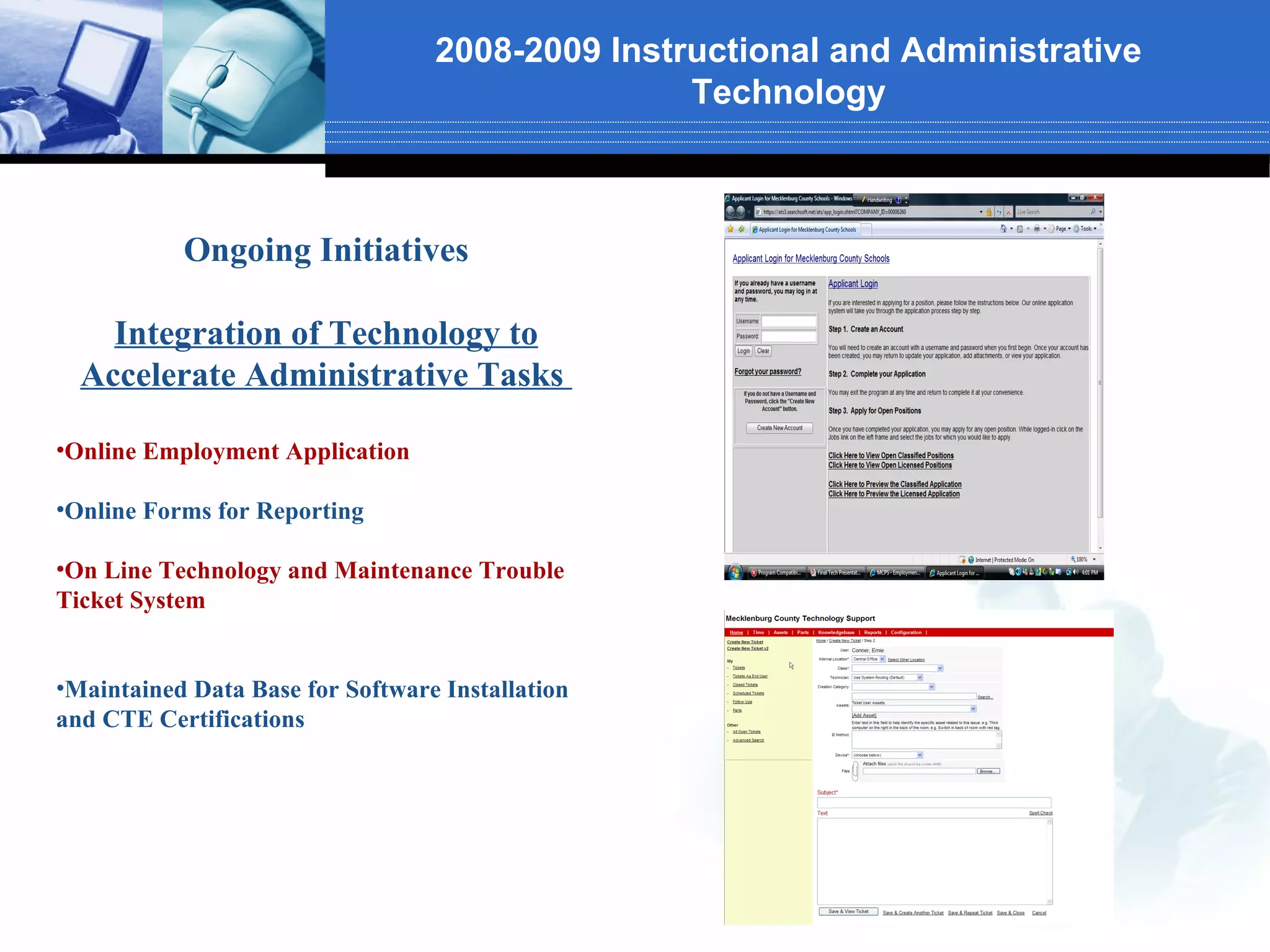

    Integration of Technology to
  Accelerate Administrative Tasks

•Online Employment Application

•Online Forms for Reporting

•On Line Technology and Maintenance Trouble
Ticket System

•Maintained Data Base for Software Installation
and CTE Certifications
2008-2009 Instructional and Administrative
                                                   Technology

   Integration of Technology to
  Accelerate Administrative Tasks
              (Cont.)

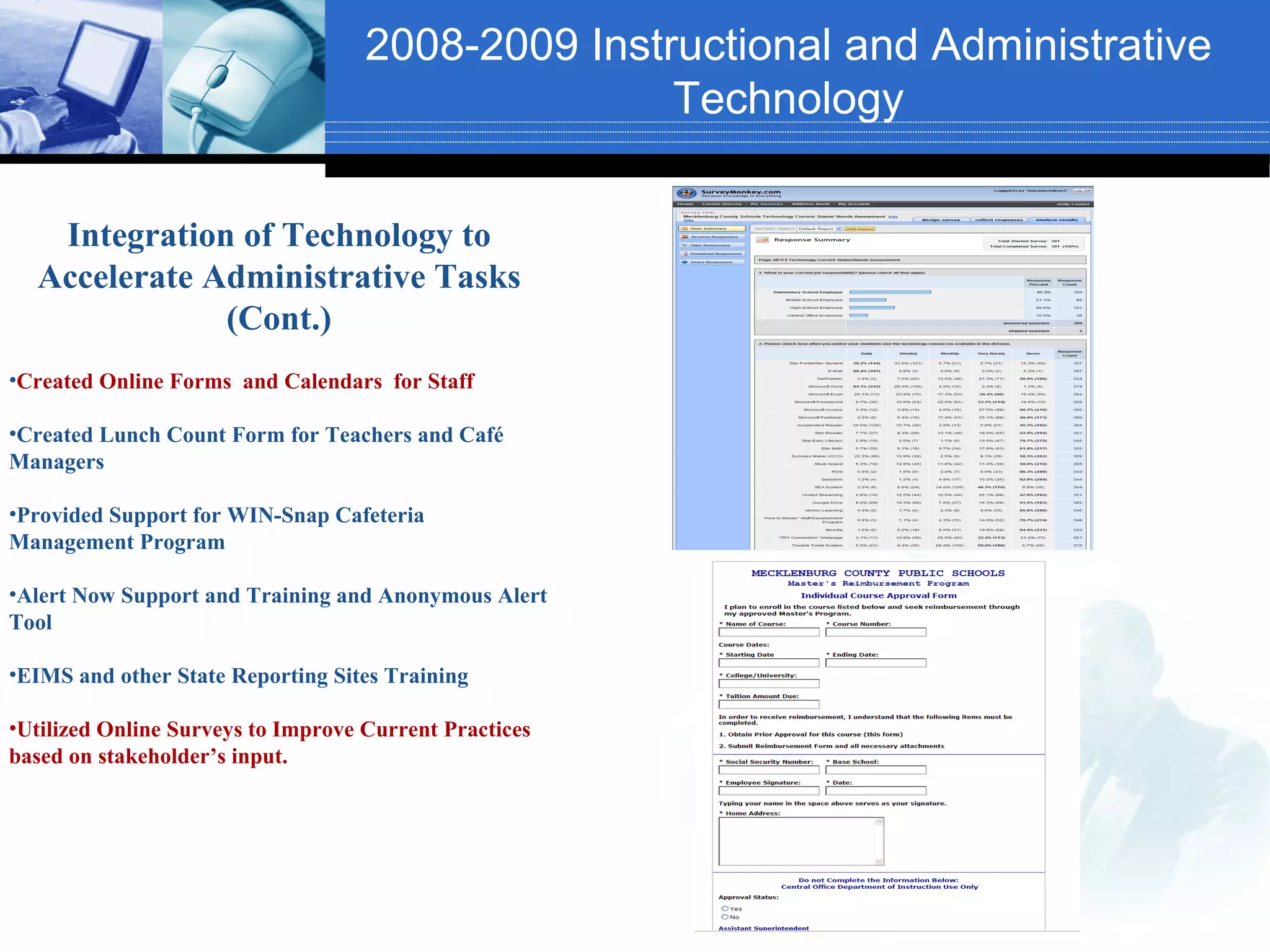

•Created Online Forms and Calendars for Staff

•Created Lunch Count Form for Teachers and Café
Managers

•Provided Support for WIN-Snap Cafeteria
Management Program

•Alert Now Support and Training and Anonymous Alert
Tool

•EIMS and other State Reporting Sites Training

•Utilized Online Surveys to Improve Current Practices
based on stakeholder’s input.
2008-2009 Instructional and Administrative
                                                          Technology
                                                               -

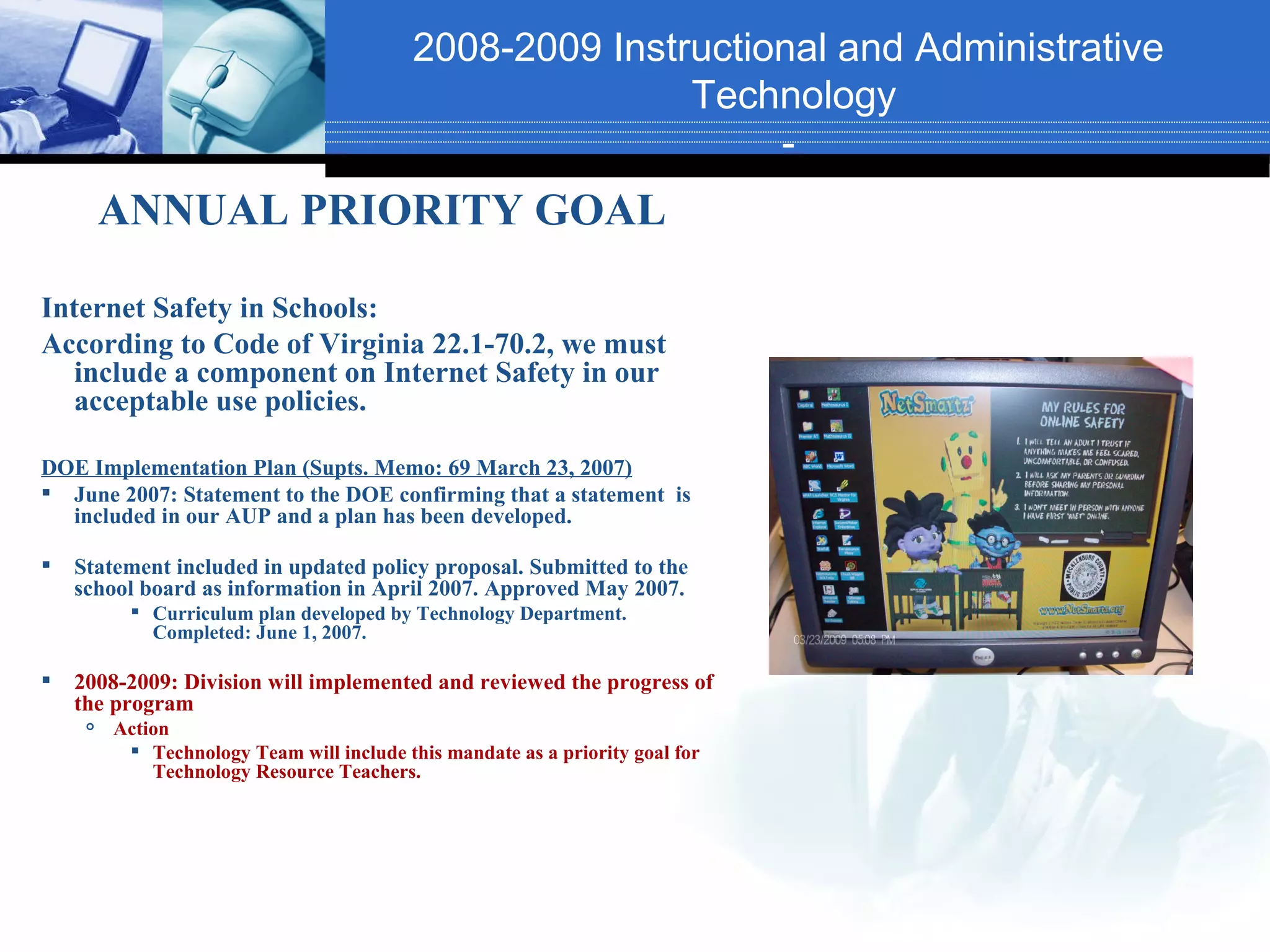

         ANNUAL PRIORITY GOAL

Internet Safety in Schools:
According to Code of Virginia 22.1-70.2, we must
   include a component on Internet Safety in our
   acceptable use policies.

DOE Implementation Plan (Supts. Memo: 69 March 23, 2007)
 June 2007: Statement to the DOE confirming that a statement is
  included in our AUP and a plan has been developed.

   Statement included in updated policy proposal. Submitted to the
    school board as information in April 2007. Approved May 2007.
           Curriculum plan developed by Technology Department.
            Completed: June 1, 2007.

   2008-2009: Division will implemented and reviewed the progress of
    the program
        Action
           Technology Team will include this mandate as a priority goal for
             Technology Resource Teachers.
2008-2009 Instructional and Administrative
                                       Technology

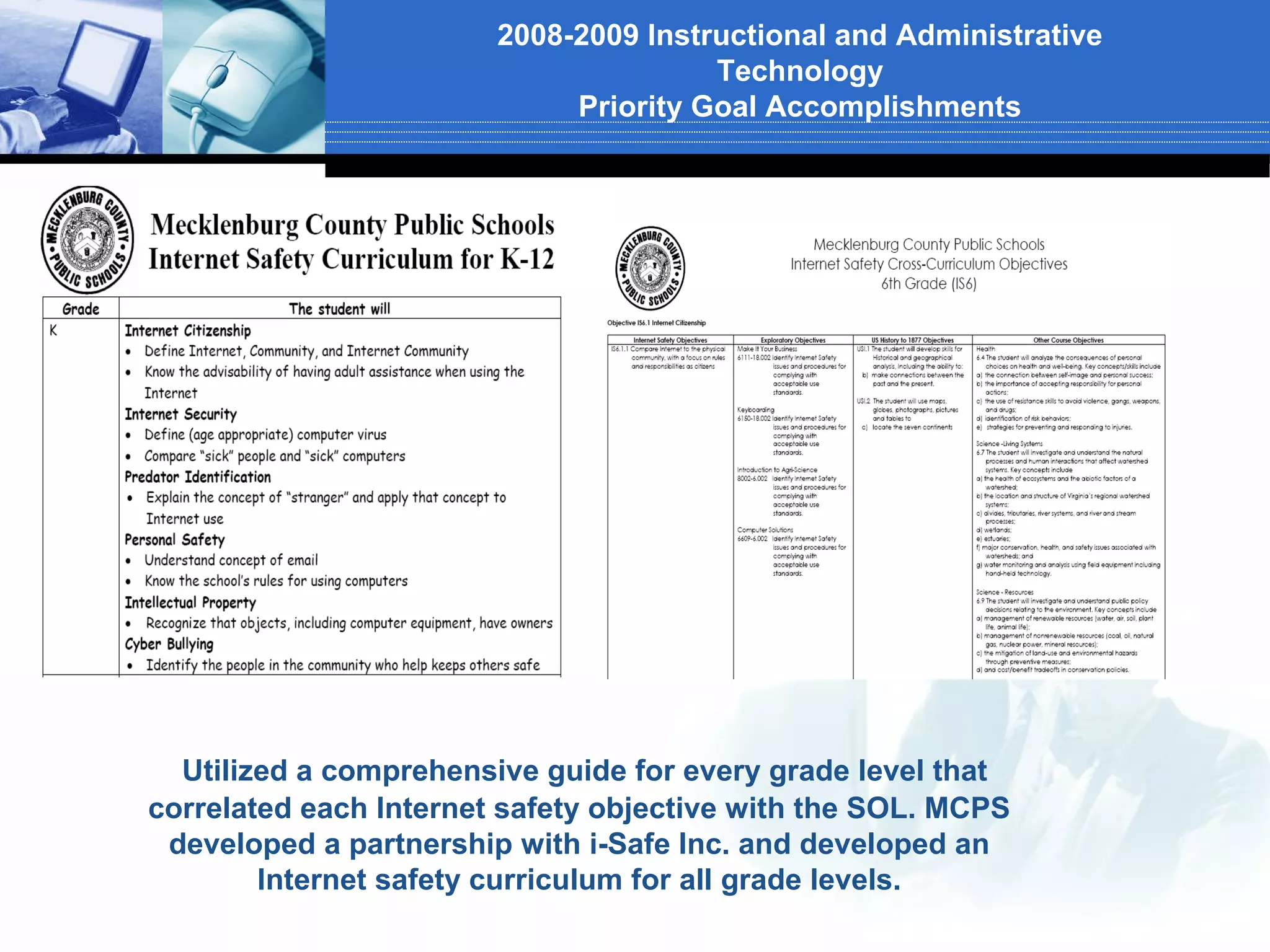

                             Priority Goal Accomplishments

  Utilized a comprehensive guide for every grade level that
correlated each Internet safety objective with the SOL. MCPS
 developed a partnership with i-Safe Inc. and developed an
        Internet safety curriculum for all grade levels.
2008-2009 Instructional and Administrative
Technology
Priority Goal Accomplishments

                     A Computer Crimes Investigator from the Attorney
                  Generals Office spoke to all Mecklenburg County’s High
                   and Middle School Students about the dangers of the
                   Internet and current issues that students face online.

                            Other implementation strategies included
                                faculty newsletters, informational
                                   brochures, exhibits and live
                            demonstrations at the South Central Fair,
                             parent newsletters, Internet safety rules
                              wallpaper on student computers, PTA
                            presentations, faculty workshops and an
                            online professional development course.
2008-2009 Instructional and Administrative
                                                          Technology

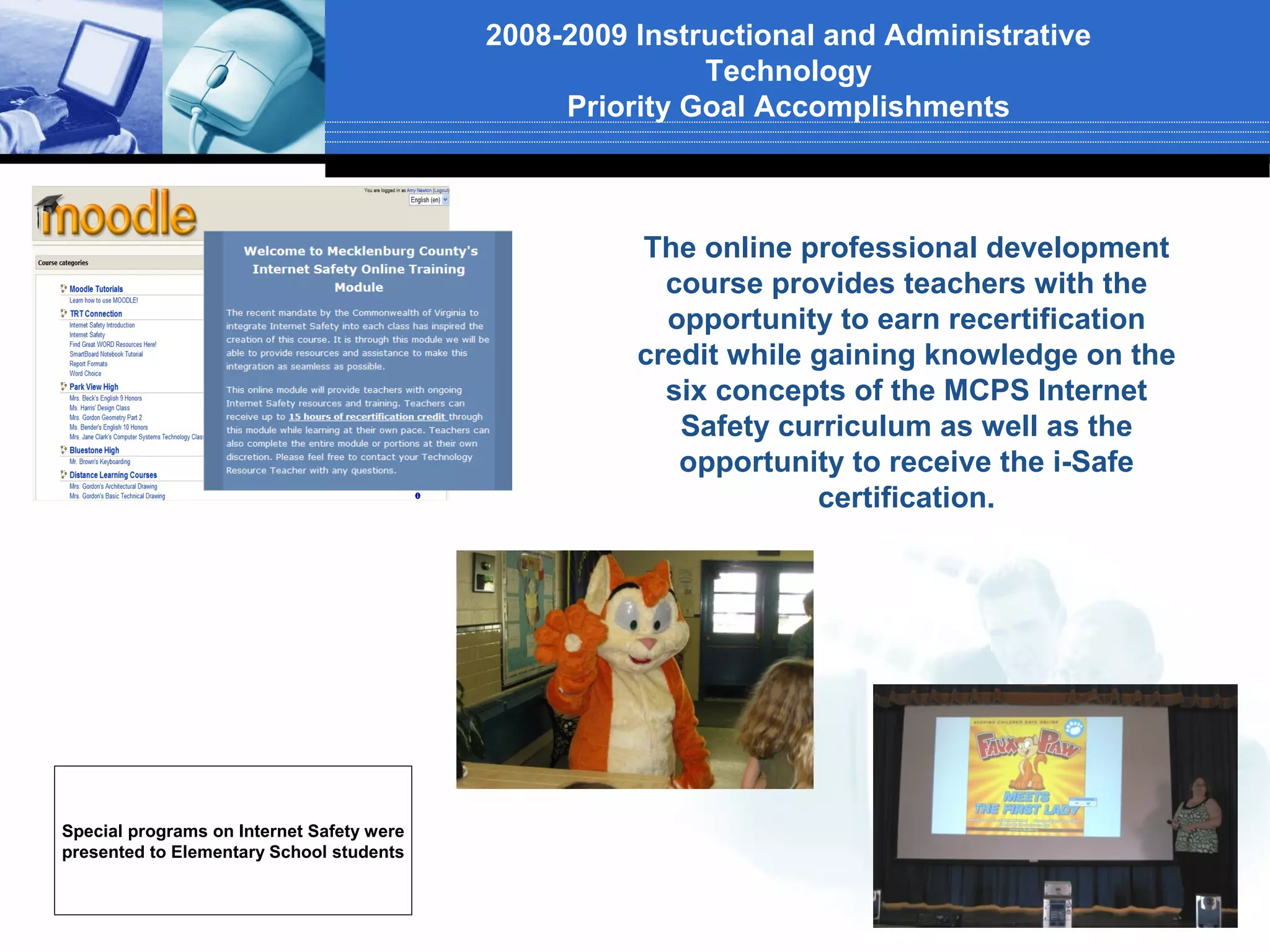

                                                Priority Goal Accomplishments

                                                     The online professional development
                                                       course provides teachers with the
                                                       opportunity to earn recertification
                                                     credit while gaining knowledge on the
                                                       six concepts of the MCPS Internet
                                                        Safety curriculum as well as the
                                                        opportunity to receive the i-Safe
                                                                  certification.

Special programs on Internet Safety were
presented to Elementary School students
2008-2009 Instructional and Administrative
                                     Technology
                           Priority Goal Accomplishments

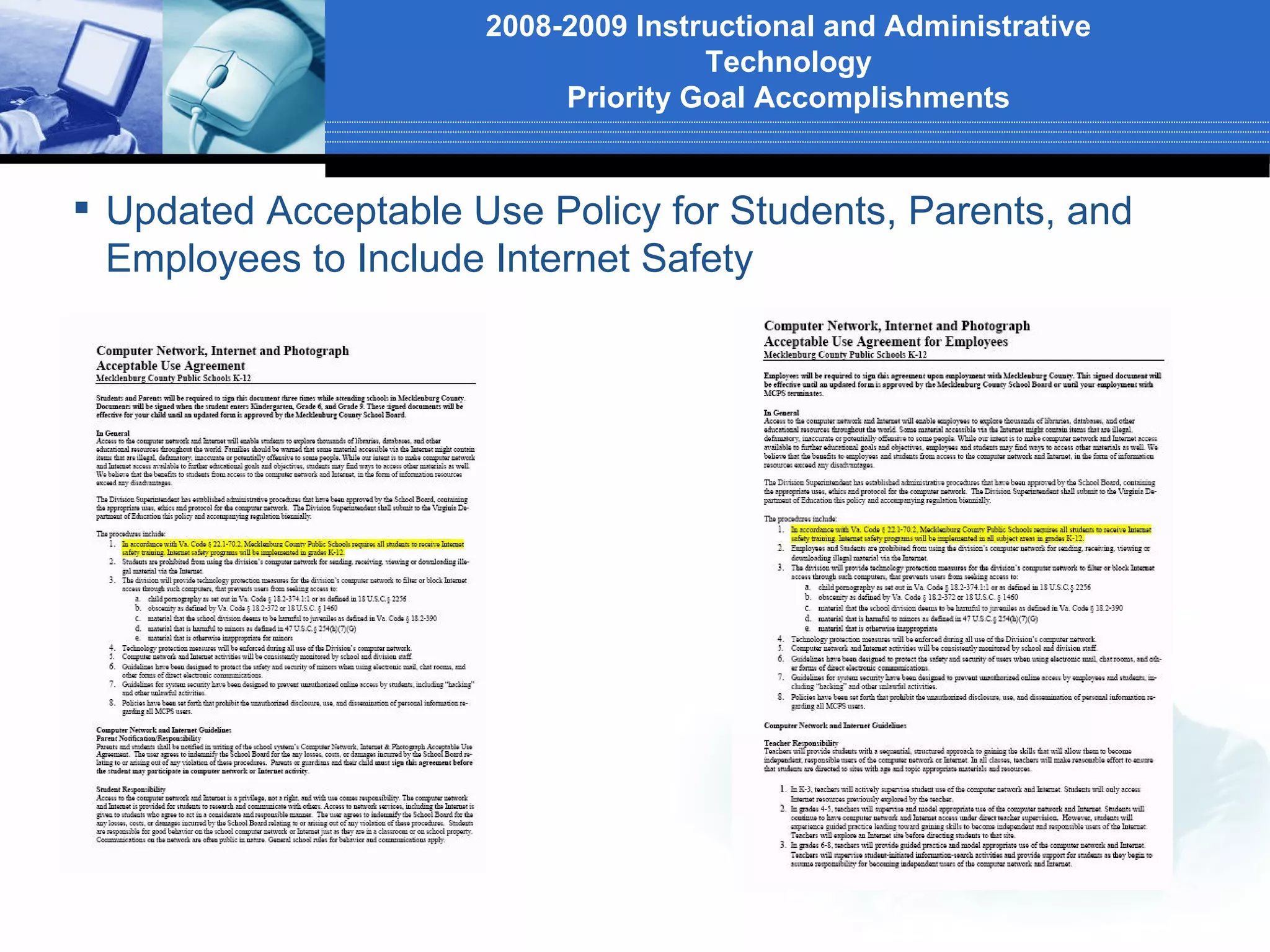

 Updated Acceptable Use Policy for Students, Parents, and
  Employees to Include Internet Safety

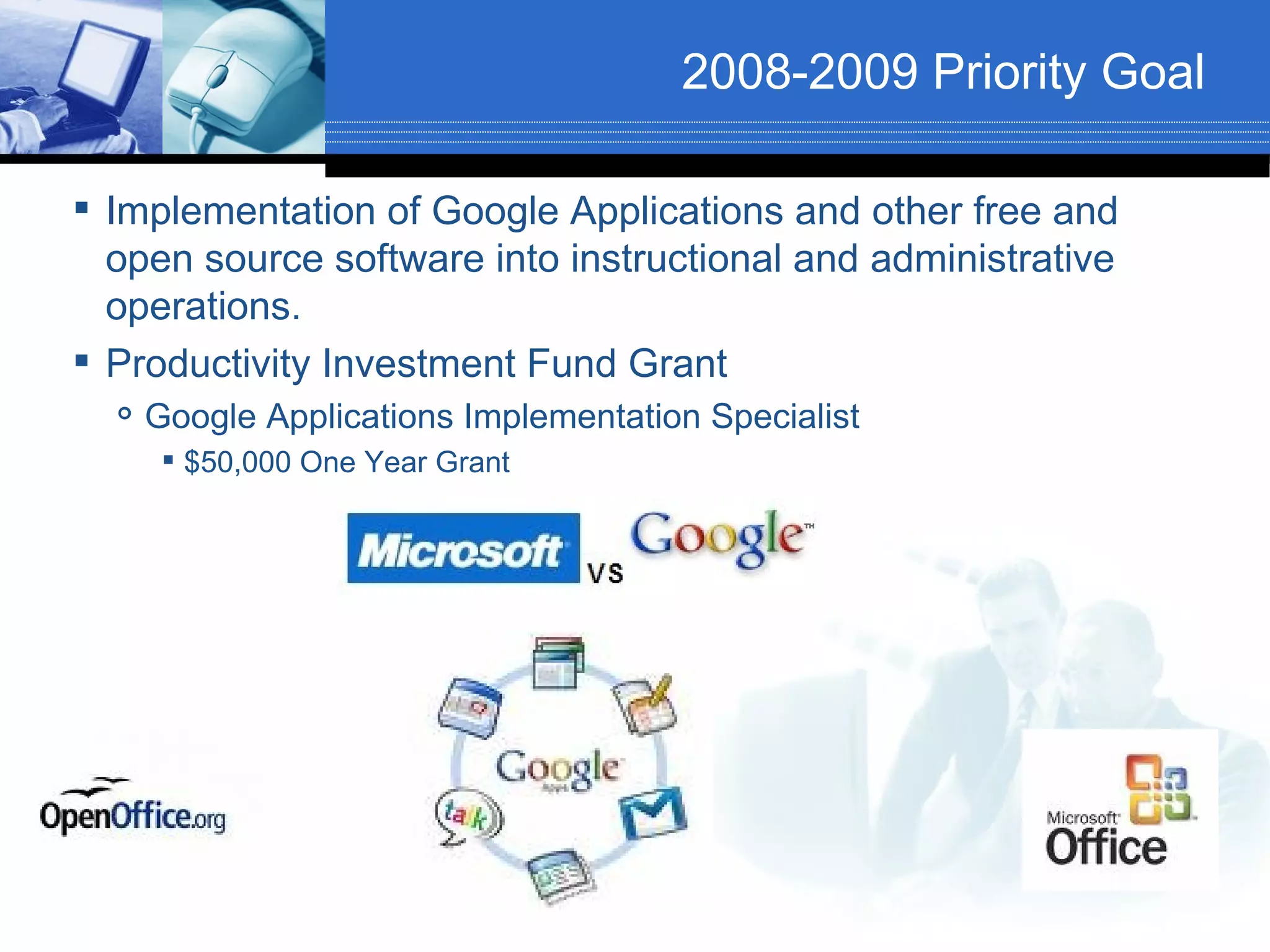

2008-2009 Priority Goal

 Implementation of Google Applications and other free and
  open source software into instructional and administrative
  operations.
 Productivity Investment Fund Grant
     Google Applications Implementation Specialist
        $50,000 One Year Grant

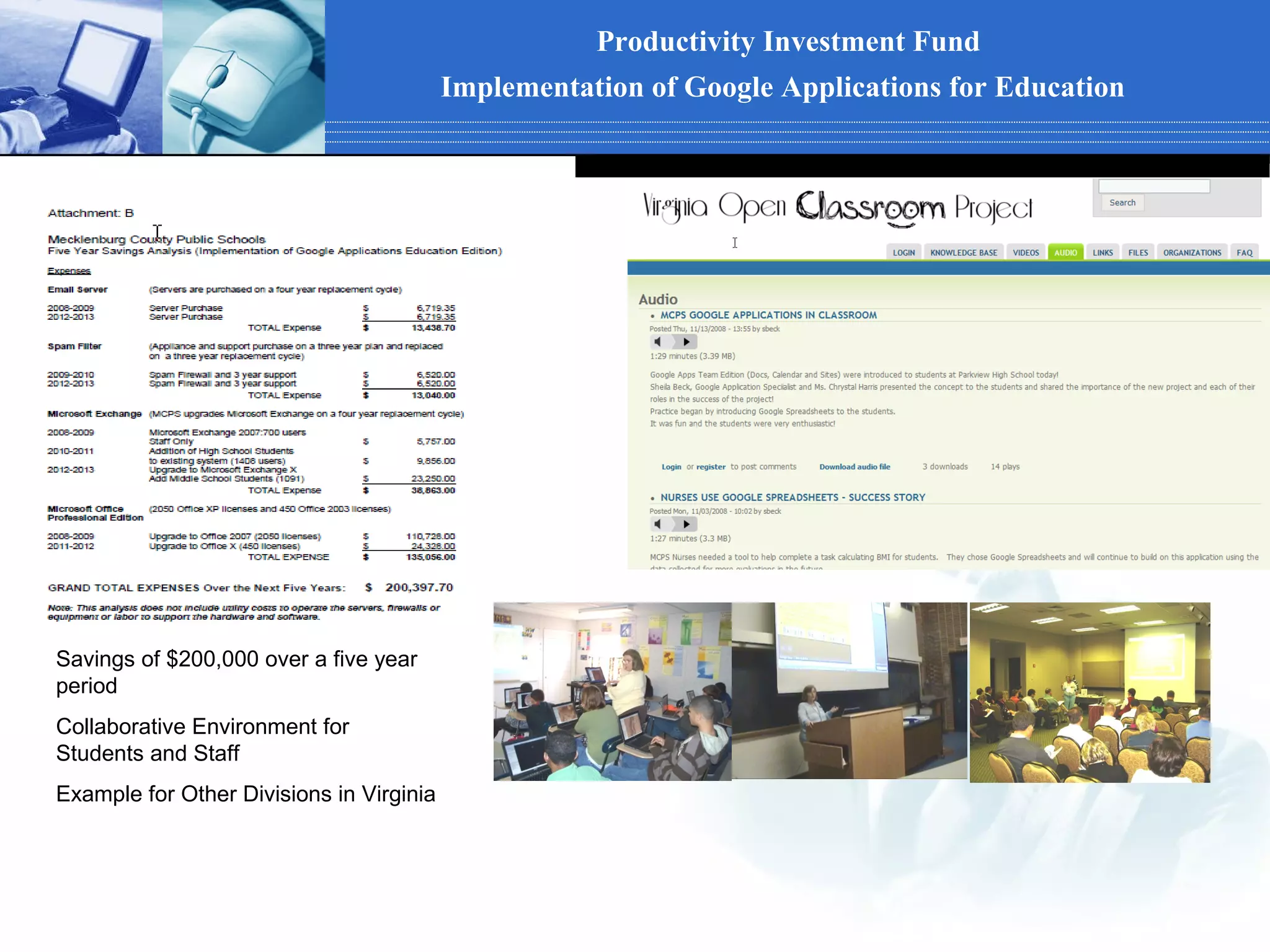

Productivity Investment Fund
                                          Implementation of Google Applications for Education

Savings of $200,000 over a five year
period
Collaborative Environment for
Students and Staff
Example for Other Divisions in Virginia

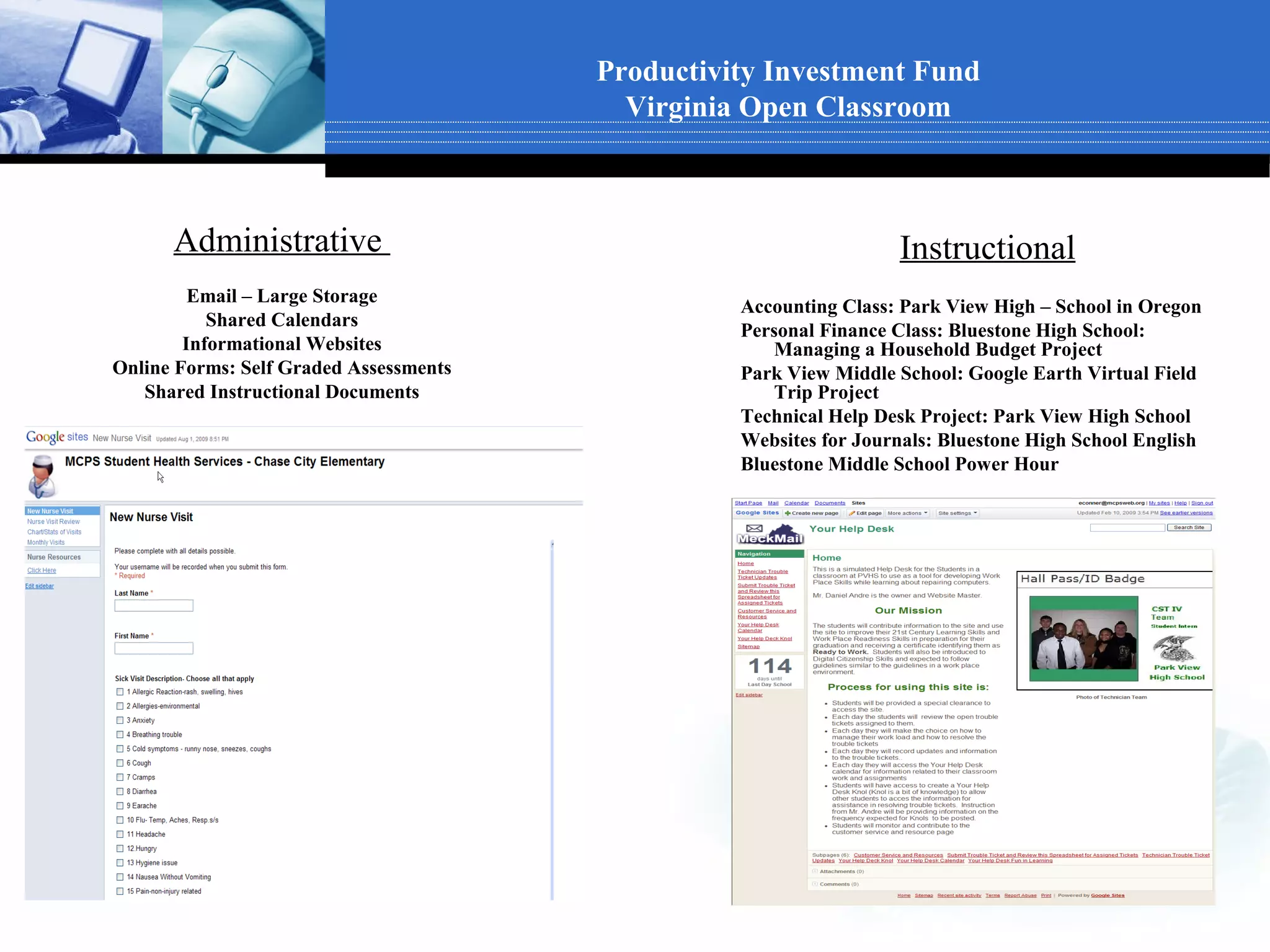

Productivity Investment Fund
                                          Virginia Open Classroom

      Administrative                                               Instructional
         Email – Large Storage
                                                  Accounting Class: Park View High – School in Oregon
           Shared Calendars
                                                  Personal Finance Class: Bluestone High School:
        Informational Websites                       Managing a Household Budget Project
Online Forms: Self Graded Assessments             Park View Middle School: Google Earth Virtual Field
   Shared Instructional Documents                    Trip Project
                                                  Technical Help Desk Project: Park View High School
                                                  Websites for Journals: Bluestone High School English
                                                  Bluestone Middle School Power Hour

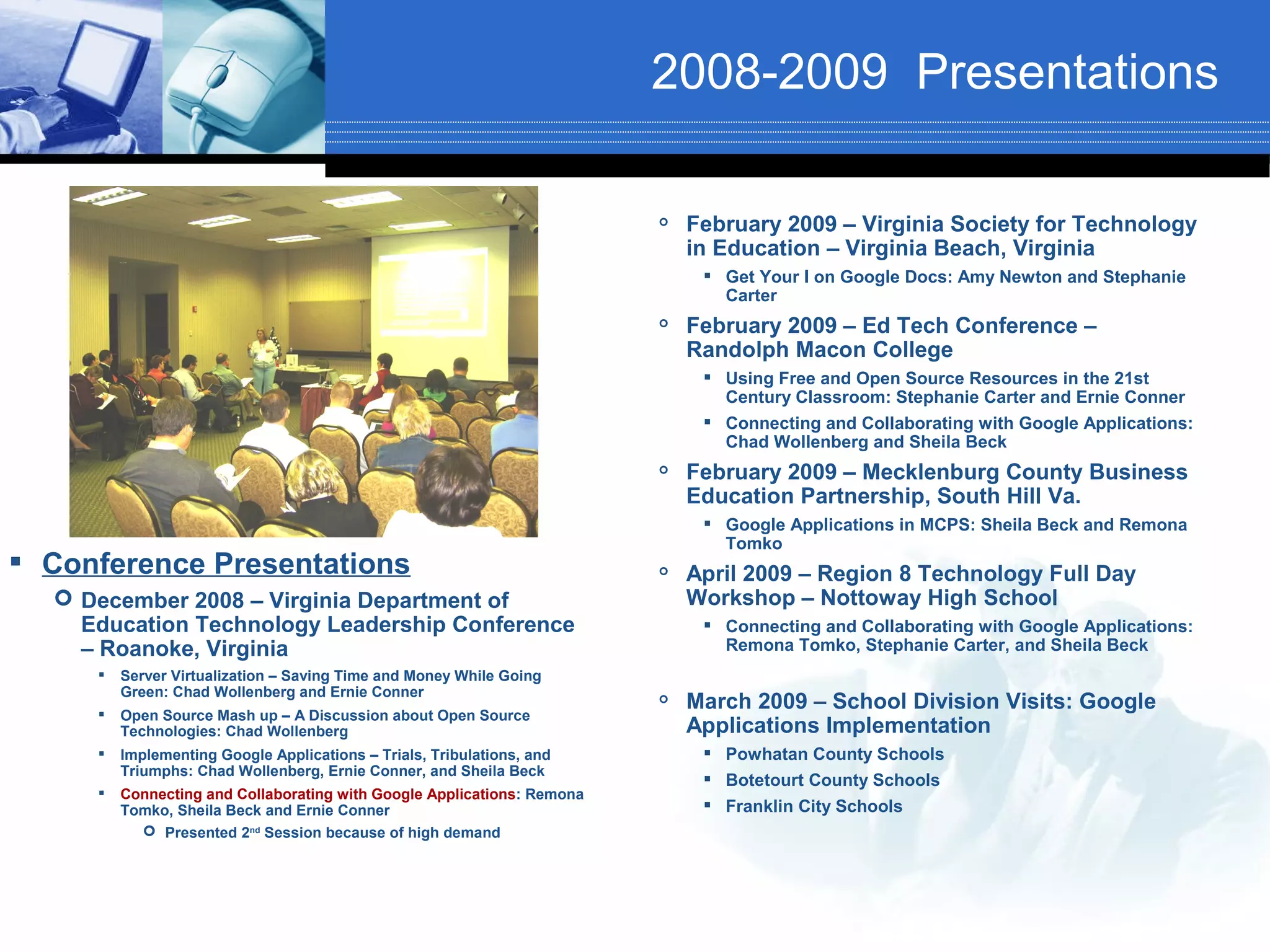

2008-2009 Presentations

                                                                            February 2009 – Virginia Society for Technology
                                                                             in Education – Virginia Beach, Virginia
                                                                               Get Your I on Google Docs: Amy Newton and Stephanie
                                                                                Carter
                                                                            February 2009 – Ed Tech Conference –
                                                                             Randolph Macon College
                                                                               Using Free and Open Source Resources in the 21st
                                                                                Century Classroom: Stephanie Carter and Ernie Conner
                                                                               Connecting and Collaborating with Google Applications:
                                                                                Chad Wollenberg and Sheila Beck
                                                                            February 2009 – Mecklenburg County Business
                                                                             Education Partnership, South Hill Va.
                                                                               Google Applications in MCPS: Sheila Beck and Remona
                                                                                Tomko
 Conference Presentations                                               
                                                                             April 2009 – Region 8 Technology Full Day
   December 2008 – Virginia Department of                                   Workshop – Nottoway High School
    Education Technology Leadership Conference                                 Connecting and Collaborating with Google Applications:
    – Roanoke, Virginia                                                         Remona Tomko, Stephanie Carter, and Sheila Beck
        Server Virtualization – Saving Time and Money While Going
         Green: Chad Wollenberg and Ernie Conner
     
                                                                            March 2009 – School Division Visits: Google
         Open Source Mash up – A Discussion about Open Source
         Technologies: Chad Wollenberg                                       Applications Implementation
        Implementing Google Applications – Trials, Tribulations, and          Powhatan County Schools
         Triumphs: Chad Wollenberg, Ernie Conner, and Sheila Beck
                                                                               Botetourt County Schools
        Connecting and Collaborating with Google Applications: Remona
         Tomko, Sheila Beck and Ernie Conner                                   Franklin City Schools
            Presented 2nd Session because of high demand

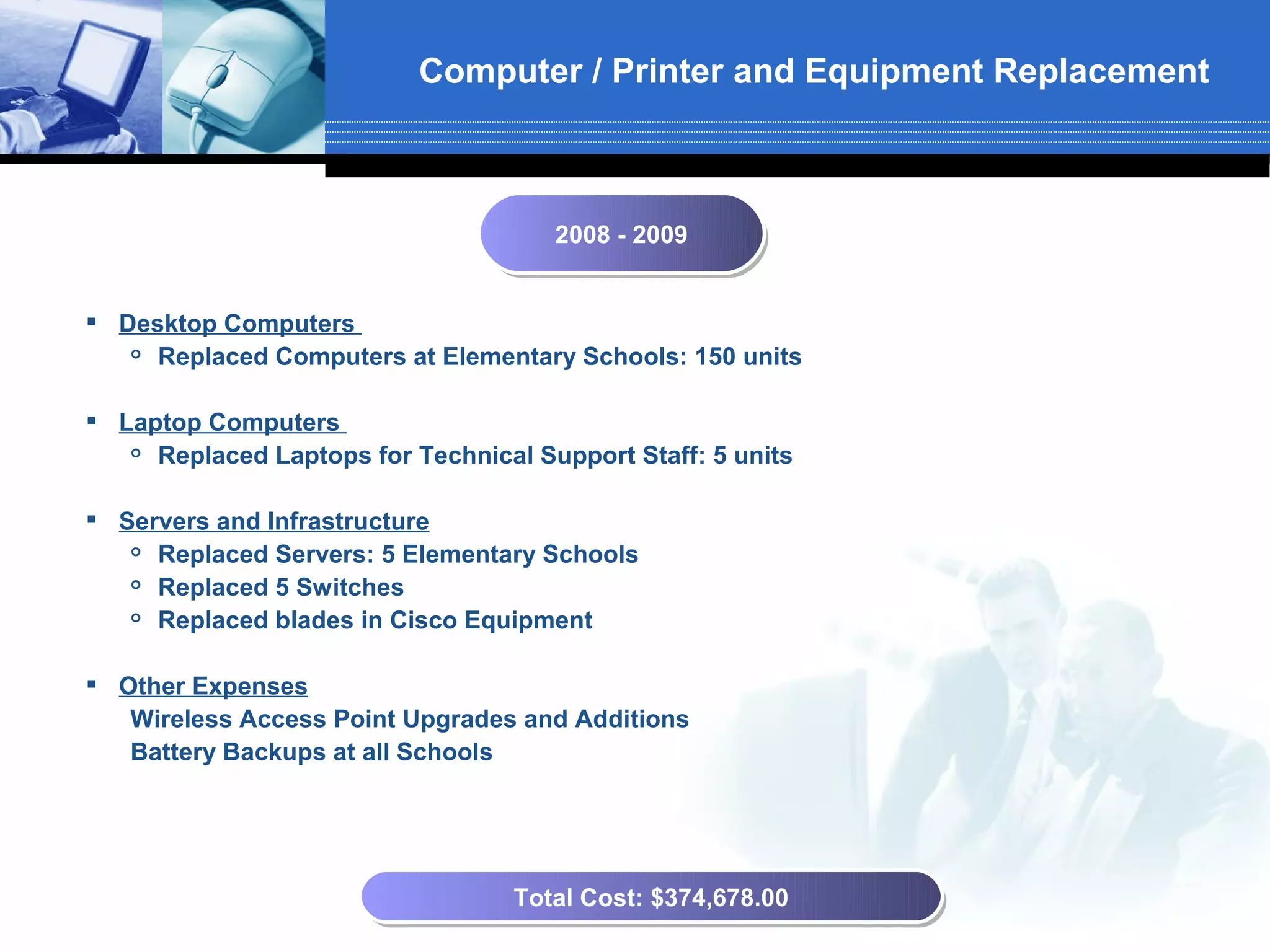

Computer Replacement Schedule and
Technical Services

    2008-2009

    Company
    LOGO
2008-2009 Technical Services – Service

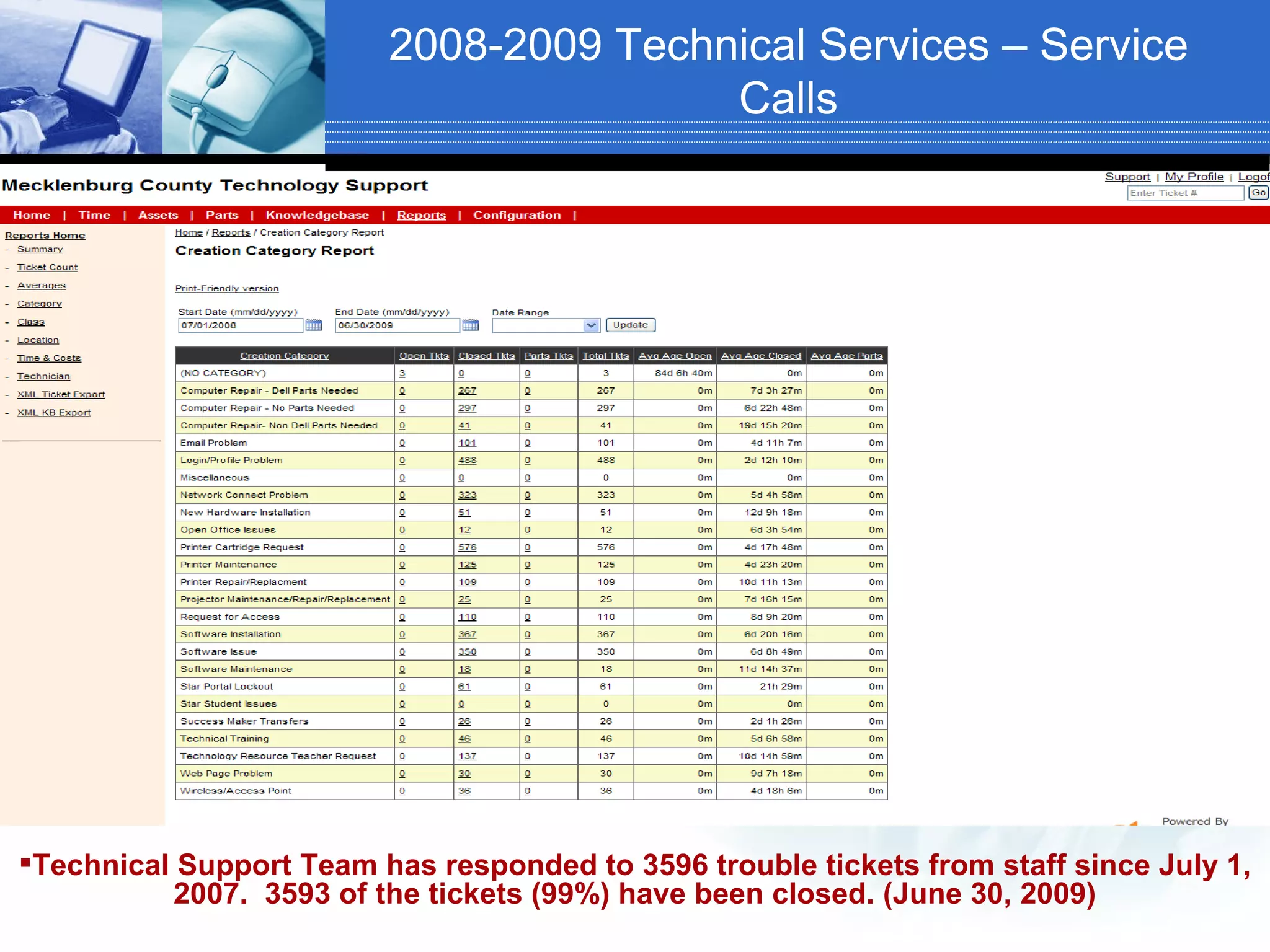

                                        Calls

Technical Support Team has responded to 3596 trouble tickets from staff since July 1,
           2007. 3593 of the tickets (99%) have been closed. (June 30, 2009)

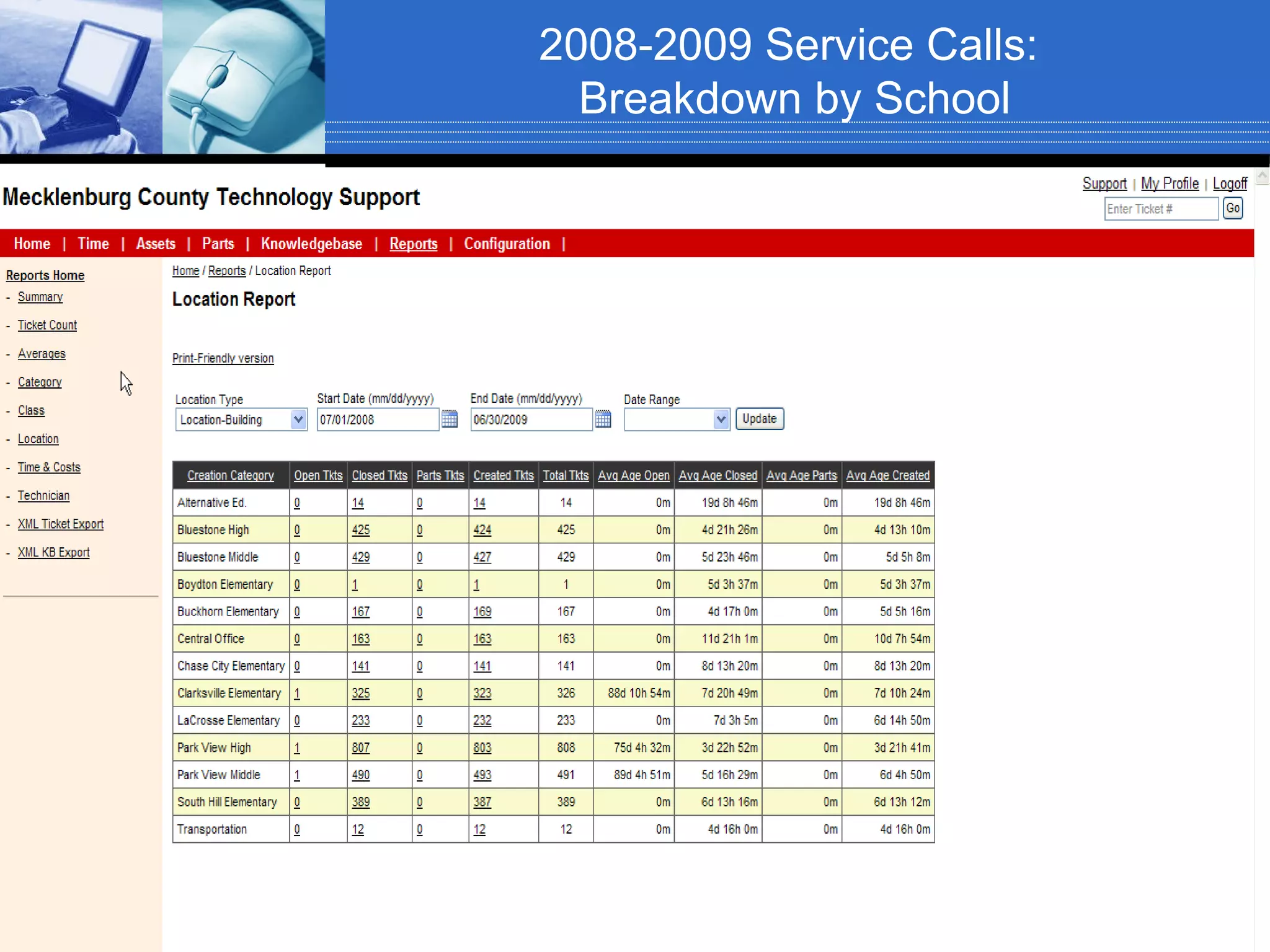

2008-2009 Service Calls:
  Breakdown by School

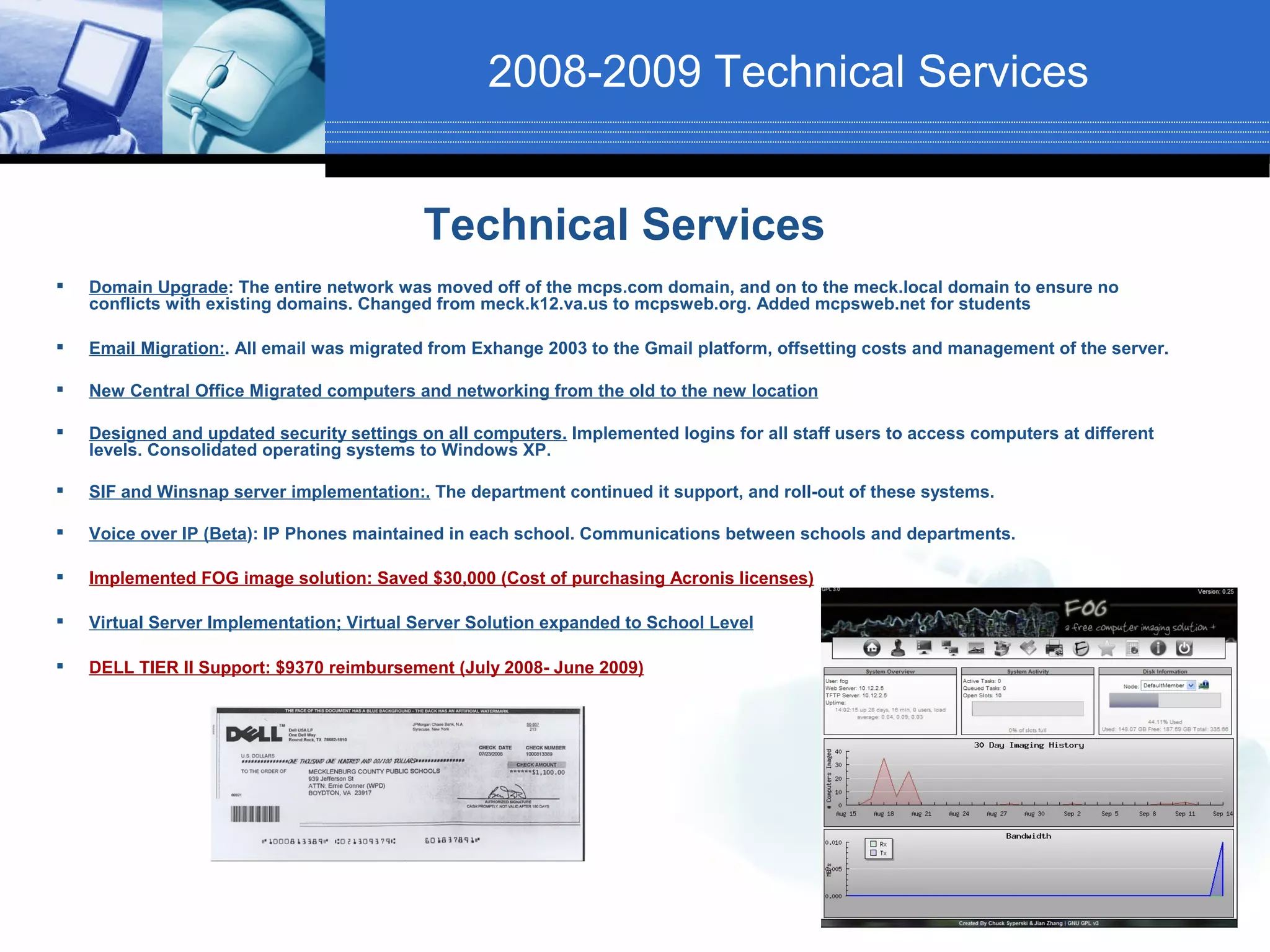

2008-2009 Technical Services

                                            Technical Services
   Domain Upgrade: The entire network was moved off of the mcps.com domain, and on to the meck.local domain to ensure no
    conflicts with existing domains. Changed from meck.k12.va.us to mcpsweb.org. Added mcpsweb.net for students

   Email Migration:. All email was migrated from Exhange 2003 to the Gmail platform, offsetting costs and management of the server.

   New Central Office Migrated computers and networking from the old to the new location

   Designed and updated security settings on all computers. Implemented logins for all staff users to access computers at different
    levels. Consolidated operating systems to Windows XP.

   SIF and Winsnap server implementation:. The department continued it support, and roll-out of these systems.

   Voice over IP (Beta): IP Phones maintained in each school. Communications between schools and departments.

   Implemented FOG image solution: Saved $30,000 (Cost of purchasing Acronis licenses)

   Virtual Server Implementation; Virtual Server Solution expanded to School Level

   DELL TIER II Support: $9370 reimbursement (July 2008- June 2009)

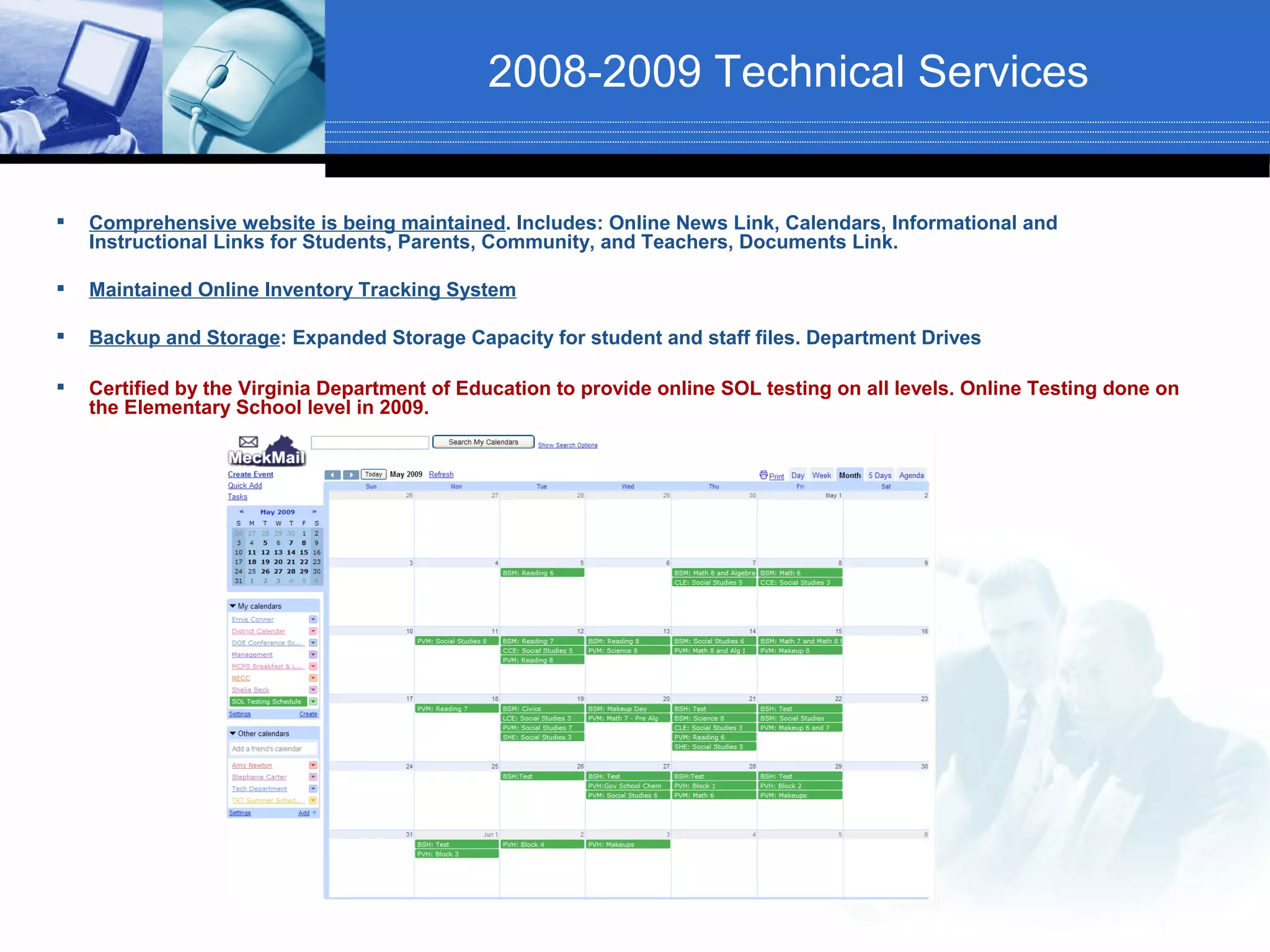

2008-2009 Technical Services

   Comprehensive website is being maintained. Includes: Online News Link, Calendars, Informational and
    Instructional Links for Students, Parents, Community, and Teachers, Documents Link.

   Maintained Online Inventory Tracking System

   Backup and Storage: Expanded Storage Capacity for student and staff files. Department Drives

   Certified by the Virginia Department of Education to provide online SOL testing on all levels. Online Testing done on
    the Elementary School level in 2009.

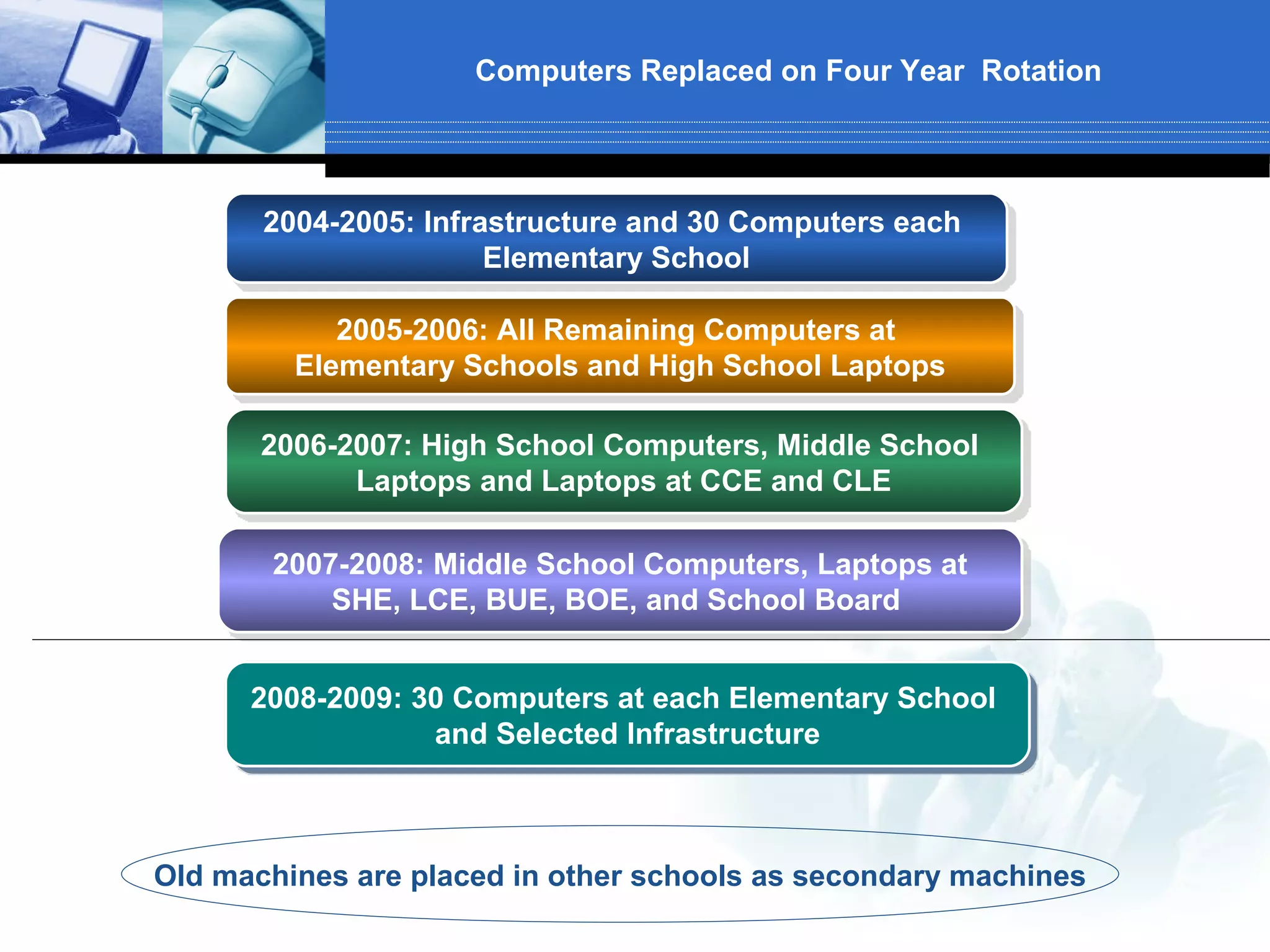

Computers Replaced on Four Year Rotation

       2004-2005: Infrastructure and 30 Computers each
                       Elementary School

            2005-2006: All Remaining Computers at
         Elementary Schools and High School Laptops

       2006-2007: High School Computers, Middle School
             Laptops and Laptops at CCE and CLE

       2007-2008: Middle School Computers, Laptops at
           SHE, LCE, BUE, BOE, and School Board

      2008-2009: 30 Computers at each Elementary School
                  and Selected Infrastructure

Old machines are placed in other schools as secondary machines
Computer / Printer and Equipment Replacement

                                      2008 -- 2009
                                      2008 2009

 Desktop Computers
   
     Replaced Computers at Elementary Schools: 150 units

 Laptop Computers
    Replaced Laptops for Technical Support Staff: 5 units

 Servers and Infrastructure
   
     Replaced Servers: 5 Elementary Schools
   
     Replaced 5 Switches
   
     Replaced blades in Cisco Equipment

 Other Expenses
   Wireless Access Point Upgrades and Additions
   Battery Backups at all Schools

                                   Total Cost: $374,678.00
                                   Total Cost: $374,678.00
Materials and Supplies

2008-2009
Consumable Supplies: $148,000.00

Includes:
1. Parts for computers not under warranty (Old machines not under warranty)
   Hard Drives, Fans, Power Supplies, Monitors, Motherboards, Sound/ Graphic Cards
2. Keyboards, Mice, Speakers, CD’s, Memory, Storage Drives, Microphones
3. Printer Cartridges (List of models supported)
4. Surge Protectors
5. Network Cable, Connectors, Network Cards, Jet Direct Cards , Laptop Batteries

Non-Consumable Supplies: $95,000.00

Includes:
1. Cameras and Projectors: $13,331.00
2. Net Trekker: $9820.00
3. St. Bernard Filtering Content Application: $17,865.00
4. Edu Structures: SIF: $1363.00
5. VM Ware and Windows Server Licenses: $6744.00
6. Educational Software: $11,525.00
7. Study Island Renewal: $18,367.00
8. Other: $15,985

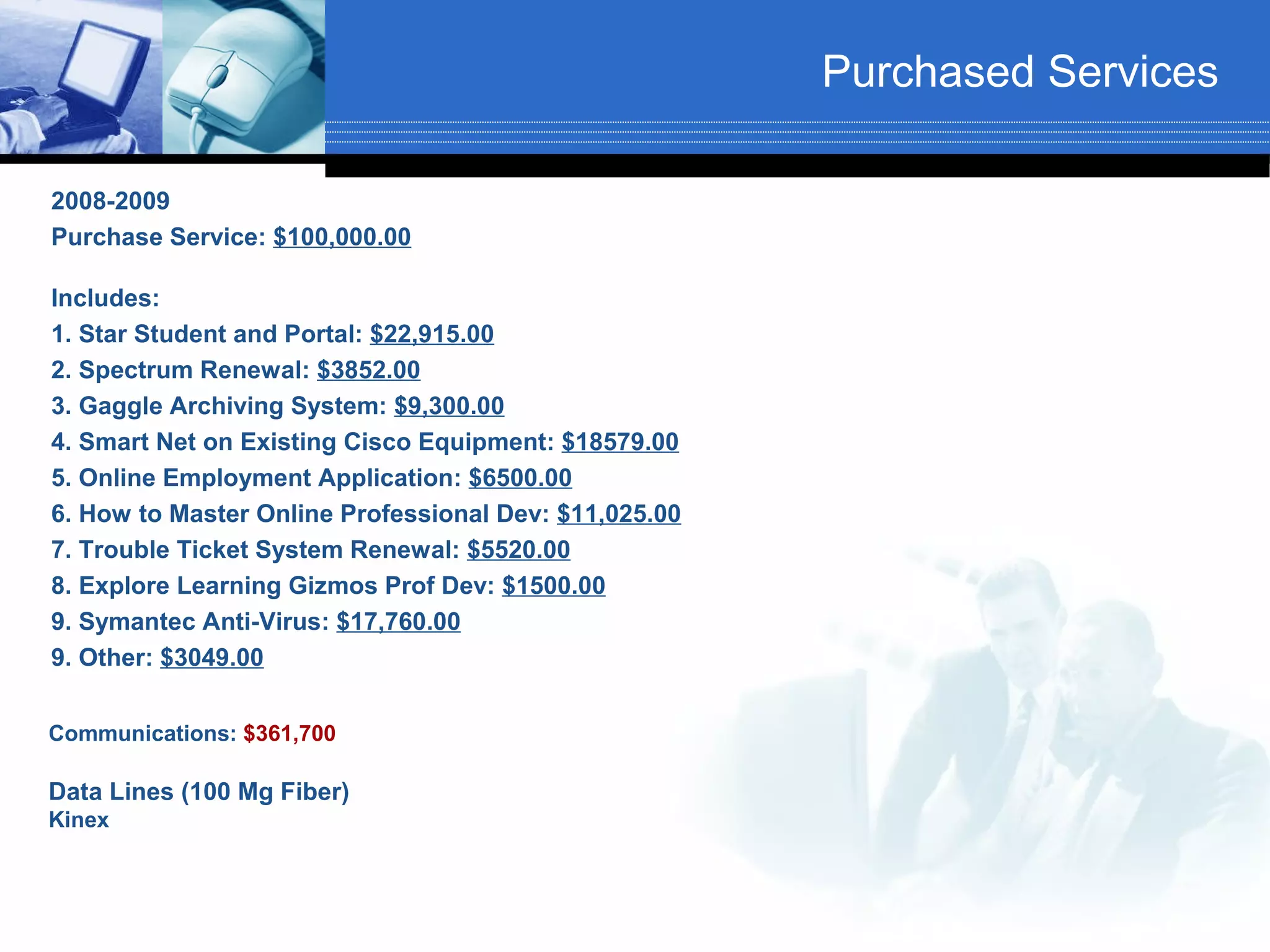

Purchased Services

2008-2009
Purchase Service: $100,000.00

Includes:
1. Star Student and Portal: $22,915.00
2. Spectrum Renewal: $3852.00
3. Gaggle Archiving System: $9,300.00
4. Smart Net on Existing Cisco Equipment: $18579.00
5. Online Employment Application: $6500.00
6. How to Master Online Professional Dev: $11,025.00
7. Trouble Ticket System Renewal: $5520.00
8. Explore Learning Gizmos Prof Dev: $1500.00
9. Symantec Anti-Virus: $17,760.00
9. Other: $3049.00

Communications: $361,700

Data Lines (100 Mg Fiber)
Kinex
2008-2009 Accolades and Honors

             The Mecklenburg County School’s Technology Department was
            awarded the Southern Virginia Regional Technology Consortium's
                      2009 Division Technology Leadership Award

                 Mark Eckler, Teacher at Bluestone Middle School, was awarded the Southern Virginia
                                Regional Technology Consortium's Technology Award

                    Bernard Robinson, Technical Support Specialist, was awarded the Southern
                    Virginia Regional Technology Consortium's Technical Support Award

Article Appeared in Virginia Business Journal on Google Applications
Implementation in Mecklenburg County Schools
2009 – 2010 School Year

                 2006-2007

                                 2007-2008

  2005-2006

                                 2008-2009

2004-2005
              2003-2004

                                             2009-2010
                                             Transition Year
2009-2010

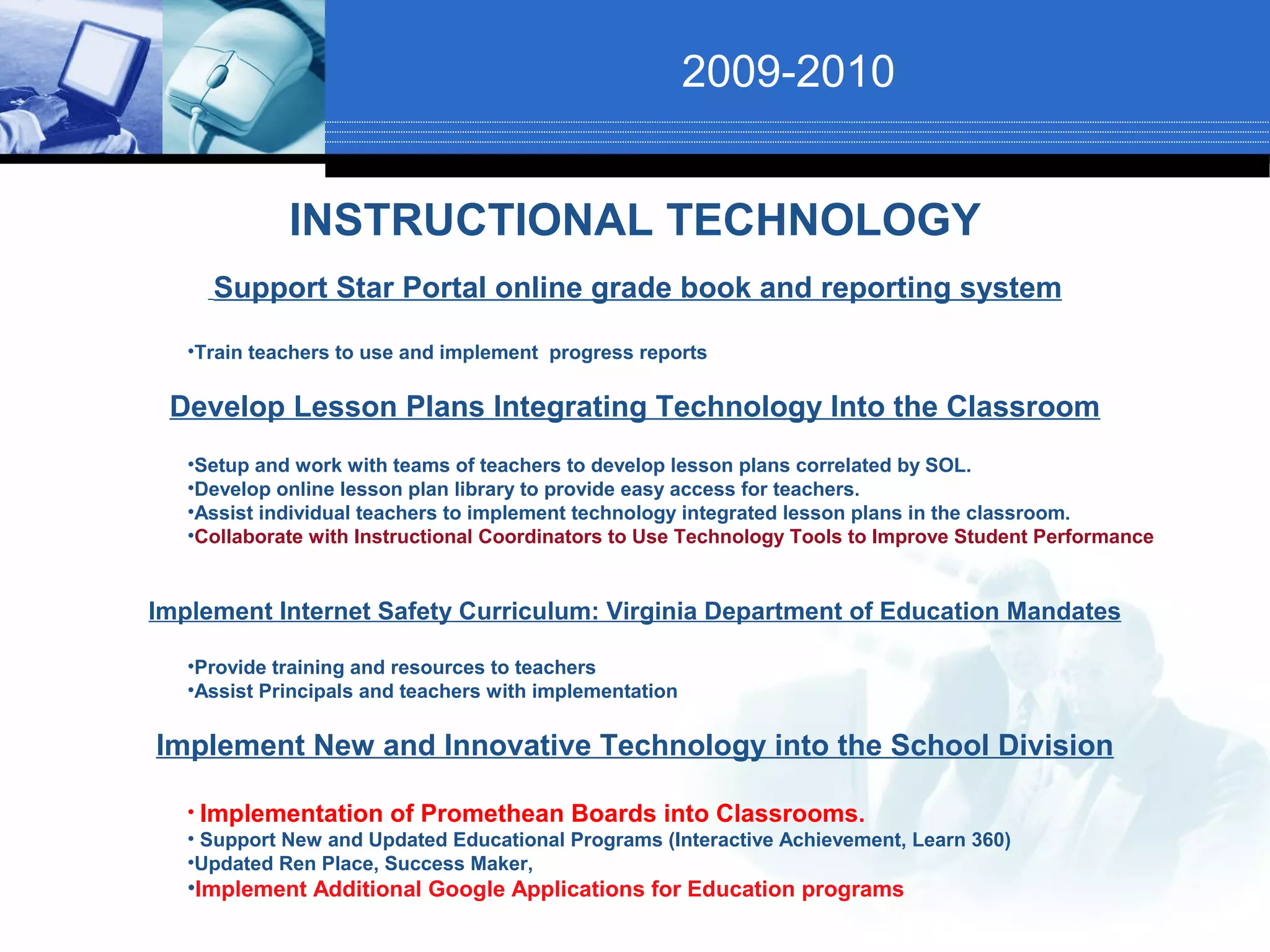

             INSTRUCTIONAL TECHNOLOGY
     Support Star Portal online grade book and reporting system

   •Train teachers to use and implement progress reports

 Develop Lesson Plans Integrating Technology Into the Classroom
   •Setup and work with teams of teachers to develop lesson plans correlated by SOL.
   •Develop online lesson plan library to provide easy access for teachers.
   •Assist individual teachers to implement technology integrated lesson plans in the classroom.
   •Collaborate with Instructional Coordinators to Use Technology Tools to Improve Student Performance

Implement Internet Safety Curriculum: Virginia Department of Education Mandates

   •Provide training and resources to teachers
   •Assist Principals and teachers with implementation

Implement New and Innovative Technology into the School Division

   • Implementation of Promethean Boards into Classrooms.
   • Support New and Updated Educational Programs (Interactive Achievement, Learn 360)
   •Updated Ren Place, Success Maker,
   •Implement Additional Google Applications for Education programs

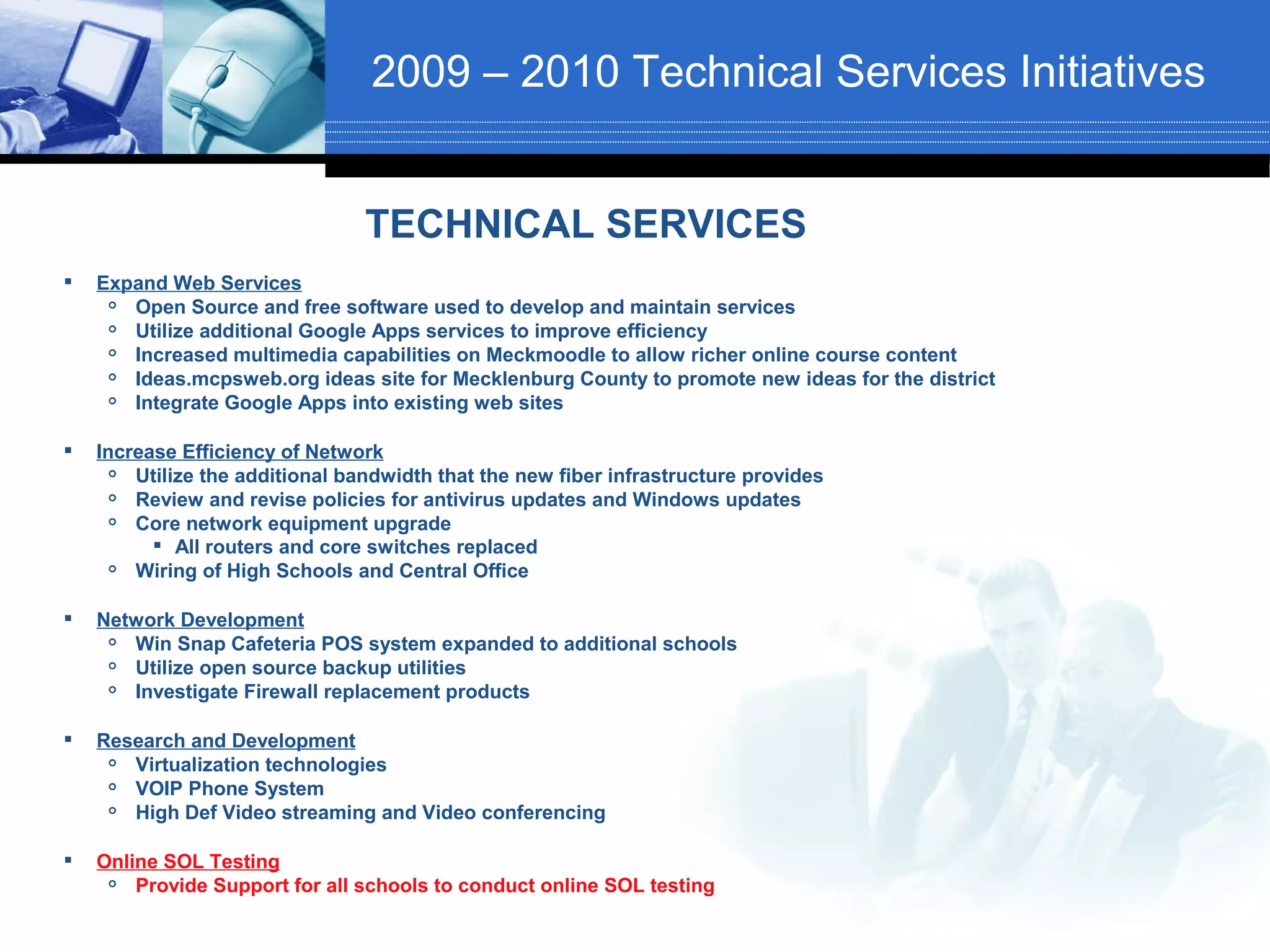

2009 – 2010 Technical Services Initiatives

                                 TECHNICAL SERVICES
   Expand Web Services
      Open Source and free software used to develop and maintain services
      Utilize additional Google Apps services to improve efficiency
      Increased multimedia capabilities on Meckmoodle to allow richer online course content
      Ideas.mcpsweb.org ideas site for Mecklenburg County to promote new ideas for the district
      Integrate Google Apps into existing web sites

   Increase Efficiency of Network
       Utilize the additional bandwidth that the new fiber infrastructure provides
       Review and revise policies for antivirus updates and Windows updates
       Core network equipment upgrade
           All routers and core switches replaced
       Wiring of High Schools and Central Office

   Network Development
      Win Snap Cafeteria POS system expanded to additional schools
      Utilize open source backup utilities
      Investigate Firewall replacement products

   Research and Development
      Virtualization technologies
      VOIP Phone System
      High Def Video streaming and Video conferencing

   Online SOL Testing
       Provide Support for all schools to conduct online SOL testing

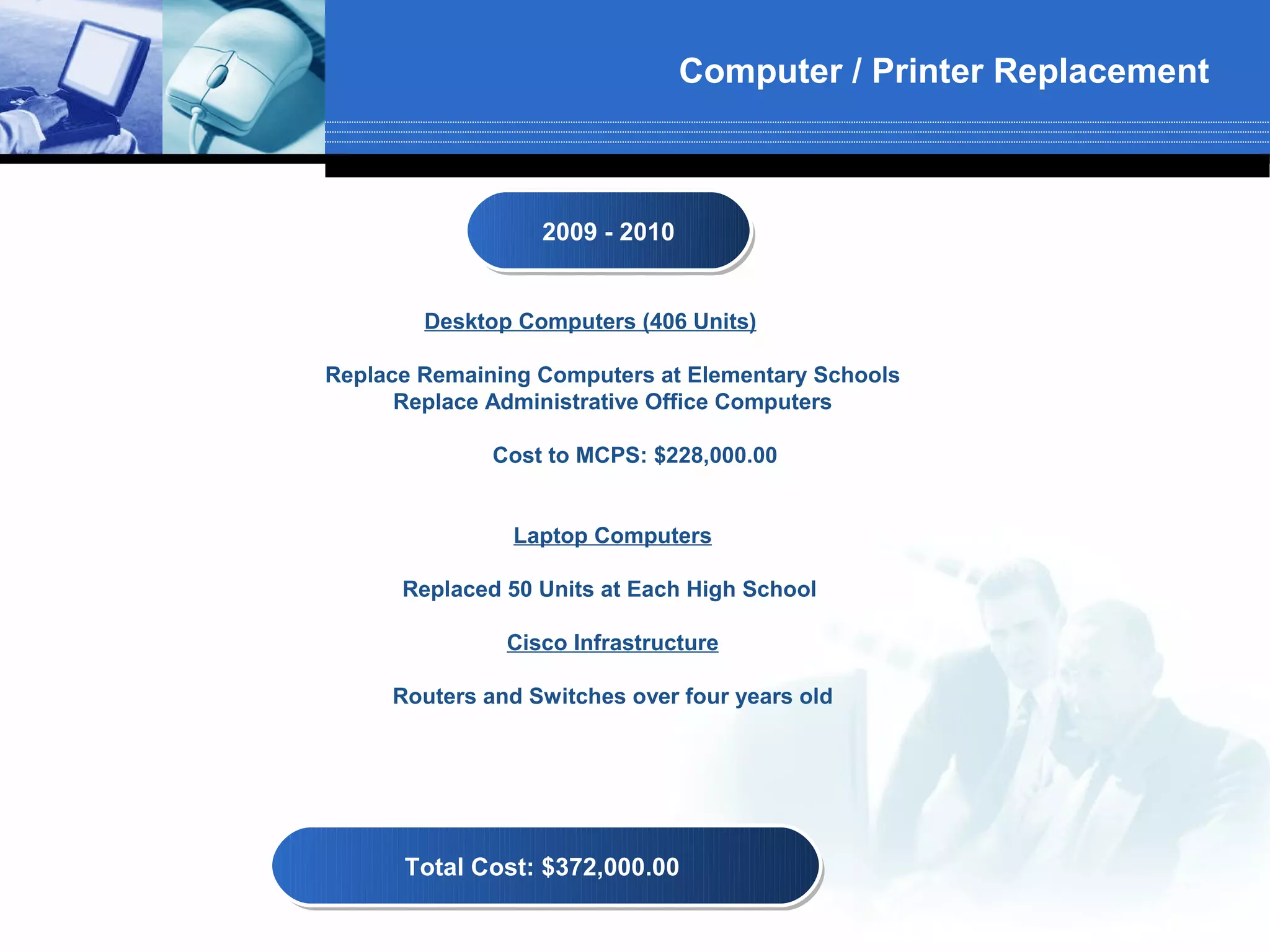

Computer / Printer Replacement

                  2009 -- 2010
                  2009 2010

        Desktop Computers (406 Units)

Replace Remaining Computers at Elementary Schools
      Replace Administrative Office Computers

              Cost to MCPS: $228,000.00

                Laptop Computers

      Replaced 50 Units at Each High School

               Cisco Infrastructure

     Routers and Switches over four years old

      Total Cost: $372,000.00
      Total Cost: $372,000.00

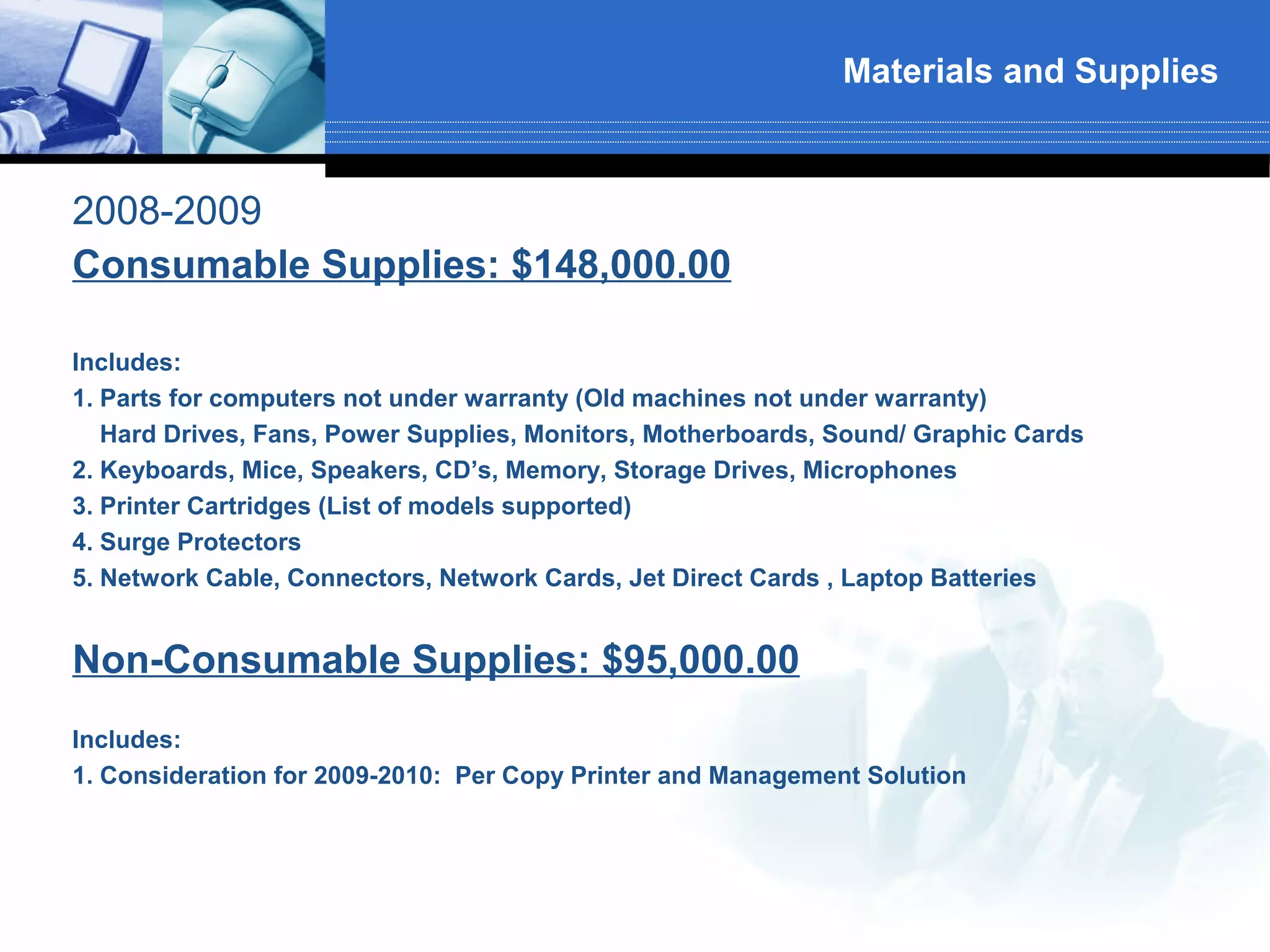

Materials and Supplies

2008-2009
Consumable Supplies: $148,000.00

Includes:
1. Parts for computers not under warranty (Old machines not under warranty)
   Hard Drives, Fans, Power Supplies, Monitors, Motherboards, Sound/ Graphic Cards
2. Keyboards, Mice, Speakers, CD’s, Memory, Storage Drives, Microphones
3. Printer Cartridges (List of models supported)
4. Surge Protectors
5. Network Cable, Connectors, Network Cards, Jet Direct Cards , Laptop Batteries

Non-Consumable Supplies: $95,000.00
Includes:
1. Consideration for 2009-2010: Per Copy Printer and Management Solution
Purchased Services/Communications

 2009-2010

 Purchase Service: $100,000.00
 Includes

    Anti Virus Subscription
    Online Survey Instrument
    Help Desk Trouble Ticket System
    Smart Net on Cisco Equipment
    Printer Repair

Communications: $361,700.00

Data Lines 100 Mb Fiber Connection

Includes:
1. Kinex
2009-2010 Summer Accomplishments

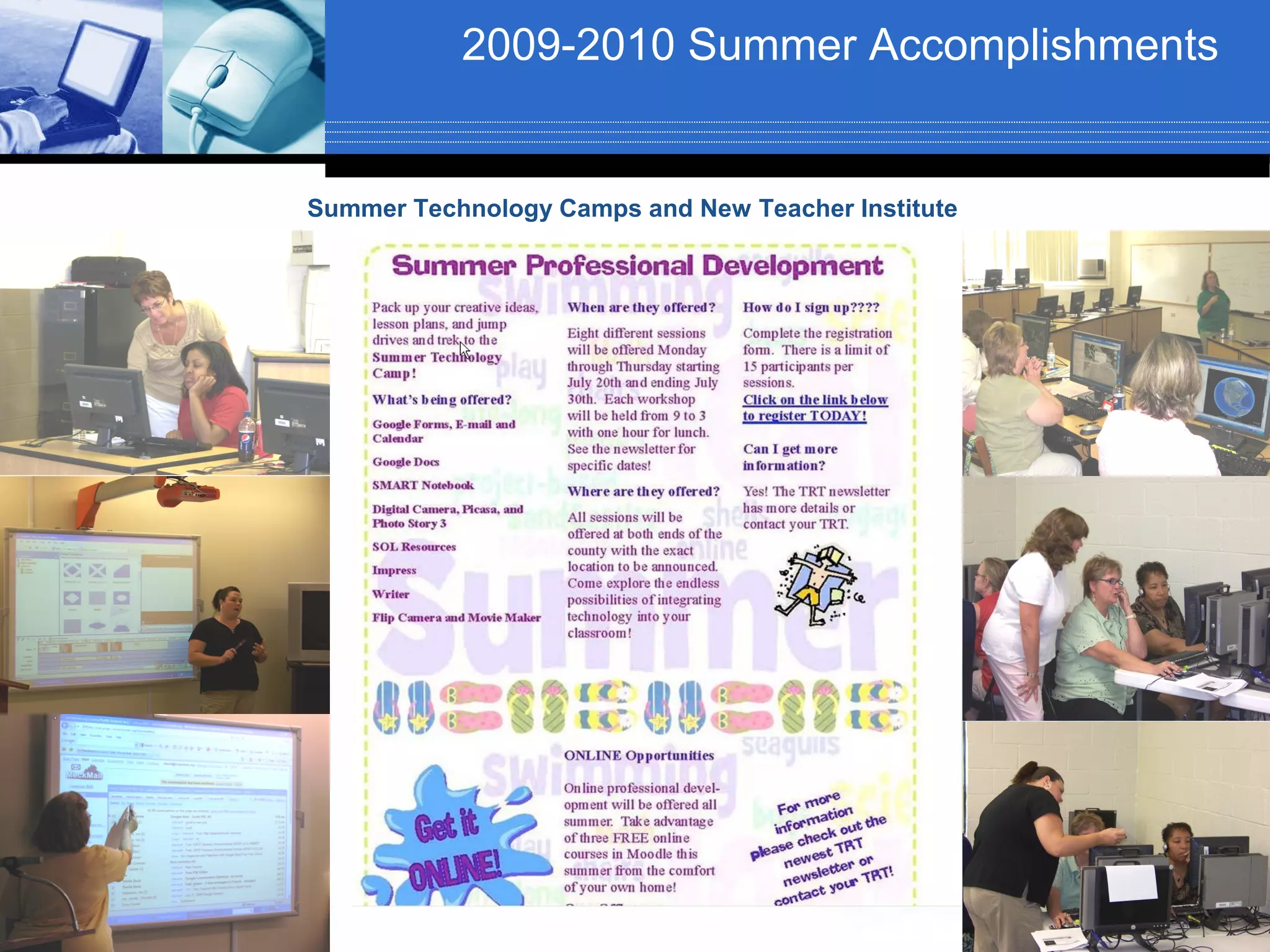

Summer Technology Camps and New Teacher Institute
2009 – 2010 School Year:

              New Local Six Year Plan Aligned With State Plan

                      2013-2014

                                   2014-2015
  2012-2013

                                    2009-2010

2011-1012
                   2010-2011
Department of Technology and Career Education

     Instructional Technology                           Technical Services
   Natalie Coronas: Coordinator                       Bernard Robinson: Manager
   Stephanie Carter: Technology Resource Teacher      Ron Goodwin: Assistant Manager
   Remona Tomko: Technology Resource Teacher          Pam Jackson: Technical Support Services
   Brook Hatcher: Technology Resource Teacher         Drew Coronas: Technical Support Services
   Sheila Beck: Google Implementation Specialist      Ben Webb: Technical Support Service
MCPS Technology Plan 2003-2009

For Additional Information, Please Contact:
Ernie Conner, Director
Technology and Career Education
Mecklenburg County Public Schools
175 Mayfield Drive
Boydton, Virginia 23917
Phone: (434) 738-6111 ext. 241
Email: econner@mcpsweb.org

Tech Presentation 2009 2010 Plans

  • 1.
    Mecklenburg County PublicSchools 2009 Annual Report to the School Board Comprehensive Technology Plan 2003-2009 (Includes Required Update and Alignment Reports) 2009-2010: Vision, Review, Plans and Projections Company LOGO
  • 2.
    2003-2009 Technology Plan 2005-2006 2006-2007 2004-2005 2007-2008 2008-2009
  • 3.
    Technology Plan 2009-2010 June 2009 Technology Plan Update and Alignment Reports were sent to the Virginia Department of Education August 2009 Division Superintendent, M rs. Helen Hill received a letter from the Virginia Department of Education stating that M ecklenburg County School’s Technology Plan was in full alignment with the state’s plan. 2003- 2010 M ecklenburg County Public School’s Technology Plan is available on our website. The Plan is reviewed annually and updates are provided to the M ecklenburg County School Board based on the needs of the students, parents, teachers, and community.
  • 4.
    2003-2010 Technology IntegrationPlan of Action 1. 2008 - 2009 Status Report 2. 2009 - 2010 Plan of Action 3. 2010 - 2011 New State and Local Plan Alignment
  • 5.
  • 6.
    2008-2009 Instructional andAdministrative Technology TECHNOLOGY RESOURCE TEACHERS The Virginia Standards of Quality mandate: that each school division in Virginia provide one technology resource teacher per 1000 students. Student Population: 4668 (March 2009 ADM) Three on Staff in 2008-2009 Amy Newton, Stephanie Carter, and Remona Tomko JOB DESCRIPTION: The Technology Resource Teacher assists teachers and administrators with the integration of technology into the classroom and school, trains teachers and staff to use technology in an effective manner, and assists with curriculum development as it relates to educational technology. The TRT is responsible for modeling instructional strategies with students, providing training and professional development, and developing the curriculum.
  • 7.
    2008-2009 Instructional andAdministrative Technology Ongoing Initiatives Provide Distance Learning Opportunities VIDEO CONFERENCING: HIGH SCHOOL COURSES TAUGHT: Technical Drawing and Design Architectural Drawing and Design Engineering Design. Division wide use of Star Portal online Portal Online Grade Book grade book and reporting system User Guide Onsite Teacher Training Users Manual Training for Principals Star Portal Grade Posting Report Cards Click on the arrow to move Ongoing Support and Training through the instruction at your own pace. CONTINUE
  • 8.
    2008-2009 Instructional and Administrative Technology Ongoing Initiatives Integration of Technology into Classroom Instruction New Teacher Institute Open Office and Google Applications Training Delivered and provided instructions for “jump drive” for all new staff members Individual Teacher Logins, Email, Trouble Ticket System, H Drive Space SEA System for Professional Development Renaissance Place (Includes Accelerated Reader) Study Island Curriculum (Elem. And Middle) Tablet PC – Middle School Math Initiative Smart Board and Interactive White Board Training Atomic Learning For Faculty, Students, and Parents
  • 9.
    2008-2009 Instructional and Administrative Technology Integration of Technology into Classroom Instruction (Cont.)  TRT Connection Resource Webpage  HIT (Helping Integrate Technology) Mini-Sessions  Alcohol Ed – U Program for Students  SOL Test Preparation Workshops  Success Maker Program Training  Developed Technology Newsletter  Installation of Software  Developed Step by Step Instructions and Manuals for Teachers and Staff  Assisted in Integrating Technology into Curriculums by Developing Lesson Plans
  • 10.
    2008-2009 Instructional andAdministrative Technology Ongoing Initiatives Integration of Technology to Accelerate Administrative Tasks •Online Employment Application •Online Forms for Reporting •On Line Technology and Maintenance Trouble Ticket System •Maintained Data Base for Software Installation and CTE Certifications
  • 11.
    2008-2009 Instructional andAdministrative Technology Integration of Technology to Accelerate Administrative Tasks (Cont.) •Created Online Forms and Calendars for Staff •Created Lunch Count Form for Teachers and Café Managers •Provided Support for WIN-Snap Cafeteria Management Program •Alert Now Support and Training and Anonymous Alert Tool •EIMS and other State Reporting Sites Training •Utilized Online Surveys to Improve Current Practices based on stakeholder’s input.
  • 12.
    2008-2009 Instructional andAdministrative Technology - ANNUAL PRIORITY GOAL Internet Safety in Schools: According to Code of Virginia 22.1-70.2, we must include a component on Internet Safety in our acceptable use policies. DOE Implementation Plan (Supts. Memo: 69 March 23, 2007)  June 2007: Statement to the DOE confirming that a statement is included in our AUP and a plan has been developed.  Statement included in updated policy proposal. Submitted to the school board as information in April 2007. Approved May 2007.  Curriculum plan developed by Technology Department. Completed: June 1, 2007.  2008-2009: Division will implemented and reviewed the progress of the program  Action  Technology Team will include this mandate as a priority goal for Technology Resource Teachers.
  • 13.
    2008-2009 Instructional andAdministrative Technology Priority Goal Accomplishments Utilized a comprehensive guide for every grade level that correlated each Internet safety objective with the SOL. MCPS developed a partnership with i-Safe Inc. and developed an Internet safety curriculum for all grade levels.
  • 14.
    2008-2009 Instructional andAdministrative Technology Priority Goal Accomplishments A Computer Crimes Investigator from the Attorney Generals Office spoke to all Mecklenburg County’s High and Middle School Students about the dangers of the Internet and current issues that students face online. Other implementation strategies included faculty newsletters, informational brochures, exhibits and live demonstrations at the South Central Fair, parent newsletters, Internet safety rules wallpaper on student computers, PTA presentations, faculty workshops and an online professional development course.
  • 15.
    2008-2009 Instructional andAdministrative Technology Priority Goal Accomplishments The online professional development course provides teachers with the opportunity to earn recertification credit while gaining knowledge on the six concepts of the MCPS Internet Safety curriculum as well as the opportunity to receive the i-Safe certification. Special programs on Internet Safety were presented to Elementary School students
  • 16.
    2008-2009 Instructional andAdministrative Technology Priority Goal Accomplishments  Updated Acceptable Use Policy for Students, Parents, and Employees to Include Internet Safety
  • 17.
    2008-2009 Priority Goal Implementation of Google Applications and other free and open source software into instructional and administrative operations.  Productivity Investment Fund Grant  Google Applications Implementation Specialist  $50,000 One Year Grant
  • 18.
    Productivity Investment Fund Implementation of Google Applications for Education Savings of $200,000 over a five year period Collaborative Environment for Students and Staff Example for Other Divisions in Virginia
  • 19.
    Productivity Investment Fund Virginia Open Classroom Administrative Instructional Email – Large Storage Accounting Class: Park View High – School in Oregon Shared Calendars Personal Finance Class: Bluestone High School: Informational Websites Managing a Household Budget Project Online Forms: Self Graded Assessments Park View Middle School: Google Earth Virtual Field Shared Instructional Documents Trip Project Technical Help Desk Project: Park View High School Websites for Journals: Bluestone High School English Bluestone Middle School Power Hour
  • 20.
    2008-2009 Presentations  February 2009 – Virginia Society for Technology in Education – Virginia Beach, Virginia  Get Your I on Google Docs: Amy Newton and Stephanie Carter  February 2009 – Ed Tech Conference – Randolph Macon College  Using Free and Open Source Resources in the 21st Century Classroom: Stephanie Carter and Ernie Conner  Connecting and Collaborating with Google Applications: Chad Wollenberg and Sheila Beck  February 2009 – Mecklenburg County Business Education Partnership, South Hill Va.  Google Applications in MCPS: Sheila Beck and Remona Tomko  Conference Presentations  April 2009 – Region 8 Technology Full Day  December 2008 – Virginia Department of Workshop – Nottoway High School Education Technology Leadership Conference  Connecting and Collaborating with Google Applications: – Roanoke, Virginia Remona Tomko, Stephanie Carter, and Sheila Beck  Server Virtualization – Saving Time and Money While Going Green: Chad Wollenberg and Ernie Conner   March 2009 – School Division Visits: Google Open Source Mash up – A Discussion about Open Source Technologies: Chad Wollenberg Applications Implementation  Implementing Google Applications – Trials, Tribulations, and  Powhatan County Schools Triumphs: Chad Wollenberg, Ernie Conner, and Sheila Beck  Botetourt County Schools  Connecting and Collaborating with Google Applications: Remona Tomko, Sheila Beck and Ernie Conner  Franklin City Schools  Presented 2nd Session because of high demand
  • 21.
    Computer Replacement Scheduleand Technical Services 2008-2009 Company LOGO
  • 22.
    2008-2009 Technical Services– Service Calls Technical Support Team has responded to 3596 trouble tickets from staff since July 1, 2007. 3593 of the tickets (99%) have been closed. (June 30, 2009)
  • 23.
    2008-2009 Service Calls: Breakdown by School
  • 24.
    2008-2009 Technical Services Technical Services  Domain Upgrade: The entire network was moved off of the mcps.com domain, and on to the meck.local domain to ensure no conflicts with existing domains. Changed from meck.k12.va.us to mcpsweb.org. Added mcpsweb.net for students  Email Migration:. All email was migrated from Exhange 2003 to the Gmail platform, offsetting costs and management of the server.  New Central Office Migrated computers and networking from the old to the new location  Designed and updated security settings on all computers. Implemented logins for all staff users to access computers at different levels. Consolidated operating systems to Windows XP.  SIF and Winsnap server implementation:. The department continued it support, and roll-out of these systems.  Voice over IP (Beta): IP Phones maintained in each school. Communications between schools and departments.  Implemented FOG image solution: Saved $30,000 (Cost of purchasing Acronis licenses)  Virtual Server Implementation; Virtual Server Solution expanded to School Level  DELL TIER II Support: $9370 reimbursement (July 2008- June 2009)
  • 25.
    2008-2009 Technical Services  Comprehensive website is being maintained. Includes: Online News Link, Calendars, Informational and Instructional Links for Students, Parents, Community, and Teachers, Documents Link.  Maintained Online Inventory Tracking System  Backup and Storage: Expanded Storage Capacity for student and staff files. Department Drives  Certified by the Virginia Department of Education to provide online SOL testing on all levels. Online Testing done on the Elementary School level in 2009.
  • 26.
    Computers Replaced onFour Year Rotation 2004-2005: Infrastructure and 30 Computers each Elementary School 2005-2006: All Remaining Computers at Elementary Schools and High School Laptops 2006-2007: High School Computers, Middle School Laptops and Laptops at CCE and CLE 2007-2008: Middle School Computers, Laptops at SHE, LCE, BUE, BOE, and School Board 2008-2009: 30 Computers at each Elementary School and Selected Infrastructure Old machines are placed in other schools as secondary machines
  • 27.
    Computer / Printerand Equipment Replacement 2008 -- 2009 2008 2009  Desktop Computers  Replaced Computers at Elementary Schools: 150 units  Laptop Computers  Replaced Laptops for Technical Support Staff: 5 units  Servers and Infrastructure  Replaced Servers: 5 Elementary Schools  Replaced 5 Switches  Replaced blades in Cisco Equipment  Other Expenses Wireless Access Point Upgrades and Additions Battery Backups at all Schools Total Cost: $374,678.00 Total Cost: $374,678.00
  • 28.
    Materials and Supplies 2008-2009 ConsumableSupplies: $148,000.00 Includes: 1. Parts for computers not under warranty (Old machines not under warranty) Hard Drives, Fans, Power Supplies, Monitors, Motherboards, Sound/ Graphic Cards 2. Keyboards, Mice, Speakers, CD’s, Memory, Storage Drives, Microphones 3. Printer Cartridges (List of models supported) 4. Surge Protectors 5. Network Cable, Connectors, Network Cards, Jet Direct Cards , Laptop Batteries Non-Consumable Supplies: $95,000.00 Includes: 1. Cameras and Projectors: $13,331.00 2. Net Trekker: $9820.00 3. St. Bernard Filtering Content Application: $17,865.00 4. Edu Structures: SIF: $1363.00 5. VM Ware and Windows Server Licenses: $6744.00 6. Educational Software: $11,525.00 7. Study Island Renewal: $18,367.00 8. Other: $15,985
  • 29.
    Purchased Services 2008-2009 Purchase Service:$100,000.00 Includes: 1. Star Student and Portal: $22,915.00 2. Spectrum Renewal: $3852.00 3. Gaggle Archiving System: $9,300.00 4. Smart Net on Existing Cisco Equipment: $18579.00 5. Online Employment Application: $6500.00 6. How to Master Online Professional Dev: $11,025.00 7. Trouble Ticket System Renewal: $5520.00 8. Explore Learning Gizmos Prof Dev: $1500.00 9. Symantec Anti-Virus: $17,760.00 9. Other: $3049.00 Communications: $361,700 Data Lines (100 Mg Fiber) Kinex
  • 30.
    2008-2009 Accolades andHonors The Mecklenburg County School’s Technology Department was awarded the Southern Virginia Regional Technology Consortium's 2009 Division Technology Leadership Award Mark Eckler, Teacher at Bluestone Middle School, was awarded the Southern Virginia Regional Technology Consortium's Technology Award Bernard Robinson, Technical Support Specialist, was awarded the Southern Virginia Regional Technology Consortium's Technical Support Award Article Appeared in Virginia Business Journal on Google Applications Implementation in Mecklenburg County Schools
  • 31.
    2009 – 2010School Year 2006-2007 2007-2008 2005-2006 2008-2009 2004-2005 2003-2004 2009-2010 Transition Year
  • 32.
    2009-2010 INSTRUCTIONAL TECHNOLOGY Support Star Portal online grade book and reporting system •Train teachers to use and implement progress reports Develop Lesson Plans Integrating Technology Into the Classroom •Setup and work with teams of teachers to develop lesson plans correlated by SOL. •Develop online lesson plan library to provide easy access for teachers. •Assist individual teachers to implement technology integrated lesson plans in the classroom. •Collaborate with Instructional Coordinators to Use Technology Tools to Improve Student Performance Implement Internet Safety Curriculum: Virginia Department of Education Mandates •Provide training and resources to teachers •Assist Principals and teachers with implementation Implement New and Innovative Technology into the School Division • Implementation of Promethean Boards into Classrooms. • Support New and Updated Educational Programs (Interactive Achievement, Learn 360) •Updated Ren Place, Success Maker, •Implement Additional Google Applications for Education programs
  • 33.
    2009 – 2010Technical Services Initiatives TECHNICAL SERVICES  Expand Web Services  Open Source and free software used to develop and maintain services  Utilize additional Google Apps services to improve efficiency  Increased multimedia capabilities on Meckmoodle to allow richer online course content  Ideas.mcpsweb.org ideas site for Mecklenburg County to promote new ideas for the district  Integrate Google Apps into existing web sites  Increase Efficiency of Network  Utilize the additional bandwidth that the new fiber infrastructure provides  Review and revise policies for antivirus updates and Windows updates  Core network equipment upgrade  All routers and core switches replaced  Wiring of High Schools and Central Office  Network Development  Win Snap Cafeteria POS system expanded to additional schools  Utilize open source backup utilities  Investigate Firewall replacement products  Research and Development  Virtualization technologies  VOIP Phone System  High Def Video streaming and Video conferencing  Online SOL Testing  Provide Support for all schools to conduct online SOL testing
  • 34.
    Computer / PrinterReplacement 2009 -- 2010 2009 2010 Desktop Computers (406 Units) Replace Remaining Computers at Elementary Schools Replace Administrative Office Computers Cost to MCPS: $228,000.00 Laptop Computers Replaced 50 Units at Each High School Cisco Infrastructure Routers and Switches over four years old Total Cost: $372,000.00 Total Cost: $372,000.00
  • 35.
    Materials and Supplies 2008-2009 ConsumableSupplies: $148,000.00 Includes: 1. Parts for computers not under warranty (Old machines not under warranty) Hard Drives, Fans, Power Supplies, Monitors, Motherboards, Sound/ Graphic Cards 2. Keyboards, Mice, Speakers, CD’s, Memory, Storage Drives, Microphones 3. Printer Cartridges (List of models supported) 4. Surge Protectors 5. Network Cable, Connectors, Network Cards, Jet Direct Cards , Laptop Batteries Non-Consumable Supplies: $95,000.00 Includes: 1. Consideration for 2009-2010: Per Copy Printer and Management Solution
  • 36.
    Purchased Services/Communications 2009-2010 Purchase Service: $100,000.00 Includes  Anti Virus Subscription  Online Survey Instrument  Help Desk Trouble Ticket System  Smart Net on Cisco Equipment  Printer Repair Communications: $361,700.00 Data Lines 100 Mb Fiber Connection Includes: 1. Kinex
  • 37.
    2009-2010 Summer Accomplishments SummerTechnology Camps and New Teacher Institute
  • 38.
    2009 – 2010School Year: New Local Six Year Plan Aligned With State Plan 2013-2014 2014-2015 2012-2013 2009-2010 2011-1012 2010-2011
  • 39.
    Department of Technologyand Career Education Instructional Technology Technical Services  Natalie Coronas: Coordinator  Bernard Robinson: Manager  Stephanie Carter: Technology Resource Teacher  Ron Goodwin: Assistant Manager  Remona Tomko: Technology Resource Teacher  Pam Jackson: Technical Support Services  Brook Hatcher: Technology Resource Teacher  Drew Coronas: Technical Support Services  Sheila Beck: Google Implementation Specialist  Ben Webb: Technical Support Service
  • 40.
    MCPS Technology Plan2003-2009 For Additional Information, Please Contact: Ernie Conner, Director Technology and Career Education Mecklenburg County Public Schools 175 Mayfield Drive Boydton, Virginia 23917 Phone: (434) 738-6111 ext. 241 Email: econner@mcpsweb.org
