SwissQ Agile Trends &
Benchmarks Switzerland 2012
Where are we now – where are we going to?
TABLE OF CONTENTS                      SwissQ Agile Trends & Benchmarks 2012 2

        3   EDITORIAL
        4   TRENDWAVE 2012
        5   KEY MESSAGES
        6   PROJECTS
        7   EXPERIENCE
        8   IMPLEMENTATION
        9   OBSTACLES

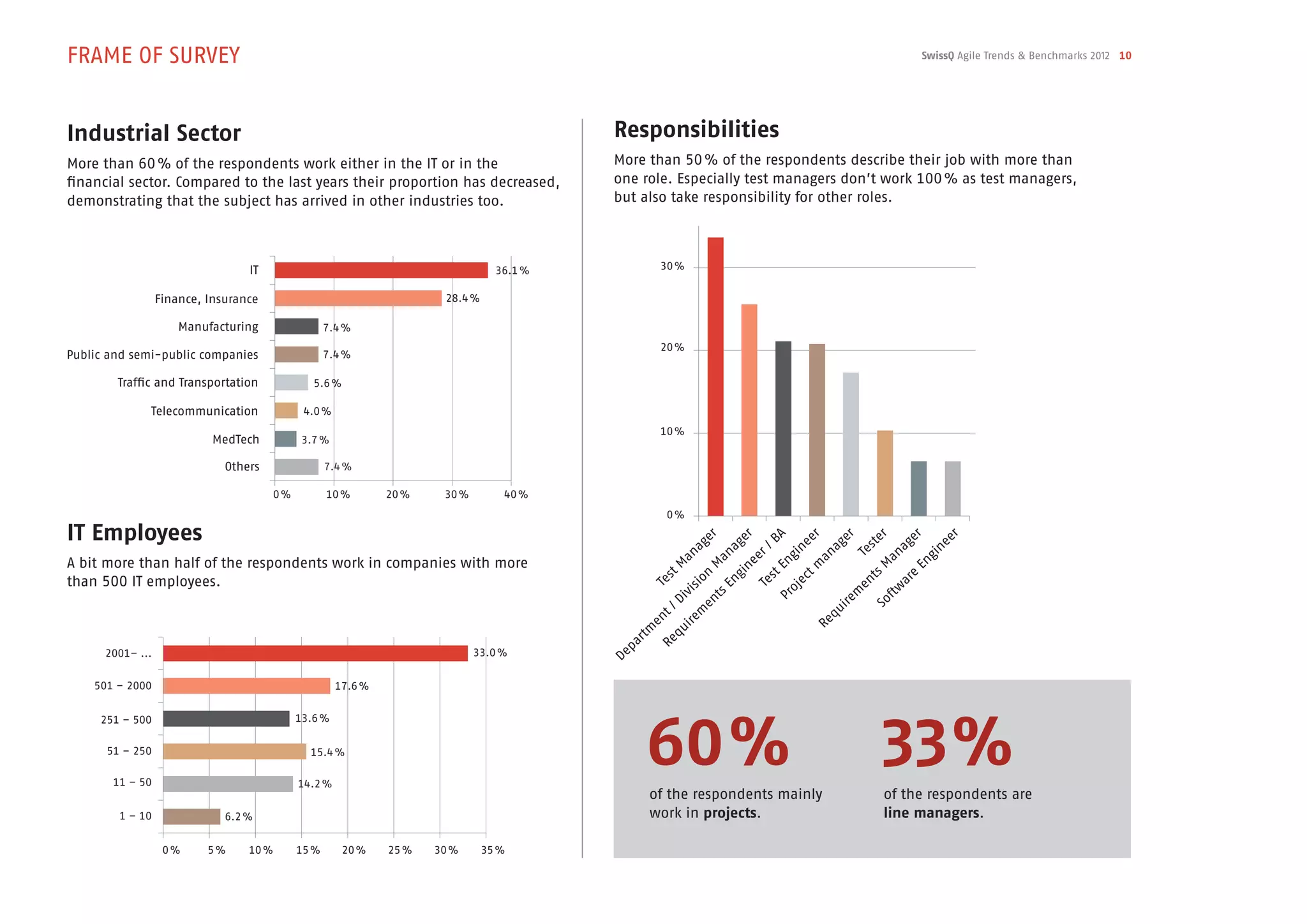

       10   FRAME OF SURVEY
       11   TESTING AND REQUIREMENTS

EDITORIAL                                                                                                                                  SwissQ Agile Trends & Benchmarks 2012 3

Agility resounds throughout the land – there are those who adore it and there might be others who don‘t like it so much. Each to their own.
However, how does the agile landscape look like in the Swiss IT Community? Let the Trends and Benchmarks of our current survey sink in,
discuss about it and draw your own conclusions.

“Agility: Flexibility takes over from planning”, the Financial Times predicted on      Whereas many are still indifferent to the agile movement, others already pay a
20 November 2007. This came true sooner than many expected. More than ever             lot of attention to Scrum. Topics like using Sprints or the roles of Developers and
before, modern organizations are challenged to respond pro-actively to the fast        Scrum Masters are established and almost “daily business“.
changes of today‘s global and strongly interlinked world. Plans become waste
paper before they even had a chance of being realized. The adaption of and the         Two of the main topics, which are currently being worked on intensively, are the
reaction to change is a top priority. This fast and continuous modification of         Definition of Done and the Product Owner Role. The Definition of Done advanced
business models also challenges the backbone of any company: the IT.                   rapidly by considering it as a quality gate and by incorporating acceptance criteria.
                                                                                       The Product Owner is recognized more and more in his role as a key player and
Agile approaches, in particular Scrum, have hit the nail on the head. In the last      therefore is challenged to a greater extent. In the end it is his work which forms
years, the “Lean & Agile“ approach significantly gained momentum. A lot is             the basis for a successful product and for the acceptance by the end user.
promised, a lot is set up, but the expectations are often not met. It seems that the
reality is much more complex and laborious than books and shiny presentations          An amassing of topics can be noticed in the growth-sector of the Trend Wave.
let you believe. The report at hand is based on a survey with more than 300            The restricted view from just one Sprint to the next Sprint is slowly being replaced
participants and numerous interviews with IT-executives. Thus, it presents facts.      by transparent overall planning and efficient backlog management. Thus, the
It shows, where agility stands in Switzerland today, what difficulties the             overall view of the product is becoming more focused. In addition to that, new
community faces day after day and which topics are being actively pursued.             ways of collaboration are being tried out in terms of place or discipline.
                                                                                       Keywords on this would be: online collaboration and co-location, and accordingly
The benchmarks depicted in a multitude of informative charts and diagrams form         embedded Scrum testers and agile requirements engineers.
the backbone of this report and allow you to position your company in comparison
to others.                                                                             In addition there are topics whose future trend development is not yet assessable.
                                                                                       Or were you concerned with Management 3.0 before?
In order to show the currentness of the examined topics, we use the SwissQ Trend
Wave®. It shows in four phases how select topics will most likely develop over time    We wish you lots of interesting findings by reading the agile report and lots of fun
and in turn allows you to appraise the influence of these trends on your business.     on your way to more flexibility and agility.

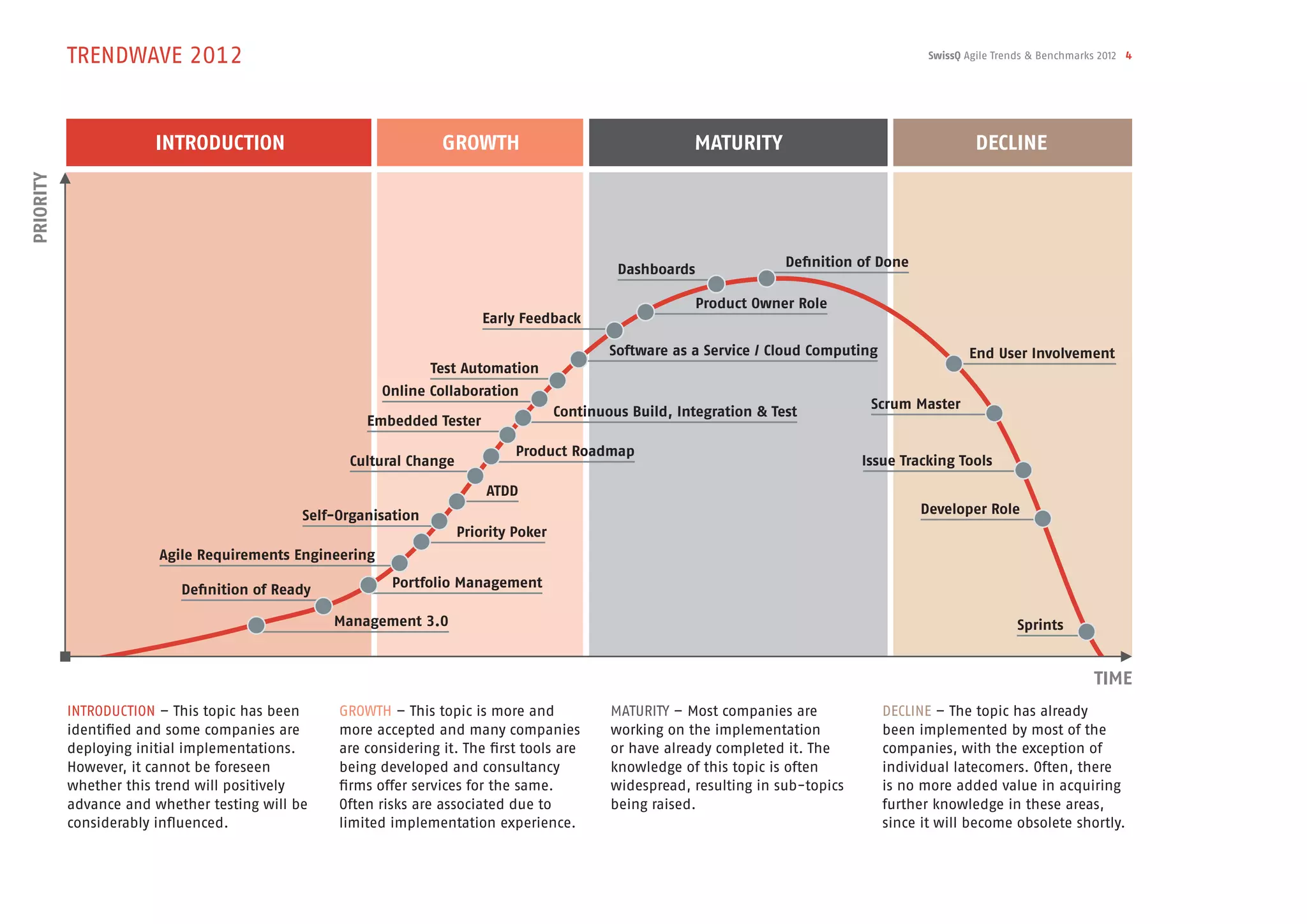

TRENDWAVE 2012                                                                                                                      SwissQ Agile Trends & Benchmarks 2012 4

                       INTRODUCTION                               GROWTH                                  MATURITY                                      DECLINE
PRIORITY

                                                                                               Dashboards               Definition of Done

                                                                                                            Product Owner Role
                                                                         Early Feedback

                                                                                              Software as a Service / Cloud Computing                 End User Involvement
                                                                 Test Automation
                                                         Online Collaboration
                                                                                                                                     Scrum Master
                                                                                      Continuous Build, Integration & Test
                                                      Embedded Tester

                                                                              Product Roadmap
                                                   Cultural Change                                                                  Issue Tracking Tools

                                                                         ATDD
                                             Self-Organisation                                                                               Developer Role
                                                                     Priority Poker
                        Agile Requirements Engineering

                           Definition of Ready            Portfolio Management

                                                 Management 3.0                                                                                                 Sprints

                                                                                                                                                                              TIME
           INTRODUCTION – This topic has been     GROWTH – This topic is more and             MATURITY – Most companies are             DECLINE – The topic has already
           identified and some companies are      more accepted and many companies            working on the implementation             been implemented by most of the
           deploying initial implementations.     are considering it. The first tools are     or have already completed it. The         companies, with the exception of
           However, it cannot be foreseen         being developed and consultancy             knowledge of this topic is often          individual latecomers. Often, there
           whether this trend will positively     firms offer services for the same.          widespread, resulting in sub-topics       is no more added value in acquiring
           advance and whether testing will be    Often risks are associated due to           being raised.                             further knowledge in these areas,
           considerably influenced.               limited implementation experience.                                                    since it will become obsolete shortly.

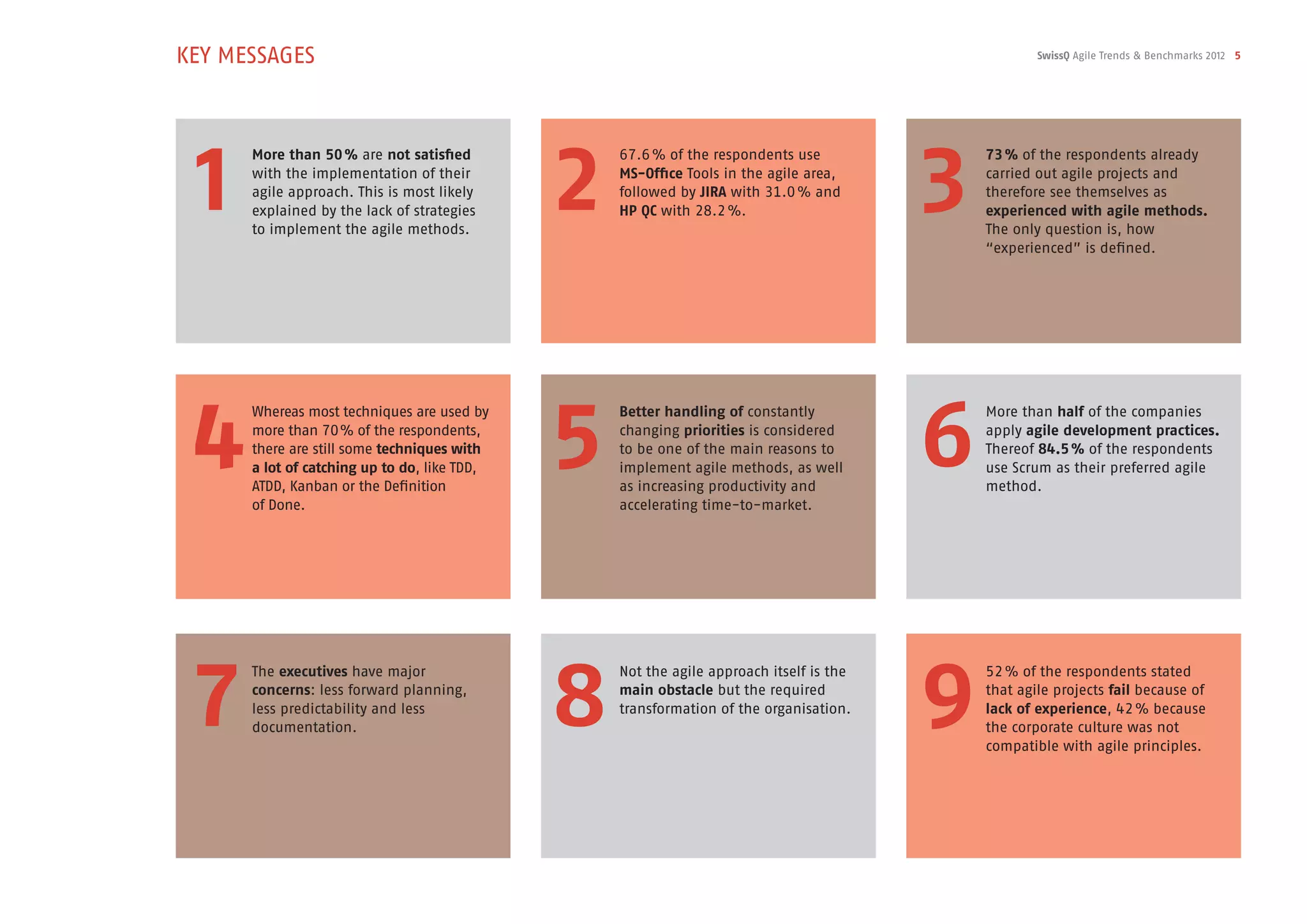

KEY MESSAGES                                                                                         SwissQ Agile Trends & Benchmarks 2012 5

 1                                            2                                          3
      More than 50 % are not satisfied            67.6 % of the respondents use              73 % of the respondents already
      with the implementation of their            MS-Office Tools in the agile area,         carried out agile projects and
      agile approach. This is most likely         followed by JIRA with 31.0 % and           therefore see themselves as
      explained by the lack of strategies         HP QC with 28.2 %.                         experienced with agile methods.
      to implement the agile methods.                                                        The only question is, how
                                                                                             “experienced” is defined.

 4                                            5                                          6
      Whereas most techniques are used by         Better handling of constantly              More than half of the companies
      more than 70 % of the respondents,          changing priorities is considered          apply agile development practices.
      there are still some techniques with        to be one of the main reasons to           Thereof 84.5 % of the respondents
      a lot of catching up to do, like TDD,       implement agile methods, as well           use Scrum as their preferred agile
      ATDD, Kanban or the Definition              as increasing productivity and             method.
      of Done.                                    accelerating time-to-market.

 7                                            8                                          9
      The executives have major                   Not the agile approach itself is the       52 % of the respondents stated
      concerns: less forward planning,            main obstacle but the required             that agile projects fail because of
      less predictability and less                transformation of the organisation.        lack of experience, 42 % because
      documentation.                                                                         the corporate culture was not
                                                                                             compatible with agile principles.

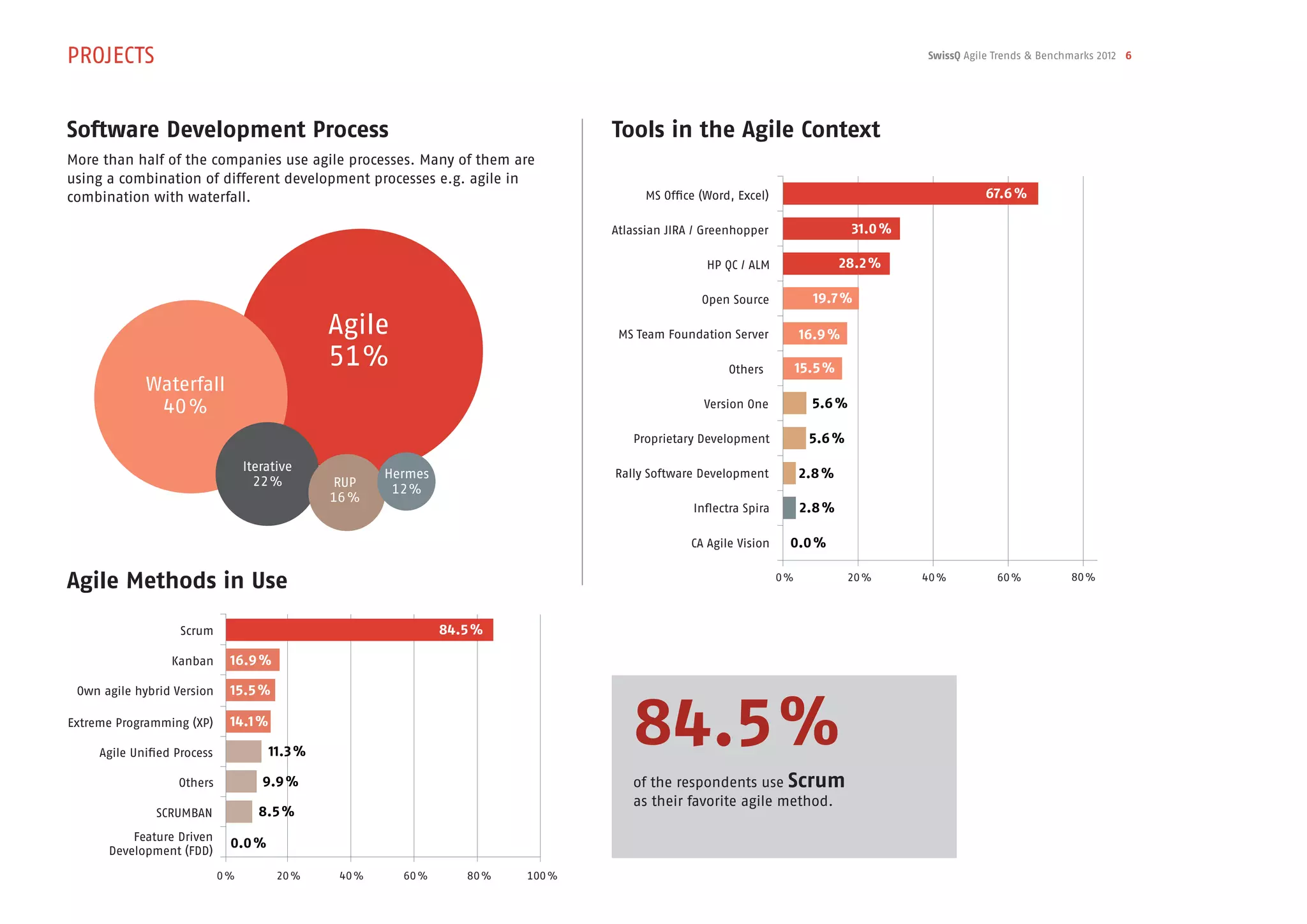

PROJECTS                                                                                                                                      SwissQ Agile Trends & Benchmarks 2012 6

Software Development Process                                                        Tools in the Agile Context
More than half of the companies use agile processes. Many of them are
using a combination of different development processes e.g. agile in
combination with waterfall.                                                               MS Office (Word, Excel)                                        67.6 %

                                                                                    Atlassian JIRA / Greenhopper                    31.0 %

                                                                                                     HP QC / ALM                   28.2 %

                                                                                                    Open Source             19.7 %

                                                 Agile                               MS Team Foundation Server            16.9 %
                                                 51 %                                                    Others           15.5 %
             Waterfall
              40 %                                                                                  Version One             5.6 %

                                                                                       Proprietary Development              5.6 %
                                   Iterative
                                                         Hermes                     Rally Software Development            2.8 %
                                     22 %        RUP      12 %
                                                 16 %
                                                                                                  Inflectra Spira         2.8 %

                                                                                                  CA Agile Vision     0.0 %

Agile Methods in Use                                                                                                0 %             20 %     40 %          60 %          80 %

                   Scrum                                          84.5 %

                  Kanban       16.9 %

                                                                                       84.5 %
 Own agile hybrid Version      15.5 %

Extreme Programming (XP)       14.1 %

     Agile Unified Process              11.3 %

                   Others             9.9 %                                            of the respondents use Scrum
                                                                                       as their favorite agile method.
               SCRUMBAN              8.5 %
          Feature Driven
                               0.0 %
      Development (FDD)
                             0 %         20 %     40 %     60 %      80 %   100 %

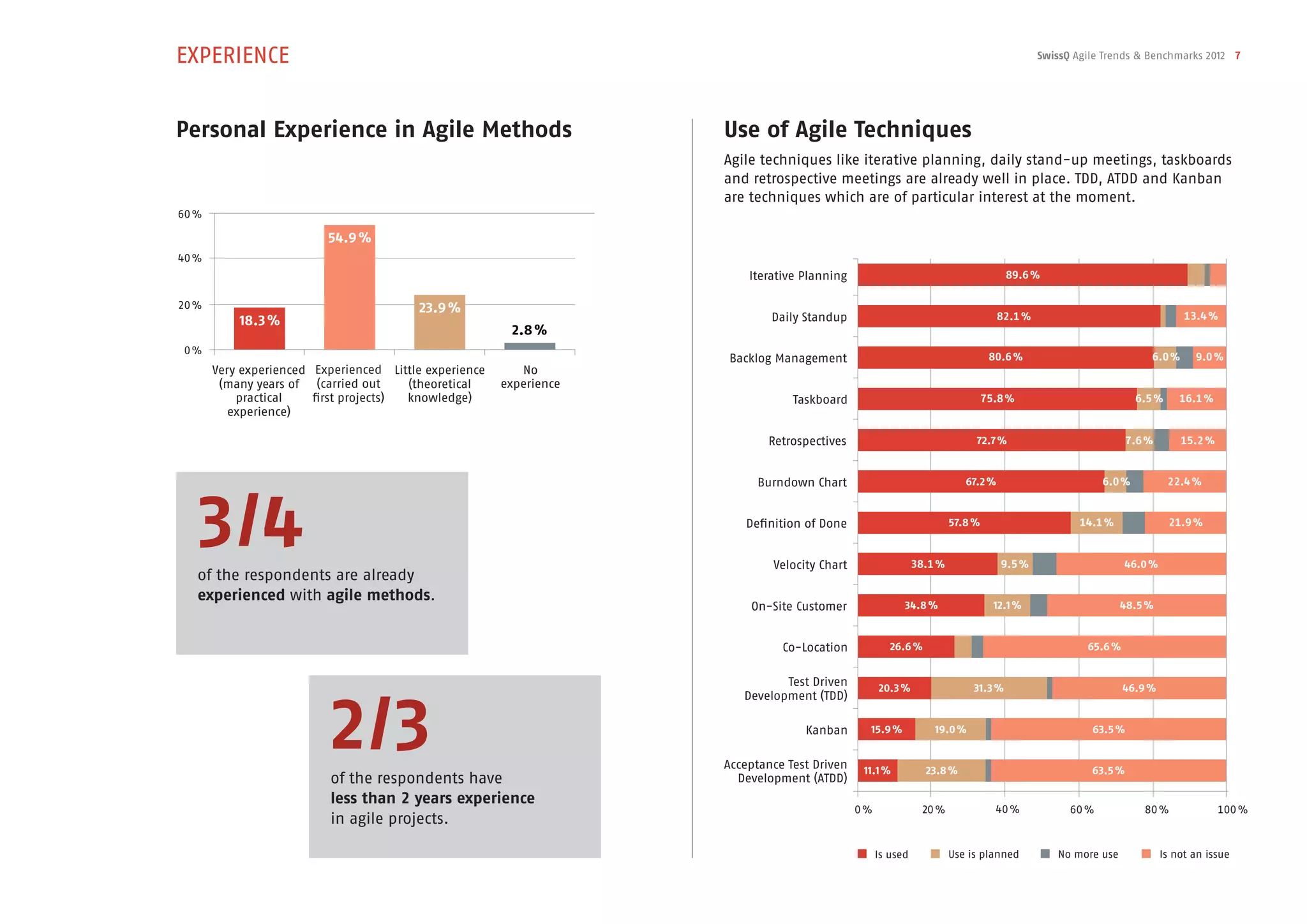

EXPERIENCE                                                                                                                                  SwissQ Agile Trends & Benchmarks 2012 7

Personal Experience in Agile Methods                                 Use of Agile Techniques
                                                                     Agile techniques like iterative planning, daily stand-up meetings, taskboards
                                                                     and retrospective meetings are already well in place. TDD, ATDD and Kanban
                                                                     are techniques which are of particular interest at the moment.
60 %

                          54.9 %
40 %
                                                                         Iterative Planning                                          89.6 %

20 %                                     23.9 %
           18.3 %                                                            Daily Standup                                         82.1 %                                   13.4 %
                                                         2.8 %
 0 %
                                                                     Backlog Management                                          80.6 %                             6.0 %     9.0 %
       Very experienced Experienced Little experience      No
        (many years of (carried out     (theoretical    experience
           practical    first projects) knowledge)                               Taskboard                                      75.8 %                           6.5 %     16.1 %
          experience)

                                                                            Retrospectives                                  72.7 %                             7.6 %        15.2 %

                                                                          Burndown Chart                                  67.2 %                         6.0 %           22.4 %

   3/4
   of the respondents are already
                                                                        Definition of Done

                                                                             Velocity Chart                   38.1 %
                                                                                                                       57.8 %

                                                                                                                                   9.5 %
                                                                                                                                                    14.1 %

                                                                                                                                                              46.0 %
                                                                                                                                                                         21.9 %

   experienced with agile methods.
                                                                         On-Site Customer                 34.8 %                  12.1 %                     48.5 %

                                                                               Co-Location             26.6 %                                        65.6 %

                                                                               Test Driven

                          2/3
                                                                                                    20.3 %                  31.3 %                            46.9 %
                                                                        Development (TDD)

                                                                                   Kanban       15.9 %            19.0 %                              63.5 %

                                                                     Acceptance Test Driven    11.1 %           23.8 %                                63.5 %
                          of the respondents have                      Development (ATDD)
                          less than 2 years experience
                                                                                              0 %              20 %               40 %            60 %            80 %               100 %
                          in agile projects.

                                                                                                    Is used            Use is planned          No more use             Is not an issue

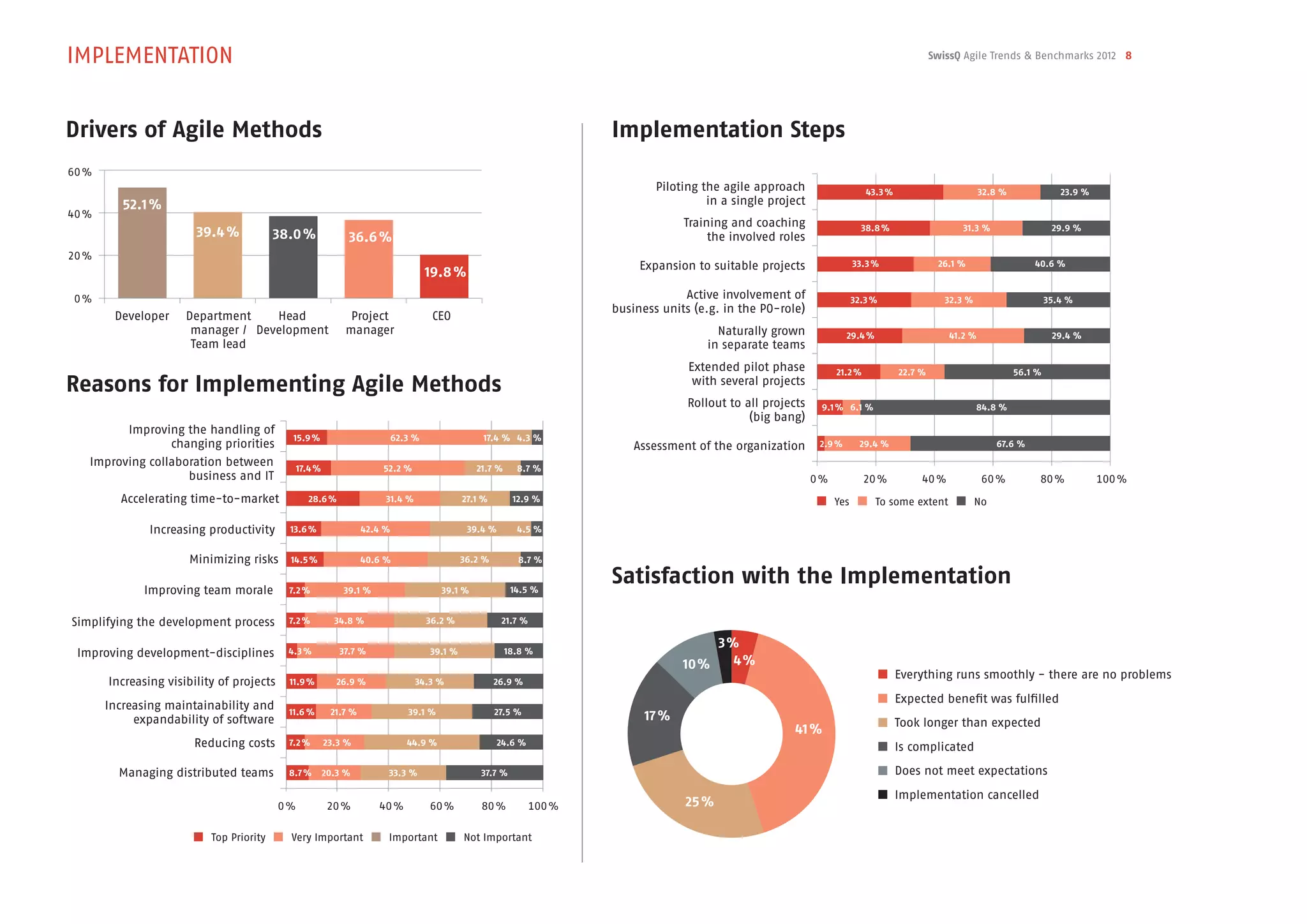

IMPLEMENTATION                                                                                                                                                                                               SwissQ Agile Trends & Benchmarks 2012 8

Drivers of Agile Methods                                                                                                           Implementation Steps
60 %
                                                                                                                                           Piloting the agile approach                    43.3 %                           32.8  %                 23.9  %
          52.1 %                                                                                                                                     in a single project
40 %
                                                                                                                                                Training and coaching                    38.8 %                     31.3  %                     29.9  %
                        39.4 %            38.0 %                36.6 %                                                                               the involved roles
20 %
                                                                                                                                        Expansion to suitable projects                 33.3 %                 26.1  %                     40.6  %
                                                                                          19.8 %
 0 %                                                                                                                                            Active involvement of                  32.3 %                   32.3  %                        35.4  %
                                                                                                                                   business units (e.g. in the PO-role)
        Developer     Department    Head                        Project                    CEO
                       manager / Development                   manager                                                                                 Naturally grown              29.4 %                       41.2  %                         29.4  %
                       Team lead                                                                                                                     in separate teams
                                                                                                                                                 Extended pilot phase            21.2 %            22.7  %                           56.1  %
Reasons for Implementing Agile Methods                                                                                                            with several projects
                                                                                                                                                 Rollout to all projects    9.1 % 6.1  %                                  84.8  %
                                                                                                                                                             (big bang)
         Improving the handling of
                                             15.9 %                             62.3  %                   17.4  % 4.3  %
                 changing priorities                                                                                                   Assessment of the organization       2.9 %        29.4  %                               67.6  %

   Improving collaboration between               17.4 %                    52.2  %                      21.7  %      8.7  %
                    business and IT                                                                                                                                        0 %            20 %           40 %              60 %            80 %              100 %
         Accelerating time-to-market               28.6 %                   31.4  %                  27.1  %        12.9  %                                                      Yes         To some extent               No

               Increasing productivity       13.6 %                   42.4  %                         39.4  %        4.5  %

                      Minimizing risks       14.5 %                   40.6  %                        36.2  %         8.7  %

              Improving team morale         7.2 %              39.1  %                        39.1  %               14.5  %
                                                                                                                                   Satisfaction with the Implementation
Simplifying the development process         7.2 %            34.8  %                      36.2  %                21.7  %

                                                                                                                                                       3 %
 Improving development-disciplines          4.3 %             37.7  %                      39.1  %                18.8  %
                                                                                                                                                10 %      4 %
                                                                                                                                                                                                   Everything runs smoothly - there are no problems
       Increasing visibility of projects    11.9 %           26.9  %                  34.3  %                  26.9  %
                                                                                                                                                                                                   Expected benefit was fulfilled
       Increasing maintainability and       11.6 %          21.7  %                 39.1  %                    27.5  %
            expandability of software                                                                                                    17 %                                                      Took longer than expected
                                                                                                                                                                      41 %
                       Reducing costs       7.2 %         23.3  %                  44.9  %                      24.6  %
                                                                                                                                                                                                   Is complicated

         Managing distributed teams         8.7 %         20.3  %           33.3  %                       37.7  %                                                                                  Does not meet expectations
                                                                                                                                                                                                   Implementation cancelled
                                           0 %             20 %           40 %            60 %            80 %             100 %                25 %

                           Top Priority      Very Important                 Important                Not Important
OBSTACLES                                                                                                                                                                           SwissQ Agile Trends & Benchmarks 2012 9

  The Biggest Concerns                                                                                           Main Implementation Obstacles

           No / less forward planning                                              41 %
                                                                                                                              Ability to change the
                                                                                                                                                                                                     55 %
                                                                                                                             organizational culture
Necessity to change management style                                          37 %
                                                                                                                                                                                         39 %
                                                                                                                      General resistance to change
                    Less predictability                                     32 %
                                                                                                                          Availability of personnel                                   37 %
                                                                                                                      with necessary qualifications
                  Less documentation                                   31 %

                                                                                                               Projects are too big or too complex                                34 %
            Less management control                                  28 %

                                                                                                                      Collaboration with the client                            31 %
              Not / not easily scalable                        24 %
                                                                                                                               (internal / external)
         Development team not ready                           23 %
                                                                                                                            Lacking support of line
                                                                                                                                                                           28 %
                         for change                                                                                                  management
Insufficient discipline in development                 16 %                                                            Confidence in the scalability                    25 %
                                                                                                                                  of agile methods
               Inconsistency with the             13 %
                 regulatory standards                                                                                         Not enough time for                   23 %
                                                                                                                              sustainable changes
                          No concerns           10 %

                                                                                                                                       Cost reasons          9 %
                                Others          9 %

          Less quality of the software          9 %                                                                                          Others      6 %

     Quality of the development skills      7 %                                                                                        No obstacles      0 %

                                          0 %                 20 %                   40 %       60 %                                                   0 %          20 %                     40 %           60 %

  Main Reasons for the Failure of Agile Projects

                                                              45 %                                                         38 %                                                          35 %
                                                                                                                                                                                          Lack of

                                                                                                                                                         37 %
                                                    Corporate culture                                                   Lack of support                                                cooperation
              52 %                               is not compatible with                                                    from line
                                                                                                                         management
                                                                                                                                                                                         between
                                                                                                                                                                                      organisational
                                                                                                 41 %
                                                 agile principles (theory                                                                                  Lack of /
       Lack of experience                       and practice are difficult                                                                                                                 units
                                                                                                                                                         insufficient
                                                       to reconcile)
              with                                                                            External pressure                                           training /
                                                                                                                                                          coaching
         agile methods                                                                      to follow a traditional
                                                                                                   approach                                                                       23 %
                                                                                                                                                                               Lack of team
                                                                                                                                                                                motivation
FRAME OF SURVEY                                                                                                                                                             SwissQ Agile Trends & Benchmarks 2012 10

Industrial Sector                                                                          Responsibilities
More than 60 % of the respondents work either in the IT or in the                          More than 50 % of the respondents describe their job with more than
financial sector. Compared to the last years their proportion has decreased,               one role. Especially test managers don’t work 100 % as test managers,
demonstrating that the subject has arrived in other industries too.                        but also take responsibility for other roles.

                                  IT                                              36.1 %              30 %

                  Finance, Insurance                                   28.4 %

                      Manufacturing                 7.4 %
                                                                                                      20 %
Public and semi-public companies                    7.4 %

        Traffic and Transportation              5.6 %

              Telecommunication               4.0 %
                                                                                                      10 %
                            MedTech           3.7 %

                              Others                7.4 %

                                       0 %          10 %       20 %    30 %        40 %
                                                                                                        0 %

IT Employees                                                                                                        ge
                                                                                                                       r        r      A
                                                                                                                              ge / B nee age
                                                                                                                                                r         r
                                                                                                                                                               st
                                                                                                                                                                 er      ge
                                                                                                                                                                            r
                                                                                                                                                                                    ee
                                                                                                                                                                                      r
                                                                                                               na ana er                    i       n        Te        na        in
A bit more than half of the respondents work in companies with more                                          a                    e      ng       a                  a
                                                                                                                                                                             En
                                                                                                                                                                               g
                                                                                                         t M n M gin st E ct m                                  ts
                                                                                                                                                                   M
                                                                                                                                                                          re
than 500 IT employees.                                                                               Tes         si o        n      Te        e               en twa
                                                                                                             vi          ts
                                                                                                                            E             oj
                                                                                                           Di                           Pr                  m        f
                                                                                                                      en                                ire       So
                                                                                                       t / em                                        qu
                                                                                                    en        ir                                  Re
                                                                                                  tm equ
                                                                                              par      R
      2001– ...                                                               33.0 %        De

    501 – 2000                                        17.6 %

                                                                                                  60 %                                                           33 %
     251 – 500                               13.6 %

      51 – 250                                 15.4 %

       11 – 50                               14.2 %
                                                                                                   of the respondents mainly                                      of the respondents are
        1 – 10                6.2 %                                                                work in projects.                                              line managers.

                   0 %     5 %    10 %       15 %       20 %   25 %   30 %      35 %

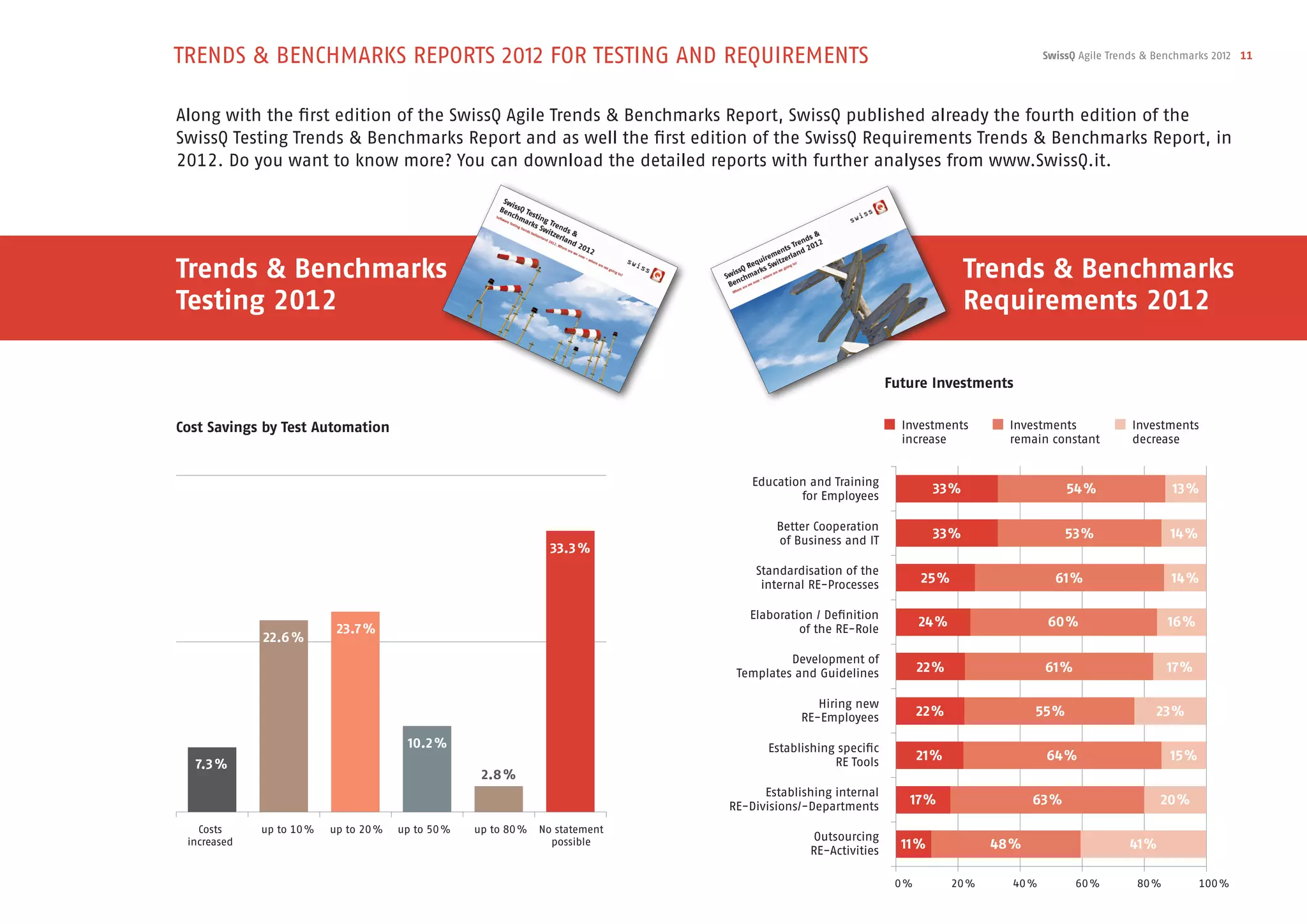

TRENDS & BENCHMARKS REPORTS 2012 FOR TESTING AND REQUIREMENTS                                                                                SwissQ Agile Trends & Benchmarks 2012 11

Along with the first edition of the SwissQ Agile Trends & Benchmarks Report, SwissQ published already the fourth edition of the
SwissQ Testing Trends & Benchmarks Report and as well the first edition of the SwissQ Requirements Trends & Benchmarks Report, in
2012. Do you want to know more? You can download the detailed reports with further analyses from www.SwissQ.it.

Trends & Benchmarks                                                                                                            Trends & Benchmarks
Testing 2012                                                                                                                   Requirements 2012

                                                                                                               Future Investments

Cost Savings by Test Automation                                                                                  Investments          Investments             Investments
                                                                                                                 increase             remain constant         decrease

                                                                                    Education and Training
                                                                                            for Employees
                                                                                                                        33 %                      54 %               13 %

                                                                                        Better Cooperation
                                                                                        of Business and IT
                                                                                                                        33 %                      53 %               14 %
                                                                   33.3 %
                                                                                    Standardisation of the
                                                                                     internal RE-Processes            25 %                     61 %                  14 %

                                                                                   Elaboration / Definition
                           23.7 %                                                           of the RE-Role
                                                                                                                      24 %                   60 %                    16 %
             22.6 %
                                                                                          Development of
                                                                                 Templates and Guidelines             22 %                   61 %                    17 %

                                                                                                Hiring new
                                                                                             RE-Employees             22 %                 55 %                   23 %

                                        10.2 %                                         Establishing specific
                                                                                                   RE Tools           21 %                   64 %                    15 %
  7.3 %
                                                     2.8 %
                                                                                      Establishing internal
                                                                                RE-Divisions/-Departments         17 %                     63 %                     20 %

   Costs     up to 10 %   up to 20 %   up to 50 %   up to 80 %   No statement
                                                                                               Outsourcing
 increased                                                         possible
                                                                                              RE-Activities      11 %               48 %                     41 %

                                                                                                                0 %          20 %     40 %          60 %      80 %          100 %
ABOUT US
SwissQ supports its clients in the development and implementation of IT-solutions and
assures that the end users get the functionality they really need. This is achieved by
unambiguously determining requirements and risk-based testing the implementation.
Our vision is to improve the added value of IT through requirements management and
software testing. Along with providing high-quality services, we pursue this vision
by establishing independent platforms, like the Swiss Testing Day and the Swiss
Requirements Day, which facilitate the exchange of know-how and experiences.
In addition to that we help bright minds to expand their knowledge in our trainings.

                                                       © by SwissQ Consulting AG | Stadthaus-Quai 15 | Switzerland-8001 Zürich
                                                 www.SwissQ.it | info@SwissQ.it | Phone +41 43 288 88 40 | Fax +41 43 288 88 39
                                                                                   Twitter: @SwissQ | Facebook: swissqconsulting

SwissQ Agile Trends & Benchmarks 2012 (Englisch)

  • 1.
    SwissQ Agile Trends& Benchmarks Switzerland 2012 Where are we now – where are we going to?
  • 2.
    TABLE OF CONTENTS SwissQ Agile Trends & Benchmarks 2012 2 3 EDITORIAL 4 TRENDWAVE 2012 5 KEY MESSAGES 6 PROJECTS 7 EXPERIENCE 8 IMPLEMENTATION 9 OBSTACLES 10 FRAME OF SURVEY 11 TESTING AND REQUIREMENTS
  • 3.
    EDITORIAL SwissQ Agile Trends & Benchmarks 2012 3 Agility resounds throughout the land – there are those who adore it and there might be others who don‘t like it so much. Each to their own. However, how does the agile landscape look like in the Swiss IT Community? Let the Trends and Benchmarks of our current survey sink in, discuss about it and draw your own conclusions. “Agility: Flexibility takes over from planning”, the Financial Times predicted on Whereas many are still indifferent to the agile movement, others already pay a 20 November 2007. This came true sooner than many expected. More than ever lot of attention to Scrum. Topics like using Sprints or the roles of Developers and before, modern organizations are challenged to respond pro-actively to the fast Scrum Masters are established and almost “daily business“. changes of today‘s global and strongly interlinked world. Plans become waste paper before they even had a chance of being realized. The adaption of and the Two of the main topics, which are currently being worked on intensively, are the reaction to change is a top priority. This fast and continuous modification of Definition of Done and the Product Owner Role. The Definition of Done advanced business models also challenges the backbone of any company: the IT. rapidly by considering it as a quality gate and by incorporating acceptance criteria. The Product Owner is recognized more and more in his role as a key player and Agile approaches, in particular Scrum, have hit the nail on the head. In the last therefore is challenged to a greater extent. In the end it is his work which forms years, the “Lean & Agile“ approach significantly gained momentum. A lot is the basis for a successful product and for the acceptance by the end user. promised, a lot is set up, but the expectations are often not met. It seems that the reality is much more complex and laborious than books and shiny presentations An amassing of topics can be noticed in the growth-sector of the Trend Wave. let you believe. The report at hand is based on a survey with more than 300 The restricted view from just one Sprint to the next Sprint is slowly being replaced participants and numerous interviews with IT-executives. Thus, it presents facts. by transparent overall planning and efficient backlog management. Thus, the It shows, where agility stands in Switzerland today, what difficulties the overall view of the product is becoming more focused. In addition to that, new community faces day after day and which topics are being actively pursued. ways of collaboration are being tried out in terms of place or discipline. Keywords on this would be: online collaboration and co-location, and accordingly The benchmarks depicted in a multitude of informative charts and diagrams form embedded Scrum testers and agile requirements engineers. the backbone of this report and allow you to position your company in comparison to others. In addition there are topics whose future trend development is not yet assessable. Or were you concerned with Management 3.0 before? In order to show the currentness of the examined topics, we use the SwissQ Trend Wave®. It shows in four phases how select topics will most likely develop over time We wish you lots of interesting findings by reading the agile report and lots of fun and in turn allows you to appraise the influence of these trends on your business. on your way to more flexibility and agility.
  • 4.
    TRENDWAVE 2012 SwissQ Agile Trends & Benchmarks 2012 4 INTRODUCTION GROWTH MATURITY DECLINE PRIORITY Dashboards Definition of Done Product Owner Role Early Feedback Software as a Service / Cloud Computing End User Involvement Test Automation Online Collaboration Scrum Master Continuous Build, Integration & Test Embedded Tester Product Roadmap Cultural Change Issue Tracking Tools ATDD Self-Organisation Developer Role Priority Poker Agile Requirements Engineering Definition of Ready Portfolio Management Management 3.0 Sprints TIME INTRODUCTION – This topic has been GROWTH – This topic is more and MATURITY – Most companies are DECLINE – The topic has already identified and some companies are more accepted and many companies working on the implementation been implemented by most of the deploying initial implementations. are considering it. The first tools are or have already completed it. The companies, with the exception of However, it cannot be foreseen being developed and consultancy knowledge of this topic is often individual latecomers. Often, there whether this trend will positively firms offer services for the same. widespread, resulting in sub-topics is no more added value in acquiring advance and whether testing will be Often risks are associated due to being raised. further knowledge in these areas, considerably influenced. limited implementation experience. since it will become obsolete shortly.
  • 5.
    KEY MESSAGES SwissQ Agile Trends & Benchmarks 2012 5 1 2 3 More than 50 % are not satisfied 67.6 % of the respondents use 73 % of the respondents already with the implementation of their MS-Office Tools in the agile area, carried out agile projects and agile approach. This is most likely followed by JIRA with 31.0 % and therefore see themselves as explained by the lack of strategies HP QC with 28.2 %. experienced with agile methods. to implement the agile methods. The only question is, how “experienced” is defined. 4 5 6 Whereas most techniques are used by Better handling of constantly More than half of the companies more than 70 % of the respondents, changing priorities is considered apply agile development practices. there are still some techniques with to be one of the main reasons to Thereof 84.5 % of the respondents a lot of catching up to do, like TDD, implement agile methods, as well use Scrum as their preferred agile ATDD, Kanban or the Definition as increasing productivity and method. of Done. accelerating time-to-market. 7 8 9 The executives have major Not the agile approach itself is the 52 % of the respondents stated concerns: less forward planning, main obstacle but the required that agile projects fail because of less predictability and less transformation of the organisation. lack of experience, 42 % because documentation. the corporate culture was not compatible with agile principles.
  • 6.
    PROJECTS SwissQ Agile Trends & Benchmarks 2012 6 Software Development Process Tools in the Agile Context More than half of the companies use agile processes. Many of them are using a combination of different development processes e.g. agile in combination with waterfall. MS Office (Word, Excel) 67.6 % Atlassian JIRA / Greenhopper 31.0 % HP QC / ALM 28.2 % Open Source 19.7 % Agile MS Team Foundation Server 16.9 % 51 % Others 15.5 % Waterfall 40 % Version One 5.6 % Proprietary Development 5.6 % Iterative Hermes Rally Software Development 2.8 % 22 % RUP 12 % 16 % Inflectra Spira 2.8 % CA Agile Vision 0.0 % Agile Methods in Use 0 % 20 % 40 % 60 % 80 % Scrum 84.5 % Kanban 16.9 % 84.5 % Own agile hybrid Version 15.5 % Extreme Programming (XP) 14.1 % Agile Unified Process 11.3 % Others 9.9 % of the respondents use Scrum as their favorite agile method. SCRUMBAN 8.5 % Feature Driven 0.0 % Development (FDD) 0 % 20 % 40 % 60 % 80 % 100 %
  • 7.
    EXPERIENCE SwissQ Agile Trends & Benchmarks 2012 7 Personal Experience in Agile Methods Use of Agile Techniques Agile techniques like iterative planning, daily stand-up meetings, taskboards and retrospective meetings are already well in place. TDD, ATDD and Kanban are techniques which are of particular interest at the moment. 60 % 54.9 % 40 % Iterative Planning 89.6 % 20 % 23.9 % 18.3 % Daily Standup 82.1 % 13.4 % 2.8 % 0 % Backlog Management 80.6 % 6.0 % 9.0 % Very experienced Experienced Little experience No (many years of (carried out (theoretical experience practical first projects) knowledge) Taskboard 75.8 % 6.5 % 16.1 % experience) Retrospectives 72.7 % 7.6 % 15.2 % Burndown Chart 67.2 % 6.0 % 22.4 % 3/4 of the respondents are already Definition of Done Velocity Chart 38.1 % 57.8 % 9.5 % 14.1 % 46.0 % 21.9 % experienced with agile methods. On-Site Customer 34.8 % 12.1 % 48.5 % Co-Location 26.6 % 65.6 % Test Driven 2/3 20.3 % 31.3 % 46.9 % Development (TDD) Kanban 15.9 % 19.0 % 63.5 % Acceptance Test Driven 11.1 % 23.8 % 63.5 % of the respondents have Development (ATDD) less than 2 years experience 0 % 20 % 40 % 60 % 80 % 100 % in agile projects. Is used Use is planned No more use Is not an issue
  • 8.
    IMPLEMENTATION SwissQ Agile Trends & Benchmarks 2012 8 Drivers of Agile Methods Implementation Steps 60 % Piloting the agile approach 43.3 % 32.8  % 23.9  % 52.1 % in a single project 40 % Training and coaching 38.8 % 31.3  % 29.9  % 39.4 % 38.0 % 36.6 % the involved roles 20 % Expansion to suitable projects 33.3 % 26.1  % 40.6  % 19.8 % 0 % Active involvement of 32.3 % 32.3  % 35.4  % business units (e.g. in the PO-role) Developer Department Head Project CEO manager / Development manager Naturally grown 29.4 % 41.2  % 29.4  % Team lead in separate teams Extended pilot phase 21.2 % 22.7  % 56.1  % Reasons for Implementing Agile Methods with several projects Rollout to all projects 9.1 % 6.1  % 84.8  % (big bang) Improving the handling of 15.9 % 62.3  % 17.4  % 4.3  % changing priorities Assessment of the organization 2.9 % 29.4  % 67.6  % Improving collaboration between 17.4 % 52.2  % 21.7  % 8.7  % business and IT 0 % 20 % 40 % 60 % 80 % 100 % Accelerating time-to-market 28.6 % 31.4  % 27.1  % 12.9  % Yes To some extent No Increasing productivity 13.6 % 42.4  % 39.4  % 4.5  % Minimizing risks 14.5 % 40.6  % 36.2  % 8.7  % Improving team morale 7.2 % 39.1  % 39.1  % 14.5  % Satisfaction with the Implementation Simplifying the development process 7.2 % 34.8  % 36.2  % 21.7  % 3 % Improving development-disciplines 4.3 % 37.7  % 39.1  % 18.8  % 10 % 4 % Everything runs smoothly - there are no problems Increasing visibility of projects 11.9 % 26.9  % 34.3  % 26.9  % Expected benefit was fulfilled Increasing maintainability and 11.6 % 21.7  % 39.1  % 27.5  % expandability of software 17 % Took longer than expected 41 % Reducing costs 7.2 % 23.3  % 44.9  % 24.6  % Is complicated Managing distributed teams 8.7 % 20.3  % 33.3  % 37.7  % Does not meet expectations Implementation cancelled 0 % 20 % 40 % 60 % 80 % 100 % 25 % Top Priority Very Important Important Not Important
  • 9.
    OBSTACLES SwissQ Agile Trends & Benchmarks 2012 9 The Biggest Concerns Main Implementation Obstacles No / less forward planning 41 % Ability to change the 55 % organizational culture Necessity to change management style 37 % 39 % General resistance to change Less predictability 32 % Availability of personnel 37 % with necessary qualifications Less documentation 31 % Projects are too big or too complex 34 % Less management control 28 % Collaboration with the client 31 % Not / not easily scalable 24 % (internal / external) Development team not ready 23 % Lacking support of line 28 % for change management Insufficient discipline in development 16 % Confidence in the scalability 25 % of agile methods Inconsistency with the 13 % regulatory standards Not enough time for 23 % sustainable changes No concerns 10 % Cost reasons 9 % Others 9 % Less quality of the software 9 % Others 6 % Quality of the development skills 7 % No obstacles 0 % 0 % 20 % 40 % 60 % 0 % 20 % 40 % 60 % Main Reasons for the Failure of Agile Projects 45 % 38 % 35 % Lack of 37 % Corporate culture Lack of support cooperation 52 % is not compatible with from line management between organisational 41 % agile principles (theory Lack of / Lack of experience and practice are difficult units insufficient to reconcile) with External pressure training / coaching agile methods to follow a traditional approach 23 % Lack of team motivation
  • 10.
    FRAME OF SURVEY SwissQ Agile Trends & Benchmarks 2012 10 Industrial Sector Responsibilities More than 60 % of the respondents work either in the IT or in the More than 50 % of the respondents describe their job with more than financial sector. Compared to the last years their proportion has decreased, one role. Especially test managers don’t work 100 % as test managers, demonstrating that the subject has arrived in other industries too. but also take responsibility for other roles. IT 36.1 % 30 % Finance, Insurance 28.4 % Manufacturing 7.4 % 20 % Public and semi-public companies 7.4 % Traffic and Transportation 5.6 % Telecommunication 4.0 % 10 % MedTech 3.7 % Others 7.4 % 0 % 10 % 20 % 30 % 40 % 0 % IT Employees ge r r A ge / B nee age r r st er ge r ee r na ana er i n Te na in A bit more than half of the respondents work in companies with more a e ng a a En g t M n M gin st E ct m ts M re than 500 IT employees. Tes si o n Te e en twa vi ts E oj Di Pr m f en ire So t / em qu en ir Re tm equ par R 2001– ... 33.0 % De 501 – 2000 17.6 % 60 % 33 % 251 – 500 13.6 % 51 – 250 15.4 % 11 – 50 14.2 % of the respondents mainly of the respondents are 1 – 10 6.2 % work in projects. line managers. 0 % 5 % 10 % 15 % 20 % 25 % 30 % 35 %
  • 11.
    TRENDS & BENCHMARKSREPORTS 2012 FOR TESTING AND REQUIREMENTS SwissQ Agile Trends & Benchmarks 2012 11 Along with the first edition of the SwissQ Agile Trends & Benchmarks Report, SwissQ published already the fourth edition of the SwissQ Testing Trends & Benchmarks Report and as well the first edition of the SwissQ Requirements Trends & Benchmarks Report, in 2012. Do you want to know more? You can download the detailed reports with further analyses from www.SwissQ.it. Trends & Benchmarks Trends & Benchmarks Testing 2012 Requirements 2012 Future Investments Cost Savings by Test Automation Investments Investments Investments increase remain constant decrease Education and Training for Employees 33 % 54 % 13 % Better Cooperation of Business and IT 33 % 53 % 14 % 33.3 % Standardisation of the internal RE-Processes 25 % 61 % 14 % Elaboration / Definition 23.7 % of the RE-Role 24 % 60 % 16 % 22.6 % Development of Templates and Guidelines 22 % 61 % 17 % Hiring new RE-Employees 22 % 55 % 23 % 10.2 % Establishing specific RE Tools 21 % 64 % 15 % 7.3 % 2.8 % Establishing internal RE-Divisions/-Departments 17 % 63 % 20 % Costs up to 10 % up to 20 % up to 50 % up to 80 % No statement Outsourcing increased possible RE-Activities 11 % 48 % 41 % 0 % 20 % 40 % 60 % 80 % 100 %
  • 12.
    ABOUT US SwissQ supportsits clients in the development and implementation of IT-solutions and assures that the end users get the functionality they really need. This is achieved by unambiguously determining requirements and risk-based testing the implementation. Our vision is to improve the added value of IT through requirements management and software testing. Along with providing high-quality services, we pursue this vision by establishing independent platforms, like the Swiss Testing Day and the Swiss Requirements Day, which facilitate the exchange of know-how and experiences. In addition to that we help bright minds to expand their knowledge in our trainings. © by SwissQ Consulting AG | Stadthaus-Quai 15 | Switzerland-8001 Zürich www.SwissQ.it | info@SwissQ.it | Phone +41 43 288 88 40 | Fax +41 43 288 88 39 Twitter: @SwissQ | Facebook: swissqconsulting
