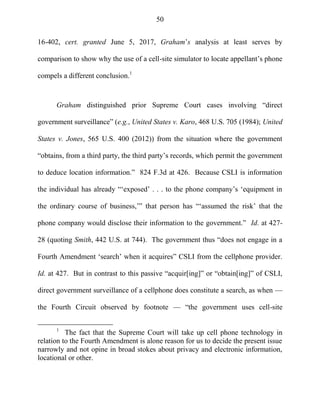

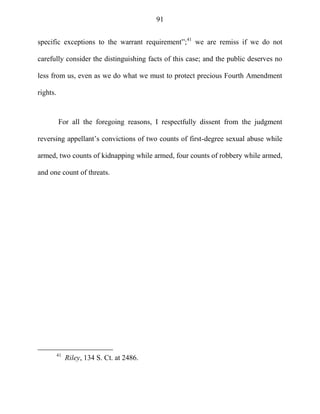

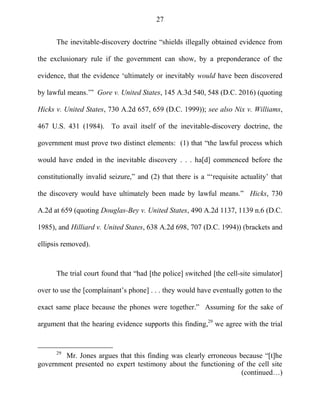

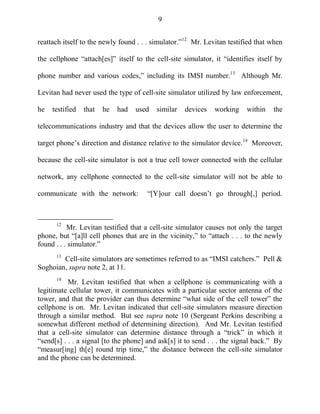

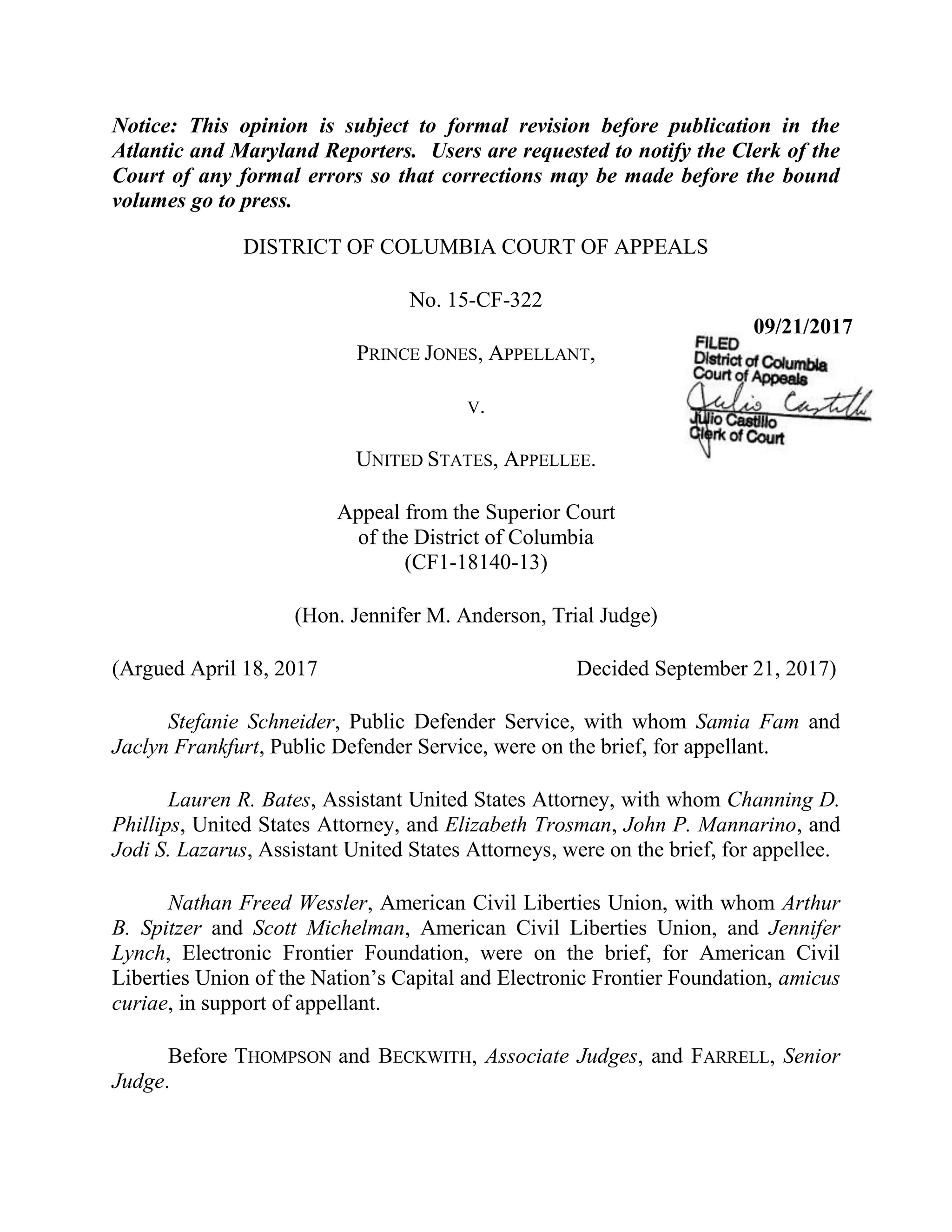

Prince Jones was convicted of sexual assault and robbery but appealed his convictions, arguing that evidence obtained through a warrantless search using a cell-site simulator violated his Fourth Amendment rights. The District of Columbia Court of Appeals agreed with Jones, ruling that the use of the cell-site simulator was unlawful and the trial court's inevitable-discovery ruling was reversed, resulting in the reversal of Jones's convictions. The case highlights issues regarding the legality of warrantless surveillance methods by law enforcement.
