RED FORT CAPITAL PARSVNATH TOWERS
New Delhi’s Premier Office Address
Table of Contents


    Key Sections                      Page Nos.
    Executive Summary                 3-6
    Location & Infrastructure         7-11
    Amenities & Features              12-17
    Tower Perspectives & Renderings   18-24
    Site Plan & Test-Fit Layouts      25-29
    Benchmarking & Conclusion         30
    Conclusion                        31




                                                  2
Red Fort Capital Parsvnath Towers – Landmark Presence




          Only Expansive 5-Acre Office Plot in New Delhi’s CBD


                                                                 3
Designed to Meet Multi-National Corporate Requirements


   PRIME CBD       •   Located in New Delhi’s Central Business District
   LOCATION        •   2 minute drive from Connaught Place


                   •   Located in New Delhi’s high security VIP zone
    DESIRED        •   5 minute drive to North & South Block, Central Government Ministries & Diplomatic Enclave
NEIGHBOURHOOD      •   Leading global MNCs all operate in close vicinity
                   •   More than 10+ five-star hotels within 5 minutes driving distance

                   •   Convenient access to Metro Stations, Airport Express Line, Rail and major arterial roads
   EXCELLENT
                   •   Frontage on 60 meter wide boulevard
 CONNECTIVITY
                   •   Established social infrastructure including premium retail, fine dining, sports & entertainment


  INTELLIGENT      •   Only green building in CBD – pre-certified LEED Silver (LEED Gold Targeted)
                   •   1,000+ parking spaces spread across 3 basement levels
    DESIGN
                   •   Spacious & flexible floor plates – 5,000 to 27,900 square feet available per floor


                   •   New Grade A+ office towers with world-class technical specifications & materials palette
PREMIUM GRADE A+
     SPECS         •   Luxurious mixed-use amenities – multiple restaurants & cafes, executive lounge, fitness
                       center, sky & mezzanine terraces, exquisite landscaping, water features & modern art


                                                                                                                         4
Red Fort Capital Parsvnath Towers (RFCPT) – Summary Overview

                                                   PROJECT OVERVIEW
                                 FLOORS            3 Basements + Ground + Eight Floors
                           TOTAL PROJECT SIZE      Approx. 5,06,000 square feet
                          TOTAL LEASABLE AREA      Approx. 3,00,000 square feet
                               FLOOR PLATE         Approx. 27,900 square feet
                            MINIMUM UNIT SIZE      5,000 square feet
                                                   Office + Mixed-Use (Restaurants, Cafes, Conferencing,
                                  USAGE
                                                   Fitness Centre, ATMs, etc)
                                CAR PARKS          1,000
                                                   Leasing commenced August 2012
                             LEASING STATUS
                                                   Anchor tenants: Red Fort Capital, Global MNCs
  Front View Rendering                             Nearing completion (Contractor: Larsen & Toubro)
                                                   Ready for fit-outs in October 2012
                             PROJECT STATUS
                                                   Building Operational in Q1 2013
                                                   Pre-certified LEED rating
                                                   Corporate
                                                   World Bank, Exxon Mobil, DBS, Boeing, Bank of
                                                   America, UTC, Vodafone, Accenture, HSBC, Mitsubishi,
                                               Cisco, Reuters, IBM, Rolls Royce, BBC, Edelweiss,
                         NEIGHBOURHOOD PROFILE Hindustan Times, Mizuho Bank,
                                                   Non-Corporate
                                                   The Metropolitan Hotel, The Imperial, Shangri-La, Le
                                                   Meridien, Parliament House, Presidential Estate
  Side View Rendering

                                                                                                          5

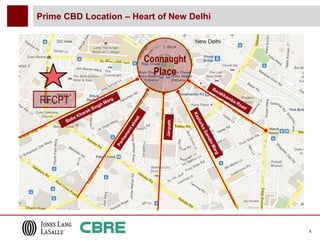

Prime CBD Location – Heart of New Delhi



                       Connaught
                          Place

RFCPT




                                          6
An Integrated Environment


                         Metropolitan
                                                      Prime
                            Hotel
                                                      CBD                         The Lalit




              RFCPT                          The
                                           Imperial                 American
                                                                     Center




                                           RBI
                                  Le
                                Meridien               Shangri-La

                                                                               British
                                                                               Council




                      North
                      Block




Rashtrapati     Ministry of
 Bhavan          External
               Affairs-South                                                                  India
                   Block                                                                      Gate




                                                                                                      7
Excellent Transportation Infrastructure (Metro)

                                                                                    North - South Delhi
                                                                                    Gurgaon
                                                                                    Dwarka-Noida




  RFCPT
                     AIRPORT
                     EXPRESS
                     TERMINAL




                                                                 KEY DISTANCES                       KMS
                                                          CONNAUGHT PLACE METRO STATION               1.5
                                                             AIRPORT EXPRESS TERMINAL                 1
                                                                METROPOLITIAN HOTEL                   0


       Extremely Well Connected for Both Local, Domestic and International Travel


                                                                                                            8
                                                                                                            8
Metro Map – Accessible from All Major Metro Lines




                          RFCPT




                                                    9
Convenient Delhi-NCR Connectivity via Road and Highway




                RFCPT
                               CONNAUGHT
                                 PLACE



                             NEHRU
                             PLACE
                  SAKET                              NOIDA

                                                   DRIVE TIME

                                           CONNAUGHT PLACE      6 min
                                        INTERNATIONAL AIRPORT   25 min

GURGAON                                    NEHRU PLACE (SBD)    23 min
                                                NOIDA           23 min
                                                SAKET           30 min
                                               GURGAON          33 min



                                                                         10
Prestigious Neighborhood Corporate Profile




                             RFCPT
                      Neighborhood Profile
                                                                   3
                                                               2
                                             1




1     DLF CENTER         2     HT HOUSE      3   BIRLA TOWER            OTHER MAJOR TENANTS

    BANK OF AMERICA          ERNST & YOUNG          CISCO      SHELL             CALYON BANK

      ACCENTURE               WORLD BANK            HSBC       DBS               PROVIDENCE PE

        BOEING                   BBC             BNP PARIBAS   NESTLE            BRITISH PETROLEUM



                                                                                                 11

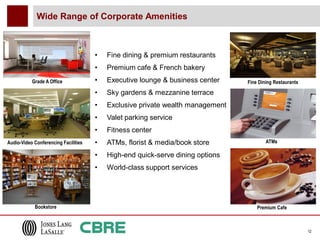

Wide Range of Corporate Amenities



                                      •   Fine dining & premium restaurants
                                      •   Premium cafe & French bakery
           Grade A Office             •   Executive lounge & business center    Fine Dining Restaurants

                                      •   Sky gardens & mezzanine terrace
                                      •   Exclusive private wealth management
                                      •   Valet parking service
                                      •   Fitness center
Audio-Video Conferencing Facilities   •   ATMs, florist & media/book store              ATMs

                                      •   High-end quick-serve dining options
                                      •   World-class support services




            Bookstore                                                               Premium Cafe



                                                                                                          12
5-Star Environment with Superior Property Management


•   Global property management provider

•   4-tier security system
•   High-tech surveillance & monitoring
                                                  INSERT INDICATIVE
•   Mandatory entry security checks
                                                         PICTURES
•   Dedicated office entry & exit                  • Sculpture garden
•   Efficient traffic management                           rendering
                                           OFFICE ENTRY PLAZA WITH SCULPTURE GARDEN

•   Ample visitor parking

•   Premium valet parking service
•   LEED-rating for cost efficiency




                                           DEDICATED HIGH-SECURITY OFFICE ENTRY & EXIT




                                                                                         13

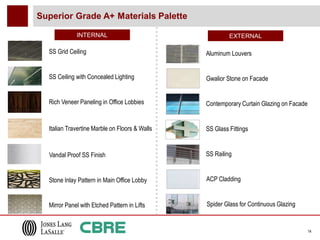

Superior Grade A+ Materials Palette

             INTERNAL                                    EXTERNAL

  SS Grid Ceiling                               Aluminum Louvers


  SS Ceiling with Concealed Lighting            Gwalior Stone on Facade


  Rich Veneer Paneling in Office Lobbies        Contemporary Curtain Glazing on Facade


  Italian Travertine Marble on Floors & Walls   SS Glass Fittings


  Vandal Proof SS Finish                        SS Railing


  Stone Inlay Pattern in Main Office Lobby      ACP Cladding


  Mirror Panel with Etched Pattern in Lifts     Spider Glass for Continuous Glazing


                                                                                         14

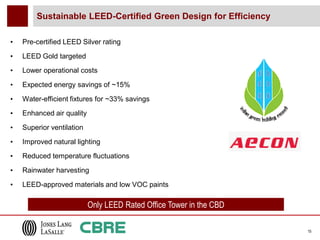

Sustainable LEED-Certified Green Design for Efficiency

•   Pre-certified LEED Silver rating
•   LEED Gold targeted
•   Lower operational costs

•   Expected energy savings of ~15%

•   Water-efficient fixtures for ~33% savings
•   Enhanced air quality
•   Superior ventilation

•   Improved natural lighting
•   Reduced temperature fluctuations

•   Rainwater harvesting
•   LEED-approved materials and low VOC paints

                           Only LEED Rated Office Tower in the CBD

                                                                     15

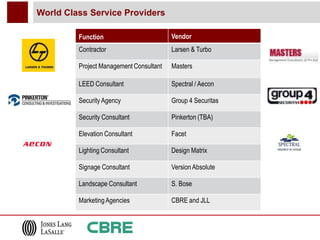

World Class Service Providers

         Function                        Vendor
         Contractor                      Larsen & Turbo

         Project Management Consultant   Masters

         LEED Consultant                 Spectral / Aecon

         Security Agency                 Group 4 Securitas

         Security Consultant             Pinkerton (TBA)

         Elevation Consultant            Facet

         Lighting Consultant             Design Matrix

         Signage Consultant              Version Absolute

         Landscape Consultant            S. Bose

         Marketing Agencies              CBRE and JLL
Tower Perspectives – North



A




                                       View of Elevated Metro Line from Point “A”

                                          RETAIL SHOPPING

                                 CANOPIED WALKWAY CONNECTING THE
                                 OFFICE TOWER TO THE RESTAURANTS



                                    LANDSCAPED OPEN TERRACES


                                      MAIN OFFICE LOBBY ENTRY




                                                                                    17
Tower Perspectives – South



                A




                             View of Parliament House from Point “A”



                             FINE DINING & PREMIUM RESTAURANTS




                                   LANDSCAPED TERRACE FOR
                                   OUTDOOR SEATING & EVENTS




                                                                       18
Tower Perspectives – East



  A




                            View of Connaught Place & Metropolitan Hotel
                                          From Point “A”




                                     EAST-FACING GLAZING ENHANCES
                                        NATURAL LIGHT EXPOSURE




                                        CONTEMPORARY FACADE OF
                                        GWALIOR STONE, TEXTURED
                                         PAINT, CURTAIN GLAZING &
                                             PUNCH WINDOWS




                                                                           19

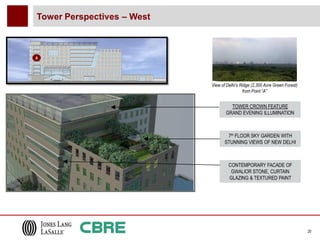

Tower Perspectives – West



A




                            View of Delhi’s Ridge (2,300 Acre Green Forest)
                                             from Point “A”


                                     TOWER CROWN FEATURE
                                   GRAND EVENING ILLUMINATION



                                    7th FLOOR SKY GARDEN WITH
                                   STUNNING VIEWS OF NEW DELHI



                                     CONTEMPORARY FACADE OF
                                      GWALIOR STONE, CURTAIN
                                     GLAZING & TEXTURED PAINT




                                                                              20
Artistic Renderings




LANDSCAPED OFFICE ENTRY PLAZA WITH SCULPTURE GARDEN           DEDICATED HIGH-SECURITY OFFICE ENTRY




      FINE DINING RESTAURANTS & OUTDOOR SEATING       TOWER ENTRY DRIVE WITH ELEGANT PAVING & LANDSCAPING




                                                                                                            21
Luxurious Reception & Elevator Lobbies




           MAIN OFFICE LOBBY (GROUND FLOOR)                            LIFT LOBBIES (FLOORS 1-8)
• ITALIAN TRAVERTINE MARBLE FLOORING & WALL CLADDING      • ITALIAN TRAVERTINE MARBLE FLOOR WITH BAND PATTERN
• RICH EBONY WOOD VENEER PANELS                           • METALLIC CEILING WITH DIFFUSED LIGHTING TRENCHES
• SMART SS CEILING TILES WITH CONCEALED LIGHTING          • STONE-CLADDED WALLS WITH ABSTRACT BANDING
• MODERN ART & LCD TELEVISION DISPLAYS                    • DEEP-SET ELEVATOR DOORS WITH SS FINISH AND JAMBS
• COMFORTABLE LOUNGE WITH ITALIAN FURNITURE (NOT SHOWN)   • THREE HIGH-SPEED ELEVATOR BANKS




                                                                                                                22
Luxurious Reception & Elevator Lobbies




                                         23
Night Perspectives & Illumination Plan




  TOWER & OFFICE CROWN ILLUMINATED AT NIGHT                                  ILLUMINATED TOWER ENTRY DRIVE




                            LIGHTING PLAN FOR MAIN OFFICE ENTRY – WATER FEATURE




                                                                                                             24
Site Plan – Dedicated Office Entry and Exit


OFFICE LIFT LOBBY # 2                                            Expansive
LANDSCAPED DRIVE
                                                                Landscaped
                                                                5-Acre Plot
OFFICE LIFT LOBBY #1
                                                           OFFICE LIFT LOBBY # 3
OFFICE ENTRY PLAZA &
SCULPTURE GARDEN
OFFICE PARKING ENTRY & EXIT
RAMPS TO TWO DEDICATED
BASEMENT PARKING FLOORS
FINE DINING &
PREMIUM RESTAURANTS
TERRACE GARDEN FOR
                                                                          LEGEND
OUTDOOR SEATING & EVENTS
                                                                   TRAFFIC FLOW

                                                                   MAIN ACCESS RD
    DEDICATED OFFICE
    ENTRY DRIVEWAY                                                 DEDICATED OFFICE
                                                                   ENTRY/EXIT



 B h a i     Ve e r     S i n g   M a r g   GUARD ROOM



                                                                                      25
Typical Floor Plan – Large Floor Plates




                                          26
Floor Plan for Three Tenants




                               27

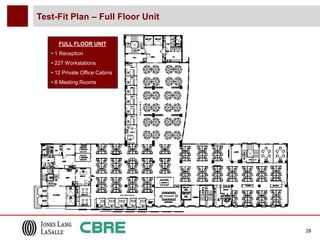

Test-Fit Plan – Full Floor Unit

      FULL FLOOR UNIT
   • 1 Reception
   • 227 Workstations
   • 12 Private Office Cabins
   • 8 Meeting Rooms




                                  28
Test-Fit Plan For Units #1, 2 & 3

                                                UNIT #2
                                        • 1 Reception
                                        • 66 Workstations
                                        • 5 Private Office Cabins
                                        • 3 Meeting Rooms

        UNIT #1                                 UNIT #3
• 1 Reception                           • 1 Reception
• 74 Workstations                       • 44 Workstations
• 6 Private Office Cabins               • 7 Private Office Cabins
• 4 Meeting rooms                       • 3 Meeting Rooms




                                                                    29
RFCPT – New Delhi’s Premier Office Address

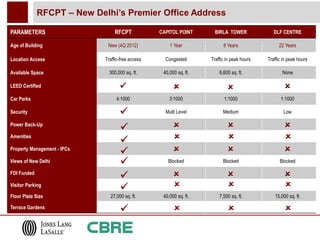

PARAMETERS                        RFCPT            CAPITOL POINT       BIRLA TOWER              DLF CENTRE

Age of Building               New (4Q 2012)            1 Year              8 Years                22 Years

Location Access              Traffic-free access     Congested       Traffic in peak hours   Traffic in peak hours

Available Space                300,000 sq. ft.      40,000 sq. ft.       6,600 sq. ft.              None

LEED Certified                                                                                    
Car Parks                         4:1000               3:1000              1:1000                  1:1000

Security                                             Multi Level           Medium                    Low

Power Back-Up                                                                                      
Amenities                                                                                          
Property Management - IPCs                                                                         
Views of New Delhi                                    Blocked              Blocked                 Blocked

FDI Funded
                                                                                                   
Visitor Parking                                                                                    
Floor Plate Size               27,000 sq. ft.       40,000 sq. ft.       7,500 sq. ft.          15,000 sq. ft.

Terrace Gardens                                                                                    

Red fort pdl towers Lease @ 09958959555

  • 1.
    RED FORT CAPITALPARSVNATH TOWERS New Delhi’s Premier Office Address
  • 2.
    Table of Contents Key Sections Page Nos. Executive Summary 3-6 Location & Infrastructure 7-11 Amenities & Features 12-17 Tower Perspectives & Renderings 18-24 Site Plan & Test-Fit Layouts 25-29 Benchmarking & Conclusion 30 Conclusion 31 2
  • 3.
    Red Fort CapitalParsvnath Towers – Landmark Presence Only Expansive 5-Acre Office Plot in New Delhi’s CBD 3
  • 4.
    Designed to MeetMulti-National Corporate Requirements PRIME CBD • Located in New Delhi’s Central Business District LOCATION • 2 minute drive from Connaught Place • Located in New Delhi’s high security VIP zone DESIRED • 5 minute drive to North & South Block, Central Government Ministries & Diplomatic Enclave NEIGHBOURHOOD • Leading global MNCs all operate in close vicinity • More than 10+ five-star hotels within 5 minutes driving distance • Convenient access to Metro Stations, Airport Express Line, Rail and major arterial roads EXCELLENT • Frontage on 60 meter wide boulevard CONNECTIVITY • Established social infrastructure including premium retail, fine dining, sports & entertainment INTELLIGENT • Only green building in CBD – pre-certified LEED Silver (LEED Gold Targeted) • 1,000+ parking spaces spread across 3 basement levels DESIGN • Spacious & flexible floor plates – 5,000 to 27,900 square feet available per floor • New Grade A+ office towers with world-class technical specifications & materials palette PREMIUM GRADE A+ SPECS • Luxurious mixed-use amenities – multiple restaurants & cafes, executive lounge, fitness center, sky & mezzanine terraces, exquisite landscaping, water features & modern art 4
  • 5.
    Red Fort CapitalParsvnath Towers (RFCPT) – Summary Overview PROJECT OVERVIEW FLOORS 3 Basements + Ground + Eight Floors TOTAL PROJECT SIZE Approx. 5,06,000 square feet TOTAL LEASABLE AREA Approx. 3,00,000 square feet FLOOR PLATE Approx. 27,900 square feet MINIMUM UNIT SIZE 5,000 square feet Office + Mixed-Use (Restaurants, Cafes, Conferencing, USAGE Fitness Centre, ATMs, etc) CAR PARKS 1,000 Leasing commenced August 2012 LEASING STATUS Anchor tenants: Red Fort Capital, Global MNCs Front View Rendering Nearing completion (Contractor: Larsen & Toubro) Ready for fit-outs in October 2012 PROJECT STATUS Building Operational in Q1 2013 Pre-certified LEED rating Corporate World Bank, Exxon Mobil, DBS, Boeing, Bank of America, UTC, Vodafone, Accenture, HSBC, Mitsubishi, Cisco, Reuters, IBM, Rolls Royce, BBC, Edelweiss, NEIGHBOURHOOD PROFILE Hindustan Times, Mizuho Bank, Non-Corporate The Metropolitan Hotel, The Imperial, Shangri-La, Le Meridien, Parliament House, Presidential Estate Side View Rendering 5
  • 6.
    Prime CBD Location– Heart of New Delhi Connaught Place RFCPT 6
  • 7.
    An Integrated Environment Metropolitan Prime Hotel CBD The Lalit RFCPT The Imperial American Center RBI Le Meridien Shangri-La British Council North Block Rashtrapati Ministry of Bhavan External Affairs-South India Block Gate 7
  • 8.
    Excellent Transportation Infrastructure(Metro) North - South Delhi Gurgaon Dwarka-Noida RFCPT AIRPORT EXPRESS TERMINAL KEY DISTANCES KMS CONNAUGHT PLACE METRO STATION 1.5 AIRPORT EXPRESS TERMINAL 1 METROPOLITIAN HOTEL 0 Extremely Well Connected for Both Local, Domestic and International Travel 8 8
  • 9.
    Metro Map –Accessible from All Major Metro Lines RFCPT 9
  • 10.
    Convenient Delhi-NCR Connectivityvia Road and Highway RFCPT CONNAUGHT PLACE NEHRU PLACE SAKET NOIDA DRIVE TIME CONNAUGHT PLACE 6 min INTERNATIONAL AIRPORT 25 min GURGAON NEHRU PLACE (SBD) 23 min NOIDA 23 min SAKET 30 min GURGAON 33 min 10
  • 11.
    Prestigious Neighborhood CorporateProfile RFCPT Neighborhood Profile 3 2 1 1 DLF CENTER 2 HT HOUSE 3 BIRLA TOWER OTHER MAJOR TENANTS BANK OF AMERICA ERNST & YOUNG CISCO SHELL CALYON BANK ACCENTURE WORLD BANK HSBC DBS PROVIDENCE PE BOEING BBC BNP PARIBAS NESTLE BRITISH PETROLEUM 11
  • 12.
    Wide Range ofCorporate Amenities • Fine dining & premium restaurants • Premium cafe & French bakery Grade A Office • Executive lounge & business center Fine Dining Restaurants • Sky gardens & mezzanine terrace • Exclusive private wealth management • Valet parking service • Fitness center Audio-Video Conferencing Facilities • ATMs, florist & media/book store ATMs • High-end quick-serve dining options • World-class support services Bookstore Premium Cafe 12
  • 13.
    5-Star Environment withSuperior Property Management • Global property management provider • 4-tier security system • High-tech surveillance & monitoring INSERT INDICATIVE • Mandatory entry security checks PICTURES • Dedicated office entry & exit • Sculpture garden • Efficient traffic management rendering OFFICE ENTRY PLAZA WITH SCULPTURE GARDEN • Ample visitor parking • Premium valet parking service • LEED-rating for cost efficiency DEDICATED HIGH-SECURITY OFFICE ENTRY & EXIT 13
  • 14.
    Superior Grade A+Materials Palette INTERNAL EXTERNAL SS Grid Ceiling Aluminum Louvers SS Ceiling with Concealed Lighting Gwalior Stone on Facade Rich Veneer Paneling in Office Lobbies Contemporary Curtain Glazing on Facade Italian Travertine Marble on Floors & Walls SS Glass Fittings Vandal Proof SS Finish SS Railing Stone Inlay Pattern in Main Office Lobby ACP Cladding Mirror Panel with Etched Pattern in Lifts Spider Glass for Continuous Glazing 14
  • 15.
    Sustainable LEED-Certified GreenDesign for Efficiency • Pre-certified LEED Silver rating • LEED Gold targeted • Lower operational costs • Expected energy savings of ~15% • Water-efficient fixtures for ~33% savings • Enhanced air quality • Superior ventilation • Improved natural lighting • Reduced temperature fluctuations • Rainwater harvesting • LEED-approved materials and low VOC paints Only LEED Rated Office Tower in the CBD 15
  • 16.
    World Class ServiceProviders Function Vendor Contractor Larsen & Turbo Project Management Consultant Masters LEED Consultant Spectral / Aecon Security Agency Group 4 Securitas Security Consultant Pinkerton (TBA) Elevation Consultant Facet Lighting Consultant Design Matrix Signage Consultant Version Absolute Landscape Consultant S. Bose Marketing Agencies CBRE and JLL
  • 17.
    Tower Perspectives –North A View of Elevated Metro Line from Point “A” RETAIL SHOPPING CANOPIED WALKWAY CONNECTING THE OFFICE TOWER TO THE RESTAURANTS LANDSCAPED OPEN TERRACES MAIN OFFICE LOBBY ENTRY 17
  • 18.
    Tower Perspectives –South A View of Parliament House from Point “A” FINE DINING & PREMIUM RESTAURANTS LANDSCAPED TERRACE FOR OUTDOOR SEATING & EVENTS 18
  • 19.
    Tower Perspectives –East A View of Connaught Place & Metropolitan Hotel From Point “A” EAST-FACING GLAZING ENHANCES NATURAL LIGHT EXPOSURE CONTEMPORARY FACADE OF GWALIOR STONE, TEXTURED PAINT, CURTAIN GLAZING & PUNCH WINDOWS 19
  • 20.
    Tower Perspectives –West A View of Delhi’s Ridge (2,300 Acre Green Forest) from Point “A” TOWER CROWN FEATURE GRAND EVENING ILLUMINATION 7th FLOOR SKY GARDEN WITH STUNNING VIEWS OF NEW DELHI CONTEMPORARY FACADE OF GWALIOR STONE, CURTAIN GLAZING & TEXTURED PAINT 20
  • 21.
    Artistic Renderings LANDSCAPED OFFICEENTRY PLAZA WITH SCULPTURE GARDEN DEDICATED HIGH-SECURITY OFFICE ENTRY FINE DINING RESTAURANTS & OUTDOOR SEATING TOWER ENTRY DRIVE WITH ELEGANT PAVING & LANDSCAPING 21
  • 22.
    Luxurious Reception &Elevator Lobbies MAIN OFFICE LOBBY (GROUND FLOOR) LIFT LOBBIES (FLOORS 1-8) • ITALIAN TRAVERTINE MARBLE FLOORING & WALL CLADDING • ITALIAN TRAVERTINE MARBLE FLOOR WITH BAND PATTERN • RICH EBONY WOOD VENEER PANELS • METALLIC CEILING WITH DIFFUSED LIGHTING TRENCHES • SMART SS CEILING TILES WITH CONCEALED LIGHTING • STONE-CLADDED WALLS WITH ABSTRACT BANDING • MODERN ART & LCD TELEVISION DISPLAYS • DEEP-SET ELEVATOR DOORS WITH SS FINISH AND JAMBS • COMFORTABLE LOUNGE WITH ITALIAN FURNITURE (NOT SHOWN) • THREE HIGH-SPEED ELEVATOR BANKS 22
  • 23.
    Luxurious Reception &Elevator Lobbies 23
  • 24.
    Night Perspectives &Illumination Plan TOWER & OFFICE CROWN ILLUMINATED AT NIGHT ILLUMINATED TOWER ENTRY DRIVE LIGHTING PLAN FOR MAIN OFFICE ENTRY – WATER FEATURE 24
  • 25.
    Site Plan –Dedicated Office Entry and Exit OFFICE LIFT LOBBY # 2 Expansive LANDSCAPED DRIVE Landscaped 5-Acre Plot OFFICE LIFT LOBBY #1 OFFICE LIFT LOBBY # 3 OFFICE ENTRY PLAZA & SCULPTURE GARDEN OFFICE PARKING ENTRY & EXIT RAMPS TO TWO DEDICATED BASEMENT PARKING FLOORS FINE DINING & PREMIUM RESTAURANTS TERRACE GARDEN FOR LEGEND OUTDOOR SEATING & EVENTS TRAFFIC FLOW MAIN ACCESS RD DEDICATED OFFICE ENTRY DRIVEWAY DEDICATED OFFICE ENTRY/EXIT B h a i Ve e r S i n g M a r g GUARD ROOM 25
  • 26.
    Typical Floor Plan– Large Floor Plates 26
  • 27.
    Floor Plan forThree Tenants 27
  • 28.
    Test-Fit Plan –Full Floor Unit FULL FLOOR UNIT • 1 Reception • 227 Workstations • 12 Private Office Cabins • 8 Meeting Rooms 28
  • 29.
    Test-Fit Plan ForUnits #1, 2 & 3 UNIT #2 • 1 Reception • 66 Workstations • 5 Private Office Cabins • 3 Meeting Rooms UNIT #1 UNIT #3 • 1 Reception • 1 Reception • 74 Workstations • 44 Workstations • 6 Private Office Cabins • 7 Private Office Cabins • 4 Meeting rooms • 3 Meeting Rooms 29
  • 30.
    RFCPT – NewDelhi’s Premier Office Address PARAMETERS RFCPT CAPITOL POINT BIRLA TOWER DLF CENTRE Age of Building New (4Q 2012) 1 Year 8 Years 22 Years Location Access Traffic-free access Congested Traffic in peak hours Traffic in peak hours Available Space 300,000 sq. ft. 40,000 sq. ft. 6,600 sq. ft. None LEED Certified     Car Parks 4:1000 3:1000 1:1000 1:1000 Security Multi Level Medium Low Power Back-Up    Amenities    Property Management - IPCs    Views of New Delhi Blocked Blocked Blocked FDI Funded    Visitor Parking    Floor Plate Size 27,000 sq. ft. 40,000 sq. ft. 7,500 sq. ft. 15,000 sq. ft. Terrace Gardens   
