© 2006 John Wiley and Sons, Inc.
Project Management: A
Managerial Approach
Chapter 7 – Budgeting and Cost
Estimation
© 2006 John Wiley and Sons, Inc.

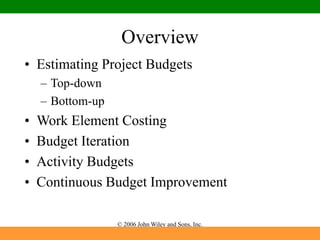

Overview
• Estimating Project Budgets
– Top-down
– Bottom-up
• Work Element Costing
• Budget Iteration
• Activity Budgets
• Continuous Budget Improvement
© 2006 John Wiley and Sons, Inc.
Budgeting and Cost Estimation
• The budget serves as a standard for comparison
• It is a baseline from which to measure the difference
between the actual and planned use of resources
• Budgeting procedures must associate resource use
with the achievement of organizational goals or the
planning/control process becomes useless
• The budget is simply the project plan in another form
Chapter 7-1
© 2006 John Wiley and Sons, Inc.

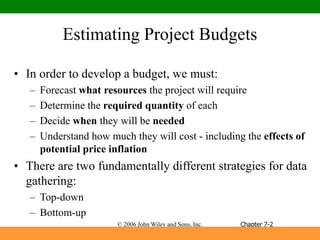

Estimating Project Budgets
• In order to develop a budget, we must:
– Forecast what resources the project will require
– Determine the required quantity of each
– Decide when they will be needed
– Understand how much they will cost - including the effects of
potential price inflation
• There are two fundamentally different strategies for data
gathering:
– Top-down
– Bottom-up
Chapter 7-2
© 2006 John Wiley and Sons, Inc.

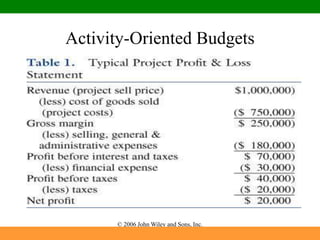

Activity-Oriented Budgets
© 2006 John Wiley and Sons, Inc.

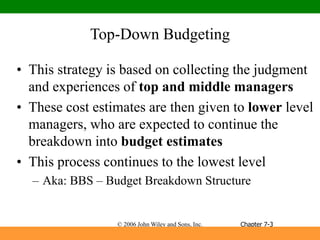

Top-Down Budgeting
• This strategy is based on collecting the judgment
and experiences of top and middle managers
• These cost estimates are then given to lower level
managers, who are expected to continue the
breakdown into budget estimates
• This process continues to the lowest level
– Aka: BBS – Budget Breakdown Structure
Chapter 7-3
© 2006 John Wiley and Sons, Inc.

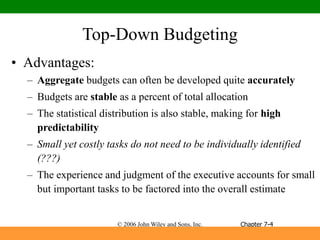

Top-Down Budgeting
• Advantages:
– Aggregate budgets can often be developed quite accurately
– Budgets are stable as a percent of total allocation
– The statistical distribution is also stable, making for high
predictability
– Small yet costly tasks do not need to be individually identified
(???)
– The experience and judgment of the executive accounts for small
but important tasks to be factored into the overall estimate
Chapter 7-4
© 2006 John Wiley and Sons, Inc.
Bottom-Up Budgeting
• In this method, elemental tasks, their schedules, and their
individual budgets are constructed following the WBS
or project action plan
• The people doing the work are consulted regarding
times and budgets for the tasks to ensure the best level of
accuracy
• Initially, estimates are made in terms of resources, such
as labor hours and materials
• Bottom-up budgets should be and usually are, more
accurate in the detailed tasks, but it is critical that all
elements be included
Chapter 7-5
© 2006 John Wiley and Sons, Inc.

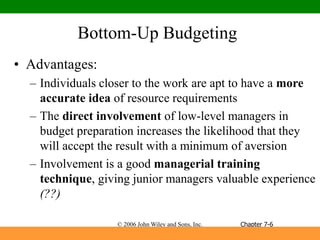

Bottom-Up Budgeting
• Advantages:
– Individuals closer to the work are apt to have a more
accurate idea of resource requirements
– The direct involvement of low-level managers in
budget preparation increases the likelihood that they
will accept the result with a minimum of aversion
– Involvement is a good managerial training
technique, giving junior managers valuable experience
(??)
Chapter 7-6
© 2006 John Wiley and Sons, Inc.

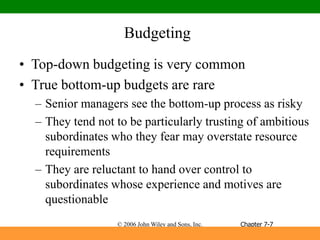

Budgeting
• Top-down budgeting is very common
• True bottom-up budgets are rare
– Senior managers see the bottom-up process as risky
– They tend not to be particularly trusting of ambitious
subordinates who they fear may overstate resource
requirements
– They are reluctant to hand over control to
subordinates whose experience and motives are
questionable
Chapter 7-7
© 2006 John Wiley and Sons, Inc.

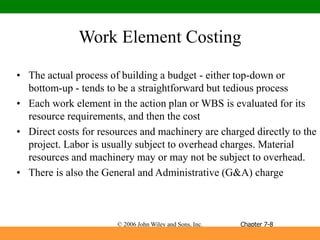

Work Element Costing
• The actual process of building a budget - either top-down or
bottom-up - tends to be a straightforward but tedious process
• Each work element in the action plan or WBS is evaluated for its
resource requirements, and then the cost
• Direct costs for resources and machinery are charged directly to the
project. Labor is usually subject to overhead charges. Material
resources and machinery may or may not be subject to overhead.
• There is also the General and Administrative (G&A) charge
Chapter 7-8
© 2006 John Wiley and Sons, Inc.
An Iterative Budgeting Process
• Resource estimates and actual requirements are rarely the
same for several reasons:
– The farther one moves up the organizational chart, the easier,
faster and cheaper the job looks
– Wishful thinking leads the superior to underestimate cost (and
time) because the superior has a stake in representing the project
as a profitable venture
– The subordinates are led to build-in some level of protection
against failure by adding an allowance for “Murphy’s Law”
Chapter 7-9

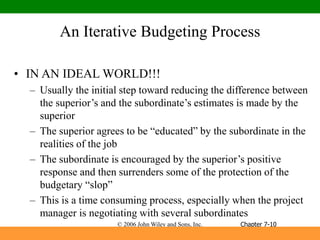

© 2006 John Wiley and Sons, Inc.
An Iterative Budgeting Process
• IN AN IDEAL WORLD!!!
– Usually the initial step toward reducing the difference between
the superior’s and the subordinate’s estimates is made by the
superior
– The superior agrees to be “educated” by the subordinate in the
realities of the job
– The subordinate is encouraged by the superior’s positive
response and then surrenders some of the protection of the
budgetary “slop”
– This is a time consuming process, especially when the project
manager is negotiating with several subordinates
Chapter 7-10
© 2006 John Wiley and Sons, Inc.

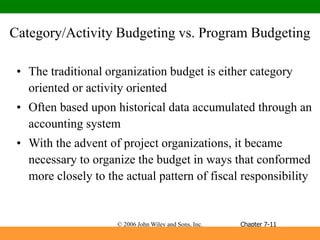

Category/Activity Budgeting vs. Program Budgeting
• The traditional organization budget is either category
oriented or activity oriented
• Often based upon historical data accumulated through an
accounting system
• With the advent of project organizations, it became
necessary to organize the budget in ways that conformed
more closely to the actual pattern of fiscal responsibility
Chapter 7-11
© 2006 John Wiley and Sons, Inc.

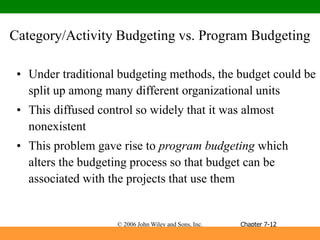

Category/Activity Budgeting vs. Program Budgeting
• Under traditional budgeting methods, the budget could be
split up among many different organizational units
• This diffused control so widely that it was almost
nonexistent
• This problem gave rise to program budgeting which
alters the budgeting process so that budget can be
associated with the projects that use them
Chapter 7-12
© 2006 John Wiley and Sons, Inc.
Program Budgeting
• Program budgeting aggregates income and expenditures
across programs (projects)
• Aggregation by program is in addition to, not instead of,
aggregation by organizational unit
• These budgets usually take the form of a spreadsheet with
standard categories disaggregated into “regular
operations” and charges to the various projects
Chapter 7-13
© 2006 John Wiley and Sons, Inc.

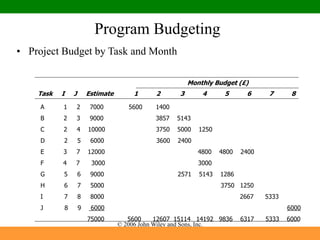

Program Budgeting
• Project Budget by Task and Month
Chapter 7-14
Task I J Estimate 1 2 3 4 5 6 7 8
Monthly Budget (£)
A 1 2 7000 5600 1400
B 2 3 9000 3857 5143
C 2 4 10000 3750 5000 1250
D 2 5 6000 3600 2400
E 3 7 12000 4800 4800 2400
F 4 7 3000 3000
G 5 6 9000 2571 5143 1286
H 6 7 5000 3750 1250
I 7 8 8000 2667 5333
J 8 9 6000 6000
75000 5600 12607 15114 14192 9836 6317 5333 6000
© 2006 John Wiley and Sons, Inc.

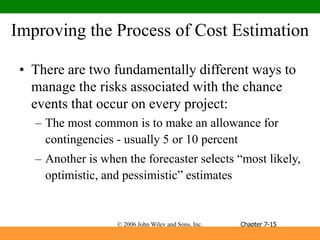

Improving the Process of Cost Estimation
• There are two fundamentally different ways to
manage the risks associated with the chance
events that occur on every project:
– The most common is to make an allowance for
contingencies - usually 5 or 10 percent
– Another is when the forecaster selects “most likely,
optimistic, and pessimistic” estimates
Chapter 7-15
© 2006 John Wiley and Sons, Inc.

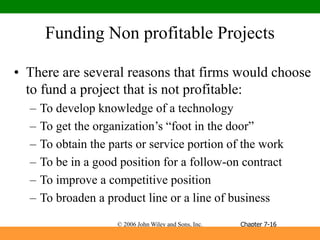

Funding Non profitable Projects
• There are several reasons that firms would choose
to fund a project that is not profitable:
– To develop knowledge of a technology
– To get the organization’s “foot in the door”
– To obtain the parts or service portion of the work
– To be in a good position for a follow-on contract
– To improve a competitive position
– To broaden a product line or a line of business
Chapter 7-16
© 2006 John Wiley and Sons, Inc.
Learning Curves
• Studies have shown that human performance usually improves
when a task is repeated
• In general, performance improves by a fixed percent each time
production doubles
• More specifically, each time the output doubles, the worker hours
per unit decrease to a fixed percentage of their previous value
• That percentage is called the learning rate
• The project manager should take the learning curve into account
for any task where labor is significant
Chapter 7-17
© 2006 John Wiley and Sons, Inc.

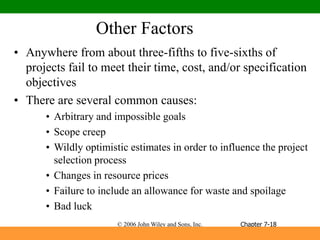

Other Factors
• Anywhere from about three-fifths to five-sixths of
projects fail to meet their time, cost, and/or specification
objectives
• There are several common causes:
• Arbitrary and impossible goals
• Scope creep
• Wildly optimistic estimates in order to influence the project
selection process
• Changes in resource prices
• Failure to include an allowance for waste and spoilage
• Bad luck
Chapter 7-18
© 2006 John Wiley and Sons, Inc.

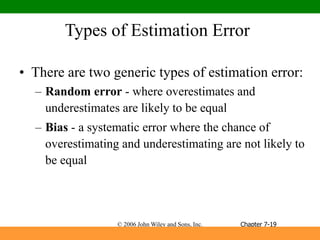

Types of Estimation Error
• There are two generic types of estimation error:
– Random error - where overestimates and
underestimates are likely to be equal
– Bias - a systematic error where the chance of
overestimating and underestimating are not likely to
be equal
Chapter 7-19
© 2006 John Wiley and Sons, Inc.
Copyright 2006 John Wiley & Sons, Inc.
All rights reserved. Reproduction or translation of this work beyond that permitted in section 117
of the 1976 United States Copyright Act without express permission of the copyright owner is
unlawful. Request for further information should be addressed to the Permissions Department,
John Wiley & Sons, Inc. The Publisher assumes no responsibility for errors, omissions, or
damages caused by the use of these programs or from the use of the information herein.

Project management:A managerial approach

  • 1.
    © 2006 JohnWiley and Sons, Inc. Project Management: A Managerial Approach Chapter 7 – Budgeting and Cost Estimation
  • 2.
    © 2006 JohnWiley and Sons, Inc. Overview • Estimating Project Budgets – Top-down – Bottom-up • Work Element Costing • Budget Iteration • Activity Budgets • Continuous Budget Improvement
  • 3.
    © 2006 JohnWiley and Sons, Inc. Budgeting and Cost Estimation • The budget serves as a standard for comparison • It is a baseline from which to measure the difference between the actual and planned use of resources • Budgeting procedures must associate resource use with the achievement of organizational goals or the planning/control process becomes useless • The budget is simply the project plan in another form Chapter 7-1
  • 4.
    © 2006 JohnWiley and Sons, Inc. Estimating Project Budgets • In order to develop a budget, we must: – Forecast what resources the project will require – Determine the required quantity of each – Decide when they will be needed – Understand how much they will cost - including the effects of potential price inflation • There are two fundamentally different strategies for data gathering: – Top-down – Bottom-up Chapter 7-2
  • 5.
    © 2006 JohnWiley and Sons, Inc. Activity-Oriented Budgets
  • 6.
    © 2006 JohnWiley and Sons, Inc. Top-Down Budgeting • This strategy is based on collecting the judgment and experiences of top and middle managers • These cost estimates are then given to lower level managers, who are expected to continue the breakdown into budget estimates • This process continues to the lowest level – Aka: BBS – Budget Breakdown Structure Chapter 7-3
  • 7.
    © 2006 JohnWiley and Sons, Inc. Top-Down Budgeting • Advantages: – Aggregate budgets can often be developed quite accurately – Budgets are stable as a percent of total allocation – The statistical distribution is also stable, making for high predictability – Small yet costly tasks do not need to be individually identified (???) – The experience and judgment of the executive accounts for small but important tasks to be factored into the overall estimate Chapter 7-4
  • 8.
    © 2006 JohnWiley and Sons, Inc. Bottom-Up Budgeting • In this method, elemental tasks, their schedules, and their individual budgets are constructed following the WBS or project action plan • The people doing the work are consulted regarding times and budgets for the tasks to ensure the best level of accuracy • Initially, estimates are made in terms of resources, such as labor hours and materials • Bottom-up budgets should be and usually are, more accurate in the detailed tasks, but it is critical that all elements be included Chapter 7-5
  • 9.
    © 2006 JohnWiley and Sons, Inc. Bottom-Up Budgeting • Advantages: – Individuals closer to the work are apt to have a more accurate idea of resource requirements – The direct involvement of low-level managers in budget preparation increases the likelihood that they will accept the result with a minimum of aversion – Involvement is a good managerial training technique, giving junior managers valuable experience (??) Chapter 7-6
  • 10.
    © 2006 JohnWiley and Sons, Inc. Budgeting • Top-down budgeting is very common • True bottom-up budgets are rare – Senior managers see the bottom-up process as risky – They tend not to be particularly trusting of ambitious subordinates who they fear may overstate resource requirements – They are reluctant to hand over control to subordinates whose experience and motives are questionable Chapter 7-7
  • 11.
    © 2006 JohnWiley and Sons, Inc. Work Element Costing • The actual process of building a budget - either top-down or bottom-up - tends to be a straightforward but tedious process • Each work element in the action plan or WBS is evaluated for its resource requirements, and then the cost • Direct costs for resources and machinery are charged directly to the project. Labor is usually subject to overhead charges. Material resources and machinery may or may not be subject to overhead. • There is also the General and Administrative (G&A) charge Chapter 7-8
  • 12.
    © 2006 JohnWiley and Sons, Inc. An Iterative Budgeting Process • Resource estimates and actual requirements are rarely the same for several reasons: – The farther one moves up the organizational chart, the easier, faster and cheaper the job looks – Wishful thinking leads the superior to underestimate cost (and time) because the superior has a stake in representing the project as a profitable venture – The subordinates are led to build-in some level of protection against failure by adding an allowance for “Murphy’s Law” Chapter 7-9
  • 13.
    © 2006 JohnWiley and Sons, Inc. An Iterative Budgeting Process • IN AN IDEAL WORLD!!! – Usually the initial step toward reducing the difference between the superior’s and the subordinate’s estimates is made by the superior – The superior agrees to be “educated” by the subordinate in the realities of the job – The subordinate is encouraged by the superior’s positive response and then surrenders some of the protection of the budgetary “slop” – This is a time consuming process, especially when the project manager is negotiating with several subordinates Chapter 7-10
  • 14.
    © 2006 JohnWiley and Sons, Inc. Category/Activity Budgeting vs. Program Budgeting • The traditional organization budget is either category oriented or activity oriented • Often based upon historical data accumulated through an accounting system • With the advent of project organizations, it became necessary to organize the budget in ways that conformed more closely to the actual pattern of fiscal responsibility Chapter 7-11
  • 15.
    © 2006 JohnWiley and Sons, Inc. Category/Activity Budgeting vs. Program Budgeting • Under traditional budgeting methods, the budget could be split up among many different organizational units • This diffused control so widely that it was almost nonexistent • This problem gave rise to program budgeting which alters the budgeting process so that budget can be associated with the projects that use them Chapter 7-12
  • 16.
    © 2006 JohnWiley and Sons, Inc. Program Budgeting • Program budgeting aggregates income and expenditures across programs (projects) • Aggregation by program is in addition to, not instead of, aggregation by organizational unit • These budgets usually take the form of a spreadsheet with standard categories disaggregated into “regular operations” and charges to the various projects Chapter 7-13
  • 17.
    © 2006 JohnWiley and Sons, Inc. Program Budgeting • Project Budget by Task and Month Chapter 7-14 Task I J Estimate 1 2 3 4 5 6 7 8 Monthly Budget (£) A 1 2 7000 5600 1400 B 2 3 9000 3857 5143 C 2 4 10000 3750 5000 1250 D 2 5 6000 3600 2400 E 3 7 12000 4800 4800 2400 F 4 7 3000 3000 G 5 6 9000 2571 5143 1286 H 6 7 5000 3750 1250 I 7 8 8000 2667 5333 J 8 9 6000 6000 75000 5600 12607 15114 14192 9836 6317 5333 6000
  • 18.
    © 2006 JohnWiley and Sons, Inc. Improving the Process of Cost Estimation • There are two fundamentally different ways to manage the risks associated with the chance events that occur on every project: – The most common is to make an allowance for contingencies - usually 5 or 10 percent – Another is when the forecaster selects “most likely, optimistic, and pessimistic” estimates Chapter 7-15
  • 19.
    © 2006 JohnWiley and Sons, Inc. Funding Non profitable Projects • There are several reasons that firms would choose to fund a project that is not profitable: – To develop knowledge of a technology – To get the organization’s “foot in the door” – To obtain the parts or service portion of the work – To be in a good position for a follow-on contract – To improve a competitive position – To broaden a product line or a line of business Chapter 7-16
  • 20.
    © 2006 JohnWiley and Sons, Inc. Learning Curves • Studies have shown that human performance usually improves when a task is repeated • In general, performance improves by a fixed percent each time production doubles • More specifically, each time the output doubles, the worker hours per unit decrease to a fixed percentage of their previous value • That percentage is called the learning rate • The project manager should take the learning curve into account for any task where labor is significant Chapter 7-17
  • 21.
    © 2006 JohnWiley and Sons, Inc. Other Factors • Anywhere from about three-fifths to five-sixths of projects fail to meet their time, cost, and/or specification objectives • There are several common causes: • Arbitrary and impossible goals • Scope creep • Wildly optimistic estimates in order to influence the project selection process • Changes in resource prices • Failure to include an allowance for waste and spoilage • Bad luck Chapter 7-18
  • 22.
    © 2006 JohnWiley and Sons, Inc. Types of Estimation Error • There are two generic types of estimation error: – Random error - where overestimates and underestimates are likely to be equal – Bias - a systematic error where the chance of overestimating and underestimating are not likely to be equal Chapter 7-19
  • 23.
    © 2006 JohnWiley and Sons, Inc. Copyright 2006 John Wiley & Sons, Inc. All rights reserved. Reproduction or translation of this work beyond that permitted in section 117 of the 1976 United States Copyright Act without express permission of the copyright owner is unlawful. Request for further information should be addressed to the Permissions Department, John Wiley & Sons, Inc. The Publisher assumes no responsibility for errors, omissions, or damages caused by the use of these programs or from the use of the information herein.
