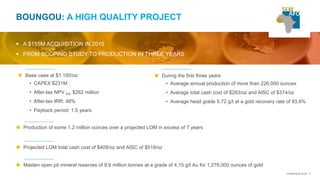

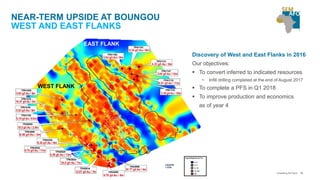

1. The document discusses SEMAFO's Boungou gold mine project in Burkina Faso, including highlights from the feasibility study and construction plans.

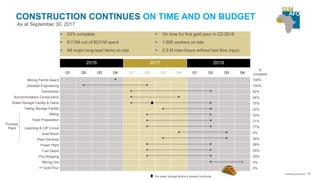

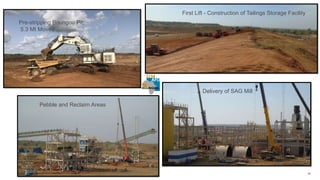

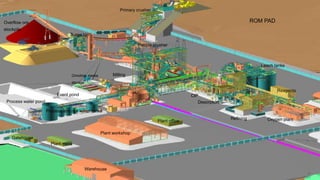

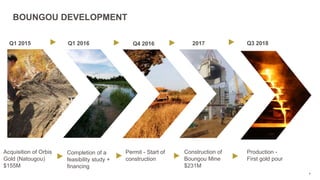

2. Construction is scheduled to be completed in Q3 2018, with first gold pour expected in Q4 2018. The mine is projected to produce over 1.2 million ounces of gold over its estimated 7+ year life.

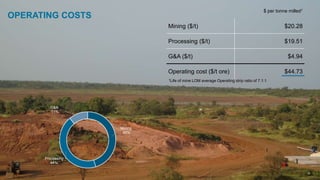

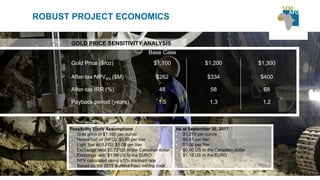

3. The feasibility study shows strong economics for the project, with an after-tax IRR of 48% and payback period of 1.5 years at a gold price of $1,100/oz. Operating costs are estimated at $408/oz total cash cost and $518/oz all-in sustaining cost over
