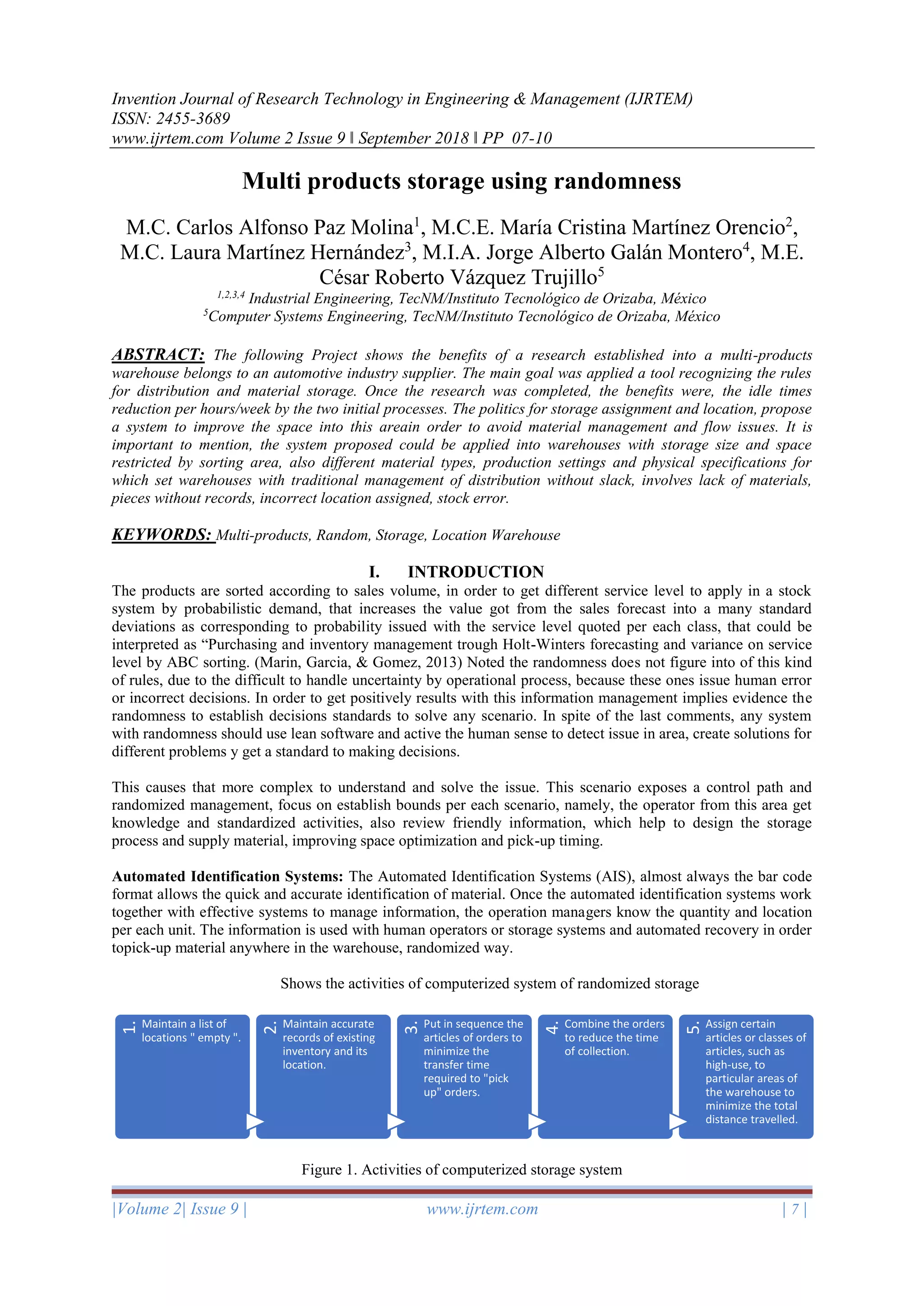

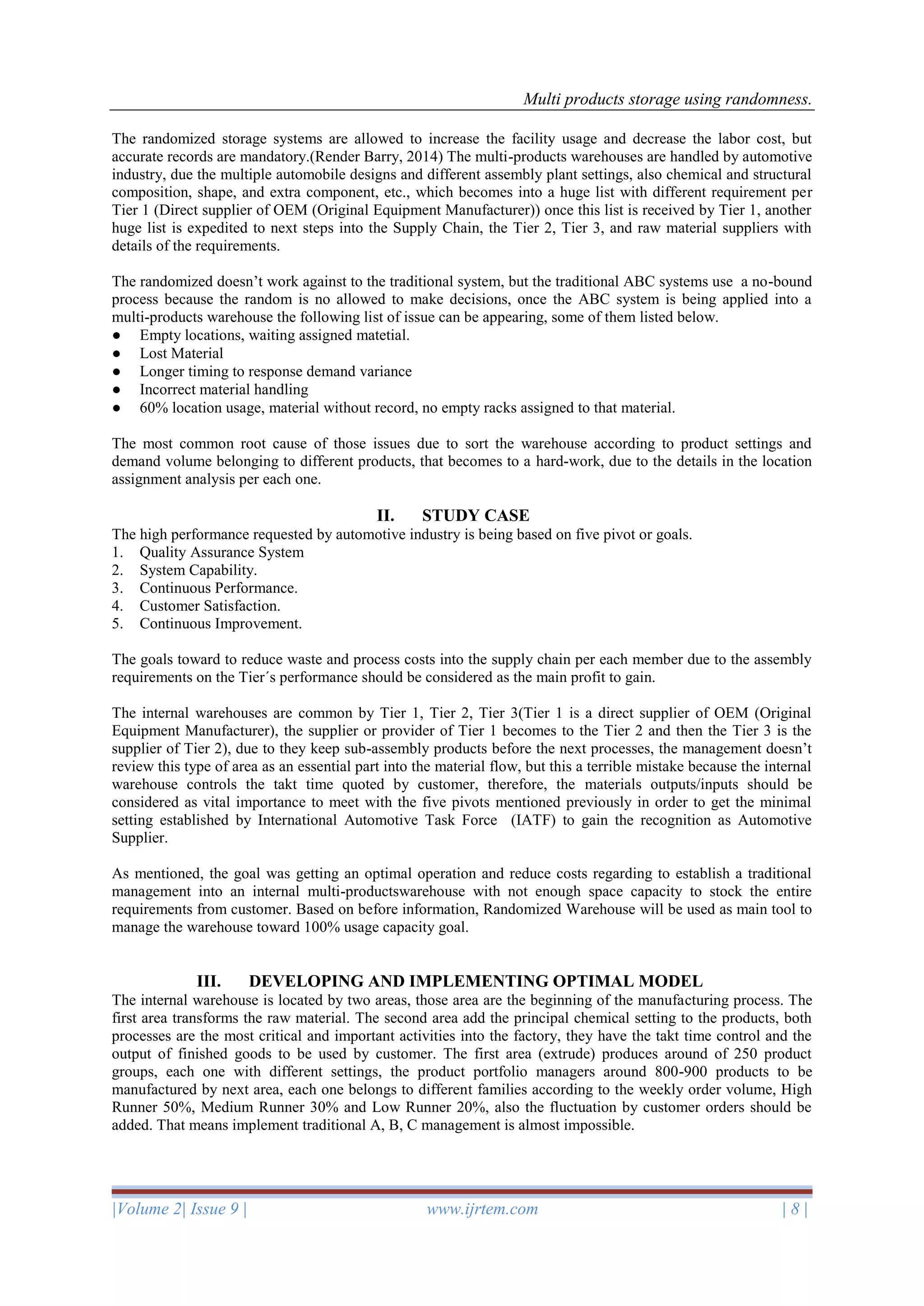

This document discusses a study of implementing a randomized storage system in a multi-product warehouse belonging to an automotive supplier. The traditional ABC storage system was causing issues like empty locations, lost materials, and long response times to demand variability. The researchers implemented a randomized storage tool that assigns materials to zones based on similar characteristics rather than specific locations. This increased warehouse utilization from 60% to 80-90% and reduced idle time for production areas from 9,000 to 1,000 hours per week. The randomized system provides more flexibility to handle fluctuations while maintaining accurate material records. Training operators and continuous improvement were important to successfully adopting the new approach.
