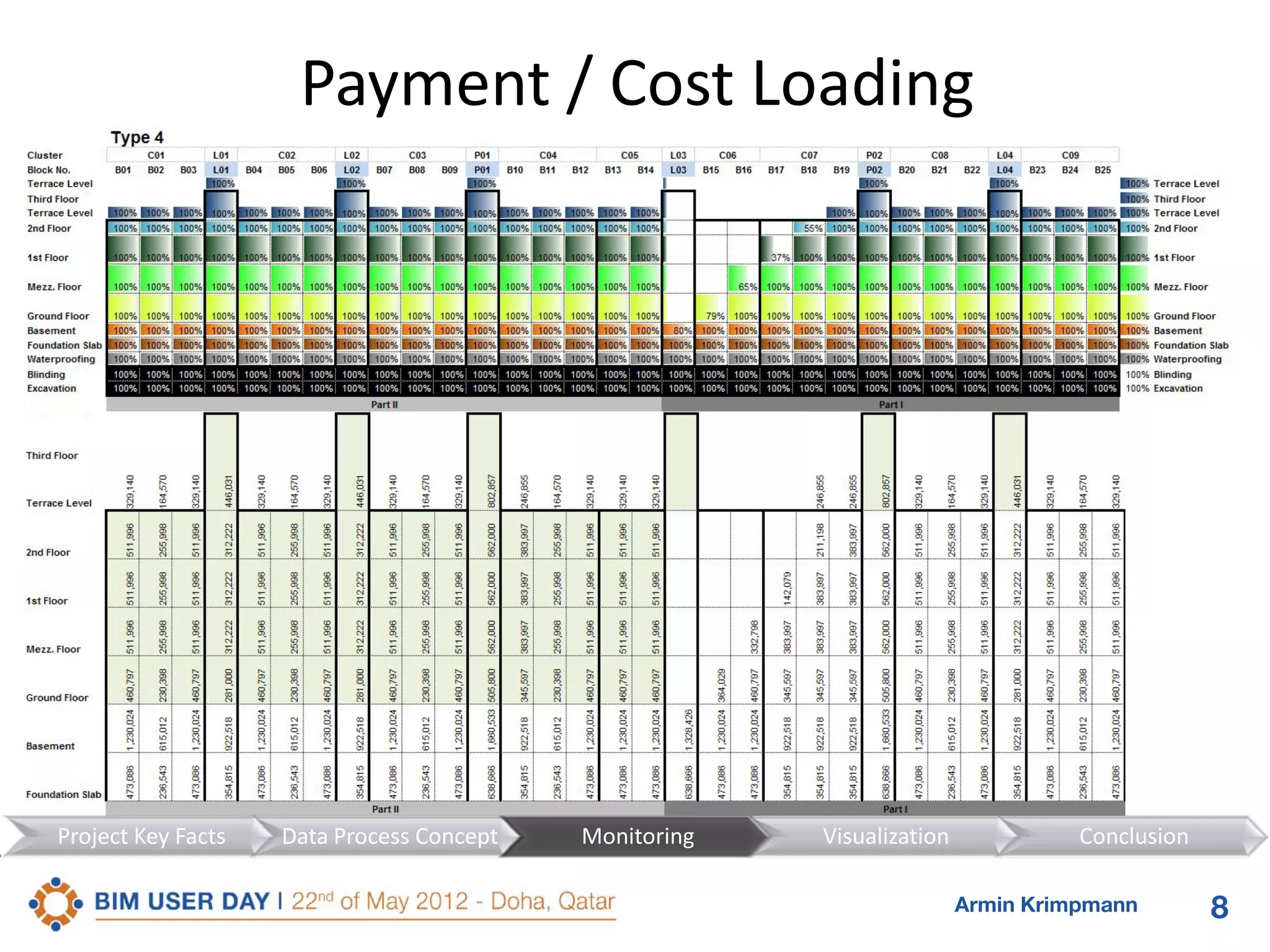

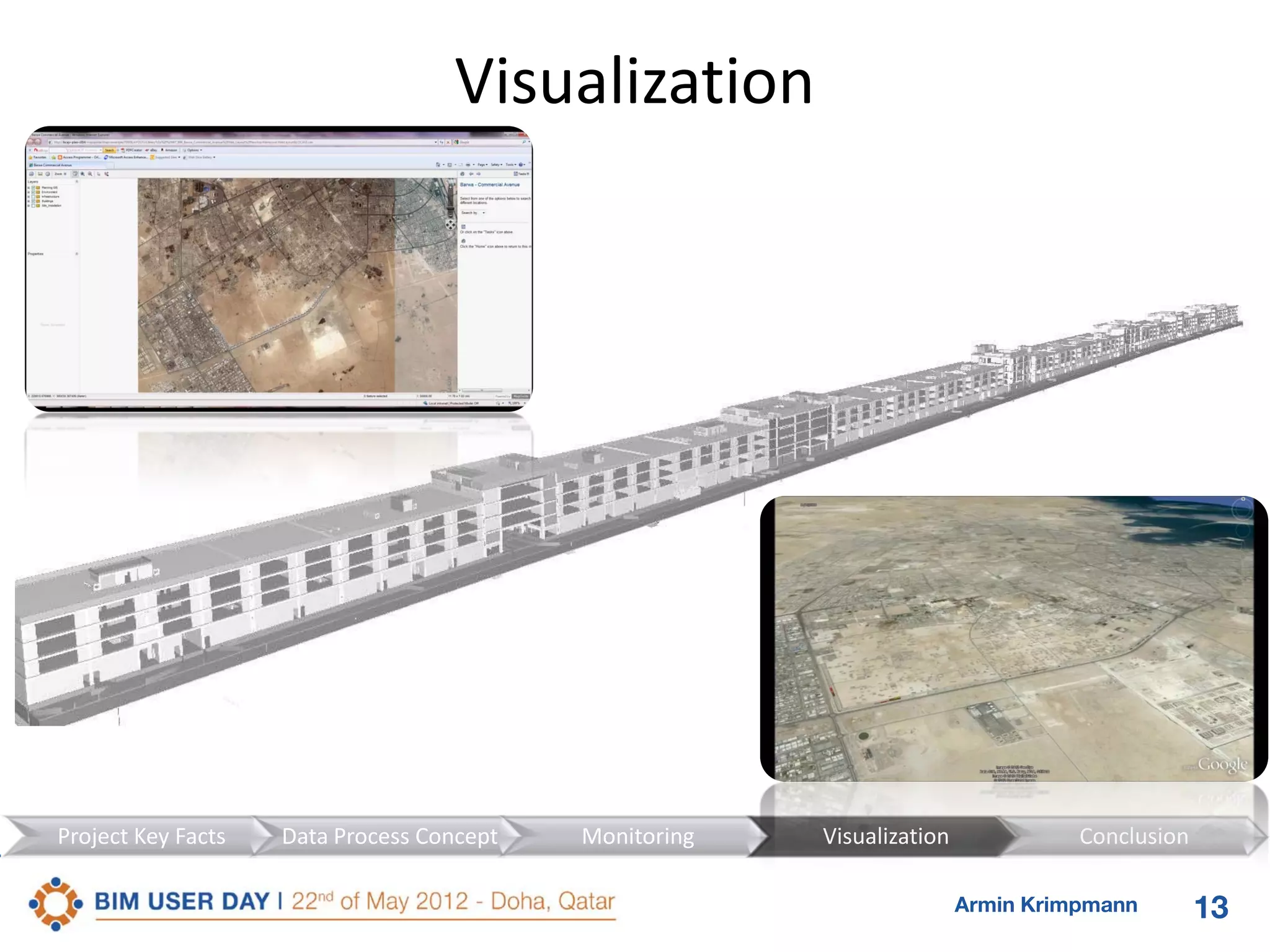

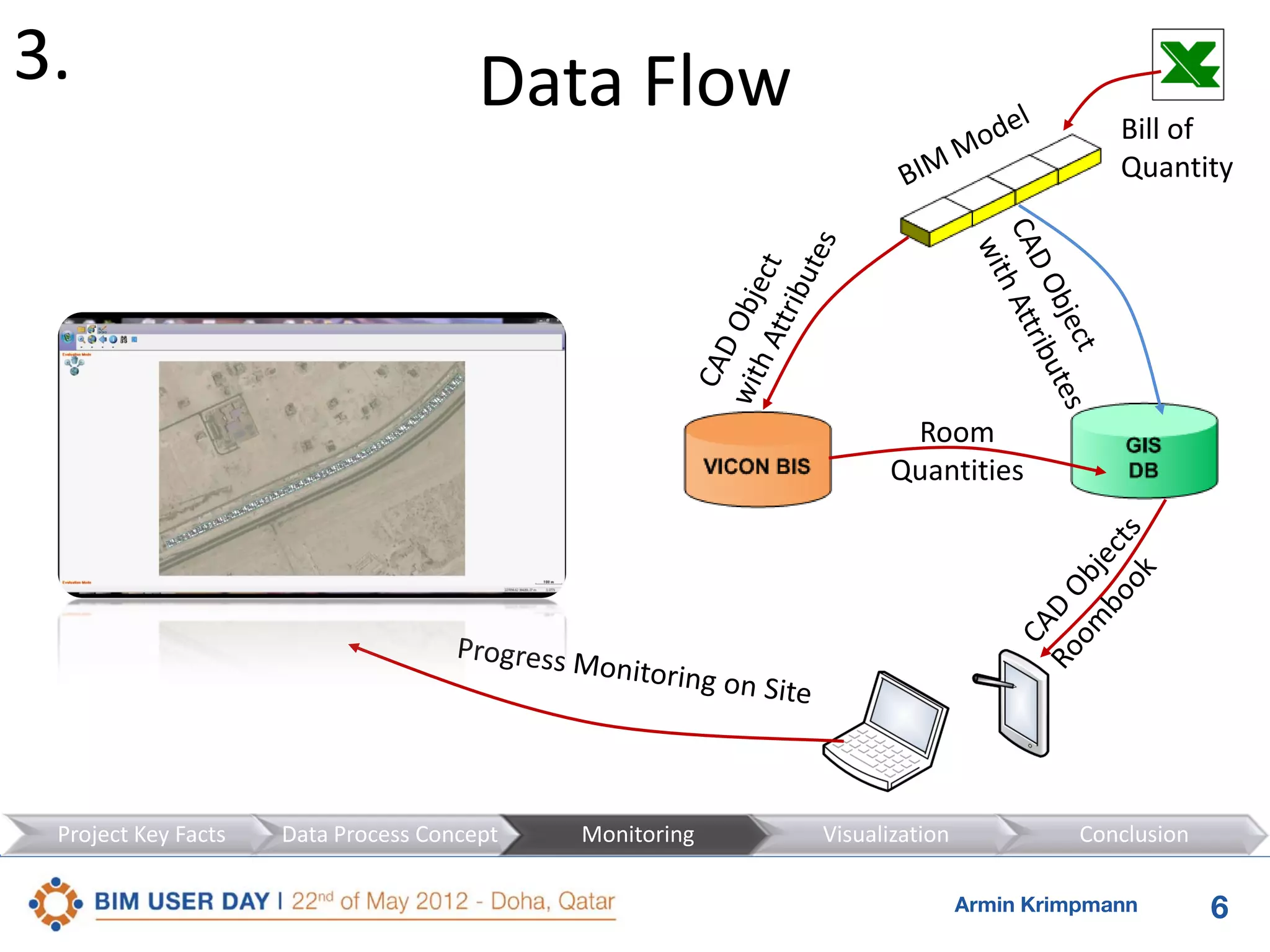

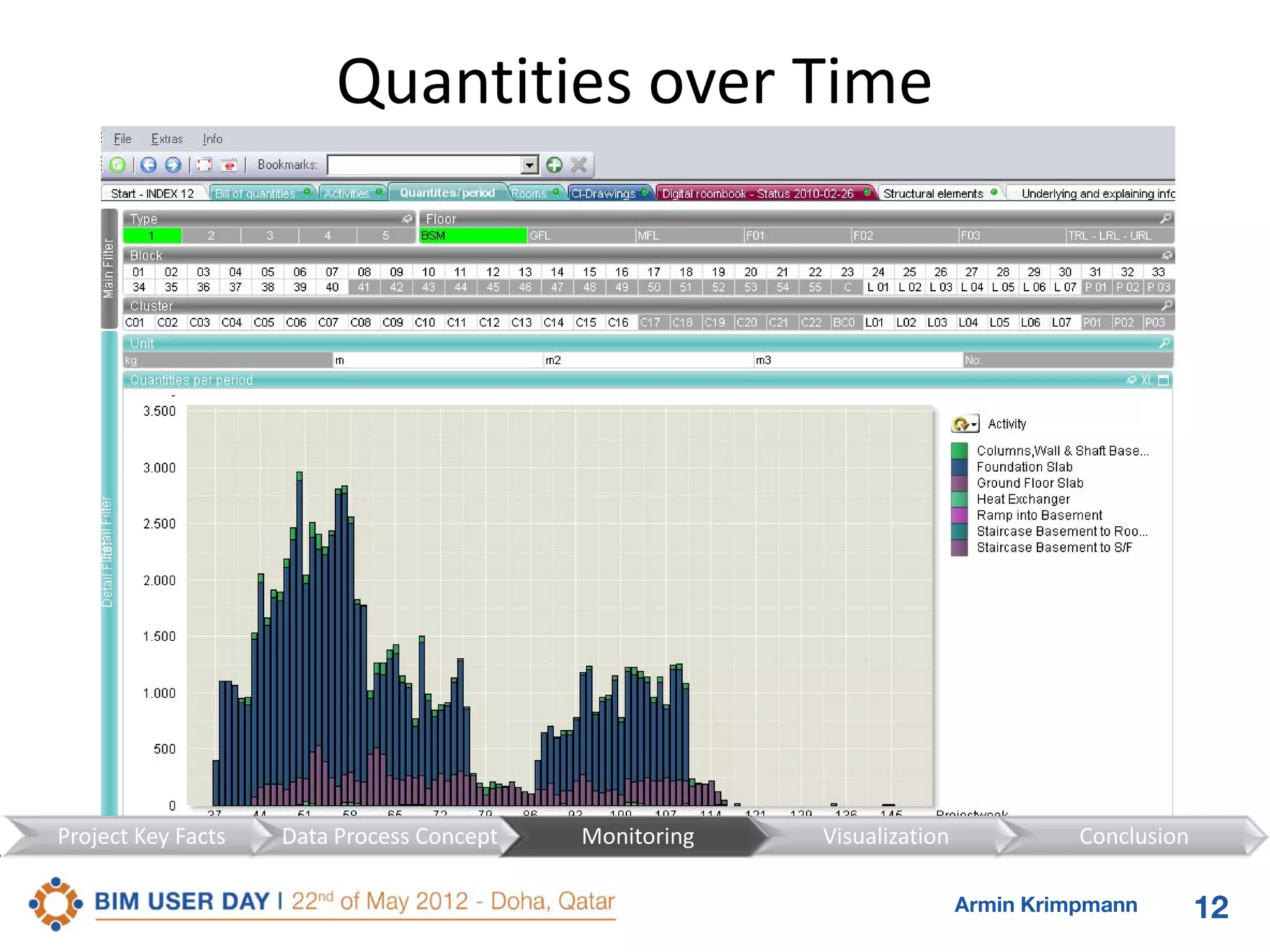

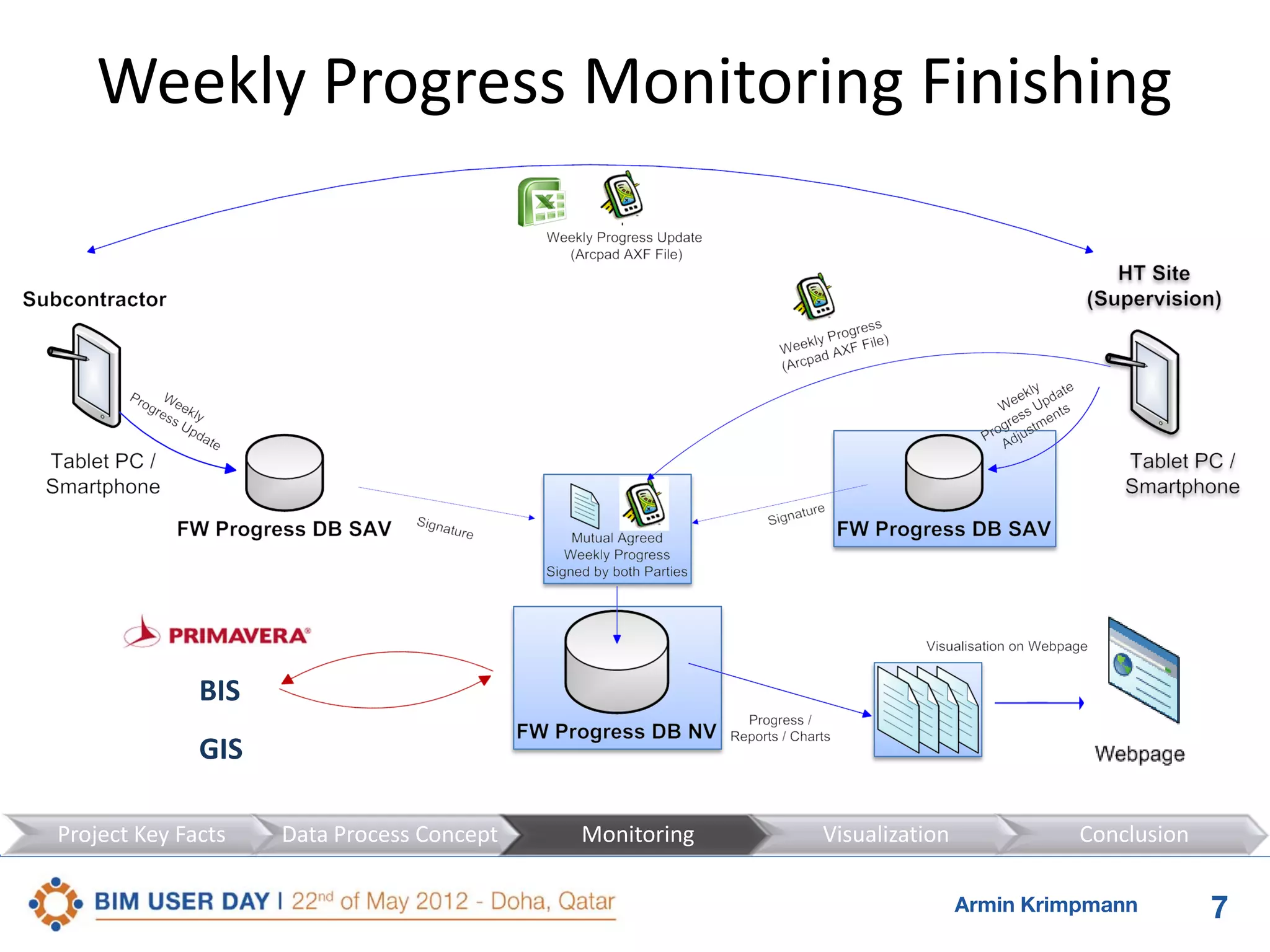

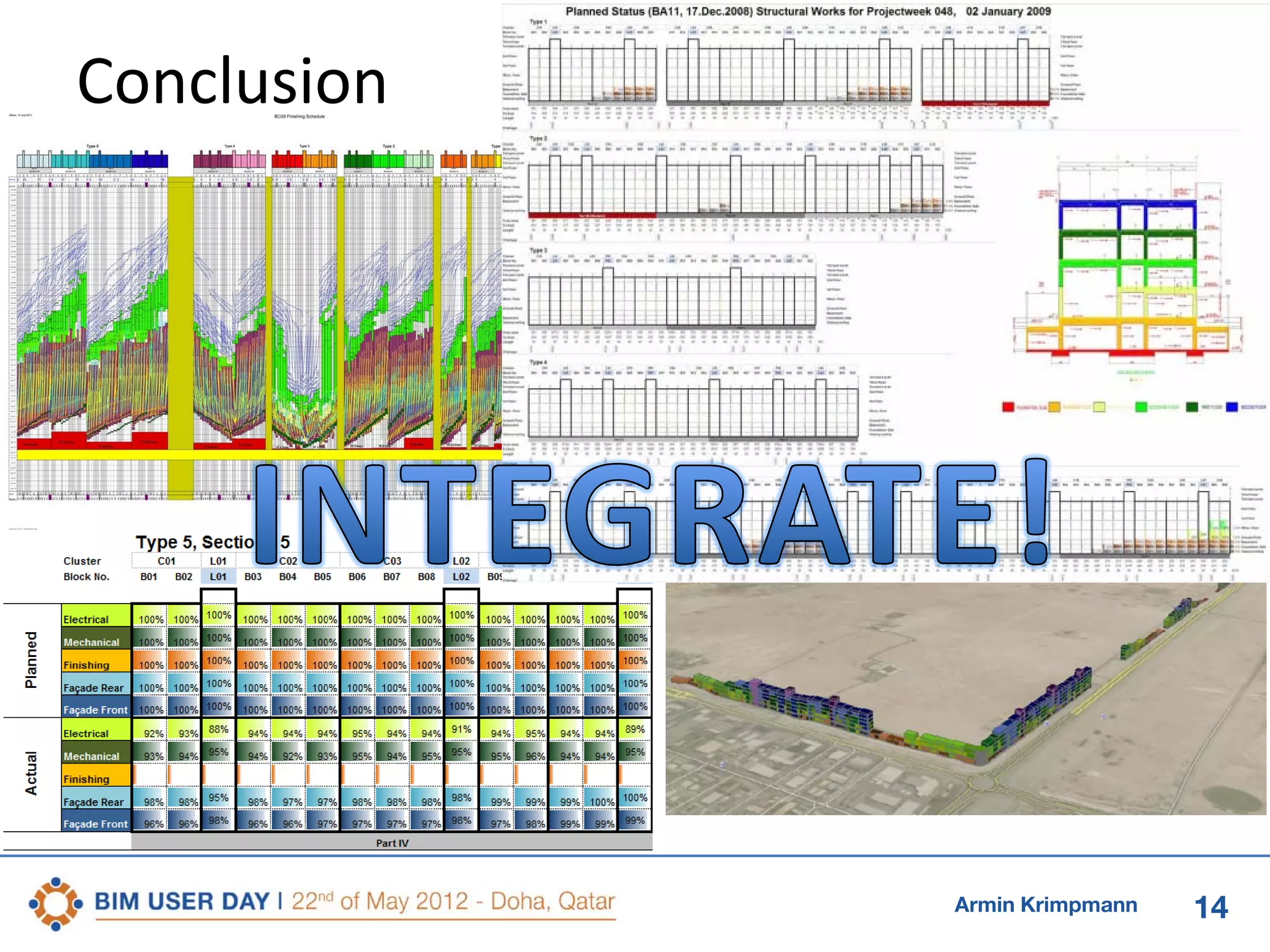

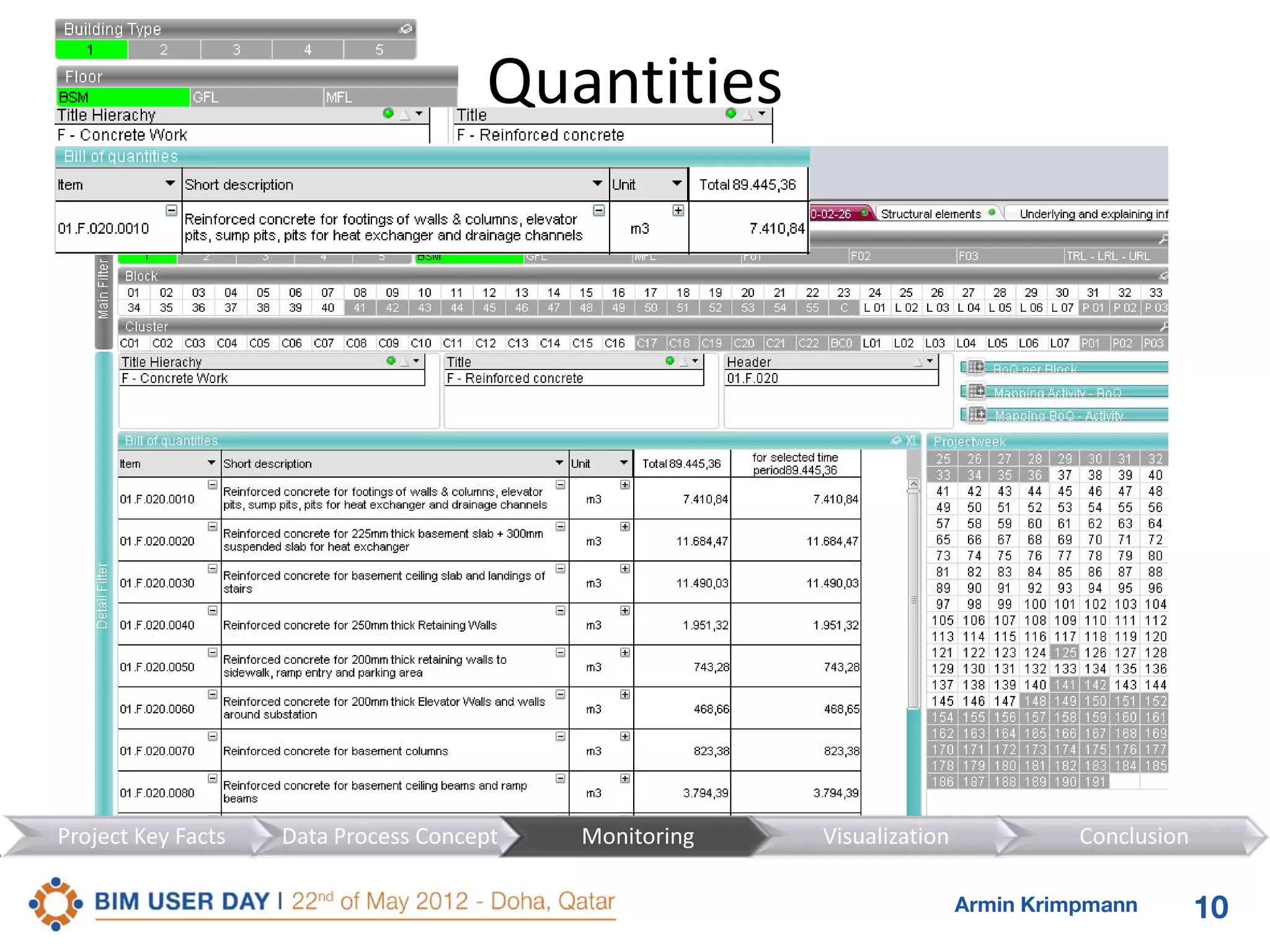

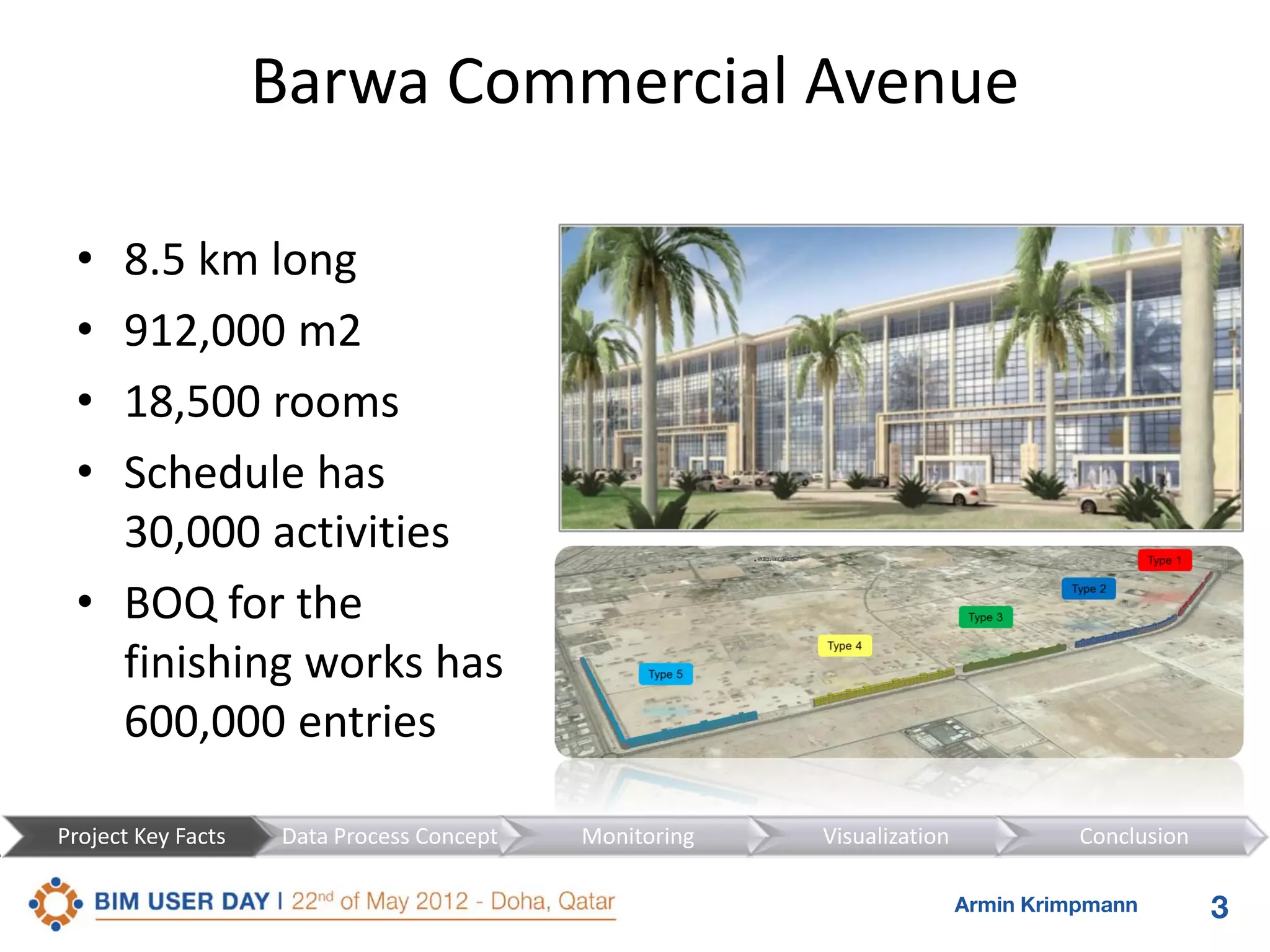

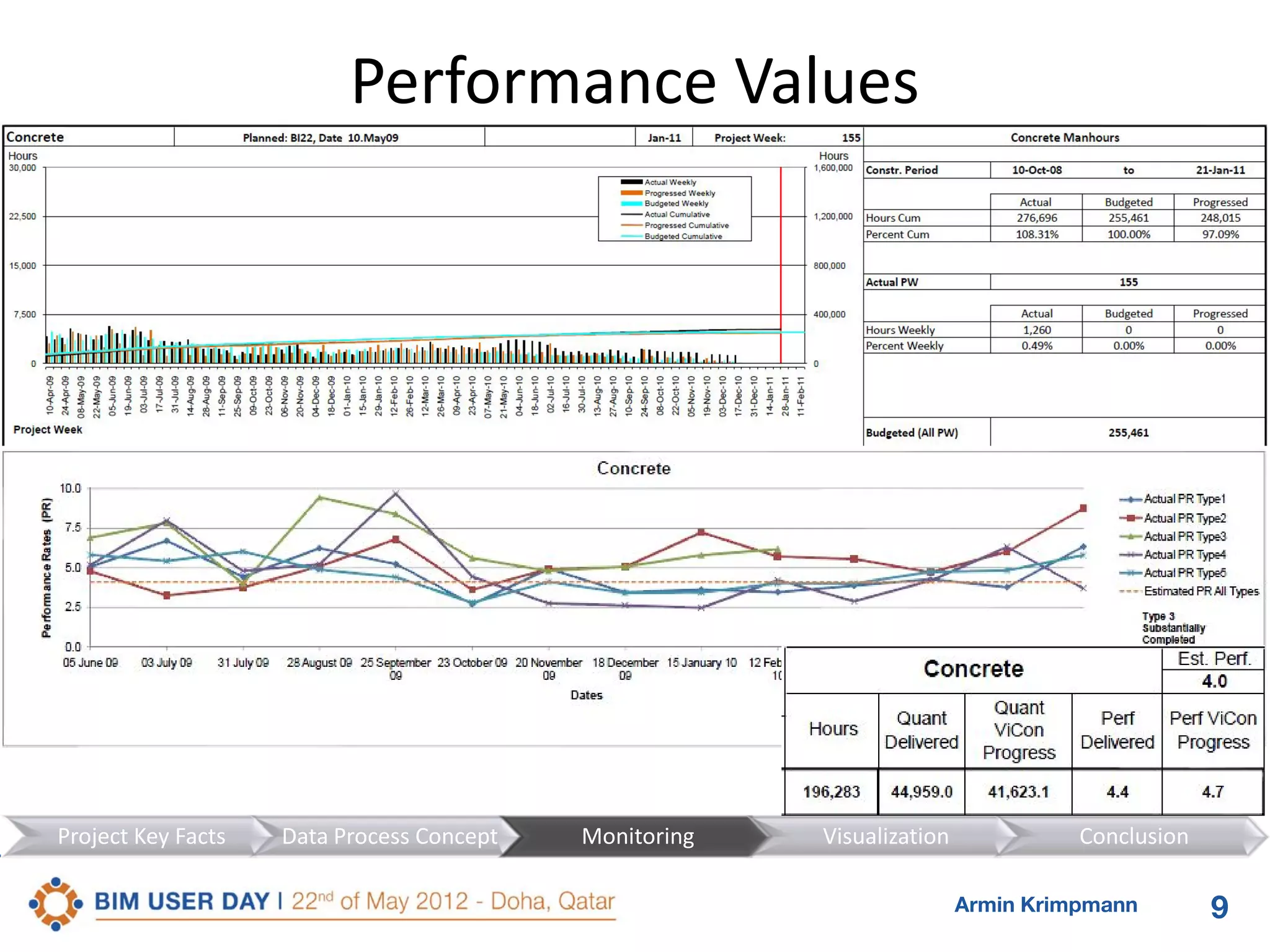

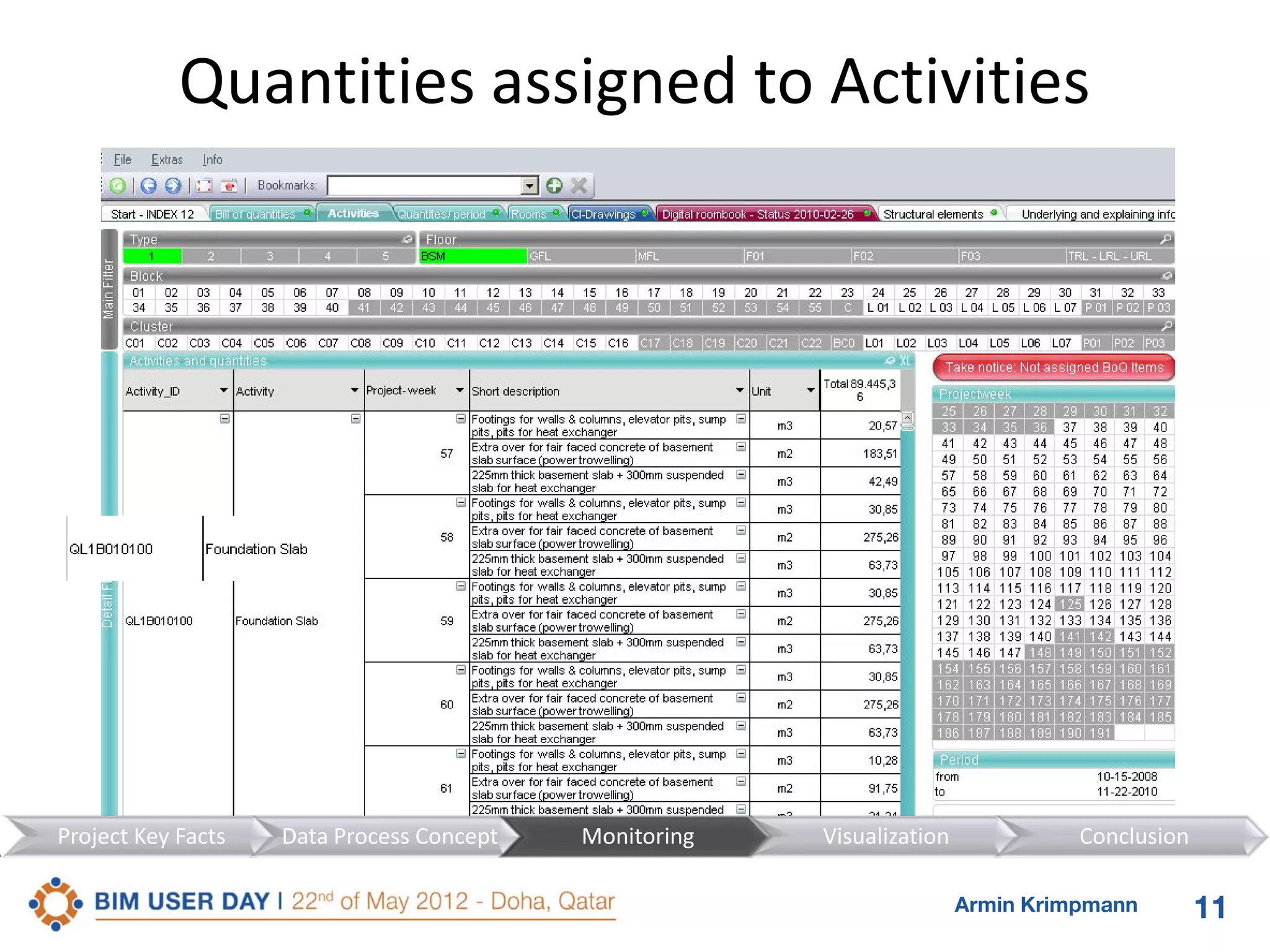

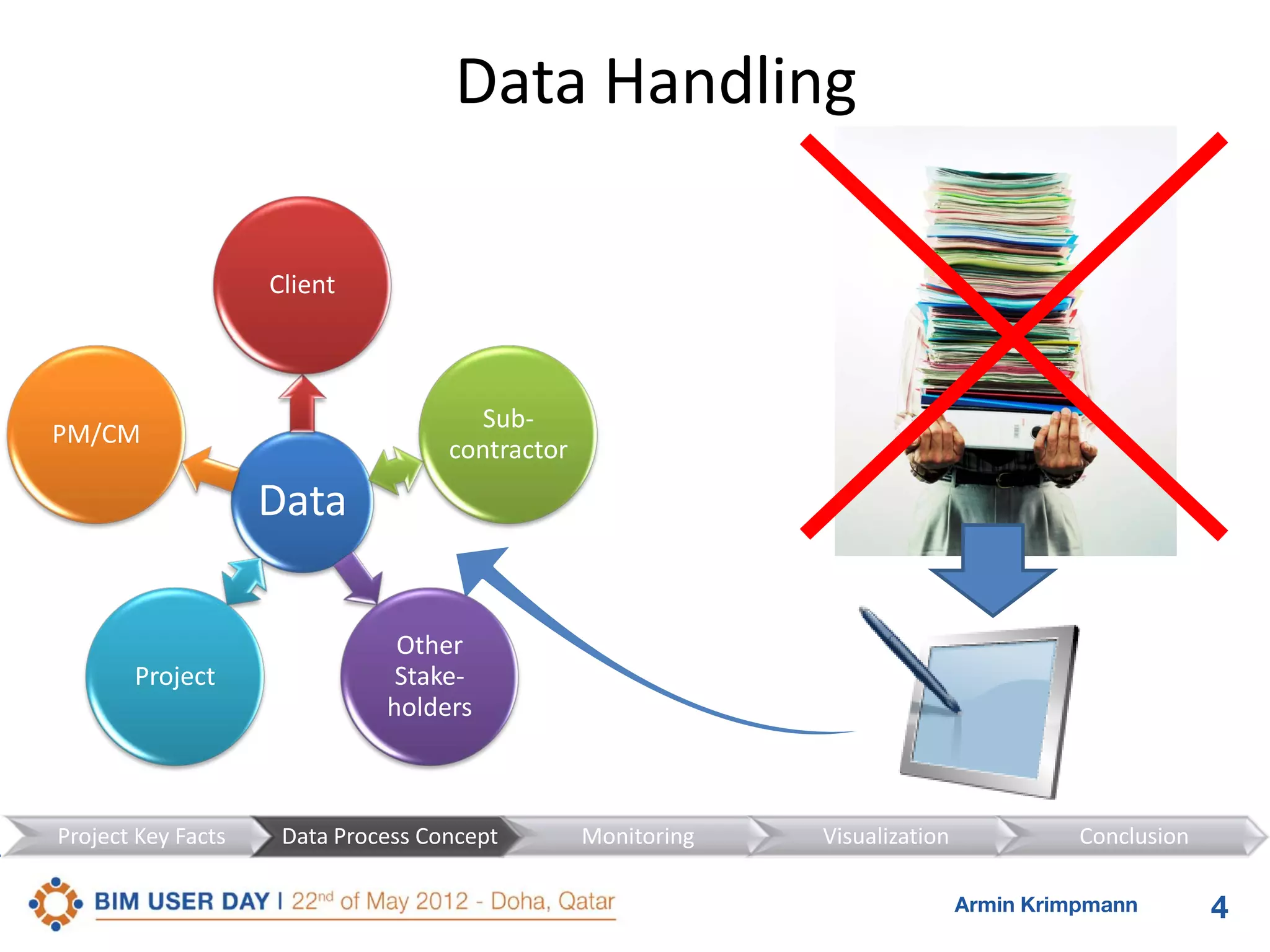

The document outlines a case study on the progress and cost monitoring process for the Barwa Commercial Avenue project, which covers 8.5 km and consists of 912,000 m2 and 18,500 rooms. It discusses the project's key facts, data handling, monitoring processes, and visualization techniques to track performance and activities. The conclusion synthesizes the findings from data processing and monitoring throughout the project's life cycle.
