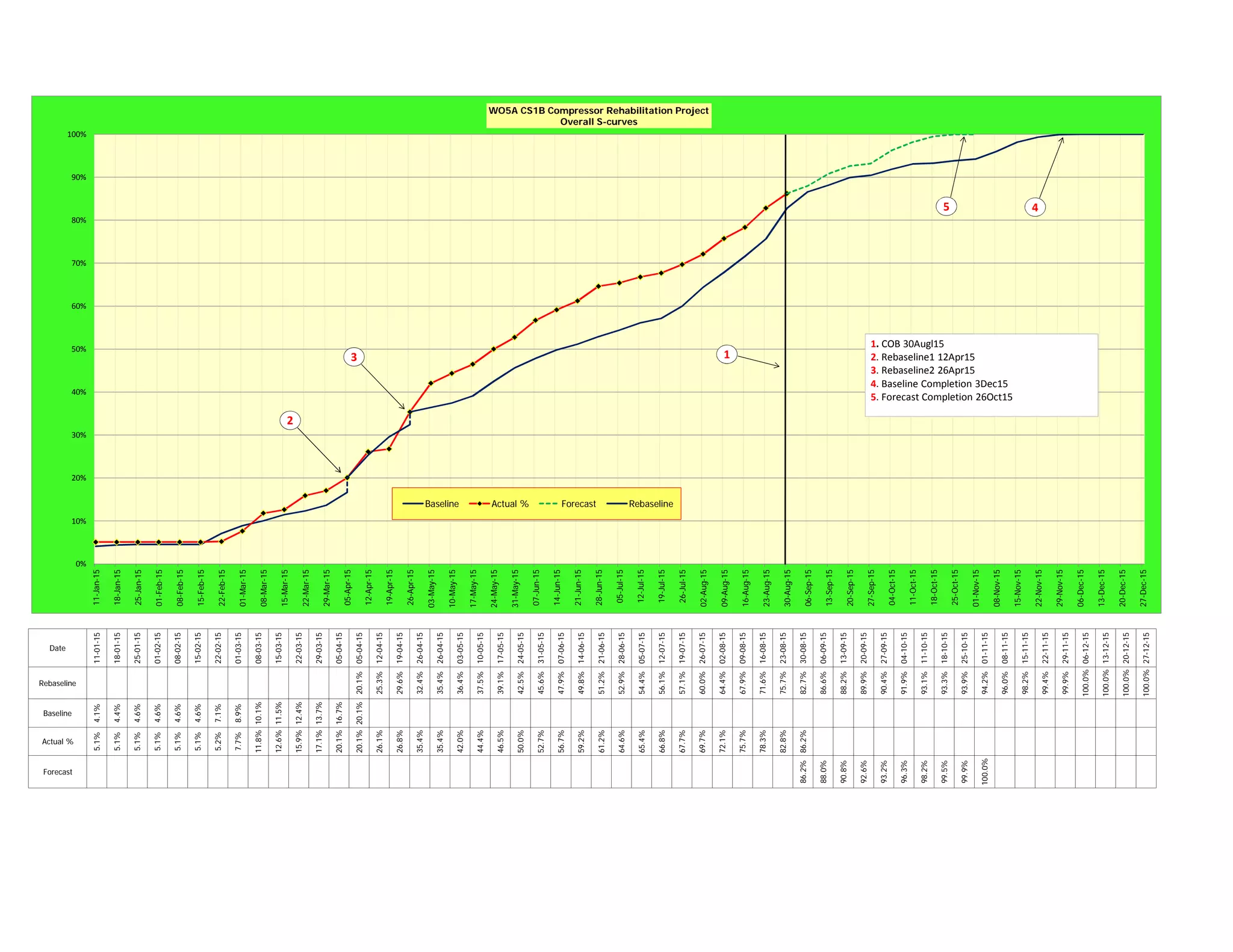

The document contains data tracking the progress of a compressor rehabilitation project over time from January 2015 to December 2015. It includes the dates, baseline, actual, and forecasted percentage completions. There were four key events: the original baseline completion was set for December 3, 2015; the baseline was rebaselined on April 12, 2015 and again on April 26, 2015 due to project changes; the forecasted completion was moved up to October 26, 2015; and the project actually completed on August 30, 2015, ahead of both the original and reforecasted schedules.
