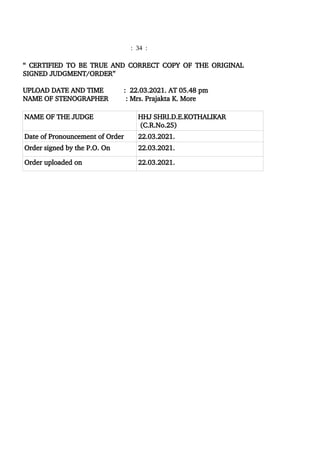

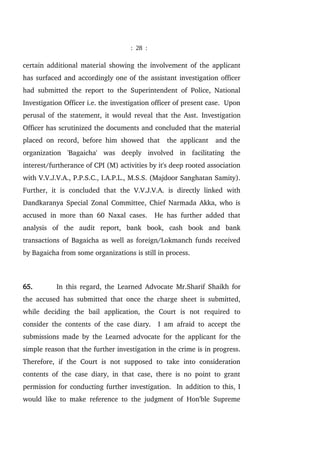

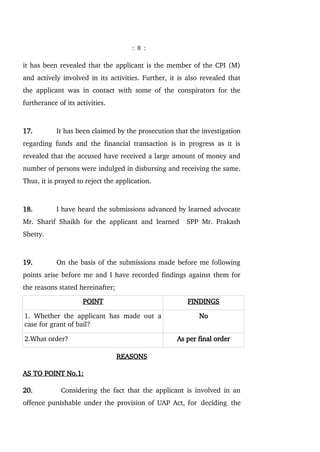

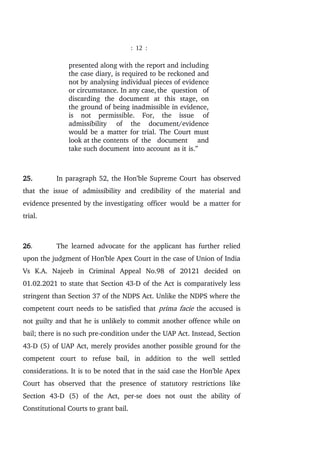

1. The document summarizes a court order regarding an application for bail filed by Fr. Stan Swamy, who has been accused of various offenses including being part of a criminal conspiracy to wage war against India.

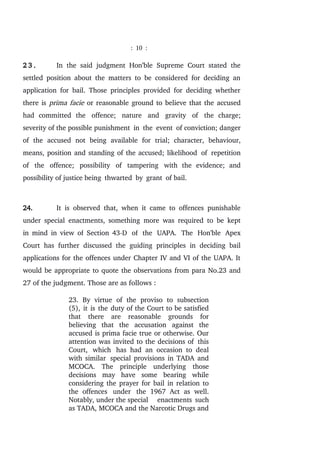

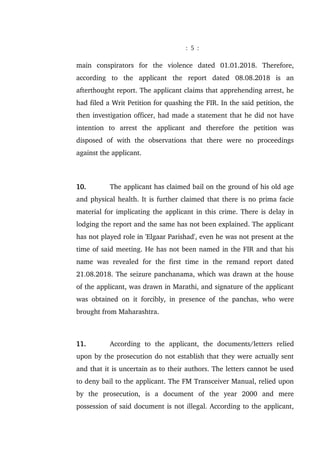

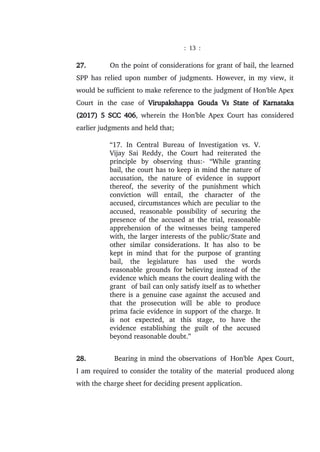

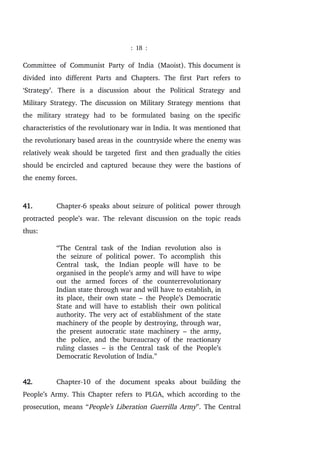

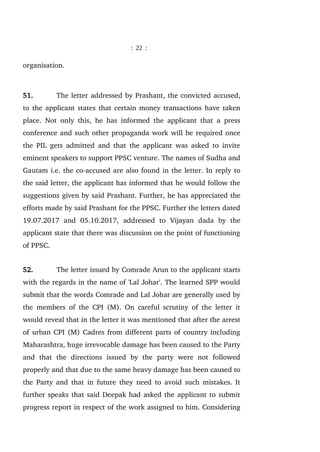

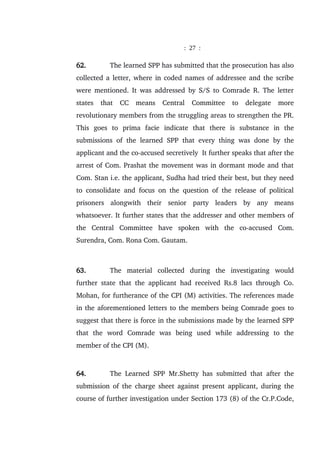

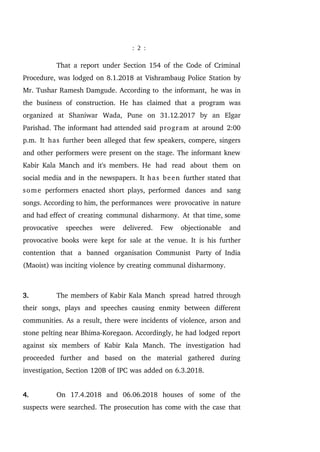

2. It outlines the background of the case, including the police complaint filed in 2018 regarding the Elgar Parishad meeting and subsequent violence, and the expanding scope of the investigation.

3. The court order then summarizes the applicant's arguments for bail, including his age, health issues, lack of evidence against him, and delays in the investigation and filing of charges. It also summarizes the prosecution's arguments in opposition to bail, including evidence they claim links the applicant to Maoist organizations and
