BRICKS

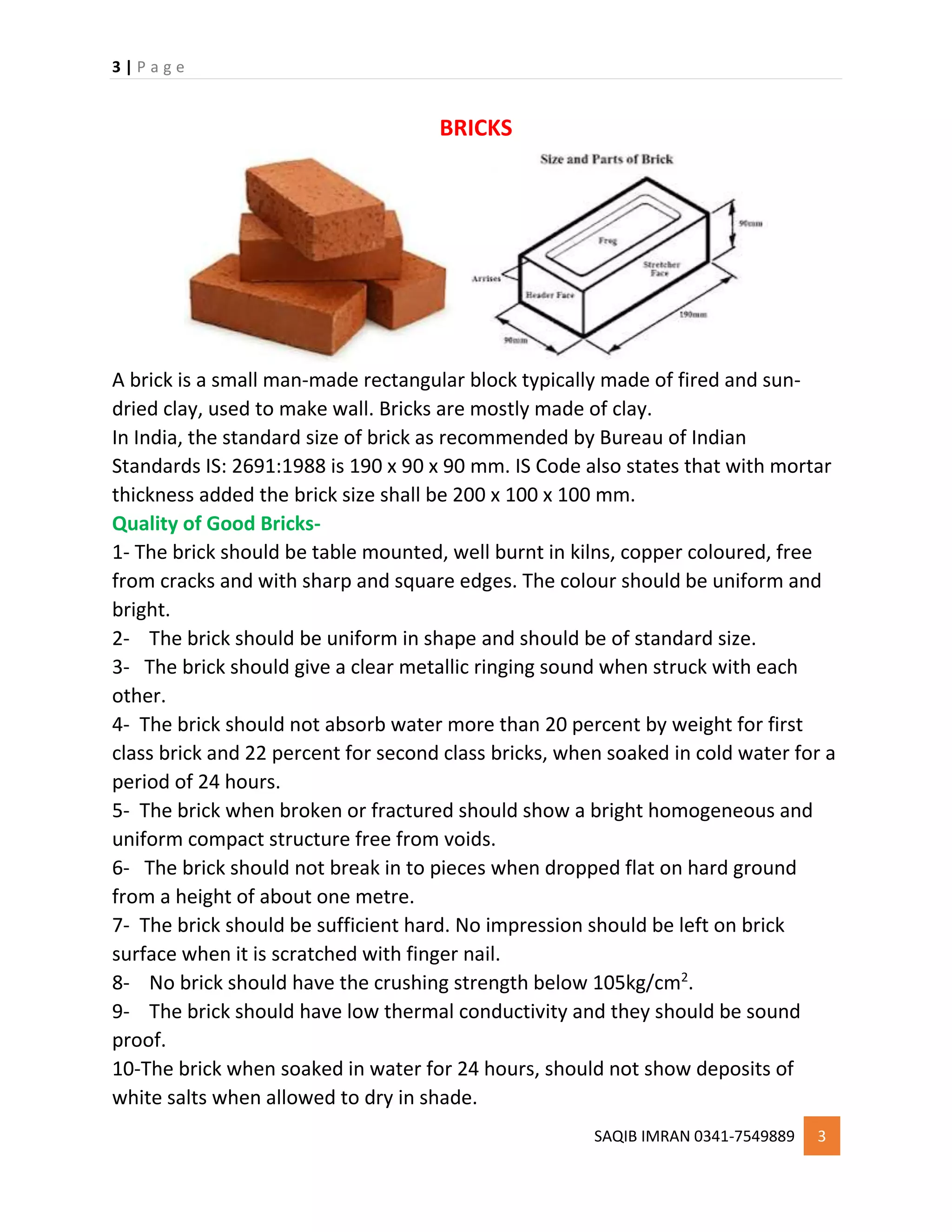

A brick is a small man-made rectangular block typically made of fired and sun-
dried clay, used to make wall. Bricks are mostly made of clay.
In India, the standard size of brick as recommended by Bureau of Indian
Standards IS: 2691:1988 is 190 x 90 x 90 mm. IS Code also states that with mortar
thickness added the brick size shall be 200 x 100 x 100 mm.
Quality of Good Bricks-
1- The brick should be table mounted, well burnt in kilns, copper coloured, free
from cracks and with sharp and square edges. The colour should be uniform and
bright.
2- The brick should be uniform in shape and should be of standard size.
3- The brick should give a clear metallic ringing sound when struck with each
other.
4- The brick should not absorb water more than 20 percent by weight for first
class brick and 22 percent for second class bricks, when soaked in cold water for a
period of 24 hours.
5- The brick when broken or fractured should show a bright homogeneous and
uniform compact structure free from voids.
6- The brick should not break in to pieces when dropped flat on hard ground
from a height of about one metre.
7- The brick should be sufficient hard. No impression should be left on brick
surface when it is scratched with finger nail.
8- No brick should have the crushing strength below 105kg/cm2
.
9- The brick should have low thermal conductivity and they should be sound
proof.
10-The brick when soaked in water for 24 hours, should not show deposits of
white salts when allowed to dry in shade.
4 | P a g e
SAQIB IMRAN 0341-7549889 4

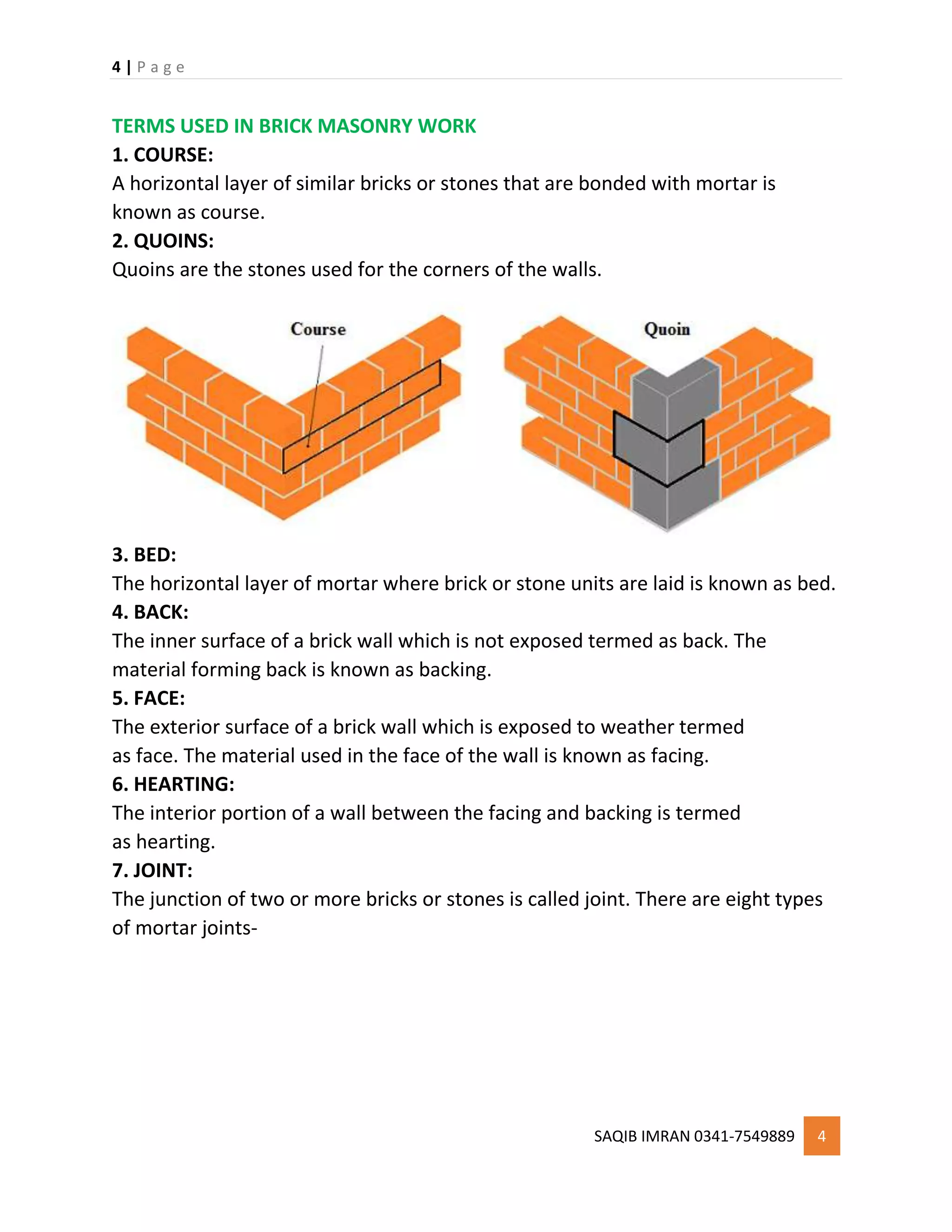

TERMS USED IN BRICK MASONRY WORK
1. COURSE:
A horizontal layer of similar bricks or stones that are bonded with mortar is
known as course.
2. QUOINS:
Quoins are the stones used for the corners of the walls.
3. BED:
The horizontal layer of mortar where brick or stone units are laid is known as bed.
4. BACK:
The inner surface of a brick wall which is not exposed termed as back. The
material forming back is known as backing.
5. FACE:
The exterior surface of a brick wall which is exposed to weather termed
as face. The material used in the face of the wall is known as facing.
6. HEARTING:
The interior portion of a wall between the facing and backing is termed
as hearting.
7. JOINT:
The junction of two or more bricks or stones is called joint. There are eight types
of mortar joints-
5 | P a g e
SAQIB IMRAN 0341-7549889 5

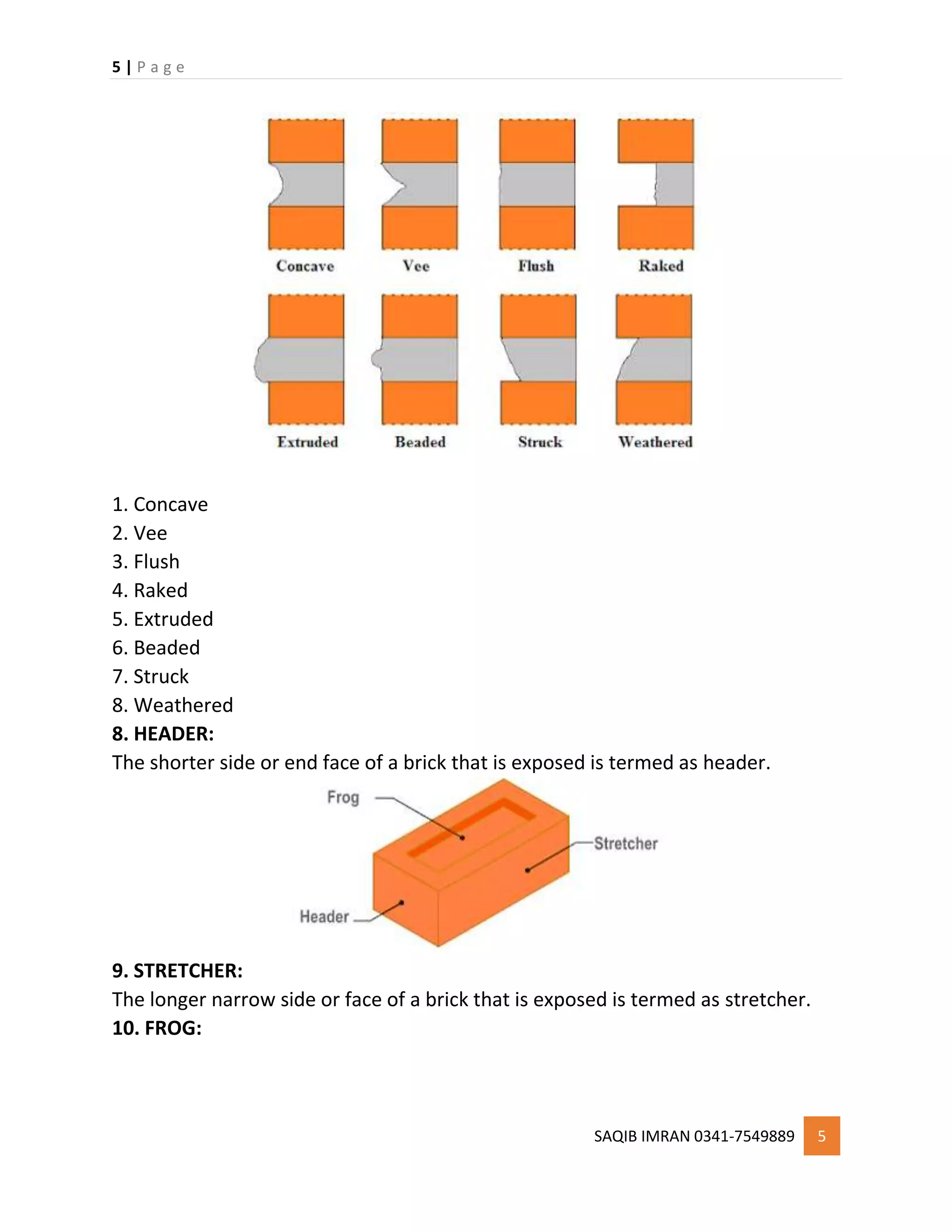

1. Concave
2. Vee
3. Flush
4. Raked
5. Extruded
6. Beaded
7. Struck
8. Weathered
8. HEADER:
The shorter side or end face of a brick that is exposed is termed as header.
9. STRETCHER:
The longer narrow side or face of a brick that is exposed is termed as stretcher.
10. FROG:

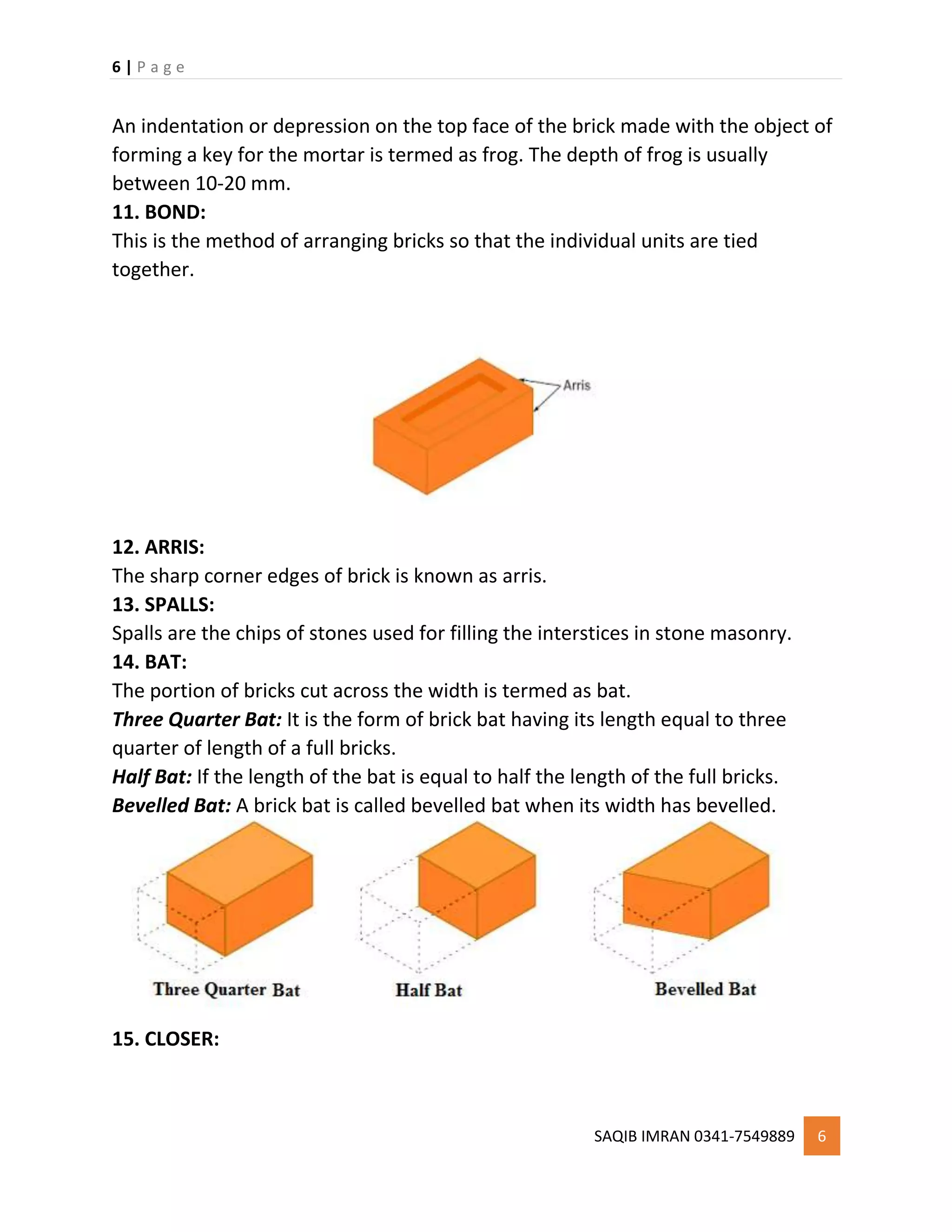

6 | P a g e
SAQIB IMRAN 0341-7549889 6
An indentation or depression on the top face of the brick made with the object of
forming a key for the mortar is termed as frog. The depth of frog is usually
between 10-20 mm.
11. BOND:
This is the method of arranging bricks so that the individual units are tied
together.
12. ARRIS:
The sharp corner edges of brick is known as arris.
13. SPALLS:
Spalls are the chips of stones used for filling the interstices in stone masonry.
14. BAT:
The portion of bricks cut across the width is termed as bat.
Three Quarter Bat: It is the form of brick bat having its length equal to three
quarter of length of a full bricks.
Half Bat: If the length of the bat is equal to half the length of the full bricks.
Bevelled Bat: A brick bat is called bevelled bat when its width has bevelled.
15. CLOSER:
7 | P a g e

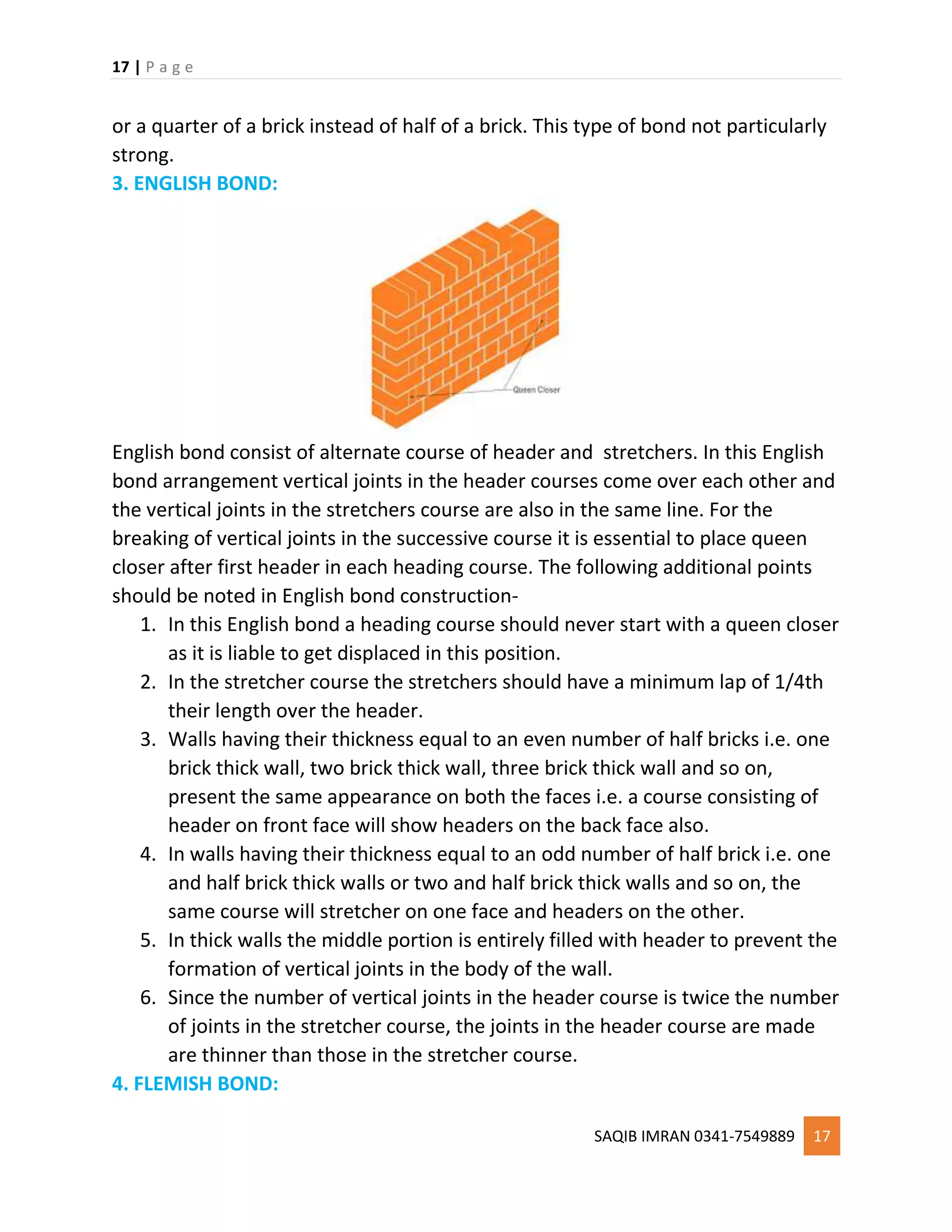

SAQIB IMRAN 0341-7549889 7

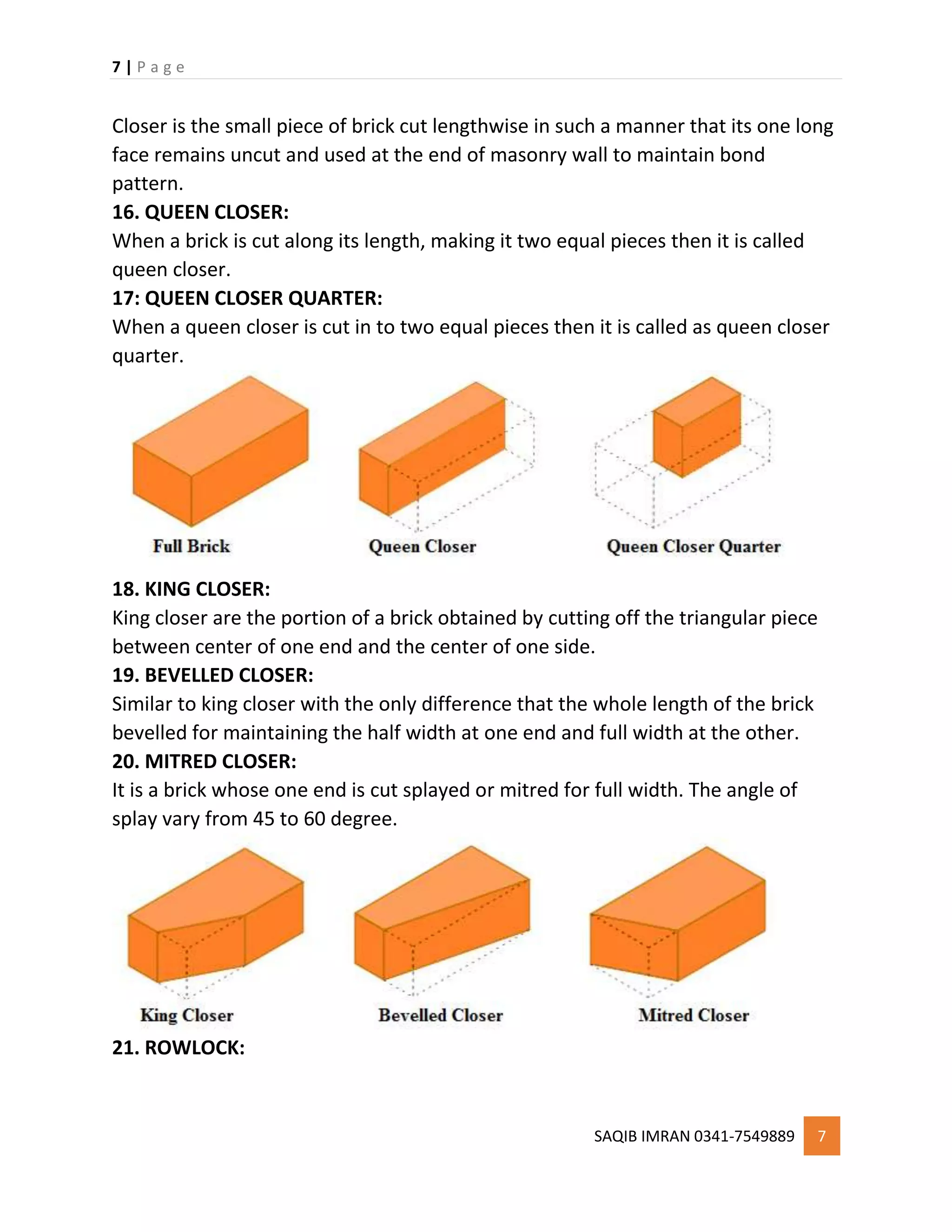

Closer is the small piece of brick cut lengthwise in such a manner that its one long
face remains uncut and used at the end of masonry wall to maintain bond
pattern.
16. QUEEN CLOSER:
When a brick is cut along its length, making it two equal pieces then it is called
queen closer.
17: QUEEN CLOSER QUARTER:
When a queen closer is cut in to two equal pieces then it is called as queen closer
quarter.
18. KING CLOSER:
King closer are the portion of a brick obtained by cutting off the triangular piece
between center of one end and the center of one side.
19. BEVELLED CLOSER:
Similar to king closer with the only difference that the whole length of the brick
bevelled for maintaining the half width at one end and full width at the other.
20. MITRED CLOSER:
It is a brick whose one end is cut splayed or mitred for full width. The angle of
splay vary from 45 to 60 degree.
21. ROWLOCK:
8 | P a g e
SAQIB IMRAN 0341-7549889 8
The head is visible and the long narrow sides are on bottom and top.
22. ROWLOCK STRETCHER:
When the thinner stretcher sides are on bottom and top faces on the sides.
23. SAILOR:
The heads are on top and bottom and the stretcher faces are on the side. Mostly
used for decoration.
24. SOLDIER:
The stretcher side is visible and the heads are at the bottom and top. It is usually
used for decoration.
25. BUTTERING:
Placing of mortar in on masonry block with trowel is termed as buttering.
COLOURS OF BRICKS
The colours of bricks as obtained in its natural course of manufacture depend on
the following factors.
 Degree of dryness achieved before burning
 Natural colour of clay and its chemical composition
 Nature of sand used in moulding operation
 Quality of fuel used in burning operation
 Quantity of air admitted to the kiln during burning
9 | P a g e

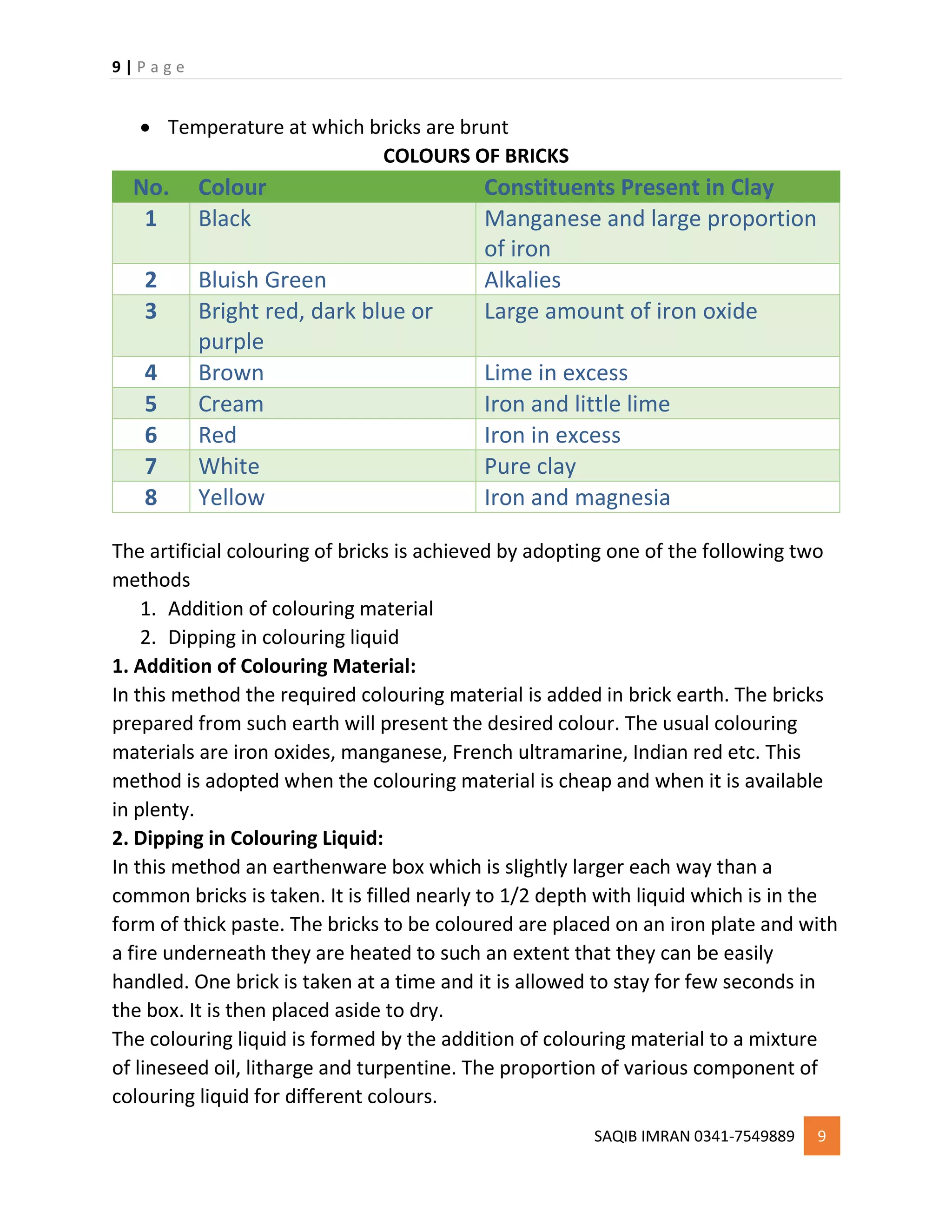

SAQIB IMRAN 0341-7549889 9
 Temperature at which bricks are brunt
COLOURS OF BRICKS
No. Colour Constituents Present in Clay
1 Black Manganese and large proportion
of iron
2 Bluish Green Alkalies
3 Bright red, dark blue or
purple
Large amount of iron oxide
4 Brown Lime in excess
5 Cream Iron and little lime
6 Red Iron in excess
7 White Pure clay
8 Yellow Iron and magnesia
The artificial colouring of bricks is achieved by adopting one of the following two
methods
1. Addition of colouring material
2. Dipping in colouring liquid
1. Addition of Colouring Material:
In this method the required colouring material is added in brick earth. The bricks
prepared from such earth will present the desired colour. The usual colouring
materials are iron oxides, manganese, French ultramarine, Indian red etc. This
method is adopted when the colouring material is cheap and when it is available
in plenty.
2. Dipping in Colouring Liquid:
In this method an earthenware box which is slightly larger each way than a
common bricks is taken. It is filled nearly to 1/2 depth with liquid which is in the
form of thick paste. The bricks to be coloured are placed on an iron plate and with
a fire underneath they are heated to such an extent that they can be easily
handled. One brick is taken at a time and it is allowed to stay for few seconds in
the box. It is then placed aside to dry.
The colouring liquid is formed by the addition of colouring material to a mixture
of lineseed oil, litharge and turpentine. The proportion of various component of
colouring liquid for different colours.
10 | P a g e

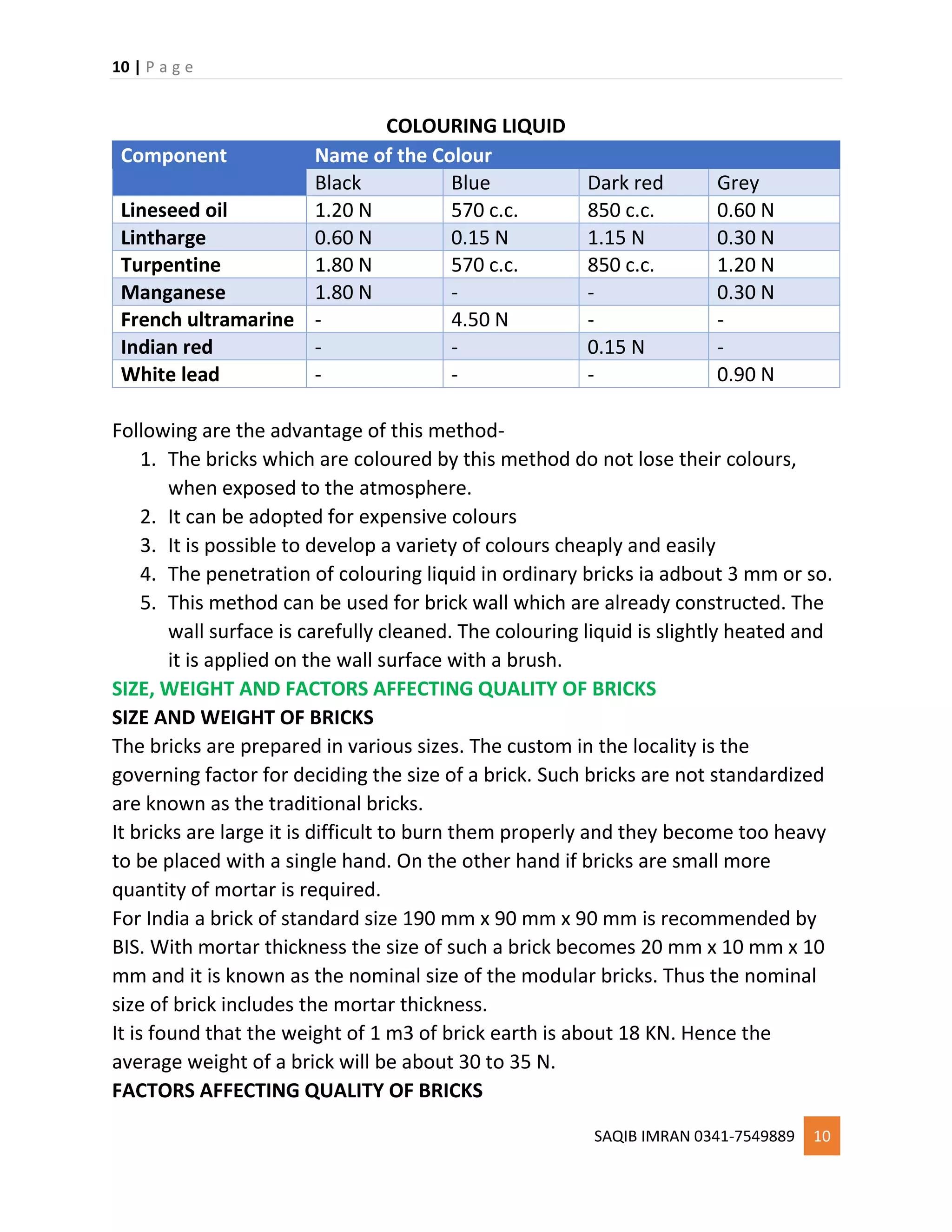

SAQIB IMRAN 0341-7549889 10
COLOURING LIQUID
Component Name of the Colour
Black Blue Dark red Grey
Lineseed oil 1.20 N 570 c.c. 850 c.c. 0.60 N
Lintharge 0.60 N 0.15 N 1.15 N 0.30 N
Turpentine 1.80 N 570 c.c. 850 c.c. 1.20 N
Manganese 1.80 N - - 0.30 N
French ultramarine - 4.50 N - -
Indian red - - 0.15 N -
White lead - - - 0.90 N
Following are the advantage of this method-
1. The bricks which are coloured by this method do not lose their colours,
when exposed to the atmosphere.
2. It can be adopted for expensive colours
3. It is possible to develop a variety of colours cheaply and easily
4. The penetration of colouring liquid in ordinary bricks ia adbout 3 mm or so.
5. This method can be used for brick wall which are already constructed. The
wall surface is carefully cleaned. The colouring liquid is slightly heated and
it is applied on the wall surface with a brush.
SIZE, WEIGHT AND FACTORS AFFECTING QUALITY OF BRICKS
SIZE AND WEIGHT OF BRICKS
The bricks are prepared in various sizes. The custom in the locality is the
governing factor for deciding the size of a brick. Such bricks are not standardized
are known as the traditional bricks.
It bricks are large it is difficult to burn them properly and they become too heavy
to be placed with a single hand. On the other hand if bricks are small more
quantity of mortar is required.
For India a brick of standard size 190 mm x 90 mm x 90 mm is recommended by
BIS. With mortar thickness the size of such a brick becomes 20 mm x 10 mm x 10
mm and it is known as the nominal size of the modular bricks. Thus the nominal
size of brick includes the mortar thickness.
It is found that the weight of 1 m3 of brick earth is about 18 KN. Hence the
average weight of a brick will be about 30 to 35 N.
FACTORS AFFECTING QUALITY OF BRICKS
11 | P a g e
SAQIB IMRAN 0341-7549889 11
Following factors affect the quality of bricks-
 Composition of brick earth
 Preparation of clay and blending of ingredient
 Nature of moulding adopted
 Care taken in drying and stacking of raw or green bricks
 Types of kiln used including type of fuel and its feeding
 Burning and cooling processes
 Care taken in including
It is thus obvious that not only the bricks of different brick fields will have
different strength, but in the same brick field, the bricks of the same batch may
have different strengths.
The average crushing strength and tensile strength of hand moulded bricks are
60000 KN/m2
and 2000 KN/m2
respectively. In practice however the bricks are not
subjected to the tensile stresses.
It may be noted that the strength of brickwork mainly depends on the types of
mortar used and not so much on the individual strength of the bricks.
DIFFERENT CUTS AND ORIENTATIONS OF BRICKS USED IN CONSTRUCTION
1. BRICK ORIENTATION:
(i). HEADER:
12 | P a g e
SAQIB IMRAN 0341-7549889 12

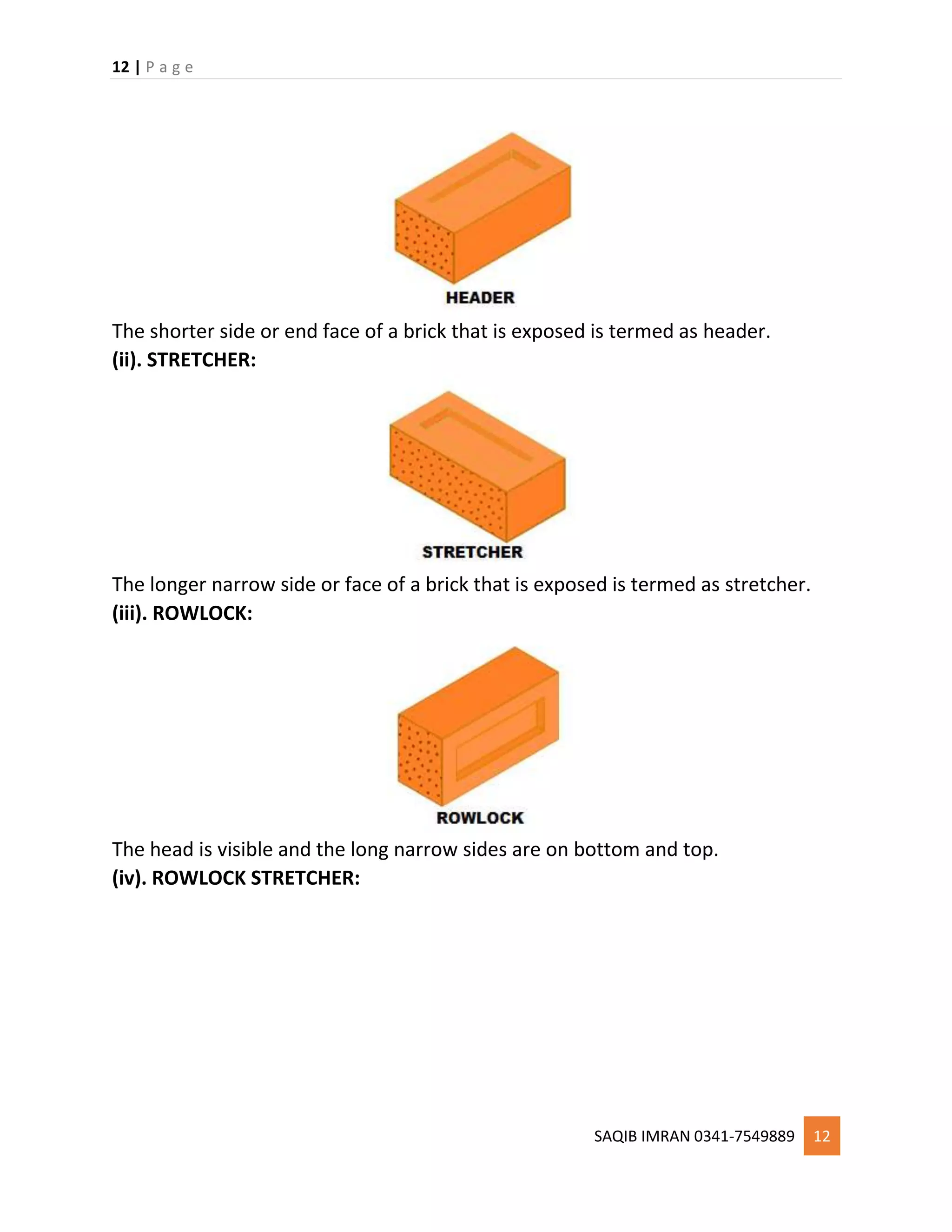

The shorter side or end face of a brick that is exposed is termed as header.
(ii). STRETCHER:
The longer narrow side or face of a brick that is exposed is termed as stretcher.
(iii). ROWLOCK:
The head is visible and the long narrow sides are on bottom and top.
(iv). ROWLOCK STRETCHER:

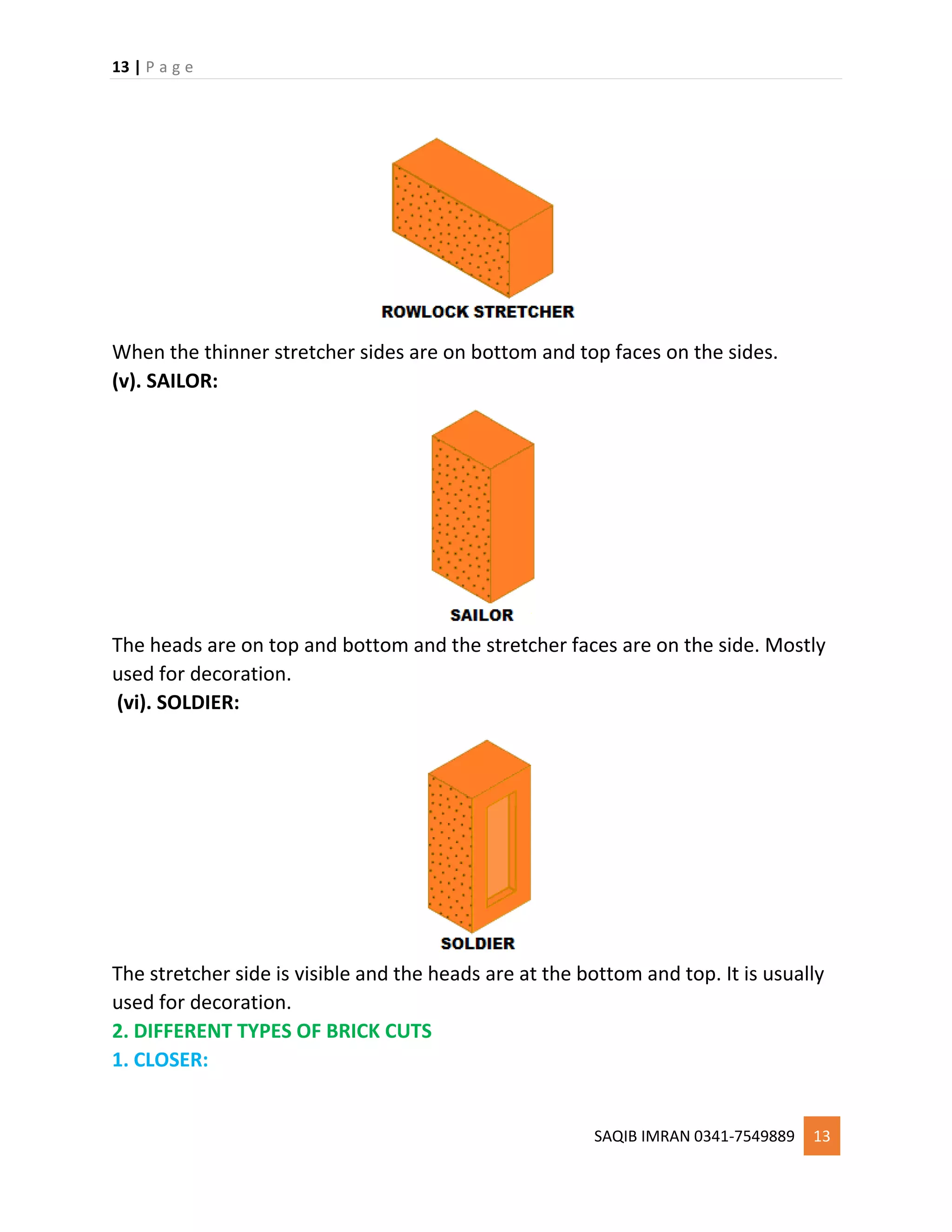

13 | P a g e
SAQIB IMRAN 0341-7549889 13
When the thinner stretcher sides are on bottom and top faces on the sides.
(v). SAILOR:
The heads are on top and bottom and the stretcher faces are on the side. Mostly
used for decoration.
(vi). SOLDIER:
The stretcher side is visible and the heads are at the bottom and top. It is usually
used for decoration.
2. DIFFERENT TYPES OF BRICK CUTS

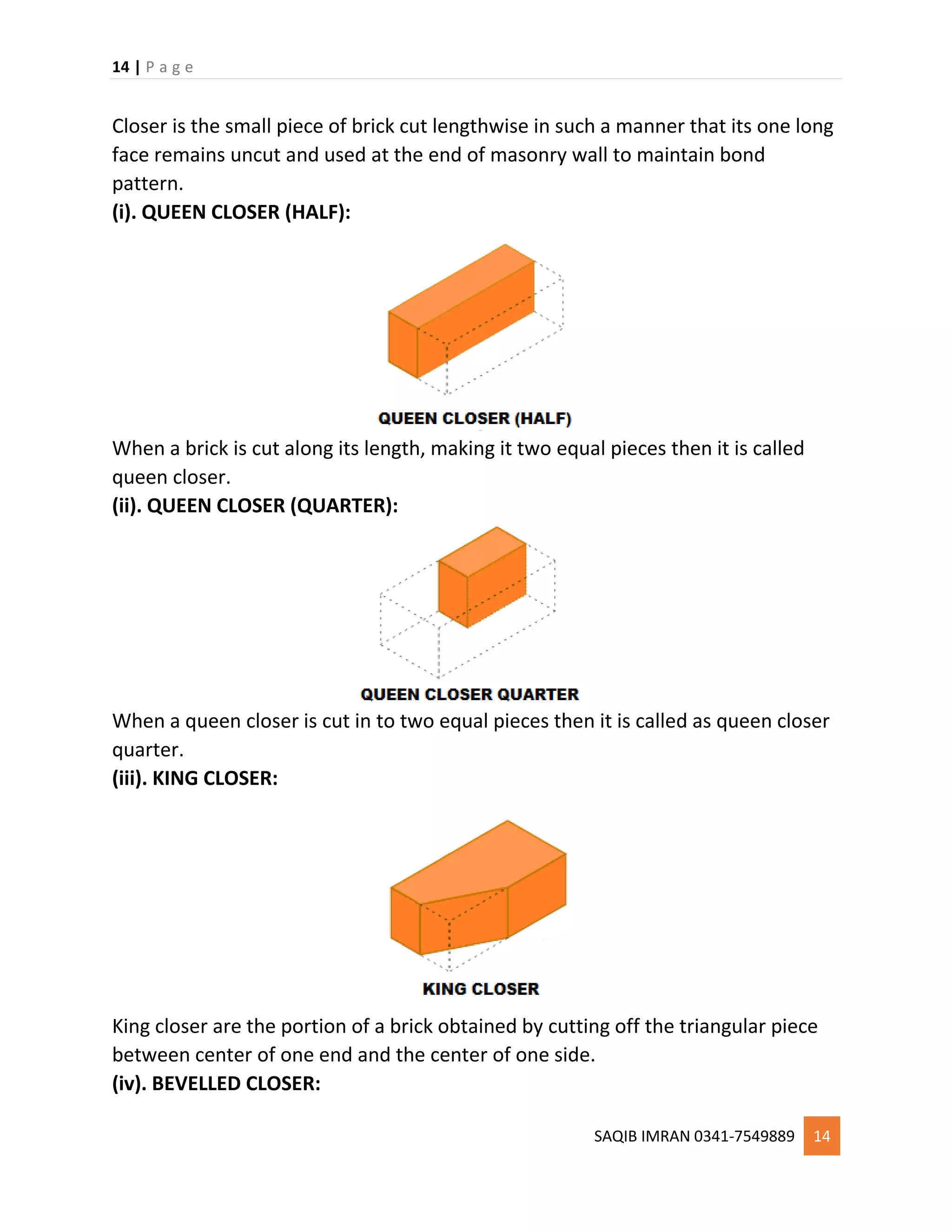

1. CLOSER:
14 | P a g e
SAQIB IMRAN 0341-7549889 14
Closer is the small piece of brick cut lengthwise in such a manner that its one long
face remains uncut and used at the end of masonry wall to maintain bond
pattern.
(i). QUEEN CLOSER (HALF):
When a brick is cut along its length, making it two equal pieces then it is called
queen closer.
(ii). QUEEN CLOSER (QUARTER):
When a queen closer is cut in to two equal pieces then it is called as queen closer
quarter.
(iii). KING CLOSER:
King closer are the portion of a brick obtained by cutting off the triangular piece
between center of one end and the center of one side.
(iv). BEVELLED CLOSER:
15 | P a g e
SAQIB IMRAN 0341-7549889 15
Similar to king closer with the only difference that the whole length of the brick
bevelled for maintaining the half width at one end and full width at the other.
(v). MITRED CLOSER:
It is a brick whose one end is cut splayed or mitred for full width. The angle of
splay vary from 45 to 60 degree.
2. BAT:
The portion of bricks cut across the width is termed as bat.
(i). THREE QUARTER BAT:
It is the form of brick bat having its length equal to three quarter of length of a full
bricks.
(ii). HALF BAT:
If the length of the bat is equal to half the length of the full bricks.
(iii). BEVELED BAT:
16 | P a g e
SAQIB IMRAN 0341-7549889 16
A brick bat is called beveled bat when its width has beveled.
TYPES OF BRICK BONDS
Most commonly used brick bonds are-
1. Header Bond
2. Stretcher Bond
3. English Bond
4. Flemish Bond
1. HEADER BOND:
In this type of bonding all the bricks are laid as headers on the faces. This bond
permit better alignment and it is used for wall curved on plan. The overlap is half
the width of the brick and can be achieved by providing a three quarter bat in
each alternate course at quoins.
2. STRETCHER BOND:
Stretcher bond is the simplest type of brick bond in which all the bricks are laid as
stretchers on the faces. This bond is also called as running bond. In this bond no
header is present hence suitable reinforcement always be provided for
construction of structural bond. The overlap between the bricks is usually a third
17 | P a g e
SAQIB IMRAN 0341-7549889 17
or a quarter of a brick instead of half of a brick. This type of bond not particularly
strong.
3. ENGLISH BOND:
English bond consist of alternate course of header and stretchers. In this English
bond arrangement vertical joints in the header courses come over each other and
the vertical joints in the stretchers course are also in the same line. For the
breaking of vertical joints in the successive course it is essential to place queen
closer after first header in each heading course. The following additional points
should be noted in English bond construction-
1. In this English bond a heading course should never start with a queen closer
as it is liable to get displaced in this position.
2. In the stretcher course the stretchers should have a minimum lap of 1/4th
their length over the header.
3. Walls having their thickness equal to an even number of half bricks i.e. one
brick thick wall, two brick thick wall, three brick thick wall and so on,
present the same appearance on both the faces i.e. a course consisting of
header on front face will show headers on the back face also.
4. In walls having their thickness equal to an odd number of half brick i.e. one
and half brick thick walls or two and half brick thick walls and so on, the
same course will stretcher on one face and headers on the other.
5. In thick walls the middle portion is entirely filled with header to prevent the
formation of vertical joints in the body of the wall.
6. Since the number of vertical joints in the header course is twice the number
of joints in the stretcher course, the joints in the header course are made
are thinner than those in the stretcher course.
4. FLEMISH BOND:
18 | P a g e
SAQIB IMRAN 0341-7549889 18
In Flemish bond each course consist of alternate headers and stretchers. The
alternate headers of each course are centered over the stretchers in the course
below. Every alternate course starts with a header at the corner. For the breaking
of vertical joints in the successive courses, closers are inserted in the alternate
courses next to the quoin header. In walls having their thickness equal to odd
number of half bricks, bats are essentially used to achieve the bond.
Flemish bond is further divided in to two different types namely-
1. Single Flemish Bond
2. Double Flemish Bond
1. Single Flemish Bond-
This bond is a combination of English bond and Flemish bond. In this work the
facing of the wall consists of Flemish bond and the backing consists of English
bond in each course. This type of bonding can not be adopted in walls less than
one and a half brick in thickness. This bond is adopted to present the attractive
appearance of Flemish bond with an effort to ensure full strength in the brick
work.
2. Double Flemish Bond-
In double Flemish bond each course presents the same appearance both in the
front and back elevation. Every course consist of headers and stretchers laid
alternately. This type of bond is beast suited from consideration of economy and
appearance. It enables the one brick wall to have flush and uniform faces on both
sides. This type of bonding is comparatively weaker than English bond.
Other types of brick bonds are-
1. Facing Bond
2. Dutch Bond
3. English Cross Bond
19 | P a g e
SAQIB IMRAN 0341-7549889 19
4. Brick on Edge Bond
5. Raking Bond
6. Zigzag Bond
7. Garden Wall Bond
FACTORS AFFECTING STRENGTH OF BRICKS
Following factors affecting the strength and quality of bricks-
1. Composition of brick making earth.
2. Preparation of clay and blending of ingredients.
3. Nature of moulding adopted.
4. Care taken in drying and stacking of raw or green bricks.
5. Types of kilns used including types of fuel and its feeding.
6. Burning and cooling process.
7. Care taken in unloading.
It is thus obvious that not only the bricks of different brick field will have different
strength, but in the same brick field, the bricks of the same batch may have
different strength.
The average crushing strength and tensile strength of hand moulded bricks are
60000 kN/m2
and 2000 kN/m2
respectively. The shearing strength of bricks are
not subjected to the tensile stresses.
It may be noted that the strength of brickwork mainly depends on the types of
mortar used and not so much on the individual strength of the bricks.
20 | P a g e
SAQIB IMRAN 0341-7549889 20
COMPOSITIONS OF GOOD BRICK EARTH
In order to get good quality brick, the earth should contain the following
constituents.
 Silica
 Alumina
 Lime
 Iron Oxide
 Magnesia
1. SILICA-
 Good brick earth should contain about 50 to 60% of Silica
 It prevents Cracking, Shrinkage and Warping of raw bricks.
 It also affects the durability of bricks.
 The excess of silica destroys the cohesion between particles and the brick
becomes brittle.
2. ALUMINA-
 The percentage of alumina should be in the range of 20 to 30% in a good
brick earth.
 The presence of this constituent imparts plasticity to the clay so that it can
be moulded.
 If present in excess, then the raw bricks shrink and warp during drying.
3. LIME-
 Brick earth should contain about 2 to 5% of lime.
 It prevents shrinkage of raw brick on drying.
 It helps to lower the fusion temperature.
21 | P a g e
SAQIB IMRAN 0341-7549889 21
 It cause silica in clay to melt on burning and thus helps to bind it.
 The excess of lime causes the bricks to melt and brick looses its shape.
4. IRON OXIDE-
 A good brick earth should contain about 5 to 7% of Iron oxide.
 It gives red colour to the bricks.
 It improves impermeability and durability.
 It gives strength and hardness.
 If present in excess, then the colour of brick becomes dark blue or blackish.
 If the quantity of iron oxide is comparatively less the brick becomes
yellowish in colour.
5. MAGNESIA-
 Good brick earth should contain a small quantity of magnesia about 1%.
 Magnesium in brick earth impart yellow tint to the brick.
 It is responsible for reducing shrinkage.
 Excess of magnesia leads to the decay of bricks.
-------------------------------------------------------------------------------------------------------------
---
Silica........................................50-60%
Alumina...................................20-30%
Lime.........................................2-5%
Iron oxide.................................5-7%
Magnesia..................................not more than 1%
HARMFUL INGREDIENTS IN BRICKS AND THEIR EFFECTS
Following are the ingredients which are undesirable in the brick material-
 Lime
 Alkalies
 Pebbles
 Iron pyrites
 Vegetation and Organic matter
1. LIME
 If lime in brick earth present in excess, it causes the brick to melt and hence
brick looses its shape.
22 | P a g e
SAQIB IMRAN 0341-7549889 22
 If lime is present in the form of lumps, then it is converted into quick lime
after burning. This quick lime slakes and expands in presence of moisture,
causing splitting of bricks into pieces.
2. ALKALIES
 Alkalies exist in the brick in the form of soda and potash
 Alkalies present in the brick earth lower the fusion temperature abnormally
as a result of which the brick deforms and twist.
 Alkalies remaining in bricks will absorb water from the atmosphere. When
the moisture gets evaporated leaving grey or white deposits on wall surface
(efflorescence) which affects the appearance of the building structure.
3. PEBBLES
 It prevents mixing of clay thoroughly and uniformly, which results in weak
and porous bricks.
 Bricks containing pebbles will not break into shapes as per requirements.
4. IRON PYRITES
 If the iron pyrites present in brick earth causes the brick to get crystallized
and disintegrated during burning, because of the oxidation of the iron
pyrites.
5. VEGETATION AND ORGANIC MATTER
 The presence of vegetation and organic matter in brick earth assists in
burning. But if such matter is not completely burnt, the bricks become
porous. This is due to the fact that the gasses will be evolved during the
burning of the carbonaceous matter and it will result in the formation of
small pores.
MANUFACTURING OF CLAY BRICKS
Manufacturing of clay bricks includes following steps-
 Preparation of brick earth
 Moulding of bricks
 Drying of moulded bricks
 Burning of bricks
TESTS TO JUSTIFY BRICK QUALITY
To know the quality of bricks following tests can be performed-
 Water Absorption test
 Crushing strength test
23 | P a g e
SAQIB IMRAN 0341-7549889 23
 Hardness test
 Shape and size
 Color test
 Soundness test
 Structure of brick
 Efflorescence Test
1. WATER ABSORPTION TEST-
This test is conducted on brick to find out the amount of moisture absorbed by
brick under extreme condition. In this test a sample of dry brick are taken and
weighed and immersed in fresh water at a temperature of 27'C for a period of 24
hours. After 24 hours the specimen taken out and wiped with cloth. The weight of
sample in wet condition is taken, the difference in weight indicates the amount of
water absorbed by brick. For a good quality brick the amount of water absorption
should not exceed 20 percent of weight of dry brick.
M1- Weight of dry brick
M2- Weight of wet brick

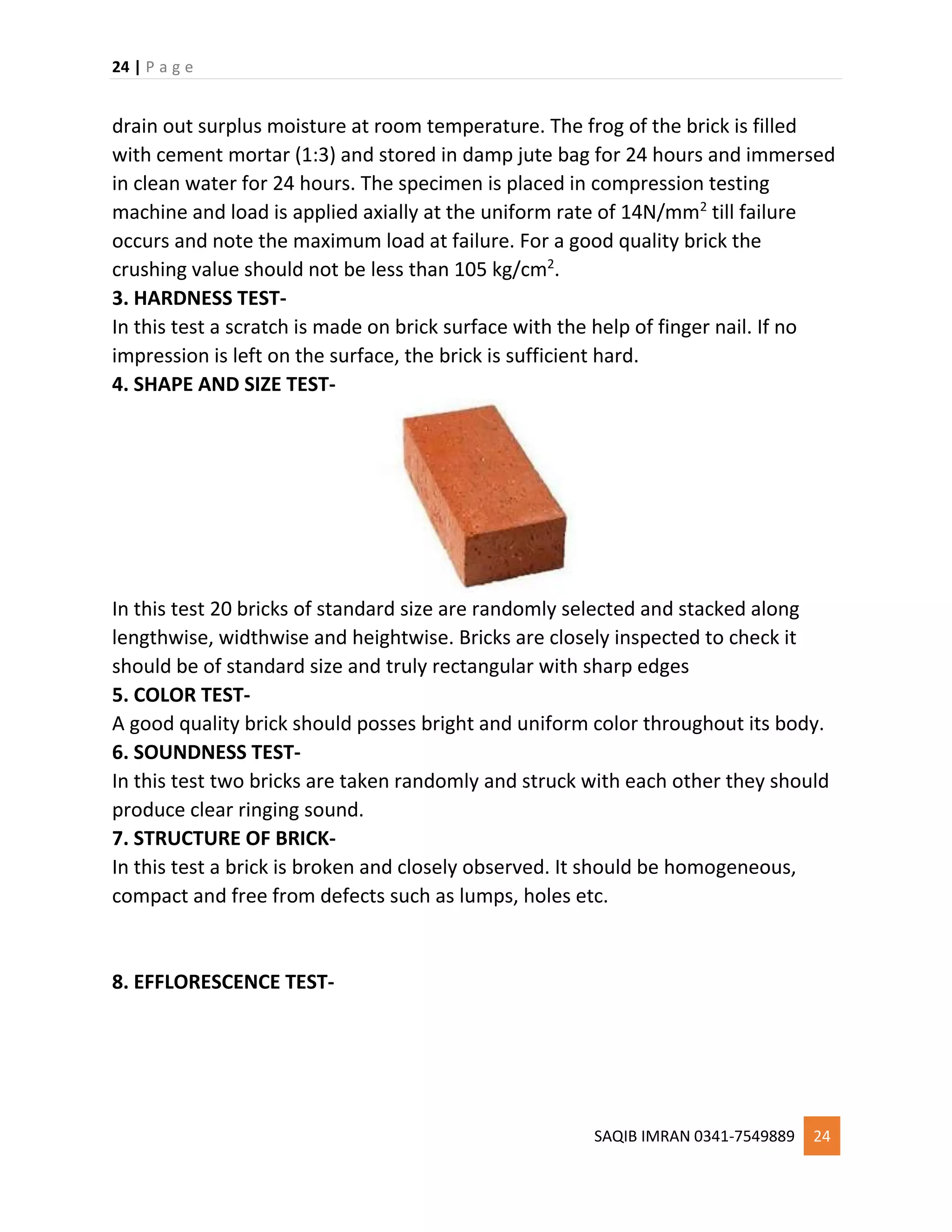

2. CRUSHING STRENGTH TEST-
This test is done to know the load carrying capacity of brick under compression.
The brick specimen immersed in water for 24 hours, remove the specimen and
24 | P a g e
SAQIB IMRAN 0341-7549889 24
drain out surplus moisture at room temperature. The frog of the brick is filled
with cement mortar (1:3) and stored in damp jute bag for 24 hours and immersed
in clean water for 24 hours. The specimen is placed in compression testing
machine and load is applied axially at the uniform rate of 14N/mm2
till failure
occurs and note the maximum load at failure. For a good quality brick the
crushing value should not be less than 105 kg/cm2
.
3. HARDNESS TEST-
In this test a scratch is made on brick surface with the help of finger nail. If no
impression is left on the surface, the brick is sufficient hard.
4. SHAPE AND SIZE TEST-
In this test 20 bricks of standard size are randomly selected and stacked along
lengthwise, widthwise and heightwise. Bricks are closely inspected to check it
should be of standard size and truly rectangular with sharp edges
5. COLOR TEST-
A good quality brick should posses bright and uniform color throughout its body.
6. SOUNDNESS TEST-
In this test two bricks are taken randomly and struck with each other they should
produce clear ringing sound.
7. STRUCTURE OF BRICK-
In this test a brick is broken and closely observed. It should be homogeneous,
compact and free from defects such as lumps, holes etc.
8. EFFLORESCENCE TEST-
25 | P a g e
SAQIB IMRAN 0341-7549889 25
This test is used to find out the presence of soluble salts in brick. In this test a
brick is immersed in fresh water for 24 hours. It is then taken out from water and
allowed to dry in shade. If white and grey layer is not visible on brick surface it
indicates absence of soluble salts and useful for construction. If the whitish layer
visible about 10% of brick surface then the presence of alkalies is in acceptable
range. If that is about 50% of surface then it is moderate. If the alkalies presence
is over 50% then the is severely affected by alkalies.
26 | P a g e
SAQIB IMRAN 0341-7549889 26
Building Construction
TYPES OF RCC BEAMS
Beam can be defined as a structural member which is normally placed horizontal.
It provide resistance to bending when loads are applied on it. There are various
types materials used for construction of beam such as steel, aluminum, wood etc.
But RCC (Reinforced Cement Concrete) is most commonly used material for
construction of beam.
TYPES OF RCC BEAMS
Depending upon their supporting system RCC beam can be classified in to four
categories as follows-
1. Simply Supported Beam
2. Continuous Beam
3. Semi-Continuous Beam
4. Cantilever Beam
5. T- Beam
1. SIMPLY SUPPORTED BEAM
The simply supported beam contains only a single span which is supported by two
supports at both ends. This beam also called simple beam.
2. CONTINUOUS BEAM
This types of beam has more than two span and has more than three supports
along its length in one straight line.
27 | P a g e
SAQIB IMRAN 0341-7549889 27
3. SEMI-CONTINUOUS BEAM
This types of beams does not have more than two span and three supports.
4. CANTILEVER BEAM
This types of beam has only one support in one end, other end is free.
5. T-BEAM
When floor slabs and beams are poured simultaneously producing a monolithic
structure where where the portion of the slab at both side of the beam serves as
flange of T beam. The beam below the slab serves as the web member and is
sometimes called stem.
28 | P a g e
SAQIB IMRAN 0341-7549889 28
STANDARD SIZE OF ROOM IN A RESIDENTIAL BUILDINGS
TYPES OF ROOMS IN A RESIDENTIAL BUILDING AND THEIR STANDARD SIZE
1. LIVING ROOM
29 | P a g e
SAQIB IMRAN 0341-7549889 29
 Small- 12x18ft (3.4X5.4m)
 Medium- 16x20ft (4.8x6.0m)
 Large- 22x28ft (6.6x8.4m)
2. MASTER BEDROOM
 Small- 12x14ft (3.6x4.2m)
 Medium- 14x20ft (4.2x6.0m)
 Large- 16x24ft (4.8x7.2m)
3. BEDROOM
 Small- 10x10ft (3.0x3.0m)
 Medium- 12x12ft (3.6x3.6m)
 Large- 14x16ft (4.2x4.8m)
4. DINING ROOM
 Small- 10x12ft (3.0x3.6m)
 Medium- 12x16ft (3.6x4.2m)
 Large- 14x18ft (4.2x4.8m)
5. KITCHEN
 Small- 5x10ft (1.5x3.0m)
 Medium- 8x13ft (2.5x3.9m)
 Large- 10x12ft (3.0x3.6m)
6. BATHROOM (MASTER BEDROOM)
 Small- 6x7ft (1.8x2.7m)
 Medium- 7x10ft (2.1x3.0m)
 Large- 8x12ft (2.5x3.6m)
7. BATHROOM (COMMON BEDROOM)
 Small- 5x9ft (1.5x2.7m)
 Medium- 6x10ft (1.8x3.0m)
 Large- 7x12ft (2.1x3.6m)
8. DRESSING ROOM
 Small- 4x4ft (1.2x1.2m)
 Medium- 5x5ft (1.5x1.5m)
 Large- 6x6ft (1.8x1.8m)
9. FOYER
 Small- 5ft Wide (1.5m)
 Medium- 6ft Wide (1.8m)
 Large- 8ft Wide (2.5m)
30 | P a g e
SAQIB IMRAN 0341-7549889 30
10. STORE ROOM
 Small- 6x6ft (1.8x1.8m)
 Medium- 8x10ft (2.5x3.0m)
 Large- 10x10ft (3.0x3.0m)
11. PANTRY
 Small- 2x2ft (0.6x0.6m)
 Medium- 3x4ft (0.9x1.2m)
 Large- 4x6ft (1.2x1.8m)
12. OFFICE ROOM
 Small- 8x10ft (2.5x3.0m)
 Medium- 10x12ft (3.0x3.6m)
 Large- 12x14ft (3.6x4.2m)
13. STUDY ROOM
 Small- 10x10ft (3.0x30.m)
 Medium- 12x12ft (3.6x3.6m)
 Large- 14x16ft (4.2x4.8m)
14. GUEST BEDROOM
 Small- 10x12ft (3.0x3.6m)
 Medium- 12x14ft (3.6x4.2m)
 Large- 14x18ft (4.2x4.8m)
15. GUEST BATHROOM
 Small- 5x9ft (1.5x2.7m)
 Medium- 6x10ft (1.8x3.0m)
 Large- 7x12ft (2.1x3.6m)
16. GARAGE
 Small- 12x20ft (3.6x4.2m)
 Medium- 20x20ft (6.0x6.0m)
 Large- 24x24ft (7.2x7.2m)
17. LAUNDRY
 Small- 3x6ft (0.9x1.8m)
 Medium- 6x8ft (1.8x2.5m)
 Large- 8x10ft (2.5x3.0m)
ELEMENTS OF BUILDING CONSTRUCTION
31 | P a g e
SAQIB IMRAN 0341-7549889 31
COMMON BUILDING COMPONENTS
SUPER STRUCTURE
The super structure is that part of the building which is above the ground and
which serve the purpose of buildings intended use. It includes-
 Plinth
 Wall
 Coulums
 Arches
 Roofs & Slabs
 Lintel
 Chajjas
 Parapet
 Stairs & Steps
SUBSTRUCTURE
The substructure is the lower portion of the building which is located below
ground level which transmits the load of the superstructure to the sub soil. It
includes-
 Foundation
NOMINAL DIMENSIONS OF BUILDING COMPONENT
32 | P a g e
SAQIB IMRAN 0341-7549889 32
Building Component Nominal Dimensions
Plinth (Height) 30, 45, 60, 75, 90 cm
Wall (Thickness)
Partition Wall
Load bearing Wall
10 cm
20, 30, 40 cm
Lintel (Thickness) 15 cm
Lintel (Height) 2.0 m from floor level
Chajja Projection 30, 45, 60, 75, 90 cm
Slab (Thickness) 0.1-0.15 m
Parapet Wall (Thickness) 10 cm
Parapet Height 1 m
Door (Width) 0.8, 0.9, 1.0, 1.2 m
Door (Height) 1.8, 2.0, 2.1 m
Sill Height 0.07-0.1 m
Column Size
Square 20x20, 30x30 cm
Rectangular 20x30 cm
Circular 20Ф, 30Ф
Column Footing 1x1x1m below ground
Depth of Beam 30, 45, 60 cm
Steps
No. of risers = Height of Ceiling+
Slab thickness/ Riser height
No. of Treads= No. of Risers-1
Riser Height 15-20 cm
Tread Width 25, 30, 35 cm
Width of steps Minimum 1 m
DIFFERENT TYPES OF BUILDINGS
A building is a man made structure with a roof and walls standing more or less
permanently in one place such as house or factory. Buildings are classified in to
two categories-
(A). Based on Occupancy
(B). Based on types of Construction
33 | P a g e
SAQIB IMRAN 0341-7549889 33
A. CLASSIFICATION BASED ON OCCUPANCY
1. Residential Buildings
2. Industrial Buildings
3. Educational Buildings
4. Institutional Buildings
5. assembly Buildings
6. Business Buildings
7. Mercantile Buildings
8. Storage Buildings
9. Hazardous Buildings
RESIDENTIAL BUILDINGS
Buildings in which sleeping arrangement are provided with or without cooking
arrangement. It includes single or multi family dwelling, apartments, lodgings,
restaurant, hostels, dormitories and hotels.
INDUSTRIAL BUILDINGS
These are buildings where products or materials of all kinds and properties are
fabricated, assembled, manufactured or processed.
EDUCATIONAL BUILDINGS
These includes any buildings used for schools, colleges, education purposes.
INSTITUTIONAL BUILDINGS
These buildings used for different purposes such as medical or other treatment.
They includes hospitals, sanatorium, jails, asylum.
ASSEMBLY BUILDINGS
34 | P a g e
SAQIB IMRAN 0341-7549889 34
These are the buildings where group of peoples meet or gather for amusement,
social, religious, political, civil travel and similar purposes. E.g. theaters, motion
pictures, house, assembly halls, restaurants assembly halls.
BUSINESS BUILDINGS
These buildings are used for transactions of business, for keeping accounts and
for similar other purpose.
MERCANTILE BUILDINGS
These buildings are used as shops, stores, market for display and sale of
merchandise either wholesale or retail, office, shops, storage services.
STORAGE BUILDINGS
These buildings are used primarily for the storage or sheltering of goods, wares or
merchandise, vehicles and animals, grains.
HAZARDOUS BUILDINGS
These buildings are used for the storage, handling, manufacturing or processing of
highly combustible or explosive materials or products.
B. CLASSIFICATION BASED ON STRUCTURES
1. Framed Structure
2. Load Bearing Structure
FRAMED STRUCTURE
Reinforced cement concrete structures the most common type of construction
today. They consist of a skeleton of beams and columns. The load is transferred
from from beams to the columns and column intern transfer the load directly to
the sub soil through footing. Framed structures are suitable for multistory
building subjected to variety of extreme loads like compressive, tensile torsion,
shear along with moment. The open space in the skeleton are to be filled with
brick walls or glass panels.
LOAD BEARING STRUCTURE
In this type of structures loads from roof slab or trusses and floors are transmitted
through walls to the firm soil below the ground. This types of structures are
adopted where hard strata are available at shallow depth. The structural
elements like beams, slabs rest directly on the walls.
TYPES OF LOADS ON STRUCTURE
35 | P a g e
SAQIB IMRAN 0341-7549889 35
The different types of loads coming on the foundation of a structure are described
below-
1. Dead Load
2. Live Load
3. Wind Load
4. Snow Load
5. Earthquake Load
6. Erection load
1. DEAD LOAD
Dead load comprises of the weight of all walls, partitions, floors, and roof
including all other permanent construction in the building.
2. LIVE LOAD
Live load consist of moving or variable loads due to people or occupants, their
furniture, temporary stores, machineries.
3. WIND LOAD
It is considered as basic wind pressure which is equivalent static pressure in the
direction of the wind.
Wind Pressure = kV2
Where k= co-efficient 0.006
V= wind velocity
Wind pressure always acts in the vertically exposed surface of the walls and
columns.
4. SNOW LOAD
Actual load due to snow depends upon the shape of the roof and its capacity to
retain the snow. The load due to snow may be assumed to be 2.5kg/m3 per cm
depth of snow.
5. EARTHQUAKE LOAD
An earthquake load produced waves in every possible direction below ground. As
per intensity or scale of earthquake, jerk and shocks are acting on the earth. As
per the location of the building in the prescribed zone of earthquake coefficients
of earthquake loads are decided.
6. ERECTION LOAD
36 | P a g e
SAQIB IMRAN 0341-7549889 36
All loads required to be carried by the structure or any part of it due to storage or
positioning of construction material and erection equipment including all loads
due to operation of such equipment shall be considered as erection load.
DAMP-PROOFING
In order to prevent the entry of damp or moisture in the building the damp-
proofing courses (D.P.C) are provided at various levels of entry of damp in to a
building. At present practically all the buildings are given the treatment of damp-
proofing. Thus the provision of D.P.c prevent the entry of moisture from walls,
floors, and basement of a building. Following are the various causes of dampness
in a building:
 Rising of moisture from the ground
 Rain travel from wall tops
 Rain beating against external walls
 Condensation
 Poor drainage, imperfect orientation, imperfect roof slope, defective
construction etc.
The ideal damp proofing material have the following characteristics:
1. It should be perfectly impervious
2. It should be durable
37 | P a g e
SAQIB IMRAN 0341-7549889 37
3. It should be strong and capable of resisting superimposed load coming on
it.
4. It should be flexible so that it can accommodate the structural movements
without any fracture.
5. It should remain steady in its position when once applied
6. It should not be costly.
The materials commonly used for damp-proofing are not bitumen, mastic asphalt,
bituminous or asphaltic felts, metal sheets, combination of sheets are felts, stone,
bricks, mortar, cement concrete and plastic sheets.
The following general principles should be kept in mind while providing D.P.C.
1. The damp-proofing course may be horizontal or vertical.
2. The horizontal damp-proof course ahould cover the full thickness of wall,
excluding rendering.
3. The damp-proof course should be so laid that a continous projection is
provided.
4. At junctions and cornersof walls, the horizontal damp-proof course should
be laid continous.
5. The mortar bed supporting the damp-proof course should be even and
levelled and should be free from projections so that the damp proof course
is not damaged.
6. The damp proof course should not be kept exposed on the wall surface
otherwise it may get damaged during finishing work.
7. When a horizontal damp proof course is continued to a vertical face a
cement concrete fillet of about 75 mm radius should be provided at he
junction.
ARCHES- IMPORTANT TECHNICAL TERMS
An arch is a structure constructed to span across an opening. It generally consist
of small wedge-shaped units which are jointed together with mortar.
The important technical terms used in arch work are as follows:
1. Intrados- It is the inner curve of an arch.
2. Soffit- It is the inner surface of an arch. Sometimes intrados and soffit are
used synonymously.
3. Extrados- It is the outer curve of an arch.
38 | P a g e
SAQIB IMRAN 0341-7549889 38

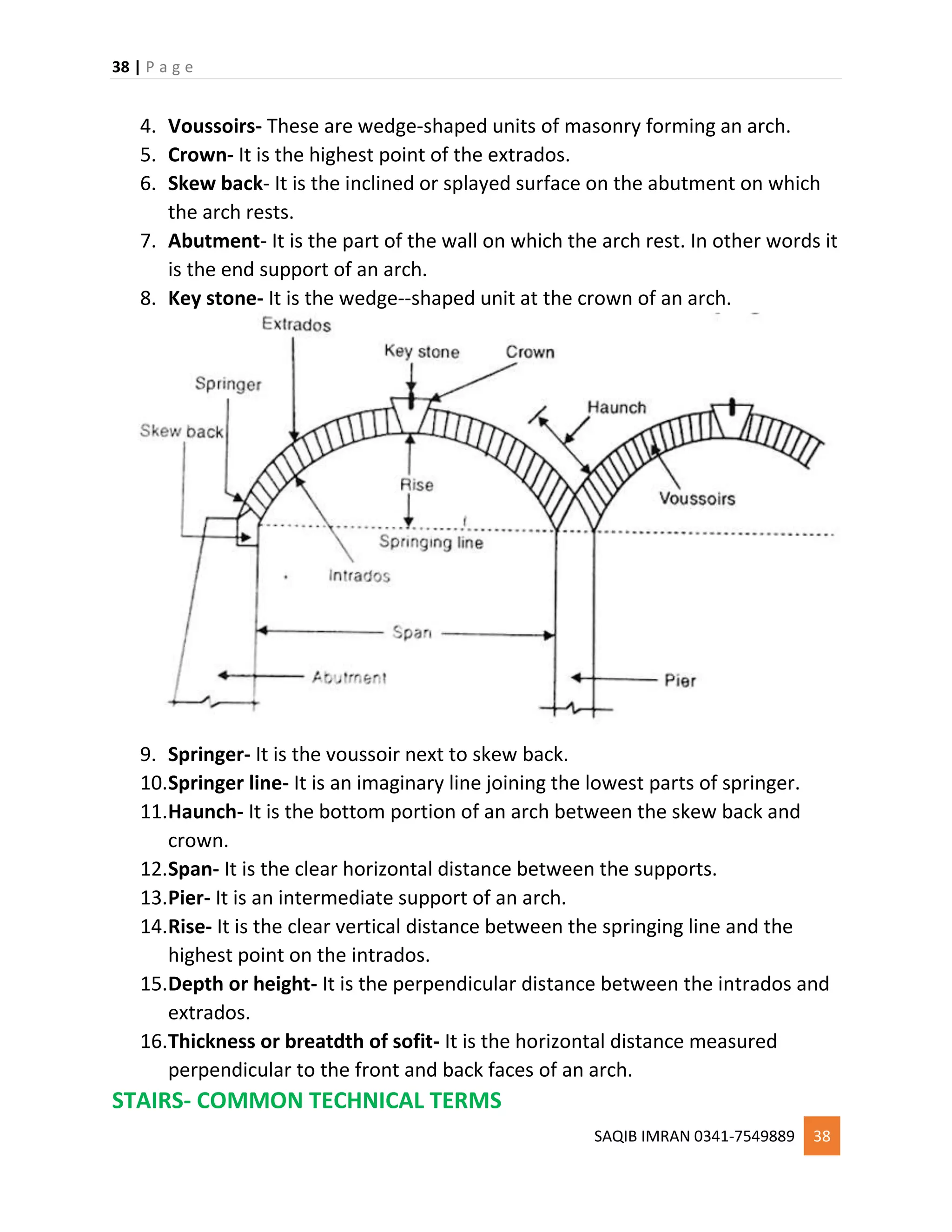

4. Voussoirs- These are wedge-shaped units of masonry forming an arch.
5. Crown- It is the highest point of the extrados.
6. Skew back- It is the inclined or splayed surface on the abutment on which
the arch rests.
7. Abutment- It is the part of the wall on which the arch rest. In other words it
is the end support of an arch.
8. Key stone- It is the wedge--shaped unit at the crown of an arch.
9. Springer- It is the voussoir next to skew back.
10.Springer line- It is an imaginary line joining the lowest parts of springer.
11.Haunch- It is the bottom portion of an arch between the skew back and
crown.
12.Span- It is the clear horizontal distance between the supports.
13.Pier- It is an intermediate support of an arch.
14.Rise- It is the clear vertical distance between the springing line and the
highest point on the intrados.
15.Depth or height- It is the perpendicular distance between the intrados and
extrados.
16.Thickness or breatdth of sofit- It is the horizontal distance measured
perpendicular to the front and back faces of an arch.
STAIRS- COMMON TECHNICAL TERMS
39 | P a g e
SAQIB IMRAN 0341-7549889 39
A stair is a sequence of steps provided to afford the means of ascent and decent
between the floors or landing. The apartment or room of a building in which the
stair is located is known as a staircase and the opening or space occupied by the
stair is known as stairway.
Following are the common technical terms used in connection with the stairs-
Tread- The horizontal upper part of a step on which foot is placed in ascending or
descending a stairway is called tread.
1. Riser- A vertical portion of a step providing a support to the tread is
called riser.
2. Flier- A straight step having a parallel width of tread is called flier.
3. Flight- An unbroken series of steps between two landing is called flight.
4. Landing- A horizontal platform at the top or bottom of a flight between the
floors is calledlanding. It facilitates change of direction and provides an
opportunity for taking rest during the use of the stair.
5. Rise- The vertical distance between two successive tread faces is called rise.
6. Going- The horizontal distance between two successive riser face is
called going.
7. Nosing- The projecting part of the tread beyond the face of riser is
called nosing.
8. Scotia- A moulding provided under the nosing to beautify the elevation of a
step and to provide strength to nosing is called scotia.
9. Soffit- The under surface of a stair is called soffit.
40 | P a g e
SAQIB IMRAN 0341-7549889 40

10.Pitch or slope- The angle which the line of nosing of the stair makes with
the horizontal is called pitch or slope.
11.Strings or stringers- The sloping members which support the steps in a stair
are calledstrings or stringers.
12.Baluster- The vertical member of wood or metal to support the hand rail is
called baluster.
13.Balustrade- The combined frame work of handrail and balusters is known
as balustrade.
14.Hand rail- The horizontal or inclined support provided at a convenient
height is calledhand rail.
15.Newel post- The vertical member placed at the ends of flight connecting
the ends of strings and hand rail is called newel post.
Notes:-
The size of a step commonly adopted for residential building is 250 mm X 160
mm. In hospital etc. the comfortable size of step is 300 mm X 100 mm.
The width of stairs depend upon its location in the building and the types of a
building itself. In a residential building the average value of stair width is 900 mm
while in a public building 1.5 to 1.8 metres width may be required.
The width of landing should be greater than the width of stair.
The pitch of stair should never exceed 40 degree.
In designing a stair a comfortable slopes is achieved when the sum of going and
twice the rise should be equal to 60 approximately.
In designing a stair the product of going and the rise should be equal to 400.
The clear distance between the tread and soffit of the flight immediately above it
should not be less than 2 metres.
An open newel stair consist of two or more straight flights arranged in such a
manner that a clear space occurs between the background and forward flights.
In wooden stairs the thickness of tread is adopted as 38 mm.
41 | P a g e
SAQIB IMRAN 0341-7549889 41
BUILDING MATERIALS
BUILDING MATERIALS
List of building materials.......
1. Brick
2. Cement
3. Sand
4. Coarse Aggregate
5. Concrete
6. Reinforcement
42 | P a g e
SAQIB IMRAN 0341-7549889 42
7. Mortar
8. Wood
9. Tiles
10. Glass
11. Plastic
12. Paint
REQUIREMENTS OF A GOOD AGGREGATE
Following are the desirable properties and requirement of a good aggregate-
 Adhesion
 Cementation
 Durability
 Hardness
 Shape
 Strength
 Toughness
ADHESION:
A good aggregate should have adhesive property, it should have sufficient binding
capacity with binder. If this quality is absent in the aggregate, it will lead to the
separation of bituminous and cement coating in the presence of water.
CEMENTATION:
The binding quality of the aggregate depends on its ability to form its own binding
material under different loading so as to make the rough broken stone pieces grip
together to resist displacement

DURABILITY:
43 | P a g e
SAQIB IMRAN 0341-7549889 43
A good aggregate should be sufficiently durable, it should be sufficiently resistant
to weathering agencies and is largely dependent upon its petrological
composition. This requirement of aggregate is essential so that it can resist the
effect of weathering agencies like rain, frost, variation of temperature etc. in
order to achieve long life of the structures.
HARDNESS:
A good aggregate should be sufficiently hard, it should offer maximum possible
resistance to abrasion and attrition. The road aggregate should be hard enough to
resist abrasion due to grinding of pieces of stones against each other.
SHAPE:
The shape of aggregates may be rounded, cubical, angular, flaky or elongated.
The flaky and elongated aggregates possess less strength and durability and they
are not used in construction work as far as possible. The rounded aggregates are
preferred in cement concrete construction. They are unsuitable in W.B.M
construction, bituminous construction, and in granular base course because their
stability due to interlocking is less. The angular aggregates are used for such types
of construction work.
STRENGTH:
The good aggregates should be sufficiently strong to withstand the stresses
developed due to the wheel load of traffic. This property is especially desirable for
the road aggregates which are to be used in top layer of the pavements. Thus the
wearing course of road should be composed of aggregates which posses enough
strength in addition to enough resistance to crushing.
TOUGHNESS:
A good aggregate quite tough, it should offer the maximum possible resistance to
the hammering effect of wheel load. This is essential so that the aggregate used in
the construction of pavement can resist the impact caused due to movement of
heavy traffic load without breaking into smaller pieces.
PROPERTIES OF GOOD PRESERVATIVE FOR TIMBER
The preservatives used to protect the timber should contain following
requirements or properties-
 It should be effortlessly and cheaply available.
44 | P a g e
SAQIB IMRAN 0341-7549889 44
 It should not contain any harmful substances, gases etc.
 It should cover larger area with small quantity.
 It should be economical.
 It should not contain any unpleasent smell.
 It should not get affected by light, heat, water etc.
 It should not get affected by fungi, insects etc and should also efficient to
kill them.
 It should not generate flame when contact with fire.
 It should not corrode metals when it makes a contact with them.
 Decorative treatment or any surface treatment should be allowed on
timber after the application of preservatives.
 The depth of penetration of preservatives in wood fibers should be
minimum 6mm to 25mm.
QUALITIES OF GOOD TIMBER
Following are the characteristics or qualities of a good timber:
45 | P a g e
SAQIB IMRAN 0341-7549889 45
1. APPEARANCE: A freshly cut surface of timber should exhibit hard and
shining appearance.
2. COLOUR: The colour of timber should preferably be dark. The light colour
usually indicates timber with low strength.
3. DEFECTS: A good timber should be free from serious defects such as dead
knots, flaws, shakes, etc.
4. DURABILITY: A good timber should be durable. It should be capable of
resisting the action of fungi insects, chemicals, physical agencies and
mechanical agencies. If wood is exposed to the actions of acid and alkalies
foe a prolonged period it is seriously damaged. The weak alkali and acid
solutions usually do not affect wood to a considerable extent.
5. ELASTICITY: This is the property by which timber returns to its original
shapes when load causing its deformation is removed. This property of
timber would be essential when it is to used for bows, carrying shafts,
sports goods etc.
6. FIBRES: The timber should have straight fibres.
7. FIRE RESISTANT: The timber is a bad conductor of heat. A dense wood
offers good resistant to the fire and it requires sufficient heat to cause a
flame. The heat conductivity of wood is low and it depends on various
factors such as porosity, moisture content, surrounding temperature,
orientation of fibres, bulk densdity etc.
8. HARDNESS: A good timber should be hard i.e. it should offer resistant when
it is being penetrate by another body. The chemicals present in heart wood
and density of wood impart hardness to the timber. The mere resistance
offered to chisel or saw does not usually indicate hardness of timber.
9. MECHANICAL WEAR: A good timber should not deteriorate easily due too
mechanical wear or abrasion. This property of timber would be essential for
places where timber would be subjected to traffic e.g. wooden floors,
pavements etc.
10.SHAPE: A good timber should be capable of retaining its shape during
conversion or seasoning. It should not bow or warp or split.
11.SMELL: A good timber should have sweet smell. An unpleasant smell
indicates decayed timber.
12.SOUND: A good timber should give out a clear ringing sound when struck. A
dull heavy sound when struck indicates decayed timber. The velocity of
46 | P a g e
SAQIB IMRAN 0341-7549889 46
sound in wood is 2-17 times greater than that in air and hence the wood
may be considered high in sound transmission. The sound conductivity is
faster along the fibres is lower in the radial direction and is slowest along
the chord of a cross-section.
13.STRENGTH: A good timber should be strong for working as structural
member such as joist, beam, rafter etc. It should be capable of taking loads
slowly or suddenly. It should also possess enough strength in direct and
transverse directions.
14.STRUCTURE: It should be uniform. The fibres should be firmly added. The
medullary rays should be hard and compact. The annual rings should be
regular and they should be closed located.
15.TOUGHNESS: A good timber should be tough i.e. it should be capable of
offering resistant to the shocks due to vibrations. This property of timber
would be essential when it is to be used for tool handles, parts of motor
cars and aeroplanes etc.
16.WATER PERMEABILITY: A good timber should have low water permeability
which is measured by the quality of water filtered through a unit surface
area of specimen of wood. The water permeability is greater along the
fibres than in other directions and it depends on initial moisture content,
character of cut, type of wood, width of annual rings, age of wood etc.
17.WEATHERING EFFECTS: A good timber should be able to stand reasonably
the weathering effects. When timber is exposed to weather its colour
normally fades and slow turns grey. A good timber should show the least
disintegration of the surface under adverse weather conditions such as
drying and wetting, extreme heat and extreme cold etc.
18.WEIGHT: The timber with heavy weight is considered to be sound and
strong.
19.WORKING CONDITION: The timber should be easily workable. It should not
clog the teeth of saw and should be capable of being easily planed or made
smooth.
DIFFERENT TYPES OF PRESERVATIVES FOR TIMBER
47 | P a g e
SAQIB IMRAN 0341-7549889 47
1. COAL TAR
The timber surface is coated with hot coal tar with the help of brush. The coal
tar becomes workable when heated. The process is known as the tarring. The
coal tar has unpleasant smell and appearance. It makes timber unsuitable for
painting. Hence the tarring is adopted for frames of doors and windows, rough
timber work etc. and it is found to be most useful for parts embedded in
ground because of its cheapness and effective resistance. The coal tar is fire
resistant.
2. ASCU
The ascu is special preservative which is developed at the Forest Research
Institute Dehradun. Its composition is as follows-
(a). Part by weight of hydrated arsenic pentoxide, (As2O5, 2H2O)
(b). Part by weight of blue vitriol or copper sulphate, (CuSO4, 5H2O)
(c). Part by weight of potassium dichromate, (K2Cr2O7) or sodium dichromate
(Na2Cr2O7, 2H2O)
This material is available in powder form. To prepare a solution of this
material, six parts by weight of ascu are mixed in 100 parts by weight of water.
The solution is then sprayed or applied on timber surface. This preservative
gives timber protection against the attack of white ants. The surface treated
with this preservative can be painted, polished, varnished or waxed. The
solution is odourless.
3. CHEMICAL SLATS
These are water borne preservatives and they are mostly salts dissolved in
water. The usual salts used are copper sulphate, mercury chloride, sodium
fluoride and zinc chloride. The solutions are prepared from these salts and
48 | P a g e
SAQIB IMRAN 0341-7549889 48
they are applied on the timber surface can be painted or varnished after
drying. These preservatives have good penetration and the timbers treated
with these preservatives will show an immediate increase in weight of 2400 to
4800 N per m3
. After drying the net increase in weight will come down to
about 50 to 300 N per m3
.
4. OIL PAINTS
The timber surface is coated with 2 or 3 coats of oil paint. The wood should be
seasoned. Otherwise sap will be confined and it will lead to the decay of
timber. The oil paints preserve timber from moisture and make it durable.
5. SOLIGNUM PAINTS
These paints preserve timber from white ants as they are highly toxic in
nature. They can be mixed with colour pigments and applied in hot state with
the help of brush. The timber surface may therefore be given the desired
colour or appearance.
6. CREOSOTE OIL
In this case the timber surface is coated with creosote oil. The process is
known as the creosoting or Bethel's method of preservation of timber. The
creosote oil is obtained by the distillation of tar. The creosoting is carried out
as follows-
(a). The timber is thoroughly seasoned and dried.
(b). It is then placed in an air tight chamber.
(c). The air is pumped out from the chamber.
(d). The creosote oil is then pumped under a high pressure off about 0.70 to 1
N/mm2
and a temperature of about 50*C.
(e). After a period of about 1 to 2 hours when timber has sufficient absorbed
creosote oil it is taken out of chamber.
The creosote oil is one of the best antiseptic substance poisonous for wood
attacking fungi. It is a black or brown liquid weakly affected by water neither
volatile nor hygroscopic, harmless to wood or metal, inflammable, with an
unpleasant odour and having low wood penetrating ability to the extent of 1
mm to 2 mm only.
The creosoting practically doubles the life of timber and it is generally adopted
for piles, poles, railway sleepers, etc. Depending upon the net retention and
type of timber the creosote treated timber will normally increase in weight by
800 to 3200 N per m3
. The creosote oil is highly toxic in nature and gives out
49 | P a g e
SAQIB IMRAN 0341-7549889 49
highly unpleasant smell. The process of creosoting proves to be costly. The
creosote oil should not be used for interior surface of dwelling houses,
foodstuff storage premises, in underground installation and near inflammable
surface.
IMPORTANT BUILDING STONES
The following are important building stone, their composition, properties and
uses:
1. Granite:
It is an igneous rock. It is mainly composed of quartz, felspar and mica. Its specific
gravity is 2.64 and compressive strength varies from 70 to 130 MN/m2. Its colour
depends upon that of felspar which may be brown, grey, green and pink. A fine
grained granite offers high resistance to weathering. It can be easily polished and
worked. It is used for exterior facing of buildings.
2. Slate:
It is an argillaceous rock. It is mainly composed of alumina mixed with sand or
carbonate of lime. Its specific gravity is 2.8 and compressive strength varies from
60 to 70 MN/m2. It has grey or dark blue colour. A good slate is hard, tough and
fine grained. It is suitable for use in cistern. The slate in the form of tiles is used as
an excellent roof covering material.
3. Gneiss:
50 | P a g e
SAQIB IMRAN 0341-7549889 50
It is a silicious rock. It is mainly composed of quartz and felspar. It is more easily
worked than granite. It is a good material for street paving.
4. Sandstone:
It is a sedimentary rock of silicious variety. It is mainly composed of quartz, lime
and silica. Its specific gravity is 2.65 to 2.95 and compressive strength varies from
35 to 40 MN/m2. Its usual colours are white, grey, brown, pink etc. The fine
grained stones are strong and durable. It is suitable for ashlar work, mouldings,
carving etc.
5. Limestone:
It is a sedimentary rock of calcarious variety. Its specific gravity is 2.6. It is
available in brown, yellow and dark grey colours. It is used in large quantities in
blast furnaces. It may be used as stone masonry for wall.
6. Marble:
51 | P a g e
SAQIB IMRAN 0341-7549889 51
It is a metamorphic rock of calcarious variety. Its specific gravity is 2.7 and is
available in many colours. It is very hard and takes a fine polish. It is used for
carving and decoration work.
7. Kankar:
It is very impure lime stone containing 30% of alumina and silica. The hard kankar
is used for foundations of buildings.
8. Laterite:
It is a sandy clay stone containing high percentage of iron oxides. It has a porous
and cellular structure. Its specific gravity, varies from 2 to 2.2. The laterite blocks
are suitable as building stones whereas nodular laterite proves a very good road
metal.
9. Moorum:
52 | P a g e
SAQIB IMRAN 0341-7549889 52
It is a decomposed laterite and has deep brown or red colour. It is used in
surfacing fancy paths and garden walks.
10. Quartzite:
It is a silicious sand stone which has been subjected to metamorphic action. It is
strong and durable. It is used as a road metal or railway ballast or in concrete.
CONCRETE BLOCKS
RAW MATERIALS-
The materials required for the production of the concrete blocks are aggregates,
cement, water.
53 | P a g e
SAQIB IMRAN 0341-7549889 53
The aggregates of various types have been used with varying degree of success
and they include crushed stones, gravels, volcanic cinder, foamed slag, furnace
clinker, etc. The aggregates are selected by considering the weight, texture or
composition of the unit designed. The strength, texture and economy of the
concrete block depend upon the careful grading of the aggregate. If locally
available aggregate is suitable it will help in achieving the economy.
The cement used is ordinary portland cement. The water required is the normal
potable water.
MANUFACTURING-
The fully automatic plants are available for the manufacturing of high strength
concrete blocks. These automatic machines produce superior quality concrete
blocks. But they involves a large capital investment. The manually operated
machines are also available and they can be installed at project site itself which
further reduce the transportation cost of the concrete blocks from the place of
production to the place of actual use.
The process involves in the manufacturing of the concrete blocks are as follows -
1. Selection and proportion of ingredients- The main criteria for the selection
of the ingredients is the desired strength of the block. The greater the
proportion of course aggregate, the greater will be the strength of the
quantity of cement used.
2. Mixing of ingredients- The blending of aggregate, cement and water should
be done very carefully. The mixing should preferably take place in a
mechanical mixer. For hand mixing extreme care should be taken to see
54 | P a g e
SAQIB IMRAN 0341-7549889 54
that the cement and aggregate are first mixed thoroughly in dry state and
the water is then added gradually.
3. Placing and vibration- The mixed concrete material is fed into the mould
box up to the top level and it is ensured that the box is evenly filled. The
vibration of concrete is done till it has uniformly settled in the mould box.
4. Curing- The block is watered after about one day of casting and it is
continued for a minimum of 7 days and preferably till 20 days. The longer
the curing period the better will be the block.
ADVANTAGES-
The use of concrete blocks as a masonry unit can be observed on many
construction sites because of the following advantages-
1. It increases the carpet area of the building of small width of concrete block
as compared to the brick masonry wall.
2. It provide better thermal insulation, enhanced fire resistance and sound
absorption.
3. It results in the saving of precious agricultural land which is used for the
manufacturing of bricks.
4. The blocks can be prepared in such a manner that the vertical joints can be
staggered automatically and thus the skilled supervision is reduced.
5. The construction of concrete block masonry is easier, faster and stronger
than the brick masonry.
6. The perfect shape and size of the concrete block makes the work of a
mason much simpler.
7. There is saving in construction of mortar because the numbers of joints are
reduced.
8. The utility can be further increased by producing the reinforced concrete
blocks (RCB) masonry units. The blocks are provided two holes for placing
suitable reinforcing bars and the structure with RCB units could safely resist
wind and earthquakes if so designed. The traditional beams and columns
can be completely eliminated and the structure with RCB units cane be
given a better appearance.
USE-
In view of the advantages mentioned above, the concrete block masonry
technique of construction can be adopted on a large scale for mass housing and
various civil engineering projects.
55 | P a g e
SAQIB IMRAN 0341-7549889 55
MARKET FORMS OF STEEL
Following are the standard shapes in which the rolled steel sections are available
in the market-
1. Angle sections-
The Angle section may be equal legs or unequal legs. The equal angle sections are
available in sizes varying from 20 mm x 20 mm x 3 mm to 200 mm x 200 mm x 25
mm. The corresponding weight per meter length are respectively 9 N and 736
N. The unequal angle sections are available in sizes varying from 30 mm x 20 mm
x 3 mm to 200 mm x 150 mm x 18 mm. The corresponding weight per meter
length are respectively 11 N and 469 N. The angle section extensively used in the
structural steel work especially in the construction of steel roof trusses and filler
joist floors.
2. Channel Section-
The channel section consist of a web with two equal flanges. A channel section is
designated by the height of web and width of flange. These sections are available
in sizes varying from 100 mm x 45 mm to 400 mm x 100 mm. The corresponding
weights per metre length are respectively 58 N and 494 N. A channel section of
size 300 mm x 100 mm with weight per metre length as 331 N. The Bureau of
Indian Standards has classified channel sections as junior channel, light channel
and medium channel and accordingly they are designated as I.S.J.C, I.S.L.C and
56 | P a g e
SAQIB IMRAN 0341-7549889 56
I.S.M.C respectively. The channel sections are widely used as the structural
members of the steel framed structures.
3. Expanded Metal
This form of steel is available in different shapes and sizes. It is prepared from
sheets of mild steel which are machine cut and drawn out or expanded. A
diamond mesh appearance is thus formed throughout the whole area of the
sheet. The expanded metal is widely used for reinforcing concrete in foundation,
roads, bridges etc. It is also used as lathing material and for partitions.
4. Corrugated Sheets
These are formed by passing steel sheets through grooves. These grooves bend
and press steel sheets and corrugations are formed on the sheets. These
corrugated sheets are usually galvanized and they are referred to as the
galvanized sheets or G I sheets. These sheets are widely used for roof covering.
5. I- Sections
57 | P a g e
SAQIB IMRAN 0341-7549889 57
These are popularly known as the rolled steel joist or beams. It consist of two
flanges connected by a web. It is designated by overall depth width of flange and
weight per meter length. They are available in various sizes varying from 75 mm x
50 mm at 61 N to 600 mm x 210 mm at 995 N. Joist of size 300 mm x 150 mm at
377 N. The wide flange beams are available on sizes varying from 150 mm x 100
mm at 170 N to 600 mm x 250 mm at 1451 N. The beams suitable for columns are
available in H- section which vary in sizes from 150 mm x 150 mm at 271 N to 450
mm x 250 mm at 925 N. The Bureau of Indian Standard has classified the I section
in to junior beams, light beams, medium beams, wide flange beams and heavy
beams and they are accordingly desingated as ISJB, ISLB, ISMB, ISWB and ISHB
respectively.
6. T- Sections
The shapes of this section is like that of letter T and it consist of flange and web. It
is desingated by overall dimensions and thickness. These sections are availble in
sizes varying from 20 mm x 20 mm x 3 mm to 150 mm x 150 mm x 10 mm. The
coressponding weight per meter length are 9 N and 228 N respectively. T section
of size 100 mm x 100 mm x 10 mm with weight per meter length as 150 N. The
special T section with unequal sides bulbs at the bottom edge of web etc are also
available. These sections are widely used as members of steel roof trusses and to
form built up sections.
7. Plates
58 | P a g e
SAQIB IMRAN 0341-7549889 58
The plates section of steels are available in different sizes with thickness varying
from 5 mm to 50 mm. The corresponding weights per square meter are 392 N and
3925 N respectively. They used mainly for the following purposes in the structural
steel works.
 To connect steel beams for extension of the length
 To serve as tension members of steel roof truss
 To form built up sections of steel
8. Ribbed Bars (HYSD Bars)
These bars are produced from the ribbed which is a deformed high strength steel.
These bars have ribs or projection on their surface and they are produced by
controlled cold twisting of hot rolled bars. Each bars is to be twisted individually
and it is tested to conform the standard requirements. These bars are also called
high yield strength deformed (HYSD) bars. the ribbed bars are available in sizes
varying from 6 mm to 50 mm diameter with the corresponding weight per meter
length as 2.22 N and 154.10 N. These bars are widely used as reinforcement in
concrete structures such as buildings, bridge, docks and harbors structures, roads,
irrigation works, piles foundations, pre-cast concrete works etc.
9. Round Bars
These are available in circular cross section with diameter varying from 5 mm to
250 mm. They are widely used as reinforcement in concrete structures,
construction of steel grill work etc. The commonly used cross-sections have
59 | P a g e
SAQIB IMRAN 0341-7549889 59
diameters varying from 5 mm to 25 mm with the corresponding weights per
meter length as 1.50 N and 38 N respectively.
10. Square Bars
These are available in square cross-section with sides varying from 5 mm to 250
mm. They are widely used in the construction of steel grill work for window,
gates, etc. The commonly used cross-section have side varying from 5 mm to 25
mm with corresponding weight per meter length as 2 N and 49 N respectively.
11. Flat Bars
These are available in suitable widths varying from 10 mm to 400 mm with
thickness varying from 3 mm to 40 mm. They are widely used in the construction
of steel grill work for windows and gates.
12. Ribbed mild steel Bars
These are the hot rolled mild steel bars but during rolling steel rods, ribs are
produced on them. These ribs increases the bond strength of bars. Such ribbed
mild steel bars are not recommended in the code but are available in the market.
They looks like high strength ribbed bars but the allowable stresses in these
ribbed mild steel bars are much lower than the HYSD bars. Theses bars should not
be used in RCC work.
13. Thermo-mechanically Treated Bars (TMT Bars)
60 | P a g e
SAQIB IMRAN 0341-7549889 60
Sudden quenching of red hot steel bars by a spray of water can produce steel bars
with high strength at the structure with a core of mild steel. As the core of the
wire is still hot the heat inside helps in tempering the surface. The result is a
structure with tempered martensite on the periphery and a fine grained ferrite
pearlite at the center. The combined strength of these materials raises the yield
point of steel with the high percentage of elongation at ultimate failure. TMT bars
are also rolled with ribs to increase the bond strength.
These are more corrosion resistance than cold twisted bars. Specially TMT-CRS
(Thermo-mechanically Treated Corrosion Resistance Steel bars ) bars are also
available in the market in which high corrosion resistance is achieved by adding
corrosion resistant element like copper, phosphorous and chromium. These bars
are produced in three grades like Fe415, Fe500, Fe550.
14. Cold Twisted Deformed Bars (CTD Bars)
These were the first high strength steel bars introduced in India around 1960.
These bars are first hot rolled out of high grade mild steel with three or more
parallel straight ribs and other indentation on it. After cooling they are twisted by
a separate operation so that the steel is stained beyond the elastic limit and then
released. This operation raises the yield point of steel for subsequent tensile or
compressive stresses. Thus its strength is increased. Normally welding is not in
this type of steel as the strength of steel is increased due to cold working.
61 | P a g e
SAQIB IMRAN 0341-7549889 61
15. Welded Wire Fabrics (WWF Bars)
Welded wire fabric is fabricated from a series of wires arranged at right angles to
each other and electrically welded at all intersections. It is made from medium
tensile steel drawn out from higher diameter mild steel bars. It is much stronger
than mild steel are available in different width rolls. Welded wire fabric has
various uses in reinforeced concrete construction. It is mostly used for floor slabs
on well compacted ground. Heavier fabrics supplied mainly in flat sheets, iis often
also used in walls and for the primary reinforcement in structural floor slabs. It is
also used in road and runway pavements, box culverts and small canal lining.
62 | P a g e
SAQIB IMRAN 0341-7549889 62
CEMENT NOTES
STORAGE OF CEMENT AND PRECAUTIONS TAKEN
The cement should be stored carefully. Otherwise it may absorbed moisture from
the atmosphere and may become useless for the structural work. Following
precaution are to be taken for the storage of cement
(1). Moisture:
If moisture is kept away from cement, it is found that cement will maintain its
quality for indefinite period. An absorption of one to two percent of moisture has
no appreciable effect on quality of cement. But if moisture absorption exceeds
five percent the cement becomes totally useless. Hence when cement is to be
stored for a long period it should be stored in air tight containers.
(2). Period of Storage:
The loose cement may be stored indefinitely in air tight containers. But it is
advisable to avoid storing off cement in jute bags for a period longer than three
months. If it is unavoidable the cement should be tested to ascertain its
properties.
(3). Piles:
The cement bags are stacked in piles. It is economical to form a pile of 10 bags of
cement. A distance of about 300 mm should be kept between the piles of cement
bags and exterior walls of building. The passages of width about 900 mm should
be provided between the piles. For long storage the top and bottom of piles
should be covered with tarpaulins or water proof paper.
(4). Quality of Cement:
The cement which is finely ground is more active and consequently it absorbs
moisture rapidly from the atmosphere. Hence extraordinary precaution should be
taken to store finely ground cement.
63 | P a g e
SAQIB IMRAN 0341-7549889 63
(5). Removal of Cement:
When cement bags are to be removed from piles of sufficient height the steps
should be formed by taking out two or three bags from front piles. It is also
advisable to remove cement in order of its storage period i.e. cement which is
stored previously should be taken out first. In other words the rule of first in, first
out should be followed.
(6). Storage Sheds:
For storing cement for a sufficient long period the storage sheds of special design
should be constructed. The walls, roof and floor of such sheds should be of water
proof construction.
Few small windows should be provided and they should be kept tightly shut. The
floor should be above ground. If necessary the drainage should be provided to
drain water collected in vicinity of such shed. For determining the size of storage
shed it is found that 20 bags or 10 bags of cement will require about 1 m3 of
space.
It should be noted that cement even if stored in the most favorable conditions
loses its activity when stored for a long time. For instance the storage duration of
3 months and 12 months will cause a reduction in the activity of cement to the
extent of about 20 percent and 40 percent respectively.
Hence it is advisable to reactivate the cement stored for prolonged period. The
most effective method of reacting such cement consists in vibro-grinding which
ensure greater fineness and makes cement fit for use.
IMPORTANT PROPERTIES OF CONCRETE
The following are the important properties of concrete are to be noted by
designer-
1. Through it consists of different materials like cement, sand and jelly the
intimate mixture is so good that for all practical purposes it may be
assumed as homogeneous.
2. For concrete characteristics strength is defined as compressive strength of
150 mm cube at 28 days in N/mm2
, below which not more than 5 percent
cubes gives the result. Based on the characteristics strength concrete is
graded as given below:
Grades of Concrete
64 | P a g e
SAQIB IMRAN 0341-7549889 64
Group Grade
Designation
Characteristics
Strength (N/mm2
)
Ordinary
Concrete
M10
M15
M20
10
15
20
Standard
Concrete
M25
M30
M35
M40
M45
M50
M55
25
30
35
40
45
50
55
High Strength
Concrete
M60
M65
M70
M75
M80
60
65
70
75
80
Now a days ultra high strength of grade M500 are also produced in the
laboratories amd M250 concrete has been used for the construction of some
bridges. Minimum Grades of concrete for different exposure with
normal weight aggregates of 20 mm nominal maximum size.
S. No. Exposure Minimum Grade of
Concrete
1 Mild M20
2 Moderate M25
3 Sever M30
4 Very Sever M35
5 Èxtreme M40
Stress Strain Relationship: Stress strain curve depend on strength of concrete as
well as on the rate of loading. The sort term stress strain curve is to be obtained
for a constant rate of straining of 0.01 percent per minute or for a constant rate
of stress increases of 14 N/mm2 per minute.
Tensile Strength: A designer may use the following expression for the flexceral
tensile strength of concrete:
Fcr = 0.7√fck N/mm2
Where
fck= Characteristics compressive strength of concrete.
65 | P a g e
SAQIB IMRAN 0341-7549889 65
Modulus of Elasticity: The short term modulus of elasticity for concrete may be
taken
as:
Ec = 5000√fck
Poisson's Ratio: It may be taken as 0.1 for high strength concrete and 0.2 for
weak concrete. Usually it is taken as 0.15 for strength and 0.2 for serviceability
calculations.
Shrinkage: Total amount of shrinkage in concrete depends on the various factors
including the amount of water present at the time of casting. In the absence of
data the approximate value of the total shrinkage strain may be taken as 0.0003.
Creep: It depends on various factors including the age of loading, duration of
loading and stress level. The creep coefficient which is defined as the ratio of
ultimate creep strain to elastic strain at the age of loading may be taken as shown
below:
S. No. Age of Loading Creep Coefficient
1 7 Days 2.2
2 28 Days 1.6
3 1 Year 1.1
SLUMP TEST FOR WORKABILITY OF CONCRETE
Slump test is performed to determined the workability as well as the consistency
of fresh concrete mix at the laboratory or the construction site during the
progress of the work.
APPARATUS:-
66 | P a g e
SAQIB IMRAN 0341-7549889 66

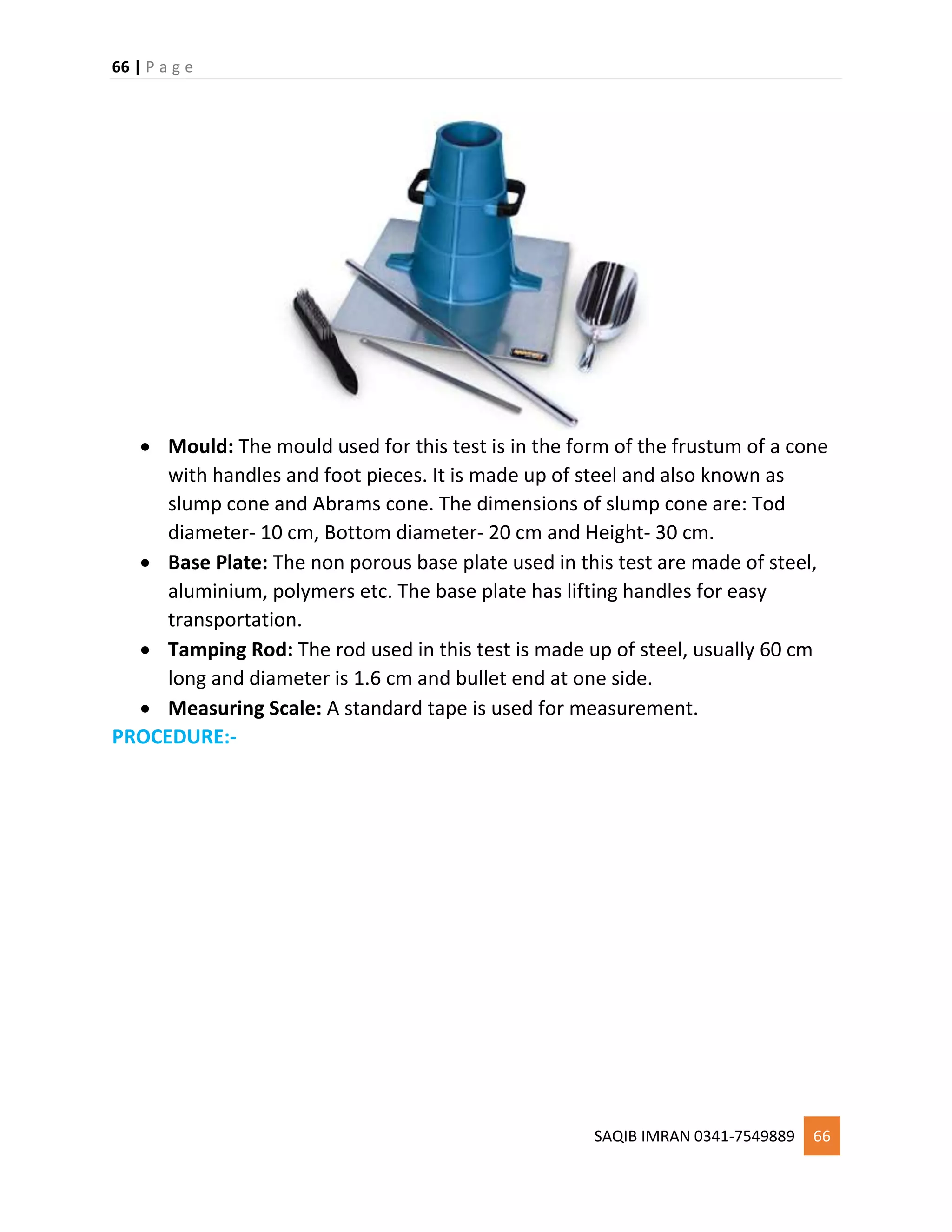

 Mould: The mould used for this test is in the form of the frustum of a cone
with handles and foot pieces. It is made up of steel and also known as
slump cone and Abrams cone. The dimensions of slump cone are: Tod
diameter- 10 cm, Bottom diameter- 20 cm and Height- 30 cm.
 Base Plate: The non porous base plate used in this test are made of steel,
aluminium, polymers etc. The base plate has lifting handles for easy
transportation.
 Tamping Rod: The rod used in this test is made up of steel, usually 60 cm
long and diameter is 1.6 cm and bullet end at one side.
 Measuring Scale: A standard tape is used for measurement.
PROCEDURE:-
67 | P a g e
SAQIB IMRAN 0341-7549889 67
 The slump cone should be thoroughly cleaned and then apply oil to it.
 The base is placed on a smooth surface, set the mould on a horizontal non-
porous and non absorbent base plate.
 Fill the mould fully by pouring freshly mixed concrete in four equal layers
each with an approximate height of 1/4th of mould.
 Each layer is tamped 25 times by tamping rod in a uniform manner over the
cross section of the mould.
 After completely filling the mould excess concrete should be removed and
surface should be leveled with a trowel.
 Now lift the mould slowly and carefully in the vertical direction without
disturbing the concrete cone. It undergoes some subsidence which is called
slump.
 Use the measuring scale to measure the difference level between the
height of the mould and the sample of concrete.
TYPES OF CONCRETE SLUMP:-
 True Slump: After the test when the concrete mass sliding equally
throughout the cone with out disintegration then it is treated as the true
slump.
68 | P a g e
SAQIB IMRAN 0341-7549889 68
 Zero Slump: For very dry and high stiff concrete does not show any
difference after removing the mould. It is the indication of very low water-
cement ratio.
 Collapsed Slump: When the concrete mass collapsed due to very high
water-cement ratio then it is called as collapsed slump.
 Shear Slump: When half of the concrete mass slides down in a inclined
plane then this is known as shear slump. This type of slump is obtained in a
lean concrete mix.
CLASSIFICATION OF CONCRETE MIXES:-
S. No. Slump
Nature of Concrete
Mix
1 No Slump
Stiff and extra stiff
mix
2
From 10 mm to 30
mm Poorly mobile mix
3
From 40 mm to 150
mm Mobile mix
4 Over 150 mm Cast mix
RECOMMENDED SLUMPS OF CONCRETE:-
S. No. Types of concrete Slump
1 Concrete for road construction 20 – 40 mm
2
Concrete for tops of curbs, parapets,
piers, slabs and walls that are
horizontal 40 – 50 mm
3 Concrete for canal linings 70 – 80 mm
69 | P a g e
SAQIB IMRAN 0341-7549889 69
4
Concrete for arch and side walls of
tunnels 90- 100 mm
5 Normal R.C.C. work 80 – 150 mm
6 Mass concrete 25 – 50 mm
7 Concrete to be vibrated 10 – 25 mm
LIMITATIONS OF SLUMP TEST:-
1. It is not suitable for concrete in which maximum size of aggregate exceeds
40 mm.
2. The slump occurs only in case of plastic mixes, not occurs in case of dry
mixes
Different Codes-
ASTM C143- United States
IS:1199-1959- India
EN 12350-2- Europe
PROPERTIES OF CEMENT CONCRETE
Following are the important properties of cement concrete-
(1). Concrete has high compressive strength.
(2). It is free from corrosion and there is no appreciable effect of atmospheric
agents on it.
(3). Its hardens with age and the process of hardening continues for a long time
after the concrete has attained sufficient strength. It is the property of cement
concrete which gives it a distinct place among the building materials.
(4). It is proved to be more economical than steel. This is due to the fact that sand
and pebbles or crushed rock, forming the bulk of cement concrete, to the extent
of about 80-90 % are usually available at the moderate cost. The formwork which
70 | P a g e
SAQIB IMRAN 0341-7549889 70
is of steel or timber can be used over and over again of for other purposes after it
is removed.
(5). It binds rapidly with steel and as it is weak in tension, the steel reinforcement
is placed in cement concrete at suitable place to take up the tensile stress. This is
termed as the reinforced cement concrete or simply R.C.C.
(6). Under the following two conditions it has tendency to shrink.
There is initial shrinkage of cement concrete which is mainly due to the lose of
water through forms, absorption by surface of forms etc.
The shrinkage of cement concrete occurs as it hardens. This tendency of cement
concrete can be minimized by proper curing of concrete.
(7) It has tendency to be porous. This is due to the presence of voids which are
formed during and after its placing. The two precaution necessary to avoid this
tendency are as follows:
There should be proper grading and consolidating of its aggregates.
The minimum water cement ratio should be adopted.
(8). It forms a hard surface, capable of resisting abrasion.
(9). It should be remembered that apart from other materials, the concrete comes
to the site in the form of raw materials only. Its final strength and quality depends
entirely on local conditions and persons handling it. However the materials of
which concrete is composed may be subjected to rigid specifications.
71 | P a g e
SAQIB IMRAN 0341-7549889 71
CONSTRUCTION EQUIPMENTS
TYPES OF CONSTRUCTION EQUIPMENTS
Construction equipment can be categorized as follows-
A. EARTH MOVING EQUIPMENT
1. Excavators
2. Graders
3. Loaders
4. Skid loaders
5. Crawler loader
6. Back hoe
7. Bulldozers
8. Trenchers
9. Scrapers
10.Shovels
B. MATERIAL HANDLING EQUIPMENT
1. Crane
72 | P a g e
SAQIB IMRAN 0341-7549889 72
2. Conveyors
3. Hoist
4. Forklifts
C. CONSTRUCTION EQUIPMENT
1. Concrete Mixers
2. Compactors
3. Pavers
4. Road Rollers
D. CONSTRUCTION VEHICLE
1. Tippers
2. Dumpers
3. Trailers
4. Tankers
E. TUNNELING EQUIPMENT
1. Road Headers
2. Tunnel boring machine
F. OTHER CONSTRUCTION EQUIPMENT
CONSTRUCTION TOOLS AND THEIR USES
1. HOE:
A hoe is a tool used to digging soil and to place cement mortar, concrete in head
pan.
73 | P a g e
SAQIB IMRAN 0341-7549889 73
2. PICK AXE:
It is a hand tool with hard metal head and wooden handle. This tool is used to
excavate the soil. It is more suitable for hard soil which is quite difficult to dig with
spade or hoe.
3. SPADE:
A spade is tool contains metal plate at the end of long wooden handle. It is used
to dig the soil for foundation trenches etc.
4. DIGGING BAR:
A digging bar is a long straight solid metal rod with pin shape at the bottom used
to dig the hard surfaces of ground.
5. MEASURING BOX:
74 | P a g e
SAQIB IMRAN 0341-7549889 74
Measuring box is used to measure the quantity of cement, sand and aggregates
used for making concrete mix. The volume of measuring box is generally 1 cum
feet which makes it easy to measure concrete ratio. The general dimensions of
measuring box are 300 x 300 x 400 mm.
6. HEAD PAN:
Head pan is commonly used in construction sites made of iron or plastic. It is used
to lift excavated soil or cement or concrete to the working site.
7. MASONRY TROWEL:
The masonry trowel is used in brick work or stone work spreading, leveling and
shaping mortar or concrete. It is made up of steel and wooden handle is provided
for holding. The ends of trowel may be pointed or bull nosed.
8. FLOAT:
75 | P a g e
SAQIB IMRAN 0341-7549889 75
It is made up of wood contains handle on its top and smooth surface on its
bottom. Float is used to give a smooth finish to the plastered area.
9. WHEEL BARROW:
A wheel barrow is a small hand propelled vehicle with one wheel designed to be
pushed by a single person using two handle at the rear. It is used to transport bulk
weight of materials like cement, sand, mortar, concrete etc.
10. PLUMB BOB:
A plumb bob is a weight with pointed tip at the bottom, suspended from a string
and used as a vertical reference line or plumb line. It is used to check verticality of
structures. It is also used in surveying to level the instrument position.
11. CONCRETE MIXER:
76 | P a g e
SAQIB IMRAN 0341-7549889 76
A concrete mixer is a device that homogeneously mixes cement, aggregates such
as sand or gravels and water to form concrete. A typical concrete mixer uses a
revolving drum to mix the components.
12. CROWBAR:
Crow bars are commonly used to open nailed wooden crates, remove nails, or pry
apart board.
13. BRICK HAMMER:
Brick hammer has one flat traditional face and a short or long chisel shaped blade.
It is used to cut the bricks and also used to push the bricks if they come out from
the course line.
14. CHISEL:
A chisel is a tool that has a long metal blade with a sharp edge at the end and a
handle which is struck with a hammer or mallet. It is generally used in wood work
and must be useful to remove the concrete bumps or excess concrete in
77 | P a g e
SAQIB IMRAN 0341-7549889 77
harden surface.
15. LINE AND PINS:
A line pin is a metal rod usually with a pointed, leaf shaped blade and and a flat
button head. Lines are typically found in pairs as they are commonly used as
anchor points for a brick line. It is used to level the alignment of bricks course
while brick laying.
16. MEASURING TAP:
It is a common measuring tool consist of a ribbon of clothe, plastic, fiber glass or
metal strip with linear measurement marking. It is used to check the thickness,
length, widths of masonry walls, foundation beds, excavated trenches etc.
17. RUBBER BOOTS:
78 | P a g e
SAQIB IMRAN 0341-7549889 78
Safety rubber boots are required to protect legs may have damaged due to
contact with chemical materials like cement or physical accidents during the
construction work.
18. GLOVES:
Gloves are required to prevent the hands from direct contact with cement, paints
etc. and to avoid injury while using machines, tools etc. Gloves made from lather,
cotton, synthetic, nitrile, latex, PVC or combinations of these.
19. HAND SAW:
Hand saw is used to cut wood materials like doors, windows etc.
20. LADDER:
A ladder is a vertical or inclined set of rugs or steps. It is also required in
construction works to check the slab work, to transport material to the higher
79 | P a g e
SAQIB IMRAN 0341-7549889 79
floor, to paint the walls etc.
21. TILE CUTTER:
Tile cutters are used to cut the tiles to a required shape and size. Sometimes
normal size of tiles is larger than the size required at the corners where the floor
meets the wall in that case tile cutter is useful.
22. PUTTY KNIFE:
Putty knife is used to level the putty finishing and also used to reduce the
thickness of finish when it is more thick.
23. DRILL MACHINE:
Drill machine is used to make holes in the walls, slabs, doors, window frames etc.
24. JACK PLANE:
80 | P a g e
SAQIB IMRAN 0341-7549889 80
Jack plane is used in the wooden work to smoothen the surface of doors,
windows etc.
25. MASON SQUARE:
Mason square is used to achieve perfect right angle at the corner of masonry wall.
It is L shaped. First course is laid properly using mason square then based on first,
remaining layers of bricks are set out.
26. MEASURING WHEEL:
Measuring wheel is used to measure the distances or lengths. It contains a wheel
of known diameter which record the number of complete revolutions from which
distance can be measured. It makes the work easier.
27. EARTH RAMMER:
81 | P a g e
SAQIB IMRAN 0341-7549889 81
An earth rammer is a hand tool consist of big square shaped block with handle.
Sometimes it is also called tamper. It is used in construction industries to
compress or compact earth or soil. The earth rammer creates a solid, compacted
layer of earth by compressing the soil repeatedly with its weight.
28. SAFETY GLASSES:
Safety glasses should be used to protect the eye from dust, chemical action of
materials etc.
29. SAFETY HELMET:
The safety helmet is regarded one of the basic safety device required for workers
in several industrial and construction related sectors in addition to industries likes
mining's, petroleum, refineries and so on. If any material for structure may fall
from height during construction work, it protects the head from injury or any fatal
accident.
30. SCRATCHER:
82 | P a g e
SAQIB IMRAN 0341-7549889 82
Plastering of a surface is carried out layer wise, minimum two layer are necessary
for plastering. To provide a good bond between the old and new layer, old layer is
scratched with the help of tool called scratcher.
31. SAND SCREEN MACHINE:
The sand screen machine is used to screen the sand or fine aggregate before
mixing it with concrete. It should remove the impurities and coarse particles from
sand.
32. SPIRIT LEVEL:
A spirit level is an instrument designed to indicate whether a surface is horizontal
or vertical. It is made up of wood or hard plastic with bubble tube in the middle
which is partially filled with alcohol so the air bubble is formed in it. It is used in
brick masonry, plastering, flooring and tile work to check the horizontal level of
surface. The surface is leveled if the air bubble settles at the middle of the tube.
33. POLISHER:
83 | P a g e
SAQIB IMRAN 0341-7549889 83
A polisher is a device used to smoothen the rough surfaces of tiles, marble, wood
works etc. The smoothening makes them shine and the process is called polishing.
34. BUMP CUTTER:
A bump cutter is a tool used to leveled the fresh concrete surfaces likes concrete
floors, foundations, pavement etc. This is also called screed.
35. CIRCULAR SAW:
Circular saw is used to cut wood boards, frames etc. It is used when accurate
cutting is required in less time. It is safer then hand saw.
36. FRAMING HAMMER:
84 | P a g e
SAQIB IMRAN 0341-7549889 84
Framing hammer is used to used to drive and remove nails.
37. VIBRATOR:
A concrete vibrator is a construction tool typically used on construction pouring
sites. The vibrators are used to ensure that the pour is free of air bubbles and are
even. This is so that the concrete remains strong and has a smooth finish even
after removal of the form work.
LIST OF EQUIPMENT USED IN ROAD CONSTRUCTION PROJECTS
(A). PNEUMATIC TOOLS:
1. Air Compressor
2. Rock drill/ Jack hammer/ Steel drill/ Wood drill
3. Concrete Breaker
4. Asphalt Cutter
5. Rock Splitter
6. Compacter
7. Impact Wrenches/ Nail Driver
8. Grinder
9. Concrete Vibrators
10.Backfill Tamper
11.Circular Saw/ Chain Saw
12.Road Broom
(B). ROCK CRUSHER:
1. Jaw Crusher, Double Roll Crusher, Cone Crusher, Hammer Mill
2. Screens
3. Conveyors
85 | P a g e
SAQIB IMRAN 0341-7549889 85
(C). ASPHALT PLANT:
1. Central Mix Plant
2. Hot oil Heater
3. Asphalt Melter
4. Bitumen Distributer
5. Asphalt kettle/ Bitumen Heater
6. Portable Mix Plant
7. Pavers
8. Rotary Sweeper
9. Aggregate Speader
(D). CONCRETE PLANT:
1. Aggregate Batching Plant
2. Concrete Mixer
3. Concrete Pavers
4. Concrete Vibrator
5. Concrete Saw
6. Portable Concrete Curing Machine
(E). EARTH MOVING EQUIPMENT:
1. Dozer
2. Loader/ Shovel
3. Excavator/ Backhoe
4. Scraper
5. Grader
6. Hauler
(F). COMPACTION EQUIPMENT:
1. Sheep foot Roller, Tamping Roller
2. Steel Wheel Vibratory Roller
3. Steel Wheel Static Roller
4. Pneumatic Roller
5. Plate Compactor/ Rammer
(G). ANCILLARY EQUIPMENT:
1. Water Distributer
2. Rotary Tiller Mixer
3. Portable Electric Generator
4. Welding Generator
86 | P a g e
SAQIB IMRAN 0341-7549889 86
5. Crane
6. Pile Driver
7. Water Pump
8. Boring Ring
9. Fork Lift
10.Trucks Flat Bed
11.Low Bed Transporter
EARTH COMPACTING EQUIPMENTS- TYPES OF ROLLERS
Following are the equipments used for the compaction of earth:
1. Smooth Wheel Roller
2. Sheep Foot Roller
3. Pneumatic Roller
4. Tamping Roller
5. Grid Roller
6. Vibratory Roller
1. SMOOTH WHEEL ROLLER:
 This types of roller incorporates a large steel drum at the front and one or
two wheels or drums at the rear.
 If their is one wheel at the rear they are known as Tandem roller, and Three
wheeled roller if there are two wheels at the rear.
 The weight of tandem roller varies from 2-8 tonnes and three wheeled
roller varies from 8-10 tonnes.
87 | P a g e
SAQIB IMRAN 0341-7549889 87
 The ground pressure exerted by tandem roller is typically around 10-17
kg/cm2.
 The weight of roller increased by blasting with sand, water or pig iron.
 Smooth wheel roller are most suitable for consolidating stone, gravel, sand,
hardcore and ballast but are not suitable for embankments, soft sub-grades
or uniform sand.
 The Speed and number of passes of a smooth wheel roller depends on the
types of soil to be compacted and project requirements.
 The optimum working speed has found to be 3-6 km/h and about 8 passes
are adequate for compacting 20 cm layer.
 The smooth wheel roller leaves the surface smooth after compaction.
2. SHEEP FOOT ROLLER:
 Sheep foot roller consist of a steel drum on which round or rectangular
protrusions known as lugs or feet are fixed.
 There are different types of lugs such as spindle shaped with widened base,
prismatic and clubfoot.
 Sheep foot roller are used for compacting fine grained soil such as heavy
clay and silty clay. They are used for compaction of soils in
dam, embankments, sub-grade layers in pavements and rail road
construction projects.
 Coverage area of sheep foot roller is less about 8-12 % because of the boots
on drums.
 Contact pressure of this type roller varies from 1200-7000 Kpa.
 Area of each protrusions in sheep foot roller varies from 30-80 cm2.
88 | P a g e
SAQIB IMRAN 0341-7549889 88
 Generally 10-20 passes are required to provide complete coverage on the
soil and top layer of consolidated soil finished by smooth wheel roller.
Factors that governs the amount of compaction of soil are-
1- Weight of roller
2- Area of each lugs
3- No. of lugs in contact with the ground
4- No. of lugs per drum
3. PNEUMATIC ROLLER:
 Pneumatic roller consist of a heavily loaded wagon with with several rows
of closely spaced tyres. They are also known as rubber tyred roller.
 They provide uniform contact pressure through out the width covered and
are often used in pavement sub-grade works.
 They are suitable for compacting uniform coarse soil and rock. They are
also used to finish embankment compacted by sheep foot roller.
 The factors which affect the amount of compaction that can be achieved
are the weight, tyre inflation pressure and the area of contact.
 Coverage area of pneumatic roller is about 80%.
 Contact pressure of pneumatic roller ranges from 500-700 Kpa.
 The optimum speed of roller is between 6-24 km/h and maximum density
can be achieved by 8 passes of the roller.
 The gross weight of roller 6-10 tonnes which can be increased to 25 tonnes
by ballasting.
4. TAMPING ROLLER:
89 | P a g e
SAQIB IMRAN 0341-7549889 89
 The tamping rollers are similar to sheep foot roller.
 Tamping roller consist of four wheels and one each wheel kneading
boots/feet are fixed.
 These roller also consist of leveling blades to spread the material.
 Tamping roller has more coverage area about 40-50%.
 Contact pressure of tamping roller varies from 1400-8500 Kpa.
 Tamping roller is best dedicated for fine grained soils.
 Tamping roller have static weight in the range of 15-40 tonnes and their
static linear drum loads are between 30-80 kg/cm.
 The degree of compaction achieved is more than sheep foot roller and
density achieved by tamping roller after compaction is more uniform.
5. VIBRATORY ROLLER:
 Vibratory roller have fitted with one or two smooth surfaced steel drums
measuring 0.9-1.5 in diameter and 1.2-1.8 in width.
90 | P a g e
SAQIB IMRAN 0341-7549889 90
 The drum vibrates by the rotation of an electric shaft inside.
 Vibratory roller are commonly used for compacting granular base course
and some times for asphalt.
 Tamping roller have higher output and improved performance compared to
other rollers.
6. GRID ROLLER:
 Grid roller have a cylindrical heavy steel surface comprising a network of
steel bars which form a grid with square shaped holes.
 They are typically used for the compaction of well graded coarse soil and
weathered rocks, often in sub-grades and sub-base road projects.
 They are not suitable for clayey soil, silty clay or uniform soil.
 The weight of grid roller con be increased by ballasting with concrete
blocks.
 Typical weight of grid roller vary between 5.5 tonnes net and 15 tonnes
ballasted.
 This roller provides higher contact pressure but little kneading action.
BULL DOZERS
91 | P a g e
SAQIB IMRAN 0341-7549889 91
These versatile equipments are commonly used in construction projects. It is
essentially a heavy steel blade which is mounted on the front of a tractor. The
tractor can be of the crawler or the wheel type. The heavy blade attached to the
tractors pushes the material from one place to another. Bull dozers are classified
on the basis of:
(A). Position of blades:
1. Bull dozers with blades perpendicular to the direction of movement.
2. Angle dozers in which the blade is set at an angle with the direction of
movement
(B). Based on mountings:
1. Wheel mounted
2. Crawler mounted
(C). Based on the control:
1. Cable controlled
2. Hydraulically controlled
The earth moving bull dozer consist of a heavy blade of somewhat concave
profile. The blade is attached to the body of the tractor with two arms and a
supporting frame. The blade is held at the lower edge on the two heavily built
push arms which are hinged to the track frame of the tractor. The top of the blade
is supported by two brace arms attached to the push arms. The blade is projecting
ahead at the bottom.
92 | P a g e
SAQIB IMRAN 0341-7549889 92
Application-
 Bull dozer are mainly used for the following operations-
 For spreading the earth fill
 For opening up pilot roads through mountainous and rocky terrains
 Clearing construction sites
 Maintaining haul roads
 Clearing land from the trees and stumps
 Back filling trenches at construction sites by dragging the earth from one
place to another.
COMPONENTS OF A CITY ROAD
The following technical terms should be clearly understood before making
detailed study of a road construction.
1. RIGHT OF WAY-
The area of land acquired for construction and future development of a road
symmetrical about the central alignment is called right of way. The width of these
acquired land is known as land width and it depends upon the importance of the
road and possible future development.
2. FORMATION WIDTH-
The top width of the highway embankment or the bottom width of highway
cutting excluding the side drains is called formation width or road way. The
93 | P a g e
SAQIB IMRAN 0341-7549889 93
formation width is the sum of widths of pavements of carriage way including the
separators and width of the shoulders on either side of the carriage way.
3. CARRIAGE WAY-
The portion of the road surface which is used for vehicular traffic is known as
carriage way or pavement. The width of carriage way depends upon the width
and number of lanes. For single lane roads the width of pavement is generally
kept 3.75 m.
4. CROWN-
The highest point on the road surface is called crown.
5. CAMBER OR CROSS SLOPE-
The rise of the center of the carriage wway about its edges along the straight
portion of a road is called camber or cross slope. The transverse slope of the
pavement is provided for the drainage of rainwater. The amount of camber for
the roads is decided according to the road surface and the amount of rainfall.
6. SEPARATOR OR DIVIDER-
The narrow continuous structure provided for dividing the two directions of the
traffic flow is known as separator or divider.
7. SHOULDERS-
The portion of the roadway between the outer edges of the carriage way and
edge of the top surface of the embankment or inner edge of the side drains in
cuttings of the roads are called shoulders. The shoulders are generally in level
with road surface having a slope towards drain side. The shoulders and foot path
prevent the edge of the road from wear and tear. The minimum shoulder width
recommended by IRC is 2.5 m.
8. KERBS-
The boundaries between the pavement and shoulder of foot path are known as
kerbs. These are also provided between the pavement and the traffic separator or
divider. It is desirable to provide kerbs on urban roads.
9. SIDE SLOPES-
The slopes of the sides of earth work of embankment and cutting to ensure their
stability are called side slopes. The embankment is generally given a side slope of
1:1.5.
10. BERMS-
The width of the land left in between the toes of the embankment and the inner
edges of the borrow pits is called berms.
94 | P a g e
SAQIB IMRAN 0341-7549889 94
LOW COST BUILDING MATERIAL AND TECHNIQUES
1. RAT TRAP BOND
The rat trap bond is a masonry technique, where the bricks are used in a way
which creates a cavity within the wall, while maintaining the same wall thickness
as for a conventional brick masonry wall. While in a conventional English bond or
Flemish bond, bricks are laid flat, in a Rat trap bond, they are placed on edge
forming the inner and outer face of the wall, with cross bricks bridging the two
faces. The main advantage of Rat-trap bond is reduction in the number of bricks
and mortar required as compared to English/ Flemish bond because of the cavity
formed in the wall. The cavity also makes the wall more thermally efficient. This
also reduces the embodied energy of brick masonry by saving number of bricks
and the cement-sand mortar. It is suitable for use, wherever one-brick thick wall
is required. Since its original dissemination in Kerala in the 1970sby architect
Laurie Baker, rat trap bond has been extensively used in every category of
building from large institutional complexes, community buildings. Government
offices/village panchayats, individual homes both for high income and middle
income and also in government supported EWS housing programmes.
2. FILLER SLAB
95 | P a g e
SAQIB IMRAN 0341-7549889 95

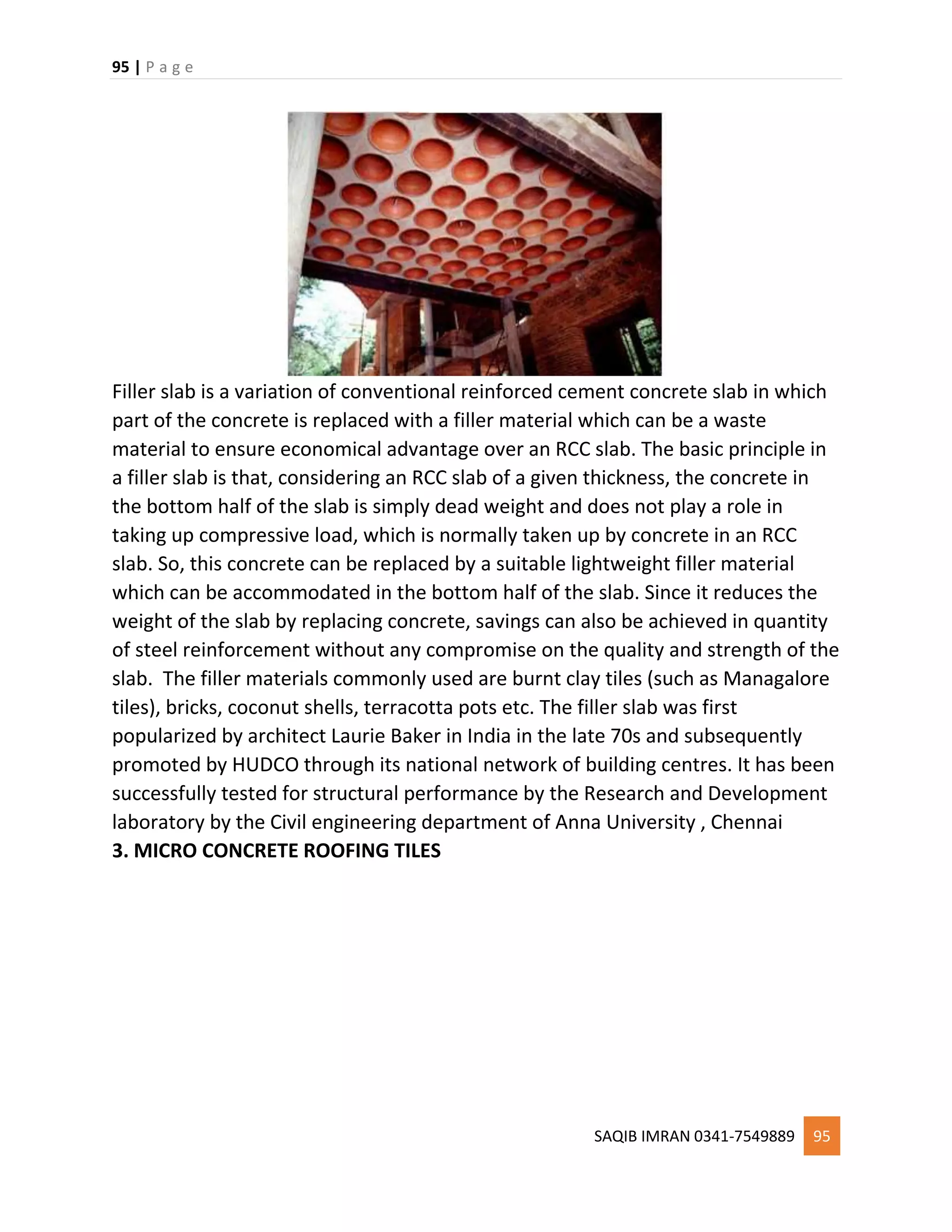

Filler slab is a variation of conventional reinforced cement concrete slab in which
part of the concrete is replaced with a filler material which can be a waste
material to ensure economical advantage over an RCC slab. The basic principle in
a filler slab is that, considering an RCC slab of a given thickness, the concrete in
the bottom half of the slab is simply dead weight and does not play a role in
taking up compressive load, which is normally taken up by concrete in an RCC
slab. So, this concrete can be replaced by a suitable lightweight filler material
which can be accommodated in the bottom half of the slab. Since it reduces the
weight of the slab by replacing concrete, savings can also be achieved in quantity
of steel reinforcement without any compromise on the quality and strength of the
slab. The filler materials commonly used are burnt clay tiles (such as Managalore
tiles), bricks, coconut shells, terracotta pots etc. The filler slab was first
popularized by architect Laurie Baker in India in the late 70s and subsequently
promoted by HUDCO through its national network of building centres. It has been
successfully tested for structural performance by the Research and Development
laboratory by the Civil engineering department of Anna University , Chennai
3. MICRO CONCRETE ROOFING TILES
96 | P a g e
SAQIB IMRAN 0341-7549889 96
Micro-concrete roofing (MCR) tiles are used as a cladding material for
construction of sloping roofs. They are 10mm thick and basically made up of a
plain cement concrete which uses stone aggregate of less than 6 mm size. The
concrete mix is well compacted through optimum vibration provided by an
electric vibrator. These tiles derive their strength primarily from their shape and a
very low water cement ratio used during production. When the tile is produced
on a vibrating table top, it is flat. The tiles are moulded to their standardized
profile after they are transferred to a plastic mould. The profile of the tiles is such
that it enables overalp between adjacent tiles to prevent water leakage. The
effective dimensions of the tiles (after overlap) are 400mm x 200mm, with 13 tiles
needed for 1 m2
of roof area. The production package available for the tiles has
been specially designed to provide a compact work-station with an integrated
vibrating table to compact the tiles. MCR tiles can be laid over a variety of under-
structures like trusses, rafters and purlins, made with steel, timber or even
bamboo. Tiles of two profile types- Pan (curved) and Roman (flat) can be made
using the production equipment.
4. FUNICULAR SHELL ROOF
97 | P a g e
SAQIB IMRAN 0341-7549889 97

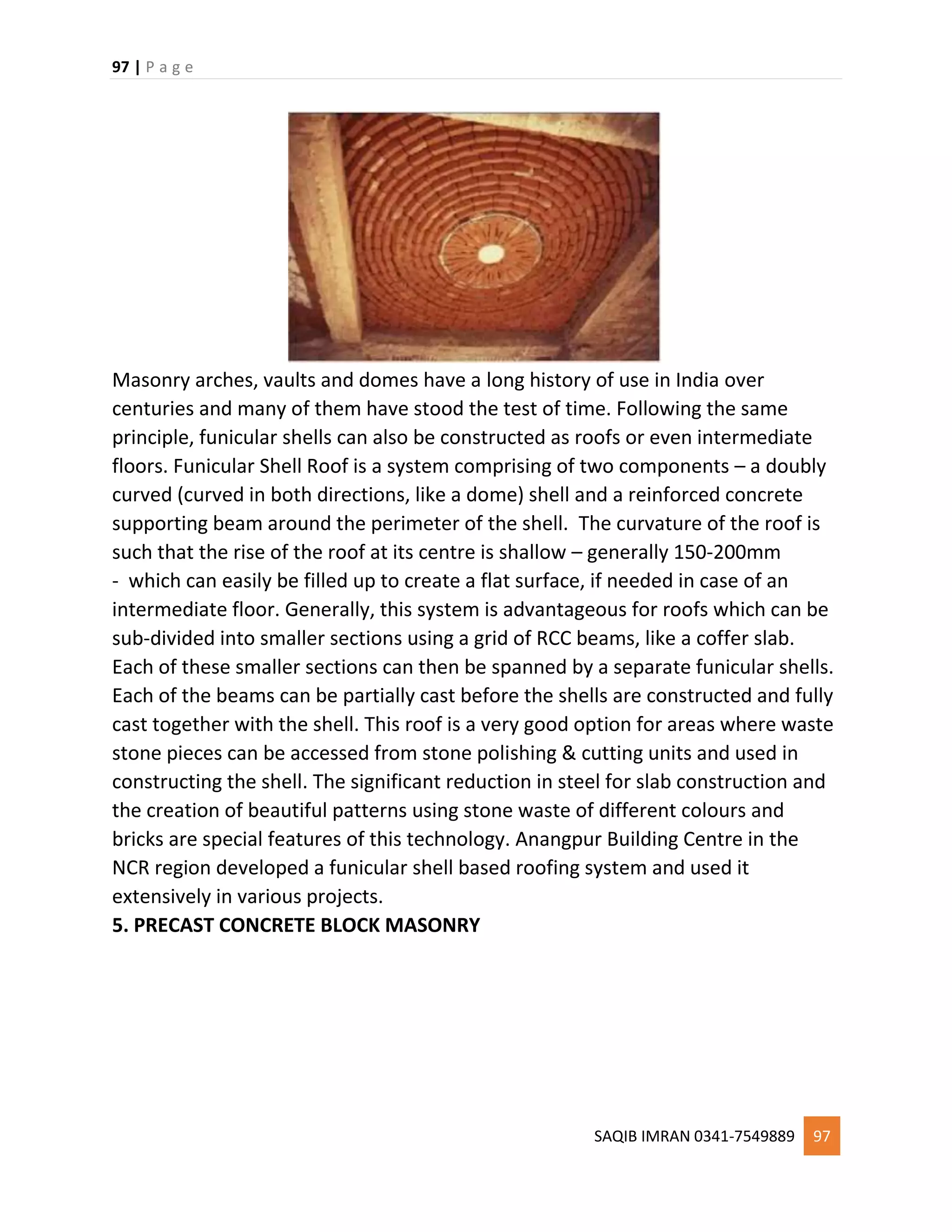

Masonry arches, vaults and domes have a long history of use in India over
centuries and many of them have stood the test of time. Following the same
principle, funicular shells can also be constructed as roofs or even intermediate
floors. Funicular Shell Roof is a system comprising of two components – a doubly
curved (curved in both directions, like a dome) shell and a reinforced concrete
supporting beam around the perimeter of the shell. The curvature of the roof is
such that the rise of the roof at its centre is shallow – generally 150-200mm
- which can easily be filled up to create a flat surface, if needed in case of an
intermediate floor. Generally, this system is advantageous for roofs which can be
sub-divided into smaller sections using a grid of RCC beams, like a coffer slab.
Each of these smaller sections can then be spanned by a separate funicular shells.
Each of the beams can be partially cast before the shells are constructed and fully
cast together with the shell. This roof is a very good option for areas where waste
stone pieces can be accessed from stone polishing & cutting units and used in
constructing the shell. The significant reduction in steel for slab construction and
the creation of beautiful patterns using stone waste of different colours and
bricks are special features of this technology. Anangpur Building Centre in the
NCR region developed a funicular shell based roofing system and used it
extensively in various projects.
5. PRECAST CONCRETE BLOCK MASONRY
98 | P a g e
SAQIB IMRAN 0341-7549889 98
Concrete has a wide application in construction across various parts of a building
– from foundation to columns to roof, because it can be formed into various
shapes. Concrete blocks are precast masonry units which are rectangular in shape
and made with plain cement concrete of a lean mix-proportion that ranges from
1:9 to 1:13 (1 part of cement: 13 parts of sand and stone aggregates). In addition
to the basic components, the concrete for making blocks may also contain
additives like admixtures to increase compressive strength, or improve
workability. They have also been produced with improved textures for better
durability and appearance using stone ships or glazed surfaces. Concrete blocks
have been in use in India for nearly three decades and are commonly found in all
parts of the country- both rural and urban. They also owe their popularity to the
fact that speed of construction is enhanced since the blocks could be 5-10 times
bigger than burnt bricks. Commonly available dimensions are length 200-400mm,
width 100 or 200mm and height 150-200 mm. Both solid and hollow blocks are
made – generally hollow blocks are used for partition walls. Various machines are
available in the country for concrete block production
6. PRECAST RCC PLANK AND JOIST
This is a system which uses precast concete elements to construct a roof which
can also be used as an intermediate floor. It consists of two main elements – 1.
the plank which represents smaller sections of the slab and therefore of reduced
99 | P a g e
SAQIB IMRAN 0341-7549889 99
thickness and reinforcement, and 2.Joist which is a beam spanning across the
room to provide bearing for the planks. The joist is partially precast, with the
remaining portion being cast in-situ after the planks are installed. The planks can
be made in standard sizes of 0.3m x 1.5m and the joists can be 0.15m x 0.15m in
size for a roof span upto 4 metres. The planks are supported over partially precast
RC joists side by side and then joined together with in-situ concrete poured over
the entire roofing area. Monolithic action of the slab elements is enhanced by
leaving reinforcement hooks projecting out of joists and providing nominal
reinforcement over the planks, before the in-situ concrete is poured. The
technique has been developed by the Central Building Research Institute (CBRI)
and validated by the BMTPC (Building Materials and Technology Promotion
Council). The technique can be easily adapted by masons who are familiar with
the similar technique of placing stone slabs over girders to construct roofs. Both
elements of the roof – planks and joists can be manually produced at site using a
wooden moulds. Alternatively, given the context of a large scale use such as
housing project, they can be produced in a small enterprise mode using steel
moulds mounted on vibrating tables. The technique has successfully been used in
many rural housing projects and EWS housing developments.
7. STABILIZED EARTH BLOCK
Earth is one of the oldest and the most abundantly available building material and
there are many examples all over the world which prove the durability of well
constructed earthern buildings. There are many techniques of building with earth
such as making masonry blocks out of earth, or making monolith earth walls by
ramming. Stabilized Compressed Earth Blocks (SCEB), are an improved version of
earth based masonry units. These masonry blocks are made by compressing
100 | P a g e
SAQIB IMRAN 0341-7549889
10
0
earth/ soil by simple mechanical means. Although block production is feasible
using a wide variety of soils, understanding type of soil available for SCEB is one of
the most important aspects – generally sandy clay is the most appropriate. A
small percentage of stabilizer – most commonly 5-7% cement is added to the soil
mix to increase strength of blocks and their resistance to water. Several block
presses, both manual and mechanized types, have been developed by various
institutions and are available to produce blocks of various sizes. The thickness of
walls made with SCEB are generally close to 230mm conventional burnt clay
masonry. The distinct advantage of these blocks are their uniform sizes and good
finish which should be left unplastered externally, provided the building design
takes into account basic features of protection from water. This technology is also
very amenable to local employment generation through a block production
enterprise.
101 | P a g e
SAQIB IMRAN 0341-7549889
10
1
FOUNDATIONS, DAMS AND ART DESIGN
TYPES OF FOUNDATION
Foundation is structural part of a building on which a building stands. Foundation
transmit and distributes it on load or imposed load to the soil in such a way that
the load bearing capacity of the foundation bed is not exceeded. The solid ground
on which the foundation rest is called foundation bed. There are various types of
foundation.
FUNCTIONS OF FOUNDATION
 Distribution of loads
 Stability against sliding and overturning
 Minimize differential settlement
 Safe against undermining
 Provide level surface
 Minimize distress against soil movement
CLASSIFICATION OF FOUNDATIONS
1. Shallow Foundation
2. Deep Foundation
1. SHALLOW FOUNDATION
A shallow foundation is a type of foundation that transfer load to the very near
the surface. Shallow foundation are those foundation in which the depth at which
foundation is placed is less than the width of the of foundation (D<B). This
foundation used when the surface soil are sufficiently strong and stiff to support
the imposed load. They are generally unsuitable in weak and highly compressible
soil. Shallow foundation itself can be various types-
 Pad Footing or Column Footing
102 | P a g e
SAQIB IMRAN 0341-7549889
10
2
1. Isolated Footing
2. Combined Footing
 Cantilever or Strap Footing
 Mat/ Raft Footing
 Wall Footing
2. DEEP FOUNDATION
Deep foundation are those foundations in which the depth of the depth of
foundation is greater than its width (D>B). The D/B ratio is usually 4-5 for deep
foundation. The deep foundation transmits the load of the super structure
vertically to the rock strata lying deep. Deep foundation are used when the
shallow foundation can not support the load of the structure. The deep
foundation can be further classified into following types-
 Pile Foundation
 Pier Foundation
 Well (Caissons) Foundation
TYPES OF SHALLOW FOUNDATION
A shallow foundation is a type of foundation that transfer load to the very near
the surface. Shallow foundation are those foundation in which the depth at which
foundation is placed is less than the width of the foundation (D<B). This
foundation used when the surface soil are sufficiently strong and stiff to support
the imposed load. They are generally unsuitable in weak and highly compressible
soil.
DIFFERENT TYPES OF SHALLOW FOUNDATIONS
1. Isolated footing
2. Combined footing
3. Strap or Cantilever footing
4. Strip footing
5. Mat/ Raft footing
1. ISOLATED FOOTING
103 | P a g e
SAQIB IMRAN 0341-7549889
10
3
Spread footing provided to the column of a framed structure is called isolated
footing, column footing or pad footing. A isolated footing is circular, square or
rectangular slab of uniform thickness. Sometime it is stepped or haunched to
spread the load over a large area. Square column footing are the most economical
but space restriction between adjacent column in a specific direction may warrant
rectangular column footing. Circular footing is not common and may be used for
circular column as the construction of form work and concreting may be more
difficult for them then for square or rectangular footings.
2. COMBINED FOOTING
A combined footing supports two columns. It is used when the two columns are
so closed to each other that their individual footing would overlap. A combined
footing is also provided when the property line is so close to one column that a
spread footing would be eccentrically loaded when kept entirely with in the
property line. By combining it with that of an interior column the load is evenly
distributed. A combined footing may be rectangular or trapezoidal in plan.
3. STRAP OR CANTILEVER FOOTING

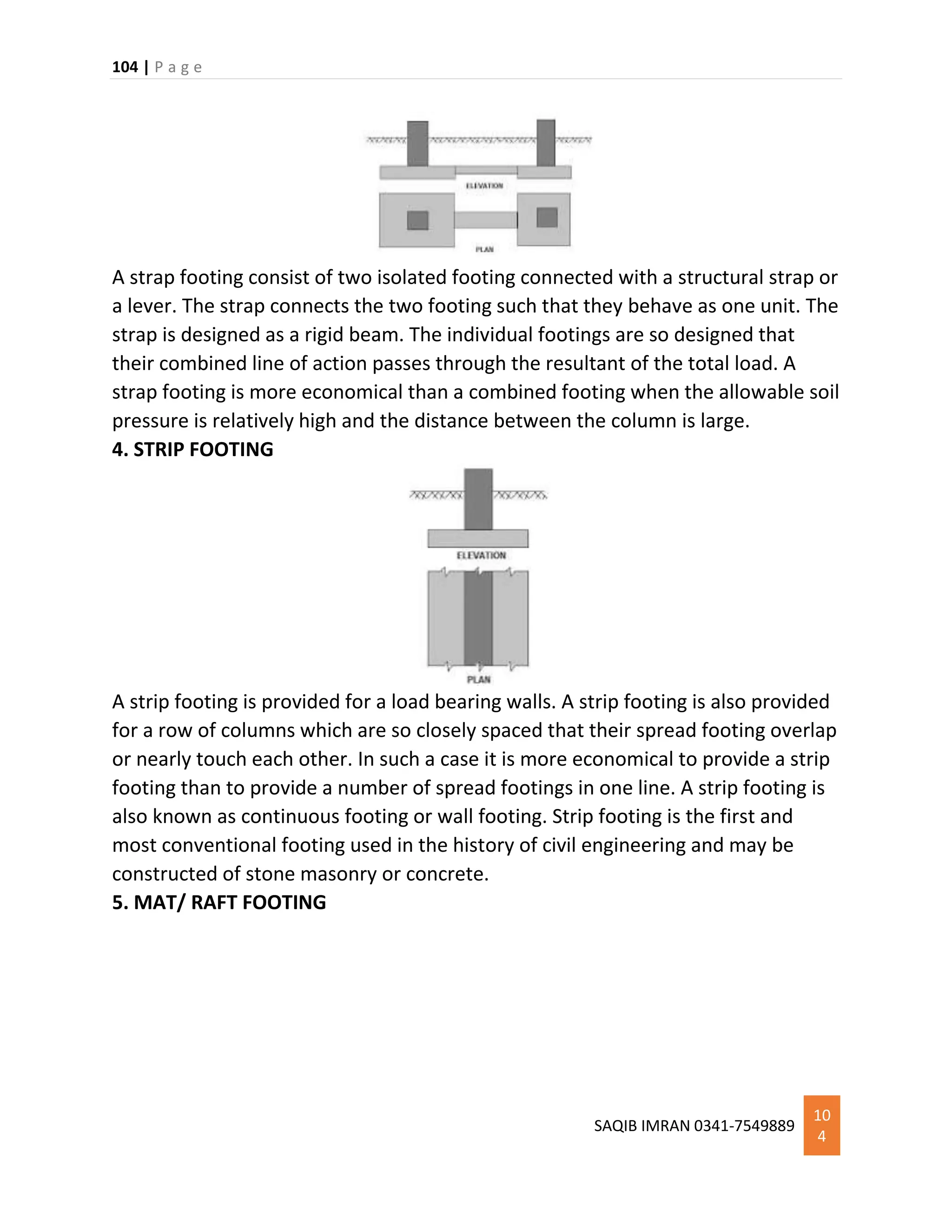

104 | P a g e
SAQIB IMRAN 0341-7549889
10
4
A strap footing consist of two isolated footing connected with a structural strap or
a lever. The strap connects the two footing such that they behave as one unit. The
strap is designed as a rigid beam. The individual footings are so designed that
their combined line of action passes through the resultant of the total load. A
strap footing is more economical than a combined footing when the allowable soil
pressure is relatively high and the distance between the column is large.
4. STRIP FOOTING
A strip footing is provided for a load bearing walls. A strip footing is also provided
for a row of columns which are so closely spaced that their spread footing overlap
or nearly touch each other. In such a case it is more economical to provide a strip
footing than to provide a number of spread footings in one line. A strip footing is
also known as continuous footing or wall footing. Strip footing is the first and
most conventional footing used in the history of civil engineering and may be
constructed of stone masonry or concrete.
5. MAT/ RAFT FOOTING
105 | P a g e
SAQIB IMRAN 0341-7549889
10
5

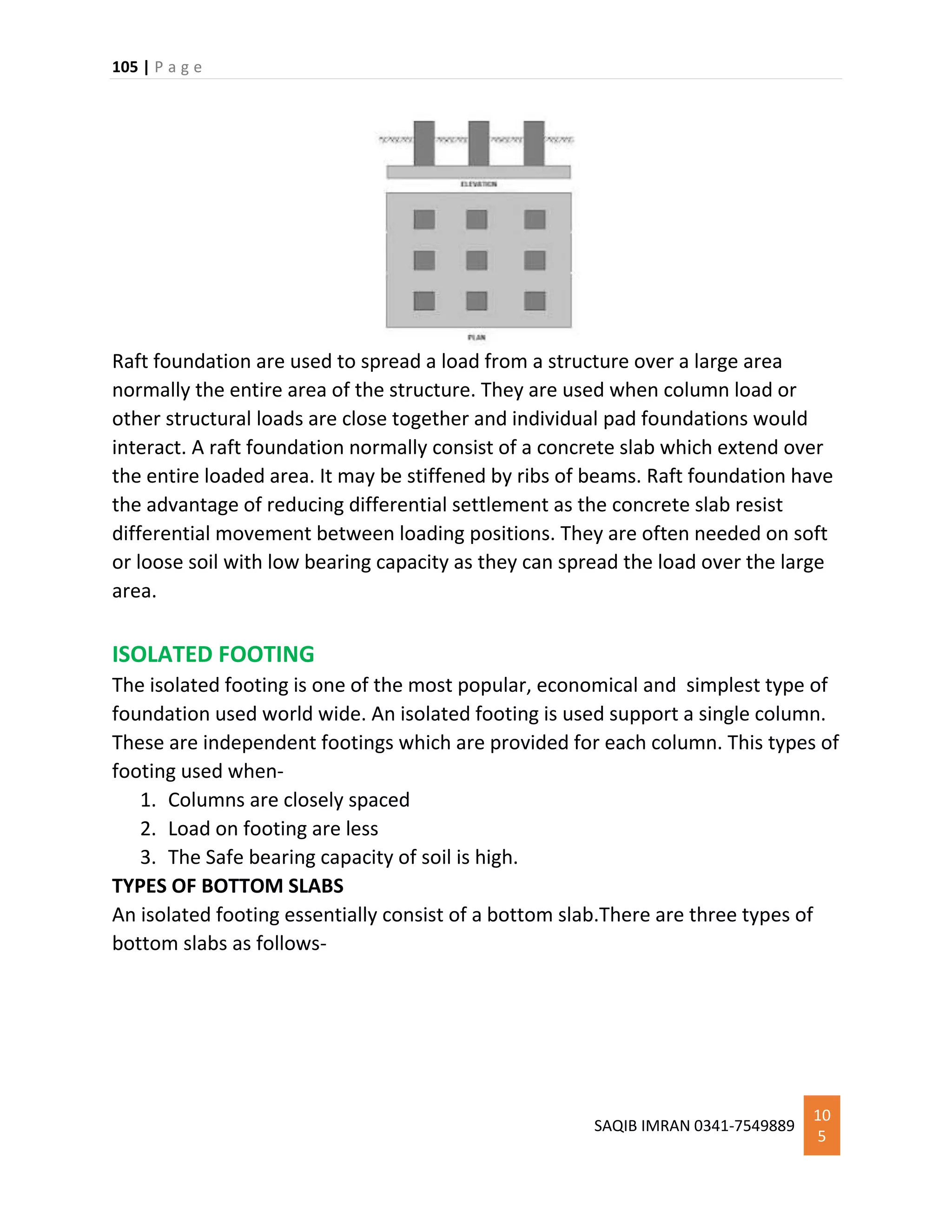

Raft foundation are used to spread a load from a structure over a large area
normally the entire area of the structure. They are used when column load or
other structural loads are close together and individual pad foundations would
interact. A raft foundation normally consist of a concrete slab which extend over
the entire loaded area. It may be stiffened by ribs of beams. Raft foundation have
the advantage of reducing differential settlement as the concrete slab resist
differential movement between loading positions. They are often needed on soft
or loose soil with low bearing capacity as they can spread the load over the large
area.
ISOLATED FOOTING
The isolated footing is one of the most popular, economical and simplest type of
foundation used world wide. An isolated footing is used support a single column.
These are independent footings which are provided for each column. This types of
footing used when-
1. Columns are closely spaced
2. Load on footing are less
3. The Safe bearing capacity of soil is high.
TYPES OF BOTTOM SLABS
An isolated footing essentially consist of a bottom slab.There are three types of
bottom slabs as follows-

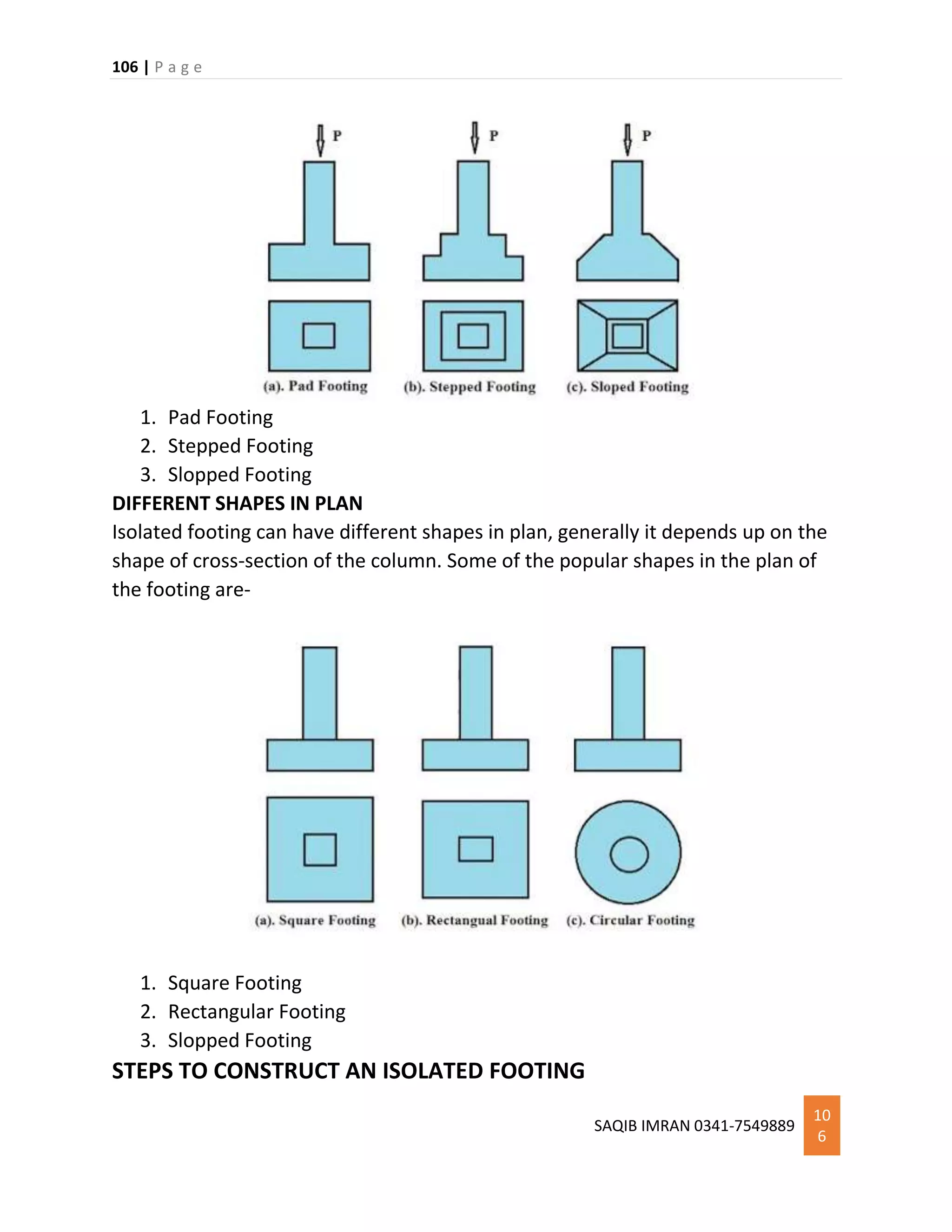

106 | P a g e
SAQIB IMRAN 0341-7549889
10
6
1. Pad Footing
2. Stepped Footing
3. Slopped Footing
DIFFERENT SHAPES IN PLAN
Isolated footing can have different shapes in plan, generally it depends up on the
shape of cross-section of the column. Some of the popular shapes in the plan of
the footing are-
1. Square Footing
2. Rectangular Footing
3. Slopped Footing
STEPS TO CONSTRUCT AN ISOLATED FOOTING
107 | P a g e
SAQIB IMRAN 0341-7549889
10
7
1. Positioning footing location
2. Earth excavation
3. Preparing the base
4. Making form-work
5. Placing reinforcement
6. Proving cover block
7. Placing column reinforcement
8. Pouring concrete
9. Removing form-work
10.Back filling
CLASSIFICATION OF DAM
Dams can be classified in number of ways. But most usual way of classification of
dam are mentioned below-
Based on Structural Behavior-
Gravity Dam- These are the dam which resist the horizontal thrust of water
entirely by their own weight.
Arch Dam- These are designed so that the force of water against it known as
hydro-static pressure presses against the arch compressing and strengthening the
structure as it pushes into its foundation or abutment.
Buttress Dam- A buttress dam or hollow dam is a dam with a solid water tight
upstream side that is supported at intervals on the downstream side by a series of
buttress or support.
Embankment Dam- These are typically created by the placement and compaction
of a complex semi plastic mound of various compositions of soil, sand, clay and
rock
108 | P a g e
SAQIB IMRAN 0341-7549889
10
8
Based on Function of Dam-
Storage Dam- They are constructed to store water during the rainy season when
there is a large flow in the river.
Detention Dam- Detention dam are constructed for flood control. A detention
dam retards the flow in the river on its downstream during floods by storing some
flood water.
Diversion Dam- A diversion is constructed for the purpose of diverting water of
the river in to an off taking canal.
Debris Dam- A debris dam is constructed to retain debris such as sand, gravel and
drift wood flowing tin the river with water.
Coffer Dam- It is an enclosure constructed around the construction site to exclude
water so that the construction can be done in dry.
Based on Material Used-
Rigid Dam- These types of dams are those which are constructed of rigid
materials like masonry, concrete, steel, timber etc.
Masonry Dam- These are made out of masonry mainly stone and brick sometimes
joined with mortar.
Steel Dam- A steel dam consist of a steel frame work with a steel skin plate on its
upstream face.
Timber Dam- Main load carrying structural element of timber dam are made of
wood primarily coniferous varieties such as pine and fir.
Non Rigid Dam- These types of dam are constructed with non rigid material such
as earth, tailings, rockfill, rubber fabric etc.
Rubber Dam- These dams are made by using huge cylindrical that are made of
synthetic rubber. They are inflated using either compressed air and pressurized
water.
Earthen Dam- An earth dam made of earth built up by compacting successive
layer of earth using the most impervious materials to form a core and placing
more permeable substance on the upstream and downstream sides
Rock fill Dam- A Rock fill dam is built of rock fragments and boulders of large size.
An impervious membrane is placed on the rock fill on the upstream side to reduce
the seepage through the dam.
Based on Hydraulic Design-
109 | P a g e
SAQIB IMRAN 0341-7549889
10
9
Over flow Dam- A dam designed for raising the water level of rivers or for
creating a reservoir, it permits the overflow of water during the passage of excess
discharge over the entire length of the dam crest or through drain opening.
Non Over Flow Dam- Non over flow dams are those which are not designed to be
over topped. This type of design giver wider choice of materials including earth fill
and rock fill dam.
DAM AND THEIR BASIC TERMS
DAM
A dam is a barrier that impounds water or under ground stream.
A dam can also be used to collect water or for storage of water which can be
evenly distributed between location.
Dams generally serve the primary purpose of retaining water.
BASIC TERMS OF DAM
 Crest- The top of the dam. These may in some cases be used for providing a
roadway or walkway over the dam.
 Heel- Portion of dam in contact with ground or river bed at upstream side.
 Parapet Wall- Low protective walls on either sides of the roadway and
walkway on the crest.
 Toe- Portion of dam in contact with ground or river bed at downstream
side.
110 | P a g e
SAQIB IMRAN 0341-7549889
11
0

 Spillway- It is the arrangement made near the top of dam for the passage
of surplus/ excessive water from the reservoir.
 Free board- The space between the highest level of water in the reservoir
and the top of the dam.
 Abutment- The valley slops on either sides of the dam wall to which the left
wall & right end of the dam are fixed to.
 Gallery- Level or gently slopping tunnels like passage at transverse or
longitudinal within the dam with drain of floor for seepage water. These
are generally provided for having space for drilling grout holes and drainage
holes. These may also be used to accommodate the instrumentation for
studying the performance of dam.
 Slice Way- Opening in the dam near the base provided to clear the silt
accumulation in the reservoir.
 Core- A zone of material of low permeability in an earth embankment dam,
hence the terms the central core, inclined core, puddle clay core, and rolled
clay core.
 Dead Storage Level- Level of permanent storage below which the water will
not be withdrawn.
 Diversion Tunnel- Tunnel constructed to divert of change the direction of
water to bypass the dam construction sites. The dam is built while the river
flows through the diversion tunnel.
 Base width- The width of dam measured along dam/ foundation interface
 Breach- An opening or a breakthrough of a dam sometimes cause by rapid
erosion of a section of earth embankment by water.
COFFERDAM
111 | P a g e
SAQIB IMRAN 0341-7549889
11
1
Cofferdams are temporary enclosures to keep out water and soil so as to permit
dewatering and construction of the permanent facility in the dry. A cofferdam is a
temporary structure design to keep water and soil out of the excavation in which
a bridge pier or other structure is built. Meaning of coffer Dam: Coffer = Box. To
take up the foundation works in the marine region, it is necessary to obstruct the
water flow by means of cofferdam.
PURPOSE TO USE COFFERDAM STRUCTURE
 To retain soil and water
 Main purpose is to provide dry working area for workers
 It is constructed to facilitate pile driving operation.
 It is used to place grillage as well as raft foundation
 It is used when the foundation for piers and abutments for a bridge, dams,
locks etc are to be constructed.
 Some times it is also provided to store water temporarily
TYPES OF COFFER DAM
Considering the material used in their construction, cofferdam may be divided in
to the following categories-
1. Earthen Cofferdam
2. Rockfill Cofferdam
3. Single Walled Cofferdam
112 | P a g e
SAQIB IMRAN 0341-7549889
11
2
4. Double Walled Cofferdam
5. Braced Cofferdam
6. Cellular Cofferdam
1. Earthen Cofferdam
Earthen cofferdam are constructed at place where the height of water is less say 3
meter and the current velocity is low. These dams are built using the local
available material such as clay, fine sand or even soil. The height of the dam is
kept 1m more than that of maximum water level. Free board of the dam or top of
the dam is kept 1m so that the water does not enter the other side even when
waves arises. The slope usually given but 1:1 or 1:2. The slope of the water side is
pitched with rubble stones so that the water action does not score the
embankment. Even sheet piles are driven in the center of the dam to resist water
seepage. After the construction of earthen cofferdam the water from the other
site is pumped out and construction is executed.
2. Rockfill Cofferdam
Rockfill cofferdam are better than that of earthen cofferdam. These dams are
preferred when the rock is easy available at the construction site. These dams are
very pervious to prevent water from seeping an impervious membrane of soil is
provided in the dam. The height of the dam is can be up to 3m. The slope can be
113 | P a g e
SAQIB IMRAN 0341-7549889
11
3
maintained at 1:1.5 to 1:1.25. The slope on the water is pitched so as to protect
dam from wave action.

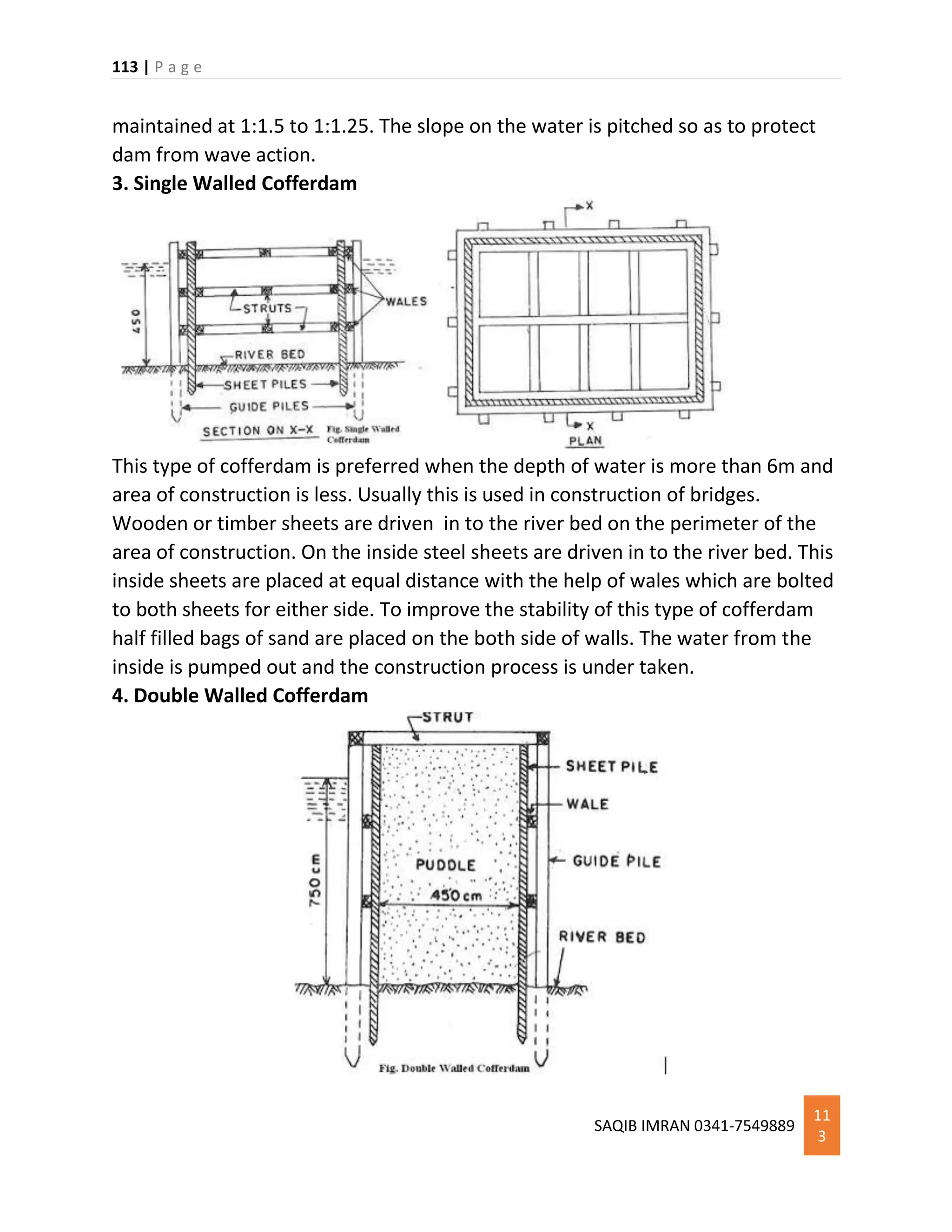

3. Single Walled Cofferdam
This type of cofferdam is preferred when the depth of water is more than 6m and
area of construction is less. Usually this is used in construction of bridges.
Wooden or timber sheets are driven in to the river bed on the perimeter of the
area of construction. On the inside steel sheets are driven in to the river bed. This
inside sheets are placed at equal distance with the help of wales which are bolted
to both sheets for either side. To improve the stability of this type of cofferdam
half filled bags of sand are placed on the both side of walls. The water from the
inside is pumped out and the construction process is under taken.
4. Double Walled Cofferdam
114 | P a g e
SAQIB IMRAN 0341-7549889
11
4
Double walled type of cofferdam are used when the area of construction site is
large and depth of water is high. In this place use of single walled cofferdam
becomes uneconomical as the supports are to be increased. So double walled
cofferdam is used. The difference in one wall and double wall dam is that her it
has two walls instead of walls for extra stability. This types of dams can hold
water up to 12m high. Two piles are driven inside the water bed with a space in
between and attached each other with wales with bolted connection. As the
water depth increases the space between the walls increases. The space between
the walls are filled with soil. To prevent the leakage from the ground below the
sheet piles are driven to a good depth in the bed.
5. Braced Cofferdam
When it is difficult to drive piles inside the bed in the water then this type of
cofferdam is used. In braced cofferdam two piles are driven in to the bed and they
are laterally supported with the help of wooden crib installed in alternate course
to form pockets. The empty pockets here are filled with stone and earth. The
frame work of the cofferdam is prepared on the ground and then floated to the
site where the cofferdam is to be constructed. The layers of sand and the other
loose material overlaying the impervious hard bed is dredged out. Crib is then
sunk to the position the bottom of each crib is given a shape to fit in the variation
in the surface of bed rock. After the pit is dewatered the structure is constructed.
When the concreting has been completed above the water level the cofferdam is
removed.
6. Cellular Cofferdam
115 | P a g e
SAQIB IMRAN 0341-7549889
11
5
When the water layer is more than the 20m common types of cofferdam are
uneconomical to use. In this situation cellular cofferdam are used. This type of
dam is used in construction of dams, locks, weirs etc. Cellular cofferdam is made
by driving straight web steel pile arranged to form a series of interconnected cells.
The cells are constructed in various shapes and style to suit the requirement of
site. Finally the cells are filled with clay, sand or gravels to make them stable
against the various forces to which they are likely to be subjected to. The two
common shapes of cellular cofferdam are-
a) Circular Type Cellular Cofferdam
b) Diaphragm Type Cellular Cofferdam
(a). Circular Type Cellular Cofferdam
This type of cellular cofferdam consist of circular arcs on the inner and outer sides
which are connected by straight diaphragm walls. The connection between the
curved part and the diaphragm are made by means of a specially fabricated Y-
element. The cofferdam is thus made from interconnected steel sheet piles. The
empty space are filled with non pervious material like clay or sand. Due to the
filling material the self weight of the membrane increases and leakage is reduced.
One advantage of diaphragm type is that the effective length of the cofferdam
may be increased easily by lenthening the diaphragm. Hence in case from design
consideration it is necessary to have effective width of the cofferdam more than
21m diaphragm type cofferdam must be used.

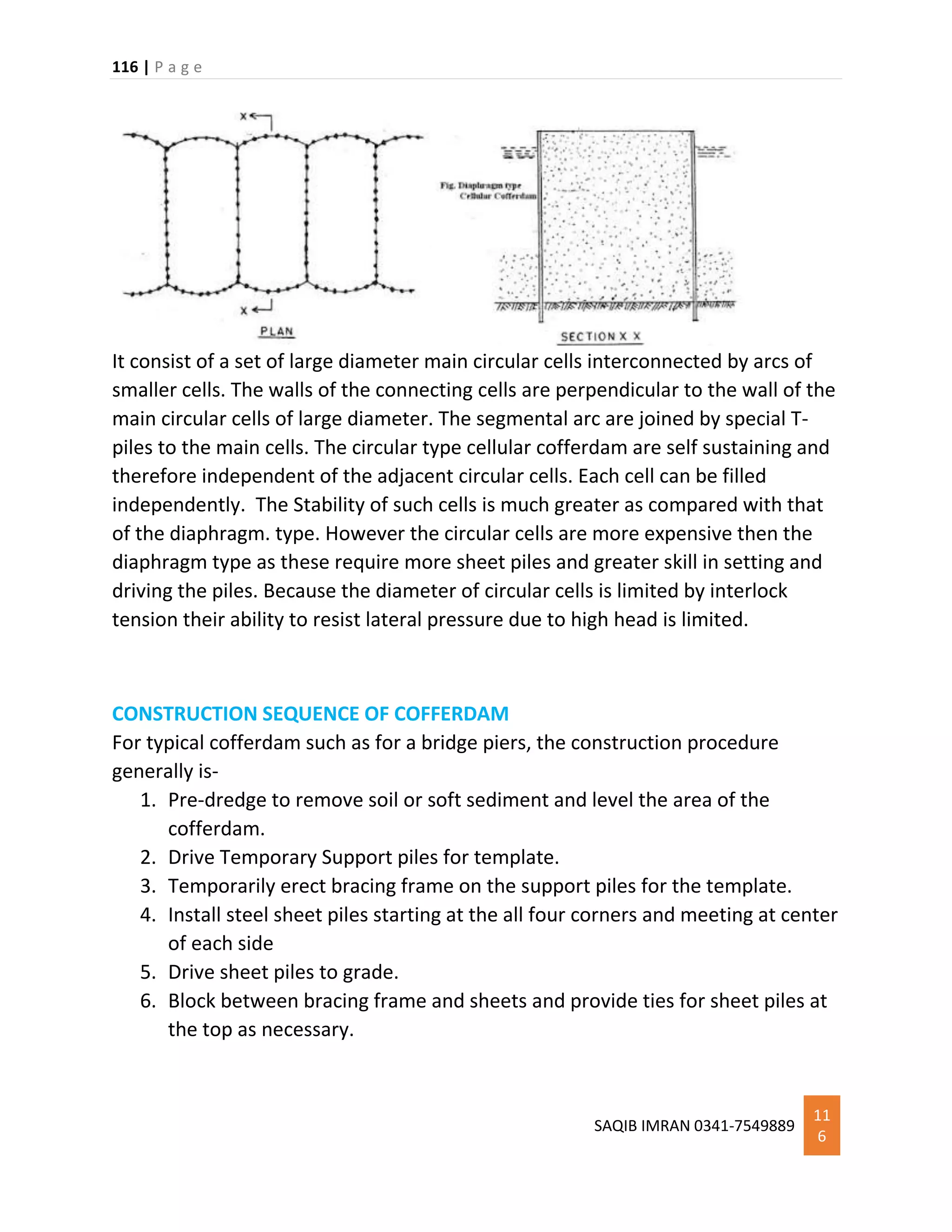

(b). Diaphragm Type Cellular Cofferdam
116 | P a g e
SAQIB IMRAN 0341-7549889
11
6
It consist of a set of large diameter main circular cells interconnected by arcs of
smaller cells. The walls of the connecting cells are perpendicular to the wall of the
main circular cells of large diameter. The segmental arc are joined by special T-
piles to the main cells. The circular type cellular cofferdam are self sustaining and
therefore independent of the adjacent circular cells. Each cell can be filled
independently. The Stability of such cells is much greater as compared with that
of the diaphragm. type. However the circular cells are more expensive then the
diaphragm type as these require more sheet piles and greater skill in setting and
driving the piles. Because the diameter of circular cells is limited by interlock
tension their ability to resist lateral pressure due to high head is limited.
CONSTRUCTION SEQUENCE OF COFFERDAM
For typical cofferdam such as for a bridge piers, the construction procedure
generally is-
1. Pre-dredge to remove soil or soft sediment and level the area of the
cofferdam.
2. Drive Temporary Support piles for template.
3. Temporarily erect bracing frame on the support piles for the template.
4. Install steel sheet piles starting at the all four corners and meeting at center
of each side
5. Drive sheet piles to grade.
6. Block between bracing frame and sheets and provide ties for sheet piles at
the top as necessary.
117 | P a g e
SAQIB IMRAN 0341-7549889
11
7
7. Excavate inside the grade or slightly below grade while leaving the
cofferdam full of water, Then lower the water inside and progressively
install internal bracing as required by the design.
8. Derive piles with in the cofferdam if required.
9. Place rockfill as a leveling and support course.
10.Place tremie concrete seal.
HOME DESIGNS 1
1-
2-
118 | P a g e
SAQIB IMRAN 0341-7549889
11
8
3-
HOME DESIGNS 2
1.
119 | P a g e
SAQIB IMRAN 0341-7549889
11
9
2.
3.
120 | P a g e
SAQIB IMRAN 0341-7549889
12
0
PLAN 30*60
121 | P a g e
SAQIB IMRAN 0341-7549889
12
1
122 | P a g e
SAQIB IMRAN 0341-7549889
12
2
SPECIFICATIONS-
Plot Size- 30×60ft
Bedroom- 3
Toilet- 3 ( 2 Attached 1 Common )
Hall- 1
Kitechen- 1
Garden Area
Garage
Dining cum Living Area
East Facing
123 | P a g e
SAQIB IMRAN 0341-7549889
12
3
IS CODES
I.S. CODES FOR IMPORTANT ENGINEERING MATERIALS PART-A
AGGREGATES:
CODE NO. DESCRIPTIONS
IS: 383-1970 Specification for coarse and fine
aggregates from natural sources of
concrete
IS: 650-1966 Specification for standards of sand for
testing of cement
IS: 2386-1963 (Part
1)
Methods of test for aggregates of
concrete
IS: 2386-1963 (Part
2)
Estimation of deleterious materials and
organic impurities
BUILDING STONES:
CODE NO. DESCRIPTIONS
IS: 1121-1974 (Part
1)
Methods of test determination of
strength properties of natural building
stones – Part-I Compressive Strength
IS: 1121-1974 (Part
2)
Methods of test determination of
strength properties of natural building
stones – Part-II Transverse Strength
IS: 1121-1974 (Part
3)
Methods of test determination of
strength properties of natural building
stones – Part-III Tensile Strength
IS: 1121-1974 (Part
4)
Methods of test determination of
strength properties of natural building
stones – Part-IV Shear Strength
IS: 1122-1974 Methods of test determination of true
specific gravity of natural building
stones
124 | P a g e
SAQIB IMRAN 0341-7549889
12
4
IS: 1123-1975 Method of identification of natural
building stones
IS: 1124-1974 Methods of test determination of water
absorption, apparent specific gravity
and porosity of natural building stones
IS: 1125-1974 Methods of test determination of
weathering of natural building stones
IS: 1126-1974 Method of test for durability of natural
building stones
IS: 1128-1974 Specifications for lime stone slabs
IS: 1130-1969 Specifications for marbles (blocks,
slabs, and tiles)
BRICKS, TILES AND OTHER CLAY MATERIALS:
CODE NO. DESCRIPTIONS
IS: 654-1972 Mangalore pattern clay roofing tiles
IS: 777-1961 Specification for glazed earthenware
tiles
IS: 1077-1976 Specification for common burnt clay
building bricks
IS: 1237-2006 Cement concrete flooring tiles
IS: 1464-1969 Specification for ridge and ceiling tiles
IS: 2117-1975 Guide for manufacture of handmade
common building bricks
IS: 2180-1970 Specification for heavy duty brunt clay
building bricks
IS: 2222-1970 Specification for brunt clay perforated
building bricks
IS: 2690-1975 (Part
1)
Specification for brunt clay flat
terracing bricks
IS: 2690-1972 Specification for brunt clay facing tiles
IS: 3102-1971 Specification for burnt clay solid bricks
125 | P a g e
SAQIB IMRAN 0341-7549889
12
5
IS: 3367-1975 Specification for burnt clay bricks for
use in lining irrigation and drainage
works
IS: 3461-1966 PVC (vinyl) asbestos floor tiles
IS: 3496-1976 Method of tests for burnt, clay building
tiles
IS: 3583-1976 Specification for paving bricks
IS: 3951-1975 Specification for hollow clay tiles for
floor and roofs
IS: 3952-1978 Specification for burnt clay hollow
blocks for walls and partitions
IS: 3978-1967 Code for practice for manufacture of
brunt clay mangalore pattern roof tiles
IS: 4139-1989 Specification for sand lime bricks
IS: 4805-1978 Guide for construction of bricks kilns
IS: 4885-1968 Specification for sewer bricks
IS: 5454-1978 Methods of sampling of clay building
IS: 5779-1970 Bricks burnt clay soiling bricks
IS: 6165-1971 Dimensions for special shapes of clay
bricks
REINFORCEMENT AND STRUCTURAL STEEL:
CODE NO. DESCRIPTIONS
IS: 432-1966 (Part 1) Specification for mild steel and medium
tensile bars
IS: 1566-1966 Specification for hard brawn steel wire
fabric for concrete reinforcement
IS: 1786-2008 High strength deformed steel bars and
wires for concrete reinforcement
IS: 226-1969 Specification for structural steel
IS: 808-1964 Specification for rolled steel beam,
channel and angle sections
126 | P a g e
SAQIB IMRAN 0341-7549889
12
6
IS: 811-1965 Specification for cold formed light
gauge structural steel sections
ASPHALT, TAR AND BITUMEN:
CODE NO. DESCRIPTIONS
IS: 73-1961 Paving Bitumens
IS: 217-1961 Cutback Bitumens
IS: 334-1965 Glossary of term relating to bitumens
and tar
IS: 3117-1965 Bitumens emulsion for road (Anionic
type)
IS: 8887-1978 Bitumens emulsion for roads (Cationic
type)
IS: 424-1965 Plastic asphalt
IS: 215-1961 Road tar
PAINTS AND VARNISHES:
CODE NO. DESCRIPTIONS
IS: 427-1965 Specification for distemper, dry, colour
as required
IS: 428-1953 Specification for distemper, oil
emulsion, colour as required
IS: 5410-1969 Specifications for cement paint, colour
as required
IS: 101-1964 Method of test for ready mixed paints
and enamels
IS: 102-1962 Specifications for ready mixed paint
brushing, red lead, non setting, priming
IS: 103-1962 Specifications for ready mixed paint,
brushing, white led for priming for use
on aluminum and light alloys
IS: 104-1962 Specifications for ready mixed paint,
brushing, zinc chrome, priming for use
on aluminum and light alloys
127 | P a g e
SAQIB IMRAN 0341-7549889
12
7
IS: 106-1962 Specification for ready mixed paint,
brushing, priming for enamels for use
on wood
IS: 155-1950 Specification for ready mixed paint,
brushing matt black for use on wood
IS: 156-1950 Specification for ready mixed paint,
brushing for use on floor, colours as
required
IS: 158-1968 Specification for ready mixed paint, IS
brushing, bituminous, black, lead free,
acid, alkali, water and heat resisting,
for general purposes
IS: 162-1950 Specification for ready mixed paint, IS
brushing, fire resisting, silicates types
for use on wood, colour as required
IS: 290-1961 Specification for coal tar black paint
IS: 1477-1971 (Part
1&2)
Painting of ferrous metals in buildings
IS: 2524-1968 (Part
1&2)
Painting of non-ferrous metals in
buildings
128 | P a g e
SAQIB IMRAN 0341-7549889
12
8
CEMENT AND CONCRETE:
CODE NO. DESCRIPTIONS
IS: 269-1989 Specification for ordinary portland
cement, 33 grade
IS: 383-1970 Specification for coarse and fine
aggregates from natural sources for
concrete
IS: 455-1989 Specification for portland slag cement
IS: 456-2000 Code of practice for plain and
reinforced concrete
IS: 457-1957 Code of practice for general
construction of plain and reinforced
concrete for dams and other massive
structures
IS: 516-1959 Method of test for strength of concrete
IS: 650-1991 Specification for standard sand for
testing of cement
IS: 1199-1959 Methods of sampling and analysis of
concrete
IS: 1343-1980 Code of practice for prestressed
concrete
IS: 1344-1981 Specification for calcined clay
pozzolana
IS: 1489-1991 (Part
1)
Specification for portland pozzolana
cement- Fly ash based
129 | P a g e
SAQIB IMRAN 0341-7549889
12
9
IS: 1489-1991 (Part
2)
Specification for portland pozzolana
cement- Calcined clay based
IS: 1727-1967 Methods of test for pozzolanic materials
IS: 2430-1986 Methods for sampling of aggregates for
concrete
IS: 2502-1963 Code of practice for bending and fixing
of bars for concrete reinforcement
IS: 2645-003 Integral waterproofing compound for
cement mortar and concrete-
specification
IS: 2770-1967 (Part
1)
Methods of testing bond in reinforced
concrete- Pull-out test
IS: 3085-1965 Methods of test for permeability of
cement mortar and concrete
IS: 3370 Code of Practice for concrete
structures for storage of liquids
IS: 3370-2009 (Part
1)
General requirements
IS: 3370-2009 (Part
2)
Reinforced concrete structures
IS: 3370-1967 (Part
3)
Prestressed concrete
IS: 3370-1967 (Part
4)
Design tables
IS: 3466-1988 Specification for masonry cement
IS: 3535-1986 Methods of sampling hydraulic cement
IS: 3558-1983 Code of practice for use of immersion
vibrators
IS: 3812-2003 Specification for pulverized fuel ash
IS: 3812-2003 (Part
1)
For use as pozzolana in cement, cement
mortar and concrete
IS: 3812-2003 (Part
2)
For use as admixture in cement mortar
and concrete
130 | P a g e
SAQIB IMRAN 0341-7549889
13
0
IS: 4031 Methods of physical tests for
hydraulic cement
IS: 4031-1996 (Part
1)
Determination of fineness by dry
sieving
IS: 4031-1999 (Part
2)
Determination of fineness by specific
surface by Blaine air permeability
method
IS: 4031-1988 (Part
3)
Determination of soundness
IS: 4031-1988 (Part
4)
Determination of consistency of
standard cement paste
IS: 4031-1988 (Part
5)
Determination of initial and final setting
times
IS: 4031-1988 (Part
6)
Determination of compressive strength
of hydraulic cement (other than
masonry cement )
IS: 4031-1988 (Part
7)
Determination of compressive strength
of masonry cement
IS: 4031-1988 (Part
8)
Determination of transverse and
compressive strength of plastic mortar
using prism
IS: 4031-1988 (Part
9)
Determination of heat of hydration
IS: 4031-1988 (Part
10)
Determination of drying shrinkage
IS: 4031-1988 (Part
11)
Determination of density
IS: 4031-1988 (Part
12)
Determination of air content of
hydraulic cement mortar
IS: 4031-1988 (Part
13)
Measurement of water retentivity of
masonry cement
IS: 4031-1989 (Part
14)
Determination of false set
131 | P a g e
SAQIB IMRAN 0341-7549889
13
1
IS: 4031-1991 (Part
15)
Determination of fineness by wet
sieving
IS: 4032-1985 Method of chemical analysis of
hydraulic cement
IS: 4305-1967 Glossary of terms relating to pozzolana
IS: 4634-1991 Methods for testing performance of
batch type concrete mixers
IS: 4845-1968 Definitions and terminology relating to
hydraulic
IS: 4926-2003 Ready mix concrete- Code of practice
IS: 5512-1983 Specification for flow table for use in
test of hydraulic cement and pozzolanic
materials
IS: 5513-1996 Specification for vicat apparatus
IS: 5514-1996 Specification for apparatus used in Le-
Chatelier test
IS: 5515-1983 Specification for compaction factors
apparatus
IS: 5516-1996 Specification for variable flow type air
permeability apparatus (Blaine type )
IS: 5525-1969 Recommendation for detailing of
reinforcement in reinforced concrete
works
IS: 5536-1969 Specification for constant flow type air
permeability apparatus (Lea and Nurse
type)
IS: 5816-1999 Method of test for splitting tensile
strength of concrete
IS: 6452-1989 Specification for high alumina cement
for structural use
IS: 6461 Glossary of terms relating to cement
concrete
132 | P a g e
SAQIB IMRAN 0341-7549889
13
2
IS: 6461-1972 (Part
1)
Concrete aggregates
IS: 6461-1972 (Part
2)
Materials (other than cement and
aggregates)
IS: 6461-1972 (Part
3)
Concrete reinforcement
IS: 6461-1972 (Part
4)
Types of concrete
IS: 6461-1972 (Part
5)
Formwork for concrete
IS: 6461-1972 (Part
6)
Equipment, tool and plant
IS: 6461-1973 (Part
7)
Mixing, laying, compacting, curing, and
other constructions aspects
IS: 6461-1973 (Part
8)
Properties of concrete
IS: 6461-1972 (Part
9)
Structural aspects
IS: 6461-1973 (Part
10)
Test and testing apparatus
IS: 6461-1973 (Part
11)
Prestressed concrete
IS: 6461-1973 (Part
12)
Miscellaneous
IS: 6491-1973 Method of sampling fly ash
IS: 6909-1990 Specification for super sulphate cement
IS: 6925-1973 Methods of test for determination of
water soluble chloride in concrete
admixtures
IS: 7246-1974 Recommendations for use of table
vibrators for consolidating concrete
IS: 7320-1974 Specifications for concrete slump test
apparatus
133 | P a g e
SAQIB IMRAN 0341-7549889
13
3
IS: 7325-1974 Specifications for apparatus for
determining constituents of fresh
concrete
IS: 7861 Code of practice for extreme weather
concreting
IS: 7861-1975 (Part
1)
Recommended practice for hot weather
IS: 7861-1981 (Part
2)
Recommended practice for cold
weather concreting
IS: 8041-1990 Specification for rapid hardening
portland cement
IS: 8042-1989 Specification for white portland cement
IS: 8043-1991 Specification for hydrophobic portland
cement
IS: 8112-1989 Specification for 43 grade ordinary
cement
IS: 8125-1976 Dimensions and materials of cement
rotary kilns, compositions and
auxiliaries
IS: 8142-1976 Method to test for determining setting
time of concrete by penetration
resistance
IS: 8229-1986 Specification for oil well cement
IS: 8425-1977 Determination of specific surface area
of powders by air permeability
IS: 9012-1978 Recommended practice for shotcreting
IS: 9013-1978 Method of making, curing and
determining compressive strength of
accelerated cured concrete test
specimens
IS: 9103-1999 Specification for admixture for concrete
IS: 9142-1979 Specification for artificial light weight
aggregate for concrete masonry units
134 | P a g e
SAQIB IMRAN 0341-7549889
13
4
IS: 9284-1979 Method of test for abrasion resistance of
concrete
IS: 9376-1979 Specification for apparatus for
measuring aggregate crushing value and
10% fines
IS: 9377-1979 Specification for apparatus for
aggregate impact
IS: 9399-1979 Specification for apparatus for flexural
testing of concrete
IS: 9459-1980 Specification for apparatus for use in
measurement of length change of
hardened cement paste, mortar and
concrete
IS: 9799-1981 Specification for pressure meter for
determination of air content of freshly
mixed concrete
IS: 10070-1982 Specification for machine for abrasion
testing of coarse aggregates
IS: 10078-1982 Specification for jolting apparatus for
testing
IS: 10079-1982 Specification for cylindrical metal
measures for use in test of aggregates
and concrete
IS: 10080-1982 Specification for vibration machine for
casting- standard cement mortar cubes
IS: 10086-1982 Specification for mould for use in test of
cement and concrete
IS: 10262-2009 Guideline for concrete mix
proportioning
IS: 10510-1983 Specification for vee-bee consistometer
IS: 10850-1984 Specification for apparatus for
measurement of water retentivity of
masonry cement
135 | P a g e
SAQIB IMRAN 0341-7549889
13
5
IS: 10890-1984 Specification for planetary mixer used
in test for cement and pozzolana
IS: 11262-1985 Specification for calorimeter for
determination of heat of hydration of
hydraulic cement
IS: 11263-1985 Specification for cylinder measure for
determination of air content of
hydraulic cement
IS: 11578-1986 Method for determination of specific
surface area of powder and porous
particle using low temperature gas
absorption techniques
IS: 11993-1987 Code of practice for use of screed board
concrete vibrators
IS: 12089-1987 Specification for graduated slag for
manufacture pf portland slag cement
IS: 12119-1987 General requirement for pan mixers for
concrete
IS: 12269-1987 Specification for 53 grade ordinary
portland
IS: 12303-1987 Criteria for design of RCC hinges Dec
IS: 12330-1988 Specification for sulphate resisting
portland
IS: 12423-1988 Method for colorimetric analysis of
hydraulic
IS: 12600-1989 Specification for low heat portland
cement
IS: 12803-1989 Methods of analysis of hydraulic
cement by x-ray fluorescence
spectrometer
IS: 12813-1989 Method of analysis of hydraulic cement
by atomic absorption spectrometer
136 | P a g e
SAQIB IMRAN 0341-7549889
13
6
IS: 12870-1989 Methods of sampling calcined clay
pozzolana
IS: 13311-1992 (Part
1)
Methods of non destructive testing of
concrete- Ultrasonic pulse velocity
IS: 13311-1992 (Part
2)
Method of non destructive testing of
concrete- Rebound hammer
IS: 14345-1996 Specification for autoclave apparatus
IS: 14687-1999 Guideline for false work for concrete
structures
IS: 14858-2000 Requirements for compression testing
machine used for testing of concrete and
mortar
IS: 14959 Methods of test for determination of
water soluble and acid soluble
chlorides
IS: 14959-2001 (Part
1)
In fresh mortar and concrete
IS: 14959-2001 (Part
2)
In hardened mortar and concrete
IS: 15388-2003 Silica fume- Specification
SP:16-1980 Design aids for reinforced concrete to IS
456-1978
SP: 23-1982 Handbook on concrete mixes
SP: 24-1983 Explanatory handbook on IS code of
practice for plan and reinforced
concrete
SP: 34-1987 Handbook on concrete reinforcement
and detailing
I.S. CODES FOR IMPORTANT ENGINEERING MATERIALS PART- B
GLASS
CODE NO. DESCRIPTIONS
137 | P a g e
SAQIB IMRAN 0341-7549889
13
7
IS: 1761-1960 Specification for transparent sheet for
glazing and framing purpose
IS: 2553-1964 Specification for safety glass
IS: 2853-1965 Specification for transparent glass
IS: 5437-1969 Specification for wired and figured
glass
HARDWARE
CODE NO. DESCRIPTIONS
IS: 362-1968 Specification for parliament hinges
IS: 729-1963 Specification for drawer locks,
cupboard locks and box locks
IS: 2209-1966 Specification for mortice locks
IS: 3564-1966 Specification for door closer
IS: 3847-1966 Specification for mortice night latches
THINNER AND SOLVENT
CODE NO. DESCRIPTIONS
IS: 82-1950 Methods for test for thinners and solvent
for paints
WATER SUPPLY AND SANITARY APPLIANCES AND
FITTINGS
CODE NO. DESCRIPTIONS
IS: 771-1963 Specification for glazed earthenware
sanitary appliances
IS: 772-1962 Specification for general requirement of
enameled cast iron sanitary appliances
IS: 1726-1967 Specification for cast iron manhole
covers and frames intended for use in
drainage works
IS: 2556-1967 (Part
6)
Specific requirement of urinals
138 | P a g e
SAQIB IMRAN 0341-7549889
13
8
IS: 2692-1964 Specification for sluices valves (350 to
1200 mm size) for water works
purposes
IS: 2906-1984 Sluice valves for water works purpose
IS: 651-2007 Specification for glazed stoneware pipe
and fittings
IS: 771 Specification for glazed fire clay
sanitary appliances
IS: 771-1979 (Part 1) General requirement
IS: 771-1985 (Part 2) Specific requirement of kitchen and
laboratory sink
IS: 771-1979 (Part
3/sec 1)
Specific requirement of urinal- section 1
slab urinals
IS: 771-1985 (Part
3/sec 2)
Specific requirement of urinals- section
2 stall urinals
IS: 771-1979 (Part 4) Specific requirement of postmortem
slabs
IS: 771-1979 (Part 5) Specific requirement of shower trays
IS: 771-1979 (Part 6) Specific requirement of bedpan sinks
IS: 771-1981 (Part 7) Specific requirement of slop sinks
IS: 772-1973 Specification for general requirement
for enameled CI sanitary appliances
IS: 774-2004 Specification for flushing cistern for
water closet and urinals
IS: 778-1984 Specification for copper alloy gate,
globe and check valves for water works
purpose
IS: 779-1994 Specification for water meters
IS: 781-1984 Specification for cast copper alloy
screw down bib taps and stop valves for
water services
IS: 782-1978 Specification for caulking lead
139 | P a g e
SAQIB IMRAN 0341-7549889
13
9
IS: 1701-1960 Specification for mixing valves for
ablutionary and domestic purpose
IS: 1703-2000 Water fittings- copper alloy float valves
specification
IS: 1711-1984 Specification for self closing taps for
water supply purpose
IS: 1726-1991 Specification for cast iron manhole
covers and frames
IS: 1795-1982 Specification for pillar taps for water
supply purpose
IS: 2326-1987 Specification for automatic flushing
cistern for urinals
IS: 2373-1981 Specification for water meters
IS: 2548-1996 Specification for plastic seats and cover
for water closets
IS: 2548-1996 (Part
1)
Thermoset seat and covers
IS: 2548- 1996 (Part
2)
Thermo plastics seats and covers
IS: 2556 Specification for vitreous sanitary
appliances
IS:2256-1994 (Part 1) General requirements
IS: 2256-2004 (Part
2)
Specific requirement of wash down
water closet
IS: 2256-2004 (Part
3)
Specific requirement of squatting pans
IS: 2256-2004 (Part
4)
Specific requirement of wash basins
IS: 2256-1994 (Part
5)
Specific requirement of laboratory sinks
IS: 2256-1995 (Part
6)
Specific requirement of urinals and
partition plates
140 | P a g e
SAQIB IMRAN 0341-7549889
14
0
IS: 2256-1995 (Part
7)
Specific requirement of accessories for
sanitary appliances
IS: 2256-2004 (Part
8)
Specific requirement of pedestal close
coupled wash down and siphonic water
closet
IS: 2256-2004 (Part
9)
Specific requirement of pedestal type
bidets
IS: 2256-1995 (Part
14)
Specific requirement of integrated
squatting pans
IS: 2256-2004 (Part
15)
Specific requirement of universal water
closet
IS: 2256-2002 (Part
16)
Specific requirement of wash down wall
mounted water closets
IS: 2256-2001 (Part
17)
Specific requirement of wall mounted
bidets
IS: 2685-1971 Code of practice for selection,
installation and maintenance of sluice
valves
IS: 2692-1989 Specification for ferrules for water
services
IS: 2963-1979 Specification for copper alloy waste
fitting for wash basin and sinks
IS: 3004-1979 Specification for plug cock for water
supply purposes
IS: 3006-1979 Specification for chemically resistant
glazed stoneware pipes and fittings
IS: 3042-1965 Specification for single faced sluices
gate (200 to 1200 mm size)
IS: 3311-1979 Specification for waste plug and its
accessories for sink and wash basins
IS: 3950-1979 Specification for surface box for sluices
valves
141 | P a g e
SAQIB IMRAN 0341-7549889
14
1
IS: 4038-1986 Specification for foot valves for water
works purposes
IS: 4346-1982 Specification for washer for uses with
fittings for water services
IS: 5219-1969 (Part
1)
Specification for cast copper alloys
traps: Part 1 P and S traps
IS: 5312 Specification for swing check types
reflux (non-return) valves
IS: 5312-2004 (Part
1)
Single door pattern
IS: 5312-1986 (Part
2)
Multi door pattern
IS: 5455-1969 Specification for cast iron steps for
drainage purpose
IS: 5961-1970 Specification for cast iron grating for
drainage purpose
IS: 6411-1985 Specification for gel coated glass fiber
reinforced polyester resin bath tubs
IS: 6784-1996 Methods for performance testing of
water meters domestic types
IS: 7231-1994 Specification for plastic flushing
cisterns for water closets and urinals
IS: 8931-1993 Specification for copper alloy fancy
single taps, combinations tap assembly
and top valves for water services
IS: 9140-1996 Method of sampling of vitreous and fire
clay sanitary appliances
IS: 9338-1984 Specification for cast iron screw down
stop valves and stop and check valves
for water works purpose
IS: 9739-1981 Specification for pressure reducing
valves for domestic water supply
systems
142 | P a g e
SAQIB IMRAN 0341-7549889
14
2
IS: 9758-1981 Specification for flush valves and
fittings for water closet and urinals
IS: 9762-1994 Specification for polyethylene floats for
float valves
IS: 9763-2000 Plastic bib taps, pillar taps, angle valves
and stop valves for hot and cold water
services – specification
IS: 11246-1992 Specification for glass fibre reinforced
polyester resin GRP squatting pans
IS: 12234-1998 Specification for plastic equilibrium
float valve for cold water services
IS: 12701-1996 Specification for rotational moulded
polyethylene water storage tank
IS: 13049-1991 Specification for diaphragm type float
operated valves for cold water services
IS: 13114-1991 Specification for forged brass gate,
globe and check valves for water works
IS: 13349-1992 Specification for single faced cast iron
thimble mounted sluice gate
IS: 13983-1994 Specification for stainless steel sinks for
domestic purposes
IS: 14399 Hot press moulded thermosetting
glass fibre reinforced polyester resin
GRP sectional water storage tanks
IS: 14399-1996 (Part
1)
Specification for panels
IS: 14399-1996 (Part
2)
Guideline for assembly and installation
IS: 14845-2000 Resilient seated cast iron air relief
valves for water works purposes-
Specification
IS: 14846-2000 Sluice valves for water works purposes
(50-1200 mm)- Specification
143 | P a g e
SAQIB IMRAN 0341-7549889
14
3
INSULATING MATERIALS
CODE NO. DESCRIPTIONS
IS: 3792-1978 Guide for heat insulation of non
industrial buildings
IS: 1950-1162 Code of practice for sound insulation of
non- industrial buildings
PIPES , STEEL SECTIONS ETC.
CODE NO. DESCRIPTIONS
IS: 458-2003 Specification for concrete pipes
IS: 783-1985 Laying of concrete pipes
IS: 1230-1979 Cast iron rain water pipes and fitting
IS: 1173-1978 Hot rolled and slit steel tee bars
IS: 1536-1976 Centrifugally cast iron pressure pipes
for water, gas and sewage
IS: 1592-1978 Specification for asbestos cement
pressure pipes
IS: 1730 Dimensions for steel plates (Part 1, 2 &
3) sheets and strips for structural and
general engineering purposes
IS: 1926-1960 Specification for asbestos cement
building pipes, gutters and fitting
SHEETS, LIGHT METALS AND THEIR ALLOYS
CODE NO. DESCRIPTIONS
IS: 277-1969 Specification for galvanized steel sheets
IS: 737-1965 Specification for wrought aluminum
alloys, sheet and strip for general
engineering purpose
IS: 1161-1968 Specification for steel tubes for
structural purpose
IS: 1239 Specification for mild steel tubes,
tubular and other wrought steel fittings
144 | P a g e
SAQIB IMRAN 0341-7549889
14
4
IS: 1254-1965 Specification for corrugated aluminum
sheets
IS: 4270-1967 Specification for steel tubes for water
well
IS: 4923-1968 Specification for hollow mild steel
section for structural use
WIRE ROPES AND WIRE PRODUCTS
CODE NO. DESCRIPTIONS
IS: 278-1964 Specifications for galvanized steel
barbed wire for fencing
IS: 2266-1963 Specifications for steel wire ropes for
general engineering purposes
IS: 2365-1963 Specifications for steel wire suspension
ropes for lifts and hoists
VARNISH AND LACQUERS
CODE NO. DESCRIPTIONS
IS: 197-1952 Specifications for varnish and lacquers
IS: 340-1952 Specifications for varnish, mixing
IS: 347-1952 Specifications for varnish, shellac for
general purpose
IS: 348-1968 Specifications for French polish
IS: 642-1963 Specifications for varnish medium for
aluminium paints
WOODEN AND METAL DOORS-WINDOWS,
TIMBER AND WOOD PRODUCTS
CODE NO. DESCRIPTIONS
(a)Timber:
IS: 287-1973 Recommendation for maximum
permissible moisture content of timber
used for different purpose
IS: 399-1963 Classification of commercial timber and
their zonal distribution
145 | P a g e
SAQIB IMRAN 0341-7549889
14
5
IS: 401-2001 Code of practices for preservation of
timber
IS: 707-1976 Glossary of term applicable to timber
technology and utilization
IS: 883-1994 Code of practices for design of
structural timber in buildings
IS: 1141-1973 Code of practices for seasoning of
timber
IS: 1150-1976 Trade names and abbreviated symbols
for timber species
IS: 1708-1986 (Part 1
to 18)
Method testing small clear specimens
of timber
IS: 3364-1976 (Part 1
& 2)
Methods of measurement and elevation
of defects in timber
IS: 3513-1966 (Part
1& 2)
Specifications for compressed wood
laminates
IS: 4423-1967 Guide for hand sawing of timber
IS: 4970-1973 Key for identification of commercial
timbers
IS: 6534-1971 Guiding principle for grading and
inspections of timber
IS: 9676-1980 Guideline for mills sawing of timber
IS: 11215-1986 Method of determination of moisture
content of timber and timber products
(b)Wooden doors and windows frame and shutter:
IS: 1003 Specifications for timber paneled and
glazed shutters
IS: 1003 (Part 1) Door shutters
IS: 1003 (Part 2) Window and ventilation shutters
IS: 2191 Specifications for wooden flush door
shutter (Cellular and hollow core
type)
IS: 2191 (Part 1) Plywood face panels
146 | P a g e
SAQIB IMRAN 0341-7549889
14
6
IS: 2191 (Part 2) Particle board face panels
IS: 2202 Specifications for wooden flush door
shutters
IS: 2202 (Part 1) Plywood face panels
IS: 2202 (Part 2) Particle board face panels
IS: 4021-1967 Specification for timber door, window
and ventilator frames
(c) Metal door and window frames and shutters:
IS: 1361-1978 Specification for steel window for
industrial buildings
IS: 1948-1961 Specifications for aluminum doors,
windows and ventilators
IS: 1949-1961 Specifications for aluminum windows
for industrial buildings
(d)Plywood:
IS: 303-1989 Specifications for plywood for general
purpose
IS: 1328-1958 Specifications for veneered decorative
plywood
IS: 4990-1969 Specifications for plywood for concrete
shuttering work
IS: 5509-1969 Specifications for fire retarding
plywood
(e) Particle board and fibre boards:
IS: 1658-1966 Specification for fibre hard-board
IS: 3097-1965 Specification for veneered particle
board

Engineering basic notes

  • 1.
    1 | Pa g e SAQIB IMRAN 0341-7549889 1 ENGINEERING CONSTRUCTION BASIC NOTES Written & Composed BY SAQIB IMRAN Cell & WHATSAPP no: 0341-7549889 Email: saqibimran43@gmail.com BS.TECH(CIVIL) From SARHAD UNIVERSITY OF SCIENCE & INFORMATION TECHNOLOGY PESHAWER.
  • 2.
    2 | Pa g e SAQIB IMRAN 0341-7549889 2 S.NO TOPICS PAGE NO 1 BRICKS 3 2 BUILDING CONSTRUCTION 26 3 BUILDING MATERIALS 41 4 CEMENT 62 5 CONSTRUCTION EQUIPMENTS 71 6 FOUNDATIONS, DAMS & ART DESIGN 101 7 IS CODES 123
  • 3.
    3 | Pa g e SAQIB IMRAN 0341-7549889 3 BRICKS A brick is a small man-made rectangular block typically made of fired and sun- dried clay, used to make wall. Bricks are mostly made of clay. In India, the standard size of brick as recommended by Bureau of Indian Standards IS: 2691:1988 is 190 x 90 x 90 mm. IS Code also states that with mortar thickness added the brick size shall be 200 x 100 x 100 mm. Quality of Good Bricks- 1- The brick should be table mounted, well burnt in kilns, copper coloured, free from cracks and with sharp and square edges. The colour should be uniform and bright. 2- The brick should be uniform in shape and should be of standard size. 3- The brick should give a clear metallic ringing sound when struck with each other. 4- The brick should not absorb water more than 20 percent by weight for first class brick and 22 percent for second class bricks, when soaked in cold water for a period of 24 hours. 5- The brick when broken or fractured should show a bright homogeneous and uniform compact structure free from voids. 6- The brick should not break in to pieces when dropped flat on hard ground from a height of about one metre. 7- The brick should be sufficient hard. No impression should be left on brick surface when it is scratched with finger nail. 8- No brick should have the crushing strength below 105kg/cm2 . 9- The brick should have low thermal conductivity and they should be sound proof. 10-The brick when soaked in water for 24 hours, should not show deposits of white salts when allowed to dry in shade.
  • 4.
    4 | Pa g e SAQIB IMRAN 0341-7549889 4 TERMS USED IN BRICK MASONRY WORK 1. COURSE: A horizontal layer of similar bricks or stones that are bonded with mortar is known as course. 2. QUOINS: Quoins are the stones used for the corners of the walls. 3. BED: The horizontal layer of mortar where brick or stone units are laid is known as bed. 4. BACK: The inner surface of a brick wall which is not exposed termed as back. The material forming back is known as backing. 5. FACE: The exterior surface of a brick wall which is exposed to weather termed as face. The material used in the face of the wall is known as facing. 6. HEARTING: The interior portion of a wall between the facing and backing is termed as hearting. 7. JOINT: The junction of two or more bricks or stones is called joint. There are eight types of mortar joints-
  • 5.
    5 | Pa g e SAQIB IMRAN 0341-7549889 5 1. Concave 2. Vee 3. Flush 4. Raked 5. Extruded 6. Beaded 7. Struck 8. Weathered 8. HEADER: The shorter side or end face of a brick that is exposed is termed as header. 9. STRETCHER: The longer narrow side or face of a brick that is exposed is termed as stretcher. 10. FROG:
  • 6.
    6 | Pa g e SAQIB IMRAN 0341-7549889 6 An indentation or depression on the top face of the brick made with the object of forming a key for the mortar is termed as frog. The depth of frog is usually between 10-20 mm. 11. BOND: This is the method of arranging bricks so that the individual units are tied together. 12. ARRIS: The sharp corner edges of brick is known as arris. 13. SPALLS: Spalls are the chips of stones used for filling the interstices in stone masonry. 14. BAT: The portion of bricks cut across the width is termed as bat. Three Quarter Bat: It is the form of brick bat having its length equal to three quarter of length of a full bricks. Half Bat: If the length of the bat is equal to half the length of the full bricks. Bevelled Bat: A brick bat is called bevelled bat when its width has bevelled. 15. CLOSER:
  • 7.
    7 | Pa g e SAQIB IMRAN 0341-7549889 7 Closer is the small piece of brick cut lengthwise in such a manner that its one long face remains uncut and used at the end of masonry wall to maintain bond pattern. 16. QUEEN CLOSER: When a brick is cut along its length, making it two equal pieces then it is called queen closer. 17: QUEEN CLOSER QUARTER: When a queen closer is cut in to two equal pieces then it is called as queen closer quarter. 18. KING CLOSER: King closer are the portion of a brick obtained by cutting off the triangular piece between center of one end and the center of one side. 19. BEVELLED CLOSER: Similar to king closer with the only difference that the whole length of the brick bevelled for maintaining the half width at one end and full width at the other. 20. MITRED CLOSER: It is a brick whose one end is cut splayed or mitred for full width. The angle of splay vary from 45 to 60 degree. 21. ROWLOCK:
  • 8.
    8 | Pa g e SAQIB IMRAN 0341-7549889 8 The head is visible and the long narrow sides are on bottom and top. 22. ROWLOCK STRETCHER: When the thinner stretcher sides are on bottom and top faces on the sides. 23. SAILOR: The heads are on top and bottom and the stretcher faces are on the side. Mostly used for decoration. 24. SOLDIER: The stretcher side is visible and the heads are at the bottom and top. It is usually used for decoration. 25. BUTTERING: Placing of mortar in on masonry block with trowel is termed as buttering. COLOURS OF BRICKS The colours of bricks as obtained in its natural course of manufacture depend on the following factors.  Degree of dryness achieved before burning  Natural colour of clay and its chemical composition  Nature of sand used in moulding operation  Quality of fuel used in burning operation  Quantity of air admitted to the kiln during burning
  • 9.
    9 | Pa g e SAQIB IMRAN 0341-7549889 9  Temperature at which bricks are brunt COLOURS OF BRICKS No. Colour Constituents Present in Clay 1 Black Manganese and large proportion of iron 2 Bluish Green Alkalies 3 Bright red, dark blue or purple Large amount of iron oxide 4 Brown Lime in excess 5 Cream Iron and little lime 6 Red Iron in excess 7 White Pure clay 8 Yellow Iron and magnesia The artificial colouring of bricks is achieved by adopting one of the following two methods 1. Addition of colouring material 2. Dipping in colouring liquid 1. Addition of Colouring Material: In this method the required colouring material is added in brick earth. The bricks prepared from such earth will present the desired colour. The usual colouring materials are iron oxides, manganese, French ultramarine, Indian red etc. This method is adopted when the colouring material is cheap and when it is available in plenty. 2. Dipping in Colouring Liquid: In this method an earthenware box which is slightly larger each way than a common bricks is taken. It is filled nearly to 1/2 depth with liquid which is in the form of thick paste. The bricks to be coloured are placed on an iron plate and with a fire underneath they are heated to such an extent that they can be easily handled. One brick is taken at a time and it is allowed to stay for few seconds in the box. It is then placed aside to dry. The colouring liquid is formed by the addition of colouring material to a mixture of lineseed oil, litharge and turpentine. The proportion of various component of colouring liquid for different colours.
  • 10.
    10 | Pa g e SAQIB IMRAN 0341-7549889 10 COLOURING LIQUID Component Name of the Colour Black Blue Dark red Grey Lineseed oil 1.20 N 570 c.c. 850 c.c. 0.60 N Lintharge 0.60 N 0.15 N 1.15 N 0.30 N Turpentine 1.80 N 570 c.c. 850 c.c. 1.20 N Manganese 1.80 N - - 0.30 N French ultramarine - 4.50 N - - Indian red - - 0.15 N - White lead - - - 0.90 N Following are the advantage of this method- 1. The bricks which are coloured by this method do not lose their colours, when exposed to the atmosphere. 2. It can be adopted for expensive colours 3. It is possible to develop a variety of colours cheaply and easily 4. The penetration of colouring liquid in ordinary bricks ia adbout 3 mm or so. 5. This method can be used for brick wall which are already constructed. The wall surface is carefully cleaned. The colouring liquid is slightly heated and it is applied on the wall surface with a brush. SIZE, WEIGHT AND FACTORS AFFECTING QUALITY OF BRICKS SIZE AND WEIGHT OF BRICKS The bricks are prepared in various sizes. The custom in the locality is the governing factor for deciding the size of a brick. Such bricks are not standardized are known as the traditional bricks. It bricks are large it is difficult to burn them properly and they become too heavy to be placed with a single hand. On the other hand if bricks are small more quantity of mortar is required. For India a brick of standard size 190 mm x 90 mm x 90 mm is recommended by BIS. With mortar thickness the size of such a brick becomes 20 mm x 10 mm x 10 mm and it is known as the nominal size of the modular bricks. Thus the nominal size of brick includes the mortar thickness. It is found that the weight of 1 m3 of brick earth is about 18 KN. Hence the average weight of a brick will be about 30 to 35 N. FACTORS AFFECTING QUALITY OF BRICKS
  • 11.
    11 | Pa g e SAQIB IMRAN 0341-7549889 11 Following factors affect the quality of bricks-  Composition of brick earth  Preparation of clay and blending of ingredient  Nature of moulding adopted  Care taken in drying and stacking of raw or green bricks  Types of kiln used including type of fuel and its feeding  Burning and cooling processes  Care taken in including It is thus obvious that not only the bricks of different brick fields will have different strength, but in the same brick field, the bricks of the same batch may have different strengths. The average crushing strength and tensile strength of hand moulded bricks are 60000 KN/m2 and 2000 KN/m2 respectively. In practice however the bricks are not subjected to the tensile stresses. It may be noted that the strength of brickwork mainly depends on the types of mortar used and not so much on the individual strength of the bricks. DIFFERENT CUTS AND ORIENTATIONS OF BRICKS USED IN CONSTRUCTION 1. BRICK ORIENTATION: (i). HEADER:
  • 12.
    12 | Pa g e SAQIB IMRAN 0341-7549889 12 The shorter side or end face of a brick that is exposed is termed as header. (ii). STRETCHER: The longer narrow side or face of a brick that is exposed is termed as stretcher. (iii). ROWLOCK: The head is visible and the long narrow sides are on bottom and top. (iv). ROWLOCK STRETCHER:
  • 13.
    13 | Pa g e SAQIB IMRAN 0341-7549889 13 When the thinner stretcher sides are on bottom and top faces on the sides. (v). SAILOR: The heads are on top and bottom and the stretcher faces are on the side. Mostly used for decoration. (vi). SOLDIER: The stretcher side is visible and the heads are at the bottom and top. It is usually used for decoration. 2. DIFFERENT TYPES OF BRICK CUTS 1. CLOSER:
  • 14.
    14 | Pa g e SAQIB IMRAN 0341-7549889 14 Closer is the small piece of brick cut lengthwise in such a manner that its one long face remains uncut and used at the end of masonry wall to maintain bond pattern. (i). QUEEN CLOSER (HALF): When a brick is cut along its length, making it two equal pieces then it is called queen closer. (ii). QUEEN CLOSER (QUARTER): When a queen closer is cut in to two equal pieces then it is called as queen closer quarter. (iii). KING CLOSER: King closer are the portion of a brick obtained by cutting off the triangular piece between center of one end and the center of one side. (iv). BEVELLED CLOSER:
  • 15.
    15 | Pa g e SAQIB IMRAN 0341-7549889 15 Similar to king closer with the only difference that the whole length of the brick bevelled for maintaining the half width at one end and full width at the other. (v). MITRED CLOSER: It is a brick whose one end is cut splayed or mitred for full width. The angle of splay vary from 45 to 60 degree. 2. BAT: The portion of bricks cut across the width is termed as bat. (i). THREE QUARTER BAT: It is the form of brick bat having its length equal to three quarter of length of a full bricks. (ii). HALF BAT: If the length of the bat is equal to half the length of the full bricks. (iii). BEVELED BAT:
  • 16.
    16 | Pa g e SAQIB IMRAN 0341-7549889 16 A brick bat is called beveled bat when its width has beveled. TYPES OF BRICK BONDS Most commonly used brick bonds are- 1. Header Bond 2. Stretcher Bond 3. English Bond 4. Flemish Bond 1. HEADER BOND: In this type of bonding all the bricks are laid as headers on the faces. This bond permit better alignment and it is used for wall curved on plan. The overlap is half the width of the brick and can be achieved by providing a three quarter bat in each alternate course at quoins. 2. STRETCHER BOND: Stretcher bond is the simplest type of brick bond in which all the bricks are laid as stretchers on the faces. This bond is also called as running bond. In this bond no header is present hence suitable reinforcement always be provided for construction of structural bond. The overlap between the bricks is usually a third
  • 17.
    17 | Pa g e SAQIB IMRAN 0341-7549889 17 or a quarter of a brick instead of half of a brick. This type of bond not particularly strong. 3. ENGLISH BOND: English bond consist of alternate course of header and stretchers. In this English bond arrangement vertical joints in the header courses come over each other and the vertical joints in the stretchers course are also in the same line. For the breaking of vertical joints in the successive course it is essential to place queen closer after first header in each heading course. The following additional points should be noted in English bond construction- 1. In this English bond a heading course should never start with a queen closer as it is liable to get displaced in this position. 2. In the stretcher course the stretchers should have a minimum lap of 1/4th their length over the header. 3. Walls having their thickness equal to an even number of half bricks i.e. one brick thick wall, two brick thick wall, three brick thick wall and so on, present the same appearance on both the faces i.e. a course consisting of header on front face will show headers on the back face also. 4. In walls having their thickness equal to an odd number of half brick i.e. one and half brick thick walls or two and half brick thick walls and so on, the same course will stretcher on one face and headers on the other. 5. In thick walls the middle portion is entirely filled with header to prevent the formation of vertical joints in the body of the wall. 6. Since the number of vertical joints in the header course is twice the number of joints in the stretcher course, the joints in the header course are made are thinner than those in the stretcher course. 4. FLEMISH BOND:
  • 18.
    18 | Pa g e SAQIB IMRAN 0341-7549889 18 In Flemish bond each course consist of alternate headers and stretchers. The alternate headers of each course are centered over the stretchers in the course below. Every alternate course starts with a header at the corner. For the breaking of vertical joints in the successive courses, closers are inserted in the alternate courses next to the quoin header. In walls having their thickness equal to odd number of half bricks, bats are essentially used to achieve the bond. Flemish bond is further divided in to two different types namely- 1. Single Flemish Bond 2. Double Flemish Bond 1. Single Flemish Bond- This bond is a combination of English bond and Flemish bond. In this work the facing of the wall consists of Flemish bond and the backing consists of English bond in each course. This type of bonding can not be adopted in walls less than one and a half brick in thickness. This bond is adopted to present the attractive appearance of Flemish bond with an effort to ensure full strength in the brick work. 2. Double Flemish Bond- In double Flemish bond each course presents the same appearance both in the front and back elevation. Every course consist of headers and stretchers laid alternately. This type of bond is beast suited from consideration of economy and appearance. It enables the one brick wall to have flush and uniform faces on both sides. This type of bonding is comparatively weaker than English bond. Other types of brick bonds are- 1. Facing Bond 2. Dutch Bond 3. English Cross Bond
  • 19.
    19 | Pa g e SAQIB IMRAN 0341-7549889 19 4. Brick on Edge Bond 5. Raking Bond 6. Zigzag Bond 7. Garden Wall Bond FACTORS AFFECTING STRENGTH OF BRICKS Following factors affecting the strength and quality of bricks- 1. Composition of brick making earth. 2. Preparation of clay and blending of ingredients. 3. Nature of moulding adopted. 4. Care taken in drying and stacking of raw or green bricks. 5. Types of kilns used including types of fuel and its feeding. 6. Burning and cooling process. 7. Care taken in unloading. It is thus obvious that not only the bricks of different brick field will have different strength, but in the same brick field, the bricks of the same batch may have different strength. The average crushing strength and tensile strength of hand moulded bricks are 60000 kN/m2 and 2000 kN/m2 respectively. The shearing strength of bricks are not subjected to the tensile stresses. It may be noted that the strength of brickwork mainly depends on the types of mortar used and not so much on the individual strength of the bricks.
  • 20.
    20 | Pa g e SAQIB IMRAN 0341-7549889 20 COMPOSITIONS OF GOOD BRICK EARTH In order to get good quality brick, the earth should contain the following constituents.  Silica  Alumina  Lime  Iron Oxide  Magnesia 1. SILICA-  Good brick earth should contain about 50 to 60% of Silica  It prevents Cracking, Shrinkage and Warping of raw bricks.  It also affects the durability of bricks.  The excess of silica destroys the cohesion between particles and the brick becomes brittle. 2. ALUMINA-  The percentage of alumina should be in the range of 20 to 30% in a good brick earth.  The presence of this constituent imparts plasticity to the clay so that it can be moulded.  If present in excess, then the raw bricks shrink and warp during drying. 3. LIME-  Brick earth should contain about 2 to 5% of lime.  It prevents shrinkage of raw brick on drying.  It helps to lower the fusion temperature.
  • 21.
    21 | Pa g e SAQIB IMRAN 0341-7549889 21  It cause silica in clay to melt on burning and thus helps to bind it.  The excess of lime causes the bricks to melt and brick looses its shape. 4. IRON OXIDE-  A good brick earth should contain about 5 to 7% of Iron oxide.  It gives red colour to the bricks.  It improves impermeability and durability.  It gives strength and hardness.  If present in excess, then the colour of brick becomes dark blue or blackish.  If the quantity of iron oxide is comparatively less the brick becomes yellowish in colour. 5. MAGNESIA-  Good brick earth should contain a small quantity of magnesia about 1%.  Magnesium in brick earth impart yellow tint to the brick.  It is responsible for reducing shrinkage.  Excess of magnesia leads to the decay of bricks. ------------------------------------------------------------------------------------------------------------- --- Silica........................................50-60% Alumina...................................20-30% Lime.........................................2-5% Iron oxide.................................5-7% Magnesia..................................not more than 1% HARMFUL INGREDIENTS IN BRICKS AND THEIR EFFECTS Following are the ingredients which are undesirable in the brick material-  Lime  Alkalies  Pebbles  Iron pyrites  Vegetation and Organic matter 1. LIME  If lime in brick earth present in excess, it causes the brick to melt and hence brick looses its shape.
  • 22.
    22 | Pa g e SAQIB IMRAN 0341-7549889 22  If lime is present in the form of lumps, then it is converted into quick lime after burning. This quick lime slakes and expands in presence of moisture, causing splitting of bricks into pieces. 2. ALKALIES  Alkalies exist in the brick in the form of soda and potash  Alkalies present in the brick earth lower the fusion temperature abnormally as a result of which the brick deforms and twist.  Alkalies remaining in bricks will absorb water from the atmosphere. When the moisture gets evaporated leaving grey or white deposits on wall surface (efflorescence) which affects the appearance of the building structure. 3. PEBBLES  It prevents mixing of clay thoroughly and uniformly, which results in weak and porous bricks.  Bricks containing pebbles will not break into shapes as per requirements. 4. IRON PYRITES  If the iron pyrites present in brick earth causes the brick to get crystallized and disintegrated during burning, because of the oxidation of the iron pyrites. 5. VEGETATION AND ORGANIC MATTER  The presence of vegetation and organic matter in brick earth assists in burning. But if such matter is not completely burnt, the bricks become porous. This is due to the fact that the gasses will be evolved during the burning of the carbonaceous matter and it will result in the formation of small pores. MANUFACTURING OF CLAY BRICKS Manufacturing of clay bricks includes following steps-  Preparation of brick earth  Moulding of bricks  Drying of moulded bricks  Burning of bricks TESTS TO JUSTIFY BRICK QUALITY To know the quality of bricks following tests can be performed-  Water Absorption test  Crushing strength test
  • 23.
    23 | Pa g e SAQIB IMRAN 0341-7549889 23  Hardness test  Shape and size  Color test  Soundness test  Structure of brick  Efflorescence Test 1. WATER ABSORPTION TEST- This test is conducted on brick to find out the amount of moisture absorbed by brick under extreme condition. In this test a sample of dry brick are taken and weighed and immersed in fresh water at a temperature of 27'C for a period of 24 hours. After 24 hours the specimen taken out and wiped with cloth. The weight of sample in wet condition is taken, the difference in weight indicates the amount of water absorbed by brick. For a good quality brick the amount of water absorption should not exceed 20 percent of weight of dry brick. M1- Weight of dry brick M2- Weight of wet brick 2. CRUSHING STRENGTH TEST- This test is done to know the load carrying capacity of brick under compression. The brick specimen immersed in water for 24 hours, remove the specimen and
  • 24.
    24 | Pa g e SAQIB IMRAN 0341-7549889 24 drain out surplus moisture at room temperature. The frog of the brick is filled with cement mortar (1:3) and stored in damp jute bag for 24 hours and immersed in clean water for 24 hours. The specimen is placed in compression testing machine and load is applied axially at the uniform rate of 14N/mm2 till failure occurs and note the maximum load at failure. For a good quality brick the crushing value should not be less than 105 kg/cm2 . 3. HARDNESS TEST- In this test a scratch is made on brick surface with the help of finger nail. If no impression is left on the surface, the brick is sufficient hard. 4. SHAPE AND SIZE TEST- In this test 20 bricks of standard size are randomly selected and stacked along lengthwise, widthwise and heightwise. Bricks are closely inspected to check it should be of standard size and truly rectangular with sharp edges 5. COLOR TEST- A good quality brick should posses bright and uniform color throughout its body. 6. SOUNDNESS TEST- In this test two bricks are taken randomly and struck with each other they should produce clear ringing sound. 7. STRUCTURE OF BRICK- In this test a brick is broken and closely observed. It should be homogeneous, compact and free from defects such as lumps, holes etc. 8. EFFLORESCENCE TEST-
  • 25.
    25 | Pa g e SAQIB IMRAN 0341-7549889 25 This test is used to find out the presence of soluble salts in brick. In this test a brick is immersed in fresh water for 24 hours. It is then taken out from water and allowed to dry in shade. If white and grey layer is not visible on brick surface it indicates absence of soluble salts and useful for construction. If the whitish layer visible about 10% of brick surface then the presence of alkalies is in acceptable range. If that is about 50% of surface then it is moderate. If the alkalies presence is over 50% then the is severely affected by alkalies.
  • 26.
    26 | Pa g e SAQIB IMRAN 0341-7549889 26 Building Construction TYPES OF RCC BEAMS Beam can be defined as a structural member which is normally placed horizontal. It provide resistance to bending when loads are applied on it. There are various types materials used for construction of beam such as steel, aluminum, wood etc. But RCC (Reinforced Cement Concrete) is most commonly used material for construction of beam. TYPES OF RCC BEAMS Depending upon their supporting system RCC beam can be classified in to four categories as follows- 1. Simply Supported Beam 2. Continuous Beam 3. Semi-Continuous Beam 4. Cantilever Beam 5. T- Beam 1. SIMPLY SUPPORTED BEAM The simply supported beam contains only a single span which is supported by two supports at both ends. This beam also called simple beam. 2. CONTINUOUS BEAM This types of beam has more than two span and has more than three supports along its length in one straight line.
  • 27.
    27 | Pa g e SAQIB IMRAN 0341-7549889 27 3. SEMI-CONTINUOUS BEAM This types of beams does not have more than two span and three supports. 4. CANTILEVER BEAM This types of beam has only one support in one end, other end is free. 5. T-BEAM When floor slabs and beams are poured simultaneously producing a monolithic structure where where the portion of the slab at both side of the beam serves as flange of T beam. The beam below the slab serves as the web member and is sometimes called stem.
  • 28.
    28 | Pa g e SAQIB IMRAN 0341-7549889 28 STANDARD SIZE OF ROOM IN A RESIDENTIAL BUILDINGS TYPES OF ROOMS IN A RESIDENTIAL BUILDING AND THEIR STANDARD SIZE 1. LIVING ROOM
  • 29.
    29 | Pa g e SAQIB IMRAN 0341-7549889 29  Small- 12x18ft (3.4X5.4m)  Medium- 16x20ft (4.8x6.0m)  Large- 22x28ft (6.6x8.4m) 2. MASTER BEDROOM  Small- 12x14ft (3.6x4.2m)  Medium- 14x20ft (4.2x6.0m)  Large- 16x24ft (4.8x7.2m) 3. BEDROOM  Small- 10x10ft (3.0x3.0m)  Medium- 12x12ft (3.6x3.6m)  Large- 14x16ft (4.2x4.8m) 4. DINING ROOM  Small- 10x12ft (3.0x3.6m)  Medium- 12x16ft (3.6x4.2m)  Large- 14x18ft (4.2x4.8m) 5. KITCHEN  Small- 5x10ft (1.5x3.0m)  Medium- 8x13ft (2.5x3.9m)  Large- 10x12ft (3.0x3.6m) 6. BATHROOM (MASTER BEDROOM)  Small- 6x7ft (1.8x2.7m)  Medium- 7x10ft (2.1x3.0m)  Large- 8x12ft (2.5x3.6m) 7. BATHROOM (COMMON BEDROOM)  Small- 5x9ft (1.5x2.7m)  Medium- 6x10ft (1.8x3.0m)  Large- 7x12ft (2.1x3.6m) 8. DRESSING ROOM  Small- 4x4ft (1.2x1.2m)  Medium- 5x5ft (1.5x1.5m)  Large- 6x6ft (1.8x1.8m) 9. FOYER  Small- 5ft Wide (1.5m)  Medium- 6ft Wide (1.8m)  Large- 8ft Wide (2.5m)
  • 30.
    30 | Pa g e SAQIB IMRAN 0341-7549889 30 10. STORE ROOM  Small- 6x6ft (1.8x1.8m)  Medium- 8x10ft (2.5x3.0m)  Large- 10x10ft (3.0x3.0m) 11. PANTRY  Small- 2x2ft (0.6x0.6m)  Medium- 3x4ft (0.9x1.2m)  Large- 4x6ft (1.2x1.8m) 12. OFFICE ROOM  Small- 8x10ft (2.5x3.0m)  Medium- 10x12ft (3.0x3.6m)  Large- 12x14ft (3.6x4.2m) 13. STUDY ROOM  Small- 10x10ft (3.0x30.m)  Medium- 12x12ft (3.6x3.6m)  Large- 14x16ft (4.2x4.8m) 14. GUEST BEDROOM  Small- 10x12ft (3.0x3.6m)  Medium- 12x14ft (3.6x4.2m)  Large- 14x18ft (4.2x4.8m) 15. GUEST BATHROOM  Small- 5x9ft (1.5x2.7m)  Medium- 6x10ft (1.8x3.0m)  Large- 7x12ft (2.1x3.6m) 16. GARAGE  Small- 12x20ft (3.6x4.2m)  Medium- 20x20ft (6.0x6.0m)  Large- 24x24ft (7.2x7.2m) 17. LAUNDRY  Small- 3x6ft (0.9x1.8m)  Medium- 6x8ft (1.8x2.5m)  Large- 8x10ft (2.5x3.0m) ELEMENTS OF BUILDING CONSTRUCTION
  • 31.
    31 | Pa g e SAQIB IMRAN 0341-7549889 31 COMMON BUILDING COMPONENTS SUPER STRUCTURE The super structure is that part of the building which is above the ground and which serve the purpose of buildings intended use. It includes-  Plinth  Wall  Coulums  Arches  Roofs & Slabs  Lintel  Chajjas  Parapet  Stairs & Steps SUBSTRUCTURE The substructure is the lower portion of the building which is located below ground level which transmits the load of the superstructure to the sub soil. It includes-  Foundation NOMINAL DIMENSIONS OF BUILDING COMPONENT
  • 32.
    32 | Pa g e SAQIB IMRAN 0341-7549889 32 Building Component Nominal Dimensions Plinth (Height) 30, 45, 60, 75, 90 cm Wall (Thickness) Partition Wall Load bearing Wall 10 cm 20, 30, 40 cm Lintel (Thickness) 15 cm Lintel (Height) 2.0 m from floor level Chajja Projection 30, 45, 60, 75, 90 cm Slab (Thickness) 0.1-0.15 m Parapet Wall (Thickness) 10 cm Parapet Height 1 m Door (Width) 0.8, 0.9, 1.0, 1.2 m Door (Height) 1.8, 2.0, 2.1 m Sill Height 0.07-0.1 m Column Size Square 20x20, 30x30 cm Rectangular 20x30 cm Circular 20Ф, 30Ф Column Footing 1x1x1m below ground Depth of Beam 30, 45, 60 cm Steps No. of risers = Height of Ceiling+ Slab thickness/ Riser height No. of Treads= No. of Risers-1 Riser Height 15-20 cm Tread Width 25, 30, 35 cm Width of steps Minimum 1 m DIFFERENT TYPES OF BUILDINGS A building is a man made structure with a roof and walls standing more or less permanently in one place such as house or factory. Buildings are classified in to two categories- (A). Based on Occupancy (B). Based on types of Construction
  • 33.
    33 | Pa g e SAQIB IMRAN 0341-7549889 33 A. CLASSIFICATION BASED ON OCCUPANCY 1. Residential Buildings 2. Industrial Buildings 3. Educational Buildings 4. Institutional Buildings 5. assembly Buildings 6. Business Buildings 7. Mercantile Buildings 8. Storage Buildings 9. Hazardous Buildings RESIDENTIAL BUILDINGS Buildings in which sleeping arrangement are provided with or without cooking arrangement. It includes single or multi family dwelling, apartments, lodgings, restaurant, hostels, dormitories and hotels. INDUSTRIAL BUILDINGS These are buildings where products or materials of all kinds and properties are fabricated, assembled, manufactured or processed. EDUCATIONAL BUILDINGS These includes any buildings used for schools, colleges, education purposes. INSTITUTIONAL BUILDINGS These buildings used for different purposes such as medical or other treatment. They includes hospitals, sanatorium, jails, asylum. ASSEMBLY BUILDINGS
  • 34.
    34 | Pa g e SAQIB IMRAN 0341-7549889 34 These are the buildings where group of peoples meet or gather for amusement, social, religious, political, civil travel and similar purposes. E.g. theaters, motion pictures, house, assembly halls, restaurants assembly halls. BUSINESS BUILDINGS These buildings are used for transactions of business, for keeping accounts and for similar other purpose. MERCANTILE BUILDINGS These buildings are used as shops, stores, market for display and sale of merchandise either wholesale or retail, office, shops, storage services. STORAGE BUILDINGS These buildings are used primarily for the storage or sheltering of goods, wares or merchandise, vehicles and animals, grains. HAZARDOUS BUILDINGS These buildings are used for the storage, handling, manufacturing or processing of highly combustible or explosive materials or products. B. CLASSIFICATION BASED ON STRUCTURES 1. Framed Structure 2. Load Bearing Structure FRAMED STRUCTURE Reinforced cement concrete structures the most common type of construction today. They consist of a skeleton of beams and columns. The load is transferred from from beams to the columns and column intern transfer the load directly to the sub soil through footing. Framed structures are suitable for multistory building subjected to variety of extreme loads like compressive, tensile torsion, shear along with moment. The open space in the skeleton are to be filled with brick walls or glass panels. LOAD BEARING STRUCTURE In this type of structures loads from roof slab or trusses and floors are transmitted through walls to the firm soil below the ground. This types of structures are adopted where hard strata are available at shallow depth. The structural elements like beams, slabs rest directly on the walls. TYPES OF LOADS ON STRUCTURE
  • 35.
    35 | Pa g e SAQIB IMRAN 0341-7549889 35 The different types of loads coming on the foundation of a structure are described below- 1. Dead Load 2. Live Load 3. Wind Load 4. Snow Load 5. Earthquake Load 6. Erection load 1. DEAD LOAD Dead load comprises of the weight of all walls, partitions, floors, and roof including all other permanent construction in the building. 2. LIVE LOAD Live load consist of moving or variable loads due to people or occupants, their furniture, temporary stores, machineries. 3. WIND LOAD It is considered as basic wind pressure which is equivalent static pressure in the direction of the wind. Wind Pressure = kV2 Where k= co-efficient 0.006 V= wind velocity Wind pressure always acts in the vertically exposed surface of the walls and columns. 4. SNOW LOAD Actual load due to snow depends upon the shape of the roof and its capacity to retain the snow. The load due to snow may be assumed to be 2.5kg/m3 per cm depth of snow. 5. EARTHQUAKE LOAD An earthquake load produced waves in every possible direction below ground. As per intensity or scale of earthquake, jerk and shocks are acting on the earth. As per the location of the building in the prescribed zone of earthquake coefficients of earthquake loads are decided. 6. ERECTION LOAD
  • 36.
    36 | Pa g e SAQIB IMRAN 0341-7549889 36 All loads required to be carried by the structure or any part of it due to storage or positioning of construction material and erection equipment including all loads due to operation of such equipment shall be considered as erection load. DAMP-PROOFING In order to prevent the entry of damp or moisture in the building the damp- proofing courses (D.P.C) are provided at various levels of entry of damp in to a building. At present practically all the buildings are given the treatment of damp- proofing. Thus the provision of D.P.c prevent the entry of moisture from walls, floors, and basement of a building. Following are the various causes of dampness in a building:  Rising of moisture from the ground  Rain travel from wall tops  Rain beating against external walls  Condensation  Poor drainage, imperfect orientation, imperfect roof slope, defective construction etc. The ideal damp proofing material have the following characteristics: 1. It should be perfectly impervious 2. It should be durable
  • 37.
    37 | Pa g e SAQIB IMRAN 0341-7549889 37 3. It should be strong and capable of resisting superimposed load coming on it. 4. It should be flexible so that it can accommodate the structural movements without any fracture. 5. It should remain steady in its position when once applied 6. It should not be costly. The materials commonly used for damp-proofing are not bitumen, mastic asphalt, bituminous or asphaltic felts, metal sheets, combination of sheets are felts, stone, bricks, mortar, cement concrete and plastic sheets. The following general principles should be kept in mind while providing D.P.C. 1. The damp-proofing course may be horizontal or vertical. 2. The horizontal damp-proof course ahould cover the full thickness of wall, excluding rendering. 3. The damp-proof course should be so laid that a continous projection is provided. 4. At junctions and cornersof walls, the horizontal damp-proof course should be laid continous. 5. The mortar bed supporting the damp-proof course should be even and levelled and should be free from projections so that the damp proof course is not damaged. 6. The damp proof course should not be kept exposed on the wall surface otherwise it may get damaged during finishing work. 7. When a horizontal damp proof course is continued to a vertical face a cement concrete fillet of about 75 mm radius should be provided at he junction. ARCHES- IMPORTANT TECHNICAL TERMS An arch is a structure constructed to span across an opening. It generally consist of small wedge-shaped units which are jointed together with mortar. The important technical terms used in arch work are as follows: 1. Intrados- It is the inner curve of an arch. 2. Soffit- It is the inner surface of an arch. Sometimes intrados and soffit are used synonymously. 3. Extrados- It is the outer curve of an arch.
  • 38.
    38 | Pa g e SAQIB IMRAN 0341-7549889 38 4. Voussoirs- These are wedge-shaped units of masonry forming an arch. 5. Crown- It is the highest point of the extrados. 6. Skew back- It is the inclined or splayed surface on the abutment on which the arch rests. 7. Abutment- It is the part of the wall on which the arch rest. In other words it is the end support of an arch. 8. Key stone- It is the wedge--shaped unit at the crown of an arch. 9. Springer- It is the voussoir next to skew back. 10.Springer line- It is an imaginary line joining the lowest parts of springer. 11.Haunch- It is the bottom portion of an arch between the skew back and crown. 12.Span- It is the clear horizontal distance between the supports. 13.Pier- It is an intermediate support of an arch. 14.Rise- It is the clear vertical distance between the springing line and the highest point on the intrados. 15.Depth or height- It is the perpendicular distance between the intrados and extrados. 16.Thickness or breatdth of sofit- It is the horizontal distance measured perpendicular to the front and back faces of an arch. STAIRS- COMMON TECHNICAL TERMS
  • 39.
    39 | Pa g e SAQIB IMRAN 0341-7549889 39 A stair is a sequence of steps provided to afford the means of ascent and decent between the floors or landing. The apartment or room of a building in which the stair is located is known as a staircase and the opening or space occupied by the stair is known as stairway. Following are the common technical terms used in connection with the stairs- Tread- The horizontal upper part of a step on which foot is placed in ascending or descending a stairway is called tread. 1. Riser- A vertical portion of a step providing a support to the tread is called riser. 2. Flier- A straight step having a parallel width of tread is called flier. 3. Flight- An unbroken series of steps between two landing is called flight. 4. Landing- A horizontal platform at the top or bottom of a flight between the floors is calledlanding. It facilitates change of direction and provides an opportunity for taking rest during the use of the stair. 5. Rise- The vertical distance between two successive tread faces is called rise. 6. Going- The horizontal distance between two successive riser face is called going. 7. Nosing- The projecting part of the tread beyond the face of riser is called nosing. 8. Scotia- A moulding provided under the nosing to beautify the elevation of a step and to provide strength to nosing is called scotia. 9. Soffit- The under surface of a stair is called soffit.
  • 40.
    40 | Pa g e SAQIB IMRAN 0341-7549889 40 10.Pitch or slope- The angle which the line of nosing of the stair makes with the horizontal is called pitch or slope. 11.Strings or stringers- The sloping members which support the steps in a stair are calledstrings or stringers. 12.Baluster- The vertical member of wood or metal to support the hand rail is called baluster. 13.Balustrade- The combined frame work of handrail and balusters is known as balustrade. 14.Hand rail- The horizontal or inclined support provided at a convenient height is calledhand rail. 15.Newel post- The vertical member placed at the ends of flight connecting the ends of strings and hand rail is called newel post. Notes:- The size of a step commonly adopted for residential building is 250 mm X 160 mm. In hospital etc. the comfortable size of step is 300 mm X 100 mm. The width of stairs depend upon its location in the building and the types of a building itself. In a residential building the average value of stair width is 900 mm while in a public building 1.5 to 1.8 metres width may be required. The width of landing should be greater than the width of stair. The pitch of stair should never exceed 40 degree. In designing a stair a comfortable slopes is achieved when the sum of going and twice the rise should be equal to 60 approximately. In designing a stair the product of going and the rise should be equal to 400. The clear distance between the tread and soffit of the flight immediately above it should not be less than 2 metres. An open newel stair consist of two or more straight flights arranged in such a manner that a clear space occurs between the background and forward flights. In wooden stairs the thickness of tread is adopted as 38 mm.
  • 41.
    41 | Pa g e SAQIB IMRAN 0341-7549889 41 BUILDING MATERIALS BUILDING MATERIALS List of building materials....... 1. Brick 2. Cement 3. Sand 4. Coarse Aggregate 5. Concrete 6. Reinforcement
  • 42.
    42 | Pa g e SAQIB IMRAN 0341-7549889 42 7. Mortar 8. Wood 9. Tiles 10. Glass 11. Plastic 12. Paint REQUIREMENTS OF A GOOD AGGREGATE Following are the desirable properties and requirement of a good aggregate-  Adhesion  Cementation  Durability  Hardness  Shape  Strength  Toughness ADHESION: A good aggregate should have adhesive property, it should have sufficient binding capacity with binder. If this quality is absent in the aggregate, it will lead to the separation of bituminous and cement coating in the presence of water. CEMENTATION: The binding quality of the aggregate depends on its ability to form its own binding material under different loading so as to make the rough broken stone pieces grip together to resist displacement DURABILITY:
  • 43.
    43 | Pa g e SAQIB IMRAN 0341-7549889 43 A good aggregate should be sufficiently durable, it should be sufficiently resistant to weathering agencies and is largely dependent upon its petrological composition. This requirement of aggregate is essential so that it can resist the effect of weathering agencies like rain, frost, variation of temperature etc. in order to achieve long life of the structures. HARDNESS: A good aggregate should be sufficiently hard, it should offer maximum possible resistance to abrasion and attrition. The road aggregate should be hard enough to resist abrasion due to grinding of pieces of stones against each other. SHAPE: The shape of aggregates may be rounded, cubical, angular, flaky or elongated. The flaky and elongated aggregates possess less strength and durability and they are not used in construction work as far as possible. The rounded aggregates are preferred in cement concrete construction. They are unsuitable in W.B.M construction, bituminous construction, and in granular base course because their stability due to interlocking is less. The angular aggregates are used for such types of construction work. STRENGTH: The good aggregates should be sufficiently strong to withstand the stresses developed due to the wheel load of traffic. This property is especially desirable for the road aggregates which are to be used in top layer of the pavements. Thus the wearing course of road should be composed of aggregates which posses enough strength in addition to enough resistance to crushing. TOUGHNESS: A good aggregate quite tough, it should offer the maximum possible resistance to the hammering effect of wheel load. This is essential so that the aggregate used in the construction of pavement can resist the impact caused due to movement of heavy traffic load without breaking into smaller pieces. PROPERTIES OF GOOD PRESERVATIVE FOR TIMBER The preservatives used to protect the timber should contain following requirements or properties-  It should be effortlessly and cheaply available.
  • 44.
    44 | Pa g e SAQIB IMRAN 0341-7549889 44  It should not contain any harmful substances, gases etc.  It should cover larger area with small quantity.  It should be economical.  It should not contain any unpleasent smell.  It should not get affected by light, heat, water etc.  It should not get affected by fungi, insects etc and should also efficient to kill them.  It should not generate flame when contact with fire.  It should not corrode metals when it makes a contact with them.  Decorative treatment or any surface treatment should be allowed on timber after the application of preservatives.  The depth of penetration of preservatives in wood fibers should be minimum 6mm to 25mm. QUALITIES OF GOOD TIMBER Following are the characteristics or qualities of a good timber:
  • 45.
    45 | Pa g e SAQIB IMRAN 0341-7549889 45 1. APPEARANCE: A freshly cut surface of timber should exhibit hard and shining appearance. 2. COLOUR: The colour of timber should preferably be dark. The light colour usually indicates timber with low strength. 3. DEFECTS: A good timber should be free from serious defects such as dead knots, flaws, shakes, etc. 4. DURABILITY: A good timber should be durable. It should be capable of resisting the action of fungi insects, chemicals, physical agencies and mechanical agencies. If wood is exposed to the actions of acid and alkalies foe a prolonged period it is seriously damaged. The weak alkali and acid solutions usually do not affect wood to a considerable extent. 5. ELASTICITY: This is the property by which timber returns to its original shapes when load causing its deformation is removed. This property of timber would be essential when it is to used for bows, carrying shafts, sports goods etc. 6. FIBRES: The timber should have straight fibres. 7. FIRE RESISTANT: The timber is a bad conductor of heat. A dense wood offers good resistant to the fire and it requires sufficient heat to cause a flame. The heat conductivity of wood is low and it depends on various factors such as porosity, moisture content, surrounding temperature, orientation of fibres, bulk densdity etc. 8. HARDNESS: A good timber should be hard i.e. it should offer resistant when it is being penetrate by another body. The chemicals present in heart wood and density of wood impart hardness to the timber. The mere resistance offered to chisel or saw does not usually indicate hardness of timber. 9. MECHANICAL WEAR: A good timber should not deteriorate easily due too mechanical wear or abrasion. This property of timber would be essential for places where timber would be subjected to traffic e.g. wooden floors, pavements etc. 10.SHAPE: A good timber should be capable of retaining its shape during conversion or seasoning. It should not bow or warp or split. 11.SMELL: A good timber should have sweet smell. An unpleasant smell indicates decayed timber. 12.SOUND: A good timber should give out a clear ringing sound when struck. A dull heavy sound when struck indicates decayed timber. The velocity of
  • 46.
    46 | Pa g e SAQIB IMRAN 0341-7549889 46 sound in wood is 2-17 times greater than that in air and hence the wood may be considered high in sound transmission. The sound conductivity is faster along the fibres is lower in the radial direction and is slowest along the chord of a cross-section. 13.STRENGTH: A good timber should be strong for working as structural member such as joist, beam, rafter etc. It should be capable of taking loads slowly or suddenly. It should also possess enough strength in direct and transverse directions. 14.STRUCTURE: It should be uniform. The fibres should be firmly added. The medullary rays should be hard and compact. The annual rings should be regular and they should be closed located. 15.TOUGHNESS: A good timber should be tough i.e. it should be capable of offering resistant to the shocks due to vibrations. This property of timber would be essential when it is to be used for tool handles, parts of motor cars and aeroplanes etc. 16.WATER PERMEABILITY: A good timber should have low water permeability which is measured by the quality of water filtered through a unit surface area of specimen of wood. The water permeability is greater along the fibres than in other directions and it depends on initial moisture content, character of cut, type of wood, width of annual rings, age of wood etc. 17.WEATHERING EFFECTS: A good timber should be able to stand reasonably the weathering effects. When timber is exposed to weather its colour normally fades and slow turns grey. A good timber should show the least disintegration of the surface under adverse weather conditions such as drying and wetting, extreme heat and extreme cold etc. 18.WEIGHT: The timber with heavy weight is considered to be sound and strong. 19.WORKING CONDITION: The timber should be easily workable. It should not clog the teeth of saw and should be capable of being easily planed or made smooth. DIFFERENT TYPES OF PRESERVATIVES FOR TIMBER
  • 47.
    47 | Pa g e SAQIB IMRAN 0341-7549889 47 1. COAL TAR The timber surface is coated with hot coal tar with the help of brush. The coal tar becomes workable when heated. The process is known as the tarring. The coal tar has unpleasant smell and appearance. It makes timber unsuitable for painting. Hence the tarring is adopted for frames of doors and windows, rough timber work etc. and it is found to be most useful for parts embedded in ground because of its cheapness and effective resistance. The coal tar is fire resistant. 2. ASCU The ascu is special preservative which is developed at the Forest Research Institute Dehradun. Its composition is as follows- (a). Part by weight of hydrated arsenic pentoxide, (As2O5, 2H2O) (b). Part by weight of blue vitriol or copper sulphate, (CuSO4, 5H2O) (c). Part by weight of potassium dichromate, (K2Cr2O7) or sodium dichromate (Na2Cr2O7, 2H2O) This material is available in powder form. To prepare a solution of this material, six parts by weight of ascu are mixed in 100 parts by weight of water. The solution is then sprayed or applied on timber surface. This preservative gives timber protection against the attack of white ants. The surface treated with this preservative can be painted, polished, varnished or waxed. The solution is odourless. 3. CHEMICAL SLATS These are water borne preservatives and they are mostly salts dissolved in water. The usual salts used are copper sulphate, mercury chloride, sodium fluoride and zinc chloride. The solutions are prepared from these salts and
  • 48.
    48 | Pa g e SAQIB IMRAN 0341-7549889 48 they are applied on the timber surface can be painted or varnished after drying. These preservatives have good penetration and the timbers treated with these preservatives will show an immediate increase in weight of 2400 to 4800 N per m3 . After drying the net increase in weight will come down to about 50 to 300 N per m3 . 4. OIL PAINTS The timber surface is coated with 2 or 3 coats of oil paint. The wood should be seasoned. Otherwise sap will be confined and it will lead to the decay of timber. The oil paints preserve timber from moisture and make it durable. 5. SOLIGNUM PAINTS These paints preserve timber from white ants as they are highly toxic in nature. They can be mixed with colour pigments and applied in hot state with the help of brush. The timber surface may therefore be given the desired colour or appearance. 6. CREOSOTE OIL In this case the timber surface is coated with creosote oil. The process is known as the creosoting or Bethel's method of preservation of timber. The creosote oil is obtained by the distillation of tar. The creosoting is carried out as follows- (a). The timber is thoroughly seasoned and dried. (b). It is then placed in an air tight chamber. (c). The air is pumped out from the chamber. (d). The creosote oil is then pumped under a high pressure off about 0.70 to 1 N/mm2 and a temperature of about 50*C. (e). After a period of about 1 to 2 hours when timber has sufficient absorbed creosote oil it is taken out of chamber. The creosote oil is one of the best antiseptic substance poisonous for wood attacking fungi. It is a black or brown liquid weakly affected by water neither volatile nor hygroscopic, harmless to wood or metal, inflammable, with an unpleasant odour and having low wood penetrating ability to the extent of 1 mm to 2 mm only. The creosoting practically doubles the life of timber and it is generally adopted for piles, poles, railway sleepers, etc. Depending upon the net retention and type of timber the creosote treated timber will normally increase in weight by 800 to 3200 N per m3 . The creosote oil is highly toxic in nature and gives out
  • 49.
    49 | Pa g e SAQIB IMRAN 0341-7549889 49 highly unpleasant smell. The process of creosoting proves to be costly. The creosote oil should not be used for interior surface of dwelling houses, foodstuff storage premises, in underground installation and near inflammable surface. IMPORTANT BUILDING STONES The following are important building stone, their composition, properties and uses: 1. Granite: It is an igneous rock. It is mainly composed of quartz, felspar and mica. Its specific gravity is 2.64 and compressive strength varies from 70 to 130 MN/m2. Its colour depends upon that of felspar which may be brown, grey, green and pink. A fine grained granite offers high resistance to weathering. It can be easily polished and worked. It is used for exterior facing of buildings. 2. Slate: It is an argillaceous rock. It is mainly composed of alumina mixed with sand or carbonate of lime. Its specific gravity is 2.8 and compressive strength varies from 60 to 70 MN/m2. It has grey or dark blue colour. A good slate is hard, tough and fine grained. It is suitable for use in cistern. The slate in the form of tiles is used as an excellent roof covering material. 3. Gneiss:
  • 50.
    50 | Pa g e SAQIB IMRAN 0341-7549889 50 It is a silicious rock. It is mainly composed of quartz and felspar. It is more easily worked than granite. It is a good material for street paving. 4. Sandstone: It is a sedimentary rock of silicious variety. It is mainly composed of quartz, lime and silica. Its specific gravity is 2.65 to 2.95 and compressive strength varies from 35 to 40 MN/m2. Its usual colours are white, grey, brown, pink etc. The fine grained stones are strong and durable. It is suitable for ashlar work, mouldings, carving etc. 5. Limestone: It is a sedimentary rock of calcarious variety. Its specific gravity is 2.6. It is available in brown, yellow and dark grey colours. It is used in large quantities in blast furnaces. It may be used as stone masonry for wall. 6. Marble:
  • 51.
    51 | Pa g e SAQIB IMRAN 0341-7549889 51 It is a metamorphic rock of calcarious variety. Its specific gravity is 2.7 and is available in many colours. It is very hard and takes a fine polish. It is used for carving and decoration work. 7. Kankar: It is very impure lime stone containing 30% of alumina and silica. The hard kankar is used for foundations of buildings. 8. Laterite: It is a sandy clay stone containing high percentage of iron oxides. It has a porous and cellular structure. Its specific gravity, varies from 2 to 2.2. The laterite blocks are suitable as building stones whereas nodular laterite proves a very good road metal. 9. Moorum:
  • 52.
    52 | Pa g e SAQIB IMRAN 0341-7549889 52 It is a decomposed laterite and has deep brown or red colour. It is used in surfacing fancy paths and garden walks. 10. Quartzite: It is a silicious sand stone which has been subjected to metamorphic action. It is strong and durable. It is used as a road metal or railway ballast or in concrete. CONCRETE BLOCKS RAW MATERIALS- The materials required for the production of the concrete blocks are aggregates, cement, water.
  • 53.
    53 | Pa g e SAQIB IMRAN 0341-7549889 53 The aggregates of various types have been used with varying degree of success and they include crushed stones, gravels, volcanic cinder, foamed slag, furnace clinker, etc. The aggregates are selected by considering the weight, texture or composition of the unit designed. The strength, texture and economy of the concrete block depend upon the careful grading of the aggregate. If locally available aggregate is suitable it will help in achieving the economy. The cement used is ordinary portland cement. The water required is the normal potable water. MANUFACTURING- The fully automatic plants are available for the manufacturing of high strength concrete blocks. These automatic machines produce superior quality concrete blocks. But they involves a large capital investment. The manually operated machines are also available and they can be installed at project site itself which further reduce the transportation cost of the concrete blocks from the place of production to the place of actual use. The process involves in the manufacturing of the concrete blocks are as follows - 1. Selection and proportion of ingredients- The main criteria for the selection of the ingredients is the desired strength of the block. The greater the proportion of course aggregate, the greater will be the strength of the quantity of cement used. 2. Mixing of ingredients- The blending of aggregate, cement and water should be done very carefully. The mixing should preferably take place in a mechanical mixer. For hand mixing extreme care should be taken to see
  • 54.
    54 | Pa g e SAQIB IMRAN 0341-7549889 54 that the cement and aggregate are first mixed thoroughly in dry state and the water is then added gradually. 3. Placing and vibration- The mixed concrete material is fed into the mould box up to the top level and it is ensured that the box is evenly filled. The vibration of concrete is done till it has uniformly settled in the mould box. 4. Curing- The block is watered after about one day of casting and it is continued for a minimum of 7 days and preferably till 20 days. The longer the curing period the better will be the block. ADVANTAGES- The use of concrete blocks as a masonry unit can be observed on many construction sites because of the following advantages- 1. It increases the carpet area of the building of small width of concrete block as compared to the brick masonry wall. 2. It provide better thermal insulation, enhanced fire resistance and sound absorption. 3. It results in the saving of precious agricultural land which is used for the manufacturing of bricks. 4. The blocks can be prepared in such a manner that the vertical joints can be staggered automatically and thus the skilled supervision is reduced. 5. The construction of concrete block masonry is easier, faster and stronger than the brick masonry. 6. The perfect shape and size of the concrete block makes the work of a mason much simpler. 7. There is saving in construction of mortar because the numbers of joints are reduced. 8. The utility can be further increased by producing the reinforced concrete blocks (RCB) masonry units. The blocks are provided two holes for placing suitable reinforcing bars and the structure with RCB units could safely resist wind and earthquakes if so designed. The traditional beams and columns can be completely eliminated and the structure with RCB units cane be given a better appearance. USE- In view of the advantages mentioned above, the concrete block masonry technique of construction can be adopted on a large scale for mass housing and various civil engineering projects.
  • 55.
    55 | Pa g e SAQIB IMRAN 0341-7549889 55 MARKET FORMS OF STEEL Following are the standard shapes in which the rolled steel sections are available in the market- 1. Angle sections- The Angle section may be equal legs or unequal legs. The equal angle sections are available in sizes varying from 20 mm x 20 mm x 3 mm to 200 mm x 200 mm x 25 mm. The corresponding weight per meter length are respectively 9 N and 736 N. The unequal angle sections are available in sizes varying from 30 mm x 20 mm x 3 mm to 200 mm x 150 mm x 18 mm. The corresponding weight per meter length are respectively 11 N and 469 N. The angle section extensively used in the structural steel work especially in the construction of steel roof trusses and filler joist floors. 2. Channel Section- The channel section consist of a web with two equal flanges. A channel section is designated by the height of web and width of flange. These sections are available in sizes varying from 100 mm x 45 mm to 400 mm x 100 mm. The corresponding weights per metre length are respectively 58 N and 494 N. A channel section of size 300 mm x 100 mm with weight per metre length as 331 N. The Bureau of Indian Standards has classified channel sections as junior channel, light channel and medium channel and accordingly they are designated as I.S.J.C, I.S.L.C and
  • 56.
    56 | Pa g e SAQIB IMRAN 0341-7549889 56 I.S.M.C respectively. The channel sections are widely used as the structural members of the steel framed structures. 3. Expanded Metal This form of steel is available in different shapes and sizes. It is prepared from sheets of mild steel which are machine cut and drawn out or expanded. A diamond mesh appearance is thus formed throughout the whole area of the sheet. The expanded metal is widely used for reinforcing concrete in foundation, roads, bridges etc. It is also used as lathing material and for partitions. 4. Corrugated Sheets These are formed by passing steel sheets through grooves. These grooves bend and press steel sheets and corrugations are formed on the sheets. These corrugated sheets are usually galvanized and they are referred to as the galvanized sheets or G I sheets. These sheets are widely used for roof covering. 5. I- Sections
  • 57.
    57 | Pa g e SAQIB IMRAN 0341-7549889 57 These are popularly known as the rolled steel joist or beams. It consist of two flanges connected by a web. It is designated by overall depth width of flange and weight per meter length. They are available in various sizes varying from 75 mm x 50 mm at 61 N to 600 mm x 210 mm at 995 N. Joist of size 300 mm x 150 mm at 377 N. The wide flange beams are available on sizes varying from 150 mm x 100 mm at 170 N to 600 mm x 250 mm at 1451 N. The beams suitable for columns are available in H- section which vary in sizes from 150 mm x 150 mm at 271 N to 450 mm x 250 mm at 925 N. The Bureau of Indian Standard has classified the I section in to junior beams, light beams, medium beams, wide flange beams and heavy beams and they are accordingly desingated as ISJB, ISLB, ISMB, ISWB and ISHB respectively. 6. T- Sections The shapes of this section is like that of letter T and it consist of flange and web. It is desingated by overall dimensions and thickness. These sections are availble in sizes varying from 20 mm x 20 mm x 3 mm to 150 mm x 150 mm x 10 mm. The coressponding weight per meter length are 9 N and 228 N respectively. T section of size 100 mm x 100 mm x 10 mm with weight per meter length as 150 N. The special T section with unequal sides bulbs at the bottom edge of web etc are also available. These sections are widely used as members of steel roof trusses and to form built up sections. 7. Plates
  • 58.
    58 | Pa g e SAQIB IMRAN 0341-7549889 58 The plates section of steels are available in different sizes with thickness varying from 5 mm to 50 mm. The corresponding weights per square meter are 392 N and 3925 N respectively. They used mainly for the following purposes in the structural steel works.  To connect steel beams for extension of the length  To serve as tension members of steel roof truss  To form built up sections of steel 8. Ribbed Bars (HYSD Bars) These bars are produced from the ribbed which is a deformed high strength steel. These bars have ribs or projection on their surface and they are produced by controlled cold twisting of hot rolled bars. Each bars is to be twisted individually and it is tested to conform the standard requirements. These bars are also called high yield strength deformed (HYSD) bars. the ribbed bars are available in sizes varying from 6 mm to 50 mm diameter with the corresponding weight per meter length as 2.22 N and 154.10 N. These bars are widely used as reinforcement in concrete structures such as buildings, bridge, docks and harbors structures, roads, irrigation works, piles foundations, pre-cast concrete works etc. 9. Round Bars These are available in circular cross section with diameter varying from 5 mm to 250 mm. They are widely used as reinforcement in concrete structures, construction of steel grill work etc. The commonly used cross-sections have
  • 59.
    59 | Pa g e SAQIB IMRAN 0341-7549889 59 diameters varying from 5 mm to 25 mm with the corresponding weights per meter length as 1.50 N and 38 N respectively. 10. Square Bars These are available in square cross-section with sides varying from 5 mm to 250 mm. They are widely used in the construction of steel grill work for window, gates, etc. The commonly used cross-section have side varying from 5 mm to 25 mm with corresponding weight per meter length as 2 N and 49 N respectively. 11. Flat Bars These are available in suitable widths varying from 10 mm to 400 mm with thickness varying from 3 mm to 40 mm. They are widely used in the construction of steel grill work for windows and gates. 12. Ribbed mild steel Bars These are the hot rolled mild steel bars but during rolling steel rods, ribs are produced on them. These ribs increases the bond strength of bars. Such ribbed mild steel bars are not recommended in the code but are available in the market. They looks like high strength ribbed bars but the allowable stresses in these ribbed mild steel bars are much lower than the HYSD bars. Theses bars should not be used in RCC work. 13. Thermo-mechanically Treated Bars (TMT Bars)
  • 60.
    60 | Pa g e SAQIB IMRAN 0341-7549889 60 Sudden quenching of red hot steel bars by a spray of water can produce steel bars with high strength at the structure with a core of mild steel. As the core of the wire is still hot the heat inside helps in tempering the surface. The result is a structure with tempered martensite on the periphery and a fine grained ferrite pearlite at the center. The combined strength of these materials raises the yield point of steel with the high percentage of elongation at ultimate failure. TMT bars are also rolled with ribs to increase the bond strength. These are more corrosion resistance than cold twisted bars. Specially TMT-CRS (Thermo-mechanically Treated Corrosion Resistance Steel bars ) bars are also available in the market in which high corrosion resistance is achieved by adding corrosion resistant element like copper, phosphorous and chromium. These bars are produced in three grades like Fe415, Fe500, Fe550. 14. Cold Twisted Deformed Bars (CTD Bars) These were the first high strength steel bars introduced in India around 1960. These bars are first hot rolled out of high grade mild steel with three or more parallel straight ribs and other indentation on it. After cooling they are twisted by a separate operation so that the steel is stained beyond the elastic limit and then released. This operation raises the yield point of steel for subsequent tensile or compressive stresses. Thus its strength is increased. Normally welding is not in this type of steel as the strength of steel is increased due to cold working.
  • 61.
    61 | Pa g e SAQIB IMRAN 0341-7549889 61 15. Welded Wire Fabrics (WWF Bars) Welded wire fabric is fabricated from a series of wires arranged at right angles to each other and electrically welded at all intersections. It is made from medium tensile steel drawn out from higher diameter mild steel bars. It is much stronger than mild steel are available in different width rolls. Welded wire fabric has various uses in reinforeced concrete construction. It is mostly used for floor slabs on well compacted ground. Heavier fabrics supplied mainly in flat sheets, iis often also used in walls and for the primary reinforcement in structural floor slabs. It is also used in road and runway pavements, box culverts and small canal lining.
  • 62.
    62 | Pa g e SAQIB IMRAN 0341-7549889 62 CEMENT NOTES STORAGE OF CEMENT AND PRECAUTIONS TAKEN The cement should be stored carefully. Otherwise it may absorbed moisture from the atmosphere and may become useless for the structural work. Following precaution are to be taken for the storage of cement (1). Moisture: If moisture is kept away from cement, it is found that cement will maintain its quality for indefinite period. An absorption of one to two percent of moisture has no appreciable effect on quality of cement. But if moisture absorption exceeds five percent the cement becomes totally useless. Hence when cement is to be stored for a long period it should be stored in air tight containers. (2). Period of Storage: The loose cement may be stored indefinitely in air tight containers. But it is advisable to avoid storing off cement in jute bags for a period longer than three months. If it is unavoidable the cement should be tested to ascertain its properties. (3). Piles: The cement bags are stacked in piles. It is economical to form a pile of 10 bags of cement. A distance of about 300 mm should be kept between the piles of cement bags and exterior walls of building. The passages of width about 900 mm should be provided between the piles. For long storage the top and bottom of piles should be covered with tarpaulins or water proof paper. (4). Quality of Cement: The cement which is finely ground is more active and consequently it absorbs moisture rapidly from the atmosphere. Hence extraordinary precaution should be taken to store finely ground cement.
  • 63.
    63 | Pa g e SAQIB IMRAN 0341-7549889 63 (5). Removal of Cement: When cement bags are to be removed from piles of sufficient height the steps should be formed by taking out two or three bags from front piles. It is also advisable to remove cement in order of its storage period i.e. cement which is stored previously should be taken out first. In other words the rule of first in, first out should be followed. (6). Storage Sheds: For storing cement for a sufficient long period the storage sheds of special design should be constructed. The walls, roof and floor of such sheds should be of water proof construction. Few small windows should be provided and they should be kept tightly shut. The floor should be above ground. If necessary the drainage should be provided to drain water collected in vicinity of such shed. For determining the size of storage shed it is found that 20 bags or 10 bags of cement will require about 1 m3 of space. It should be noted that cement even if stored in the most favorable conditions loses its activity when stored for a long time. For instance the storage duration of 3 months and 12 months will cause a reduction in the activity of cement to the extent of about 20 percent and 40 percent respectively. Hence it is advisable to reactivate the cement stored for prolonged period. The most effective method of reacting such cement consists in vibro-grinding which ensure greater fineness and makes cement fit for use. IMPORTANT PROPERTIES OF CONCRETE The following are the important properties of concrete are to be noted by designer- 1. Through it consists of different materials like cement, sand and jelly the intimate mixture is so good that for all practical purposes it may be assumed as homogeneous. 2. For concrete characteristics strength is defined as compressive strength of 150 mm cube at 28 days in N/mm2 , below which not more than 5 percent cubes gives the result. Based on the characteristics strength concrete is graded as given below: Grades of Concrete
  • 64.
    64 | Pa g e SAQIB IMRAN 0341-7549889 64 Group Grade Designation Characteristics Strength (N/mm2 ) Ordinary Concrete M10 M15 M20 10 15 20 Standard Concrete M25 M30 M35 M40 M45 M50 M55 25 30 35 40 45 50 55 High Strength Concrete M60 M65 M70 M75 M80 60 65 70 75 80 Now a days ultra high strength of grade M500 are also produced in the laboratories amd M250 concrete has been used for the construction of some bridges. Minimum Grades of concrete for different exposure with normal weight aggregates of 20 mm nominal maximum size. S. No. Exposure Minimum Grade of Concrete 1 Mild M20 2 Moderate M25 3 Sever M30 4 Very Sever M35 5 Èxtreme M40 Stress Strain Relationship: Stress strain curve depend on strength of concrete as well as on the rate of loading. The sort term stress strain curve is to be obtained for a constant rate of straining of 0.01 percent per minute or for a constant rate of stress increases of 14 N/mm2 per minute. Tensile Strength: A designer may use the following expression for the flexceral tensile strength of concrete: Fcr = 0.7√fck N/mm2 Where fck= Characteristics compressive strength of concrete.
  • 65.
    65 | Pa g e SAQIB IMRAN 0341-7549889 65 Modulus of Elasticity: The short term modulus of elasticity for concrete may be taken as: Ec = 5000√fck Poisson's Ratio: It may be taken as 0.1 for high strength concrete and 0.2 for weak concrete. Usually it is taken as 0.15 for strength and 0.2 for serviceability calculations. Shrinkage: Total amount of shrinkage in concrete depends on the various factors including the amount of water present at the time of casting. In the absence of data the approximate value of the total shrinkage strain may be taken as 0.0003. Creep: It depends on various factors including the age of loading, duration of loading and stress level. The creep coefficient which is defined as the ratio of ultimate creep strain to elastic strain at the age of loading may be taken as shown below: S. No. Age of Loading Creep Coefficient 1 7 Days 2.2 2 28 Days 1.6 3 1 Year 1.1 SLUMP TEST FOR WORKABILITY OF CONCRETE Slump test is performed to determined the workability as well as the consistency of fresh concrete mix at the laboratory or the construction site during the progress of the work. APPARATUS:-
  • 66.
    66 | Pa g e SAQIB IMRAN 0341-7549889 66  Mould: The mould used for this test is in the form of the frustum of a cone with handles and foot pieces. It is made up of steel and also known as slump cone and Abrams cone. The dimensions of slump cone are: Tod diameter- 10 cm, Bottom diameter- 20 cm and Height- 30 cm.  Base Plate: The non porous base plate used in this test are made of steel, aluminium, polymers etc. The base plate has lifting handles for easy transportation.  Tamping Rod: The rod used in this test is made up of steel, usually 60 cm long and diameter is 1.6 cm and bullet end at one side.  Measuring Scale: A standard tape is used for measurement. PROCEDURE:-
  • 67.
    67 | Pa g e SAQIB IMRAN 0341-7549889 67  The slump cone should be thoroughly cleaned and then apply oil to it.  The base is placed on a smooth surface, set the mould on a horizontal non- porous and non absorbent base plate.  Fill the mould fully by pouring freshly mixed concrete in four equal layers each with an approximate height of 1/4th of mould.  Each layer is tamped 25 times by tamping rod in a uniform manner over the cross section of the mould.  After completely filling the mould excess concrete should be removed and surface should be leveled with a trowel.  Now lift the mould slowly and carefully in the vertical direction without disturbing the concrete cone. It undergoes some subsidence which is called slump.  Use the measuring scale to measure the difference level between the height of the mould and the sample of concrete. TYPES OF CONCRETE SLUMP:-  True Slump: After the test when the concrete mass sliding equally throughout the cone with out disintegration then it is treated as the true slump.
  • 68.
    68 | Pa g e SAQIB IMRAN 0341-7549889 68  Zero Slump: For very dry and high stiff concrete does not show any difference after removing the mould. It is the indication of very low water- cement ratio.  Collapsed Slump: When the concrete mass collapsed due to very high water-cement ratio then it is called as collapsed slump.  Shear Slump: When half of the concrete mass slides down in a inclined plane then this is known as shear slump. This type of slump is obtained in a lean concrete mix. CLASSIFICATION OF CONCRETE MIXES:- S. No. Slump Nature of Concrete Mix 1 No Slump Stiff and extra stiff mix 2 From 10 mm to 30 mm Poorly mobile mix 3 From 40 mm to 150 mm Mobile mix 4 Over 150 mm Cast mix RECOMMENDED SLUMPS OF CONCRETE:- S. No. Types of concrete Slump 1 Concrete for road construction 20 – 40 mm 2 Concrete for tops of curbs, parapets, piers, slabs and walls that are horizontal 40 – 50 mm 3 Concrete for canal linings 70 – 80 mm
  • 69.
    69 | Pa g e SAQIB IMRAN 0341-7549889 69 4 Concrete for arch and side walls of tunnels 90- 100 mm 5 Normal R.C.C. work 80 – 150 mm 6 Mass concrete 25 – 50 mm 7 Concrete to be vibrated 10 – 25 mm LIMITATIONS OF SLUMP TEST:- 1. It is not suitable for concrete in which maximum size of aggregate exceeds 40 mm. 2. The slump occurs only in case of plastic mixes, not occurs in case of dry mixes Different Codes- ASTM C143- United States IS:1199-1959- India EN 12350-2- Europe PROPERTIES OF CEMENT CONCRETE Following are the important properties of cement concrete- (1). Concrete has high compressive strength. (2). It is free from corrosion and there is no appreciable effect of atmospheric agents on it. (3). Its hardens with age and the process of hardening continues for a long time after the concrete has attained sufficient strength. It is the property of cement concrete which gives it a distinct place among the building materials. (4). It is proved to be more economical than steel. This is due to the fact that sand and pebbles or crushed rock, forming the bulk of cement concrete, to the extent of about 80-90 % are usually available at the moderate cost. The formwork which
  • 70.
    70 | Pa g e SAQIB IMRAN 0341-7549889 70 is of steel or timber can be used over and over again of for other purposes after it is removed. (5). It binds rapidly with steel and as it is weak in tension, the steel reinforcement is placed in cement concrete at suitable place to take up the tensile stress. This is termed as the reinforced cement concrete or simply R.C.C. (6). Under the following two conditions it has tendency to shrink. There is initial shrinkage of cement concrete which is mainly due to the lose of water through forms, absorption by surface of forms etc. The shrinkage of cement concrete occurs as it hardens. This tendency of cement concrete can be minimized by proper curing of concrete. (7) It has tendency to be porous. This is due to the presence of voids which are formed during and after its placing. The two precaution necessary to avoid this tendency are as follows: There should be proper grading and consolidating of its aggregates. The minimum water cement ratio should be adopted. (8). It forms a hard surface, capable of resisting abrasion. (9). It should be remembered that apart from other materials, the concrete comes to the site in the form of raw materials only. Its final strength and quality depends entirely on local conditions and persons handling it. However the materials of which concrete is composed may be subjected to rigid specifications.
  • 71.
    71 | Pa g e SAQIB IMRAN 0341-7549889 71 CONSTRUCTION EQUIPMENTS TYPES OF CONSTRUCTION EQUIPMENTS Construction equipment can be categorized as follows- A. EARTH MOVING EQUIPMENT 1. Excavators 2. Graders 3. Loaders 4. Skid loaders 5. Crawler loader 6. Back hoe 7. Bulldozers 8. Trenchers 9. Scrapers 10.Shovels B. MATERIAL HANDLING EQUIPMENT 1. Crane
  • 72.
    72 | Pa g e SAQIB IMRAN 0341-7549889 72 2. Conveyors 3. Hoist 4. Forklifts C. CONSTRUCTION EQUIPMENT 1. Concrete Mixers 2. Compactors 3. Pavers 4. Road Rollers D. CONSTRUCTION VEHICLE 1. Tippers 2. Dumpers 3. Trailers 4. Tankers E. TUNNELING EQUIPMENT 1. Road Headers 2. Tunnel boring machine F. OTHER CONSTRUCTION EQUIPMENT CONSTRUCTION TOOLS AND THEIR USES 1. HOE: A hoe is a tool used to digging soil and to place cement mortar, concrete in head pan.
  • 73.
    73 | Pa g e SAQIB IMRAN 0341-7549889 73 2. PICK AXE: It is a hand tool with hard metal head and wooden handle. This tool is used to excavate the soil. It is more suitable for hard soil which is quite difficult to dig with spade or hoe. 3. SPADE: A spade is tool contains metal plate at the end of long wooden handle. It is used to dig the soil for foundation trenches etc. 4. DIGGING BAR: A digging bar is a long straight solid metal rod with pin shape at the bottom used to dig the hard surfaces of ground. 5. MEASURING BOX:
  • 74.
    74 | Pa g e SAQIB IMRAN 0341-7549889 74 Measuring box is used to measure the quantity of cement, sand and aggregates used for making concrete mix. The volume of measuring box is generally 1 cum feet which makes it easy to measure concrete ratio. The general dimensions of measuring box are 300 x 300 x 400 mm. 6. HEAD PAN: Head pan is commonly used in construction sites made of iron or plastic. It is used to lift excavated soil or cement or concrete to the working site. 7. MASONRY TROWEL: The masonry trowel is used in brick work or stone work spreading, leveling and shaping mortar or concrete. It is made up of steel and wooden handle is provided for holding. The ends of trowel may be pointed or bull nosed. 8. FLOAT:
  • 75.
    75 | Pa g e SAQIB IMRAN 0341-7549889 75 It is made up of wood contains handle on its top and smooth surface on its bottom. Float is used to give a smooth finish to the plastered area. 9. WHEEL BARROW: A wheel barrow is a small hand propelled vehicle with one wheel designed to be pushed by a single person using two handle at the rear. It is used to transport bulk weight of materials like cement, sand, mortar, concrete etc. 10. PLUMB BOB: A plumb bob is a weight with pointed tip at the bottom, suspended from a string and used as a vertical reference line or plumb line. It is used to check verticality of structures. It is also used in surveying to level the instrument position. 11. CONCRETE MIXER:
  • 76.
    76 | Pa g e SAQIB IMRAN 0341-7549889 76 A concrete mixer is a device that homogeneously mixes cement, aggregates such as sand or gravels and water to form concrete. A typical concrete mixer uses a revolving drum to mix the components. 12. CROWBAR: Crow bars are commonly used to open nailed wooden crates, remove nails, or pry apart board. 13. BRICK HAMMER: Brick hammer has one flat traditional face and a short or long chisel shaped blade. It is used to cut the bricks and also used to push the bricks if they come out from the course line. 14. CHISEL: A chisel is a tool that has a long metal blade with a sharp edge at the end and a handle which is struck with a hammer or mallet. It is generally used in wood work and must be useful to remove the concrete bumps or excess concrete in
  • 77.
    77 | Pa g e SAQIB IMRAN 0341-7549889 77 harden surface. 15. LINE AND PINS: A line pin is a metal rod usually with a pointed, leaf shaped blade and and a flat button head. Lines are typically found in pairs as they are commonly used as anchor points for a brick line. It is used to level the alignment of bricks course while brick laying. 16. MEASURING TAP: It is a common measuring tool consist of a ribbon of clothe, plastic, fiber glass or metal strip with linear measurement marking. It is used to check the thickness, length, widths of masonry walls, foundation beds, excavated trenches etc. 17. RUBBER BOOTS:
  • 78.
    78 | Pa g e SAQIB IMRAN 0341-7549889 78 Safety rubber boots are required to protect legs may have damaged due to contact with chemical materials like cement or physical accidents during the construction work. 18. GLOVES: Gloves are required to prevent the hands from direct contact with cement, paints etc. and to avoid injury while using machines, tools etc. Gloves made from lather, cotton, synthetic, nitrile, latex, PVC or combinations of these. 19. HAND SAW: Hand saw is used to cut wood materials like doors, windows etc. 20. LADDER: A ladder is a vertical or inclined set of rugs or steps. It is also required in construction works to check the slab work, to transport material to the higher
  • 79.
    79 | Pa g e SAQIB IMRAN 0341-7549889 79 floor, to paint the walls etc. 21. TILE CUTTER: Tile cutters are used to cut the tiles to a required shape and size. Sometimes normal size of tiles is larger than the size required at the corners where the floor meets the wall in that case tile cutter is useful. 22. PUTTY KNIFE: Putty knife is used to level the putty finishing and also used to reduce the thickness of finish when it is more thick. 23. DRILL MACHINE: Drill machine is used to make holes in the walls, slabs, doors, window frames etc. 24. JACK PLANE:
  • 80.
    80 | Pa g e SAQIB IMRAN 0341-7549889 80 Jack plane is used in the wooden work to smoothen the surface of doors, windows etc. 25. MASON SQUARE: Mason square is used to achieve perfect right angle at the corner of masonry wall. It is L shaped. First course is laid properly using mason square then based on first, remaining layers of bricks are set out. 26. MEASURING WHEEL: Measuring wheel is used to measure the distances or lengths. It contains a wheel of known diameter which record the number of complete revolutions from which distance can be measured. It makes the work easier. 27. EARTH RAMMER:
  • 81.
    81 | Pa g e SAQIB IMRAN 0341-7549889 81 An earth rammer is a hand tool consist of big square shaped block with handle. Sometimes it is also called tamper. It is used in construction industries to compress or compact earth or soil. The earth rammer creates a solid, compacted layer of earth by compressing the soil repeatedly with its weight. 28. SAFETY GLASSES: Safety glasses should be used to protect the eye from dust, chemical action of materials etc. 29. SAFETY HELMET: The safety helmet is regarded one of the basic safety device required for workers in several industrial and construction related sectors in addition to industries likes mining's, petroleum, refineries and so on. If any material for structure may fall from height during construction work, it protects the head from injury or any fatal accident. 30. SCRATCHER:
  • 82.
    82 | Pa g e SAQIB IMRAN 0341-7549889 82 Plastering of a surface is carried out layer wise, minimum two layer are necessary for plastering. To provide a good bond between the old and new layer, old layer is scratched with the help of tool called scratcher. 31. SAND SCREEN MACHINE: The sand screen machine is used to screen the sand or fine aggregate before mixing it with concrete. It should remove the impurities and coarse particles from sand. 32. SPIRIT LEVEL: A spirit level is an instrument designed to indicate whether a surface is horizontal or vertical. It is made up of wood or hard plastic with bubble tube in the middle which is partially filled with alcohol so the air bubble is formed in it. It is used in brick masonry, plastering, flooring and tile work to check the horizontal level of surface. The surface is leveled if the air bubble settles at the middle of the tube. 33. POLISHER:
  • 83.
    83 | Pa g e SAQIB IMRAN 0341-7549889 83 A polisher is a device used to smoothen the rough surfaces of tiles, marble, wood works etc. The smoothening makes them shine and the process is called polishing. 34. BUMP CUTTER: A bump cutter is a tool used to leveled the fresh concrete surfaces likes concrete floors, foundations, pavement etc. This is also called screed. 35. CIRCULAR SAW: Circular saw is used to cut wood boards, frames etc. It is used when accurate cutting is required in less time. It is safer then hand saw. 36. FRAMING HAMMER:
  • 84.
    84 | Pa g e SAQIB IMRAN 0341-7549889 84 Framing hammer is used to used to drive and remove nails. 37. VIBRATOR: A concrete vibrator is a construction tool typically used on construction pouring sites. The vibrators are used to ensure that the pour is free of air bubbles and are even. This is so that the concrete remains strong and has a smooth finish even after removal of the form work. LIST OF EQUIPMENT USED IN ROAD CONSTRUCTION PROJECTS (A). PNEUMATIC TOOLS: 1. Air Compressor 2. Rock drill/ Jack hammer/ Steel drill/ Wood drill 3. Concrete Breaker 4. Asphalt Cutter 5. Rock Splitter 6. Compacter 7. Impact Wrenches/ Nail Driver 8. Grinder 9. Concrete Vibrators 10.Backfill Tamper 11.Circular Saw/ Chain Saw 12.Road Broom (B). ROCK CRUSHER: 1. Jaw Crusher, Double Roll Crusher, Cone Crusher, Hammer Mill 2. Screens 3. Conveyors
  • 85.
    85 | Pa g e SAQIB IMRAN 0341-7549889 85 (C). ASPHALT PLANT: 1. Central Mix Plant 2. Hot oil Heater 3. Asphalt Melter 4. Bitumen Distributer 5. Asphalt kettle/ Bitumen Heater 6. Portable Mix Plant 7. Pavers 8. Rotary Sweeper 9. Aggregate Speader (D). CONCRETE PLANT: 1. Aggregate Batching Plant 2. Concrete Mixer 3. Concrete Pavers 4. Concrete Vibrator 5. Concrete Saw 6. Portable Concrete Curing Machine (E). EARTH MOVING EQUIPMENT: 1. Dozer 2. Loader/ Shovel 3. Excavator/ Backhoe 4. Scraper 5. Grader 6. Hauler (F). COMPACTION EQUIPMENT: 1. Sheep foot Roller, Tamping Roller 2. Steel Wheel Vibratory Roller 3. Steel Wheel Static Roller 4. Pneumatic Roller 5. Plate Compactor/ Rammer (G). ANCILLARY EQUIPMENT: 1. Water Distributer 2. Rotary Tiller Mixer 3. Portable Electric Generator 4. Welding Generator
  • 86.
    86 | Pa g e SAQIB IMRAN 0341-7549889 86 5. Crane 6. Pile Driver 7. Water Pump 8. Boring Ring 9. Fork Lift 10.Trucks Flat Bed 11.Low Bed Transporter EARTH COMPACTING EQUIPMENTS- TYPES OF ROLLERS Following are the equipments used for the compaction of earth: 1. Smooth Wheel Roller 2. Sheep Foot Roller 3. Pneumatic Roller 4. Tamping Roller 5. Grid Roller 6. Vibratory Roller 1. SMOOTH WHEEL ROLLER:  This types of roller incorporates a large steel drum at the front and one or two wheels or drums at the rear.  If their is one wheel at the rear they are known as Tandem roller, and Three wheeled roller if there are two wheels at the rear.  The weight of tandem roller varies from 2-8 tonnes and three wheeled roller varies from 8-10 tonnes.
  • 87.
    87 | Pa g e SAQIB IMRAN 0341-7549889 87  The ground pressure exerted by tandem roller is typically around 10-17 kg/cm2.  The weight of roller increased by blasting with sand, water or pig iron.  Smooth wheel roller are most suitable for consolidating stone, gravel, sand, hardcore and ballast but are not suitable for embankments, soft sub-grades or uniform sand.  The Speed and number of passes of a smooth wheel roller depends on the types of soil to be compacted and project requirements.  The optimum working speed has found to be 3-6 km/h and about 8 passes are adequate for compacting 20 cm layer.  The smooth wheel roller leaves the surface smooth after compaction. 2. SHEEP FOOT ROLLER:  Sheep foot roller consist of a steel drum on which round or rectangular protrusions known as lugs or feet are fixed.  There are different types of lugs such as spindle shaped with widened base, prismatic and clubfoot.  Sheep foot roller are used for compacting fine grained soil such as heavy clay and silty clay. They are used for compaction of soils in dam, embankments, sub-grade layers in pavements and rail road construction projects.  Coverage area of sheep foot roller is less about 8-12 % because of the boots on drums.  Contact pressure of this type roller varies from 1200-7000 Kpa.  Area of each protrusions in sheep foot roller varies from 30-80 cm2.
  • 88.
    88 | Pa g e SAQIB IMRAN 0341-7549889 88  Generally 10-20 passes are required to provide complete coverage on the soil and top layer of consolidated soil finished by smooth wheel roller. Factors that governs the amount of compaction of soil are- 1- Weight of roller 2- Area of each lugs 3- No. of lugs in contact with the ground 4- No. of lugs per drum 3. PNEUMATIC ROLLER:  Pneumatic roller consist of a heavily loaded wagon with with several rows of closely spaced tyres. They are also known as rubber tyred roller.  They provide uniform contact pressure through out the width covered and are often used in pavement sub-grade works.  They are suitable for compacting uniform coarse soil and rock. They are also used to finish embankment compacted by sheep foot roller.  The factors which affect the amount of compaction that can be achieved are the weight, tyre inflation pressure and the area of contact.  Coverage area of pneumatic roller is about 80%.  Contact pressure of pneumatic roller ranges from 500-700 Kpa.  The optimum speed of roller is between 6-24 km/h and maximum density can be achieved by 8 passes of the roller.  The gross weight of roller 6-10 tonnes which can be increased to 25 tonnes by ballasting. 4. TAMPING ROLLER:
  • 89.
    89 | Pa g e SAQIB IMRAN 0341-7549889 89  The tamping rollers are similar to sheep foot roller.  Tamping roller consist of four wheels and one each wheel kneading boots/feet are fixed.  These roller also consist of leveling blades to spread the material.  Tamping roller has more coverage area about 40-50%.  Contact pressure of tamping roller varies from 1400-8500 Kpa.  Tamping roller is best dedicated for fine grained soils.  Tamping roller have static weight in the range of 15-40 tonnes and their static linear drum loads are between 30-80 kg/cm.  The degree of compaction achieved is more than sheep foot roller and density achieved by tamping roller after compaction is more uniform. 5. VIBRATORY ROLLER:  Vibratory roller have fitted with one or two smooth surfaced steel drums measuring 0.9-1.5 in diameter and 1.2-1.8 in width.
  • 90.
    90 | Pa g e SAQIB IMRAN 0341-7549889 90  The drum vibrates by the rotation of an electric shaft inside.  Vibratory roller are commonly used for compacting granular base course and some times for asphalt.  Tamping roller have higher output and improved performance compared to other rollers. 6. GRID ROLLER:  Grid roller have a cylindrical heavy steel surface comprising a network of steel bars which form a grid with square shaped holes.  They are typically used for the compaction of well graded coarse soil and weathered rocks, often in sub-grades and sub-base road projects.  They are not suitable for clayey soil, silty clay or uniform soil.  The weight of grid roller con be increased by ballasting with concrete blocks.  Typical weight of grid roller vary between 5.5 tonnes net and 15 tonnes ballasted.  This roller provides higher contact pressure but little kneading action. BULL DOZERS
  • 91.
    91 | Pa g e SAQIB IMRAN 0341-7549889 91 These versatile equipments are commonly used in construction projects. It is essentially a heavy steel blade which is mounted on the front of a tractor. The tractor can be of the crawler or the wheel type. The heavy blade attached to the tractors pushes the material from one place to another. Bull dozers are classified on the basis of: (A). Position of blades: 1. Bull dozers with blades perpendicular to the direction of movement. 2. Angle dozers in which the blade is set at an angle with the direction of movement (B). Based on mountings: 1. Wheel mounted 2. Crawler mounted (C). Based on the control: 1. Cable controlled 2. Hydraulically controlled The earth moving bull dozer consist of a heavy blade of somewhat concave profile. The blade is attached to the body of the tractor with two arms and a supporting frame. The blade is held at the lower edge on the two heavily built push arms which are hinged to the track frame of the tractor. The top of the blade is supported by two brace arms attached to the push arms. The blade is projecting ahead at the bottom.
  • 92.
    92 | Pa g e SAQIB IMRAN 0341-7549889 92 Application-  Bull dozer are mainly used for the following operations-  For spreading the earth fill  For opening up pilot roads through mountainous and rocky terrains  Clearing construction sites  Maintaining haul roads  Clearing land from the trees and stumps  Back filling trenches at construction sites by dragging the earth from one place to another. COMPONENTS OF A CITY ROAD The following technical terms should be clearly understood before making detailed study of a road construction. 1. RIGHT OF WAY- The area of land acquired for construction and future development of a road symmetrical about the central alignment is called right of way. The width of these acquired land is known as land width and it depends upon the importance of the road and possible future development. 2. FORMATION WIDTH- The top width of the highway embankment or the bottom width of highway cutting excluding the side drains is called formation width or road way. The
  • 93.
    93 | Pa g e SAQIB IMRAN 0341-7549889 93 formation width is the sum of widths of pavements of carriage way including the separators and width of the shoulders on either side of the carriage way. 3. CARRIAGE WAY- The portion of the road surface which is used for vehicular traffic is known as carriage way or pavement. The width of carriage way depends upon the width and number of lanes. For single lane roads the width of pavement is generally kept 3.75 m. 4. CROWN- The highest point on the road surface is called crown. 5. CAMBER OR CROSS SLOPE- The rise of the center of the carriage wway about its edges along the straight portion of a road is called camber or cross slope. The transverse slope of the pavement is provided for the drainage of rainwater. The amount of camber for the roads is decided according to the road surface and the amount of rainfall. 6. SEPARATOR OR DIVIDER- The narrow continuous structure provided for dividing the two directions of the traffic flow is known as separator or divider. 7. SHOULDERS- The portion of the roadway between the outer edges of the carriage way and edge of the top surface of the embankment or inner edge of the side drains in cuttings of the roads are called shoulders. The shoulders are generally in level with road surface having a slope towards drain side. The shoulders and foot path prevent the edge of the road from wear and tear. The minimum shoulder width recommended by IRC is 2.5 m. 8. KERBS- The boundaries between the pavement and shoulder of foot path are known as kerbs. These are also provided between the pavement and the traffic separator or divider. It is desirable to provide kerbs on urban roads. 9. SIDE SLOPES- The slopes of the sides of earth work of embankment and cutting to ensure their stability are called side slopes. The embankment is generally given a side slope of 1:1.5. 10. BERMS- The width of the land left in between the toes of the embankment and the inner edges of the borrow pits is called berms.
  • 94.
    94 | Pa g e SAQIB IMRAN 0341-7549889 94 LOW COST BUILDING MATERIAL AND TECHNIQUES 1. RAT TRAP BOND The rat trap bond is a masonry technique, where the bricks are used in a way which creates a cavity within the wall, while maintaining the same wall thickness as for a conventional brick masonry wall. While in a conventional English bond or Flemish bond, bricks are laid flat, in a Rat trap bond, they are placed on edge forming the inner and outer face of the wall, with cross bricks bridging the two faces. The main advantage of Rat-trap bond is reduction in the number of bricks and mortar required as compared to English/ Flemish bond because of the cavity formed in the wall. The cavity also makes the wall more thermally efficient. This also reduces the embodied energy of brick masonry by saving number of bricks and the cement-sand mortar. It is suitable for use, wherever one-brick thick wall is required. Since its original dissemination in Kerala in the 1970sby architect Laurie Baker, rat trap bond has been extensively used in every category of building from large institutional complexes, community buildings. Government offices/village panchayats, individual homes both for high income and middle income and also in government supported EWS housing programmes. 2. FILLER SLAB
  • 95.
    95 | Pa g e SAQIB IMRAN 0341-7549889 95 Filler slab is a variation of conventional reinforced cement concrete slab in which part of the concrete is replaced with a filler material which can be a waste material to ensure economical advantage over an RCC slab. The basic principle in a filler slab is that, considering an RCC slab of a given thickness, the concrete in the bottom half of the slab is simply dead weight and does not play a role in taking up compressive load, which is normally taken up by concrete in an RCC slab. So, this concrete can be replaced by a suitable lightweight filler material which can be accommodated in the bottom half of the slab. Since it reduces the weight of the slab by replacing concrete, savings can also be achieved in quantity of steel reinforcement without any compromise on the quality and strength of the slab. The filler materials commonly used are burnt clay tiles (such as Managalore tiles), bricks, coconut shells, terracotta pots etc. The filler slab was first popularized by architect Laurie Baker in India in the late 70s and subsequently promoted by HUDCO through its national network of building centres. It has been successfully tested for structural performance by the Research and Development laboratory by the Civil engineering department of Anna University , Chennai 3. MICRO CONCRETE ROOFING TILES
  • 96.
    96 | Pa g e SAQIB IMRAN 0341-7549889 96 Micro-concrete roofing (MCR) tiles are used as a cladding material for construction of sloping roofs. They are 10mm thick and basically made up of a plain cement concrete which uses stone aggregate of less than 6 mm size. The concrete mix is well compacted through optimum vibration provided by an electric vibrator. These tiles derive their strength primarily from their shape and a very low water cement ratio used during production. When the tile is produced on a vibrating table top, it is flat. The tiles are moulded to their standardized profile after they are transferred to a plastic mould. The profile of the tiles is such that it enables overalp between adjacent tiles to prevent water leakage. The effective dimensions of the tiles (after overlap) are 400mm x 200mm, with 13 tiles needed for 1 m2 of roof area. The production package available for the tiles has been specially designed to provide a compact work-station with an integrated vibrating table to compact the tiles. MCR tiles can be laid over a variety of under- structures like trusses, rafters and purlins, made with steel, timber or even bamboo. Tiles of two profile types- Pan (curved) and Roman (flat) can be made using the production equipment. 4. FUNICULAR SHELL ROOF
  • 97.
    97 | Pa g e SAQIB IMRAN 0341-7549889 97 Masonry arches, vaults and domes have a long history of use in India over centuries and many of them have stood the test of time. Following the same principle, funicular shells can also be constructed as roofs or even intermediate floors. Funicular Shell Roof is a system comprising of two components – a doubly curved (curved in both directions, like a dome) shell and a reinforced concrete supporting beam around the perimeter of the shell. The curvature of the roof is such that the rise of the roof at its centre is shallow – generally 150-200mm - which can easily be filled up to create a flat surface, if needed in case of an intermediate floor. Generally, this system is advantageous for roofs which can be sub-divided into smaller sections using a grid of RCC beams, like a coffer slab. Each of these smaller sections can then be spanned by a separate funicular shells. Each of the beams can be partially cast before the shells are constructed and fully cast together with the shell. This roof is a very good option for areas where waste stone pieces can be accessed from stone polishing & cutting units and used in constructing the shell. The significant reduction in steel for slab construction and the creation of beautiful patterns using stone waste of different colours and bricks are special features of this technology. Anangpur Building Centre in the NCR region developed a funicular shell based roofing system and used it extensively in various projects. 5. PRECAST CONCRETE BLOCK MASONRY
  • 98.
    98 | Pa g e SAQIB IMRAN 0341-7549889 98 Concrete has a wide application in construction across various parts of a building – from foundation to columns to roof, because it can be formed into various shapes. Concrete blocks are precast masonry units which are rectangular in shape and made with plain cement concrete of a lean mix-proportion that ranges from 1:9 to 1:13 (1 part of cement: 13 parts of sand and stone aggregates). In addition to the basic components, the concrete for making blocks may also contain additives like admixtures to increase compressive strength, or improve workability. They have also been produced with improved textures for better durability and appearance using stone ships or glazed surfaces. Concrete blocks have been in use in India for nearly three decades and are commonly found in all parts of the country- both rural and urban. They also owe their popularity to the fact that speed of construction is enhanced since the blocks could be 5-10 times bigger than burnt bricks. Commonly available dimensions are length 200-400mm, width 100 or 200mm and height 150-200 mm. Both solid and hollow blocks are made – generally hollow blocks are used for partition walls. Various machines are available in the country for concrete block production 6. PRECAST RCC PLANK AND JOIST This is a system which uses precast concete elements to construct a roof which can also be used as an intermediate floor. It consists of two main elements – 1. the plank which represents smaller sections of the slab and therefore of reduced
  • 99.
    99 | Pa g e SAQIB IMRAN 0341-7549889 99 thickness and reinforcement, and 2.Joist which is a beam spanning across the room to provide bearing for the planks. The joist is partially precast, with the remaining portion being cast in-situ after the planks are installed. The planks can be made in standard sizes of 0.3m x 1.5m and the joists can be 0.15m x 0.15m in size for a roof span upto 4 metres. The planks are supported over partially precast RC joists side by side and then joined together with in-situ concrete poured over the entire roofing area. Monolithic action of the slab elements is enhanced by leaving reinforcement hooks projecting out of joists and providing nominal reinforcement over the planks, before the in-situ concrete is poured. The technique has been developed by the Central Building Research Institute (CBRI) and validated by the BMTPC (Building Materials and Technology Promotion Council). The technique can be easily adapted by masons who are familiar with the similar technique of placing stone slabs over girders to construct roofs. Both elements of the roof – planks and joists can be manually produced at site using a wooden moulds. Alternatively, given the context of a large scale use such as housing project, they can be produced in a small enterprise mode using steel moulds mounted on vibrating tables. The technique has successfully been used in many rural housing projects and EWS housing developments. 7. STABILIZED EARTH BLOCK Earth is one of the oldest and the most abundantly available building material and there are many examples all over the world which prove the durability of well constructed earthern buildings. There are many techniques of building with earth such as making masonry blocks out of earth, or making monolith earth walls by ramming. Stabilized Compressed Earth Blocks (SCEB), are an improved version of earth based masonry units. These masonry blocks are made by compressing
  • 100.
    100 | Pa g e SAQIB IMRAN 0341-7549889 10 0 earth/ soil by simple mechanical means. Although block production is feasible using a wide variety of soils, understanding type of soil available for SCEB is one of the most important aspects – generally sandy clay is the most appropriate. A small percentage of stabilizer – most commonly 5-7% cement is added to the soil mix to increase strength of blocks and their resistance to water. Several block presses, both manual and mechanized types, have been developed by various institutions and are available to produce blocks of various sizes. The thickness of walls made with SCEB are generally close to 230mm conventional burnt clay masonry. The distinct advantage of these blocks are their uniform sizes and good finish which should be left unplastered externally, provided the building design takes into account basic features of protection from water. This technology is also very amenable to local employment generation through a block production enterprise.
  • 101.
    101 | Pa g e SAQIB IMRAN 0341-7549889 10 1 FOUNDATIONS, DAMS AND ART DESIGN TYPES OF FOUNDATION Foundation is structural part of a building on which a building stands. Foundation transmit and distributes it on load or imposed load to the soil in such a way that the load bearing capacity of the foundation bed is not exceeded. The solid ground on which the foundation rest is called foundation bed. There are various types of foundation. FUNCTIONS OF FOUNDATION  Distribution of loads  Stability against sliding and overturning  Minimize differential settlement  Safe against undermining  Provide level surface  Minimize distress against soil movement CLASSIFICATION OF FOUNDATIONS 1. Shallow Foundation 2. Deep Foundation 1. SHALLOW FOUNDATION A shallow foundation is a type of foundation that transfer load to the very near the surface. Shallow foundation are those foundation in which the depth at which foundation is placed is less than the width of the of foundation (D<B). This foundation used when the surface soil are sufficiently strong and stiff to support the imposed load. They are generally unsuitable in weak and highly compressible soil. Shallow foundation itself can be various types-  Pad Footing or Column Footing
  • 102.
    102 | Pa g e SAQIB IMRAN 0341-7549889 10 2 1. Isolated Footing 2. Combined Footing  Cantilever or Strap Footing  Mat/ Raft Footing  Wall Footing 2. DEEP FOUNDATION Deep foundation are those foundations in which the depth of the depth of foundation is greater than its width (D>B). The D/B ratio is usually 4-5 for deep foundation. The deep foundation transmits the load of the super structure vertically to the rock strata lying deep. Deep foundation are used when the shallow foundation can not support the load of the structure. The deep foundation can be further classified into following types-  Pile Foundation  Pier Foundation  Well (Caissons) Foundation TYPES OF SHALLOW FOUNDATION A shallow foundation is a type of foundation that transfer load to the very near the surface. Shallow foundation are those foundation in which the depth at which foundation is placed is less than the width of the foundation (D<B). This foundation used when the surface soil are sufficiently strong and stiff to support the imposed load. They are generally unsuitable in weak and highly compressible soil. DIFFERENT TYPES OF SHALLOW FOUNDATIONS 1. Isolated footing 2. Combined footing 3. Strap or Cantilever footing 4. Strip footing 5. Mat/ Raft footing 1. ISOLATED FOOTING
  • 103.
    103 | Pa g e SAQIB IMRAN 0341-7549889 10 3 Spread footing provided to the column of a framed structure is called isolated footing, column footing or pad footing. A isolated footing is circular, square or rectangular slab of uniform thickness. Sometime it is stepped or haunched to spread the load over a large area. Square column footing are the most economical but space restriction between adjacent column in a specific direction may warrant rectangular column footing. Circular footing is not common and may be used for circular column as the construction of form work and concreting may be more difficult for them then for square or rectangular footings. 2. COMBINED FOOTING A combined footing supports two columns. It is used when the two columns are so closed to each other that their individual footing would overlap. A combined footing is also provided when the property line is so close to one column that a spread footing would be eccentrically loaded when kept entirely with in the property line. By combining it with that of an interior column the load is evenly distributed. A combined footing may be rectangular or trapezoidal in plan. 3. STRAP OR CANTILEVER FOOTING
  • 104.
    104 | Pa g e SAQIB IMRAN 0341-7549889 10 4 A strap footing consist of two isolated footing connected with a structural strap or a lever. The strap connects the two footing such that they behave as one unit. The strap is designed as a rigid beam. The individual footings are so designed that their combined line of action passes through the resultant of the total load. A strap footing is more economical than a combined footing when the allowable soil pressure is relatively high and the distance between the column is large. 4. STRIP FOOTING A strip footing is provided for a load bearing walls. A strip footing is also provided for a row of columns which are so closely spaced that their spread footing overlap or nearly touch each other. In such a case it is more economical to provide a strip footing than to provide a number of spread footings in one line. A strip footing is also known as continuous footing or wall footing. Strip footing is the first and most conventional footing used in the history of civil engineering and may be constructed of stone masonry or concrete. 5. MAT/ RAFT FOOTING
  • 105.
    105 | Pa g e SAQIB IMRAN 0341-7549889 10 5 Raft foundation are used to spread a load from a structure over a large area normally the entire area of the structure. They are used when column load or other structural loads are close together and individual pad foundations would interact. A raft foundation normally consist of a concrete slab which extend over the entire loaded area. It may be stiffened by ribs of beams. Raft foundation have the advantage of reducing differential settlement as the concrete slab resist differential movement between loading positions. They are often needed on soft or loose soil with low bearing capacity as they can spread the load over the large area. ISOLATED FOOTING The isolated footing is one of the most popular, economical and simplest type of foundation used world wide. An isolated footing is used support a single column. These are independent footings which are provided for each column. This types of footing used when- 1. Columns are closely spaced 2. Load on footing are less 3. The Safe bearing capacity of soil is high. TYPES OF BOTTOM SLABS An isolated footing essentially consist of a bottom slab.There are three types of bottom slabs as follows-
  • 106.
    106 | Pa g e SAQIB IMRAN 0341-7549889 10 6 1. Pad Footing 2. Stepped Footing 3. Slopped Footing DIFFERENT SHAPES IN PLAN Isolated footing can have different shapes in plan, generally it depends up on the shape of cross-section of the column. Some of the popular shapes in the plan of the footing are- 1. Square Footing 2. Rectangular Footing 3. Slopped Footing STEPS TO CONSTRUCT AN ISOLATED FOOTING
  • 107.
    107 | Pa g e SAQIB IMRAN 0341-7549889 10 7 1. Positioning footing location 2. Earth excavation 3. Preparing the base 4. Making form-work 5. Placing reinforcement 6. Proving cover block 7. Placing column reinforcement 8. Pouring concrete 9. Removing form-work 10.Back filling CLASSIFICATION OF DAM Dams can be classified in number of ways. But most usual way of classification of dam are mentioned below- Based on Structural Behavior- Gravity Dam- These are the dam which resist the horizontal thrust of water entirely by their own weight. Arch Dam- These are designed so that the force of water against it known as hydro-static pressure presses against the arch compressing and strengthening the structure as it pushes into its foundation or abutment. Buttress Dam- A buttress dam or hollow dam is a dam with a solid water tight upstream side that is supported at intervals on the downstream side by a series of buttress or support. Embankment Dam- These are typically created by the placement and compaction of a complex semi plastic mound of various compositions of soil, sand, clay and rock
  • 108.
    108 | Pa g e SAQIB IMRAN 0341-7549889 10 8 Based on Function of Dam- Storage Dam- They are constructed to store water during the rainy season when there is a large flow in the river. Detention Dam- Detention dam are constructed for flood control. A detention dam retards the flow in the river on its downstream during floods by storing some flood water. Diversion Dam- A diversion is constructed for the purpose of diverting water of the river in to an off taking canal. Debris Dam- A debris dam is constructed to retain debris such as sand, gravel and drift wood flowing tin the river with water. Coffer Dam- It is an enclosure constructed around the construction site to exclude water so that the construction can be done in dry. Based on Material Used- Rigid Dam- These types of dams are those which are constructed of rigid materials like masonry, concrete, steel, timber etc. Masonry Dam- These are made out of masonry mainly stone and brick sometimes joined with mortar. Steel Dam- A steel dam consist of a steel frame work with a steel skin plate on its upstream face. Timber Dam- Main load carrying structural element of timber dam are made of wood primarily coniferous varieties such as pine and fir. Non Rigid Dam- These types of dam are constructed with non rigid material such as earth, tailings, rockfill, rubber fabric etc. Rubber Dam- These dams are made by using huge cylindrical that are made of synthetic rubber. They are inflated using either compressed air and pressurized water. Earthen Dam- An earth dam made of earth built up by compacting successive layer of earth using the most impervious materials to form a core and placing more permeable substance on the upstream and downstream sides Rock fill Dam- A Rock fill dam is built of rock fragments and boulders of large size. An impervious membrane is placed on the rock fill on the upstream side to reduce the seepage through the dam. Based on Hydraulic Design-
  • 109.
    109 | Pa g e SAQIB IMRAN 0341-7549889 10 9 Over flow Dam- A dam designed for raising the water level of rivers or for creating a reservoir, it permits the overflow of water during the passage of excess discharge over the entire length of the dam crest or through drain opening. Non Over Flow Dam- Non over flow dams are those which are not designed to be over topped. This type of design giver wider choice of materials including earth fill and rock fill dam. DAM AND THEIR BASIC TERMS DAM A dam is a barrier that impounds water or under ground stream. A dam can also be used to collect water or for storage of water which can be evenly distributed between location. Dams generally serve the primary purpose of retaining water. BASIC TERMS OF DAM  Crest- The top of the dam. These may in some cases be used for providing a roadway or walkway over the dam.  Heel- Portion of dam in contact with ground or river bed at upstream side.  Parapet Wall- Low protective walls on either sides of the roadway and walkway on the crest.  Toe- Portion of dam in contact with ground or river bed at downstream side.
  • 110.
    110 | Pa g e SAQIB IMRAN 0341-7549889 11 0  Spillway- It is the arrangement made near the top of dam for the passage of surplus/ excessive water from the reservoir.  Free board- The space between the highest level of water in the reservoir and the top of the dam.  Abutment- The valley slops on either sides of the dam wall to which the left wall & right end of the dam are fixed to.  Gallery- Level or gently slopping tunnels like passage at transverse or longitudinal within the dam with drain of floor for seepage water. These are generally provided for having space for drilling grout holes and drainage holes. These may also be used to accommodate the instrumentation for studying the performance of dam.  Slice Way- Opening in the dam near the base provided to clear the silt accumulation in the reservoir.  Core- A zone of material of low permeability in an earth embankment dam, hence the terms the central core, inclined core, puddle clay core, and rolled clay core.  Dead Storage Level- Level of permanent storage below which the water will not be withdrawn.  Diversion Tunnel- Tunnel constructed to divert of change the direction of water to bypass the dam construction sites. The dam is built while the river flows through the diversion tunnel.  Base width- The width of dam measured along dam/ foundation interface  Breach- An opening or a breakthrough of a dam sometimes cause by rapid erosion of a section of earth embankment by water. COFFERDAM
  • 111.
    111 | Pa g e SAQIB IMRAN 0341-7549889 11 1 Cofferdams are temporary enclosures to keep out water and soil so as to permit dewatering and construction of the permanent facility in the dry. A cofferdam is a temporary structure design to keep water and soil out of the excavation in which a bridge pier or other structure is built. Meaning of coffer Dam: Coffer = Box. To take up the foundation works in the marine region, it is necessary to obstruct the water flow by means of cofferdam. PURPOSE TO USE COFFERDAM STRUCTURE  To retain soil and water  Main purpose is to provide dry working area for workers  It is constructed to facilitate pile driving operation.  It is used to place grillage as well as raft foundation  It is used when the foundation for piers and abutments for a bridge, dams, locks etc are to be constructed.  Some times it is also provided to store water temporarily TYPES OF COFFER DAM Considering the material used in their construction, cofferdam may be divided in to the following categories- 1. Earthen Cofferdam 2. Rockfill Cofferdam 3. Single Walled Cofferdam
  • 112.
    112 | Pa g e SAQIB IMRAN 0341-7549889 11 2 4. Double Walled Cofferdam 5. Braced Cofferdam 6. Cellular Cofferdam 1. Earthen Cofferdam Earthen cofferdam are constructed at place where the height of water is less say 3 meter and the current velocity is low. These dams are built using the local available material such as clay, fine sand or even soil. The height of the dam is kept 1m more than that of maximum water level. Free board of the dam or top of the dam is kept 1m so that the water does not enter the other side even when waves arises. The slope usually given but 1:1 or 1:2. The slope of the water side is pitched with rubble stones so that the water action does not score the embankment. Even sheet piles are driven in the center of the dam to resist water seepage. After the construction of earthen cofferdam the water from the other site is pumped out and construction is executed. 2. Rockfill Cofferdam Rockfill cofferdam are better than that of earthen cofferdam. These dams are preferred when the rock is easy available at the construction site. These dams are very pervious to prevent water from seeping an impervious membrane of soil is provided in the dam. The height of the dam is can be up to 3m. The slope can be
  • 113.
    113 | Pa g e SAQIB IMRAN 0341-7549889 11 3 maintained at 1:1.5 to 1:1.25. The slope on the water is pitched so as to protect dam from wave action. 3. Single Walled Cofferdam This type of cofferdam is preferred when the depth of water is more than 6m and area of construction is less. Usually this is used in construction of bridges. Wooden or timber sheets are driven in to the river bed on the perimeter of the area of construction. On the inside steel sheets are driven in to the river bed. This inside sheets are placed at equal distance with the help of wales which are bolted to both sheets for either side. To improve the stability of this type of cofferdam half filled bags of sand are placed on the both side of walls. The water from the inside is pumped out and the construction process is under taken. 4. Double Walled Cofferdam
  • 114.
    114 | Pa g e SAQIB IMRAN 0341-7549889 11 4 Double walled type of cofferdam are used when the area of construction site is large and depth of water is high. In this place use of single walled cofferdam becomes uneconomical as the supports are to be increased. So double walled cofferdam is used. The difference in one wall and double wall dam is that her it has two walls instead of walls for extra stability. This types of dams can hold water up to 12m high. Two piles are driven inside the water bed with a space in between and attached each other with wales with bolted connection. As the water depth increases the space between the walls increases. The space between the walls are filled with soil. To prevent the leakage from the ground below the sheet piles are driven to a good depth in the bed. 5. Braced Cofferdam When it is difficult to drive piles inside the bed in the water then this type of cofferdam is used. In braced cofferdam two piles are driven in to the bed and they are laterally supported with the help of wooden crib installed in alternate course to form pockets. The empty pockets here are filled with stone and earth. The frame work of the cofferdam is prepared on the ground and then floated to the site where the cofferdam is to be constructed. The layers of sand and the other loose material overlaying the impervious hard bed is dredged out. Crib is then sunk to the position the bottom of each crib is given a shape to fit in the variation in the surface of bed rock. After the pit is dewatered the structure is constructed. When the concreting has been completed above the water level the cofferdam is removed. 6. Cellular Cofferdam
  • 115.
    115 | Pa g e SAQIB IMRAN 0341-7549889 11 5 When the water layer is more than the 20m common types of cofferdam are uneconomical to use. In this situation cellular cofferdam are used. This type of dam is used in construction of dams, locks, weirs etc. Cellular cofferdam is made by driving straight web steel pile arranged to form a series of interconnected cells. The cells are constructed in various shapes and style to suit the requirement of site. Finally the cells are filled with clay, sand or gravels to make them stable against the various forces to which they are likely to be subjected to. The two common shapes of cellular cofferdam are- a) Circular Type Cellular Cofferdam b) Diaphragm Type Cellular Cofferdam (a). Circular Type Cellular Cofferdam This type of cellular cofferdam consist of circular arcs on the inner and outer sides which are connected by straight diaphragm walls. The connection between the curved part and the diaphragm are made by means of a specially fabricated Y- element. The cofferdam is thus made from interconnected steel sheet piles. The empty space are filled with non pervious material like clay or sand. Due to the filling material the self weight of the membrane increases and leakage is reduced. One advantage of diaphragm type is that the effective length of the cofferdam may be increased easily by lenthening the diaphragm. Hence in case from design consideration it is necessary to have effective width of the cofferdam more than 21m diaphragm type cofferdam must be used. (b). Diaphragm Type Cellular Cofferdam
  • 116.
    116 | Pa g e SAQIB IMRAN 0341-7549889 11 6 It consist of a set of large diameter main circular cells interconnected by arcs of smaller cells. The walls of the connecting cells are perpendicular to the wall of the main circular cells of large diameter. The segmental arc are joined by special T- piles to the main cells. The circular type cellular cofferdam are self sustaining and therefore independent of the adjacent circular cells. Each cell can be filled independently. The Stability of such cells is much greater as compared with that of the diaphragm. type. However the circular cells are more expensive then the diaphragm type as these require more sheet piles and greater skill in setting and driving the piles. Because the diameter of circular cells is limited by interlock tension their ability to resist lateral pressure due to high head is limited. CONSTRUCTION SEQUENCE OF COFFERDAM For typical cofferdam such as for a bridge piers, the construction procedure generally is- 1. Pre-dredge to remove soil or soft sediment and level the area of the cofferdam. 2. Drive Temporary Support piles for template. 3. Temporarily erect bracing frame on the support piles for the template. 4. Install steel sheet piles starting at the all four corners and meeting at center of each side 5. Drive sheet piles to grade. 6. Block between bracing frame and sheets and provide ties for sheet piles at the top as necessary.
  • 117.
    117 | Pa g e SAQIB IMRAN 0341-7549889 11 7 7. Excavate inside the grade or slightly below grade while leaving the cofferdam full of water, Then lower the water inside and progressively install internal bracing as required by the design. 8. Derive piles with in the cofferdam if required. 9. Place rockfill as a leveling and support course. 10.Place tremie concrete seal. HOME DESIGNS 1 1- 2-

  • 118.
    118 | Pa g e SAQIB IMRAN 0341-7549889 11 8 3- HOME DESIGNS 2 1.
  • 119.
    119 | Pa g e SAQIB IMRAN 0341-7549889 11 9 2. 3.
  • 120.
    120 | Pa g e SAQIB IMRAN 0341-7549889 12 0 PLAN 30*60
  • 121.
    121 | Pa g e SAQIB IMRAN 0341-7549889 12 1
  • 122.
    122 | Pa g e SAQIB IMRAN 0341-7549889 12 2 SPECIFICATIONS- Plot Size- 30×60ft Bedroom- 3 Toilet- 3 ( 2 Attached 1 Common ) Hall- 1 Kitechen- 1 Garden Area Garage Dining cum Living Area East Facing
  • 123.
    123 | Pa g e SAQIB IMRAN 0341-7549889 12 3 IS CODES I.S. CODES FOR IMPORTANT ENGINEERING MATERIALS PART-A AGGREGATES: CODE NO. DESCRIPTIONS IS: 383-1970 Specification for coarse and fine aggregates from natural sources of concrete IS: 650-1966 Specification for standards of sand for testing of cement IS: 2386-1963 (Part 1) Methods of test for aggregates of concrete IS: 2386-1963 (Part 2) Estimation of deleterious materials and organic impurities BUILDING STONES: CODE NO. DESCRIPTIONS IS: 1121-1974 (Part 1) Methods of test determination of strength properties of natural building stones – Part-I Compressive Strength IS: 1121-1974 (Part 2) Methods of test determination of strength properties of natural building stones – Part-II Transverse Strength IS: 1121-1974 (Part 3) Methods of test determination of strength properties of natural building stones – Part-III Tensile Strength IS: 1121-1974 (Part 4) Methods of test determination of strength properties of natural building stones – Part-IV Shear Strength IS: 1122-1974 Methods of test determination of true specific gravity of natural building stones
  • 124.
    124 | Pa g e SAQIB IMRAN 0341-7549889 12 4 IS: 1123-1975 Method of identification of natural building stones IS: 1124-1974 Methods of test determination of water absorption, apparent specific gravity and porosity of natural building stones IS: 1125-1974 Methods of test determination of weathering of natural building stones IS: 1126-1974 Method of test for durability of natural building stones IS: 1128-1974 Specifications for lime stone slabs IS: 1130-1969 Specifications for marbles (blocks, slabs, and tiles) BRICKS, TILES AND OTHER CLAY MATERIALS: CODE NO. DESCRIPTIONS IS: 654-1972 Mangalore pattern clay roofing tiles IS: 777-1961 Specification for glazed earthenware tiles IS: 1077-1976 Specification for common burnt clay building bricks IS: 1237-2006 Cement concrete flooring tiles IS: 1464-1969 Specification for ridge and ceiling tiles IS: 2117-1975 Guide for manufacture of handmade common building bricks IS: 2180-1970 Specification for heavy duty brunt clay building bricks IS: 2222-1970 Specification for brunt clay perforated building bricks IS: 2690-1975 (Part 1) Specification for brunt clay flat terracing bricks IS: 2690-1972 Specification for brunt clay facing tiles IS: 3102-1971 Specification for burnt clay solid bricks
  • 125.
    125 | Pa g e SAQIB IMRAN 0341-7549889 12 5 IS: 3367-1975 Specification for burnt clay bricks for use in lining irrigation and drainage works IS: 3461-1966 PVC (vinyl) asbestos floor tiles IS: 3496-1976 Method of tests for burnt, clay building tiles IS: 3583-1976 Specification for paving bricks IS: 3951-1975 Specification for hollow clay tiles for floor and roofs IS: 3952-1978 Specification for burnt clay hollow blocks for walls and partitions IS: 3978-1967 Code for practice for manufacture of brunt clay mangalore pattern roof tiles IS: 4139-1989 Specification for sand lime bricks IS: 4805-1978 Guide for construction of bricks kilns IS: 4885-1968 Specification for sewer bricks IS: 5454-1978 Methods of sampling of clay building IS: 5779-1970 Bricks burnt clay soiling bricks IS: 6165-1971 Dimensions for special shapes of clay bricks REINFORCEMENT AND STRUCTURAL STEEL: CODE NO. DESCRIPTIONS IS: 432-1966 (Part 1) Specification for mild steel and medium tensile bars IS: 1566-1966 Specification for hard brawn steel wire fabric for concrete reinforcement IS: 1786-2008 High strength deformed steel bars and wires for concrete reinforcement IS: 226-1969 Specification for structural steel IS: 808-1964 Specification for rolled steel beam, channel and angle sections
  • 126.
    126 | Pa g e SAQIB IMRAN 0341-7549889 12 6 IS: 811-1965 Specification for cold formed light gauge structural steel sections ASPHALT, TAR AND BITUMEN: CODE NO. DESCRIPTIONS IS: 73-1961 Paving Bitumens IS: 217-1961 Cutback Bitumens IS: 334-1965 Glossary of term relating to bitumens and tar IS: 3117-1965 Bitumens emulsion for road (Anionic type) IS: 8887-1978 Bitumens emulsion for roads (Cationic type) IS: 424-1965 Plastic asphalt IS: 215-1961 Road tar PAINTS AND VARNISHES: CODE NO. DESCRIPTIONS IS: 427-1965 Specification for distemper, dry, colour as required IS: 428-1953 Specification for distemper, oil emulsion, colour as required IS: 5410-1969 Specifications for cement paint, colour as required IS: 101-1964 Method of test for ready mixed paints and enamels IS: 102-1962 Specifications for ready mixed paint brushing, red lead, non setting, priming IS: 103-1962 Specifications for ready mixed paint, brushing, white led for priming for use on aluminum and light alloys IS: 104-1962 Specifications for ready mixed paint, brushing, zinc chrome, priming for use on aluminum and light alloys
  • 127.

    127 | Pa g e SAQIB IMRAN 0341-7549889 12 7 IS: 106-1962 Specification for ready mixed paint, brushing, priming for enamels for use on wood IS: 155-1950 Specification for ready mixed paint, brushing matt black for use on wood IS: 156-1950 Specification for ready mixed paint, brushing for use on floor, colours as required IS: 158-1968 Specification for ready mixed paint, IS brushing, bituminous, black, lead free, acid, alkali, water and heat resisting, for general purposes IS: 162-1950 Specification for ready mixed paint, IS brushing, fire resisting, silicates types for use on wood, colour as required IS: 290-1961 Specification for coal tar black paint IS: 1477-1971 (Part 1&2) Painting of ferrous metals in buildings IS: 2524-1968 (Part 1&2) Painting of non-ferrous metals in buildings
  • 128.
    128 | Pa g e SAQIB IMRAN 0341-7549889 12 8 CEMENT AND CONCRETE: CODE NO. DESCRIPTIONS IS: 269-1989 Specification for ordinary portland cement, 33 grade IS: 383-1970 Specification for coarse and fine aggregates from natural sources for concrete IS: 455-1989 Specification for portland slag cement IS: 456-2000 Code of practice for plain and reinforced concrete IS: 457-1957 Code of practice for general construction of plain and reinforced concrete for dams and other massive structures IS: 516-1959 Method of test for strength of concrete IS: 650-1991 Specification for standard sand for testing of cement IS: 1199-1959 Methods of sampling and analysis of concrete IS: 1343-1980 Code of practice for prestressed concrete IS: 1344-1981 Specification for calcined clay pozzolana IS: 1489-1991 (Part 1) Specification for portland pozzolana cement- Fly ash based
  • 129.

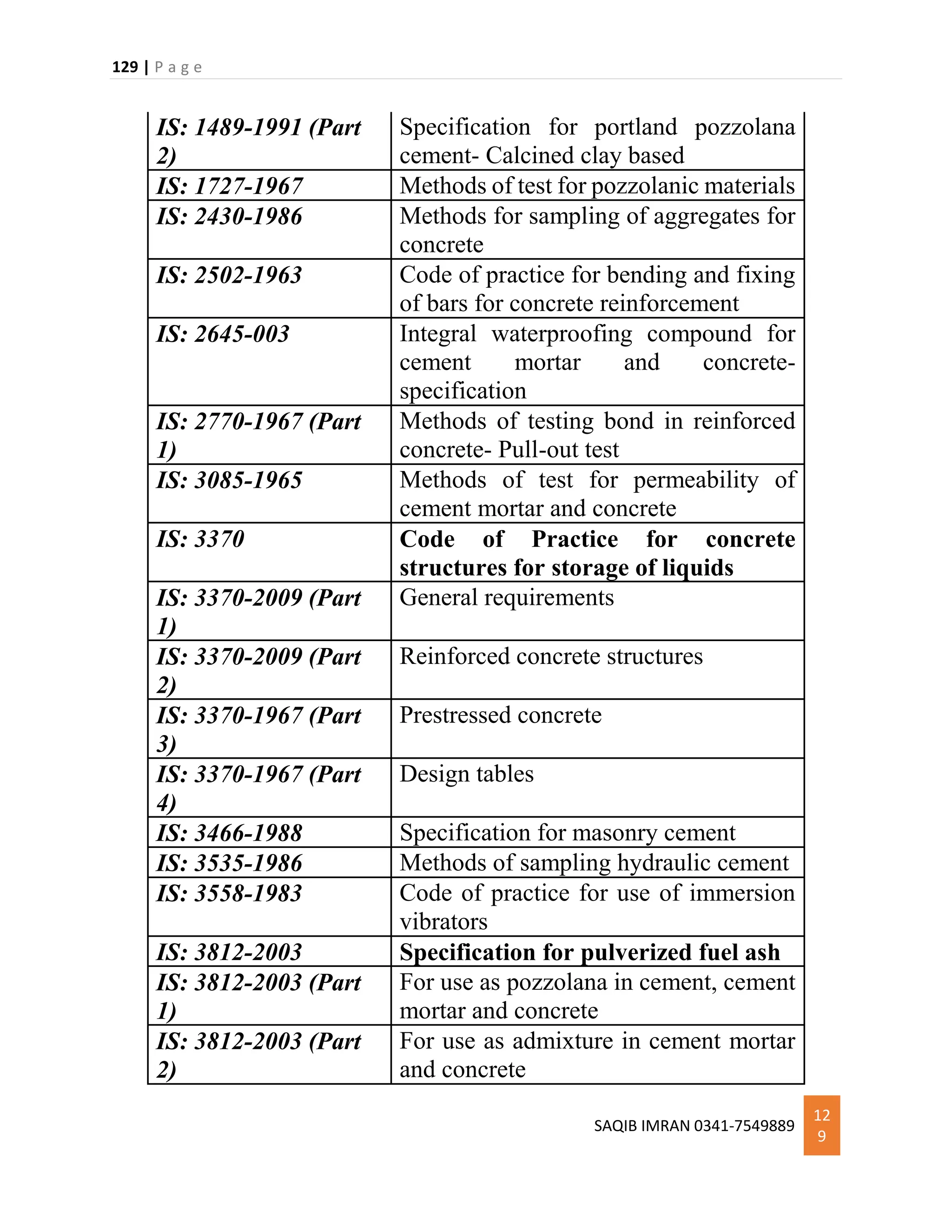

    129 | Pa g e SAQIB IMRAN 0341-7549889 12 9 IS: 1489-1991 (Part 2) Specification for portland pozzolana cement- Calcined clay based IS: 1727-1967 Methods of test for pozzolanic materials IS: 2430-1986 Methods for sampling of aggregates for concrete IS: 2502-1963 Code of practice for bending and fixing of bars for concrete reinforcement IS: 2645-003 Integral waterproofing compound for cement mortar and concrete- specification IS: 2770-1967 (Part 1) Methods of testing bond in reinforced concrete- Pull-out test IS: 3085-1965 Methods of test for permeability of cement mortar and concrete IS: 3370 Code of Practice for concrete structures for storage of liquids IS: 3370-2009 (Part 1) General requirements IS: 3370-2009 (Part 2) Reinforced concrete structures IS: 3370-1967 (Part 3) Prestressed concrete IS: 3370-1967 (Part 4) Design tables IS: 3466-1988 Specification for masonry cement IS: 3535-1986 Methods of sampling hydraulic cement IS: 3558-1983 Code of practice for use of immersion vibrators IS: 3812-2003 Specification for pulverized fuel ash IS: 3812-2003 (Part 1) For use as pozzolana in cement, cement mortar and concrete IS: 3812-2003 (Part 2) For use as admixture in cement mortar and concrete
  • 130.
    130 | Pa g e SAQIB IMRAN 0341-7549889 13 0 IS: 4031 Methods of physical tests for hydraulic cement IS: 4031-1996 (Part 1) Determination of fineness by dry sieving IS: 4031-1999 (Part 2) Determination of fineness by specific surface by Blaine air permeability method IS: 4031-1988 (Part 3) Determination of soundness IS: 4031-1988 (Part 4) Determination of consistency of standard cement paste IS: 4031-1988 (Part 5) Determination of initial and final setting times IS: 4031-1988 (Part 6) Determination of compressive strength of hydraulic cement (other than masonry cement ) IS: 4031-1988 (Part 7) Determination of compressive strength of masonry cement IS: 4031-1988 (Part 8) Determination of transverse and compressive strength of plastic mortar using prism IS: 4031-1988 (Part 9) Determination of heat of hydration IS: 4031-1988 (Part 10) Determination of drying shrinkage IS: 4031-1988 (Part 11) Determination of density IS: 4031-1988 (Part 12) Determination of air content of hydraulic cement mortar IS: 4031-1988 (Part 13) Measurement of water retentivity of masonry cement IS: 4031-1989 (Part 14) Determination of false set
  • 131.
    131 | Pa g e SAQIB IMRAN 0341-7549889 13 1 IS: 4031-1991 (Part 15) Determination of fineness by wet sieving IS: 4032-1985 Method of chemical analysis of hydraulic cement IS: 4305-1967 Glossary of terms relating to pozzolana IS: 4634-1991 Methods for testing performance of batch type concrete mixers IS: 4845-1968 Definitions and terminology relating to hydraulic IS: 4926-2003 Ready mix concrete- Code of practice IS: 5512-1983 Specification for flow table for use in test of hydraulic cement and pozzolanic materials IS: 5513-1996 Specification for vicat apparatus IS: 5514-1996 Specification for apparatus used in Le- Chatelier test IS: 5515-1983 Specification for compaction factors apparatus IS: 5516-1996 Specification for variable flow type air permeability apparatus (Blaine type ) IS: 5525-1969 Recommendation for detailing of reinforcement in reinforced concrete works IS: 5536-1969 Specification for constant flow type air permeability apparatus (Lea and Nurse type) IS: 5816-1999 Method of test for splitting tensile strength of concrete IS: 6452-1989 Specification for high alumina cement for structural use IS: 6461 Glossary of terms relating to cement concrete
  • 132.
    132 | Pa g e SAQIB IMRAN 0341-7549889 13 2 IS: 6461-1972 (Part 1) Concrete aggregates IS: 6461-1972 (Part 2) Materials (other than cement and aggregates) IS: 6461-1972 (Part 3) Concrete reinforcement IS: 6461-1972 (Part 4) Types of concrete IS: 6461-1972 (Part 5) Formwork for concrete IS: 6461-1972 (Part 6) Equipment, tool and plant IS: 6461-1973 (Part 7) Mixing, laying, compacting, curing, and other constructions aspects IS: 6461-1973 (Part 8) Properties of concrete IS: 6461-1972 (Part 9) Structural aspects IS: 6461-1973 (Part 10) Test and testing apparatus IS: 6461-1973 (Part 11) Prestressed concrete IS: 6461-1973 (Part 12) Miscellaneous IS: 6491-1973 Method of sampling fly ash IS: 6909-1990 Specification for super sulphate cement IS: 6925-1973 Methods of test for determination of water soluble chloride in concrete admixtures IS: 7246-1974 Recommendations for use of table vibrators for consolidating concrete IS: 7320-1974 Specifications for concrete slump test apparatus
  • 133.
    133 | Pa g e SAQIB IMRAN 0341-7549889 13 3 IS: 7325-1974 Specifications for apparatus for determining constituents of fresh concrete IS: 7861 Code of practice for extreme weather concreting IS: 7861-1975 (Part 1) Recommended practice for hot weather IS: 7861-1981 (Part 2) Recommended practice for cold weather concreting IS: 8041-1990 Specification for rapid hardening portland cement IS: 8042-1989 Specification for white portland cement IS: 8043-1991 Specification for hydrophobic portland cement IS: 8112-1989 Specification for 43 grade ordinary cement IS: 8125-1976 Dimensions and materials of cement rotary kilns, compositions and auxiliaries IS: 8142-1976 Method to test for determining setting time of concrete by penetration resistance IS: 8229-1986 Specification for oil well cement IS: 8425-1977 Determination of specific surface area of powders by air permeability IS: 9012-1978 Recommended practice for shotcreting IS: 9013-1978 Method of making, curing and determining compressive strength of accelerated cured concrete test specimens IS: 9103-1999 Specification for admixture for concrete IS: 9142-1979 Specification for artificial light weight aggregate for concrete masonry units
  • 134.
    134 | Pa g e SAQIB IMRAN 0341-7549889 13 4 IS: 9284-1979 Method of test for abrasion resistance of concrete IS: 9376-1979 Specification for apparatus for measuring aggregate crushing value and 10% fines IS: 9377-1979 Specification for apparatus for aggregate impact IS: 9399-1979 Specification for apparatus for flexural testing of concrete IS: 9459-1980 Specification for apparatus for use in measurement of length change of hardened cement paste, mortar and concrete IS: 9799-1981 Specification for pressure meter for determination of air content of freshly mixed concrete IS: 10070-1982 Specification for machine for abrasion testing of coarse aggregates IS: 10078-1982 Specification for jolting apparatus for testing IS: 10079-1982 Specification for cylindrical metal measures for use in test of aggregates and concrete IS: 10080-1982 Specification for vibration machine for casting- standard cement mortar cubes IS: 10086-1982 Specification for mould for use in test of cement and concrete IS: 10262-2009 Guideline for concrete mix proportioning IS: 10510-1983 Specification for vee-bee consistometer IS: 10850-1984 Specification for apparatus for measurement of water retentivity of masonry cement
  • 135.

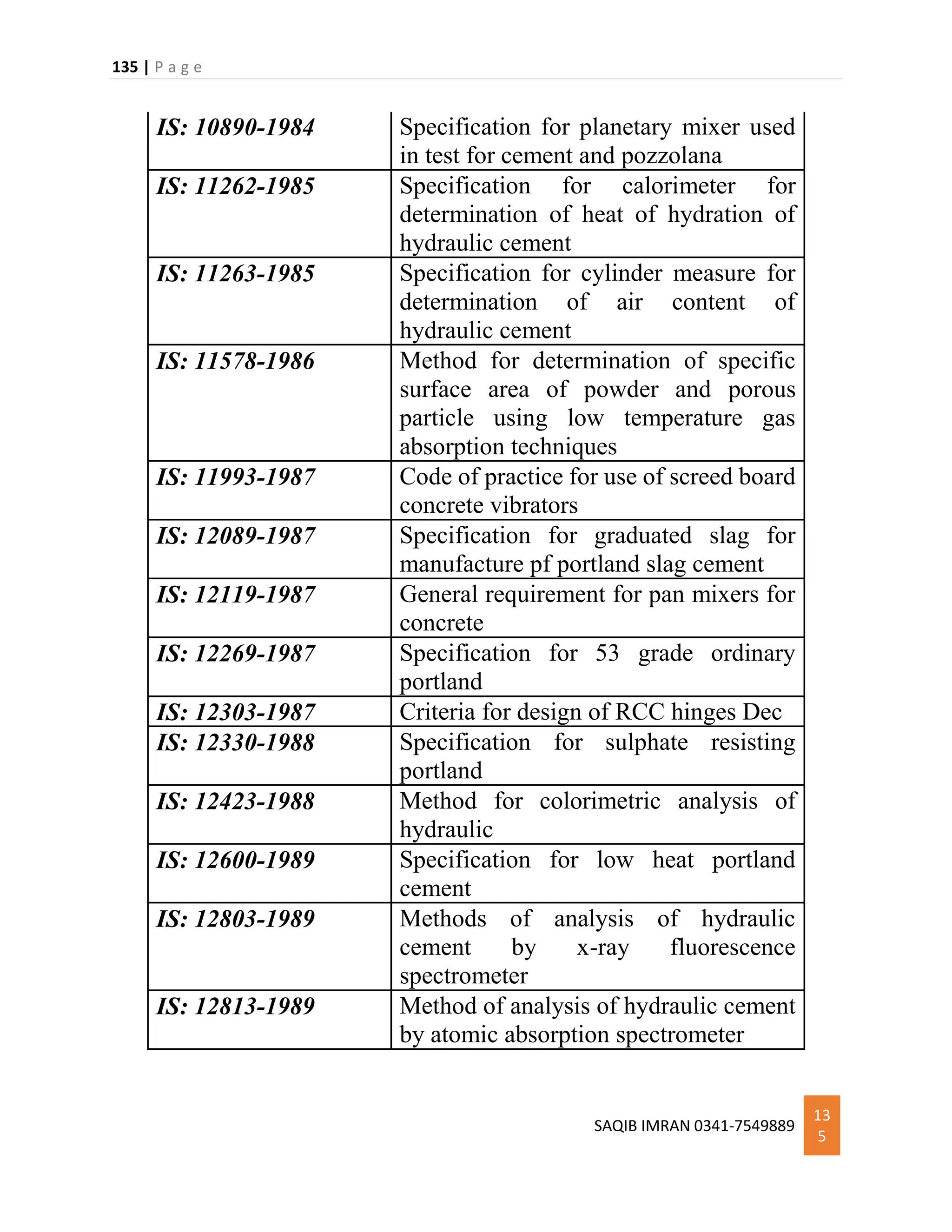

    135 | Pa g e SAQIB IMRAN 0341-7549889 13 5 IS: 10890-1984 Specification for planetary mixer used in test for cement and pozzolana IS: 11262-1985 Specification for calorimeter for determination of heat of hydration of hydraulic cement IS: 11263-1985 Specification for cylinder measure for determination of air content of hydraulic cement IS: 11578-1986 Method for determination of specific surface area of powder and porous particle using low temperature gas absorption techniques IS: 11993-1987 Code of practice for use of screed board concrete vibrators IS: 12089-1987 Specification for graduated slag for manufacture pf portland slag cement IS: 12119-1987 General requirement for pan mixers for concrete IS: 12269-1987 Specification for 53 grade ordinary portland IS: 12303-1987 Criteria for design of RCC hinges Dec IS: 12330-1988 Specification for sulphate resisting portland IS: 12423-1988 Method for colorimetric analysis of hydraulic IS: 12600-1989 Specification for low heat portland cement IS: 12803-1989 Methods of analysis of hydraulic cement by x-ray fluorescence spectrometer IS: 12813-1989 Method of analysis of hydraulic cement by atomic absorption spectrometer
  • 136.
    136 | Pa g e SAQIB IMRAN 0341-7549889 13 6 IS: 12870-1989 Methods of sampling calcined clay pozzolana IS: 13311-1992 (Part 1) Methods of non destructive testing of concrete- Ultrasonic pulse velocity IS: 13311-1992 (Part 2) Method of non destructive testing of concrete- Rebound hammer IS: 14345-1996 Specification for autoclave apparatus IS: 14687-1999 Guideline for false work for concrete structures IS: 14858-2000 Requirements for compression testing machine used for testing of concrete and mortar IS: 14959 Methods of test for determination of water soluble and acid soluble chlorides IS: 14959-2001 (Part 1) In fresh mortar and concrete IS: 14959-2001 (Part 2) In hardened mortar and concrete IS: 15388-2003 Silica fume- Specification SP:16-1980 Design aids for reinforced concrete to IS 456-1978 SP: 23-1982 Handbook on concrete mixes SP: 24-1983 Explanatory handbook on IS code of practice for plan and reinforced concrete SP: 34-1987 Handbook on concrete reinforcement and detailing I.S. CODES FOR IMPORTANT ENGINEERING MATERIALS PART- B GLASS CODE NO. DESCRIPTIONS
  • 137.
    137 | Pa g e SAQIB IMRAN 0341-7549889 13 7 IS: 1761-1960 Specification for transparent sheet for glazing and framing purpose IS: 2553-1964 Specification for safety glass IS: 2853-1965 Specification for transparent glass IS: 5437-1969 Specification for wired and figured glass HARDWARE CODE NO. DESCRIPTIONS IS: 362-1968 Specification for parliament hinges IS: 729-1963 Specification for drawer locks, cupboard locks and box locks IS: 2209-1966 Specification for mortice locks IS: 3564-1966 Specification for door closer IS: 3847-1966 Specification for mortice night latches THINNER AND SOLVENT CODE NO. DESCRIPTIONS IS: 82-1950 Methods for test for thinners and solvent for paints WATER SUPPLY AND SANITARY APPLIANCES AND FITTINGS CODE NO. DESCRIPTIONS IS: 771-1963 Specification for glazed earthenware sanitary appliances IS: 772-1962 Specification for general requirement of enameled cast iron sanitary appliances IS: 1726-1967 Specification for cast iron manhole covers and frames intended for use in drainage works IS: 2556-1967 (Part 6) Specific requirement of urinals
  • 138.
    138 | Pa g e SAQIB IMRAN 0341-7549889 13 8 IS: 2692-1964 Specification for sluices valves (350 to 1200 mm size) for water works purposes IS: 2906-1984 Sluice valves for water works purpose IS: 651-2007 Specification for glazed stoneware pipe and fittings IS: 771 Specification for glazed fire clay sanitary appliances IS: 771-1979 (Part 1) General requirement IS: 771-1985 (Part 2) Specific requirement of kitchen and laboratory sink IS: 771-1979 (Part 3/sec 1) Specific requirement of urinal- section 1 slab urinals IS: 771-1985 (Part 3/sec 2) Specific requirement of urinals- section 2 stall urinals IS: 771-1979 (Part 4) Specific requirement of postmortem slabs IS: 771-1979 (Part 5) Specific requirement of shower trays IS: 771-1979 (Part 6) Specific requirement of bedpan sinks IS: 771-1981 (Part 7) Specific requirement of slop sinks IS: 772-1973 Specification for general requirement for enameled CI sanitary appliances IS: 774-2004 Specification for flushing cistern for water closet and urinals IS: 778-1984 Specification for copper alloy gate, globe and check valves for water works purpose IS: 779-1994 Specification for water meters IS: 781-1984 Specification for cast copper alloy screw down bib taps and stop valves for water services IS: 782-1978 Specification for caulking lead
  • 139.

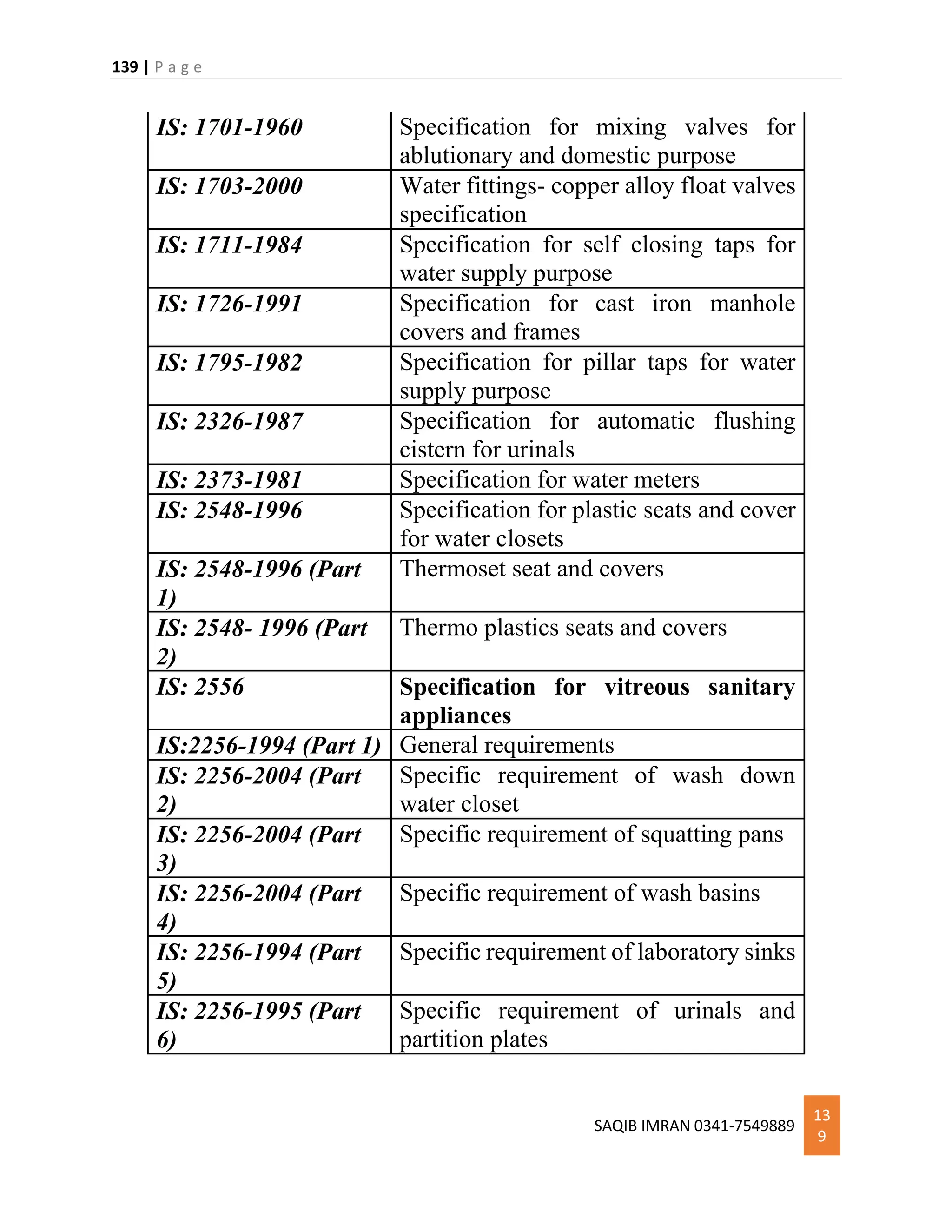

    139 | Pa g e SAQIB IMRAN 0341-7549889 13 9 IS: 1701-1960 Specification for mixing valves for ablutionary and domestic purpose IS: 1703-2000 Water fittings- copper alloy float valves specification IS: 1711-1984 Specification for self closing taps for water supply purpose IS: 1726-1991 Specification for cast iron manhole covers and frames IS: 1795-1982 Specification for pillar taps for water supply purpose IS: 2326-1987 Specification for automatic flushing cistern for urinals IS: 2373-1981 Specification for water meters IS: 2548-1996 Specification for plastic seats and cover for water closets IS: 2548-1996 (Part 1) Thermoset seat and covers IS: 2548- 1996 (Part 2) Thermo plastics seats and covers IS: 2556 Specification for vitreous sanitary appliances IS:2256-1994 (Part 1) General requirements IS: 2256-2004 (Part 2) Specific requirement of wash down water closet IS: 2256-2004 (Part 3) Specific requirement of squatting pans IS: 2256-2004 (Part 4) Specific requirement of wash basins IS: 2256-1994 (Part 5) Specific requirement of laboratory sinks IS: 2256-1995 (Part 6) Specific requirement of urinals and partition plates
  • 140.
    140 | Pa g e SAQIB IMRAN 0341-7549889 14 0 IS: 2256-1995 (Part 7) Specific requirement of accessories for sanitary appliances IS: 2256-2004 (Part 8) Specific requirement of pedestal close coupled wash down and siphonic water closet IS: 2256-2004 (Part 9) Specific requirement of pedestal type bidets IS: 2256-1995 (Part 14) Specific requirement of integrated squatting pans IS: 2256-2004 (Part 15) Specific requirement of universal water closet IS: 2256-2002 (Part 16) Specific requirement of wash down wall mounted water closets IS: 2256-2001 (Part 17) Specific requirement of wall mounted bidets IS: 2685-1971 Code of practice for selection, installation and maintenance of sluice valves IS: 2692-1989 Specification for ferrules for water services IS: 2963-1979 Specification for copper alloy waste fitting for wash basin and sinks IS: 3004-1979 Specification for plug cock for water supply purposes IS: 3006-1979 Specification for chemically resistant glazed stoneware pipes and fittings IS: 3042-1965 Specification for single faced sluices gate (200 to 1200 mm size) IS: 3311-1979 Specification for waste plug and its accessories for sink and wash basins IS: 3950-1979 Specification for surface box for sluices valves
  • 141.
    141 | Pa g e SAQIB IMRAN 0341-7549889 14 1 IS: 4038-1986 Specification for foot valves for water works purposes IS: 4346-1982 Specification for washer for uses with fittings for water services IS: 5219-1969 (Part 1) Specification for cast copper alloys traps: Part 1 P and S traps IS: 5312 Specification for swing check types reflux (non-return) valves IS: 5312-2004 (Part 1) Single door pattern IS: 5312-1986 (Part 2) Multi door pattern IS: 5455-1969 Specification for cast iron steps for drainage purpose IS: 5961-1970 Specification for cast iron grating for drainage purpose IS: 6411-1985 Specification for gel coated glass fiber reinforced polyester resin bath tubs IS: 6784-1996 Methods for performance testing of water meters domestic types IS: 7231-1994 Specification for plastic flushing cisterns for water closets and urinals IS: 8931-1993 Specification for copper alloy fancy single taps, combinations tap assembly and top valves for water services IS: 9140-1996 Method of sampling of vitreous and fire clay sanitary appliances IS: 9338-1984 Specification for cast iron screw down stop valves and stop and check valves for water works purpose IS: 9739-1981 Specification for pressure reducing valves for domestic water supply systems
  • 142.
    142 | Pa g e SAQIB IMRAN 0341-7549889 14 2 IS: 9758-1981 Specification for flush valves and fittings for water closet and urinals IS: 9762-1994 Specification for polyethylene floats for float valves IS: 9763-2000 Plastic bib taps, pillar taps, angle valves and stop valves for hot and cold water services – specification IS: 11246-1992 Specification for glass fibre reinforced polyester resin GRP squatting pans IS: 12234-1998 Specification for plastic equilibrium float valve for cold water services IS: 12701-1996 Specification for rotational moulded polyethylene water storage tank IS: 13049-1991 Specification for diaphragm type float operated valves for cold water services IS: 13114-1991 Specification for forged brass gate, globe and check valves for water works IS: 13349-1992 Specification for single faced cast iron thimble mounted sluice gate IS: 13983-1994 Specification for stainless steel sinks for domestic purposes IS: 14399 Hot press moulded thermosetting glass fibre reinforced polyester resin GRP sectional water storage tanks IS: 14399-1996 (Part 1) Specification for panels IS: 14399-1996 (Part 2) Guideline for assembly and installation IS: 14845-2000 Resilient seated cast iron air relief valves for water works purposes- Specification IS: 14846-2000 Sluice valves for water works purposes (50-1200 mm)- Specification
  • 143.
    143 | Pa g e SAQIB IMRAN 0341-7549889 14 3 INSULATING MATERIALS CODE NO. DESCRIPTIONS IS: 3792-1978 Guide for heat insulation of non industrial buildings IS: 1950-1162 Code of practice for sound insulation of non- industrial buildings PIPES , STEEL SECTIONS ETC. CODE NO. DESCRIPTIONS IS: 458-2003 Specification for concrete pipes IS: 783-1985 Laying of concrete pipes IS: 1230-1979 Cast iron rain water pipes and fitting IS: 1173-1978 Hot rolled and slit steel tee bars IS: 1536-1976 Centrifugally cast iron pressure pipes for water, gas and sewage IS: 1592-1978 Specification for asbestos cement pressure pipes IS: 1730 Dimensions for steel plates (Part 1, 2 & 3) sheets and strips for structural and general engineering purposes IS: 1926-1960 Specification for asbestos cement building pipes, gutters and fitting SHEETS, LIGHT METALS AND THEIR ALLOYS CODE NO. DESCRIPTIONS IS: 277-1969 Specification for galvanized steel sheets IS: 737-1965 Specification for wrought aluminum alloys, sheet and strip for general engineering purpose IS: 1161-1968 Specification for steel tubes for structural purpose IS: 1239 Specification for mild steel tubes, tubular and other wrought steel fittings
  • 144.
    144 | Pa g e SAQIB IMRAN 0341-7549889 14 4 IS: 1254-1965 Specification for corrugated aluminum sheets IS: 4270-1967 Specification for steel tubes for water well IS: 4923-1968 Specification for hollow mild steel section for structural use WIRE ROPES AND WIRE PRODUCTS CODE NO. DESCRIPTIONS IS: 278-1964 Specifications for galvanized steel barbed wire for fencing IS: 2266-1963 Specifications for steel wire ropes for general engineering purposes IS: 2365-1963 Specifications for steel wire suspension ropes for lifts and hoists VARNISH AND LACQUERS CODE NO. DESCRIPTIONS IS: 197-1952 Specifications for varnish and lacquers IS: 340-1952 Specifications for varnish, mixing IS: 347-1952 Specifications for varnish, shellac for general purpose IS: 348-1968 Specifications for French polish IS: 642-1963 Specifications for varnish medium for aluminium paints WOODEN AND METAL DOORS-WINDOWS, TIMBER AND WOOD PRODUCTS CODE NO. DESCRIPTIONS (a)Timber: IS: 287-1973 Recommendation for maximum permissible moisture content of timber used for different purpose IS: 399-1963 Classification of commercial timber and their zonal distribution
  • 145.
    145 | Pa g e SAQIB IMRAN 0341-7549889 14 5 IS: 401-2001 Code of practices for preservation of timber IS: 707-1976 Glossary of term applicable to timber technology and utilization IS: 883-1994 Code of practices for design of structural timber in buildings IS: 1141-1973 Code of practices for seasoning of timber IS: 1150-1976 Trade names and abbreviated symbols for timber species IS: 1708-1986 (Part 1 to 18) Method testing small clear specimens of timber IS: 3364-1976 (Part 1 & 2) Methods of measurement and elevation of defects in timber IS: 3513-1966 (Part 1& 2) Specifications for compressed wood laminates IS: 4423-1967 Guide for hand sawing of timber IS: 4970-1973 Key for identification of commercial timbers IS: 6534-1971 Guiding principle for grading and inspections of timber IS: 9676-1980 Guideline for mills sawing of timber IS: 11215-1986 Method of determination of moisture content of timber and timber products (b)Wooden doors and windows frame and shutter: IS: 1003 Specifications for timber paneled and glazed shutters IS: 1003 (Part 1) Door shutters IS: 1003 (Part 2) Window and ventilation shutters IS: 2191 Specifications for wooden flush door shutter (Cellular and hollow core type) IS: 2191 (Part 1) Plywood face panels
  • 146.
    146 | Pa g e SAQIB IMRAN 0341-7549889 14 6 IS: 2191 (Part 2) Particle board face panels IS: 2202 Specifications for wooden flush door shutters IS: 2202 (Part 1) Plywood face panels IS: 2202 (Part 2) Particle board face panels IS: 4021-1967 Specification for timber door, window and ventilator frames (c) Metal door and window frames and shutters: IS: 1361-1978 Specification for steel window for industrial buildings IS: 1948-1961 Specifications for aluminum doors, windows and ventilators IS: 1949-1961 Specifications for aluminum windows for industrial buildings (d)Plywood: IS: 303-1989 Specifications for plywood for general purpose IS: 1328-1958 Specifications for veneered decorative plywood IS: 4990-1969 Specifications for plywood for concrete shuttering work IS: 5509-1969 Specifications for fire retarding plywood (e) Particle board and fibre boards: IS: 1658-1966 Specification for fibre hard-board IS: 3097-1965 Specification for veneered particle board
