Anatomy of a Cutover Plan
                or
Don’t get caught dead in a go-live
            situation

         Mahesh Vallampati
About the Speaker
• Mahesh Vallampati
  – Senior Practice Manager at SmartDog Services
  – Senior Sales Consulting Manager at Hotsos.
  – Worked at Oracle for nine years
  – Director of IT Database Services at a company in
    Houston
  – Published in Oracle magazine

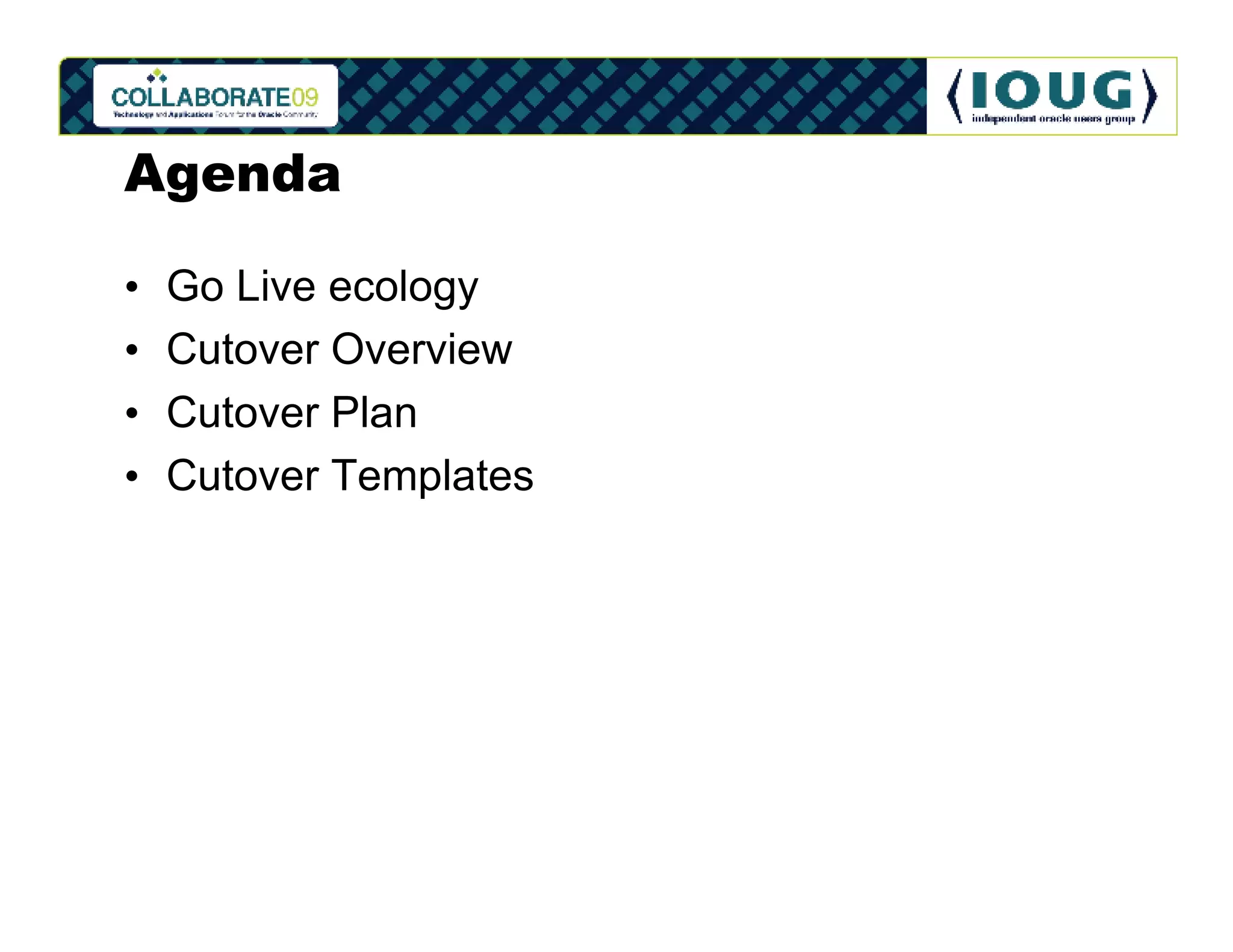

Agenda

•   Go Live ecology
•   Cutover Overview
•   Cutover Plan
•   Cutover Templates
GO LIVE ECOLOGY
Go Live Ecology
• What is a Go-Live Anyway?
   – A move from one defined state to another defined state
   – Typically supposed to
      • Minimize on-going risk
      • Cost Effective
      • Enhance Business Process
   – Involves
      • Several Stakeholders
      • Co-ordination of tasks
   – Usually involves a small defined window of time
      • Includes cutover tasks
      • Also includes rollback tasks if needed

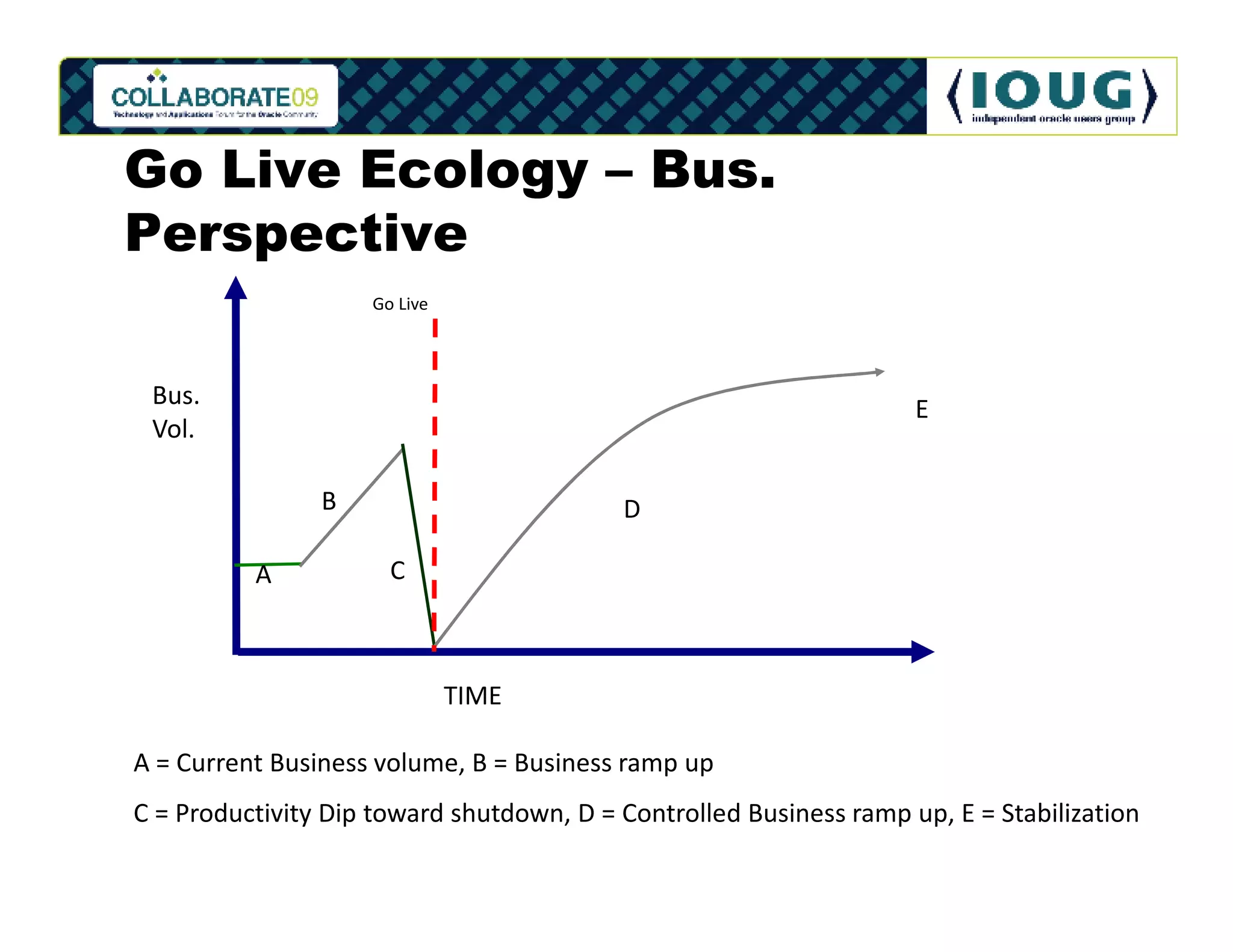

Go Live Ecology – Bus.
Perspective
                    Go Live

 Bus.                                                               E
 Vol.

                B                         D

          A           C

                              TIME

A = Current Business volume, B = Business ramp up
C = Productivity Dip toward shutdown, D = Controlled Business ramp up, E = Stabilization

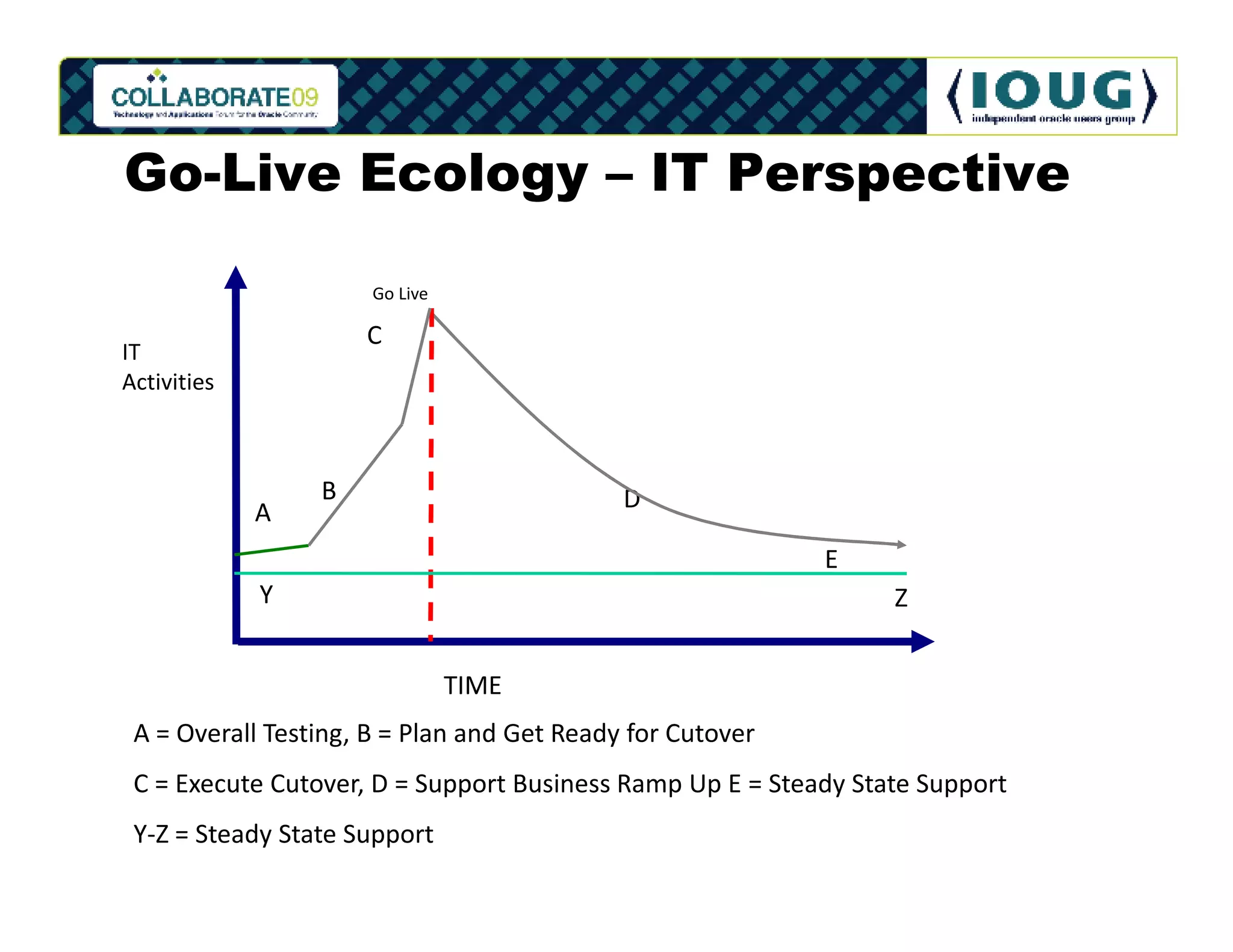

Go-Live Ecology – IT Perspective

                      Go Live

                     C
IT
Activities

                 B                          D
             A
                                                           E
             Y                                                   Z

                                TIME
 A = Overall Testing, B = Plan and Get Ready for Cutover
 C = Execute Cutover, D = Support Business Ramp Up E = Steady State Support
 Y-Z = Steady State Support
CUTOVER OVERVIEW
Cutover Definition
• Is A Process
• Execution of Planned Tasks
• By Several Stakeholders
• Step by Step
• Migrate Tested Functionality to Production
• Performed at least once or twice to document issues
  and timings
• Variance from cutover for Production should be well
  understood
• Lessons should be definitely learnt
Cutover characteristics

• Plan well ahead
• Meet Customer Demand
• Ramp down Business, (Close open items, Notify
  customers)
• Cutover Activities
• Key Decision point made by stakeholder
   – Move forward
   – Roll Back
• Go-Live or RollBack
• Business Ramp up
Cutover Process

• Pre-Cutover Activities
   •   Build Production Environment
   •   Cutover Plan development
   •   Test Cutover Plan
   •   Wash/Repeat/Rinse
   •   Finalize Cutover Plan
• Cutover Activities
   • Execute Cutover Plan
   • Perform checks
   • Go/No Go Decision
• Post Go Live Support
   • Issue Management
Cutover Plan
Cutover Plan

•   One document
•   Includes all cutover related tasks
•   Has a section for rollback also
•   Contains stakeholders and their tasks
•   Has decision checkpoints
•   Has detailed timing information for trial cutovers

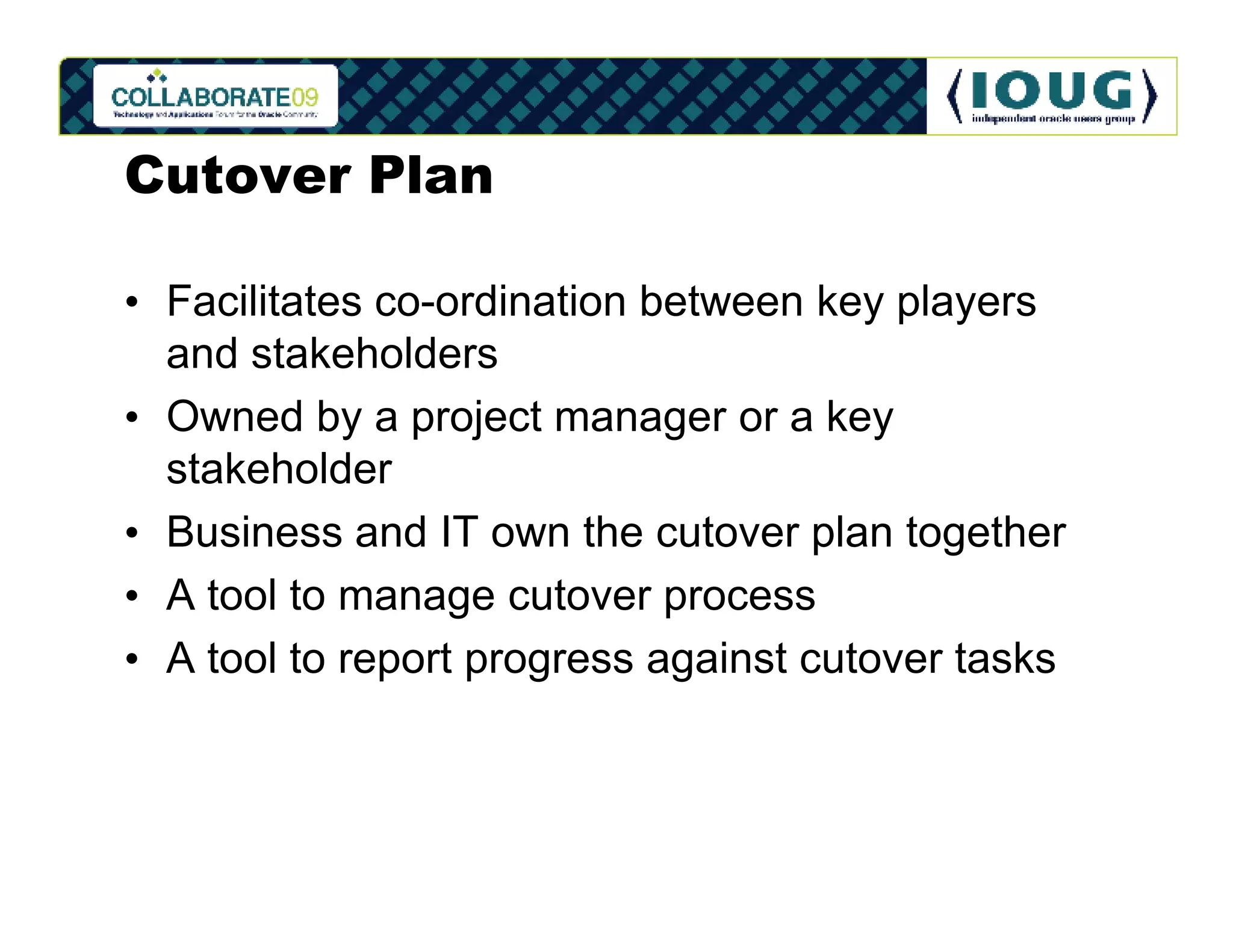

Cutover Plan

• Facilitates co-ordination between key players
  and stakeholders
• Owned by a project manager or a key
  stakeholder
• Business and IT own the cutover plan together
• A tool to manage cutover process
• A tool to report progress against cutover tasks
Cutover Plan Document

• Needs to be managed very tightly
• Changes to plan made only by cutover team
• Change risk understood and contingency plan in
  place
Cutover Plan

• Detailed Task List
• Timings and dependencies for each tasks
• Parallel execution and co-ordination of
  independent tasks
• A contact list
• Rollback Plan
• Decision Points
• Contains readiness criteria
Readiness Criteria
• Criteria
   –   Site
   –   Technology
   –   Training
   –   Data Migration
   –   Sustainment
   –   Functionality
   –   Cutover Planning
• Criteria Scores
   – 1-5
        •   1-No Impact
        •   2-Low Impact
        •   3-Medium Impact
        •   4-High Impact
        •   5-Show Stopper

Risk Scorecard
Criteria/       1-No     2-Low         3-Med.          4. High   5. Show
Score           Impact   Impact        Impact          Impact    Stopper
Site
Technology
Training
Data
Migration
Sustainment
Functionality
Cutover
Planning
Totals
                                  Overall Risk Score

Contingency Plan
Cutover Plans Formats
Cutover Plan Formats

• Spreadsheet
  – Homegrown
  – Created out of necessity
• AIM Document
  – PM.030 – Transition and Contingency Plan Document
Spreadsheet

• Components
  – Document Control
  – Resources
     •   Cutover Escalation
     •   Post Implementation Support Plan
     •   On-Site/Remote Resources
     •   War Room
     •   Conf. Bridge
  – Risk Scorecard/Readiness Criteria
  – Cutover Plan
  – DR-Restore
Document Control

•   Version Control
•   Owner
•   Contributors
•   Reviewers
•   Issue List
Resources

• Cutover Escalation
• Post Implementation Support Plan
• On-Site/Remote Resources
  – Name
  – Contact (Cell/Home/Office)
  – Manager’s Contact
• War Room/Conf. Bridge

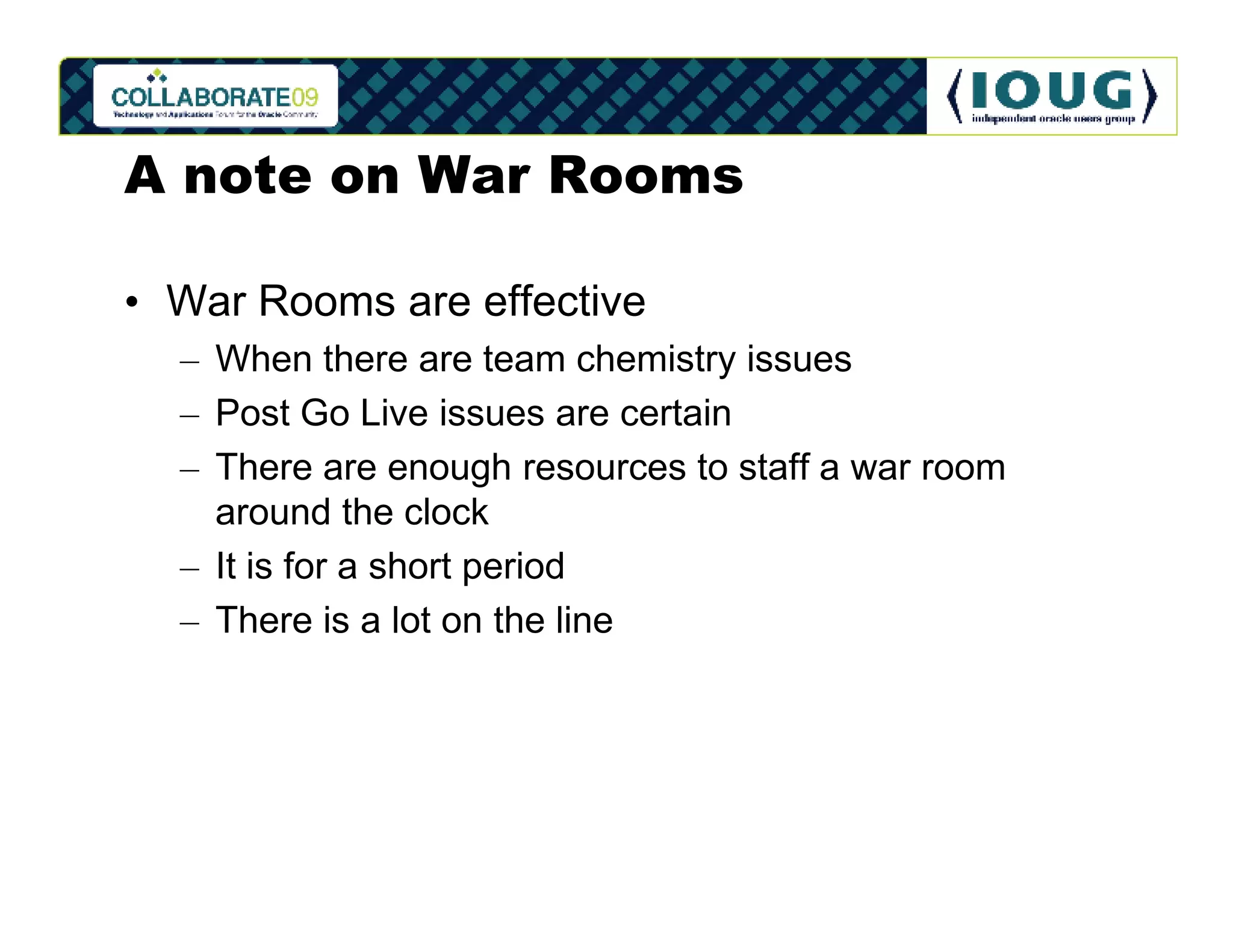

A note on War Rooms

• War Rooms are effective
  – When there are team chemistry issues
  – Post Go Live issues are certain
  – There are enough resources to staff a war room
    around the clock
  – It is for a short period
  – There is a lot on the line

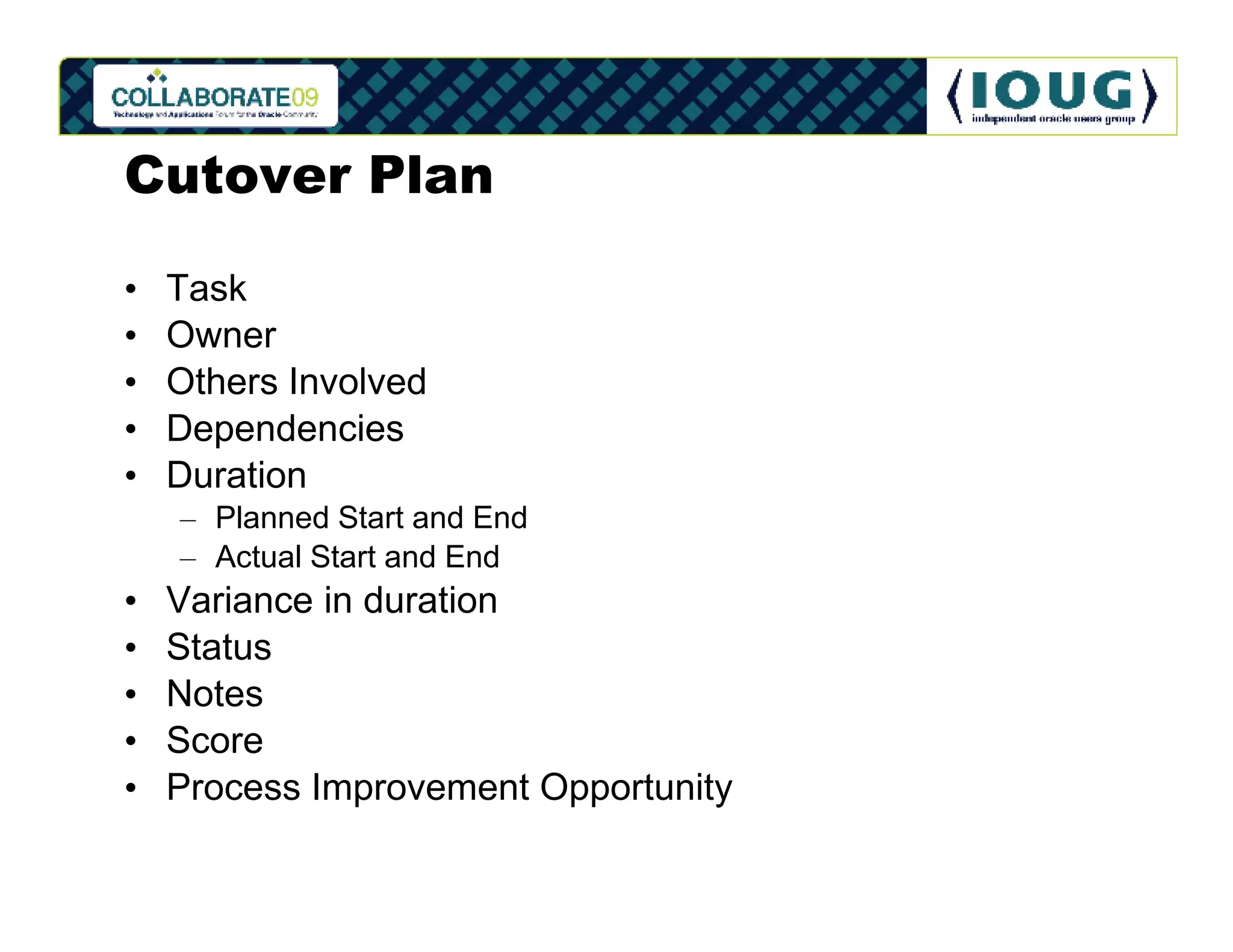

Cutover Plan

•   Task
•   Owner
•   Others Involved
•   Dependencies
•   Duration
    – Planned Start and End
    – Actual Start and End
•   Variance in duration
•   Status
•   Notes
•   Score
•   Process Improvement Opportunity
DR-Restore

• Same as Cutover Plan
• Get back to Original State

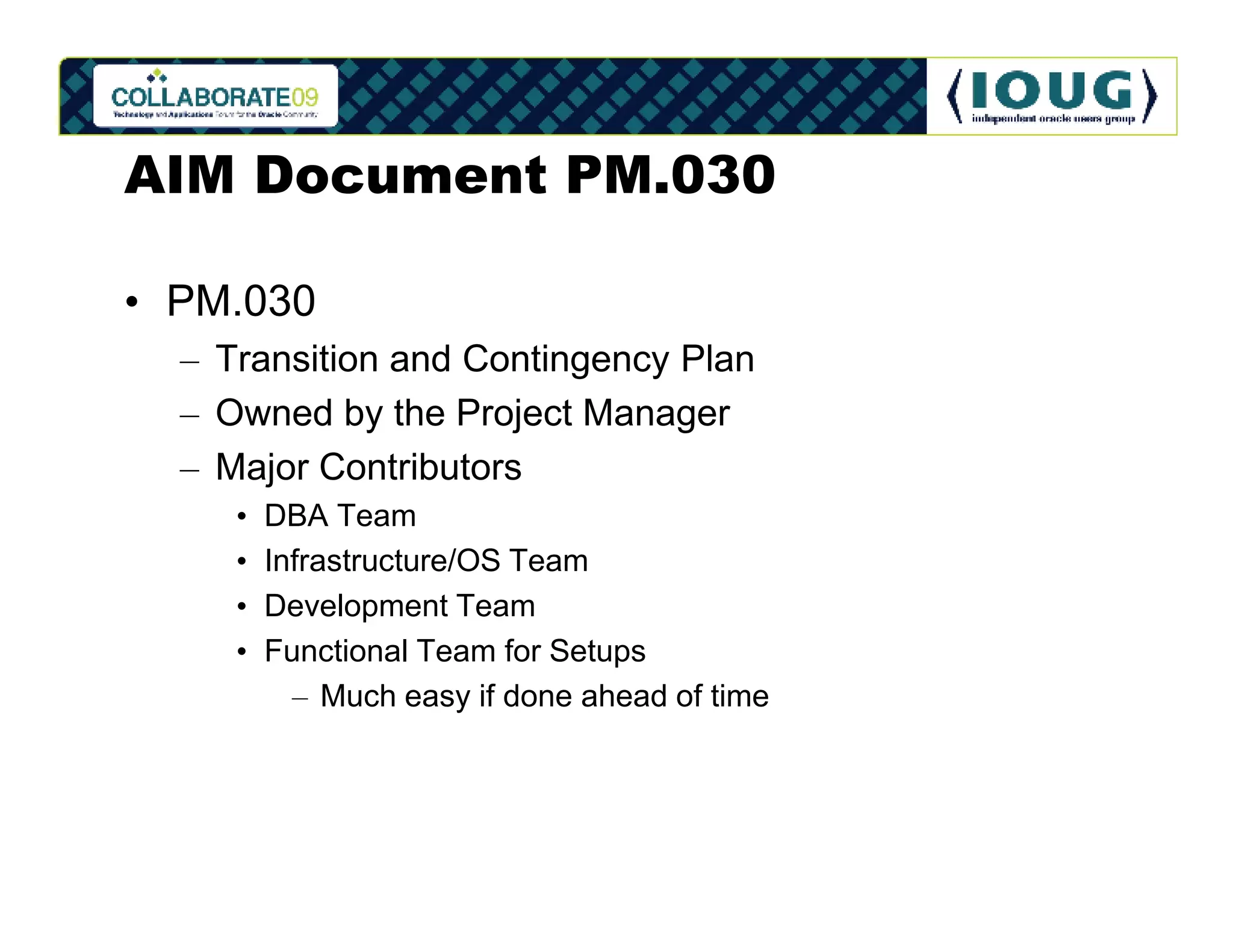

AIM Document PM.030

• PM.030
  – Transition and Contingency Plan
  – Owned by the Project Manager
  – Major Contributors
     •   DBA Team
     •   Infrastructure/OS Team
     •   Development Team
     •   Functional Team for Setups
           – Much easy if done ahead of time
PM.030 Sections

•   Detailed Transition Plan
•   Cutover Contingency Plan
•   Preparing for Production
•   Production Schedule – First Week
PM.030 Sections
• Detailed Transition Plan
   – General Tasks
   – Detailed Checklist Tasks
• Cutover Contingency Plan
   – Contingency Steps
   – Upon System Availability
• Preparing for Production
   – Approach
• Production Schedule - First Week
   – Using the Company Support Infrastructure
   – Information Systems Production Feedback Session
   – Support Status

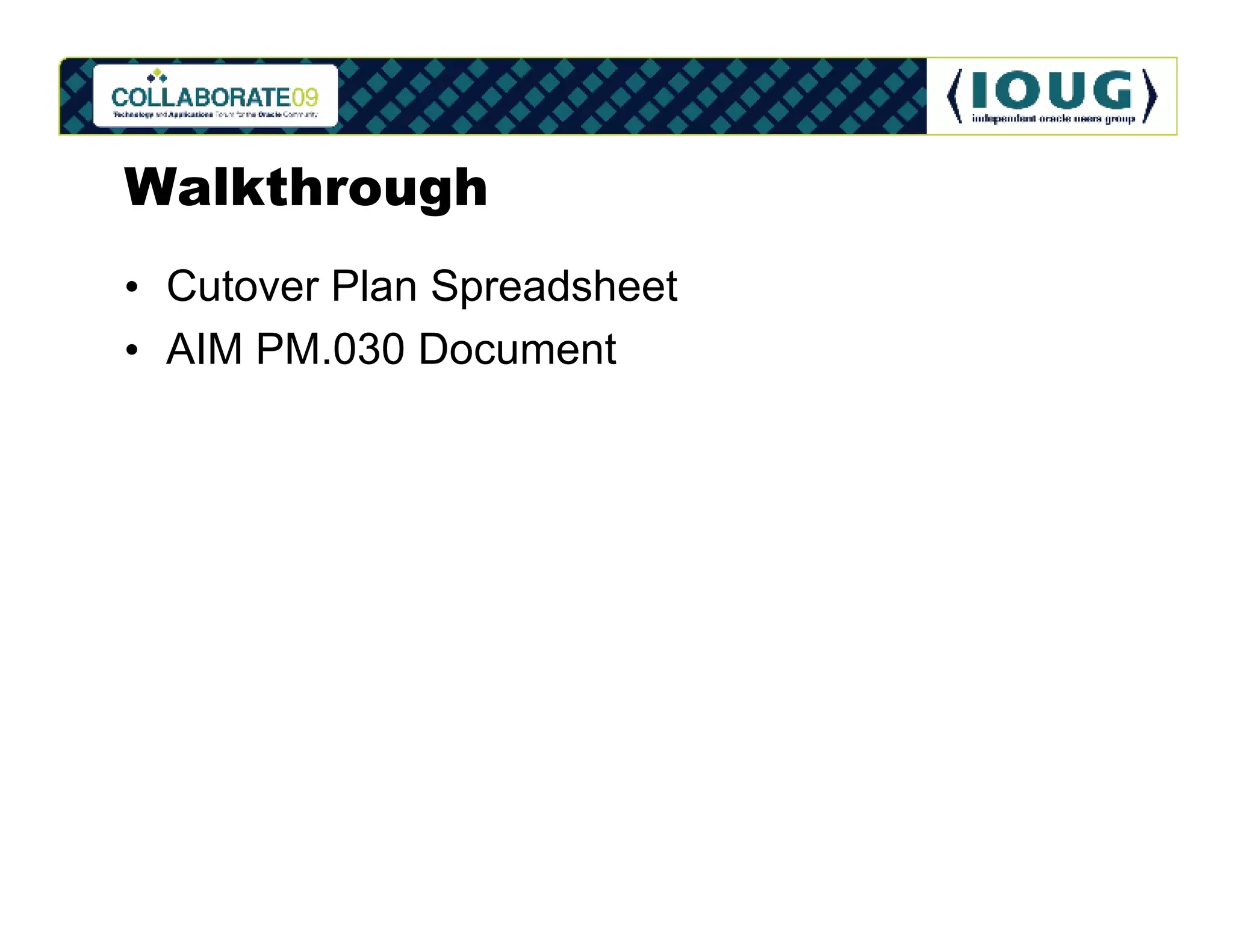

Walkthrough
• Cutover Plan Spreadsheet
• AIM PM.030 Document
Q U E S T I O N S
