BEDIFFERENT                       ACE 2012 I NTERNATI O NAL

Copyright © 2012 Aras. All Rights Reserved.                      aras.com
ACE 2012
                                              INTERNATIONAL

 Aras Innovator
 Deployment Methodology

 Strategies for Success

Copyright © 2012 Aras. All Rights Reserved.            aras.com
Agenda

    Methodology Overview
    Getting Organized
    Resources
    Getting Started
    Breaking down a project
    Some Tips
    How things get sideways
    Final thoughts

Copyright © 2012 Aras. All Rights Reserved.   Slide 3   aras.com

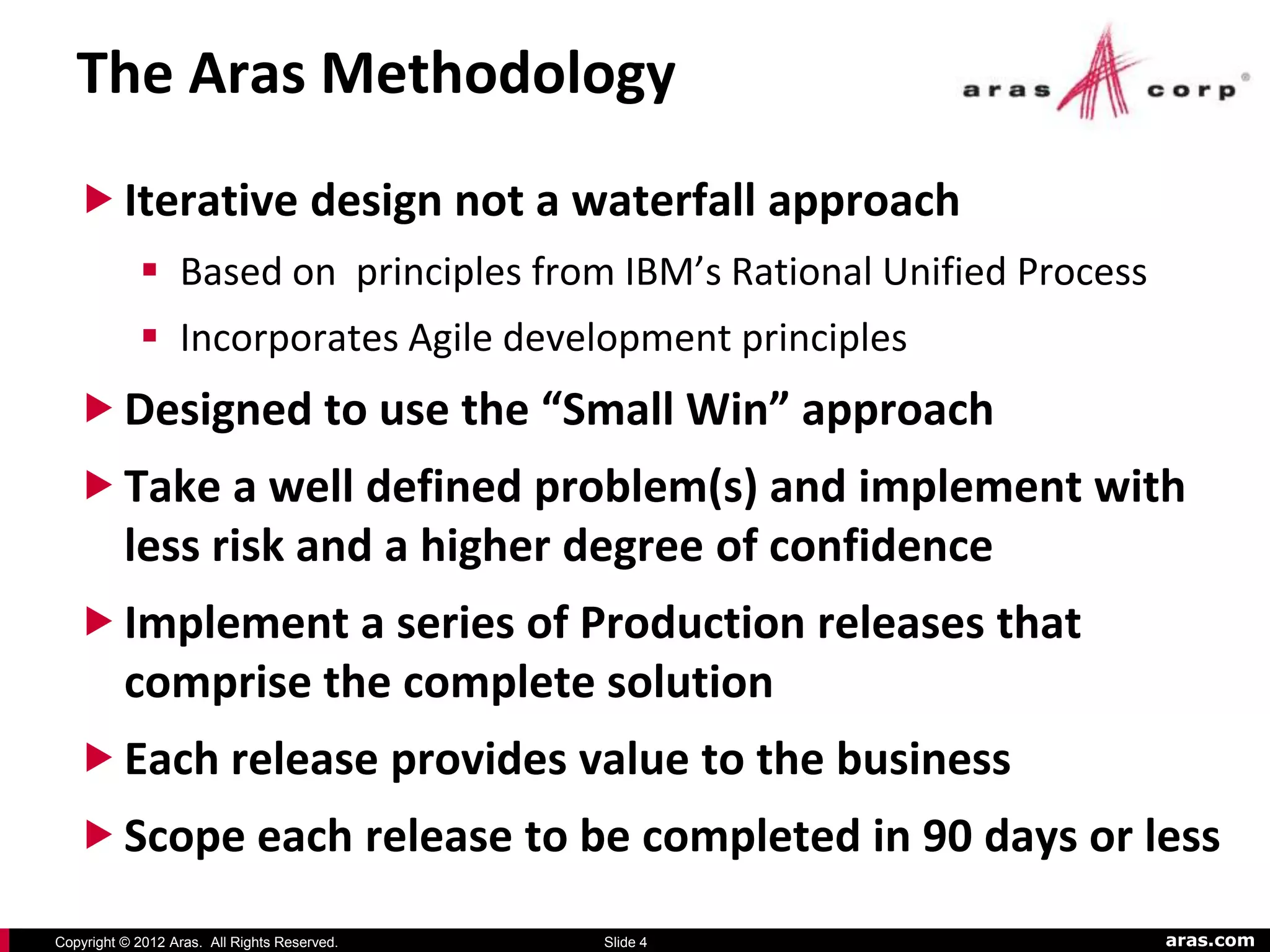

The Aras Methodology
    Iterative design not a waterfall approach
             Based on principles from IBM’s Rational Unified Process
             Incorporates Agile development principles
    Designed to use the “Small Win” approach
    Take a well defined problem(s) and implement with
     less risk and a higher degree of confidence
    Implement a series of Production releases that
     comprise the complete solution
    Each release provides value to the business
    Scope each release to be completed in 90 days or less

Copyright © 2012 Aras. All Rights Reserved.   Slide 4                   aras.com

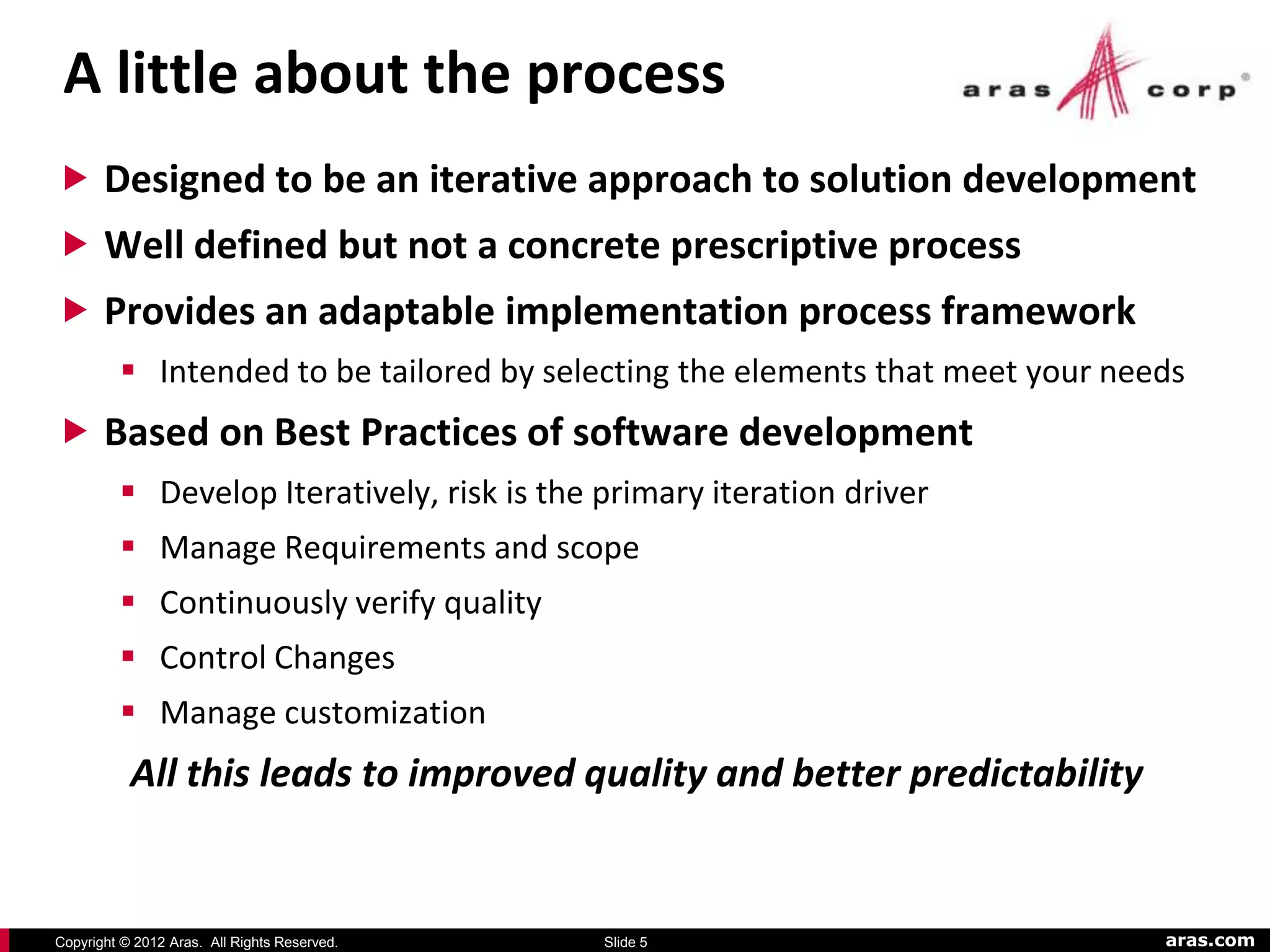

A little about the process
 Designed to be an iterative approach to solution development
 Well defined but not a concrete prescriptive process
 Provides an adaptable implementation process framework
          Intended to be tailored by selecting the elements that meet your needs
 Based on Best Practices of software development
          Develop Iteratively, risk is the primary iteration driver
          Manage Requirements and scope
          Continuously verify quality
          Control Changes
          Manage customization
           All this leads to improved quality and better predictability

Copyright © 2012 Aras. All Rights Reserved.   Slide 5                          aras.com

Iterative Development
                                              The Aras Approach

                                Business value is delivered incrementally in
                                  time-boxed cross-discipline iterations
Copyright © 2012 Aras. All Rights Reserved.            Slide 6                 aras.com
BREAKING DOWN YOUR PROJECT
        Manageable Phases

Copyright © 2012 Aras. All Rights Reserved.   Slide 7   aras.com

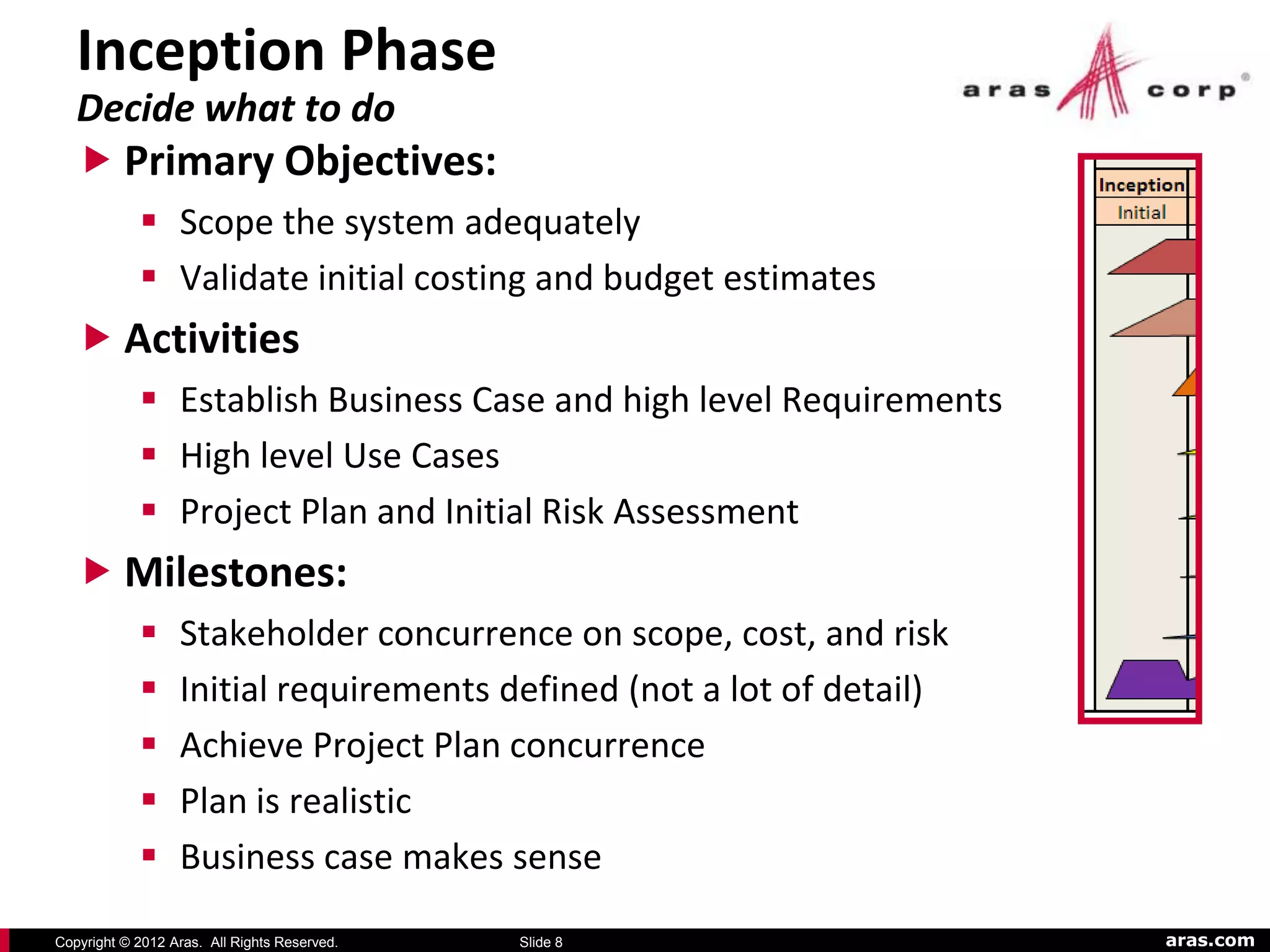

Inception Phase
   Decide what to do
    Primary Objectives:
             Scope the system adequately
             Validate initial costing and budget estimates
    Activities
             Establish Business Case and high level Requirements
             High level Use Cases
             Project Plan and Initial Risk Assessment
    Milestones:
                 Stakeholder concurrence on scope, cost, and risk
                 Initial requirements defined (not a lot of detail)
                 Achieve Project Plan concurrence
                 Plan is realistic
                 Business case makes sense

Copyright © 2012 Aras. All Rights Reserved.   Slide 8                  aras.com

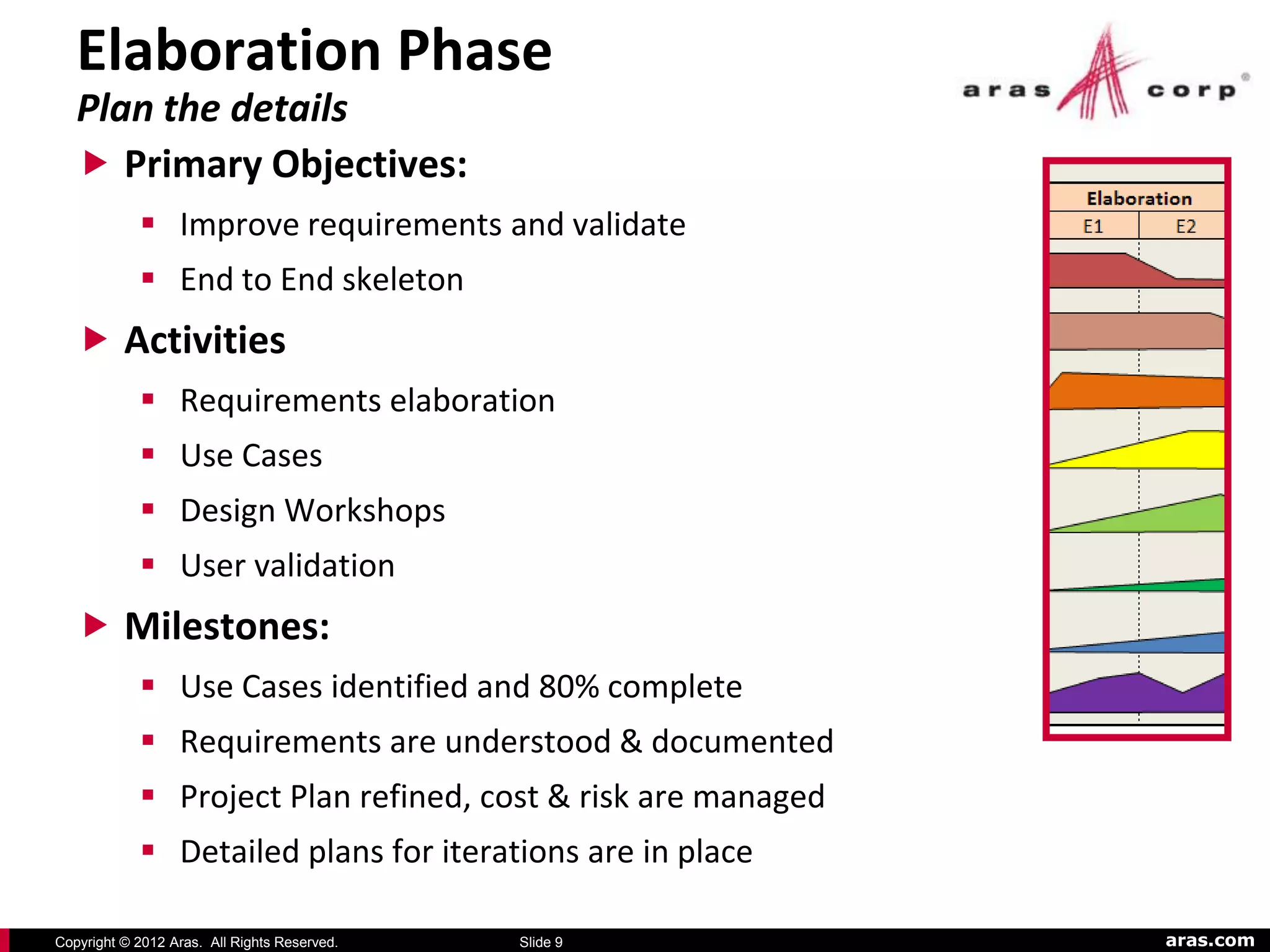

Elaboration Phase
   Plan the details
    Primary Objectives:
             Improve requirements and validate
             End to End skeleton
    Activities
             Requirements elaboration
             Use Cases
             Design Workshops
             User validation
    Milestones:
             Use Cases identified and 80% complete
             Requirements are understood & documented
             Project Plan refined, cost & risk are managed
             Detailed plans for iterations are in place

Copyright © 2012 Aras. All Rights Reserved.   Slide 9         aras.com

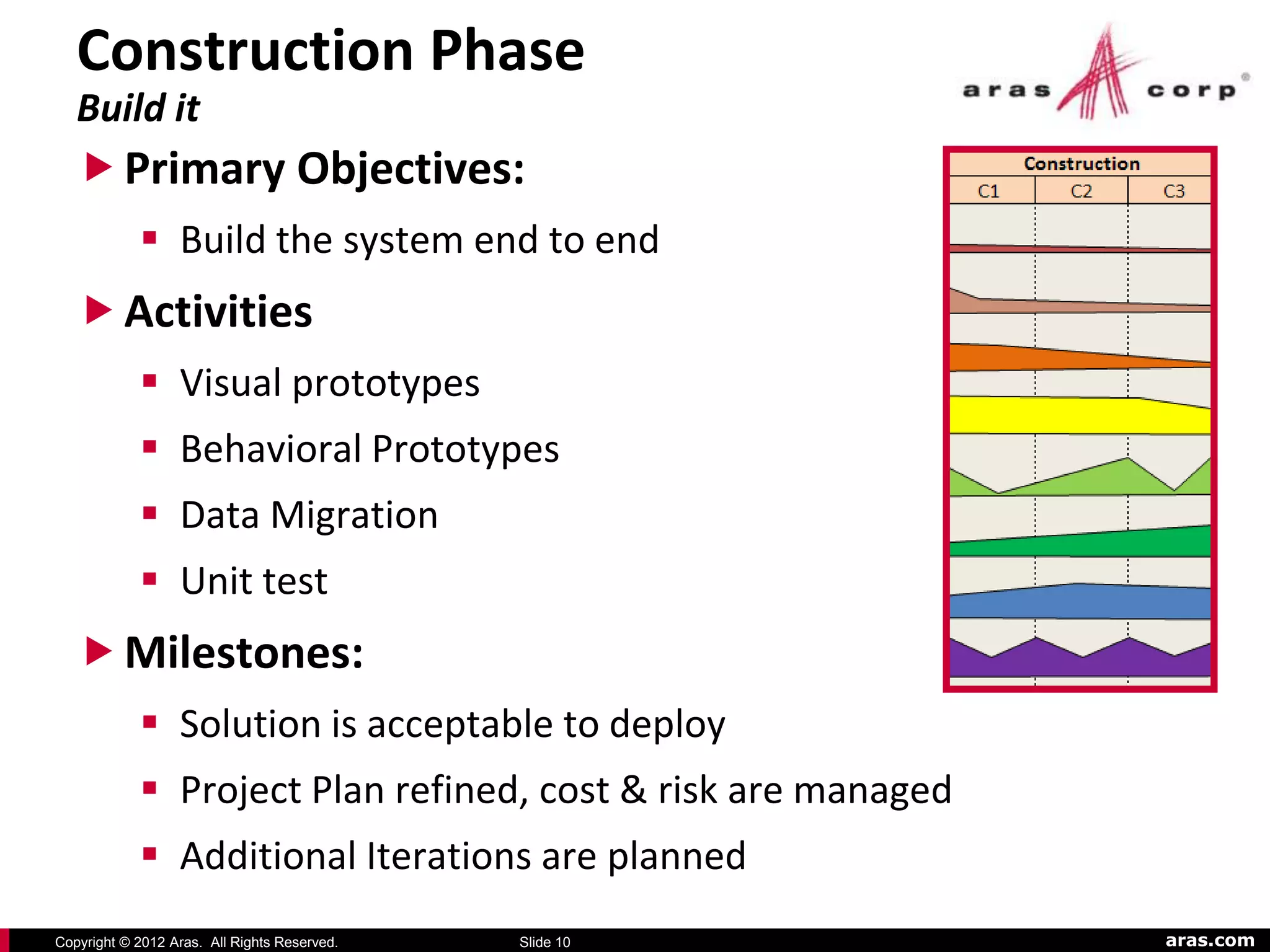

Construction Phase
   Build it
    Primary Objectives:
             Build the system end to end
    Activities
             Visual prototypes
             Behavioral Prototypes
             Data Migration
             Unit test
    Milestones:
             Solution is acceptable to deploy
             Project Plan refined, cost & risk are managed
             Additional Iterations are planned
Copyright © 2012 Aras. All Rights Reserved.   Slide 10        aras.com
Transition Phase
    Deploy it
    Primary Objectives:
             Move the system to production
             Training & fine tuning
    Activities
             End user training
             Documentation
             Full system test (production environment)
    Milestones:
             Solution & documentation is ready to deploy
             Stakeholders are near ready to deploy
             System is functional in production
Copyright © 2012 Aras. All Rights Reserved.   Slide 11      aras.com
OK, GREAT !
        Now how does this apply to Aras Innovator

Copyright © 2012 Aras. All Rights Reserved.   Slide 12   aras.com

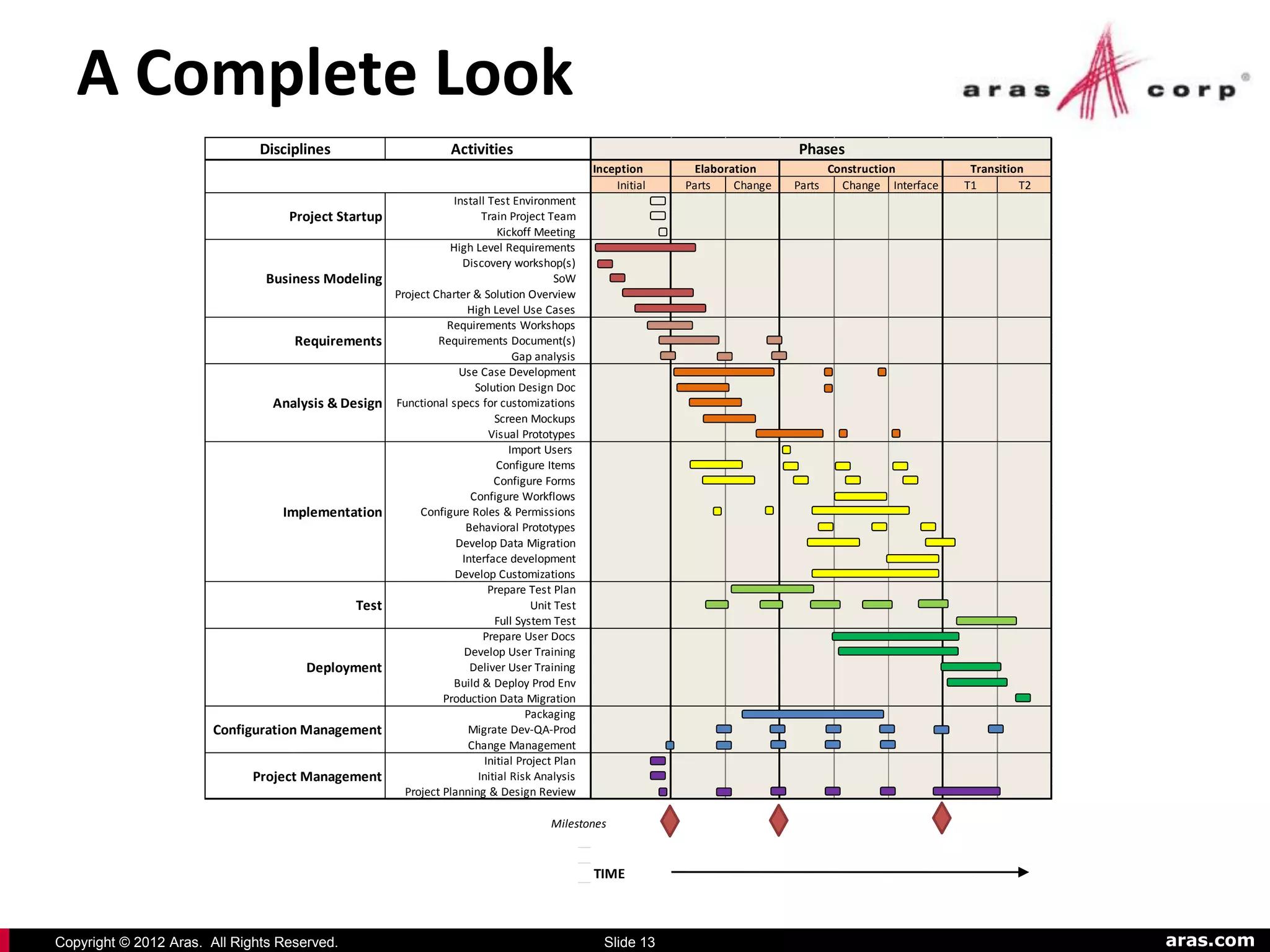

A Complete Look
                               Disciplines                       Activities                                                     Phases
                                                                                                Inception       Elaboration             Construction          Transition
                                                                                                    Initial   Parts    Change   Parts     Change Interface   T1        T2
                                                                 Install Test Environment
                                   Project Startup                      Train Project Team
                                                                            Kickoff Meeting
                                                                High Level Requirements
                                                                   Discovery workshop(s)
                                Business Modeling                                        SoW
                                                     Project Charter & Solution Overview
                                                                    High Level Use Cases
                                                                Requirements Workshops
                                    Requirements              Requirements Document(s)
                                                                                Gap analysis
                                                                  Use Case Development
                                                                      Solution Design Doc
                                 Analysis & Design   Functional specs for customizations
                                                                           Screen Mockups
                                                                          Visual Prototypes
                                                                               Import Users
                                                                            Configure Items
                                                                           Configure Forms
                                                                     Configure Workflows
                                  Implementation          Configure Roles & Permissions
                                                                    Behavioral Prototypes
                                                                  Develop Data Migration
                                                                   Interface development
                                                                 Develop Customizations
                                                                          Prepare Test Plan
                                              Test                                  Unit Test
                                                                           Full System Test
                                                                        Prepare User Docs
                                                                   Develop User Training
                                      Deployment                     Deliver User Training
                                                                 Build & Deploy Prod Env
                                                               Production Data Migration
                                                                                   Packaging
                       Configuration Management                     Migrate Dev-QA-Prod
                                                                    Change Management
                                                                         Initial Project Plan
                              Project Management                       Initial Risk Analysis
                                                       Project Planning & Design Review

                                                                                       Milestones

                                                                                                TIME

Copyright © 2012 Aras. All Rights Reserved.                                                       Slide 13                                                                  aras.com

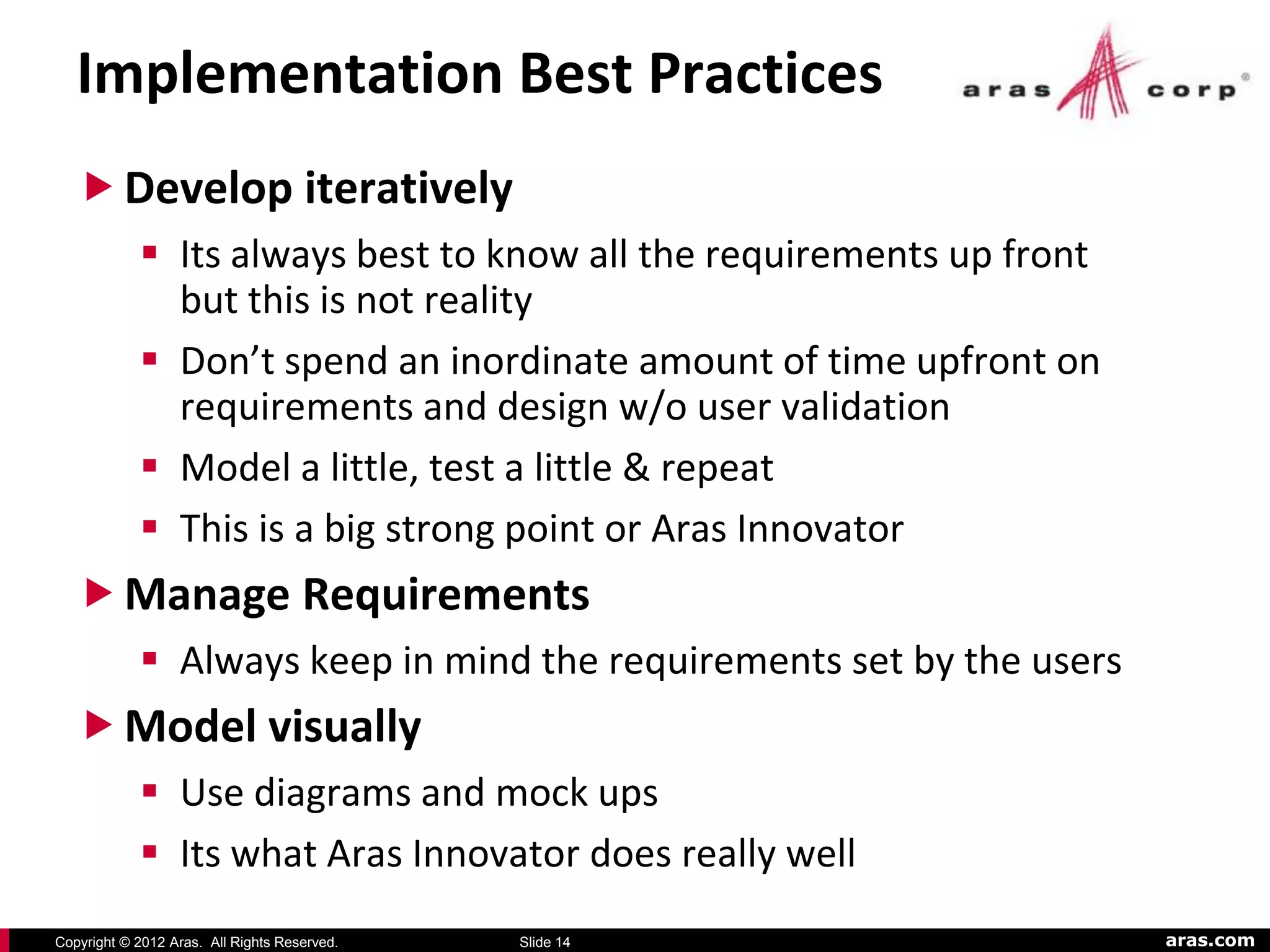

Implementation Best Practices
    Develop iteratively
             Its always best to know all the requirements up front
              but this is not reality
             Don’t spend an inordinate amount of time upfront on
              requirements and design w/o user validation
             Model a little, test a little & repeat
             This is a big strong point or Aras Innovator
    Manage Requirements
             Always keep in mind the requirements set by the users
    Model visually
             Use diagrams and mock ups
             Its what Aras Innovator does really well
Copyright © 2012 Aras. All Rights Reserved.   Slide 14                aras.com
Implementation Best Practices

    Use Components
             Break down large projects into manageable pieces
             Item reuse is a big plus
             Again, this is what Aras Innovator does really well
    Verify Quality
             Always make user testing a major part of the project
    Control Change
             Ensure changes are synchronized and verified constantly
             Use a managed process for implementing iterations

Copyright © 2012 Aras. All Rights Reserved.   Slide 15                  aras.com
Making Iterations work
   Things to think about

    Work does not proceed entirely serial
             This is not a waterfall approach
    Work is done in a serial fashion but you don’t need
          to finalize a discipline before moving on to the next
             Address some requirements, analyze, develop and go back
    Iterations should be planned according to risk
             Higher priority risks first
    Near term iterations are planned in more detail
             Longer term items may change in scope, etc
             Doesn’t mean that longer term items are not planned

Copyright © 2012 Aras. All Rights Reserved.   Slide 16              aras.com
GETTING STARTED
        Who, What & How

Copyright © 2012 Aras. All Rights Reserved.   Slide 17   aras.com

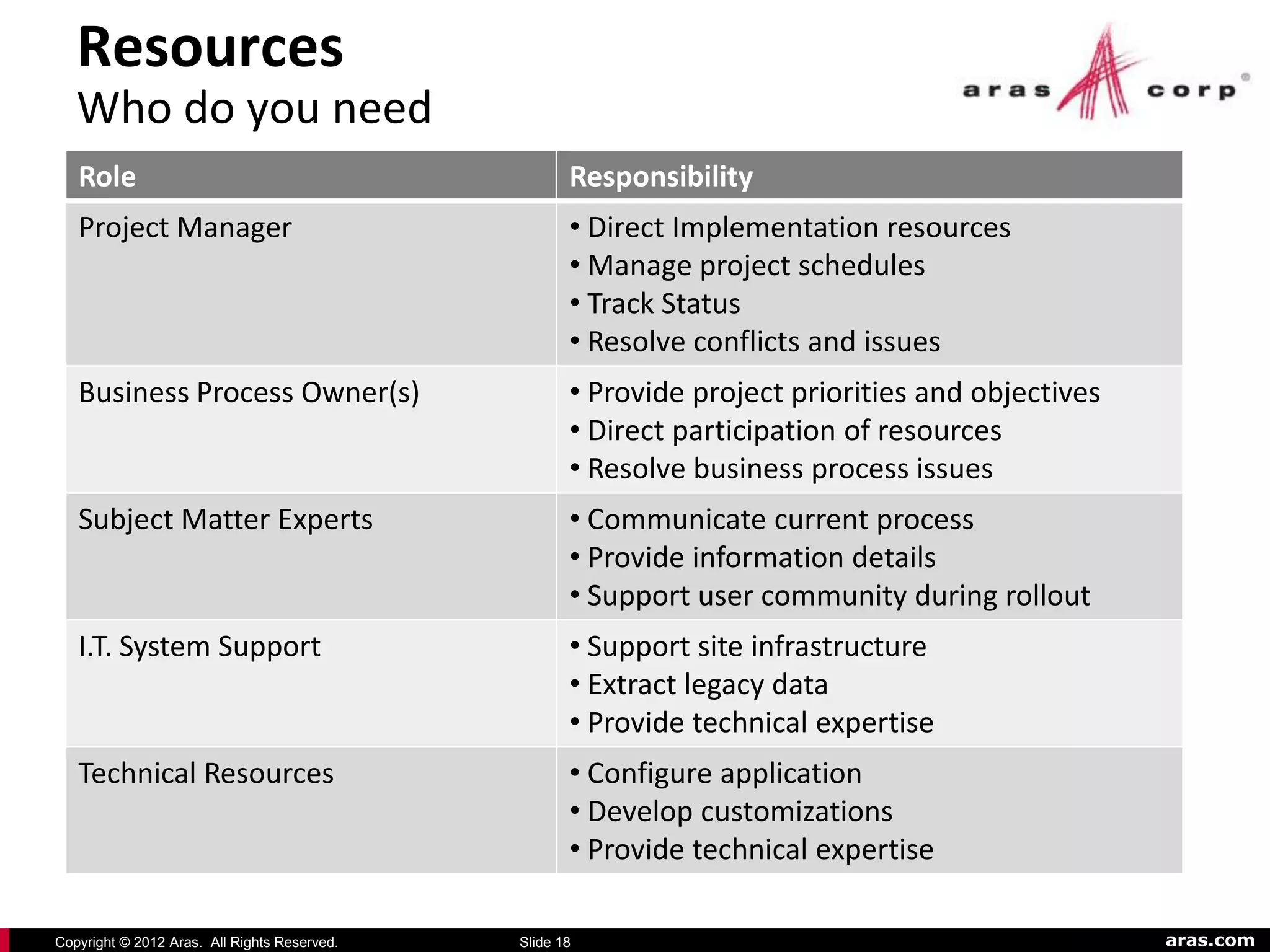

Resources
   Who do you need
   Role                                              Responsibility
   Project Manager                                   • Direct Implementation resources
                                                     • Manage project schedules
                                                     • Track Status
                                                     • Resolve conflicts and issues
   Business Process Owner(s)                         • Provide project priorities and objectives
                                                     • Direct participation of resources
                                                     • Resolve business process issues
   Subject Matter Experts                            • Communicate current process
                                                     • Provide information details
                                                     • Support user community during rollout
   I.T. System Support                               • Support site infrastructure
                                                     • Extract legacy data
                                                     • Provide technical expertise
   Technical Resources                               • Configure application
                                                     • Develop customizations
                                                     • Provide technical expertise

Copyright © 2012 Aras. All Rights Reserved.   Slide 18                                             aras.com

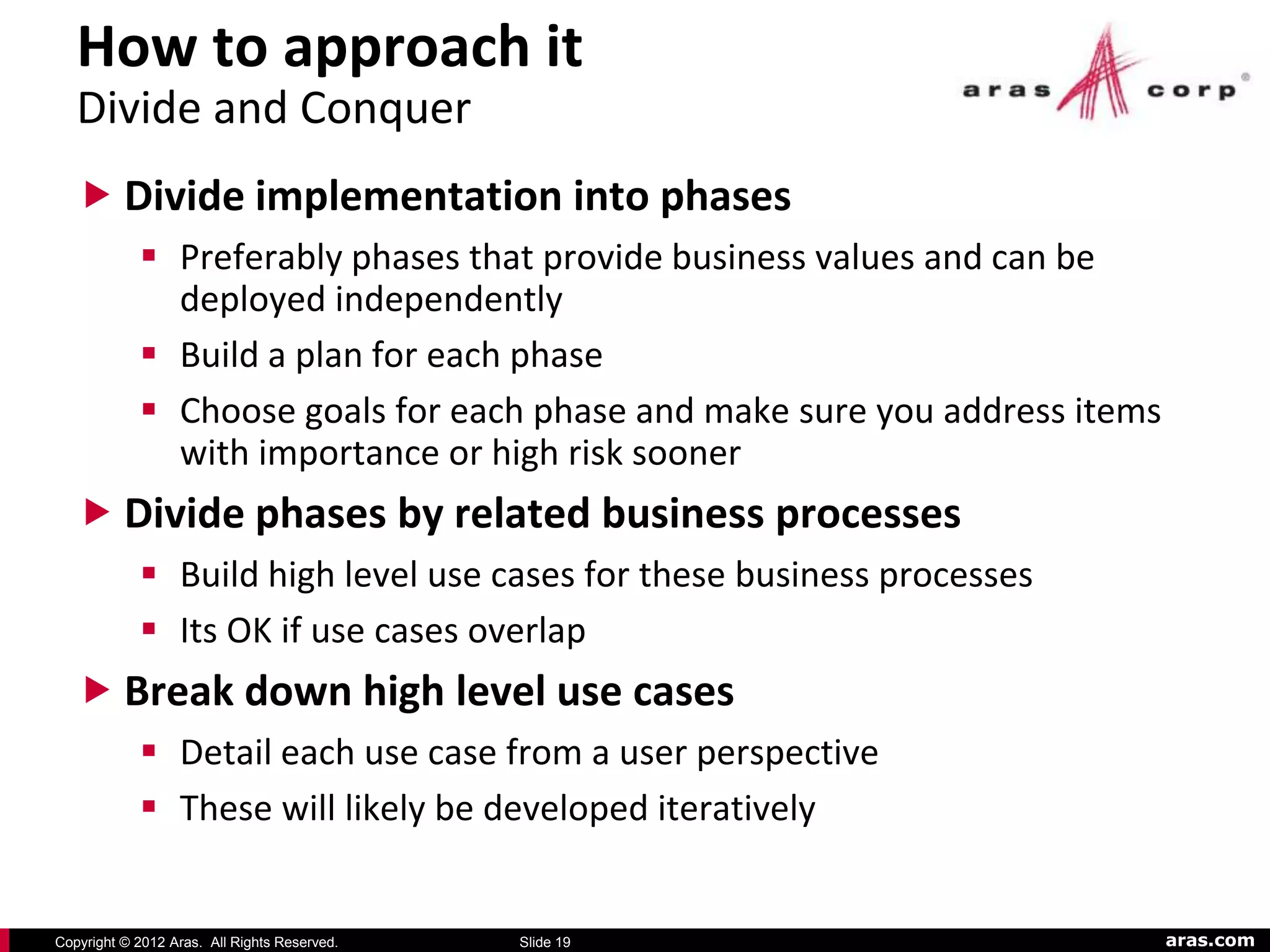

How to approach it
   Divide and Conquer
    Divide implementation into phases
             Preferably phases that provide business values and can be
              deployed independently
             Build a plan for each phase
             Choose goals for each phase and make sure you address items
              with importance or high risk sooner
    Divide phases by related business processes
             Build high level use cases for these business processes
             Its OK if use cases overlap
    Break down high level use cases
             Detail each use case from a user perspective
             These will likely be developed iteratively

Copyright © 2012 Aras. All Rights Reserved.   Slide 19                      aras.com
Getting Started
    Develop a Project Charter if you need funding
             Lets management know what you will do and will not do
             Defines a goal and an endpoint to measure success
             There are plenty of examples on the web
    Develop a Project Plan
             Lets resources know what is expected of them
             Sets the schedule for the project
    Get Trained
             The team needs to understand Aras Innovator
    Review the standard Aras Innovator Solutions
             Required for effective gap analysis
Copyright © 2012 Aras. All Rights Reserved.   Slide 20                aras.com
Getting It Done

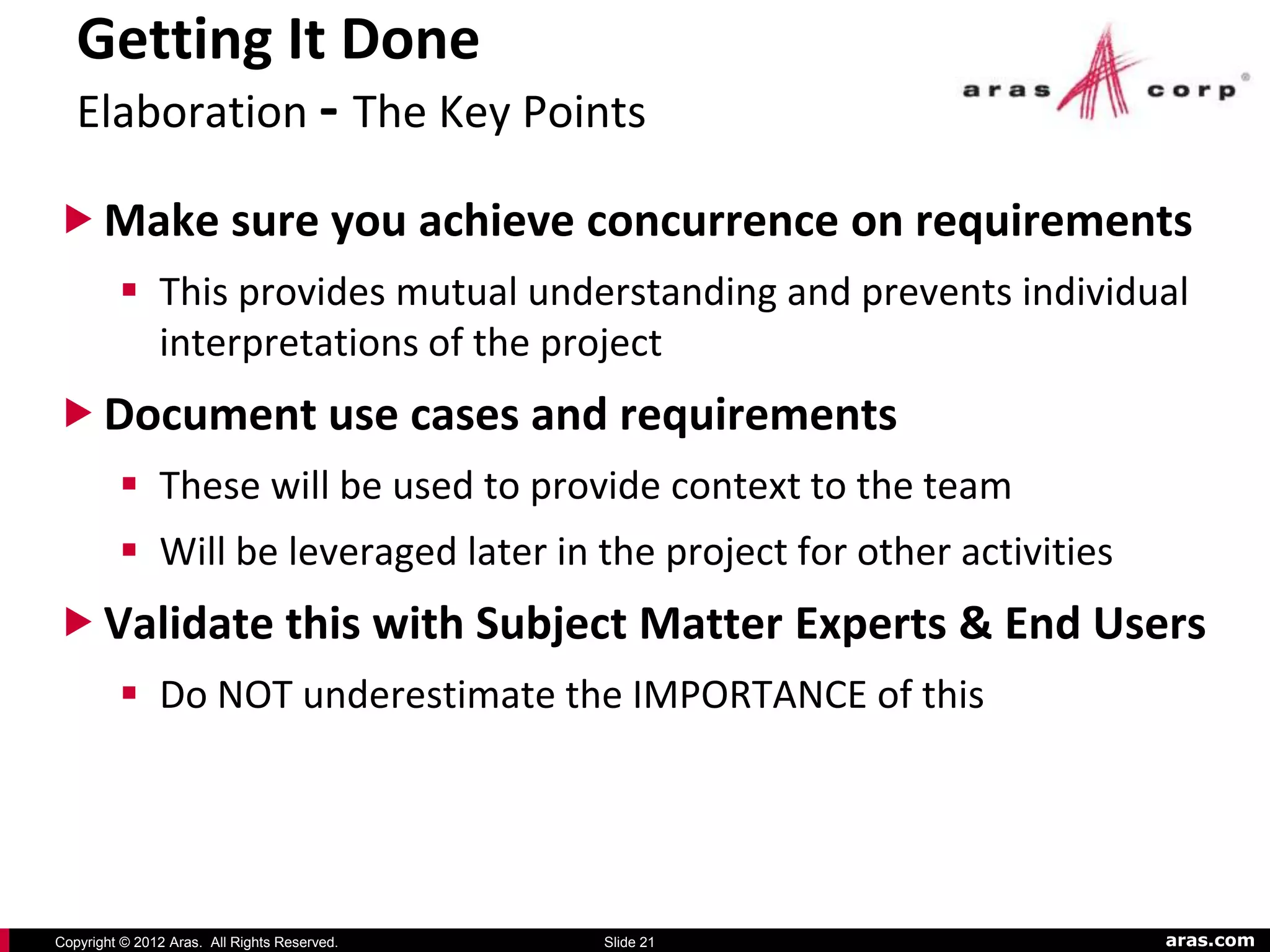

   Elaboration - The Key Points

 Make sure you achieve concurrence on requirements
          This provides mutual understanding and prevents individual
           interpretations of the project
 Document use cases and requirements
          These will be used to provide context to the team
          Will be leveraged later in the project for other activities
 Validate this with Subject Matter Experts & End Users
          Do NOT underestimate the IMPORTANCE of this

Copyright © 2012 Aras. All Rights Reserved.   Slide 21                   aras.com
Getting It Done
   Construction - The Key Points
    Visual Prototypes
             This is just building things in Aras Innovator
             Used to solicit user feedback
             May cause you to revisit use cases and specifications
             Should not include automation
             Don’t worry about getting it 100% right
    Behavioral Prototype
             Adds automation to the Visual Prototype
             Will likely cause you to revisit use cases and specifications
             Will introduce changes to the Visual prototype
             Includes building interfaces and integrations
Copyright © 2012 Aras. All Rights Reserved.   Slide 22                    aras.com
Getting It Done
   Transition – The Key Points
   Test Plans
            These are based on use cases
   Testing and Validation
            Unit testing is important for managing iterations
            Conference Room Pilots are good for user validation
            Full system test
   Training
            Don’t under estimate the time it takes to develop
             materials or train end users
   Production Cutover
            Plan, Plan, Plan, - There WILL be external influences
Copyright © 2012 Aras. All Rights Reserved.   Slide 23               aras.com

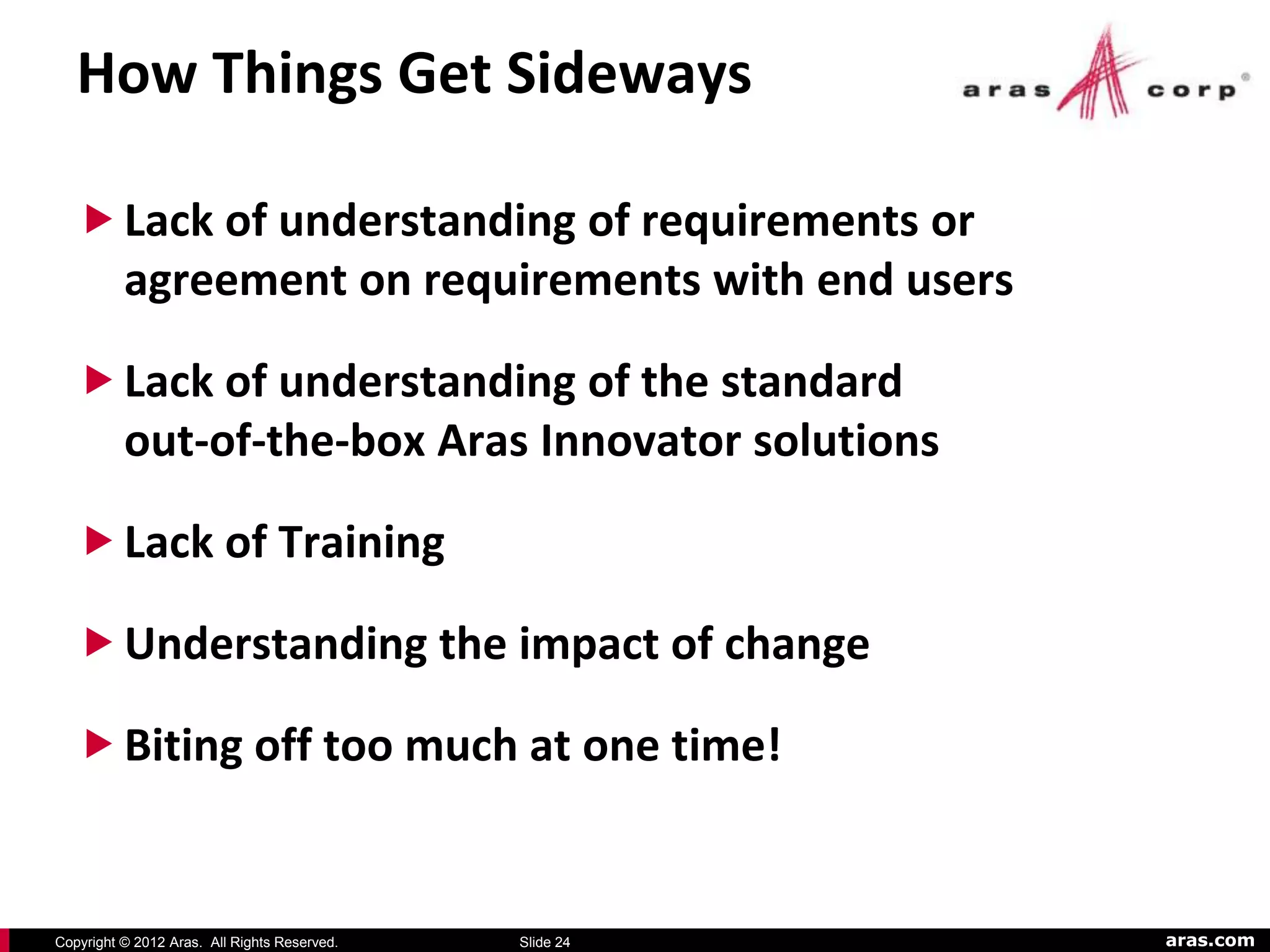

How Things Get Sideways

    Lack of understanding of requirements or
     agreement on requirements with end users

    Lack of understanding of the standard
     out-of-the-box Aras Innovator solutions

    Lack of Training

    Understanding the impact of change

    Biting off too much at one time!

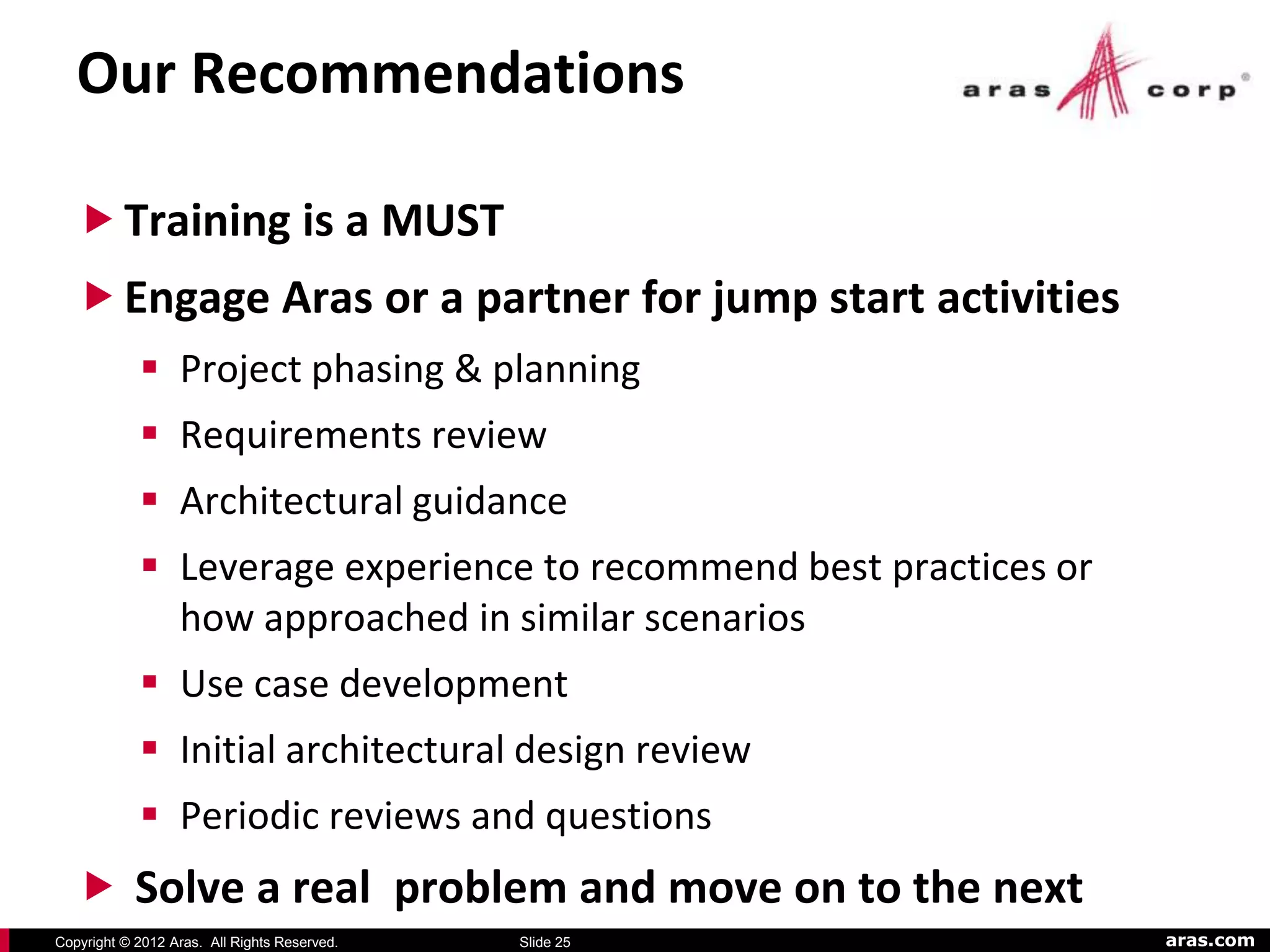

Copyright © 2012 Aras. All Rights Reserved.   Slide 24   aras.com
Our Recommendations

    Training is a MUST
    Engage Aras or a partner for jump start activities
             Project phasing & planning
             Requirements review
             Architectural guidance
             Leverage experience to recommend best practices or
              how approached in similar scenarios
             Use case development
             Initial architectural design review
             Periodic reviews and questions
    Solve a real problem and move on to the next
Copyright © 2012 Aras. All Rights Reserved.   Slide 25             aras.com
Final Thoughts
   Dos and Don’ts

    DO
             Create visual prototypes and get user validation before
              developing any method code
             Develop accurate Use Cases and keep them up to date
                      • They will save you time down the road !!
             Look for “Small Wins” that provide business value
    DON’T
             Spend a significant amount of time developing specs w/o
              prototyping the solution
             Worry about not getting 100% of the detailed
              requirements up front… because you can’t!

Copyright © 2012 Aras. All Rights Reserved.   Slide 26                  aras.com
THANK YOU
        Questions?

Copyright © 2012 Aras. All Rights Reserved.   Slide 27   aras.com

Aras Innovator PLM Deployment Methodology

  • 1.
    BEDIFFERENT ACE 2012 I NTERNATI O NAL Copyright © 2012 Aras. All Rights Reserved. aras.com
  • 2.
    ACE 2012 INTERNATIONAL Aras Innovator Deployment Methodology Strategies for Success Copyright © 2012 Aras. All Rights Reserved. aras.com
  • 3.
    Agenda  Methodology Overview  Getting Organized  Resources  Getting Started  Breaking down a project  Some Tips  How things get sideways  Final thoughts Copyright © 2012 Aras. All Rights Reserved. Slide 3 aras.com
  • 4.
    The Aras Methodology  Iterative design not a waterfall approach  Based on principles from IBM’s Rational Unified Process  Incorporates Agile development principles  Designed to use the “Small Win” approach  Take a well defined problem(s) and implement with less risk and a higher degree of confidence  Implement a series of Production releases that comprise the complete solution  Each release provides value to the business  Scope each release to be completed in 90 days or less Copyright © 2012 Aras. All Rights Reserved. Slide 4 aras.com
  • 5.
    A little aboutthe process  Designed to be an iterative approach to solution development  Well defined but not a concrete prescriptive process  Provides an adaptable implementation process framework  Intended to be tailored by selecting the elements that meet your needs  Based on Best Practices of software development  Develop Iteratively, risk is the primary iteration driver  Manage Requirements and scope  Continuously verify quality  Control Changes  Manage customization All this leads to improved quality and better predictability Copyright © 2012 Aras. All Rights Reserved. Slide 5 aras.com
  • 6.
    Iterative Development The Aras Approach Business value is delivered incrementally in time-boxed cross-discipline iterations Copyright © 2012 Aras. All Rights Reserved. Slide 6 aras.com
  • 7.
    BREAKING DOWN YOURPROJECT Manageable Phases Copyright © 2012 Aras. All Rights Reserved. Slide 7 aras.com
  • 8.
    Inception Phase Decide what to do  Primary Objectives:  Scope the system adequately  Validate initial costing and budget estimates  Activities  Establish Business Case and high level Requirements  High level Use Cases  Project Plan and Initial Risk Assessment  Milestones:  Stakeholder concurrence on scope, cost, and risk  Initial requirements defined (not a lot of detail)  Achieve Project Plan concurrence  Plan is realistic  Business case makes sense Copyright © 2012 Aras. All Rights Reserved. Slide 8 aras.com
  • 9.
    Elaboration Phase Plan the details  Primary Objectives:  Improve requirements and validate  End to End skeleton  Activities  Requirements elaboration  Use Cases  Design Workshops  User validation  Milestones:  Use Cases identified and 80% complete  Requirements are understood & documented  Project Plan refined, cost & risk are managed  Detailed plans for iterations are in place Copyright © 2012 Aras. All Rights Reserved. Slide 9 aras.com
  • 10.
    Construction Phase Build it  Primary Objectives:  Build the system end to end  Activities  Visual prototypes  Behavioral Prototypes  Data Migration  Unit test  Milestones:  Solution is acceptable to deploy  Project Plan refined, cost & risk are managed  Additional Iterations are planned Copyright © 2012 Aras. All Rights Reserved. Slide 10 aras.com
  • 11.
    Transition Phase Deploy it  Primary Objectives:  Move the system to production  Training & fine tuning  Activities  End user training  Documentation  Full system test (production environment)  Milestones:  Solution & documentation is ready to deploy  Stakeholders are near ready to deploy  System is functional in production Copyright © 2012 Aras. All Rights Reserved. Slide 11 aras.com
  • 12.
    OK, GREAT ! Now how does this apply to Aras Innovator Copyright © 2012 Aras. All Rights Reserved. Slide 12 aras.com
  • 13.
    A Complete Look Disciplines Activities Phases Inception Elaboration Construction Transition Initial Parts Change Parts Change Interface T1 T2 Install Test Environment Project Startup Train Project Team Kickoff Meeting High Level Requirements Discovery workshop(s) Business Modeling SoW Project Charter & Solution Overview High Level Use Cases Requirements Workshops Requirements Requirements Document(s) Gap analysis Use Case Development Solution Design Doc Analysis & Design Functional specs for customizations Screen Mockups Visual Prototypes Import Users Configure Items Configure Forms Configure Workflows Implementation Configure Roles & Permissions Behavioral Prototypes Develop Data Migration Interface development Develop Customizations Prepare Test Plan Test Unit Test Full System Test Prepare User Docs Develop User Training Deployment Deliver User Training Build & Deploy Prod Env Production Data Migration Packaging Configuration Management Migrate Dev-QA-Prod Change Management Initial Project Plan Project Management Initial Risk Analysis Project Planning & Design Review Milestones TIME Copyright © 2012 Aras. All Rights Reserved. Slide 13 aras.com
  • 14.
    Implementation Best Practices  Develop iteratively  Its always best to know all the requirements up front but this is not reality  Don’t spend an inordinate amount of time upfront on requirements and design w/o user validation  Model a little, test a little & repeat  This is a big strong point or Aras Innovator  Manage Requirements  Always keep in mind the requirements set by the users  Model visually  Use diagrams and mock ups  Its what Aras Innovator does really well Copyright © 2012 Aras. All Rights Reserved. Slide 14 aras.com
  • 15.
    Implementation Best Practices  Use Components  Break down large projects into manageable pieces  Item reuse is a big plus  Again, this is what Aras Innovator does really well  Verify Quality  Always make user testing a major part of the project  Control Change  Ensure changes are synchronized and verified constantly  Use a managed process for implementing iterations Copyright © 2012 Aras. All Rights Reserved. Slide 15 aras.com
  • 16.
    Making Iterations work Things to think about  Work does not proceed entirely serial  This is not a waterfall approach  Work is done in a serial fashion but you don’t need to finalize a discipline before moving on to the next  Address some requirements, analyze, develop and go back  Iterations should be planned according to risk  Higher priority risks first  Near term iterations are planned in more detail  Longer term items may change in scope, etc  Doesn’t mean that longer term items are not planned Copyright © 2012 Aras. All Rights Reserved. Slide 16 aras.com
  • 17.
    GETTING STARTED Who, What & How Copyright © 2012 Aras. All Rights Reserved. Slide 17 aras.com
  • 18.
    Resources Who do you need Role Responsibility Project Manager • Direct Implementation resources • Manage project schedules • Track Status • Resolve conflicts and issues Business Process Owner(s) • Provide project priorities and objectives • Direct participation of resources • Resolve business process issues Subject Matter Experts • Communicate current process • Provide information details • Support user community during rollout I.T. System Support • Support site infrastructure • Extract legacy data • Provide technical expertise Technical Resources • Configure application • Develop customizations • Provide technical expertise Copyright © 2012 Aras. All Rights Reserved. Slide 18 aras.com
  • 19.
    How to approachit Divide and Conquer  Divide implementation into phases  Preferably phases that provide business values and can be deployed independently  Build a plan for each phase  Choose goals for each phase and make sure you address items with importance or high risk sooner  Divide phases by related business processes  Build high level use cases for these business processes  Its OK if use cases overlap  Break down high level use cases  Detail each use case from a user perspective  These will likely be developed iteratively Copyright © 2012 Aras. All Rights Reserved. Slide 19 aras.com
  • 20.
    Getting Started  Develop a Project Charter if you need funding  Lets management know what you will do and will not do  Defines a goal and an endpoint to measure success  There are plenty of examples on the web  Develop a Project Plan  Lets resources know what is expected of them  Sets the schedule for the project  Get Trained  The team needs to understand Aras Innovator  Review the standard Aras Innovator Solutions  Required for effective gap analysis Copyright © 2012 Aras. All Rights Reserved. Slide 20 aras.com
  • 21.
    Getting It Done Elaboration - The Key Points  Make sure you achieve concurrence on requirements  This provides mutual understanding and prevents individual interpretations of the project  Document use cases and requirements  These will be used to provide context to the team  Will be leveraged later in the project for other activities  Validate this with Subject Matter Experts & End Users  Do NOT underestimate the IMPORTANCE of this Copyright © 2012 Aras. All Rights Reserved. Slide 21 aras.com
  • 22.
    Getting It Done Construction - The Key Points  Visual Prototypes  This is just building things in Aras Innovator  Used to solicit user feedback  May cause you to revisit use cases and specifications  Should not include automation  Don’t worry about getting it 100% right  Behavioral Prototype  Adds automation to the Visual Prototype  Will likely cause you to revisit use cases and specifications  Will introduce changes to the Visual prototype  Includes building interfaces and integrations Copyright © 2012 Aras. All Rights Reserved. Slide 22 aras.com
  • 23.
    Getting It Done Transition – The Key Points  Test Plans  These are based on use cases  Testing and Validation  Unit testing is important for managing iterations  Conference Room Pilots are good for user validation  Full system test  Training  Don’t under estimate the time it takes to develop materials or train end users  Production Cutover  Plan, Plan, Plan, - There WILL be external influences Copyright © 2012 Aras. All Rights Reserved. Slide 23 aras.com
  • 24.
    How Things GetSideways  Lack of understanding of requirements or agreement on requirements with end users  Lack of understanding of the standard out-of-the-box Aras Innovator solutions  Lack of Training  Understanding the impact of change  Biting off too much at one time! Copyright © 2012 Aras. All Rights Reserved. Slide 24 aras.com
  • 25.
    Our Recommendations  Training is a MUST  Engage Aras or a partner for jump start activities  Project phasing & planning  Requirements review  Architectural guidance  Leverage experience to recommend best practices or how approached in similar scenarios  Use case development  Initial architectural design review  Periodic reviews and questions  Solve a real problem and move on to the next Copyright © 2012 Aras. All Rights Reserved. Slide 25 aras.com
  • 26.
    Final Thoughts Dos and Don’ts  DO  Create visual prototypes and get user validation before developing any method code  Develop accurate Use Cases and keep them up to date • They will save you time down the road !!  Look for “Small Wins” that provide business value  DON’T  Spend a significant amount of time developing specs w/o prototyping the solution  Worry about not getting 100% of the detailed requirements up front… because you can’t! Copyright © 2012 Aras. All Rights Reserved. Slide 26 aras.com
  • 27.
    THANK YOU Questions? Copyright © 2012 Aras. All Rights Reserved. Slide 27 aras.com
