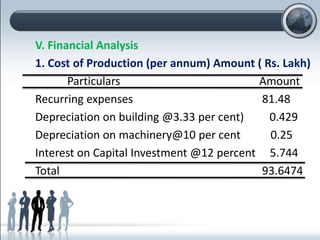

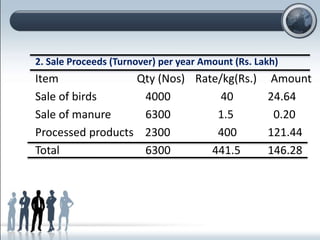

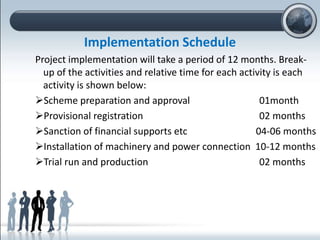

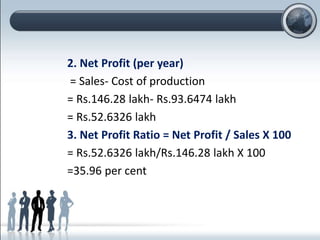

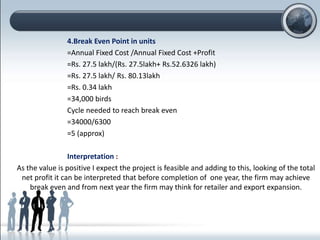

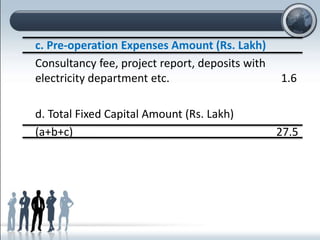

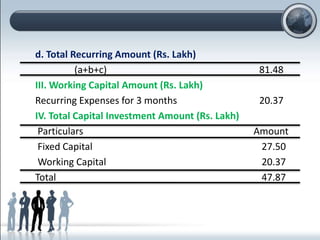

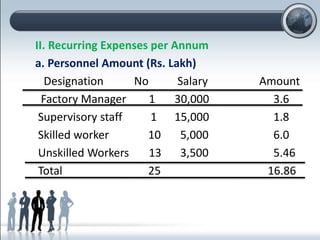

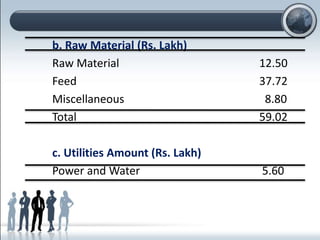

This presentation summarizes a proposed Rs. 48 lakh project to establish a chicken processing facility. The project would process 7,000 chickens per day at full capacity. Key details include an implementation schedule of 12 months, production capacity of 10,000 chickens per day, and 25 employees. Financial analysis estimates annual recurring costs of Rs. 81.48 lakh but also annual sales of Rs. 146.28 lakh, yielding a net profit of Rs. 52.63 lakh and a break-even point of 34,000 chickens (approximately 5 cycles to break even). The presentation concludes the project is feasible and could achieve break-even within the first year.
