Skip to main content
14th February 2020
Bibhuti Bhusan Gadanayak
Senior Technical Advisor
UNDP-MINEMA, Kigali – Nyarugemge
KN 3 Rd. – KN 1 Av – Pension Plazza
Rwanda
NATIONAL
STRATEGY FOR
DRR - RWANDA
CONTENTS1. Country profile – Rwanda
2. Hazard & vulnerability of Rwanda
3. What is DRR strategy?
4. Why DRR strategy?
5. Chart of SFDRR – 2015-2030
6. SFDRR Targets
7. SFDRR indicators 2015-2030 – target-e
8. Target audience
9. Phases and steps to develop NSDRR
10.10 Steps to develop NSDRR
11.Thank you

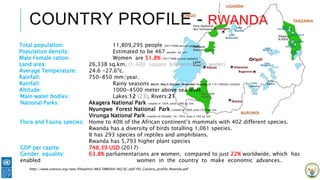

COUNTRY PROFILE - RWANDA
Total population: 11,809,295 people (2017 NISR annual updates)
Population density: Estimated to be 467 people/ sq. km.
Male Female ration: Women are 51.8% (2017 NISR annual updates)
Land area: 26,338 sq.km. (1,400 square kilometres of water)
Average Temperature: 24.6 -27.6ºc.
Rainfall: 750-850 mm/year.
Rainfall: Rainy seasons March –May & October –November (Average of 110-200mm./month)
Altitude: 1000-4500 meter above sea level.
Main water bodies: Lakes:12 (23), Rivers:21
National Parks: Akagera National Park created in 1934, area: 1080 sq. km.
Nyungwe Forest National Park created in 2004, area:1019 sq. km.
Virunga National Park created on October 1st, 1925, area is 160 sq. km
Flora and Fauna species: Home to 40% of the African continent’s mammals with 402 different species.
Rwanda has a diversity of birds totalling 1,061 species.
It has 293 species of reptiles and amphibians.
Rwanda has 5,793 higher plant species
GDP per capita: 748.39 USD (2017)
Gender equality: 63.8% parliamentarians are women, compared to just 22% worldwide, which has
enabled women in the country to make economic advances.
http://www.unesco.org/new/fileadmin/MULTIMEDIA/HQ/SC/pdf/FEI_Country_profile_Rwanda.pdf
HAZARD & VULNERABILITY OF
RWANDAKey shocks and stress experienced in
Rwanda :
Floods
Heavy rains & Winds
Landslides
Thunderstorm
Lightening
Fire
Hailstorm
201
1
2012 2013 2014 2015 2016 2017 2018 Total
Floods 3 23 10 35 45 47 54 39 256
Heavy rains &
Winds
58 60 167 179 92 343 538 151 1588
Landslides 5 8 14 17 31 87 24 34 220
Thunderstorm 15 24 40 66 58 24 20 247
Lightening 90 73 55 68 286
Fire 0 2 12 30 38 45 48 15 190
Hailstorm 9 17 14 140
TOTAL 81 117 243 327 354 628 756 321 2827
Disaster Occurrence in Rwanda (2011-2018)
Source: Ministry in Charge of Emergency Management, 2018, https://www.bbc.com/news/world-africa-44031799, https://www.newtimes.co.rw/news/death-toll-recent-heavy-rains-rises-over-100
WHAT IS DRR STRATEGY
DRR strategies are the cornerstone of formalised action for reducing
natural hazard-related disaster risk and setting the strategic direction
for a district, country or region to become more resilient to disasters.
DRR strategies ‘define goals and objectives across different time scales
and with concrete targets, indicators and timeframes’.
In line with the SFDRR 2015–30, local to regional strategies should aim
to prevent the creation of disaster risk, reduce existing risk and
strengthen ‘economic, social, health and environmental resilience’
(UNISDR, 2017).
National DRR strategies provide a means for governments to articulate
their intentions to protect citizens against current and future disaster
risk, and act as an instrument through which civil society can hold
governments accountable for those actions.
WHY DRR STRATEGY?
Ensure that DRR is a national and a local priority with a strong
institutional basis for implementation’, and the responsibilities of
states for achieving DRR were identified, the emphasis was on
institutions and processes, not national DRR plans and strategies
(UNISDR, 2017)
1. A strong governance mechanism and legal
frameworks to manage the process of developing a
DRR strategy and enabling implementation.
2. Comprehensive understanding of disaster risk and
coping capacities to inform disaster risk management
(DRM) measures.
3. Sufficient and stable financial resources to implement
the strategy.
4. Technical and institutional implementation capacities.
5 critical enabling elements have been identified as important (UNISDR,
2017b):
CHART OF SFDRR – 2015-2030Scope and purpose
The present framework will apply to the risk of small-scale and large-scale, frequent and infrequent, sudden and slow-onset disasters,
hazards as well as related environmental, technological and biological hazards and risks. It aims to guide the multi-hazard management of
all levels as well as within and across all sectors.
Expected outcome
The substantial reduction of disaster risk and losses in lives, livelihoods and health and in the economic, physical, social, cultural and
businesses, communities and countries
Goal
Prevent new and reduce existing disaster risk through the implementation of integrated and inclusive economic, structural, legal, social,
environmental, technological, political and institutional measures that prevent and reduce hazard exposure and vulnerability to
for response and recovery, and thus strengthen resilience
Targets
Substantially
global disaster
mortality by 2030,
aiming to lower
average per
global mortality
between 2020-
compared to 2005-
2015
Substantially
number of affected
people globally by
aiming to lower the
average global
per 100,000
2020-2030
2005-2015
Reduce
disaster
economic
in relation to
global gross
domestic
product
by 2030
Substantially reduce
disaster damage to
infrastructure and
disruption of basic
services, among them
health and
facilities, including
developing their
by 2030
Substantially
increase the
number of
countries with
national and
disaster risk
reduction
strategies by
Substantially enhance
international
developing countries
through adequate and
sustainable support to
complement their
actions for
of this framework by
Substantially
the availability of
access to multi-
early warning
and disaster risk
information and
assessments to
by 2030
Priorities for Action
There is a need for focused action within and across sectors by States at local, national, regional and global levels in the following four
Priority 1
Understanding
Priority 2
Strengthening disaster risk
Priority 3
Investing in disaster risk reduction for
Priority 4
Enhancing disaster preparedness for
Year Target
2016 A Substantially reduce global disaster mortality by 2030, aiming to lower the average per100,000 global
mortality rate in the decade 2020-2030 compared to the period 2005-2015;
2017 B Substantially reduce the number of people affected globally by 2030, aiming to lower the average
global figure per100,000 in the decade 2020-2030 compared to the period 2005-2015
2018 C Reduce direct disaster economic loss in relation to global gross domestic product (GDP) by2030;
2019 D Substantially reduce disaster damage to critical infrastructure and disruption of basic services, among
them health and educational facilities, including through developing their resilience by 2030;
2020 E Substantially increase the number of countries with national and local DRR strategies by 2020;
2021 F Substantially enhance international cooperation to developing countries through adequate and
sustainable support to complement their national actions for implementation of the present
Framework by 2030;
2022 G Substantially increase the availability of and access to multi hazard early warning systems and disaster
risk information and assessments to people by 2030

SFDRR-TARGETS
Targe
ts
Indicator
s
A 3
B 5
C 6
D 8
E 2
F 8
G 6
SFDRR INDICATORS 2015-2030 –
TARGET-E
Information should be provided on the appropriate levels of
government below the national level with responsibility for
E-1 Number of countries that adopt
and implement national disaster
risk reduction strategies in line with
the Sendai Framework for Disaster
Risk Reduction 2015-2030.
E-2 Percentage of local
governments that adopt and
implement local disaster risk
reduction strategies in line with
national strategies.

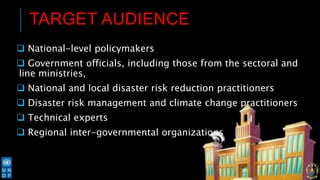

TARGET AUDIENCE
 National-level policymakers
 Government officials, including those from the sectoral and
line ministries,
 National and local disaster risk reduction practitioners
 Disaster risk management and climate change practitioners
 Technical experts
 Regional inter-governmental organizations
Phase I: Building understanding and evidence
Phase II: Designing the strategy and action
plan
Phase III: Preparing for implementation
THE DEVELOPMENT OF A SUCCESSFUL AND
IMPLEMENTABLE NATIONAL DRR STRATEGY
REQUIRES A FEW FUNDAMENTAL BUILDING
BLOCKS THAT CAN BE GROUPED UNDER THE
FOLLOWING PHASES
Phase I Phase II Phase III
STEP1
STEP2
STEP3
STEP4
STEP5
STEP6
STEP7
STEP8
STEP9
STEP10
10 STEPS TO DEVELOP A NATIONAL
DRR STRATEGY.
STEP 1 Understand the DRR country context: conduct a preliminary assessment and stocktaking of
the existing disaster risk reduction system
STEP 2 Define the high-level objectives and vision of the DRR strategy
STEP 3 Define the most appropriate multi-sectoral institutional mechanism to lead the
development of the national DRR strategy
STEP 4 Evaluate the availability of financial resources – engage in dialogue with ministry of finance
STEP 5 Design the work plan for developing the national DRR strategy
STEP 6 Publicly communicate and reach out on the process of developing the national DRR strategy
STEP 7 Consolidate evidence into a draft strategy
STEP 8 Secure and activate funding sources for implementation
STEP 9 Mobilize partnerships for country-level implementation
STEP 10 Set up a monitoring, evaluation and reporting mechanism linked to the national strategy
implementation

TABLE OF CONTENTS’ NSDRR
1. Preface, including adoption decision
 How will the strategy be endorsed, financed, and monitored during implementation?
 What is the legal status of the document? What time period will it cover?
 Executive Summary
2. Introduction
 Why and how are we doing this?
2.1. Context: importance and urgency
 Why is a national DRR strategy needed?
2.2. Scope and structure of the document
 What are the contents and how should one read the document? What are the limitations of the document
considering its scope?
2.3. Linkage of national DRR strategy to local DRR strategies
 How does the national DRR strategy link with local DRR strategies?
2.4. Legal framework and place within national policy
 On what legislation is the strategy based? How does the strategy relate to general national policy planning and to
other relevant strategies, such as a national development plan, national climate change adaptation strategy etc.?
2.5. Process of development
 How was the document developed? Who was involved and who should have been involved but was not? How did we
manage engagement and consultations with the whole of society?
TABLE OF CONTENTS’ NSDRR
CONTD.
3. Current situation and trends: challenges Where are we now?
3.1. Disaster risk
 What are the conclusions of the national disaster risk assessment (including data on historical
losses)? What are the major hazards, exposed elements and vulnerabilities? What trends are
expected (risk drivers, drivers for climate change and adapting to it etc.)?
3.2. Gaps in DRR governance system
 What are the identified gaps in the current DRR governance system, including legislation,
capacities, monitoring and evaluation?
3.3. Summary of challenges
 What are the main challenges (in risk and capacities) that need to be addressed in the strategy?
What are the current gaps in capacities (DRR capacities and coping capacities)?

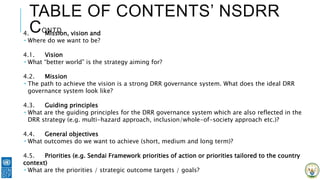

TABLE OF CONTENTS’ NSDRR
CONTD4. Mission, vision and
 Where do we want to be?
4.1. Vision
 What “better world” is the strategy aiming for?
4.2. Mission
 The path to achieve the vision is a strong DRR governance system. What does the ideal DRR
governance system look like?
4.3. Guiding principles
 What are the guiding principles for the DRR governance system which are also reflected in the
DRR strategy (e.g. multi-hazard approach, inclusion/whole-of-society approach etc.)?
4.4. General objectives
 What outcomes do we want to achieve (short, medium and long term)?
4.5. Priorities (e.g. Sendai Framework priorities of action or priorities tailored to the country
context)
 What are the priorities / strategic outcome targets / goals?
TABLE OF CONTENTS’ NSDRR
CONTD
5. Overview of action plan What are we going to do to get there? see action
plan template below
STRATEGI
C
OUTCOME
TARGET/
GOAL
(e.g. Sendai Framework Priorities and/or other nationally defined priorities that support
achievement of the global targets)
RESULT/IM
PACT
INDICATOR
The end-result/impact of the Target/Goal. May be tied to national development plan. The
change that is logically expected to occur once one or more Outcome Objectives have been
realized. Usually achieved by the end of the Strategy timeframe. (e.g. Reduction of disaster
mortality, persons affected, economic loss, increase in access to early warning, etc.)
OUTC OME
OBJECTIV
E(S)
OUTCOME INDICATORS
(specific, measurable,
attainable, realistic) Option:
May select/adapt relevant
Sendai Framework Monitor
custom indicators
OUTPUTS
(products,
tools,
services- e.g.
risk profiles)
ACTIVITI
ES
TIME
FRAME
(time
bound)
RESPONSIB
LE
(+Support
Agencies)
(assignable)
BUDG
ET
ESTIM
ATE
BUDGE
T
SOURC
E
TABLE OF CONTENTS’ NSDRR
CONTD
6. Implementation strategy How do we ensure we can get there?
6.1. Governance of implementation
 Who coordinates the implementation? What are the responsibilities of each stakeholder? How do they cooperate? How to
make the implementation of the strategy sustainable? How can the strategy be incorporated in relevant sectoral and sub-
national policies?
6.2. Financial resources
 What are the financial provisions for prevention, preparedness, response and recovery? What are the sources of funding
for the strategy? What are the procedures for assigning long-term and annual budgets?
6.3. Communication
 What is the overarching strategy for the role of media and communication mechanisms in DRR and in implementation of
the strategy?
6.4. Whole-of-society engagement
 How will the whole of society be involved in the implementation?
6.5. International cooperation and global partnership
 What are the arrangements for cross-border, regional and international cooperation? How does the strategy link to the
Sendai Framework?
TABLE OF CONTENTS’ NSDRR
CONTD
7. Monitoring, evaluation and reporting
 How do we monitor our progress and adapt to the actual situation?
7.1. Monitoring and progress reporting
 How and how often will the progress of implementation be reported (and to whom)? What are
the indicators?
7.2. Evaluation
 When and how will the strategy be evaluated?
7.3. Updating and adapting
 How often will this strategy be updated? What may trigger an update?
REFERENCE
1. http://www.unesco.org/new/fileadmin/MULTIMEDIA/HQ/SC/pdf/FEI_Country_profile_Rwanda.pdf
2. https://www.google.com/search?sxsrf=ACYBGNT-3oP_Wq-
pVCPzamrc9Ddcn4wURg%3A1578053088584&source=hp&ei=4C0PXtmbIeCGjLsPloiI4AQ&q=gdp+of+
rwanda&oq=GDP+&gs_l=psy-ab.1.0.0l10.1773.2977..5638...1.0..0.388.1062.2-3j1......0....1..gws-
wiz.......0i131.aYbzu2SFGgs
3. https://www.unicef.org/rwanda/situation-children-rwanda
4. https://www.odi.org/sites/odi.org.uk/files/resource-documents/12690.pdf
5. Developing National Disaster Risk Reduction Strategies (2019), Words in to action, UNDRR
6. Gadanayak, BB and Routray, JK (2010), A path to disaster resilient communities: Comparative
assessment of CBDRM programme in multi-hazard prone areas of Orissa, India, LAMBERT Academic
publishing, Germany
https://www.amazon.com/path-disaster-resilient-communities-multi-hazard/dp/3843366667
7. National disaster risk management plan, 2013, MINEMA, Rwanda
http://minema.gov.rw/uploads/tx_download/National_Disaster_Risk_Management_Plan_01.pdf
8. National disaster management policy, 2012, Rwanda
https://www.preventionweb.net/english/professional/policies/v.php?id=42438
THANK
YOU
