SlideShare a Scribd company logo
Guide for
Planning &
Conducting
a Kaizen Event

© Operational Excellence Consulting. All rights reserved.

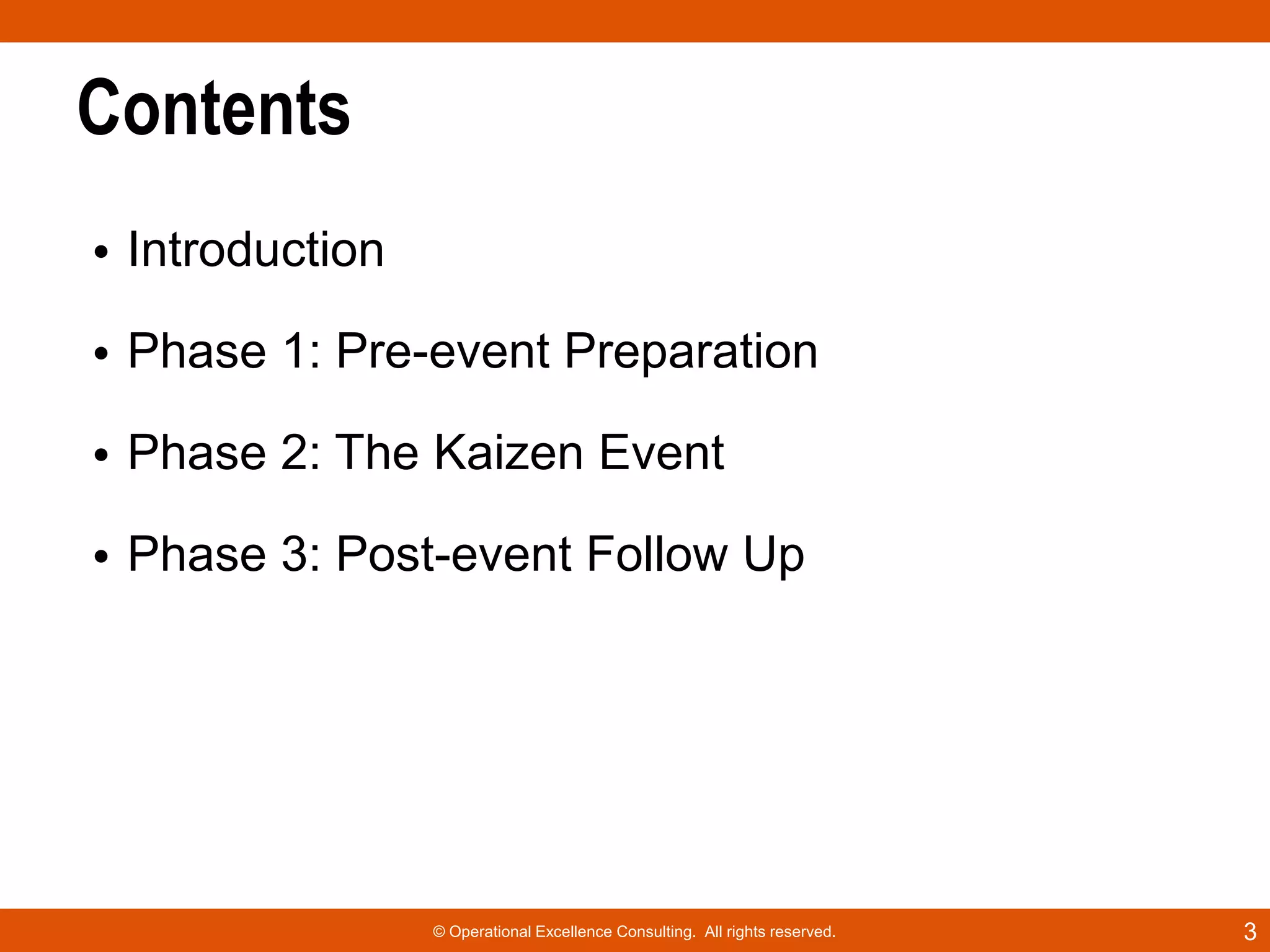

Contents
• Introduction
• Phase 1: Pre-event Preparation
• Phase 2: The Kaizen Event

• Phase 3: Post-event Follow Up

© Operational Excellence Consulting. All rights reserved.

3

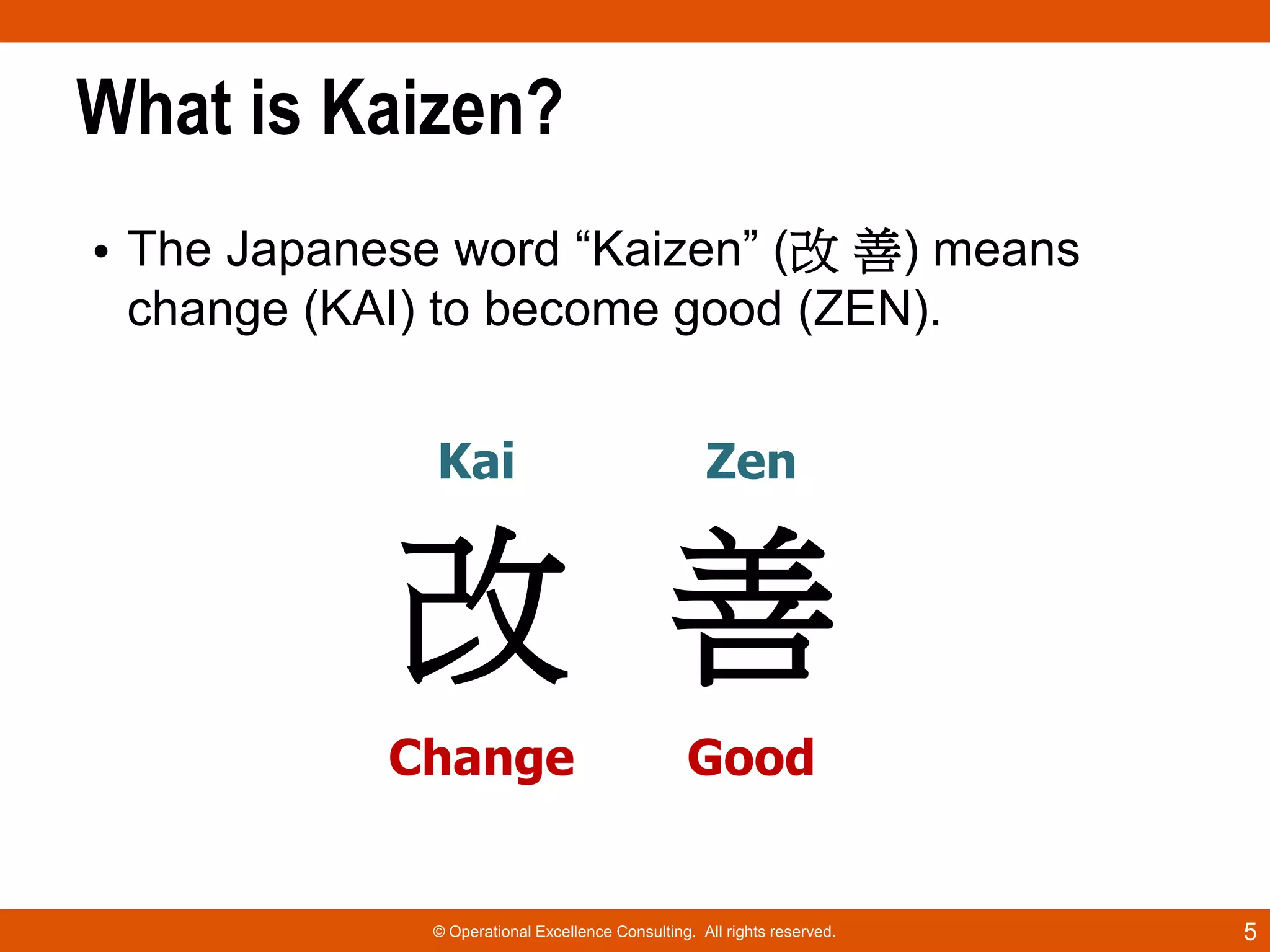

What is Kaizen?
• The Japanese word “Kaizen” (改 善) means
change (KAI) to become good (ZEN).
Kai

Zen

改 善
Change

Good

© Operational Excellence Consulting. All rights reserved.

5

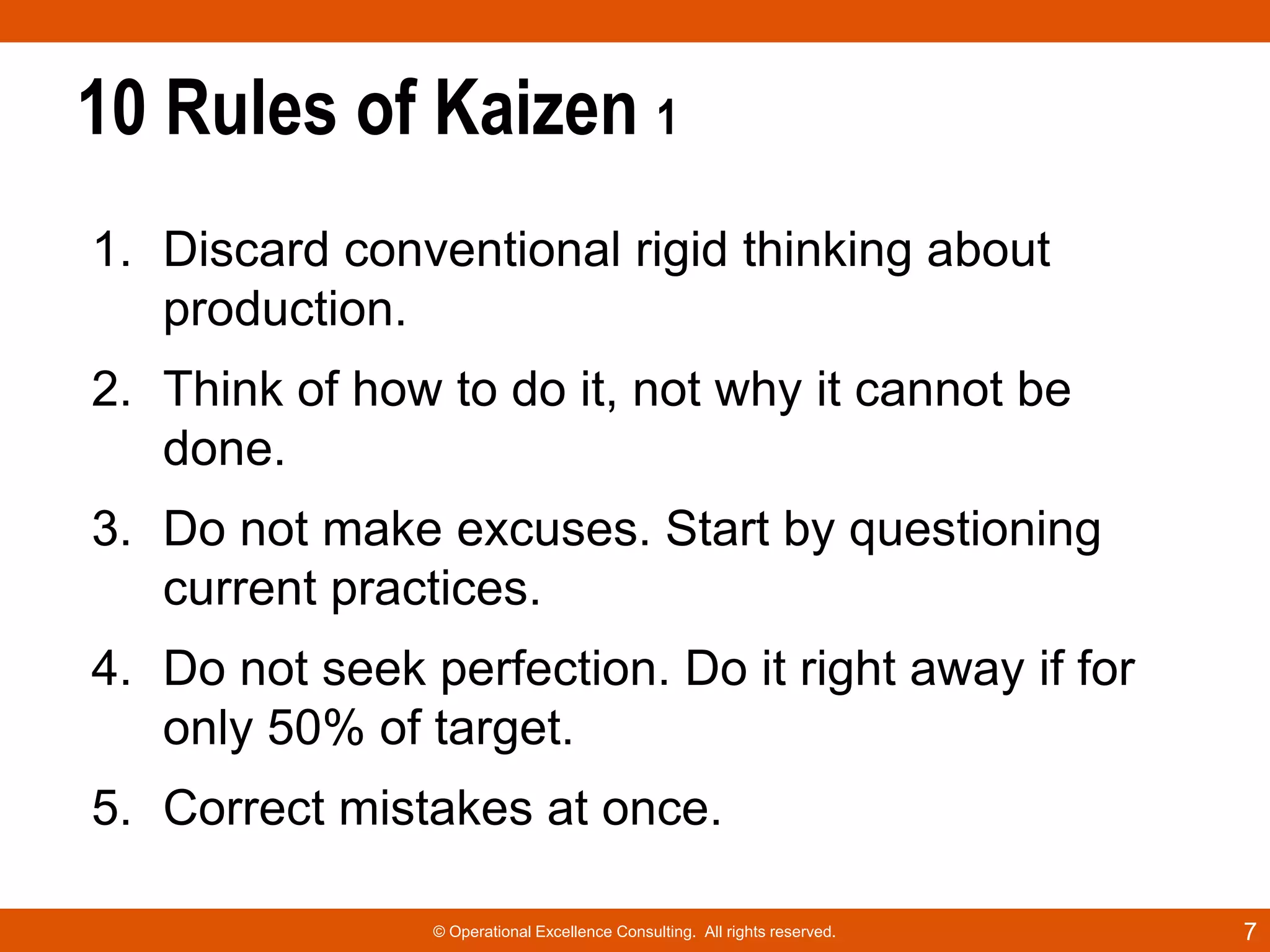

10 Rules of Kaizen 1
1. Discard conventional rigid thinking about
production.
2. Think of how to do it, not why it cannot be
done.

3. Do not make excuses. Start by questioning
current practices.
4. Do not seek perfection. Do it right away if for
only 50% of target.
5. Correct mistakes at once.
© Operational Excellence Consulting. All rights reserved.

7
What is the Purpose of Kaizen?
• Kaizen activities focus on each process in order
to add value and eliminate waste

© Operational Excellence Consulting. All rights reserved.

9

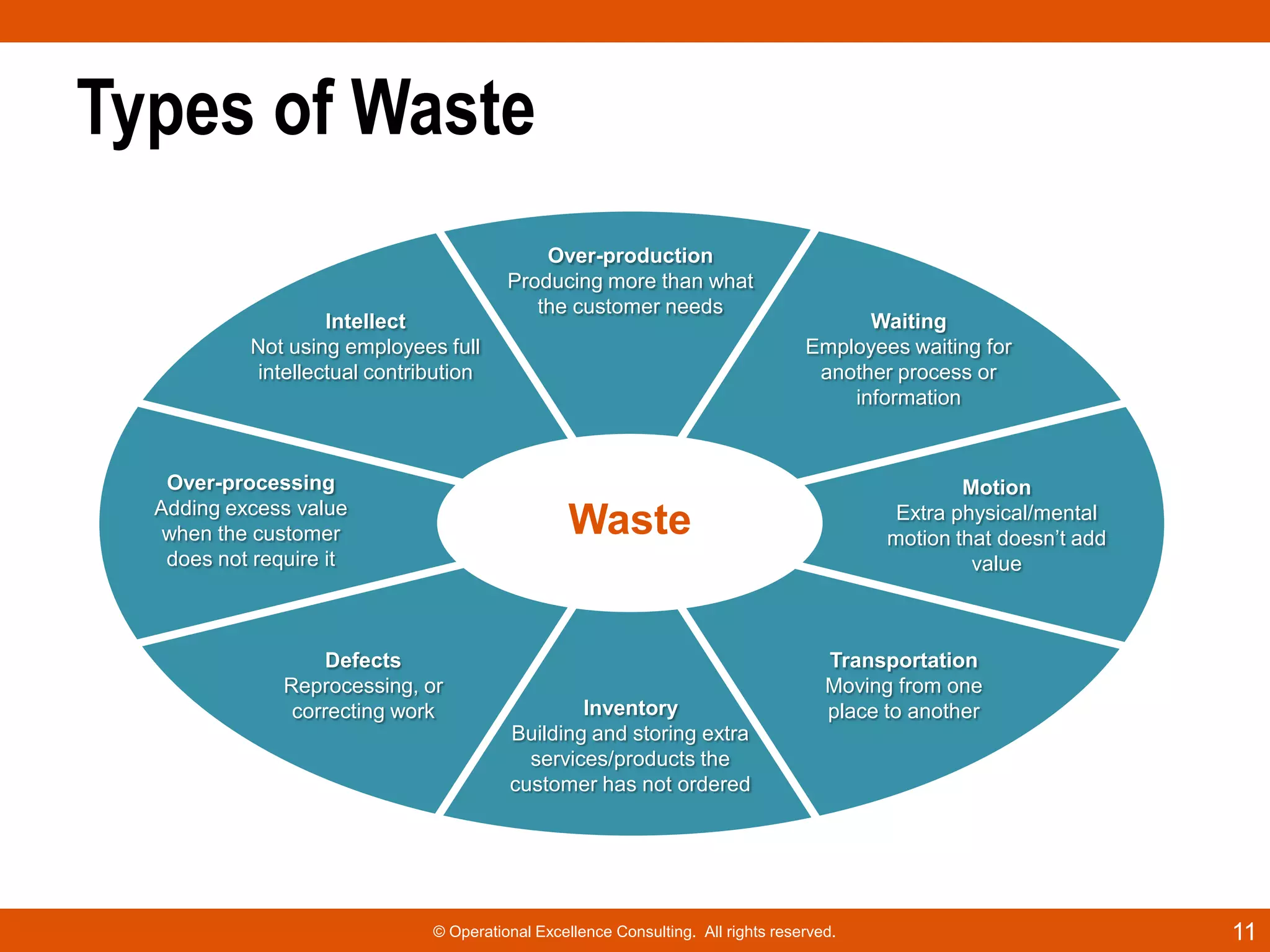

Types of Waste
Intellect
Not using employees full
intellectual contribution

Over-processing
Adding excess value
when the customer
does not require it

Over-production
Producing more than what
the customer needs

Waiting
Employees waiting for
another process or
information

Motion
Extra physical/mental
motion that doesn‟t add
value

Waste

Defects
Reprocessing, or
correcting work

Inventory
Building and storing extra
services/products the
customer has not ordered

Transportation
Moving from one
place to another

© Operational Excellence Consulting. All rights reserved.

11

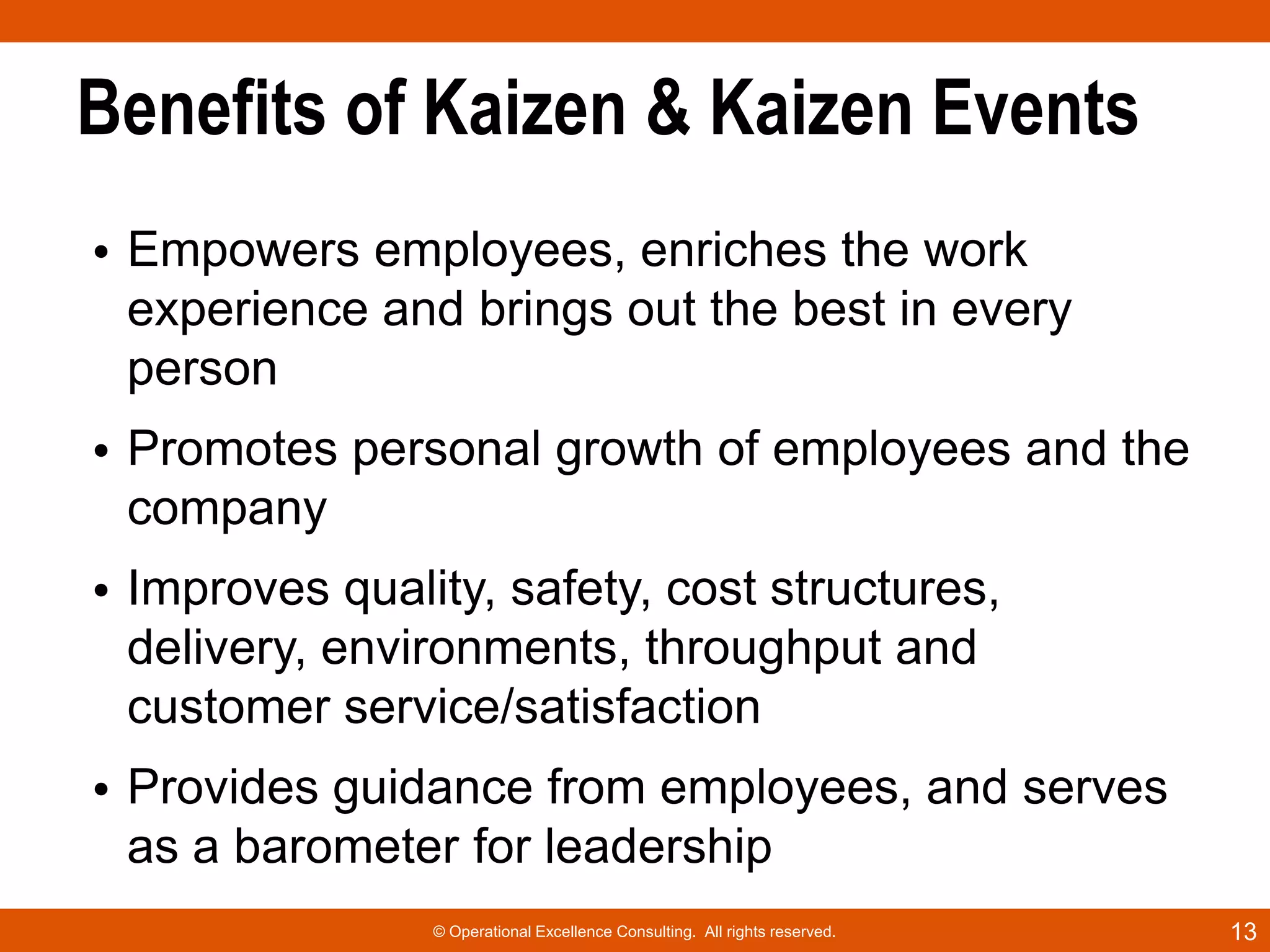

Benefits of Kaizen & Kaizen Events
• Empowers employees, enriches the work
experience and brings out the best in every
person
• Promotes personal growth of employees and the
company
• Improves quality, safety, cost structures,
delivery, environments, throughput and
customer service/satisfaction
• Provides guidance from employees, and serves
as a barometer for leadership
© Operational Excellence Consulting. All rights reserved.

13

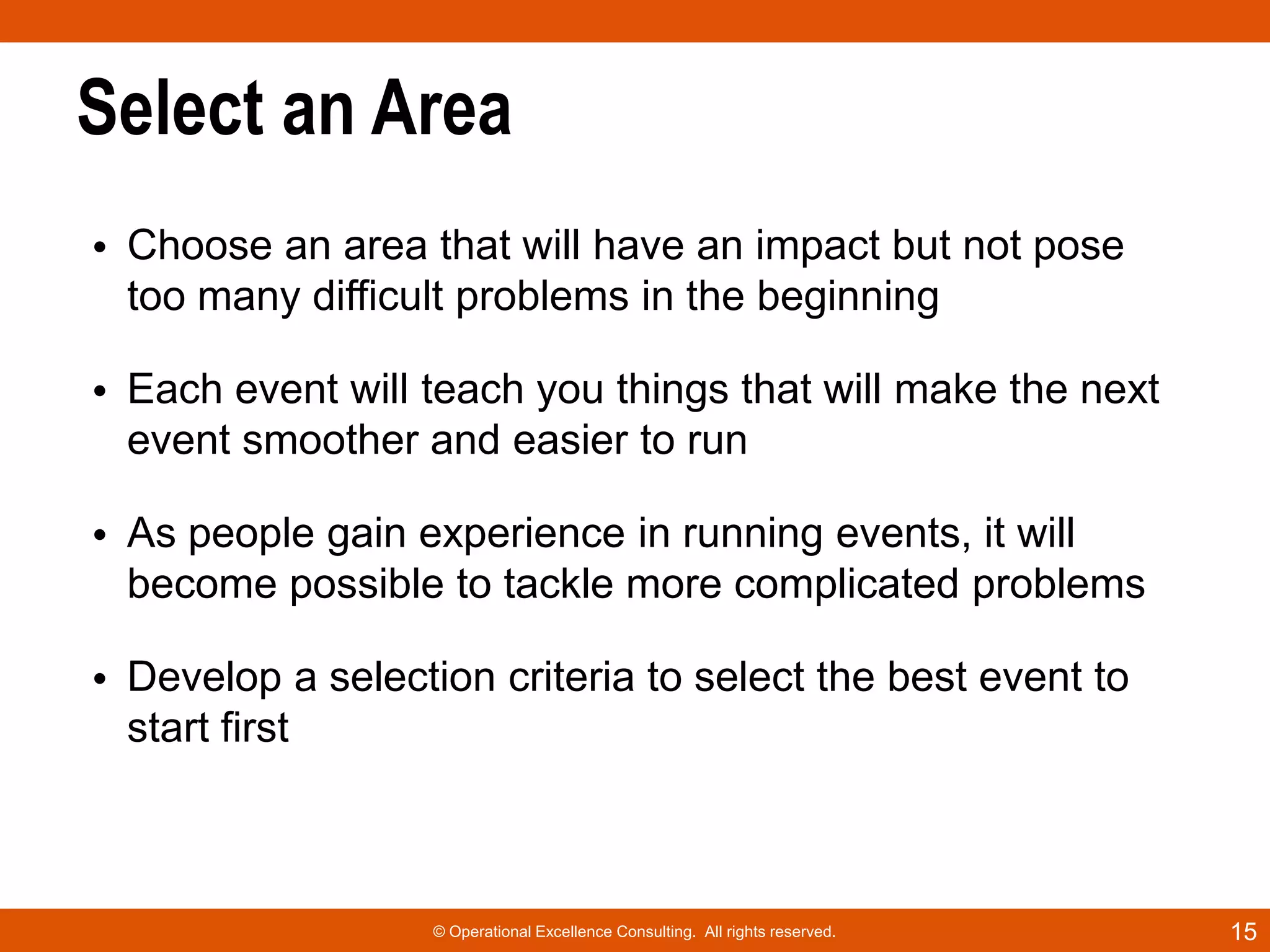

Select an Area
• Choose an area that will have an impact but not pose
too many difficult problems in the beginning
• Each event will teach you things that will make the next
event smoother and easier to run

• As people gain experience in running events, it will
become possible to tackle more complicated problems
• Develop a selection criteria to select the best event to
start first

© Operational Excellence Consulting. All rights reserved.

15

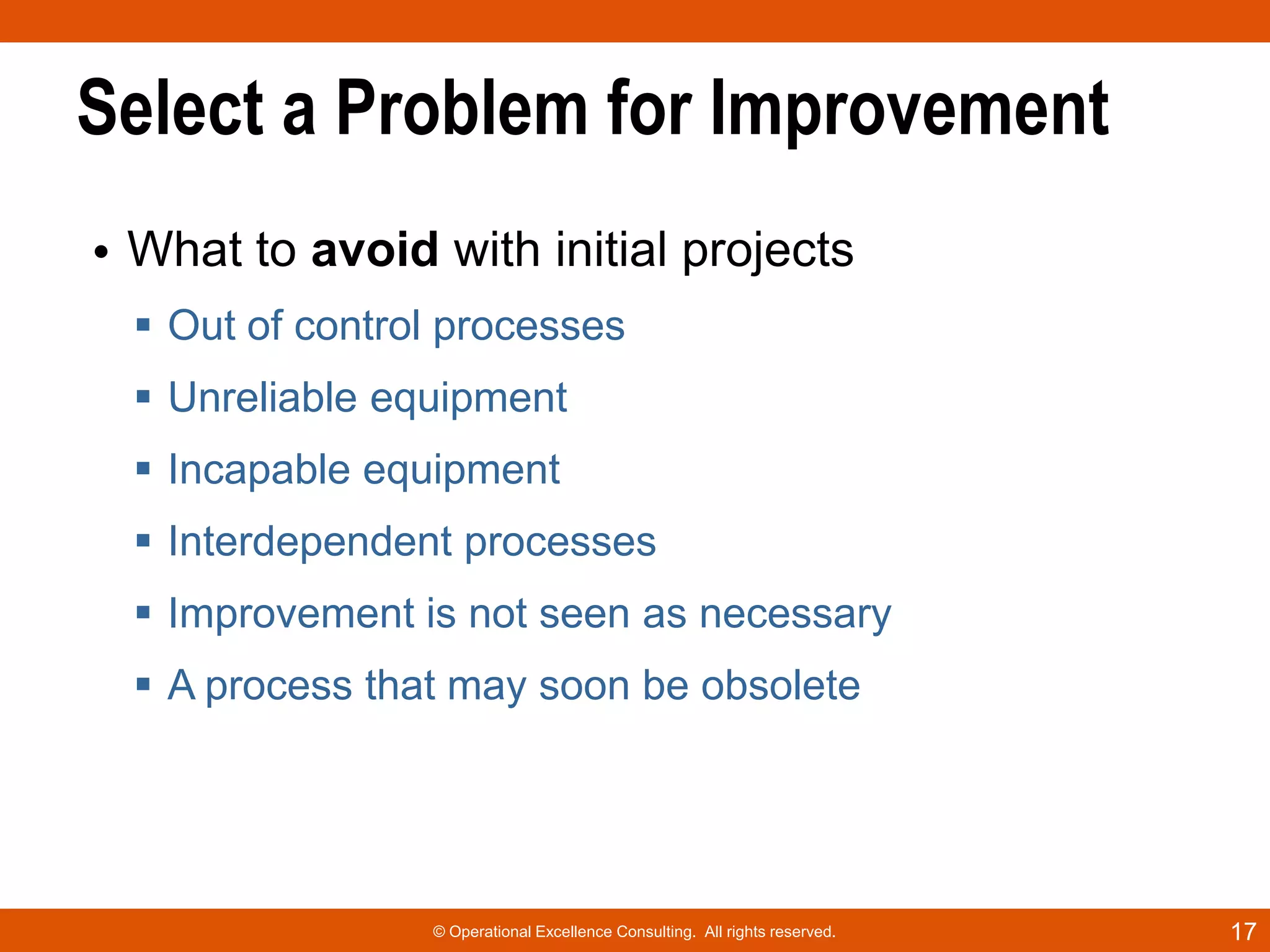

Select a Problem for Improvement
• What to avoid with initial projects
 Out of control processes
 Unreliable equipment
 Incapable equipment

 Interdependent processes
 Improvement is not seen as necessary
 A process that may soon be obsolete

© Operational Excellence Consulting. All rights reserved.

17

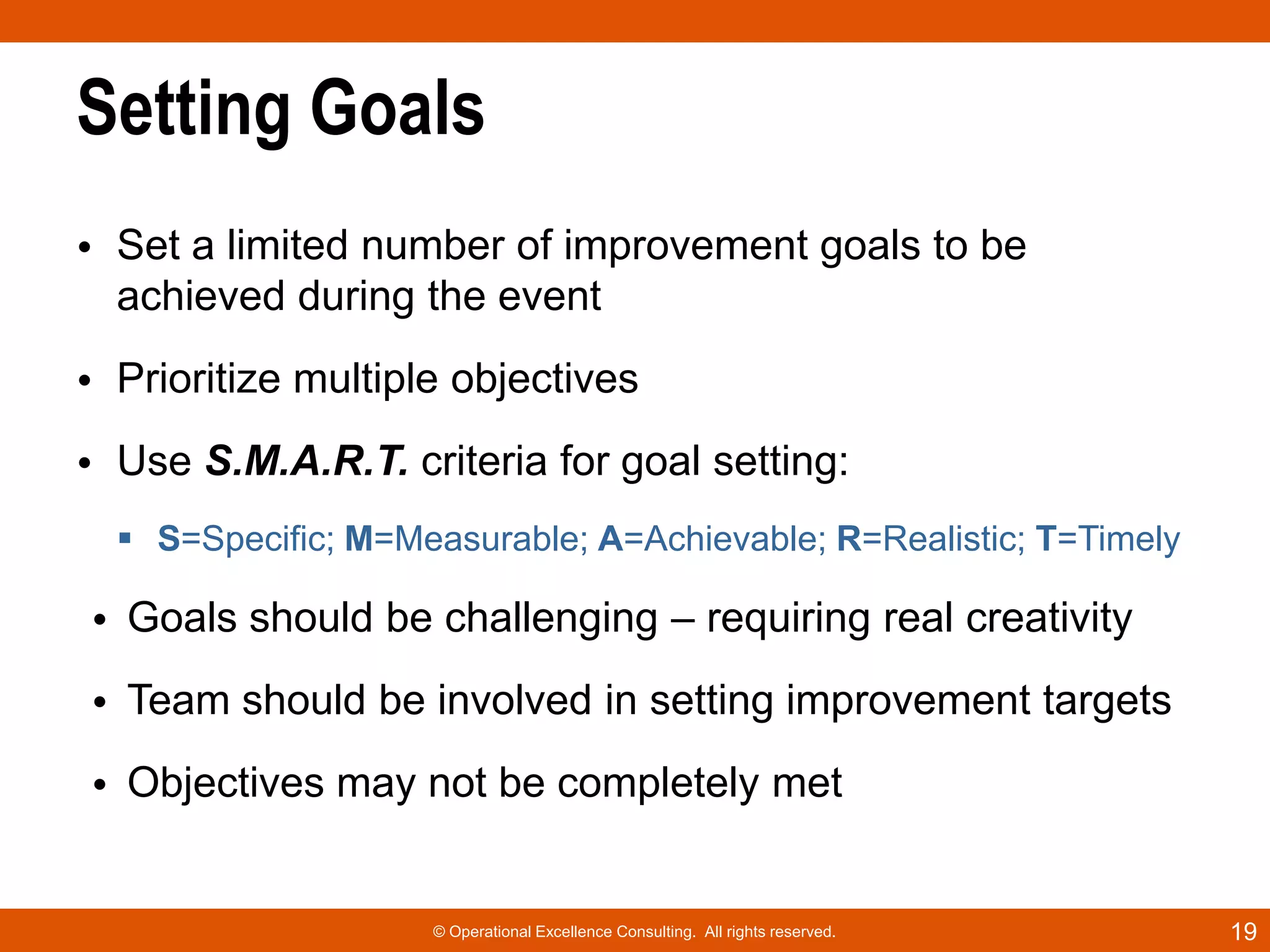

Setting Goals
• Set a limited number of improvement goals to be
achieved during the event
• Prioritize multiple objectives
• Use S.M.A.R.T. criteria for goal setting:
 S=Specific; M=Measurable; A=Achievable; R=Realistic; T=Timely

• Goals should be challenging – requiring real creativity
• Team should be involved in setting improvement targets
• Objectives may not be completely met

© Operational Excellence Consulting. All rights reserved.

19

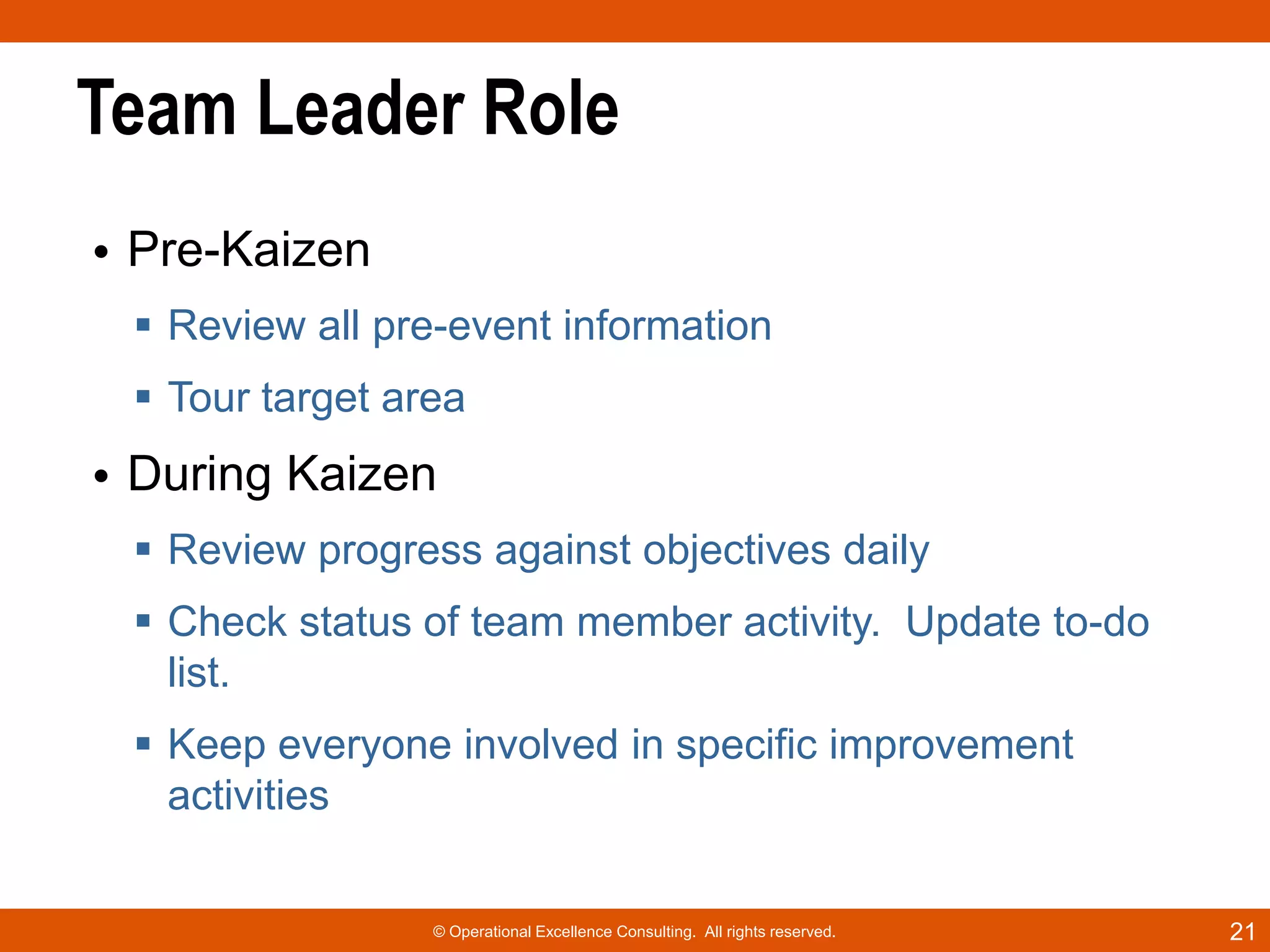

Team Leader Role
• Pre-Kaizen
 Review all pre-event information
 Tour target area

• During Kaizen
 Review progress against objectives daily
 Check status of team member activity. Update to-do
list.

 Keep everyone involved in specific improvement
activities

© Operational Excellence Consulting. All rights reserved.

21

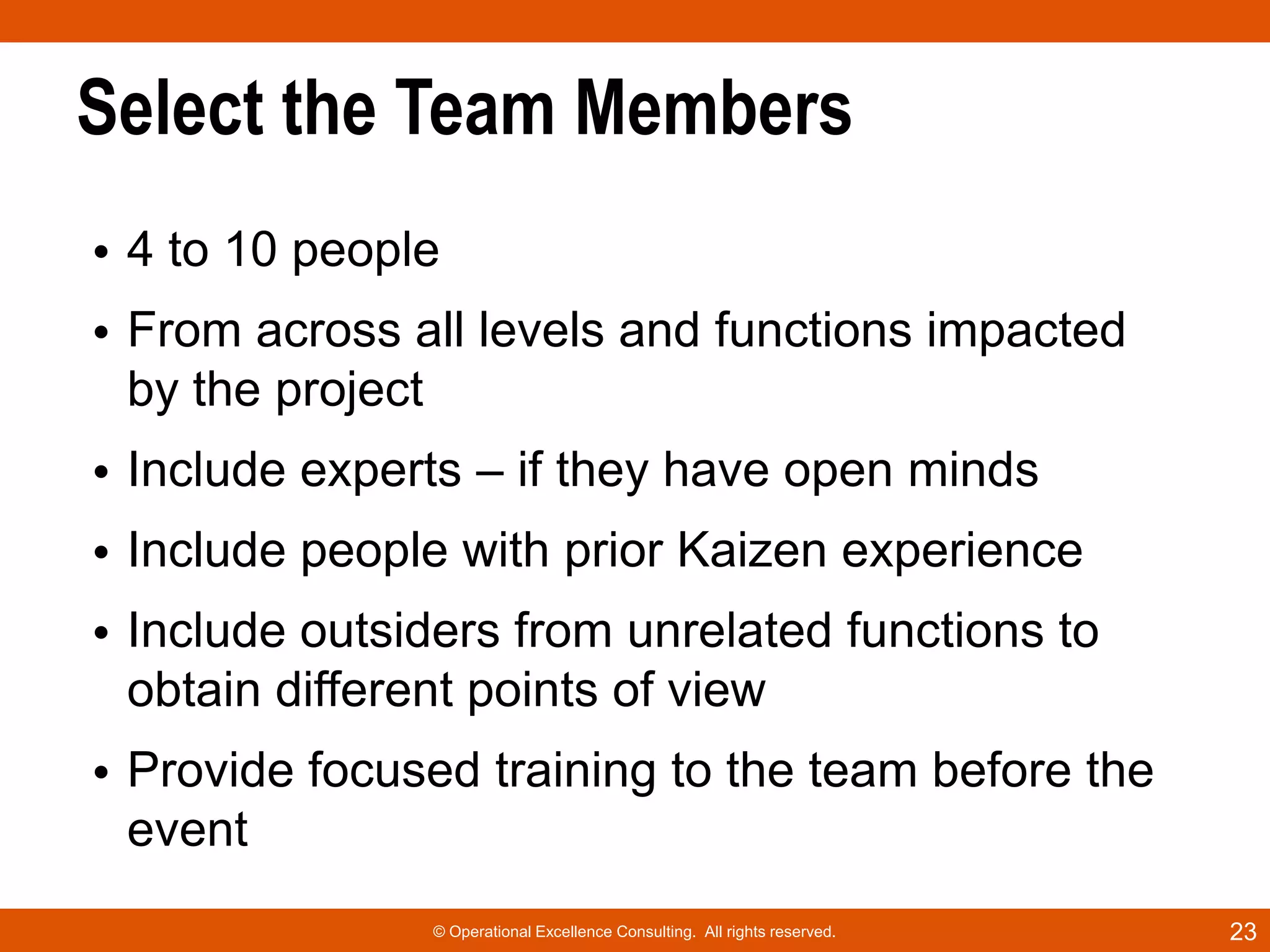

Select the Team Members
• 4 to 10 people

• From across all levels and functions impacted
by the project
• Include experts – if they have open minds

• Include people with prior Kaizen experience
• Include outsiders from unrelated functions to
obtain different points of view

• Provide focused training to the team before the
event
© Operational Excellence Consulting. All rights reserved.

23

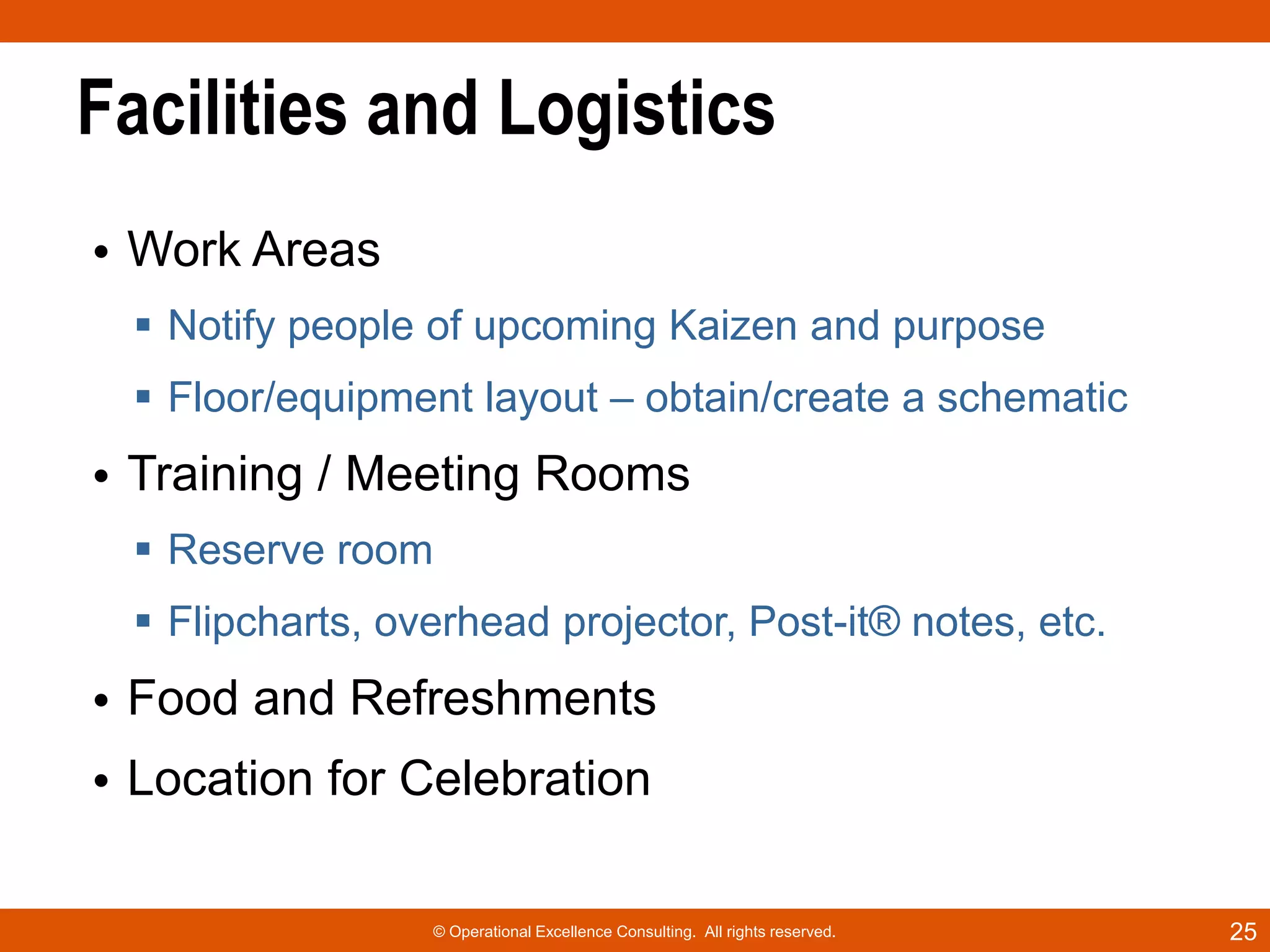

Facilities and Logistics
• Work Areas
 Notify people of upcoming Kaizen and purpose
 Floor/equipment layout – obtain/create a schematic

• Training / Meeting Rooms
 Reserve room
 Flipcharts, overhead projector, Post-it® notes, etc.

• Food and Refreshments

• Location for Celebration
© Operational Excellence Consulting. All rights reserved.

25

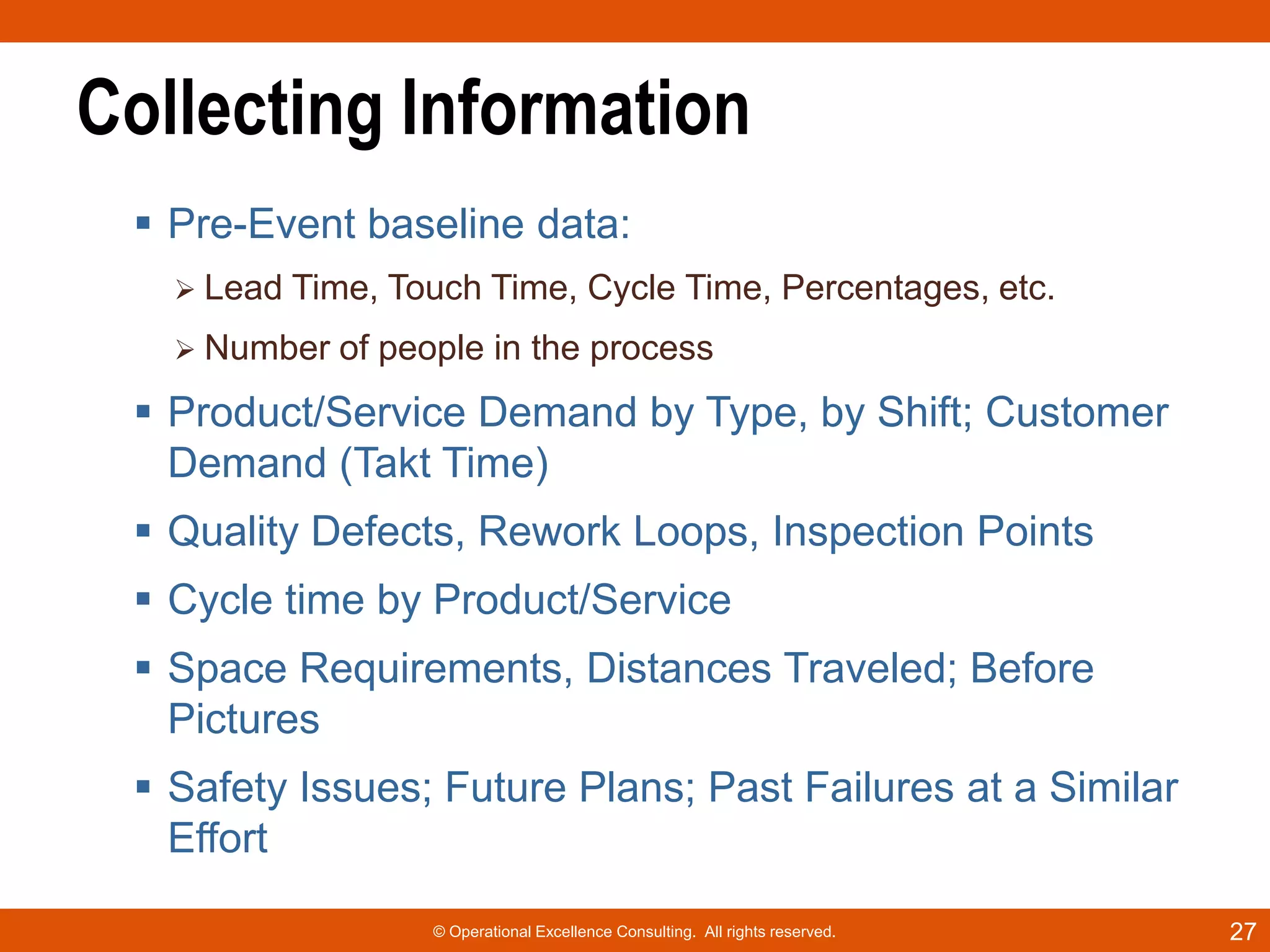

Collecting Information
 Pre-Event baseline data:
 Lead

Time, Touch Time, Cycle Time, Percentages, etc.

 Number

of people in the process

 Product/Service Demand by Type, by Shift; Customer
Demand (Takt Time)

 Quality Defects, Rework Loops, Inspection Points
 Cycle time by Product/Service
 Space Requirements, Distances Traveled; Before
Pictures
 Safety Issues; Future Plans; Past Failures at a Similar
Effort
© Operational Excellence Consulting. All rights reserved.

27

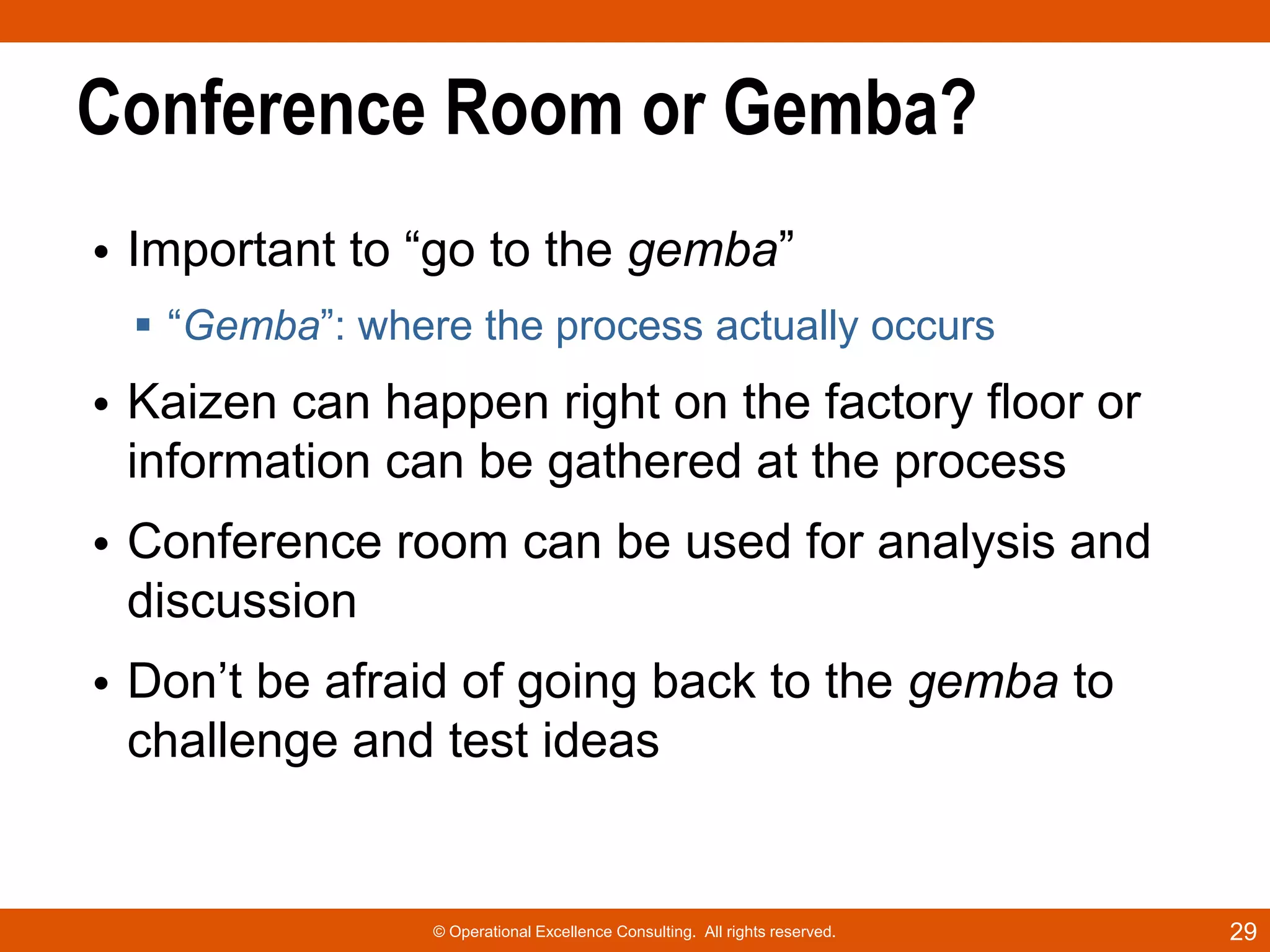

Conference Room or Gemba?
• Important to “go to the gemba”
 “Gemba”: where the process actually occurs

• Kaizen can happen right on the factory floor or
information can be gathered at the process

• Conference room can be used for analysis and
discussion
• Don‟t be afraid of going back to the gemba to
challenge and test ideas

© Operational Excellence Consulting. All rights reserved.

29

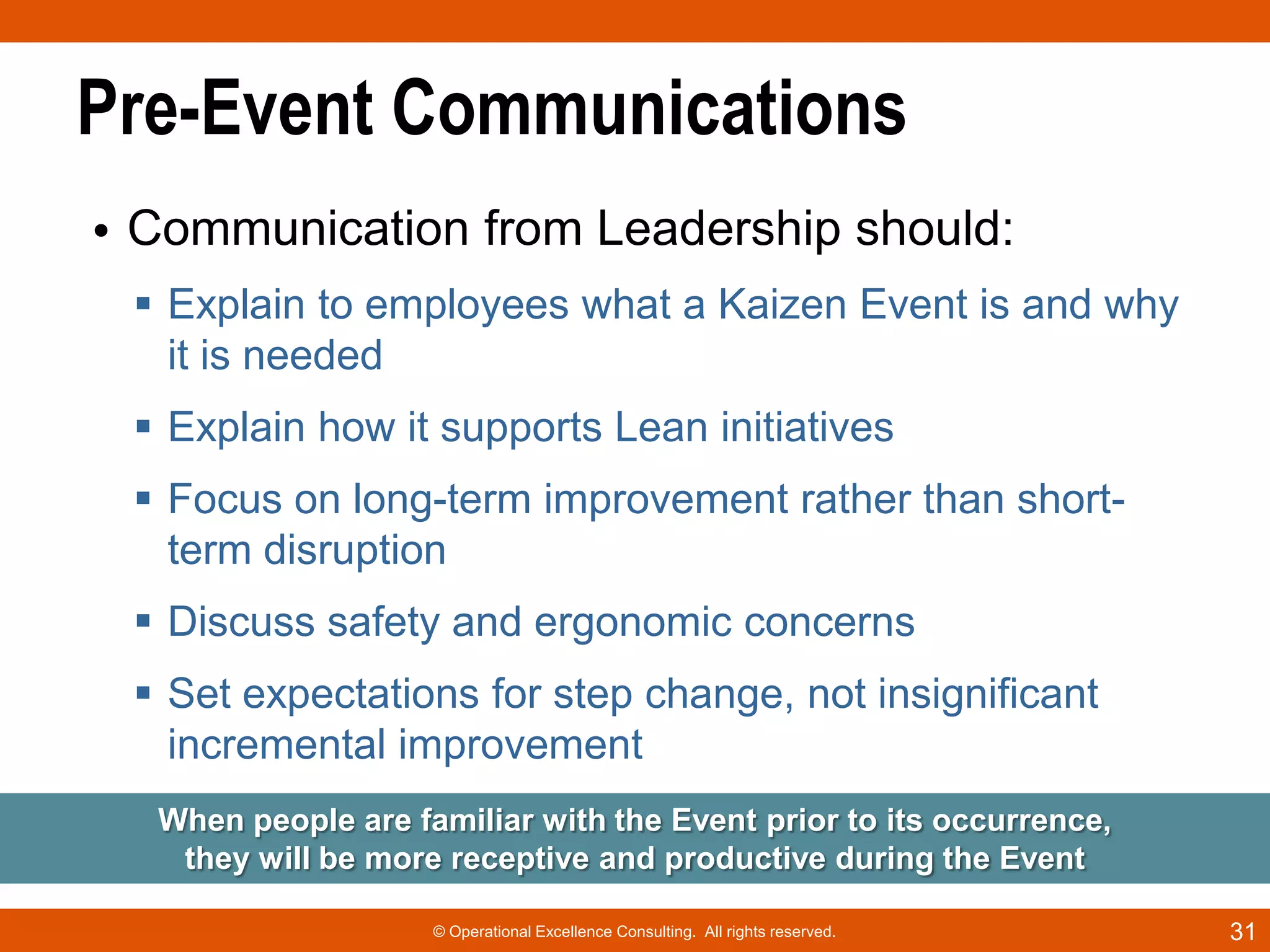

Pre-Event Communications
• Communication from Leadership should:
 Explain to employees what a Kaizen Event is and why
it is needed
 Explain how it supports Lean initiatives
 Focus on long-term improvement rather than shortterm disruption
 Discuss safety and ergonomic concerns
 Set expectations for step change, not insignificant
incremental improvement
When people are familiar with the Event prior to its occurrence,
they will be more receptive and productive during the Event
© Operational Excellence Consulting. All rights reserved.

31

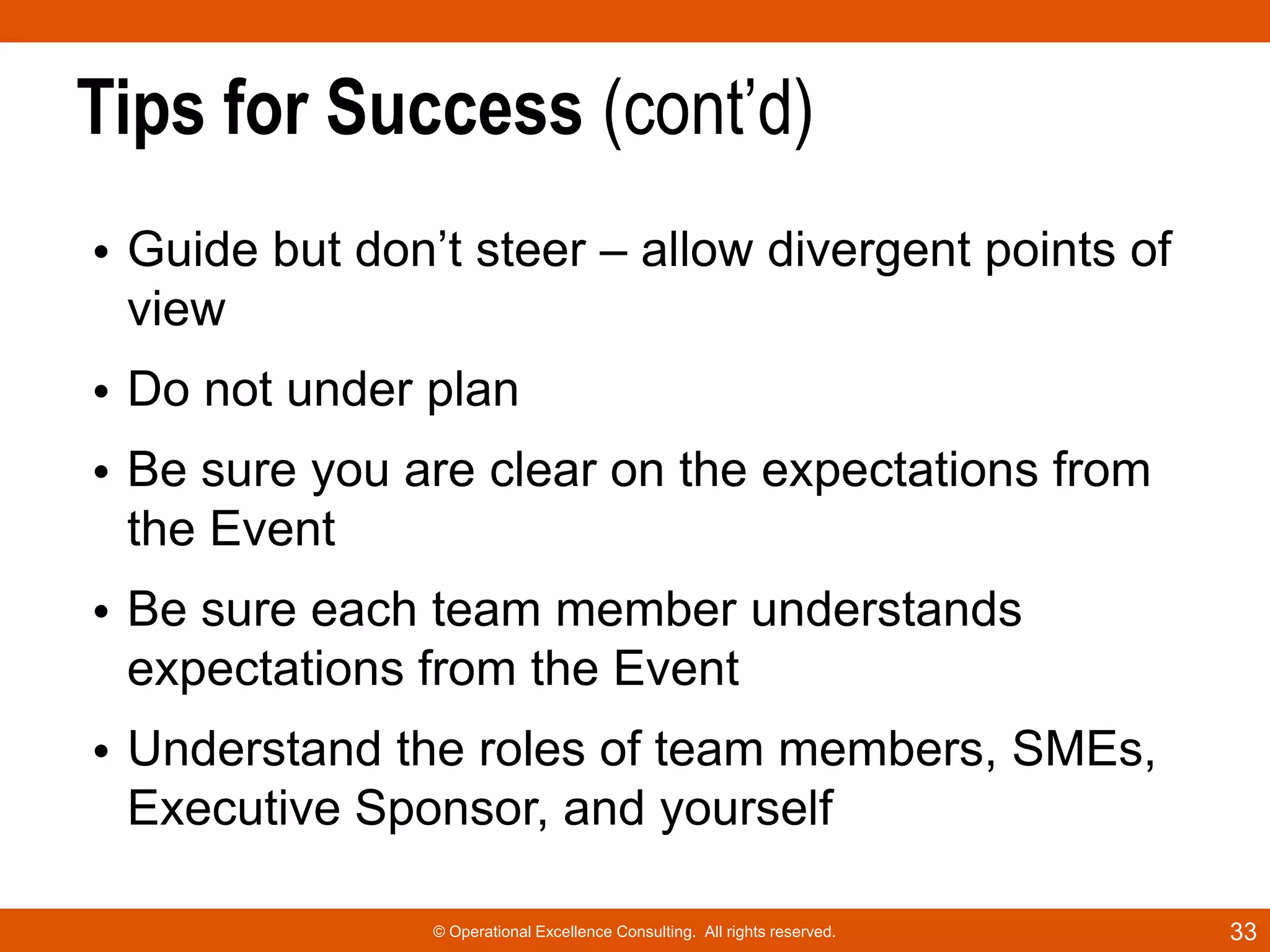

Tips for Success (cont’d)
• Guide but don‟t steer – allow divergent points of
view
• Do not under plan
• Be sure you are clear on the expectations from
the Event
• Be sure each team member understands
expectations from the Event

• Understand the roles of team members, SMEs,
Executive Sponsor, and yourself
© Operational Excellence Consulting. All rights reserved.

33
Pre-event
Preparation
Checklists

© Operational Excellence Consulting. All rights reserved.

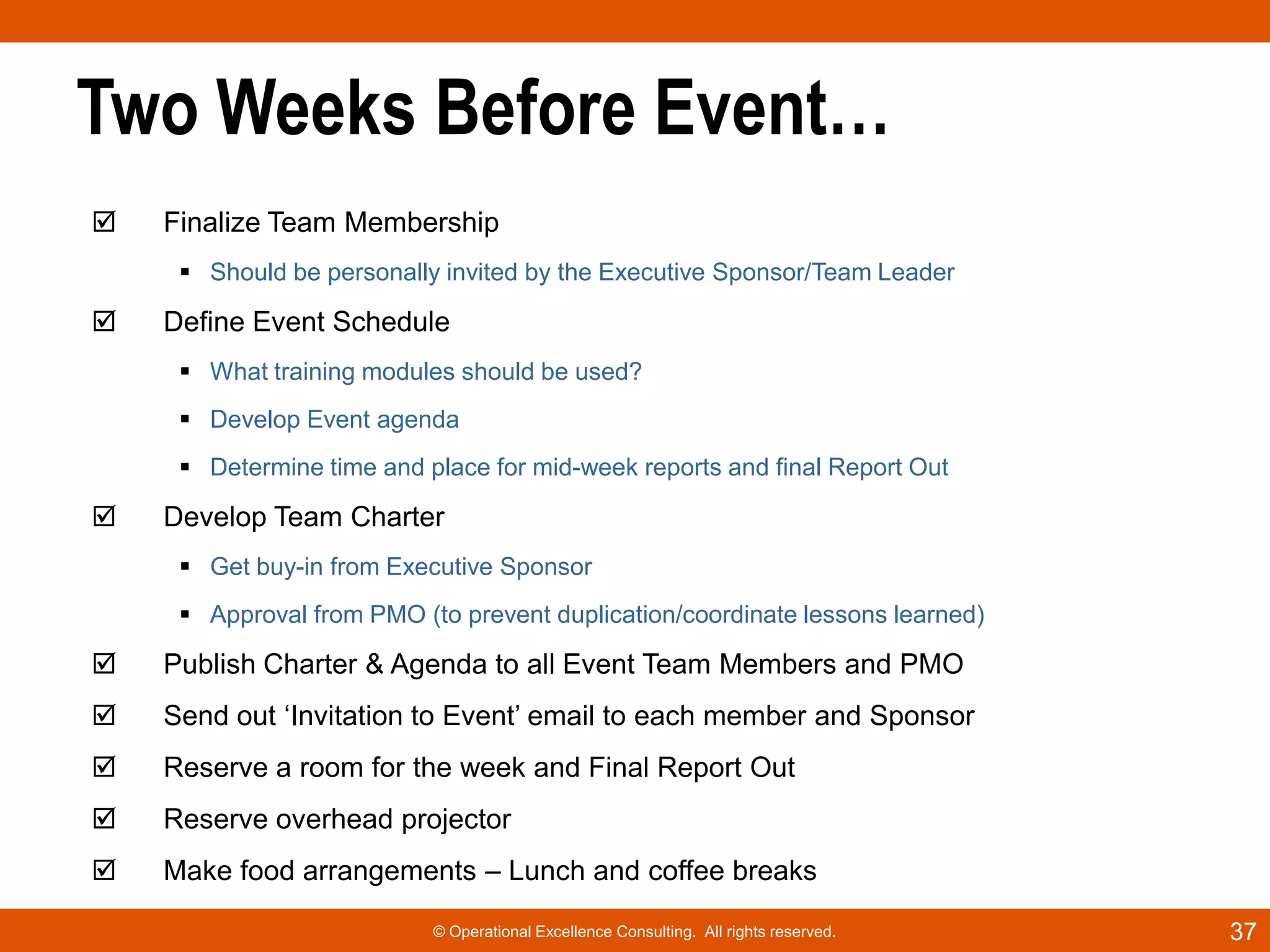

Two Weeks Before Event…


Finalize Team Membership
 Should be personally invited by the Executive Sponsor/Team Leader



Define Event Schedule
 What training modules should be used?
 Develop Event agenda
 Determine time and place for mid-week reports and final Report Out



Develop Team Charter
 Get buy-in from Executive Sponsor
 Approval from PMO (to prevent duplication/coordinate lessons learned)



Publish Charter & Agenda to all Event Team Members and PMO



Send out „Invitation to Event‟ email to each member and Sponsor



Reserve a room for the week and Final Report Out



Reserve overhead projector



Make food arrangements – Lunch and coffee breaks
© Operational Excellence Consulting. All rights reserved.

37

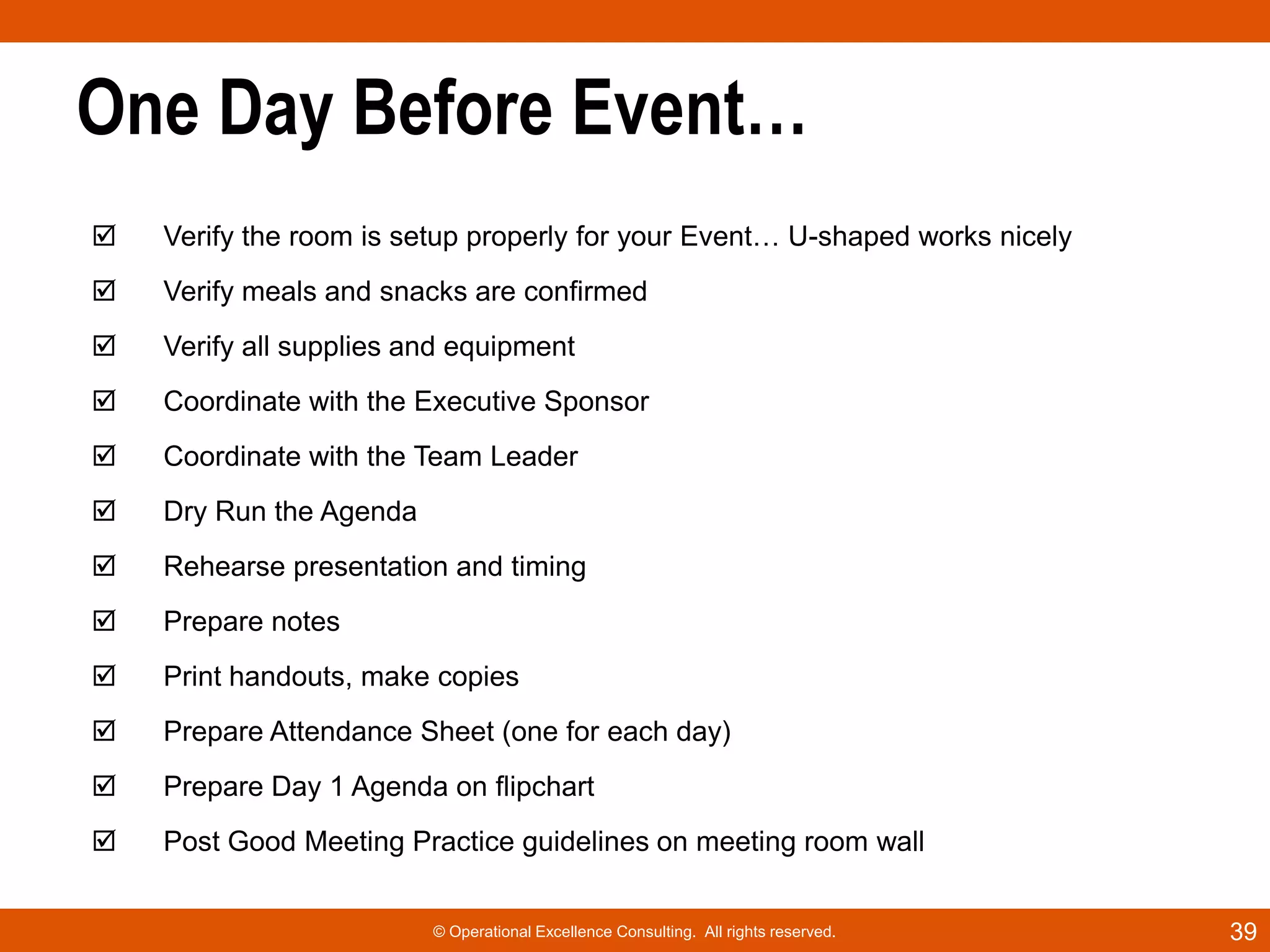

One Day Before Event…


Verify the room is setup properly for your Event… U-shaped works nicely



Verify meals and snacks are confirmed



Verify all supplies and equipment



Coordinate with the Executive Sponsor



Coordinate with the Team Leader



Dry Run the Agenda



Rehearse presentation and timing



Prepare notes



Print handouts, make copies



Prepare Attendance Sheet (one for each day)



Prepare Day 1 Agenda on flipchart



Post Good Meeting Practice guidelines on meeting room wall
© Operational Excellence Consulting. All rights reserved.

39
3
THE
KAIZEN EVENT

© Operational Excellence Consulting. All rights reserved.

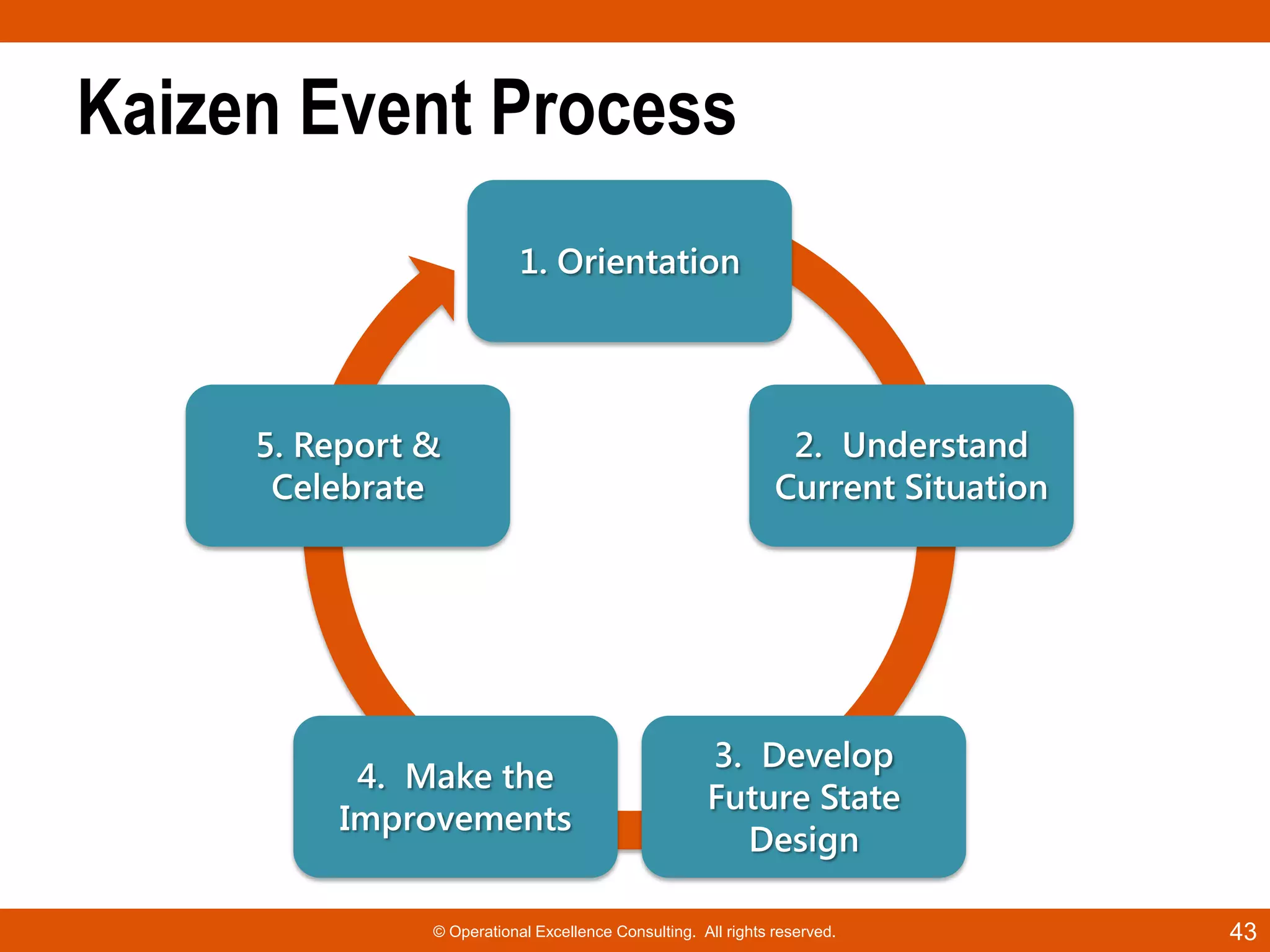

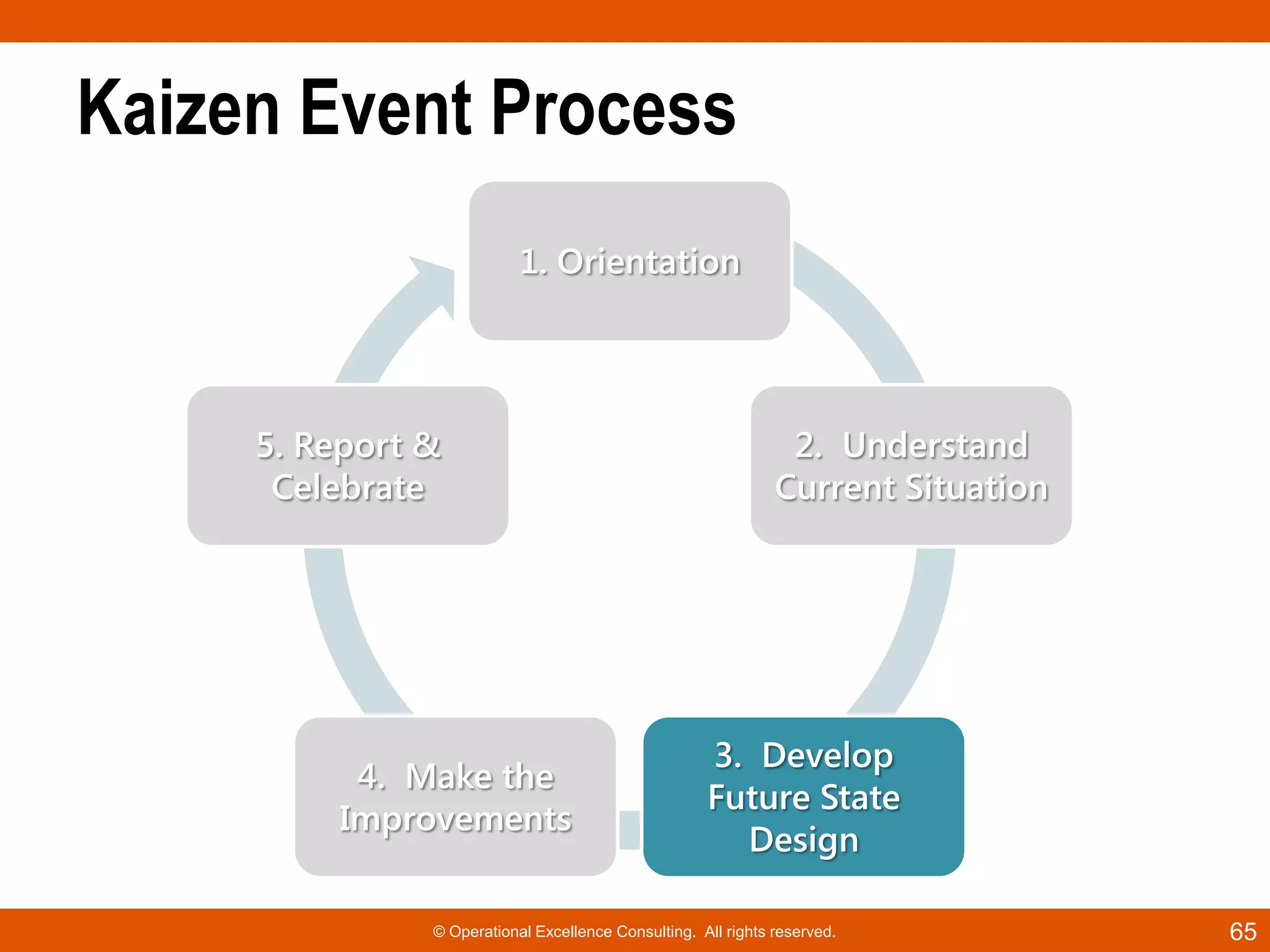

Kaizen Event Process
1. Orientation

5. Report &
Celebrate

4. Make the
Improvements

2. Understand
Current Situation

3. Develop
Future State
Design

© Operational Excellence Consulting. All rights reserved.

43

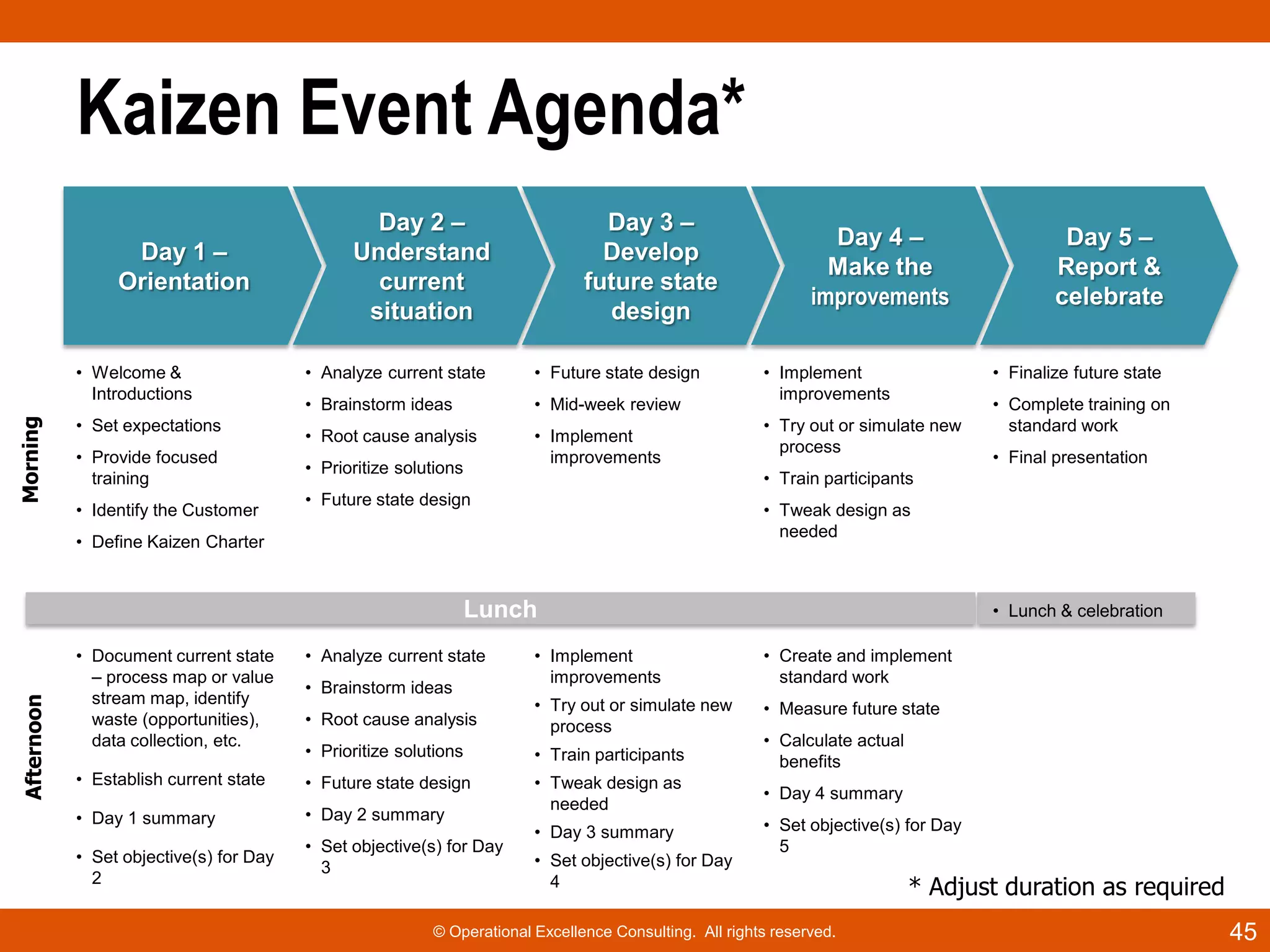

Kaizen Event Agenda*
Day 1 –
Orientation

Morning

• Welcome &
Introductions
• Set expectations
• Provide focused
training
• Identify the Customer

Day 2 –
Understand
current
situation

Day 3 –
Develop
future state
design

• Analyze current state

• Future state design

• Brainstorm ideas

• Mid-week review

• Root cause analysis
• Prioritize solutions

• Implement
improvements

Day 4 –
Make the
improvements
• Implement
improvements

• Finalize future state

• Try out or simulate new
process

• Complete training on
standard work
• Final presentation

• Train participants

• Future state design

• Tweak design as
needed

• Define Kaizen Charter

Lunch

Afternoon

Day 5 –
Report &
celebrate

• Lunch & celebration

• Implement
improvements

• Create and implement
standard work

• Root cause analysis

• Try out or simulate new
process

• Measure future state

• Prioritize solutions

• Train participants

• Establish current state

• Calculate actual
benefits

• Future state design

• Day 4 summary

• Day 1 summary

• Day 2 summary

• Tweak design as
needed
• Day 3 summary

• Set objective(s) for Day
5

• Document current state
– process map or value
stream map, identify
waste (opportunities),
data collection, etc.

• Analyze current state

• Set objective(s) for Day
2

• Brainstorm ideas

• Set objective(s) for Day
3

• Set objective(s) for Day
4

© Operational Excellence Consulting. All rights reserved.

* Adjust duration as required
45
Day 1 –
Orientation

© Operational Excellence Consulting. All rights reserved.

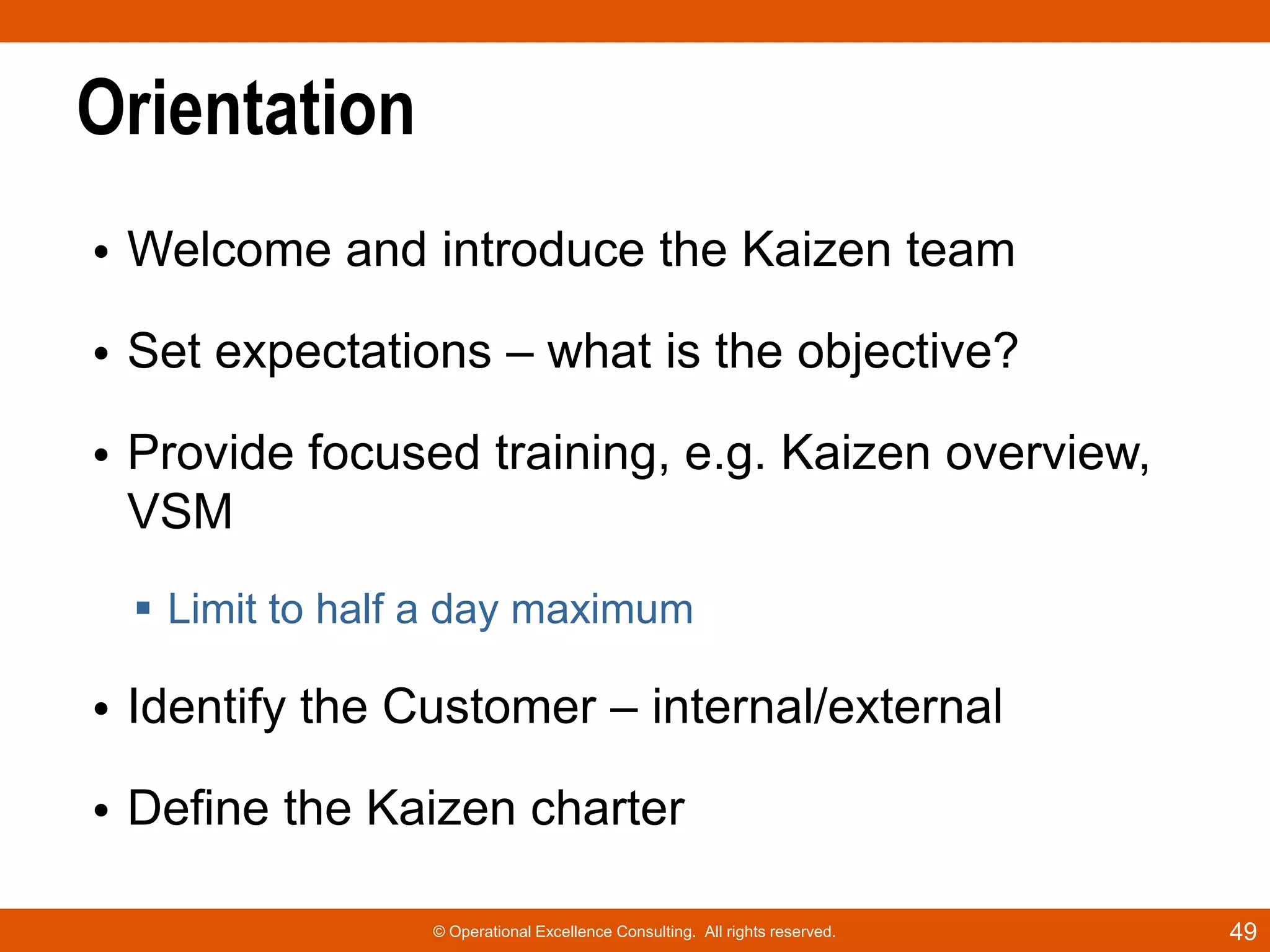

Orientation
• Welcome and introduce the Kaizen team
• Set expectations – what is the objective?
• Provide focused training, e.g. Kaizen overview,
VSM
 Limit to half a day maximum

• Identify the Customer – internal/external
• Define the Kaizen charter
© Operational Excellence Consulting. All rights reserved.

49

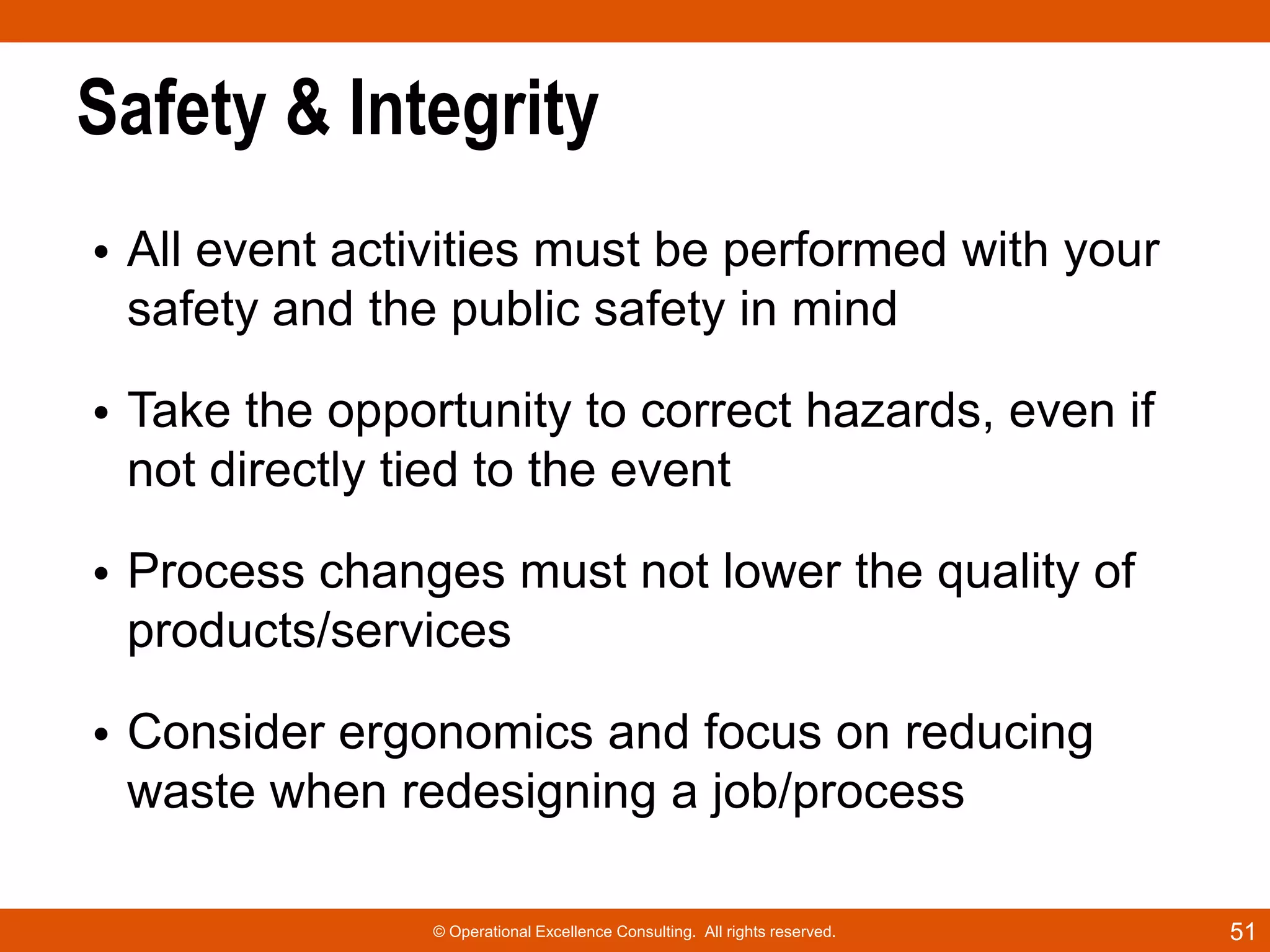

Safety & Integrity
• All event activities must be performed with your
safety and the public safety in mind
• Take the opportunity to correct hazards, even if
not directly tied to the event
• Process changes must not lower the quality of
products/services
• Consider ergonomics and focus on reducing
waste when redesigning a job/process
© Operational Excellence Consulting. All rights reserved.

51

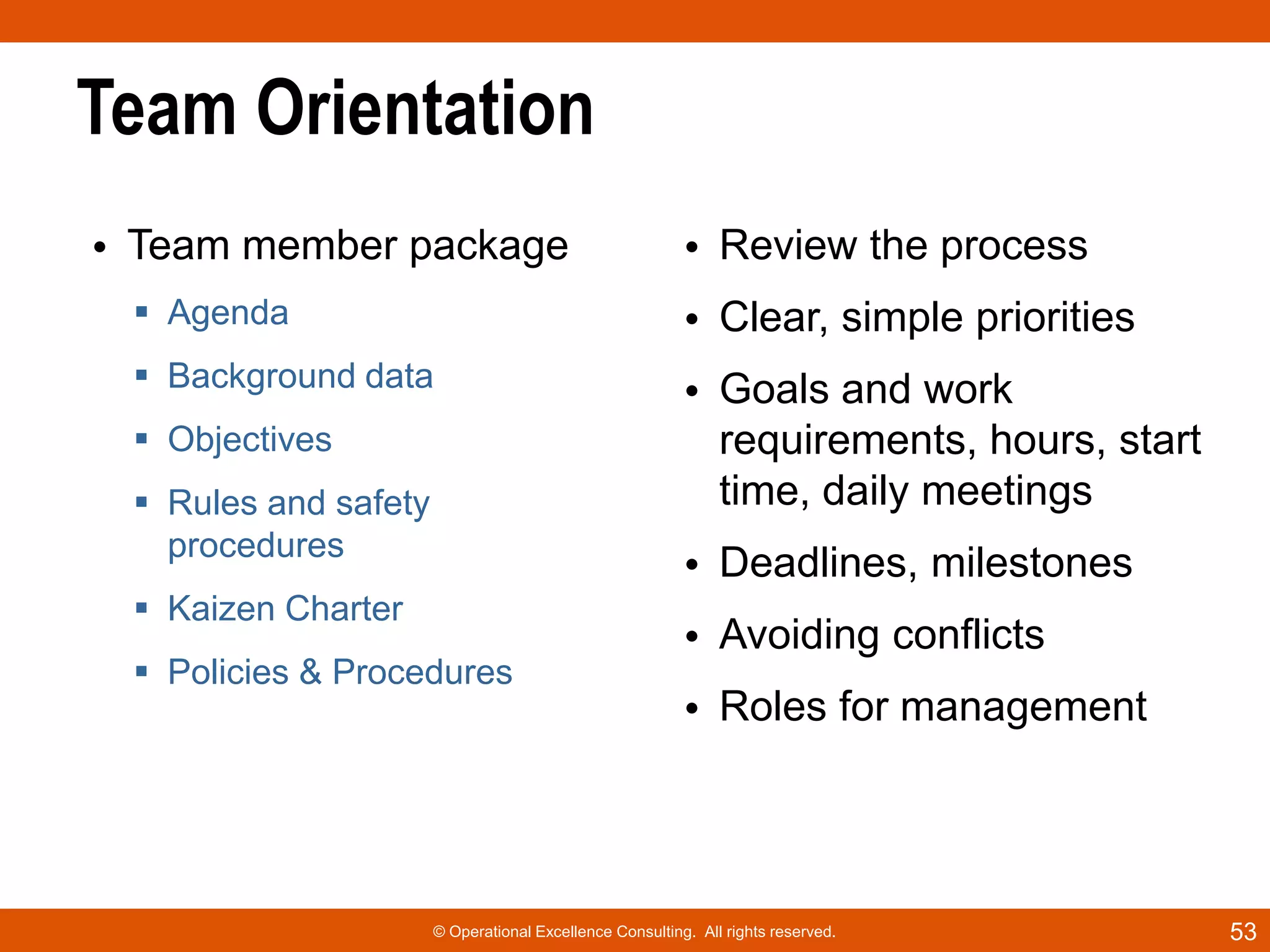

Team Orientation
• Team member package

• Review the process

 Agenda

• Clear, simple priorities

 Background data

• Goals and work
requirements, hours, start
time, daily meetings

 Objectives
 Rules and safety
procedures

• Deadlines, milestones

 Kaizen Charter
 Policies & Procedures

• Avoiding conflicts
• Roles for management

© Operational Excellence Consulting. All rights reserved.

53
Day 2 –
Understand
current situation

© Operational Excellence Consulting. All rights reserved.

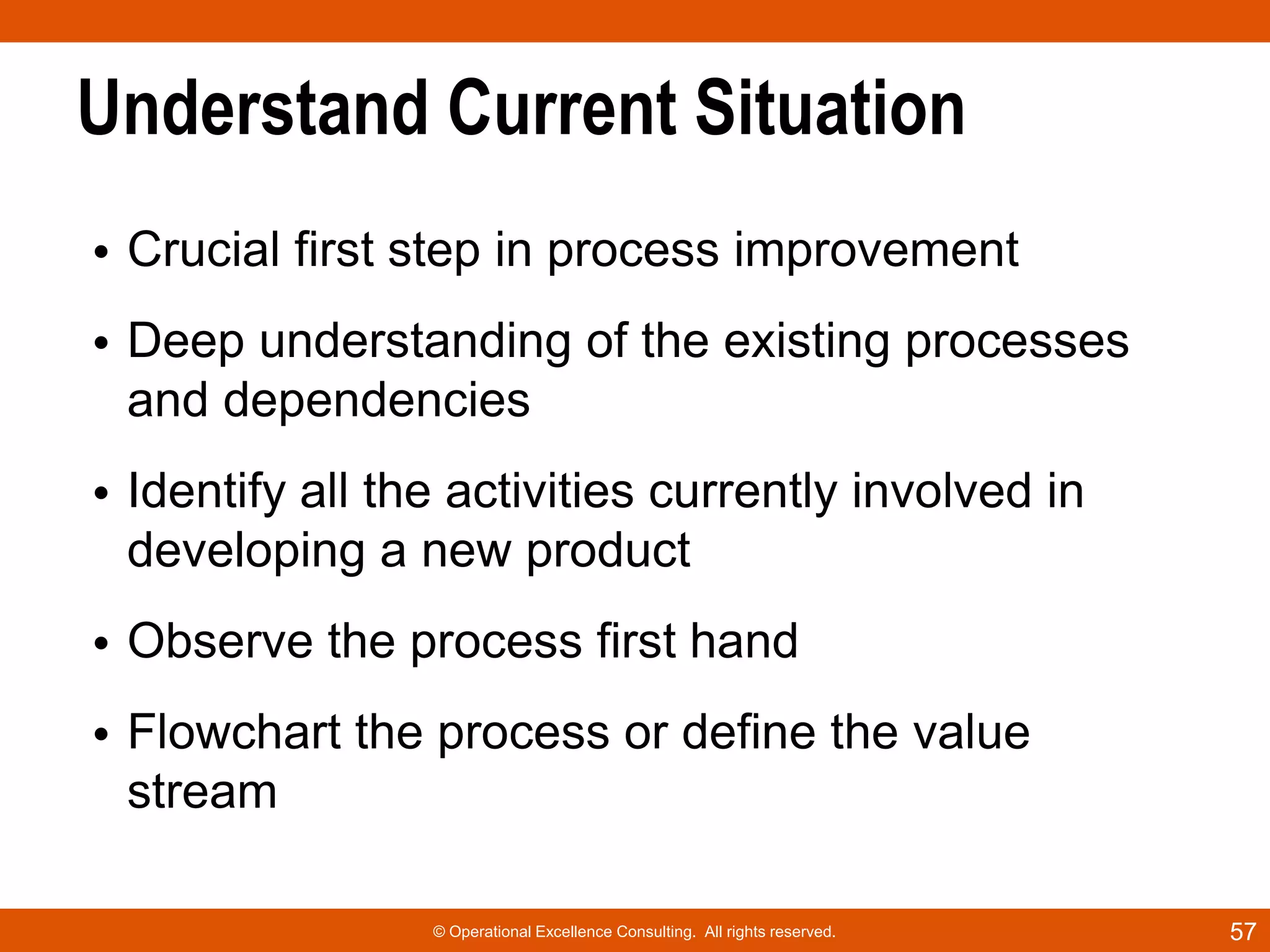

Understand Current Situation
• Crucial first step in process improvement

• Deep understanding of the existing processes
and dependencies
• Identify all the activities currently involved in
developing a new product
• Observe the process first hand
• Flowchart the process or define the value
stream
© Operational Excellence Consulting. All rights reserved.

57
Flowchart
• A flow chart is a graphical
or symbolic representation
of a process.
• Each step in the process is
represented by a different
symbol and contains a
short description of the
process step.
• The flow chart symbols are
linked together with arrows
showing the process flow
direction.
© Operational Excellence Consulting. All rights reserved.

59

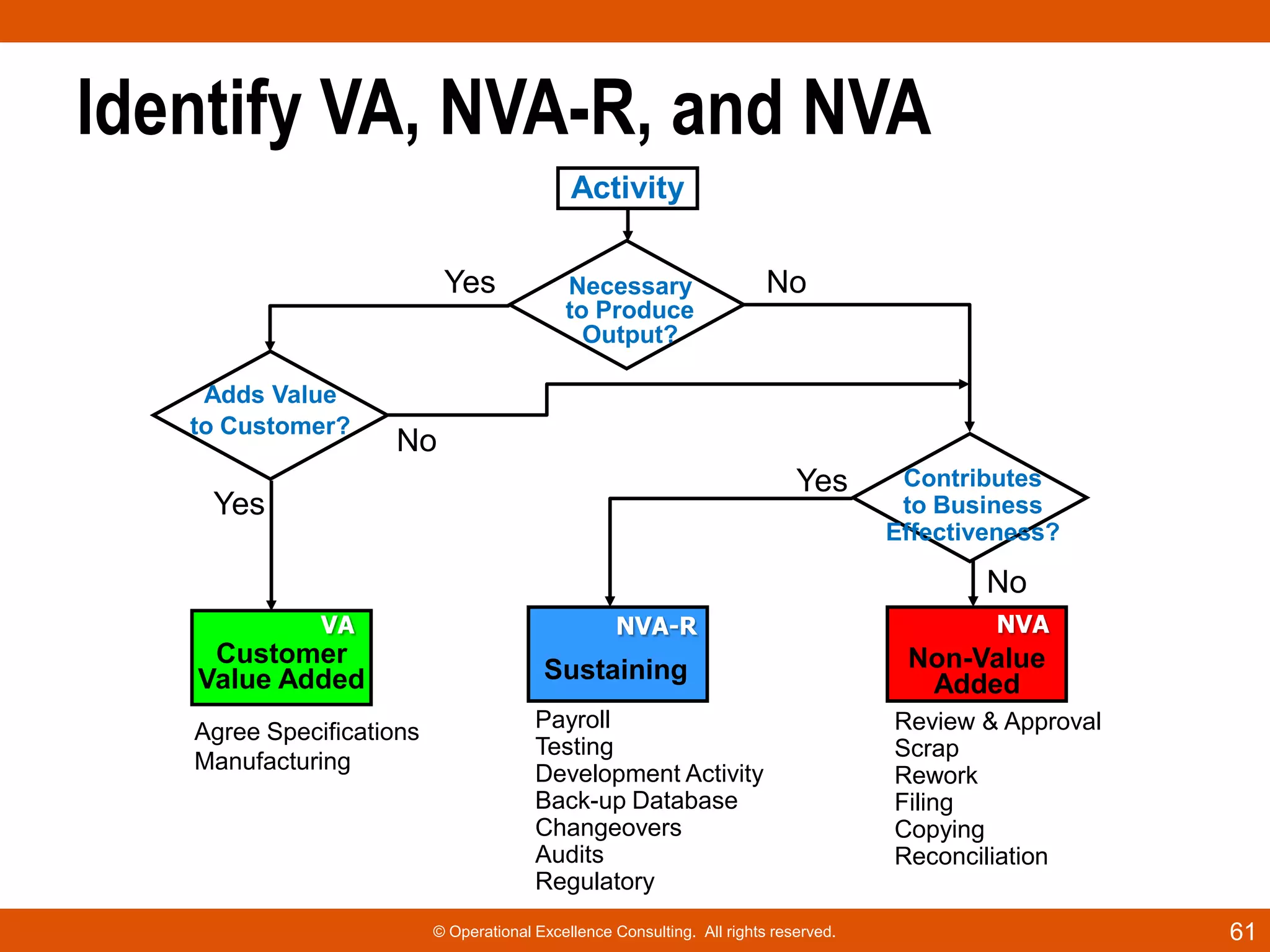

Identify VA, NVA-R, and NVA
Activity
Yes

Adds Value
to Customer?

Necessary
to Produce
Output?

No

No
Yes

Yes

Contributes
to Business
Effectiveness?

No
VA

Customer
Value Added
Agree Specifications
Manufacturing

NVA-R

Sustaining
Payroll
Testing
Development Activity
Back-up Database
Changeovers
Audits
Regulatory
© Operational Excellence Consulting. All rights reserved.

NVA

Non-Value
Added
Review & Approval
Scrap
Rework
Filing
Copying
Reconciliation
61

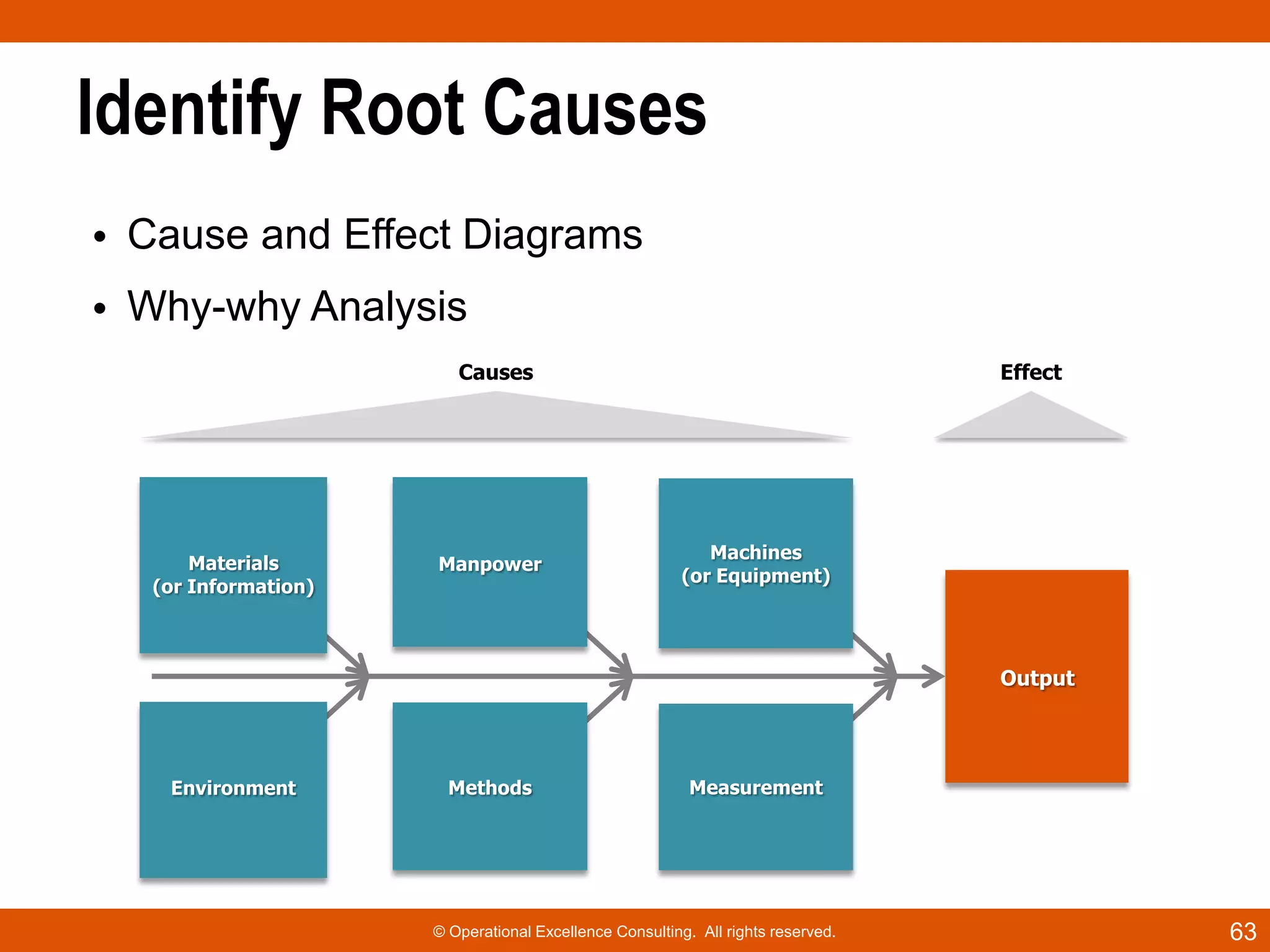

Identify Root Causes
• Cause and Effect Diagrams

• Why-why Analysis
Causes

Materials
(or Information)

Manpower

Effect

Machines
(or Equipment)

Output

Environment

Methods

Measurement

© Operational Excellence Consulting. All rights reserved.

63
Kaizen Event Process
1. Orientation

5. Report &
Celebrate

4. Make the
Improvements

2. Understand
Current Situation

3. Develop
Future State
Design

© Operational Excellence Consulting. All rights reserved.

65

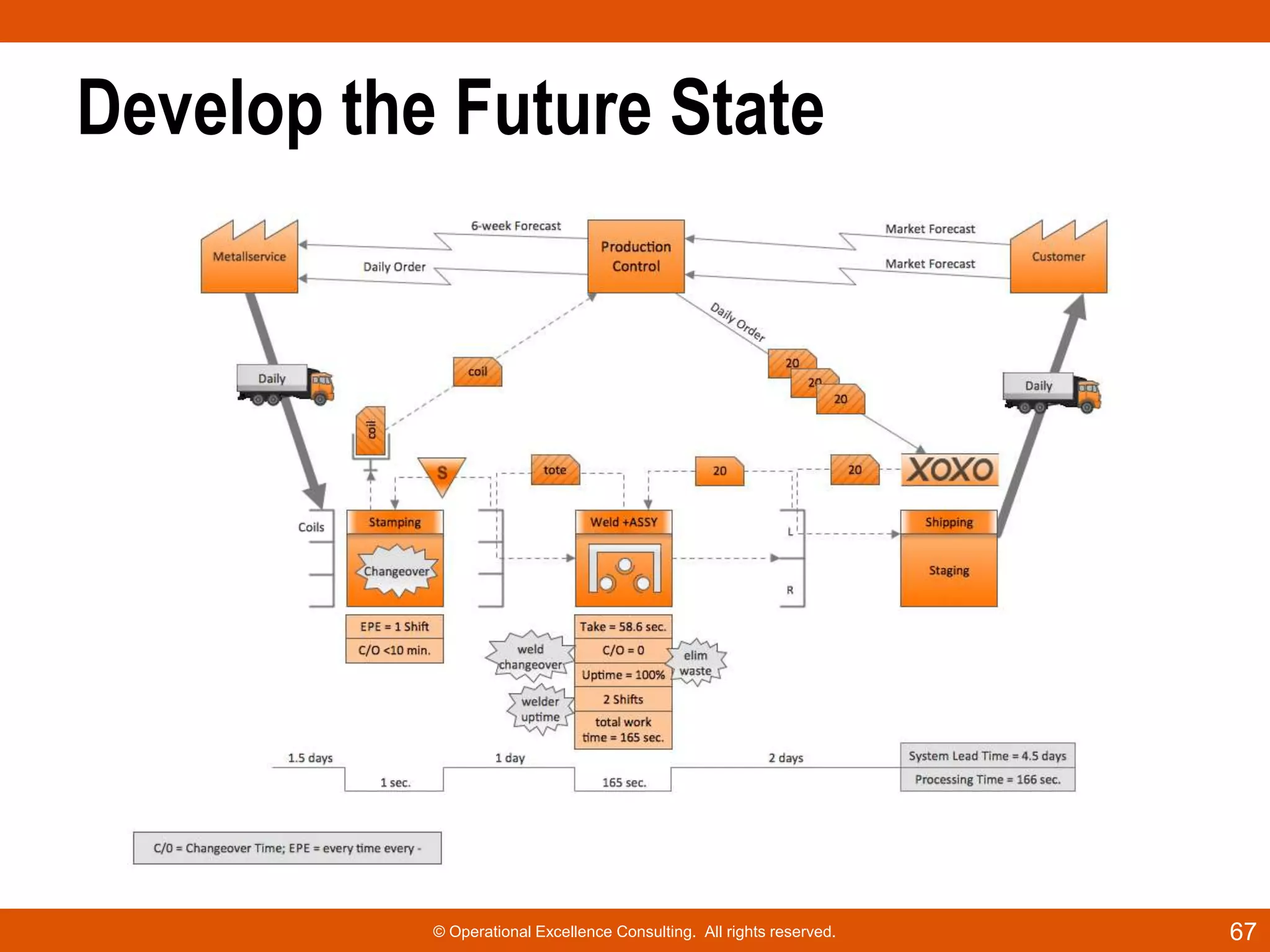

Develop the Future State

© Operational Excellence Consulting. All rights reserved.

67
Day 4 –
Make the
improvements

© Operational Excellence Consulting. All rights reserved.
Implement the New Process
• Plan
 What specific changes need to occur
 In what sequence
 Resources needed – get commitment
 Impact on existing activities and functions

 Responsibilities

• Communicate
 Who, what, when

• Implement
 Execute the plan

• Modify (as needed)
© Operational Excellence Consulting. All rights reserved.

71
Develop Implementation Plan
• Will new skill sets be
required, and how to
achieve them?
• Is the current organization
structure sufficient?
• Are there cultural issues?
• Is there potential for “push
back”?
• Any implications for
suppliers?

• Implications for customers?
• Implications for team
members?
• Do current technologies
support the new process?
Are they available and cost
justifiable?
• Technology is an enabler,
not a solution.

• Does the reward system
support the new process?

© Operational Excellence Consulting. All rights reserved.

73

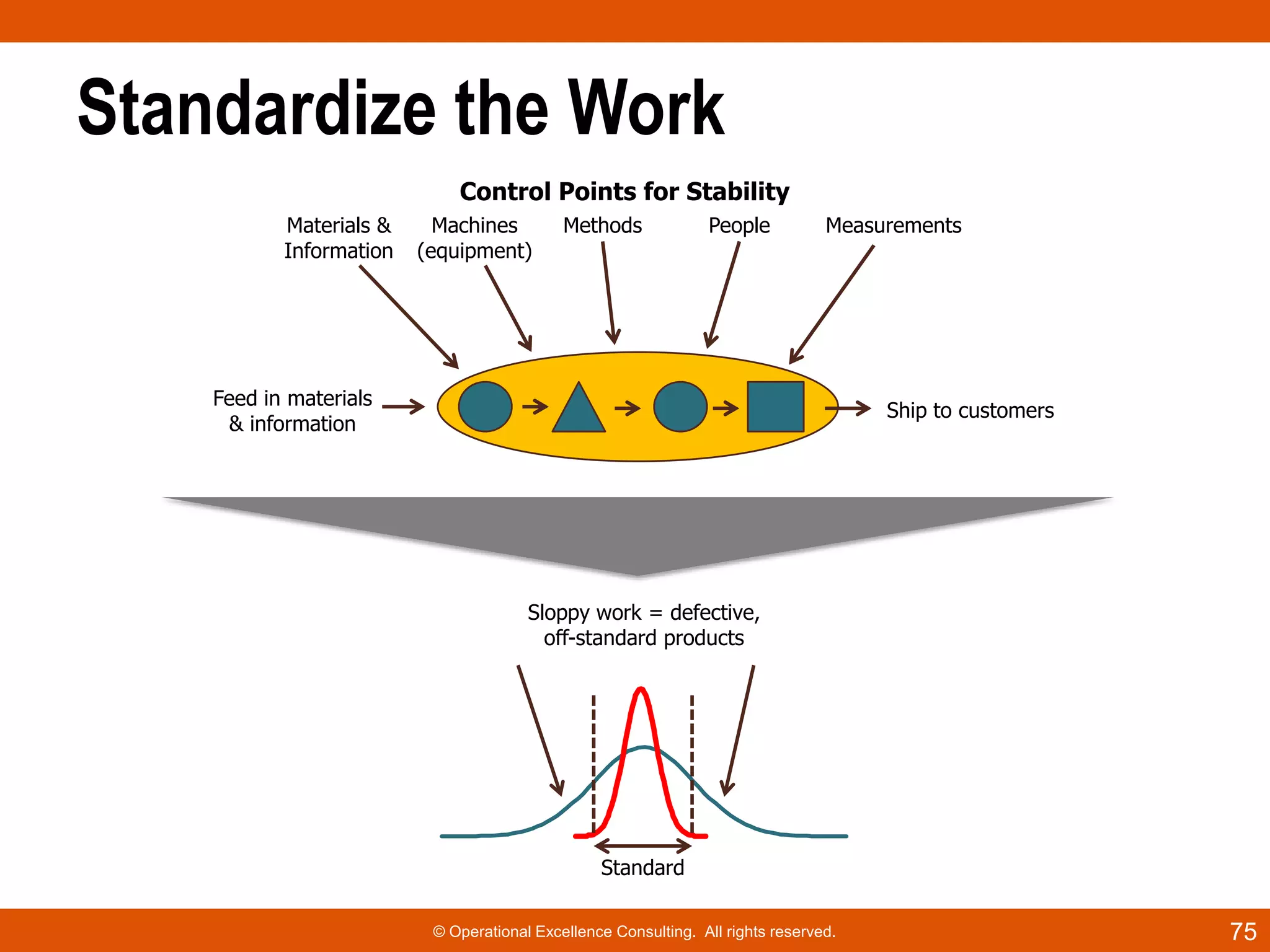

Standardize the Work
Control Points for Stability
Materials &
Information

Machines
(equipment)

Methods

People

Measurements

Feed in materials
& information

Ship to customers

Sloppy work = defective,
off-standard products

Standard
© Operational Excellence Consulting. All rights reserved.

75
Mistake-proof the Process
• Mistake proof the
process.
• Take the magic out
and make it into a
repeatable science by
eliminating the ability
to make errors.

Figure out which
method applies,
starting at the top.

Best
 Elimination
 Replacement
 Prevention
 Facilitation
 Detection
 Mitigation

© Operational Excellence Consulting. All rights reserved.

77

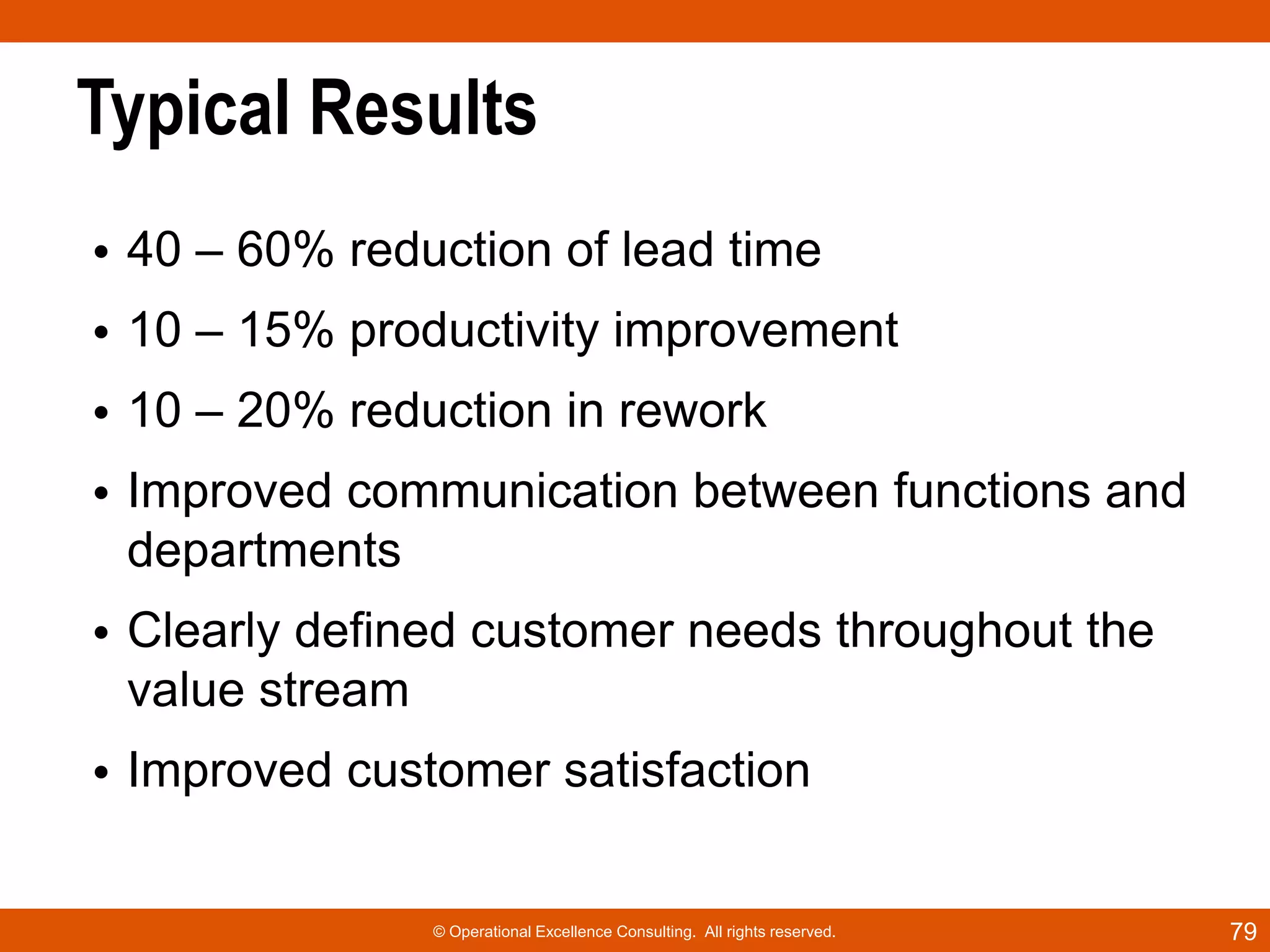

Typical Results
• 40 – 60% reduction of lead time

• 10 – 15% productivity improvement
• 10 – 20% reduction in rework
• Improved communication between functions and
departments
• Clearly defined customer needs throughout the
value stream

• Improved customer satisfaction

© Operational Excellence Consulting. All rights reserved.

79
Day 5 –
Report &
celebrate

© Operational Excellence Consulting. All rights reserved.
The Final Presentation
• Allow teams to document and publicize
accomplishments
• All team members should participate
• Allow time during event to prepare (2-3 hours)

• Invite sponsors
• Invite employees from target areas as well
adjacent areas

• Invite audience to stay for celebration

© Operational Excellence Consulting. All rights reserved.

83
Celebration Guidelines
• Involve senior leaders in celebration

• Involve and recognize contributions of area
employees not actually on the team
• Recognize contribution of support functions

• Involve team in celebration/recognition specifics
• Recognition should be focused squarely on
results achieved, not simply on having
participated in an event

© Operational Excellence Consulting. All rights reserved.

85

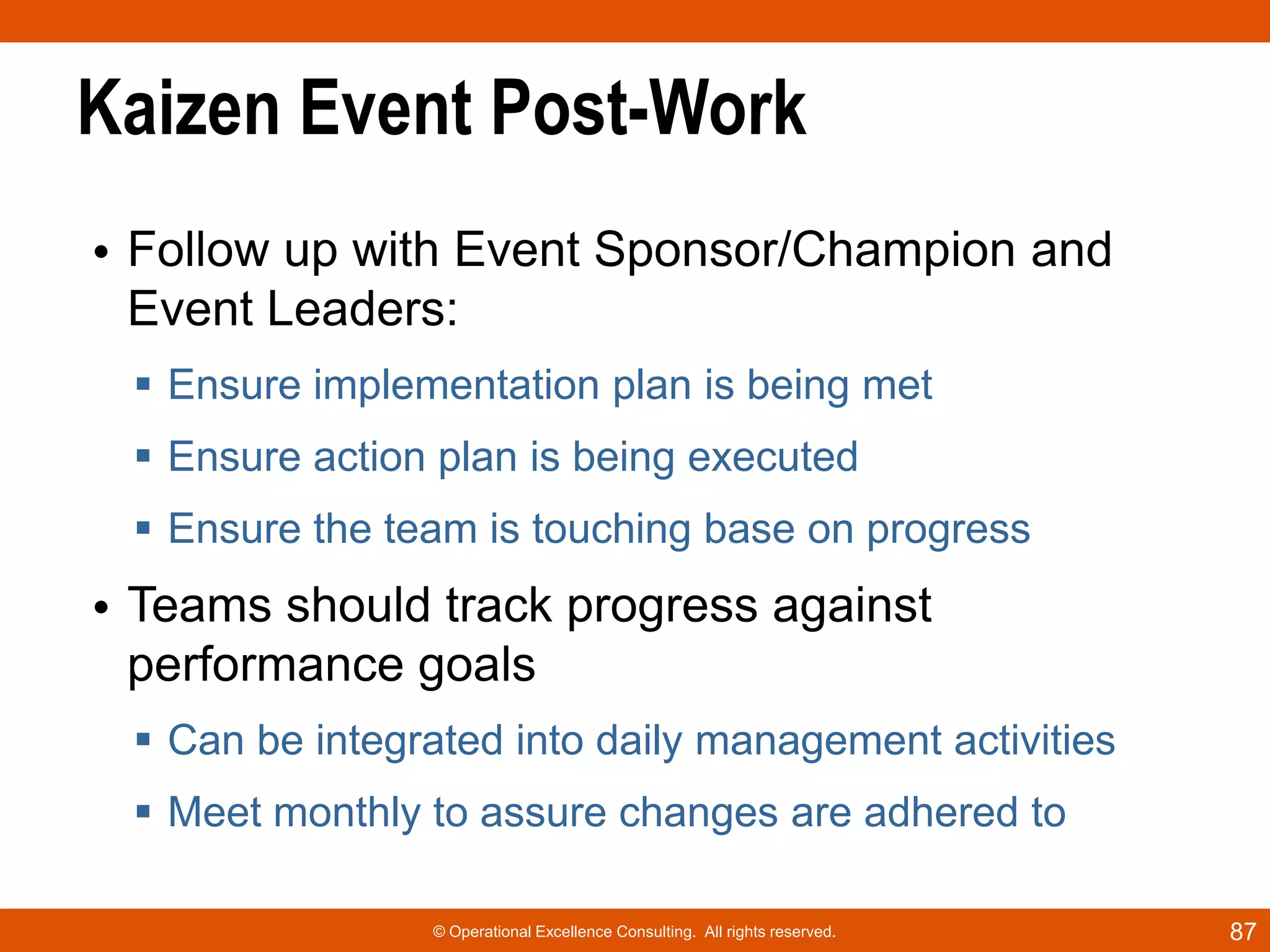

Kaizen Event Post-Work
• Follow up with Event Sponsor/Champion and
Event Leaders:
 Ensure implementation plan is being met
 Ensure action plan is being executed

 Ensure the team is touching base on progress

• Teams should track progress against
performance goals
 Can be integrated into daily management activities
 Meet monthly to assure changes are adhered to
© Operational Excellence Consulting. All rights reserved.

87
Kaizen Event Post-Work
• Publish follow-up communication
 Publish and circulate successes using Lean Team
Room/Intranet
 Send summary and thank-you package to all external
participants
 Give recognition to participants via the Lean
Newsletter to:
 Broadcast

results and generate excitement

 Communicate
 Describe

lessons learned

best practices for deployment elsewhere

© Operational Excellence Consulting. All rights reserved.

89
END OF GUIDEBOOK
For more information about our
services, please visit

www.oeconsulting.co
m.sg

© Operational Excellence Consulting. All rights reserved.
A
Kaizen Event
Templates
© Operational Excellence Consulting. All rights reserved.

Kaizen Summary
Project type: ________________ Area: _________________Team Leader: ______________
Before/current state

After/future state

Reasons project chosen:

Results:

Tools used on project:

Next steps:

© Operational Excellence Consulting. All rights reserved.

95
Kaizen Status Update
Kaizen Implemented

Expected Results

© Operational Excellence Consulting. All rights reserved.

Actual Results

97
Enter Kaizen title:
Agenda

© Operational Excellence Consulting. All rights reserved.

99
Enter Kaizen title:
Metrics & Data Collection Plan
What is to be
measured

Who is responsible
for gathering of
data, and who is to
receive data

When

Where

© Operational Excellence Consulting. All rights reserved.

How

101
Enter Kaizen title:
Layout:
• Before

• After

© Operational Excellence Consulting. All rights reserved.

103
Enter Kaizen title:
Mistake proofing improvements
• Problem

• Solution

© Operational Excellence Consulting. All rights reserved.

105
Enter Kaizen title:
Lessons learned
• Lesson one

• Lesson two
• Lesson three

© Operational Excellence Consulting. All rights reserved.

107

More Related Content

What's hot

Lean Transformation ~ A Journey
Lean Transformation ~ A JourneyLean Transformation ~ A Journey
Lean Transformation ~ A Journey
Anand Subramaniam

Lean Office
Lean OfficeLean Office
Introduction To Lean
Introduction To LeanIntroduction To Lean
Introduction To Lean
GoLeanSixSigma.com

Rapid Improvement: How to Change Behaviors & Get Stuff Done FAST
Rapid Improvement: How to Change Behaviors & Get Stuff Done FASTRapid Improvement: How to Change Behaviors & Get Stuff Done FAST
Rapid Improvement: How to Change Behaviors & Get Stuff Done FAST
TKMG, Inc.

Lean Six Sigma 101
Lean Six Sigma 101Lean Six Sigma 101
Lean Six Sigma 101
shailsood

Lean Office by Operational Excellence Consulting
Lean Office by Operational Excellence ConsultingLean Office by Operational Excellence Consulting
Lean Office by Operational Excellence Consulting
Operational Excellence Consulting

Lean Management System Assessment
Lean Management System AssessmentLean Management System Assessment
Lean Management System Assessment
Operational Excellence Consulting

Continuous Improvement Strategy
Continuous Improvement StrategyContinuous Improvement Strategy
Continuous Improvement Strategy
Craig Marton

LeanKaizenTraining
LeanKaizenTrainingLeanKaizenTraining
LeanKaizenTraining
ahmad bassiouny

Kaizen
KaizenKaizen
Value Stream Mapping: Case Studies
Value Stream Mapping: Case StudiesValue Stream Mapping: Case Studies
Value Stream Mapping: Case Studies
TKMG, Inc.

Kaizen
KaizenKaizen
Lean Thinking by Operational Excellence Consulting
Lean Thinking by Operational Excellence ConsultingLean Thinking by Operational Excellence Consulting
Lean Thinking by Operational Excellence Consulting
Operational Excellence Consulting

Value Stream Mapping
Value Stream MappingValue Stream Mapping
Value Stream Mapping
Michael (Mike) Nunn

Fundamentals of Lean
Fundamentals of LeanFundamentals of Lean
Fundamentals of Lean
Kirk Hazen, P.E.

Lean Leadership: Part 2 of 3
Lean Leadership: Part 2 of 3Lean Leadership: Part 2 of 3
Lean Leadership: Part 2 of 3
TKMG, Inc.

Identifying Lean Waste
Identifying Lean WasteIdentifying Lean Waste
Identifying Lean Waste
Operational Excellence Consulting

Overview of 3 day Lean & Kaizen Course Content
Overview of 3 day Lean & Kaizen Course ContentOverview of 3 day Lean & Kaizen Course Content
Overview of 3 day Lean & Kaizen Course Content
Timothy Wooi

Lean Six Sigma: DMAIC In-Depth
Lean Six Sigma: DMAIC In-DepthLean Six Sigma: DMAIC In-Depth
Lean Six Sigma: DMAIC In-Depth
GoLeanSixSigma.com

Kaizen Training
Kaizen Training Kaizen Training
Kaizen Training
jah10632

What's hot (20)

Lean Transformation ~ A Journey
Lean Transformation ~ A JourneyLean Transformation ~ A Journey
Lean Transformation ~ A Journey

Lean Office
Lean OfficeLean Office
Lean Office

Introduction To Lean
Introduction To LeanIntroduction To Lean
Introduction To Lean

Rapid Improvement: How to Change Behaviors & Get Stuff Done FAST
Rapid Improvement: How to Change Behaviors & Get Stuff Done FASTRapid Improvement: How to Change Behaviors & Get Stuff Done FAST
Rapid Improvement: How to Change Behaviors & Get Stuff Done FAST

Lean Six Sigma 101
Lean Six Sigma 101Lean Six Sigma 101
Lean Six Sigma 101

Lean Office by Operational Excellence Consulting
Lean Office by Operational Excellence ConsultingLean Office by Operational Excellence Consulting
Lean Office by Operational Excellence Consulting

Lean Management System Assessment
Lean Management System AssessmentLean Management System Assessment
Lean Management System Assessment

Continuous Improvement Strategy
Continuous Improvement StrategyContinuous Improvement Strategy
Continuous Improvement Strategy

LeanKaizenTraining
LeanKaizenTrainingLeanKaizenTraining
LeanKaizenTraining

Kaizen
KaizenKaizen
Kaizen

Value Stream Mapping: Case Studies
Value Stream Mapping: Case StudiesValue Stream Mapping: Case Studies
Value Stream Mapping: Case Studies

Kaizen
KaizenKaizen
Kaizen

Lean Thinking by Operational Excellence Consulting
Lean Thinking by Operational Excellence ConsultingLean Thinking by Operational Excellence Consulting
Lean Thinking by Operational Excellence Consulting

Value Stream Mapping
Value Stream MappingValue Stream Mapping
Value Stream Mapping

Fundamentals of Lean
Fundamentals of LeanFundamentals of Lean
Fundamentals of Lean

Lean Leadership: Part 2 of 3
Lean Leadership: Part 2 of 3Lean Leadership: Part 2 of 3
Lean Leadership: Part 2 of 3

Identifying Lean Waste
Identifying Lean WasteIdentifying Lean Waste
Identifying Lean Waste

Overview of 3 day Lean & Kaizen Course Content
Overview of 3 day Lean & Kaizen Course ContentOverview of 3 day Lean & Kaizen Course Content
Overview of 3 day Lean & Kaizen Course Content

Lean Six Sigma: DMAIC In-Depth
Lean Six Sigma: DMAIC In-DepthLean Six Sigma: DMAIC In-Depth
Lean Six Sigma: DMAIC In-Depth

Kaizen Training
Kaizen Training Kaizen Training
Kaizen Training

Viewers also liked

Kaizen – Forms & Checklists
Kaizen – Forms & ChecklistsKaizen – Forms & Checklists
Kaizen – Forms & Checklists
Anand Subramaniam

Kaizen Seminar Presentation
Kaizen Seminar PresentationKaizen Seminar Presentation
Kaizen Seminar Presentation
Orange Slides

Kaizen Ppt
Kaizen PptKaizen Ppt
Kaizen Ppt
vinaybidarimath

Kaizen forms xls
Kaizen forms xlsKaizen forms xls
Kaizen forms xls
beskidek

Kaizen team leader guide
Kaizen team leader guideKaizen team leader guide
Kaizen team leader guide
Kobi Vider

Kaizen training
Kaizen trainingKaizen training
Kaizen training
Sukin Shetty

Kaizen
KaizenKaizen
Kaizen
Naeem Hassan

Kaizen
KaizenKaizen
Kaizen
wpegolo

Improve phase lean six sigma tollgate template
Improve phase   lean six sigma tollgate templateImprove phase   lean six sigma tollgate template
Improve phase lean six sigma tollgate template
Steven Bonacorsi

Kaizen Philosophy
Kaizen PhilosophyKaizen Philosophy
Kaizen Philosophy
pratik207

Kaizen
KaizenKaizen
Gemba Walk Questions
Gemba Walk QuestionsGemba Walk Questions
Gemba Walk Questions
Tom Curtis

Value Stream Analysis
Value Stream AnalysisValue Stream Analysis
Value Stream Analysis
Margarito Tongco, Jr.

Kaizen & Small Group Activities
Kaizen & Small Group ActivitiesKaizen & Small Group Activities
Kaizen & Small Group Activities
DEEPAK SAHOO

Patterns Of Kaizen & A3 Thinking
Patterns Of Kaizen & A3 ThinkingPatterns Of Kaizen & A3 Thinking
Patterns Of Kaizen & A3 Thinking
Art of Lean, Inc.

A3 & Kaizen: Here's How
A3 & Kaizen: Here's HowA3 & Kaizen: Here's How
A3 & Kaizen: Here's How
Claudio Perrone

Tqm tpm kaizen
Tqm tpm kaizenTqm tpm kaizen
Tqm tpm kaizen
Anubha Walia

Six sigma vs kaizen
Six sigma vs kaizenSix sigma vs kaizen
Six sigma vs kaizen
Gopala P.

Kaizen Innovation in Manufacturing
Kaizen Innovation in ManufacturingKaizen Innovation in Manufacturing
Kaizen Innovation in Manufacturing
Timothy Wooi

Viewers also liked (19)

Kaizen – Forms & Checklists
Kaizen – Forms & ChecklistsKaizen – Forms & Checklists
Kaizen – Forms & Checklists

Kaizen Seminar Presentation
Kaizen Seminar PresentationKaizen Seminar Presentation
Kaizen Seminar Presentation

Kaizen Ppt
Kaizen PptKaizen Ppt
Kaizen Ppt

Kaizen forms xls
Kaizen forms xlsKaizen forms xls
Kaizen forms xls

Kaizen team leader guide
Kaizen team leader guideKaizen team leader guide
Kaizen team leader guide

Kaizen training
Kaizen trainingKaizen training
Kaizen training

Kaizen
KaizenKaizen
Kaizen

Kaizen
KaizenKaizen
Kaizen

Improve phase lean six sigma tollgate template
Improve phase   lean six sigma tollgate templateImprove phase   lean six sigma tollgate template
Improve phase lean six sigma tollgate template

Kaizen Philosophy
Kaizen PhilosophyKaizen Philosophy
Kaizen Philosophy

Kaizen
KaizenKaizen
Kaizen

Gemba Walk Questions
Gemba Walk QuestionsGemba Walk Questions
Gemba Walk Questions

Value Stream Analysis
Value Stream AnalysisValue Stream Analysis
Value Stream Analysis

Kaizen & Small Group Activities
Kaizen & Small Group ActivitiesKaizen & Small Group Activities
Kaizen & Small Group Activities

Patterns Of Kaizen & A3 Thinking
Patterns Of Kaizen & A3 ThinkingPatterns Of Kaizen & A3 Thinking
Patterns Of Kaizen & A3 Thinking

A3 & Kaizen: Here's How
A3 & Kaizen: Here's HowA3 & Kaizen: Here's How
A3 & Kaizen: Here's How

Tqm tpm kaizen
Tqm tpm kaizenTqm tpm kaizen
Tqm tpm kaizen

Six sigma vs kaizen
Six sigma vs kaizenSix sigma vs kaizen
Six sigma vs kaizen

Kaizen Innovation in Manufacturing
Kaizen Innovation in ManufacturingKaizen Innovation in Manufacturing
Kaizen Innovation in Manufacturing

Similar to Kaizen Event Guide

Kaizen events -what are they? Driving Performance Improvement
Kaizen events -what are they? Driving Performance ImprovementKaizen events -what are they? Driving Performance Improvement
Kaizen events -what are they? Driving Performance Improvement
Philip Lowe

Conducting a Kaizen.pdf
Conducting a Kaizen.pdfConducting a Kaizen.pdf
Conducting a Kaizen.pdf
Vijay Khonde

APICS Top Management Night
APICS  Top Management NightAPICS  Top Management Night
APICS Top Management Night
Mike Pletzer

Kaizen Event Guide: Transforming Challenges into Opportunities
Kaizen Event Guide: Transforming Challenges into OpportunitiesKaizen Event Guide: Transforming Challenges into Opportunities
Kaizen Event Guide: Transforming Challenges into Opportunities
Operational Excellence Consulting

Process Management by Jan Mohammed.pptx
Process Management by Jan Mohammed.pptxProcess Management by Jan Mohammed.pptx
Process Management by Jan Mohammed.pptx
JanMohammed3

Agile software development
Agile software developmentAgile software development
Agile software development
Siddharth Sharma

The KAIZEN method.pptx
The KAIZEN method.pptxThe KAIZEN method.pptx
The KAIZEN method.pptx
Jorge Alvarez

Proven Methods to Abnormality Management and Error Proofing
Proven Methods to Abnormality Management and Error ProofingProven Methods to Abnormality Management and Error Proofing
Proven Methods to Abnormality Management and Error Proofing
SafetyChain Software

Maintenance Planning and Scheduling Workshop - Greenvile, SC November 12-14,...
Maintenance Planning and Scheduling Workshop  - Greenvile, SC November 12-14,...Maintenance Planning and Scheduling Workshop  - Greenvile, SC November 12-14,...
Maintenance Planning and Scheduling Workshop - Greenvile, SC November 12-14,...
Ricky Smith CMRP, CMRT

Emptying Your Cup an Agile Primer
Emptying Your Cup an Agile Primer Emptying Your Cup an Agile Primer
Emptying Your Cup an Agile Primer
Todd Shelton

8 Steps To Success In Maintenance Planning And Scheduling
8 Steps To Success In Maintenance Planning And Scheduling8 Steps To Success In Maintenance Planning And Scheduling
8 Steps To Success In Maintenance Planning And Scheduling
Ricky Smith CMRP, CMRT

Teaching Scrum Fundamentals_A Quick Guide to Getting Started.pdf
Teaching Scrum Fundamentals_A Quick Guide to Getting Started.pdfTeaching Scrum Fundamentals_A Quick Guide to Getting Started.pdf
Teaching Scrum Fundamentals_A Quick Guide to Getting Started.pdf
Bijay Jayaswal, SPC4, RTE, CSM, PMP, MS, MBA

Top tips for a successful traceability system implemention paula peterson 2015
Top tips for a successful traceability system implemention paula peterson 2015Top tips for a successful traceability system implemention paula peterson 2015
Top tips for a successful traceability system implemention paula peterson 2015
Paula Peterson

Top Tips for a Successful Traceability System Implemention Paula Peterson 2015
Top Tips for a Successful Traceability System Implemention Paula Peterson 2015Top Tips for a Successful Traceability System Implemention Paula Peterson 2015
Top Tips for a Successful Traceability System Implemention Paula Peterson 2015
Paula Peterson

Teaching Scrum Fundamentals_A Quick Guide to Getting Started.pdf
Teaching Scrum Fundamentals_A Quick Guide to Getting Started.pdfTeaching Scrum Fundamentals_A Quick Guide to Getting Started.pdf
Teaching Scrum Fundamentals_A Quick Guide to Getting Started.pdf
Bijay Jayaswal, SPC4, RTE, CSM, PMP, MS, MBA

Lean transformation
Lean transformationLean transformation
Lean transformation
Anand Subramaniam

Preventive Maintenance Best Practices workshop Brochure
Preventive Maintenance Best Practices workshop BrochurePreventive Maintenance Best Practices workshop Brochure
Preventive Maintenance Best Practices workshop Brochure
Ricky Smith CMRP, CMRT

Kaizen
KaizenKaizen
Kaizen
Akhil Padiga

AVATA Webinar: Solutions to Common Demantra & ASCP Challenges
AVATA Webinar: Solutions to Common Demantra & ASCP ChallengesAVATA Webinar: Solutions to Common Demantra & ASCP Challenges
AVATA Webinar: Solutions to Common Demantra & ASCP Challenges
AVATA

CFW - Continuous Improvement & Lean Techniques
CFW - Continuous Improvement & Lean TechniquesCFW - Continuous Improvement & Lean Techniques
CFW - Continuous Improvement & Lean Techniques
Rae Davies

Similar to Kaizen Event Guide (20)

Kaizen events -what are they? Driving Performance Improvement
Kaizen events -what are they? Driving Performance ImprovementKaizen events -what are they? Driving Performance Improvement
Kaizen events -what are they? Driving Performance Improvement

Conducting a Kaizen.pdf
Conducting a Kaizen.pdfConducting a Kaizen.pdf
Conducting a Kaizen.pdf

APICS Top Management Night
APICS  Top Management NightAPICS  Top Management Night
APICS Top Management Night

Kaizen Event Guide: Transforming Challenges into Opportunities
Kaizen Event Guide: Transforming Challenges into OpportunitiesKaizen Event Guide: Transforming Challenges into Opportunities
Kaizen Event Guide: Transforming Challenges into Opportunities

Process Management by Jan Mohammed.pptx
Process Management by Jan Mohammed.pptxProcess Management by Jan Mohammed.pptx
Process Management by Jan Mohammed.pptx

Agile software development
Agile software developmentAgile software development
Agile software development

The KAIZEN method.pptx
The KAIZEN method.pptxThe KAIZEN method.pptx
The KAIZEN method.pptx

Proven Methods to Abnormality Management and Error Proofing
Proven Methods to Abnormality Management and Error ProofingProven Methods to Abnormality Management and Error Proofing
Proven Methods to Abnormality Management and Error Proofing

Maintenance Planning and Scheduling Workshop - Greenvile, SC November 12-14,...
Maintenance Planning and Scheduling Workshop  - Greenvile, SC November 12-14,...Maintenance Planning and Scheduling Workshop  - Greenvile, SC November 12-14,...
Maintenance Planning and Scheduling Workshop - Greenvile, SC November 12-14,...

Emptying Your Cup an Agile Primer
Emptying Your Cup an Agile Primer Emptying Your Cup an Agile Primer
Emptying Your Cup an Agile Primer

8 Steps To Success In Maintenance Planning And Scheduling
8 Steps To Success In Maintenance Planning And Scheduling8 Steps To Success In Maintenance Planning And Scheduling
8 Steps To Success In Maintenance Planning And Scheduling

Teaching Scrum Fundamentals_A Quick Guide to Getting Started.pdf
Teaching Scrum Fundamentals_A Quick Guide to Getting Started.pdfTeaching Scrum Fundamentals_A Quick Guide to Getting Started.pdf
Teaching Scrum Fundamentals_A Quick Guide to Getting Started.pdf

Top tips for a successful traceability system implemention paula peterson 2015
Top tips for a successful traceability system implemention paula peterson 2015Top tips for a successful traceability system implemention paula peterson 2015
Top tips for a successful traceability system implemention paula peterson 2015

Top Tips for a Successful Traceability System Implemention Paula Peterson 2015
Top Tips for a Successful Traceability System Implemention Paula Peterson 2015Top Tips for a Successful Traceability System Implemention Paula Peterson 2015
Top Tips for a Successful Traceability System Implemention Paula Peterson 2015

Teaching Scrum Fundamentals_A Quick Guide to Getting Started.pdf
Teaching Scrum Fundamentals_A Quick Guide to Getting Started.pdfTeaching Scrum Fundamentals_A Quick Guide to Getting Started.pdf
Teaching Scrum Fundamentals_A Quick Guide to Getting Started.pdf

Lean transformation
Lean transformationLean transformation
Lean transformation

Preventive Maintenance Best Practices workshop Brochure
Preventive Maintenance Best Practices workshop BrochurePreventive Maintenance Best Practices workshop Brochure
Preventive Maintenance Best Practices workshop Brochure

Kaizen
KaizenKaizen
Kaizen

AVATA Webinar: Solutions to Common Demantra & ASCP Challenges
AVATA Webinar: Solutions to Common Demantra & ASCP ChallengesAVATA Webinar: Solutions to Common Demantra & ASCP Challenges
AVATA Webinar: Solutions to Common Demantra & ASCP Challenges

CFW - Continuous Improvement & Lean Techniques
CFW - Continuous Improvement & Lean TechniquesCFW - Continuous Improvement & Lean Techniques
CFW - Continuous Improvement & Lean Techniques

More from Flevy.com Best Practices

100 Case Studies on Strategy & Transformation.pdf
100 Case Studies on Strategy & Transformation.pdf100 Case Studies on Strategy & Transformation.pdf
100 Case Studies on Strategy & Transformation.pdf
Flevy.com Best Practices

Project Management for MBA (in French)
Project Management for MBA (in French)Project Management for MBA (in French)
Project Management for MBA (in French)
Flevy.com Best Practices

4 Stages of Disruption
4 Stages of Disruption4 Stages of Disruption
4 Stages of Disruption
Flevy.com Best Practices

Customer-centric Culture
Customer-centric CultureCustomer-centric Culture
Customer-centric Culture
Flevy.com Best Practices

[Whitepaper] Business Transformation Success Factors
[Whitepaper] Business Transformation Success Factors[Whitepaper] Business Transformation Success Factors
[Whitepaper] Business Transformation Success Factors
Flevy.com Best Practices

[Whitepaper] 5 Dimensions of Employee Engagement Scorecard
[Whitepaper] 5 Dimensions of Employee Engagement Scorecard[Whitepaper] 5 Dimensions of Employee Engagement Scorecard
[Whitepaper] 5 Dimensions of Employee Engagement Scorecard
Flevy.com Best Practices

[Whitepaper] Digital Transformation: Workforce Digitization
[Whitepaper] Digital Transformation: Workforce Digitization[Whitepaper] Digital Transformation: Workforce Digitization
[Whitepaper] Digital Transformation: Workforce Digitization
Flevy.com Best Practices

[Whitepaper] Strategic Human Resources: Evolution of Competition
[Whitepaper] Strategic Human Resources: Evolution of Competition[Whitepaper] Strategic Human Resources: Evolution of Competition
[Whitepaper] Strategic Human Resources: Evolution of Competition
Flevy.com Best Practices

[Whitepaper] 8 Key Steps of Data Integration: Restructuring Redeployment Asse...
[Whitepaper] 8 Key Steps of Data Integration: Restructuring Redeployment Asse...[Whitepaper] 8 Key Steps of Data Integration: Restructuring Redeployment Asse...
[Whitepaper] 8 Key Steps of Data Integration: Restructuring Redeployment Asse...
Flevy.com Best Practices

[Whitepaper] Strategy Classics: Value Disciplines Model
[Whitepaper] Strategy Classics: Value Disciplines Model[Whitepaper] Strategy Classics: Value Disciplines Model
[Whitepaper] Strategy Classics: Value Disciplines Model
Flevy.com Best Practices

[Whitepaper] The Definitive Guide to Strategic Planning: Here’s What You Need...
[Whitepaper] The Definitive Guide to Strategic Planning: Here’s What You Need...[Whitepaper] The Definitive Guide to Strategic Planning: Here’s What You Need...
[Whitepaper] The Definitive Guide to Strategic Planning: Here’s What You Need...
Flevy.com Best Practices

[Whitepaper] The Definitive Introduction to Strategy Development and Strategy...
[Whitepaper] The Definitive Introduction to Strategy Development and Strategy...[Whitepaper] The Definitive Introduction to Strategy Development and Strategy...
[Whitepaper] The Definitive Introduction to Strategy Development and Strategy...
Flevy.com Best Practices

[Whitepaper] The “Theory of Constraints:” What’s Limiting Your Organization?
[Whitepaper] The “Theory of Constraints:” What’s Limiting Your Organization?[Whitepaper] The “Theory of Constraints:” What’s Limiting Your Organization?
[Whitepaper] The “Theory of Constraints:” What’s Limiting Your Organization?
Flevy.com Best Practices

[Whitepaper] Transportation Cost Reduction in Supply Chain Management
[Whitepaper] Transportation Cost Reduction in Supply Chain Management[Whitepaper] Transportation Cost Reduction in Supply Chain Management
[Whitepaper] Transportation Cost Reduction in Supply Chain Management
Flevy.com Best Practices

[Whitepaper] A Great Leadership Experience: Dr. Rachid Yazami, Inventor of th...
[Whitepaper] A Great Leadership Experience: Dr. Rachid Yazami, Inventor of th...[Whitepaper] A Great Leadership Experience: Dr. Rachid Yazami, Inventor of th...
[Whitepaper] A Great Leadership Experience: Dr. Rachid Yazami, Inventor of th...
Flevy.com Best Practices

[Whitepaper] Finding It Hard to Manage Conflict at the Workplace? Use the Tho...
[Whitepaper] Finding It Hard to Manage Conflict at the Workplace? Use the Tho...[Whitepaper] Finding It Hard to Manage Conflict at the Workplace? Use the Tho...
[Whitepaper] Finding It Hard to Manage Conflict at the Workplace? Use the Tho...
Flevy.com Best Practices

[Whitepaper] Key Account Management: Handling Large Global Accounts the Right...
[Whitepaper] Key Account Management: Handling Large Global Accounts the Right...[Whitepaper] Key Account Management: Handling Large Global Accounts the Right...
[Whitepaper] Key Account Management: Handling Large Global Accounts the Right...
Flevy.com Best Practices

[Whitepaper] Nudge Theory: An Effective Way to Transform Negative Behaviors
[Whitepaper] Nudge Theory: An Effective Way to Transform Negative Behaviors[Whitepaper] Nudge Theory: An Effective Way to Transform Negative Behaviors
[Whitepaper] Nudge Theory: An Effective Way to Transform Negative Behaviors
Flevy.com Best Practices

[Whitepaper] Business Model Innovation: Creation of Scalable Business Models ...
[Whitepaper] Business Model Innovation: Creation of Scalable Business Models ...[Whitepaper] Business Model Innovation: Creation of Scalable Business Models ...
[Whitepaper] Business Model Innovation: Creation of Scalable Business Models ...
Flevy.com Best Practices

[Whitepaper] Shareholder Value Traps: How to Evade Them and Focus on Value Cr...
[Whitepaper] Shareholder Value Traps: How to Evade Them and Focus on Value Cr...[Whitepaper] Shareholder Value Traps: How to Evade Them and Focus on Value Cr...
[Whitepaper] Shareholder Value Traps: How to Evade Them and Focus on Value Cr...
Flevy.com Best Practices

More from Flevy.com Best Practices (20)

100 Case Studies on Strategy & Transformation.pdf
100 Case Studies on Strategy & Transformation.pdf100 Case Studies on Strategy & Transformation.pdf
100 Case Studies on Strategy & Transformation.pdf

Project Management for MBA (in French)
Project Management for MBA (in French)Project Management for MBA (in French)
Project Management for MBA (in French)

4 Stages of Disruption
4 Stages of Disruption4 Stages of Disruption
4 Stages of Disruption

Customer-centric Culture
Customer-centric CultureCustomer-centric Culture
Customer-centric Culture

[Whitepaper] Business Transformation Success Factors
[Whitepaper] Business Transformation Success Factors[Whitepaper] Business Transformation Success Factors
[Whitepaper] Business Transformation Success Factors

[Whitepaper] 5 Dimensions of Employee Engagement Scorecard
[Whitepaper] 5 Dimensions of Employee Engagement Scorecard[Whitepaper] 5 Dimensions of Employee Engagement Scorecard
[Whitepaper] 5 Dimensions of Employee Engagement Scorecard

[Whitepaper] Digital Transformation: Workforce Digitization
[Whitepaper] Digital Transformation: Workforce Digitization[Whitepaper] Digital Transformation: Workforce Digitization
[Whitepaper] Digital Transformation: Workforce Digitization

[Whitepaper] Strategic Human Resources: Evolution of Competition
[Whitepaper] Strategic Human Resources: Evolution of Competition[Whitepaper] Strategic Human Resources: Evolution of Competition
[Whitepaper] Strategic Human Resources: Evolution of Competition

[Whitepaper] 8 Key Steps of Data Integration: Restructuring Redeployment Asse...
[Whitepaper] 8 Key Steps of Data Integration: Restructuring Redeployment Asse...[Whitepaper] 8 Key Steps of Data Integration: Restructuring Redeployment Asse...
[Whitepaper] 8 Key Steps of Data Integration: Restructuring Redeployment Asse...

[Whitepaper] Strategy Classics: Value Disciplines Model
[Whitepaper] Strategy Classics: Value Disciplines Model[Whitepaper] Strategy Classics: Value Disciplines Model
[Whitepaper] Strategy Classics: Value Disciplines Model

[Whitepaper] The Definitive Guide to Strategic Planning: Here’s What You Need...
[Whitepaper] The Definitive Guide to Strategic Planning: Here’s What You Need...[Whitepaper] The Definitive Guide to Strategic Planning: Here’s What You Need...
[Whitepaper] The Definitive Guide to Strategic Planning: Here’s What You Need...

[Whitepaper] The Definitive Introduction to Strategy Development and Strategy...
[Whitepaper] The Definitive Introduction to Strategy Development and Strategy...[Whitepaper] The Definitive Introduction to Strategy Development and Strategy...
[Whitepaper] The Definitive Introduction to Strategy Development and Strategy...

[Whitepaper] The “Theory of Constraints:” What’s Limiting Your Organization?
[Whitepaper] The “Theory of Constraints:” What’s Limiting Your Organization?[Whitepaper] The “Theory of Constraints:” What’s Limiting Your Organization?
[Whitepaper] The “Theory of Constraints:” What’s Limiting Your Organization?

[Whitepaper] Transportation Cost Reduction in Supply Chain Management
[Whitepaper] Transportation Cost Reduction in Supply Chain Management[Whitepaper] Transportation Cost Reduction in Supply Chain Management
[Whitepaper] Transportation Cost Reduction in Supply Chain Management

[Whitepaper] A Great Leadership Experience: Dr. Rachid Yazami, Inventor of th...
[Whitepaper] A Great Leadership Experience: Dr. Rachid Yazami, Inventor of th...[Whitepaper] A Great Leadership Experience: Dr. Rachid Yazami, Inventor of th...
[Whitepaper] A Great Leadership Experience: Dr. Rachid Yazami, Inventor of th...

[Whitepaper] Finding It Hard to Manage Conflict at the Workplace? Use the Tho...
[Whitepaper] Finding It Hard to Manage Conflict at the Workplace? Use the Tho...[Whitepaper] Finding It Hard to Manage Conflict at the Workplace? Use the Tho...
[Whitepaper] Finding It Hard to Manage Conflict at the Workplace? Use the Tho...

[Whitepaper] Key Account Management: Handling Large Global Accounts the Right...
[Whitepaper] Key Account Management: Handling Large Global Accounts the Right...[Whitepaper] Key Account Management: Handling Large Global Accounts the Right...
[Whitepaper] Key Account Management: Handling Large Global Accounts the Right...

[Whitepaper] Nudge Theory: An Effective Way to Transform Negative Behaviors
[Whitepaper] Nudge Theory: An Effective Way to Transform Negative Behaviors[Whitepaper] Nudge Theory: An Effective Way to Transform Negative Behaviors
[Whitepaper] Nudge Theory: An Effective Way to Transform Negative Behaviors

[Whitepaper] Business Model Innovation: Creation of Scalable Business Models ...
[Whitepaper] Business Model Innovation: Creation of Scalable Business Models ...[Whitepaper] Business Model Innovation: Creation of Scalable Business Models ...
[Whitepaper] Business Model Innovation: Creation of Scalable Business Models ...

[Whitepaper] Shareholder Value Traps: How to Evade Them and Focus on Value Cr...
[Whitepaper] Shareholder Value Traps: How to Evade Them and Focus on Value Cr...[Whitepaper] Shareholder Value Traps: How to Evade Them and Focus on Value Cr...
[Whitepaper] Shareholder Value Traps: How to Evade Them and Focus on Value Cr...

Recently uploaded

Navigating Change Strategies for Effective Transition and Operational Plannin...
Navigating Change Strategies for Effective Transition and Operational Plannin...Navigating Change Strategies for Effective Transition and Operational Plannin...
Navigating Change Strategies for Effective Transition and Operational Plannin...
Brian Frerichs

Managing Customer & User Experience of Customers
Managing Customer & User Experience of CustomersManaging Customer & User Experience of Customers
Managing Customer & User Experience of Customers
SalmanTahir60

foodgasm restaurant and Bar pune road.docx
foodgasm restaurant and Bar pune road.docxfoodgasm restaurant and Bar pune road.docx
foodgasm restaurant and Bar pune road.docx
PraghyaBhandari

Staffan Canback - The 18 Rays of Project Management
Staffan Canback - The 18 Rays of Project ManagementStaffan Canback - The 18 Rays of Project Management
Staffan Canback - The 18 Rays of Project Management
Tellusant, Inc.

Guide to Obtaining a Money Changer License in Singapore
Guide to Obtaining a Money Changer License in SingaporeGuide to Obtaining a Money Changer License in Singapore
Guide to Obtaining a Money Changer License in Singapore
Enterslice

PAWFESSIONAL ELVA MAX.pdfAAAAAAAAAAAAAAAAAAA
PAWFESSIONAL ELVA MAX.pdfAAAAAAAAAAAAAAAAAAAPAWFESSIONAL ELVA MAX.pdfAAAAAAAAAAAAAAAAAAA
PAWFESSIONAL ELVA MAX.pdfAAAAAAAAAAAAAAAAAAA
lawrenceads01

Top Digital Marketing Strategy in 2024.pdf
Top Digital Marketing Strategy in 2024.pdfTop Digital Marketing Strategy in 2024.pdf
Top Digital Marketing Strategy in 2024.pdf
Top IT Marketing

TALENT ACQUISITION AND MANAGEMENT LECTURE 2
TALENT ACQUISITION AND MANAGEMENT LECTURE 2TALENT ACQUISITION AND MANAGEMENT LECTURE 2
TALENT ACQUISITION AND MANAGEMENT LECTURE 2
projectseasy

1234567891011121314151617181920212223242
12345678910111213141516171819202122232421234567891011121314151617181920212223242
1234567891011121314151617181920212223242
fauzanal343

Anton Grutzmache- Ominisient: The Data Revolution in Banking: From Scoring Cr...
Anton Grutzmache- Ominisient: The Data Revolution in Banking: From Scoring Cr...Anton Grutzmache- Ominisient: The Data Revolution in Banking: From Scoring Cr...
Anton Grutzmache- Ominisient: The Data Revolution in Banking: From Scoring Cr...
itnewsafrica

Mandated reporting powerpoint to help with understanding your role
Mandated reporting powerpoint to help with understanding your roleMandated reporting powerpoint to help with understanding your role
Mandated reporting powerpoint to help with understanding your role
khidalgo2

Cheslyn Jacobs- TymeBank: Building Consumer Trust in Digital Banking
Cheslyn Jacobs- TymeBank: Building Consumer Trust in Digital  BankingCheslyn Jacobs- TymeBank: Building Consumer Trust in Digital  Banking
Cheslyn Jacobs- TymeBank: Building Consumer Trust in Digital Banking
itnewsafrica

BBA Final SML 501 INTERNATIONAL BUSINESS .pdf
BBA Final SML 501 INTERNATIONAL BUSINESS .pdfBBA Final SML 501 INTERNATIONAL BUSINESS .pdf
BBA Final SML 501 INTERNATIONAL BUSINESS .pdf
mcdopex6

Growth Buyouts - The Dawn of the GBO (Slow Ventures)
Growth Buyouts - The  Dawn of the GBO (Slow Ventures)Growth Buyouts - The  Dawn of the GBO (Slow Ventures)
Growth Buyouts - The Dawn of the GBO (Slow Ventures)
Razin Mustafiz

THE IMPORTANCE OF CODING IN DEVOPS EXPLANATION
THE IMPORTANCE OF CODING IN DEVOPS EXPLANATIONTHE IMPORTANCE OF CODING IN DEVOPS EXPLANATION
THE IMPORTANCE OF CODING IN DEVOPS EXPLANATION
hrajkumar444

NewBase 05 July 2024 Energy News issue - 1736 by Khaled Al Awadi_compresse...
NewBase   05 July 2024  Energy News issue - 1736 by Khaled Al Awadi_compresse...NewBase   05 July 2024  Energy News issue - 1736 by Khaled Al Awadi_compresse...
NewBase 05 July 2024 Energy News issue - 1736 by Khaled Al Awadi_compresse...
Khaled Al Awadi

High Profile Girls Call Bhubaneswar 🎈🔥000XX00000 🔥💋🎈 Provide Best And Top Gir...
High Profile Girls Call Bhubaneswar 🎈🔥000XX00000 🔥💋🎈 Provide Best And Top Gir...High Profile Girls Call Bhubaneswar 🎈🔥000XX00000 🔥💋🎈 Provide Best And Top Gir...
High Profile Girls Call Bhubaneswar 🎈🔥000XX00000 🔥💋🎈 Provide Best And Top Gir...
dimplekumaridk322

A Complete Guide of Dubai Freelance Visa and Permit in 2024
A Complete Guide of Dubai Freelance Visa and Permit in 2024A Complete Guide of Dubai Freelance Visa and Permit in 2024
A Complete Guide of Dubai Freelance Visa and Permit in 2024
Dubiz

PETAVIT SIP-05.pdfAAAAAAAAAAAAAAAAAAAAAAAAA
PETAVIT SIP-05.pdfAAAAAAAAAAAAAAAAAAAAAAAAAPETAVIT SIP-05.pdfAAAAAAAAAAAAAAAAAAAAAAAAA
PETAVIT SIP-05.pdfAAAAAAAAAAAAAAAAAAAAAAAAA
lawrenceads01

United Kingdom's Real Estate Mogul: Newman George Leech's Impact on the Swiss...
United Kingdom's Real Estate Mogul: Newman George Leech's Impact on the Swiss...United Kingdom's Real Estate Mogul: Newman George Leech's Impact on the Swiss...
United Kingdom's Real Estate Mogul: Newman George Leech's Impact on the Swiss...
Newman George Leech

Recently uploaded (20)

Navigating Change Strategies for Effective Transition and Operational Plannin...
Navigating Change Strategies for Effective Transition and Operational Plannin...Navigating Change Strategies for Effective Transition and Operational Plannin...
Navigating Change Strategies for Effective Transition and Operational Plannin...

Managing Customer & User Experience of Customers
Managing Customer & User Experience of CustomersManaging Customer & User Experience of Customers
Managing Customer & User Experience of Customers

foodgasm restaurant and Bar pune road.docx
foodgasm restaurant and Bar pune road.docxfoodgasm restaurant and Bar pune road.docx
foodgasm restaurant and Bar pune road.docx

Staffan Canback - The 18 Rays of Project Management
Staffan Canback - The 18 Rays of Project ManagementStaffan Canback - The 18 Rays of Project Management
Staffan Canback - The 18 Rays of Project Management

Guide to Obtaining a Money Changer License in Singapore
Guide to Obtaining a Money Changer License in SingaporeGuide to Obtaining a Money Changer License in Singapore
Guide to Obtaining a Money Changer License in Singapore

PAWFESSIONAL ELVA MAX.pdfAAAAAAAAAAAAAAAAAAA
PAWFESSIONAL ELVA MAX.pdfAAAAAAAAAAAAAAAAAAAPAWFESSIONAL ELVA MAX.pdfAAAAAAAAAAAAAAAAAAA
PAWFESSIONAL ELVA MAX.pdfAAAAAAAAAAAAAAAAAAA

Top Digital Marketing Strategy in 2024.pdf
Top Digital Marketing Strategy in 2024.pdfTop Digital Marketing Strategy in 2024.pdf
Top Digital Marketing Strategy in 2024.pdf

TALENT ACQUISITION AND MANAGEMENT LECTURE 2
TALENT ACQUISITION AND MANAGEMENT LECTURE 2TALENT ACQUISITION AND MANAGEMENT LECTURE 2
TALENT ACQUISITION AND MANAGEMENT LECTURE 2

1234567891011121314151617181920212223242
12345678910111213141516171819202122232421234567891011121314151617181920212223242
1234567891011121314151617181920212223242

Anton Grutzmache- Ominisient: The Data Revolution in Banking: From Scoring Cr...
Anton Grutzmache- Ominisient: The Data Revolution in Banking: From Scoring Cr...Anton Grutzmache- Ominisient: The Data Revolution in Banking: From Scoring Cr...
Anton Grutzmache- Ominisient: The Data Revolution in Banking: From Scoring Cr...

Mandated reporting powerpoint to help with understanding your role
Mandated reporting powerpoint to help with understanding your roleMandated reporting powerpoint to help with understanding your role
Mandated reporting powerpoint to help with understanding your role

Cheslyn Jacobs- TymeBank: Building Consumer Trust in Digital Banking
Cheslyn Jacobs- TymeBank: Building Consumer Trust in Digital  BankingCheslyn Jacobs- TymeBank: Building Consumer Trust in Digital  Banking
Cheslyn Jacobs- TymeBank: Building Consumer Trust in Digital Banking

BBA Final SML 501 INTERNATIONAL BUSINESS .pdf
BBA Final SML 501 INTERNATIONAL BUSINESS .pdfBBA Final SML 501 INTERNATIONAL BUSINESS .pdf
BBA Final SML 501 INTERNATIONAL BUSINESS .pdf

Growth Buyouts - The Dawn of the GBO (Slow Ventures)
Growth Buyouts - The  Dawn of the GBO (Slow Ventures)Growth Buyouts - The  Dawn of the GBO (Slow Ventures)
Growth Buyouts - The Dawn of the GBO (Slow Ventures)

THE IMPORTANCE OF CODING IN DEVOPS EXPLANATION
THE IMPORTANCE OF CODING IN DEVOPS EXPLANATIONTHE IMPORTANCE OF CODING IN DEVOPS EXPLANATION
THE IMPORTANCE OF CODING IN DEVOPS EXPLANATION

NewBase 05 July 2024 Energy News issue - 1736 by Khaled Al Awadi_compresse...
NewBase   05 July 2024  Energy News issue - 1736 by Khaled Al Awadi_compresse...NewBase   05 July 2024  Energy News issue - 1736 by Khaled Al Awadi_compresse...
NewBase 05 July 2024 Energy News issue - 1736 by Khaled Al Awadi_compresse...

High Profile Girls Call Bhubaneswar 🎈🔥000XX00000 🔥💋🎈 Provide Best And Top Gir...
High Profile Girls Call Bhubaneswar 🎈🔥000XX00000 🔥💋🎈 Provide Best And Top Gir...High Profile Girls Call Bhubaneswar 🎈🔥000XX00000 🔥💋🎈 Provide Best And Top Gir...
High Profile Girls Call Bhubaneswar 🎈🔥000XX00000 🔥💋🎈 Provide Best And Top Gir...

A Complete Guide of Dubai Freelance Visa and Permit in 2024
A Complete Guide of Dubai Freelance Visa and Permit in 2024A Complete Guide of Dubai Freelance Visa and Permit in 2024
A Complete Guide of Dubai Freelance Visa and Permit in 2024

PETAVIT SIP-05.pdfAAAAAAAAAAAAAAAAAAAAAAAAA
PETAVIT SIP-05.pdfAAAAAAAAAAAAAAAAAAAAAAAAAPETAVIT SIP-05.pdfAAAAAAAAAAAAAAAAAAAAAAAAA
PETAVIT SIP-05.pdfAAAAAAAAAAAAAAAAAAAAAAAAA

United Kingdom's Real Estate Mogul: Newman George Leech's Impact on the Swiss...
United Kingdom's Real Estate Mogul: Newman George Leech's Impact on the Swiss...United Kingdom's Real Estate Mogul: Newman George Leech's Impact on the Swiss...
United Kingdom's Real Estate Mogul: Newman George Leech's Impact on the Swiss...

Kaizen Event Guide

  • 1. Guide for Planning & Conducting a Kaizen Event © Operational Excellence Consulting. All rights reserved.
  • 2. Contents • Introduction • Phase 1: Pre-event Preparation • Phase 2: The Kaizen Event • Phase 3: Post-event Follow Up © Operational Excellence Consulting. All rights reserved. 3
  • 3. What is Kaizen? • The Japanese word “Kaizen” (改 善) means change (KAI) to become good (ZEN). Kai Zen 改 善 Change Good © Operational Excellence Consulting. All rights reserved. 5
  • 4. 10 Rules of Kaizen 1 1. Discard conventional rigid thinking about production. 2. Think of how to do it, not why it cannot be done. 3. Do not make excuses. Start by questioning current practices. 4. Do not seek perfection. Do it right away if for only 50% of target. 5. Correct mistakes at once. © Operational Excellence Consulting. All rights reserved. 7
  • 5. What is the Purpose of Kaizen? • Kaizen activities focus on each process in order to add value and eliminate waste © Operational Excellence Consulting. All rights reserved. 9
  • 6. Types of Waste Intellect Not using employees full intellectual contribution Over-processing Adding excess value when the customer does not require it Over-production Producing more than what the customer needs Waiting Employees waiting for another process or information Motion Extra physical/mental motion that doesn‟t add value Waste Defects Reprocessing, or correcting work Inventory Building and storing extra services/products the customer has not ordered Transportation Moving from one place to another © Operational Excellence Consulting. All rights reserved. 11
  • 7. Benefits of Kaizen & Kaizen Events • Empowers employees, enriches the work experience and brings out the best in every person • Promotes personal growth of employees and the company • Improves quality, safety, cost structures, delivery, environments, throughput and customer service/satisfaction • Provides guidance from employees, and serves as a barometer for leadership © Operational Excellence Consulting. All rights reserved. 13
  • 8. Select an Area • Choose an area that will have an impact but not pose too many difficult problems in the beginning • Each event will teach you things that will make the next event smoother and easier to run • As people gain experience in running events, it will become possible to tackle more complicated problems • Develop a selection criteria to select the best event to start first © Operational Excellence Consulting. All rights reserved. 15
  • 9. Select a Problem for Improvement • What to avoid with initial projects  Out of control processes  Unreliable equipment  Incapable equipment  Interdependent processes  Improvement is not seen as necessary  A process that may soon be obsolete © Operational Excellence Consulting. All rights reserved. 17
  • 10. Setting Goals • Set a limited number of improvement goals to be achieved during the event • Prioritize multiple objectives • Use S.M.A.R.T. criteria for goal setting:  S=Specific; M=Measurable; A=Achievable; R=Realistic; T=Timely • Goals should be challenging – requiring real creativity • Team should be involved in setting improvement targets • Objectives may not be completely met © Operational Excellence Consulting. All rights reserved. 19
  • 11. Team Leader Role • Pre-Kaizen  Review all pre-event information  Tour target area • During Kaizen  Review progress against objectives daily  Check status of team member activity. Update to-do list.  Keep everyone involved in specific improvement activities © Operational Excellence Consulting. All rights reserved. 21
  • 12. Select the Team Members • 4 to 10 people • From across all levels and functions impacted by the project • Include experts – if they have open minds • Include people with prior Kaizen experience • Include outsiders from unrelated functions to obtain different points of view • Provide focused training to the team before the event © Operational Excellence Consulting. All rights reserved. 23
  • 13. Facilities and Logistics • Work Areas  Notify people of upcoming Kaizen and purpose  Floor/equipment layout – obtain/create a schematic • Training / Meeting Rooms  Reserve room  Flipcharts, overhead projector, Post-it® notes, etc. • Food and Refreshments • Location for Celebration © Operational Excellence Consulting. All rights reserved. 25
  • 14. Collecting Information  Pre-Event baseline data:  Lead Time, Touch Time, Cycle Time, Percentages, etc.  Number of people in the process  Product/Service Demand by Type, by Shift; Customer Demand (Takt Time)  Quality Defects, Rework Loops, Inspection Points  Cycle time by Product/Service  Space Requirements, Distances Traveled; Before Pictures  Safety Issues; Future Plans; Past Failures at a Similar Effort © Operational Excellence Consulting. All rights reserved. 27
  • 15. Conference Room or Gemba? • Important to “go to the gemba”  “Gemba”: where the process actually occurs • Kaizen can happen right on the factory floor or information can be gathered at the process • Conference room can be used for analysis and discussion • Don‟t be afraid of going back to the gemba to challenge and test ideas © Operational Excellence Consulting. All rights reserved. 29
  • 16. Pre-Event Communications • Communication from Leadership should:  Explain to employees what a Kaizen Event is and why it is needed  Explain how it supports Lean initiatives  Focus on long-term improvement rather than shortterm disruption  Discuss safety and ergonomic concerns  Set expectations for step change, not insignificant incremental improvement When people are familiar with the Event prior to its occurrence, they will be more receptive and productive during the Event © Operational Excellence Consulting. All rights reserved. 31
  • 17. Tips for Success (cont’d) • Guide but don‟t steer – allow divergent points of view • Do not under plan • Be sure you are clear on the expectations from the Event • Be sure each team member understands expectations from the Event • Understand the roles of team members, SMEs, Executive Sponsor, and yourself © Operational Excellence Consulting. All rights reserved. 33
  • 19. Two Weeks Before Event…  Finalize Team Membership  Should be personally invited by the Executive Sponsor/Team Leader  Define Event Schedule  What training modules should be used?  Develop Event agenda  Determine time and place for mid-week reports and final Report Out  Develop Team Charter  Get buy-in from Executive Sponsor  Approval from PMO (to prevent duplication/coordinate lessons learned)  Publish Charter & Agenda to all Event Team Members and PMO  Send out „Invitation to Event‟ email to each member and Sponsor  Reserve a room for the week and Final Report Out  Reserve overhead projector  Make food arrangements – Lunch and coffee breaks © Operational Excellence Consulting. All rights reserved. 37
  • 20. One Day Before Event…  Verify the room is setup properly for your Event… U-shaped works nicely  Verify meals and snacks are confirmed  Verify all supplies and equipment  Coordinate with the Executive Sponsor  Coordinate with the Team Leader  Dry Run the Agenda  Rehearse presentation and timing  Prepare notes  Print handouts, make copies  Prepare Attendance Sheet (one for each day)  Prepare Day 1 Agenda on flipchart  Post Good Meeting Practice guidelines on meeting room wall © Operational Excellence Consulting. All rights reserved. 39
  • 21. 3 THE KAIZEN EVENT © Operational Excellence Consulting. All rights reserved.
  • 22. Kaizen Event Process 1. Orientation 5. Report & Celebrate 4. Make the Improvements 2. Understand Current Situation 3. Develop Future State Design © Operational Excellence Consulting. All rights reserved. 43
  • 23. Kaizen Event Agenda* Day 1 – Orientation Morning • Welcome & Introductions • Set expectations • Provide focused training • Identify the Customer Day 2 – Understand current situation Day 3 – Develop future state design • Analyze current state • Future state design • Brainstorm ideas • Mid-week review • Root cause analysis • Prioritize solutions • Implement improvements Day 4 – Make the improvements • Implement improvements • Finalize future state • Try out or simulate new process • Complete training on standard work • Final presentation • Train participants • Future state design • Tweak design as needed • Define Kaizen Charter Lunch Afternoon Day 5 – Report & celebrate • Lunch & celebration • Implement improvements • Create and implement standard work • Root cause analysis • Try out or simulate new process • Measure future state • Prioritize solutions • Train participants • Establish current state • Calculate actual benefits • Future state design • Day 4 summary • Day 1 summary • Day 2 summary • Tweak design as needed • Day 3 summary • Set objective(s) for Day 5 • Document current state – process map or value stream map, identify waste (opportunities), data collection, etc. • Analyze current state • Set objective(s) for Day 2 • Brainstorm ideas • Set objective(s) for Day 3 • Set objective(s) for Day 4 © Operational Excellence Consulting. All rights reserved. * Adjust duration as required 45
  • 24. Day 1 – Orientation © Operational Excellence Consulting. All rights reserved.
  • 25. Orientation • Welcome and introduce the Kaizen team • Set expectations – what is the objective? • Provide focused training, e.g. Kaizen overview, VSM  Limit to half a day maximum • Identify the Customer – internal/external • Define the Kaizen charter © Operational Excellence Consulting. All rights reserved. 49
  • 26. Safety & Integrity • All event activities must be performed with your safety and the public safety in mind • Take the opportunity to correct hazards, even if not directly tied to the event • Process changes must not lower the quality of products/services • Consider ergonomics and focus on reducing waste when redesigning a job/process © Operational Excellence Consulting. All rights reserved. 51
  • 27. Team Orientation • Team member package • Review the process  Agenda • Clear, simple priorities  Background data • Goals and work requirements, hours, start time, daily meetings  Objectives  Rules and safety procedures • Deadlines, milestones  Kaizen Charter  Policies & Procedures • Avoiding conflicts • Roles for management © Operational Excellence Consulting. All rights reserved. 53
  • 28. Day 2 – Understand current situation © Operational Excellence Consulting. All rights reserved.
  • 29. Understand Current Situation • Crucial first step in process improvement • Deep understanding of the existing processes and dependencies • Identify all the activities currently involved in developing a new product • Observe the process first hand • Flowchart the process or define the value stream © Operational Excellence Consulting. All rights reserved. 57
  • 30. Flowchart • A flow chart is a graphical or symbolic representation of a process. • Each step in the process is represented by a different symbol and contains a short description of the process step. • The flow chart symbols are linked together with arrows showing the process flow direction. © Operational Excellence Consulting. All rights reserved. 59
  • 31. Identify VA, NVA-R, and NVA Activity Yes Adds Value to Customer? Necessary to Produce Output? No No Yes Yes Contributes to Business Effectiveness? No VA Customer Value Added Agree Specifications Manufacturing NVA-R Sustaining Payroll Testing Development Activity Back-up Database Changeovers Audits Regulatory © Operational Excellence Consulting. All rights reserved. NVA Non-Value Added Review & Approval Scrap Rework Filing Copying Reconciliation 61
  • 32. Identify Root Causes • Cause and Effect Diagrams • Why-why Analysis Causes Materials (or Information) Manpower Effect Machines (or Equipment) Output Environment Methods Measurement © Operational Excellence Consulting. All rights reserved. 63
  • 33. Kaizen Event Process 1. Orientation 5. Report & Celebrate 4. Make the Improvements 2. Understand Current Situation 3. Develop Future State Design © Operational Excellence Consulting. All rights reserved. 65
  • 34. Develop the Future State © Operational Excellence Consulting. All rights reserved. 67
  • 35. Day 4 – Make the improvements © Operational Excellence Consulting. All rights reserved.
  • 36. Implement the New Process • Plan  What specific changes need to occur  In what sequence  Resources needed – get commitment  Impact on existing activities and functions  Responsibilities • Communicate  Who, what, when • Implement  Execute the plan • Modify (as needed) © Operational Excellence Consulting. All rights reserved. 71
  • 37. Develop Implementation Plan • Will new skill sets be required, and how to achieve them? • Is the current organization structure sufficient? • Are there cultural issues? • Is there potential for “push back”? • Any implications for suppliers? • Implications for customers? • Implications for team members? • Do current technologies support the new process? Are they available and cost justifiable? • Technology is an enabler, not a solution. • Does the reward system support the new process? © Operational Excellence Consulting. All rights reserved. 73
  • 38. Standardize the Work Control Points for Stability Materials & Information Machines (equipment) Methods People Measurements Feed in materials & information Ship to customers Sloppy work = defective, off-standard products Standard © Operational Excellence Consulting. All rights reserved. 75
  • 39. Mistake-proof the Process • Mistake proof the process. • Take the magic out and make it into a repeatable science by eliminating the ability to make errors. Figure out which method applies, starting at the top. Best  Elimination  Replacement  Prevention  Facilitation  Detection  Mitigation © Operational Excellence Consulting. All rights reserved. 77
  • 40. Typical Results • 40 – 60% reduction of lead time • 10 – 15% productivity improvement • 10 – 20% reduction in rework • Improved communication between functions and departments • Clearly defined customer needs throughout the value stream • Improved customer satisfaction © Operational Excellence Consulting. All rights reserved. 79
  • 41. Day 5 – Report & celebrate © Operational Excellence Consulting. All rights reserved.
  • 42. The Final Presentation • Allow teams to document and publicize accomplishments • All team members should participate • Allow time during event to prepare (2-3 hours) • Invite sponsors • Invite employees from target areas as well adjacent areas • Invite audience to stay for celebration © Operational Excellence Consulting. All rights reserved. 83
  • 43. Celebration Guidelines • Involve senior leaders in celebration • Involve and recognize contributions of area employees not actually on the team • Recognize contribution of support functions • Involve team in celebration/recognition specifics • Recognition should be focused squarely on results achieved, not simply on having participated in an event © Operational Excellence Consulting. All rights reserved. 85
  • 44. Kaizen Event Post-Work • Follow up with Event Sponsor/Champion and Event Leaders:  Ensure implementation plan is being met  Ensure action plan is being executed  Ensure the team is touching base on progress • Teams should track progress against performance goals  Can be integrated into daily management activities  Meet monthly to assure changes are adhered to © Operational Excellence Consulting. All rights reserved. 87
  • 45. Kaizen Event Post-Work • Publish follow-up communication  Publish and circulate successes using Lean Team Room/Intranet  Send summary and thank-you package to all external participants  Give recognition to participants via the Lean Newsletter to:  Broadcast results and generate excitement  Communicate  Describe lessons learned best practices for deployment elsewhere © Operational Excellence Consulting. All rights reserved. 89
  • 46. END OF GUIDEBOOK For more information about our services, please visit www.oeconsulting.co m.sg © Operational Excellence Consulting. All rights reserved.
  • 47. A Kaizen Event Templates © Operational Excellence Consulting. All rights reserved.
  • 48. Kaizen Summary Project type: ________________ Area: _________________Team Leader: ______________ Before/current state After/future state Reasons project chosen: Results: Tools used on project: Next steps: © Operational Excellence Consulting. All rights reserved. 95
  • 49. Kaizen Status Update Kaizen Implemented Expected Results © Operational Excellence Consulting. All rights reserved. Actual Results 97
  • 50. Enter Kaizen title: Agenda © Operational Excellence Consulting. All rights reserved. 99
  • 51. Enter Kaizen title: Metrics & Data Collection Plan What is to be measured Who is responsible for gathering of data, and who is to receive data When Where © Operational Excellence Consulting. All rights reserved. How 101
  • 52. Enter Kaizen title: Layout: • Before • After © Operational Excellence Consulting. All rights reserved. 103
  • 53. Enter Kaizen title: Mistake proofing improvements • Problem • Solution © Operational Excellence Consulting. All rights reserved. 105
  • 54. Enter Kaizen title: Lessons learned • Lesson one • Lesson two • Lesson three © Operational Excellence Consulting. All rights reserved. 107
