SlideShare a Scribd company logo
1 of 54
Download to read offline
Immutable Infrastructure
Rethinking Configuration in the Age of Easy Redeployment
RackN, Inc
May, 2019
Note: Graphics mainly from http://pexels.com
<<< Shift Left <<<
https://u.rackn.io/interop2019
2
RackN, Inc. and Digital Rebar Provision
Your Presenter ….
Software for Dell “CloudEdge” Hyperscale Hardware effort
Learned many DevOps lessons in the field
then created first OpenStack installer: “Crowbar”
1) Operations is inconsistent, manual and heterogenous
2) Foundational automation makes many problems go away
3) “Apply, Rinse, Repeat” (aka Immutable Infrastructure)
Founding Member, Chief
Solutions Architect, and
Community Evangelist
Shane Gibson
3
RackN, Inc. and Digital Rebar Provision
Your Presenter ….
Software for Dell “CloudEdge” Hyperscale Hardware effort
Learned many DevOps lessons in the field
then created first OpenStack installer: “Crowbar”
1) Operations is inconsistent, manual and heterogenous
2) Foundational automation makes many problems go away
3) “Apply, Rinse, Repeat” (aka Immutable Infrastructure)
Founding Member, Chief
Solutions Architect, and
Community Evangelist
Shane Gibson
But … really, who cares?
Let's get to the fun stuff …
4
@rackngo #immutable
Storytime! “Self-Bootstrapping Kubernetes”
Kubecon in Nov 2017 we created this demo
Simple “immutable” Idea:
1) In Memory Boot Machines
2) Install Docker
3) Elect Leader
4) Run Kubeadm on Leader
5) Run Kubeadm on Remainder
But….it’s shockingly hard to maintain.
Dependencies breaks the installation
And they are constantly changing.
5
@rackngo #immutable
Storytime! “Self-Bootstrapping Kubernetes”
So, while it’s pretty cool,
it’s not “real” immutability
Presentation & Demo
https://youtu.be/OowxF6GqK4I
sad!
Why is configuration fragile?
Why is configuration fragile?
mutation
V
8
@rackngo #immutable
But… I 💜 Infrastructure as Code?!
Sorry. Mutability adds complexity
Traditional “build-in place” approaches
● Have hidden dependency graphs
● Create variation between environments
● Are harder to “lock down” due to config
AND OMG… updates and patches are even harder
● Idempotent operations are difficult
● Roll backward is next to impossible!
● Creating indeterminate state
9
@rackngo #immutable
Traditional “build-in place” approaches
● Have hidden dependency graphs
● Create variation between environments
● Are harder to “lock down” due to config
AND OMG… updates and patches are even harder
● Idempotent operations are difficult
● Roll backward is impossible
● Creating indeterminate state
But… I 💜 Infrastructure as code?!
Sorry. Mutability adds complexity
Let’s lock it down!
What is Immutable Infrastructure?
What is Immutable Infrastructure?
Pre-deploy configured
V
12
@rackngo #immutable
Traditional Deploy and Configure
System is configured in situ from
a least common denominator
baseline.
This can be “immutable-like”
under the right conditions.
We’ll come back to that...
Delivery Pipeline
Deployment
Code
Build
Integrate
Run
Configure
13
@rackngo #immutable

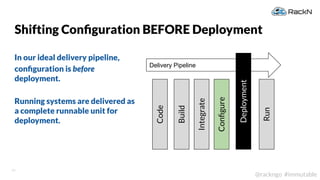

Shifting Configuration BEFORE Deployment
In our ideal delivery pipeline,
configuration is before
deployment.
Running systems are delivered as
a complete runnable unit for
deployment.
Delivery Pipeline
Deployment
Code
Build
Integrate
Run
Configure
14
@rackngo #immutable
Shifting Configuration BEFORE Deployment
In reality, it’s very hard to create a
distinct artifact for every running
instance; instead, we create
incremental versions.
So we do some initialization of the
reusable versioned instance.
Cloud init is the most commonly
known pattern for this.
Delivery Pipeline
Deployment
Code
Build
Integrate
Run
Configure
Initialize!
V
Cloud Native
Infrastructure
CNIbook.info
Justin Garrison & Kris Nova
“Infrastructure as software”
“Intent-Based Platform”
16
@rackngo #immutable

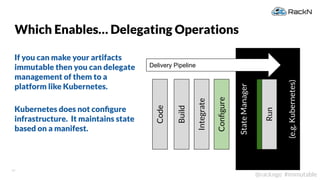

Which Enables… Delegating Operations
If you can make your artifacts
immutable then you can delegate
management of them to a
platform like Kubernetes.
Kubernetes does not configure
infrastructure. It maintains state
based on a manifest.
StateManager
(e.g.Kubernetes)
Code
Build
Integrate
Run
Configure
Delivery Pipeline
17
@rackngo #immutable
Which Enables… Delegating Operations
If you can make your artifacts
immutable then you can delegate
management of them to a
platform like Kubernetes.
Kubernetes does not configure
infrastructure. It maintains state
based on a manifest.
StateManager
(e.g.Kubernetes)
Code
Build
Integrate
Run
Configure
Delivery Pipeline
Kubernetes? WTF!
Is Immutable > K8s?
Immutable is a DevOps Pattern
<<< Shift Left & Create/Delete
19
@rackngo #immutable

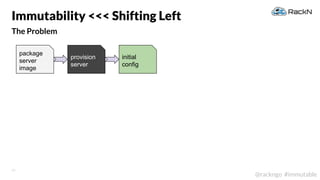

The Problem
Immutability <<< Shifting Left
package
server
provision
server
initial
config
20
@rackngo #immutable

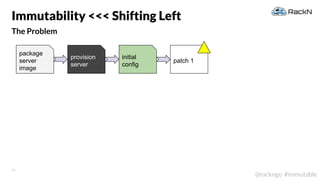

The Problem
Immutability <<< Shifting Left
patch 1
package
server
provision
server
initial
config
21
@rackngo #immutable
The Problem
Immutability <<< Shifting Left
patch 1 patch 2
package
server
provision
server
initial
config
22

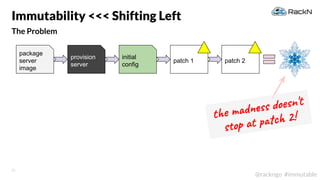

@rackngo #immutable
The Problem
Immutability <<< Shifting Left
patch 1 patch 2
the madness doesn't
stop at patch 2!
package
server
provision
server
initial
config
23

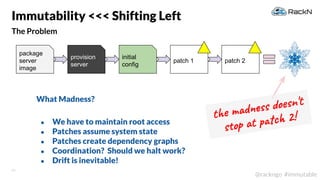

@rackngo #immutable
The Problem
Immutability <<< Shifting Left
patch 1 patch 2
the madness doesn't
stop at patch 2!
What Madness?
● We have to maintain root access
● Patches assume system state
● Patches create dependency graphs
● Coordination? Should we halt work?
● Drift is inevitable!
package
server
provision
server
initial
config
24
@rackngo #immutable
The Problem
Immutability <<< Shifting Left
patch 1 patch 2
SAD !!package
server
provision
server
initial
config
25

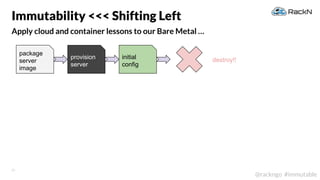

@rackngo #immutable
Apply cloud and container lessons to our Bare Metal …
Immutability <<< Shifting Left
package
server
provision
server
initial
config
destroy!!
26
@rackngo #immutable
Apply cloud and container lessons to our Bare Metal …
Immutability <<< Shifting Left
destroy!!
destroy!!patch 1
package
server
provision
server
initial
config
package
server
provision
server
initial
config
27

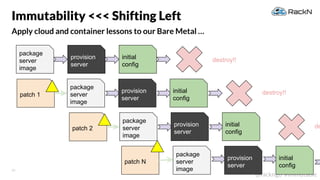

@rackngo #immutable
Apply cloud and container lessons to our Bare Metal …
Immutability <<< Shifting Left
destroy!!
destroy!!patch 1
depatch 2
package
server
provision
server
initial
config
package
server
provision
server
initial
config
package
server
provision
server
initial
config
28
@rackngo #immutable
Apply cloud and container lessons to our Bare Metal …
Immutability <<< Shifting Left
destroy!!
destroy!!patch 1
patch N
depatch 2
package
server
provision
server
initial
config
package
server
provision
server
initial
config
package
server
provision
server
initial
config
package
server
provision
server
initial
config
Cloud like behavior …
30
Immutable Provisioning systems
treat infrastructure as a black box

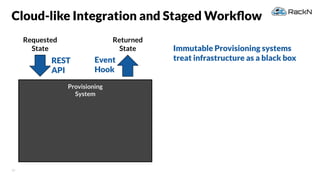

Cloud-like Integration and Staged Workflow
Provisioning
System
Requested
State
Returned
State
REST
API
Event
Hook

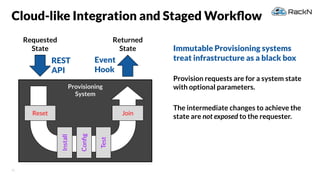

31
Cloud-like Integration and Staged Workflow
Immutable Provisioning systems
treat infrastructure as a black box
Provision requests are for a system state
with optional parameters.
The intermediate changes to achieve the
state are not exposed to the requester.
Provisioning
System
Reset Join
Install
Config
Test
Requested
State
Returned
State
REST
API
Event
Hook
32

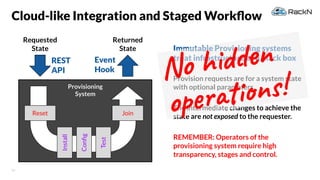

Cloud-like Integration and Staged Workflow
Immutable Provisioning systems
treat infrastructure as a black box
Provision requests are for a system state
with optional parameters.
The intermediate changes to achieve the
state are not exposed to the requester.
REMEMBER: Operators of the
provisioning system require high
transparency, stages and control.
Provisioning
System
Reset Join
Install
Config
Test
Requested
State
Returned
State
REST
API
Event
Hook
No hidden
operations!

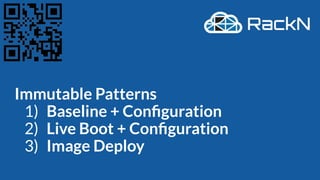

Immutable Patterns
1) Baseline + Configuration
2) Live Boot + Configuration
3) Image Deploy
34

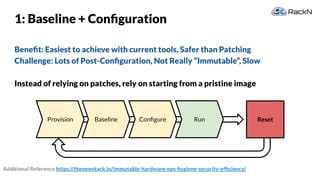

Provision
1: Baseline + Configuration
Benefit: Easiest to achieve with current tools, Safer than Patching
Challenge: Lots of Post-Configuration, Not Really “Immutable”, Slow
Instead of relying on patches, rely on starting from a pristine image
ResetBaseline Configure Run
Additional Reference https://thenewstack.io/immutable-hardware-ops-hygiene-security-efficiency/
35
Provision
1: Baseline + Configuration
Benefit: Easiest to achieve with current tools, Safer than Patching
Challenge: Lots of Post-Configuration, Not Really “Immutable”, Slow
Instead of relying on patches, rely on starting from a pristine image
ResetBaseline Configure Run
Additional Reference https://thenewstack.io/immutable-hardware-ops-hygiene-security-efficiency/
You must control ALL
of your dependency
chain !!!
36
Provision
1: Baseline + Configuration
Benefit: Easiest to achieve with current tools, Safer than Patching
Challenge: Lots of Post-Configuration, Not Really “Immutable”, Slow
Instead of relying on patches, rely on starting from a pristine image
ResetBaseline Configure Run
Additional Reference https://thenewstack.io/immutable-hardware-ops-hygiene-security-efficiency/
...every single (!!)
package from the
base OS on up ...
37

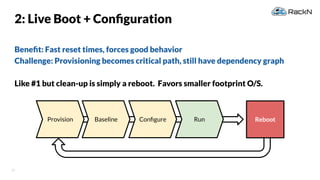

Benefit: Fast reset times, forces good behavior
Challenge: Provisioning becomes critical path, still have dependency graph
Like #1 but clean-up is simply a reboot. Favors smaller footprint O/S.
2: Live Boot + Configuration
Provision RebootBaseline Configure Run
38

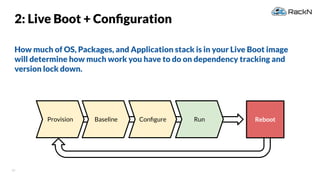

How much of OS, Packages, and Application stack is in your Live Boot image
will determine how much work you have to do on dependency tracking and
version lock down.
2: Live Boot + Configuration
Provision RebootBaseline Configure Run
39

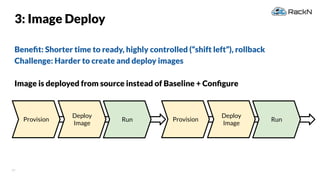

3: Image Deploy
Benefit: Shorter time to ready, highly controlled (“shift left”), rollback
Challenge: Harder to create and deploy images
Image is deployed from source instead of Baseline + Configure
Provision
Deploy
Run Provision
Deploy
Run
40
3: Image Deploy
Benefit: Shorter time to ready, highly controlled (“shift left”), rollback
Challenge: Harder to create and deploy images
Image is deployed from single artifact instead of Baseline + Configure
Provision
Deploy
Run Provision
Deploy
Run
Initialize!
V
Initialize!
V
41

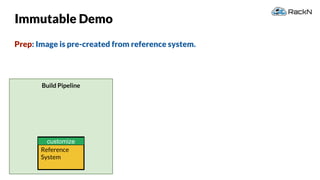

So… Let’s talk Image Creation
Ideally in an automation build process.
You DO THE CONFIGURATION on a
live system (so you still need
configuration tools) and then capture
the image into a portable format.
Tools like Hashicorp Packer, Image
Builder, WBIC or raw images are used
to create source files (e.g. Root FS
Tarball, Disk Image, AMI, OVS).
42
So… Let’s talk Image Creation
Ideally in an automation build process.
You DO THE CONFIGURATION on a
live system (so you still need
configuration tools) and then capture
the image into a portable format.
Tools like Hashicorp Packer, Image
Builder, WBIC or raw images are used
to create source files (e.g. Root FS
Tarball, Disk Image, AMI, OVS).
That sounds like a lot
of work & really slow!
Yes, But…
It’s faster, safer & more scalable.
44

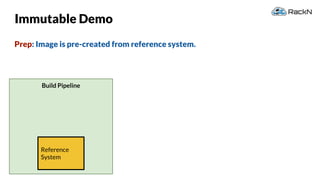

Build Pipeline
Immutable Demo
Prep: Image is pre-created from reference system.
Reference
System
45
Build Pipeline
Immutable Demo
Prep: Image is pre-created from reference system.
Reference
System
customize
46

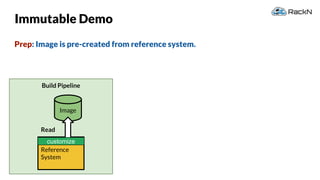

Build Pipeline
Immutable Demo
Prep: Image is pre-created from reference system.
Reference
System
Read
customize
47

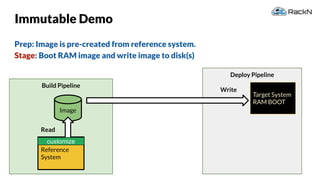

Deploy Pipeline
Build Pipeline
Immutable Demo
Prep: Image is pre-created from reference system.
Stage: Boot RAM image and write image to disk(s)
Reference
System
Target System
RAM BOOT
Write
Read
customize
48

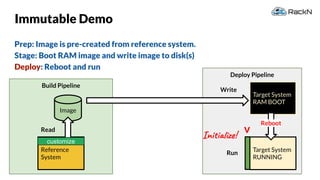

Deploy Pipeline
Build Pipeline
Immutable Demo
Prep: Image is pre-created from reference system.
Stage: Boot RAM image and write image to disk(s)
Deploy: Reboot and run
Reference
System
Target System
RAM BOOT
Target System
RUNNING
Write
Run
Read V
Reboot
Initialize!customize
49
Build Pipeline
Deploy Pipeline
Immutable Demo
Hopefully (!!): You're pushing your images through a
rigorous CI/CD pipeline before you Deploy !!
Reference
System
Read
customize
50
Build Pipeline
Deploy Pipeline
Immutable Demo
Hopefully (!!): You're pushing your images through a
rigorous CI/CD pipeline before you Deploy !!
Reference
System
Read
CI/CD Pipeline
TEST !!
51

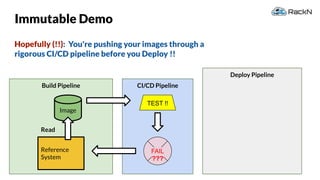

Build Pipeline
Deploy Pipeline
Immutable Demo
Hopefully (!!): You're pushing your images through a
rigorous CI/CD pipeline before you Deploy !!
Reference
System
Read
CI/CD Pipeline
TEST !!
FAIL
???
52

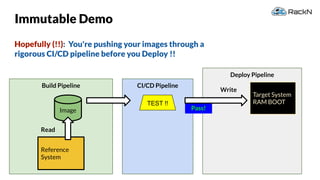

Build Pipeline
Deploy Pipeline
Immutable Demo
Hopefully (!!): You're pushing your images through a
rigorous CI/CD pipeline before you Deploy !!
Reference
System
Target System
RAM BOOT
Write
Read
CI/CD Pipeline
TEST !!
Pass!
53

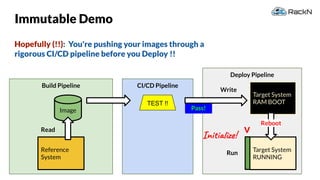

Build Pipeline
Deploy Pipeline
Immutable Demo
Hopefully (!!): You're pushing your images through a
rigorous CI/CD pipeline before you Deploy !!
Reference
System
Target System
RAM BOOT
Target System
RUNNING
Write
Run
Read V
Reboot
Initialize!
CI/CD Pipeline
TEST !!
Pass!
Thank you!
Questions?
Interested in IMMUTABLE METAL?
It’s complicated, but we can get you there.
Start at http://portal.rackn.io
• Quickstart takes about 30 minutes
• Use your own hardware, VirtualBox or Packet.net account
– use “RACKN100” on Packet.net for credit

More Related Content

What's hot

Code Reviews vs. Pull Requests
Code Reviews vs. Pull RequestsCode Reviews vs. Pull Requests
Code Reviews vs. Pull RequestsAtlassian

Continuous Delivery with Grails and CloudBees
Continuous Delivery with Grails and CloudBeesContinuous Delivery with Grails and CloudBees
Continuous Delivery with Grails and CloudBeesMarco Vermeulen

Puppet devops wdec
Puppet devops wdecPuppet devops wdec
Puppet devops wdecWojciech Dec

At Your Service: Using Jenkins in Operations
At Your Service: Using Jenkins in OperationsAt Your Service: Using Jenkins in Operations
At Your Service: Using Jenkins in OperationsMandi Walls

Spring Boot & Actuators
Spring Boot & ActuatorsSpring Boot & Actuators
Spring Boot & ActuatorsVMware Tanzu

Getting started with Jenkins
Getting started with JenkinsGetting started with Jenkins
Getting started with JenkinsEdureka!

Automated Deployment Pipeline using Jenkins, Puppet, Mcollective and AWS
Automated Deployment Pipeline using Jenkins, Puppet, Mcollective and AWSAutomated Deployment Pipeline using Jenkins, Puppet, Mcollective and AWS
Automated Deployment Pipeline using Jenkins, Puppet, Mcollective and AWSBamdad Dashtban

Microservices: What's Missing - O'Reilly Software Architecture New York
Microservices: What's Missing - O'Reilly Software Architecture New YorkMicroservices: What's Missing - O'Reilly Software Architecture New York
Microservices: What's Missing - O'Reilly Software Architecture New YorkAdrian Cockcroft

From ci to cd - LavaJug 2012
From ci to cd  - LavaJug 2012From ci to cd  - LavaJug 2012
From ci to cd - LavaJug 2012Henri Gomez

Choosing the Right Framework for Running Docker Containers in Prod
Choosing the Right Framework for Running Docker Containers in ProdChoosing the Right Framework for Running Docker Containers in Prod
Choosing the Right Framework for Running Docker Containers in ProdJosh Padnick

Tap into the power of slaves with Jenkins by Kohsuke Kawaguchi
Tap into the power of slaves with Jenkins by Kohsuke KawaguchiTap into the power of slaves with Jenkins by Kohsuke Kawaguchi
Tap into the power of slaves with Jenkins by Kohsuke KawaguchiZeroTurnaround

Spring - CDI Interop
Spring - CDI InteropSpring - CDI Interop
Spring - CDI InteropRay Ploski

How To Be a Java Automated Testing Superstar
How To Be a Java Automated Testing SuperstarHow To Be a Java Automated Testing Superstar
How To Be a Java Automated Testing SuperstarVMware Tanzu

Build, Publish, Deploy and Test Docker images and containers with Jenkins Wor...
Build, Publish, Deploy and Test Docker images and containers with Jenkins Wor...Build, Publish, Deploy and Test Docker images and containers with Jenkins Wor...
Build, Publish, Deploy and Test Docker images and containers with Jenkins Wor...Docker, Inc.

Database version control DPC version
Database version control DPC versionDatabase version control DPC version
Database version control DPC versionHarrie Verveer

Making the most of your gradle build - vJUG24 2017
Making the most of your gradle build - vJUG24 2017Making the most of your gradle build - vJUG24 2017
Making the most of your gradle build - vJUG24 2017Andres Almiray

Making the most of your gradle build - BaselOne 2017
Making the most of your gradle build - BaselOne 2017Making the most of your gradle build - BaselOne 2017
Making the most of your gradle build - BaselOne 2017Andres Almiray

Production Grade Kubernetes Applications
Production Grade Kubernetes ApplicationsProduction Grade Kubernetes Applications
Production Grade Kubernetes ApplicationsNarayanan Krishnamurthy

What's hot (20)

Akka Made Our Day
Akka Made Our DayAkka Made Our Day
Akka Made Our Day

Code Reviews vs. Pull Requests
Code Reviews vs. Pull RequestsCode Reviews vs. Pull Requests
Code Reviews vs. Pull Requests

Continuous Delivery with Grails and CloudBees
Continuous Delivery with Grails and CloudBeesContinuous Delivery with Grails and CloudBees
Continuous Delivery with Grails and CloudBees

Puppet devops wdec
Puppet devops wdecPuppet devops wdec
Puppet devops wdec

At Your Service: Using Jenkins in Operations
At Your Service: Using Jenkins in OperationsAt Your Service: Using Jenkins in Operations
At Your Service: Using Jenkins in Operations

Spring Boot & Actuators
Spring Boot & ActuatorsSpring Boot & Actuators
Spring Boot & Actuators

Getting started with Jenkins
Getting started with JenkinsGetting started with Jenkins
Getting started with Jenkins

Automated Deployment Pipeline using Jenkins, Puppet, Mcollective and AWS
Automated Deployment Pipeline using Jenkins, Puppet, Mcollective and AWSAutomated Deployment Pipeline using Jenkins, Puppet, Mcollective and AWS
Automated Deployment Pipeline using Jenkins, Puppet, Mcollective and AWS

Microservices: What's Missing - O'Reilly Software Architecture New York
Microservices: What's Missing - O'Reilly Software Architecture New YorkMicroservices: What's Missing - O'Reilly Software Architecture New York
Microservices: What's Missing - O'Reilly Software Architecture New York

From ci to cd - LavaJug 2012
From ci to cd  - LavaJug 2012From ci to cd  - LavaJug 2012
From ci to cd - LavaJug 2012

Choosing the Right Framework for Running Docker Containers in Prod
Choosing the Right Framework for Running Docker Containers in ProdChoosing the Right Framework for Running Docker Containers in Prod
Choosing the Right Framework for Running Docker Containers in Prod

Tap into the power of slaves with Jenkins by Kohsuke Kawaguchi
Tap into the power of slaves with Jenkins by Kohsuke KawaguchiTap into the power of slaves with Jenkins by Kohsuke Kawaguchi
Tap into the power of slaves with Jenkins by Kohsuke Kawaguchi

Spring - CDI Interop
Spring - CDI InteropSpring - CDI Interop
Spring - CDI Interop

How To Be a Java Automated Testing Superstar
How To Be a Java Automated Testing SuperstarHow To Be a Java Automated Testing Superstar
How To Be a Java Automated Testing Superstar

Build, Publish, Deploy and Test Docker images and containers with Jenkins Wor...
Build, Publish, Deploy and Test Docker images and containers with Jenkins Wor...Build, Publish, Deploy and Test Docker images and containers with Jenkins Wor...
Build, Publish, Deploy and Test Docker images and containers with Jenkins Wor...

Git Power Routines
Git Power RoutinesGit Power Routines
Git Power Routines

Database version control DPC version
Database version control DPC versionDatabase version control DPC version
Database version control DPC version

Making the most of your gradle build - vJUG24 2017
Making the most of your gradle build - vJUG24 2017Making the most of your gradle build - vJUG24 2017
Making the most of your gradle build - vJUG24 2017

Making the most of your gradle build - BaselOne 2017
Making the most of your gradle build - BaselOne 2017Making the most of your gradle build - BaselOne 2017
Making the most of your gradle build - BaselOne 2017

Production Grade Kubernetes Applications
Production Grade Kubernetes ApplicationsProduction Grade Kubernetes Applications
Production Grade Kubernetes Applications

Similar to Immutable Infrastructure & Rethinking Configuration - Interop 2019

SRECon 18 Immutable Infrastructure
SRECon 18 Immutable InfrastructureSRECon 18 Immutable Infrastructure
SRECon 18 Immutable InfrastructureRackN

#SREcon Immutable Infrastructure: rethinking configuration mgmt
#SREcon Immutable Infrastructure: rethinking configuration mgmt#SREcon Immutable Infrastructure: rethinking configuration mgmt
#SREcon Immutable Infrastructure: rethinking configuration mgmtrhirschfeld

The Ember.js Framework - Everything You Need To Know
The Ember.js Framework - Everything You Need To KnowThe Ember.js Framework - Everything You Need To Know
The Ember.js Framework - Everything You Need To KnowAll Things Open

Drupal Deployment
Drupal DeploymentDrupal Deployment
Drupal DeploymentJeff Eaton

Web Performance & Latest in React
Web Performance & Latest in ReactWeb Performance & Latest in React
Web Performance & Latest in ReactTalentica Software

Immutable Kubernetes with Digital Rebar Provision
Immutable Kubernetes with Digital Rebar ProvisionImmutable Kubernetes with Digital Rebar Provision
Immutable Kubernetes with Digital Rebar ProvisionRackN

Typesafe Reactive Platform: Monitoring 1.0, Commercial features and more
Typesafe Reactive Platform: Monitoring 1.0, Commercial features and moreTypesafe Reactive Platform: Monitoring 1.0, Commercial features and more
Typesafe Reactive Platform: Monitoring 1.0, Commercial features and moreLegacy Typesafe (now Lightbend)

[RHFSeoul2017]6 Steps to Transform Enterprise Applications
[RHFSeoul2017]6 Steps to Transform Enterprise Applications[RHFSeoul2017]6 Steps to Transform Enterprise Applications
[RHFSeoul2017]6 Steps to Transform Enterprise ApplicationsDaniel Oh

So. many. vulnerabilities. Why are containers such a mess and what to do abou...
So. many. vulnerabilities. Why are containers such a mess and what to do abou...So. many. vulnerabilities. Why are containers such a mess and what to do abou...
So. many. vulnerabilities. Why are containers such a mess and what to do abou...Eric Smalling

Test & Learn: Building & Deploying Resilient Products - How Feature Flags & O...
Test & Learn: Building & Deploying Resilient Products - How Feature Flags & O...Test & Learn: Building & Deploying Resilient Products - How Feature Flags & O...
Test & Learn: Building & Deploying Resilient Products - How Feature Flags & O...Optimizely

Puppet Camp Melbourne Nov 2014 - A Build Engineering Team’s Journey of Infras...
Puppet Camp Melbourne Nov 2014 - A Build Engineering Team’s Journey of Infras...Puppet Camp Melbourne Nov 2014 - A Build Engineering Team’s Journey of Infras...
Puppet Camp Melbourne Nov 2014 - A Build Engineering Team’s Journey of Infras...Peter Leschev

Clearly, I Have Made Some Bad Decisions
Clearly, I Have Made Some Bad DecisionsClearly, I Have Made Some Bad Decisions
Clearly, I Have Made Some Bad DecisionsJonathan Hitchcock

Continuous Delivery: The Dirty Details
Continuous Delivery: The Dirty DetailsContinuous Delivery: The Dirty Details
Continuous Delivery: The Dirty DetailsMike Brittain

Tracing Software Build Processes to Uncover License Compliance Inconsistencies
Tracing Software Build Processes to Uncover License Compliance InconsistenciesTracing Software Build Processes to Uncover License Compliance Inconsistencies
Tracing Software Build Processes to Uncover License Compliance InconsistenciesShane McIntosh

Docker presentasjon java bin
Docker presentasjon java binDocker presentasjon java bin
Docker presentasjon java binOlve Hansen

Lessons Learned in Software Development: QA Infrastructure – Maintaining Rob...
Lessons Learned in Software Development: QA Infrastructure – Maintaining Rob...Lessons Learned in Software Development: QA Infrastructure – Maintaining Rob...
Lessons Learned in Software Development: QA Infrastructure – Maintaining Rob...Cωνσtantίnoς Giannoulis

Virtualize and automate your development environment for fun and profit
Virtualize and automate your development environment for fun and profitVirtualize and automate your development environment for fun and profit
Virtualize and automate your development environment for fun and profitAndreas Heim

Pipeline as code for your infrastructure as Code
Pipeline as code for your infrastructure as CodePipeline as code for your infrastructure as Code
Pipeline as code for your infrastructure as CodeKris Buytaert

Subverting the monolith!
Subverting the monolith!Subverting the monolith!
Subverting the monolith!Sophia Russell

DevOps on AWS: Deep Dive on Continuous Delivery and the AWS Developer Tools
DevOps on AWS: Deep Dive on Continuous Delivery and the AWS Developer ToolsDevOps on AWS: Deep Dive on Continuous Delivery and the AWS Developer Tools
DevOps on AWS: Deep Dive on Continuous Delivery and the AWS Developer ToolsAmazon Web Services

Similar to Immutable Infrastructure & Rethinking Configuration - Interop 2019 (20)

SRECon 18 Immutable Infrastructure
SRECon 18 Immutable InfrastructureSRECon 18 Immutable Infrastructure
SRECon 18 Immutable Infrastructure

#SREcon Immutable Infrastructure: rethinking configuration mgmt
#SREcon Immutable Infrastructure: rethinking configuration mgmt#SREcon Immutable Infrastructure: rethinking configuration mgmt
#SREcon Immutable Infrastructure: rethinking configuration mgmt

The Ember.js Framework - Everything You Need To Know
The Ember.js Framework - Everything You Need To KnowThe Ember.js Framework - Everything You Need To Know
The Ember.js Framework - Everything You Need To Know

Drupal Deployment
Drupal DeploymentDrupal Deployment
Drupal Deployment

Web Performance & Latest in React
Web Performance & Latest in ReactWeb Performance & Latest in React
Web Performance & Latest in React

Immutable Kubernetes with Digital Rebar Provision
Immutable Kubernetes with Digital Rebar ProvisionImmutable Kubernetes with Digital Rebar Provision
Immutable Kubernetes with Digital Rebar Provision

Typesafe Reactive Platform: Monitoring 1.0, Commercial features and more
Typesafe Reactive Platform: Monitoring 1.0, Commercial features and moreTypesafe Reactive Platform: Monitoring 1.0, Commercial features and more
Typesafe Reactive Platform: Monitoring 1.0, Commercial features and more

[RHFSeoul2017]6 Steps to Transform Enterprise Applications
[RHFSeoul2017]6 Steps to Transform Enterprise Applications[RHFSeoul2017]6 Steps to Transform Enterprise Applications
[RHFSeoul2017]6 Steps to Transform Enterprise Applications

So. many. vulnerabilities. Why are containers such a mess and what to do abou...
So. many. vulnerabilities. Why are containers such a mess and what to do abou...So. many. vulnerabilities. Why are containers such a mess and what to do abou...
So. many. vulnerabilities. Why are containers such a mess and what to do abou...

Test & Learn: Building & Deploying Resilient Products - How Feature Flags & O...
Test & Learn: Building & Deploying Resilient Products - How Feature Flags & O...Test & Learn: Building & Deploying Resilient Products - How Feature Flags & O...
Test & Learn: Building & Deploying Resilient Products - How Feature Flags & O...

Puppet Camp Melbourne Nov 2014 - A Build Engineering Team’s Journey of Infras...
Puppet Camp Melbourne Nov 2014 - A Build Engineering Team’s Journey of Infras...Puppet Camp Melbourne Nov 2014 - A Build Engineering Team’s Journey of Infras...
Puppet Camp Melbourne Nov 2014 - A Build Engineering Team’s Journey of Infras...

Clearly, I Have Made Some Bad Decisions
Clearly, I Have Made Some Bad DecisionsClearly, I Have Made Some Bad Decisions
Clearly, I Have Made Some Bad Decisions

Continuous Delivery: The Dirty Details
Continuous Delivery: The Dirty DetailsContinuous Delivery: The Dirty Details
Continuous Delivery: The Dirty Details

Tracing Software Build Processes to Uncover License Compliance Inconsistencies
Tracing Software Build Processes to Uncover License Compliance InconsistenciesTracing Software Build Processes to Uncover License Compliance Inconsistencies
Tracing Software Build Processes to Uncover License Compliance Inconsistencies

Docker presentasjon java bin
Docker presentasjon java binDocker presentasjon java bin
Docker presentasjon java bin

Lessons Learned in Software Development: QA Infrastructure – Maintaining Rob...
Lessons Learned in Software Development: QA Infrastructure – Maintaining Rob...Lessons Learned in Software Development: QA Infrastructure – Maintaining Rob...
Lessons Learned in Software Development: QA Infrastructure – Maintaining Rob...

Virtualize and automate your development environment for fun and profit
Virtualize and automate your development environment for fun and profitVirtualize and automate your development environment for fun and profit
Virtualize and automate your development environment for fun and profit

Pipeline as code for your infrastructure as Code
Pipeline as code for your infrastructure as CodePipeline as code for your infrastructure as Code
Pipeline as code for your infrastructure as Code

Subverting the monolith!
Subverting the monolith!Subverting the monolith!
Subverting the monolith!

DevOps on AWS: Deep Dive on Continuous Delivery and the AWS Developer Tools
DevOps on AWS: Deep Dive on Continuous Delivery and the AWS Developer ToolsDevOps on AWS: Deep Dive on Continuous Delivery and the AWS Developer Tools
DevOps on AWS: Deep Dive on Continuous Delivery and the AWS Developer Tools

More from RackN

Digital Rebar Community Welcome Guide
Digital Rebar Community Welcome GuideDigital Rebar Community Welcome Guide
Digital Rebar Community Welcome GuideRackN

Immutable Deployment Hands-On Lab Interop ITX
Immutable Deployment Hands-On Lab Interop ITXImmutable Deployment Hands-On Lab Interop ITX
Immutable Deployment Hands-On Lab Interop ITXRackN

Composable Infrastructure Talk at Interop ITX 2018
Composable Infrastructure Talk at Interop ITX 2018Composable Infrastructure Talk at Interop ITX 2018
Composable Infrastructure Talk at Interop ITX 2018RackN

Immutable infrastructure & Rethinking Configuration
Immutable infrastructure & Rethinking ConfigurationImmutable infrastructure & Rethinking Configuration
Immutable infrastructure & Rethinking ConfigurationRackN

Immutable infrastructure & Rethinking Configuration
Immutable infrastructure & Rethinking ConfigurationImmutable infrastructure & Rethinking Configuration
Immutable infrastructure & Rethinking ConfigurationRackN

RackN Company Overview
RackN Company OverviewRackN Company Overview
RackN Company OverviewRackN

Operational Improvement Issues, Impacts and Solution from RackN
Operational Improvement Issues, Impacts and Solution from RackNOperational Improvement Issues, Impacts and Solution from RackN
Operational Improvement Issues, Impacts and Solution from RackNRackN

KubeCon 2017 Zero Touch Provision
KubeCon 2017 Zero Touch ProvisionKubeCon 2017 Zero Touch Provision
KubeCon 2017 Zero Touch ProvisionRackN

Data Center’s Last Mile: Zero Touch Metal Automation
Data Center’s Last Mile: Zero Touch Metal AutomationData Center’s Last Mile: Zero Touch Metal Automation
Data Center’s Last Mile: Zero Touch Metal AutomationRackN

DevOps vs SRE vs Cloud Native
DevOps vs SRE vs Cloud NativeDevOps vs SRE vs Cloud Native
DevOps vs SRE vs Cloud NativeRackN

More from RackN (10)

Digital Rebar Community Welcome Guide
Digital Rebar Community Welcome GuideDigital Rebar Community Welcome Guide
Digital Rebar Community Welcome Guide

Immutable Deployment Hands-On Lab Interop ITX
Immutable Deployment Hands-On Lab Interop ITXImmutable Deployment Hands-On Lab Interop ITX
Immutable Deployment Hands-On Lab Interop ITX

Composable Infrastructure Talk at Interop ITX 2018
Composable Infrastructure Talk at Interop ITX 2018Composable Infrastructure Talk at Interop ITX 2018
Composable Infrastructure Talk at Interop ITX 2018

Immutable infrastructure & Rethinking Configuration
Immutable infrastructure & Rethinking ConfigurationImmutable infrastructure & Rethinking Configuration
Immutable infrastructure & Rethinking Configuration

Immutable infrastructure & Rethinking Configuration
Immutable infrastructure & Rethinking ConfigurationImmutable infrastructure & Rethinking Configuration
Immutable infrastructure & Rethinking Configuration

RackN Company Overview
RackN Company OverviewRackN Company Overview
RackN Company Overview

Operational Improvement Issues, Impacts and Solution from RackN
Operational Improvement Issues, Impacts and Solution from RackNOperational Improvement Issues, Impacts and Solution from RackN
Operational Improvement Issues, Impacts and Solution from RackN

KubeCon 2017 Zero Touch Provision
KubeCon 2017 Zero Touch ProvisionKubeCon 2017 Zero Touch Provision
KubeCon 2017 Zero Touch Provision

Data Center’s Last Mile: Zero Touch Metal Automation
Data Center’s Last Mile: Zero Touch Metal AutomationData Center’s Last Mile: Zero Touch Metal Automation
Data Center’s Last Mile: Zero Touch Metal Automation

DevOps vs SRE vs Cloud Native
DevOps vs SRE vs Cloud NativeDevOps vs SRE vs Cloud Native
DevOps vs SRE vs Cloud Native

Recently uploaded

JavaScript Usage Statistics 2024 - The Ultimate Guide
JavaScript Usage Statistics 2024 - The Ultimate GuideJavaScript Usage Statistics 2024 - The Ultimate Guide
JavaScript Usage Statistics 2024 - The Ultimate GuidePixlogix Infotech

Hyatt driving innovation and exceptional customer experiences with FIDO passw...
Hyatt driving innovation and exceptional customer experiences with FIDO passw...Hyatt driving innovation and exceptional customer experiences with FIDO passw...
Hyatt driving innovation and exceptional customer experiences with FIDO passw...FIDO Alliance

How to Check GPS Location with a Live Tracker in Pakistan
How to Check GPS Location with a Live Tracker in PakistanHow to Check GPS Location with a Live Tracker in Pakistan
How to Check GPS Location with a Live Tracker in Pakistandanishmna97

Event-Driven Architecture Masterclass: Challenges in Stream Processing
Event-Driven Architecture Masterclass: Challenges in Stream ProcessingEvent-Driven Architecture Masterclass: Challenges in Stream Processing
Event-Driven Architecture Masterclass: Challenges in Stream ProcessingScyllaDB

Top 10 CodeIgniter Development Companies
Top 10 CodeIgniter Development CompaniesTop 10 CodeIgniter Development Companies
Top 10 CodeIgniter Development CompaniesTopCSSGallery

2024 May Patch Tuesday
2024 May Patch Tuesday2024 May Patch Tuesday
2024 May Patch TuesdayIvanti

AI mind or machine power point presentation
AI mind or machine power point presentationAI mind or machine power point presentation
AI mind or machine power point presentationyogeshlabana357357

State of the Smart Building Startup Landscape 2024!
State of the Smart Building Startup Landscape 2024!State of the Smart Building Startup Landscape 2024!
State of the Smart Building Startup Landscape 2024!Memoori

Human Expert Website Manual WCAG 2.0 2.1 2.2 Audit - Digital Accessibility Au...
Human Expert Website Manual WCAG 2.0 2.1 2.2 Audit - Digital Accessibility Au...Human Expert Website Manual WCAG 2.0 2.1 2.2 Audit - Digital Accessibility Au...
Human Expert Website Manual WCAG 2.0 2.1 2.2 Audit - Digital Accessibility Au...Skynet Technologies

Harnessing Passkeys in the Battle Against AI-Powered Cyber Threats.pptx
Harnessing Passkeys in the Battle Against AI-Powered Cyber Threats.pptxHarnessing Passkeys in the Battle Against AI-Powered Cyber Threats.pptx
Harnessing Passkeys in the Battle Against AI-Powered Cyber Threats.pptxFIDO Alliance

Continuing Bonds Through AI: A Hermeneutic Reflection on Thanabots
Continuing Bonds Through AI: A Hermeneutic Reflection on ThanabotsContinuing Bonds Through AI: A Hermeneutic Reflection on Thanabots
Continuing Bonds Through AI: A Hermeneutic Reflection on ThanabotsLeah Henrickson

Microsoft CSP Briefing Pre-Engagement - Questionnaire
Microsoft CSP Briefing Pre-Engagement - QuestionnaireMicrosoft CSP Briefing Pre-Engagement - Questionnaire
Microsoft CSP Briefing Pre-Engagement - QuestionnaireExakis Nelite

(Explainable) Data-Centric AI: what are you explaininhg, and to whom?
(Explainable) Data-Centric AI: what are you explaininhg, and to whom?(Explainable) Data-Centric AI: what are you explaininhg, and to whom?
(Explainable) Data-Centric AI: what are you explaininhg, and to whom?Paolo Missier

How we scaled to 80K users by doing nothing!.pdf
How we scaled to 80K users by doing nothing!.pdfHow we scaled to 80K users by doing nothing!.pdf
How we scaled to 80K users by doing nothing!.pdfSrushith Repakula

JohnPollard-hybrid-app-RailsConf2024.pptx
JohnPollard-hybrid-app-RailsConf2024.pptxJohnPollard-hybrid-app-RailsConf2024.pptx
JohnPollard-hybrid-app-RailsConf2024.pptxJohnPollard37

ChatGPT and Beyond - Elevating DevOps Productivity
ChatGPT and Beyond - Elevating DevOps ProductivityChatGPT and Beyond - Elevating DevOps Productivity
ChatGPT and Beyond - Elevating DevOps ProductivityVictorSzoltysek

UiPath manufacturing technology benefits and AI overview
UiPath manufacturing technology benefits and AI overviewUiPath manufacturing technology benefits and AI overview
UiPath manufacturing technology benefits and AI overviewDianaGray10

Navigating the Large Language Model choices_Ravi Daparthi
Navigating the Large Language Model choices_Ravi DaparthiNavigating the Large Language Model choices_Ravi Daparthi
Navigating the Large Language Model choices_Ravi DaparthiRaviKumarDaparthi

Frisco Automating Purchase Orders with MuleSoft IDP- May 10th, 2024.pptx.pdf
Frisco Automating Purchase Orders with MuleSoft IDP- May 10th, 2024.pptx.pdfFrisco Automating Purchase Orders with MuleSoft IDP- May 10th, 2024.pptx.pdf
Frisco Automating Purchase Orders with MuleSoft IDP- May 10th, 2024.pptx.pdfAnubhavMangla3

Recently uploaded (20)

JavaScript Usage Statistics 2024 - The Ultimate Guide
JavaScript Usage Statistics 2024 - The Ultimate GuideJavaScript Usage Statistics 2024 - The Ultimate Guide
JavaScript Usage Statistics 2024 - The Ultimate Guide

Hyatt driving innovation and exceptional customer experiences with FIDO passw...
Hyatt driving innovation and exceptional customer experiences with FIDO passw...Hyatt driving innovation and exceptional customer experiences with FIDO passw...
Hyatt driving innovation and exceptional customer experiences with FIDO passw...

How to Check GPS Location with a Live Tracker in Pakistan
How to Check GPS Location with a Live Tracker in PakistanHow to Check GPS Location with a Live Tracker in Pakistan
How to Check GPS Location with a Live Tracker in Pakistan

Event-Driven Architecture Masterclass: Challenges in Stream Processing
Event-Driven Architecture Masterclass: Challenges in Stream ProcessingEvent-Driven Architecture Masterclass: Challenges in Stream Processing
Event-Driven Architecture Masterclass: Challenges in Stream Processing

Top 10 CodeIgniter Development Companies
Top 10 CodeIgniter Development CompaniesTop 10 CodeIgniter Development Companies
Top 10 CodeIgniter Development Companies

2024 May Patch Tuesday
2024 May Patch Tuesday2024 May Patch Tuesday
2024 May Patch Tuesday

AI mind or machine power point presentation
AI mind or machine power point presentationAI mind or machine power point presentation
AI mind or machine power point presentation

State of the Smart Building Startup Landscape 2024!
State of the Smart Building Startup Landscape 2024!State of the Smart Building Startup Landscape 2024!
State of the Smart Building Startup Landscape 2024!

Human Expert Website Manual WCAG 2.0 2.1 2.2 Audit - Digital Accessibility Au...
Human Expert Website Manual WCAG 2.0 2.1 2.2 Audit - Digital Accessibility Au...Human Expert Website Manual WCAG 2.0 2.1 2.2 Audit - Digital Accessibility Au...
Human Expert Website Manual WCAG 2.0 2.1 2.2 Audit - Digital Accessibility Au...

Harnessing Passkeys in the Battle Against AI-Powered Cyber Threats.pptx
Harnessing Passkeys in the Battle Against AI-Powered Cyber Threats.pptxHarnessing Passkeys in the Battle Against AI-Powered Cyber Threats.pptx
Harnessing Passkeys in the Battle Against AI-Powered Cyber Threats.pptx

Continuing Bonds Through AI: A Hermeneutic Reflection on Thanabots
Continuing Bonds Through AI: A Hermeneutic Reflection on ThanabotsContinuing Bonds Through AI: A Hermeneutic Reflection on Thanabots
Continuing Bonds Through AI: A Hermeneutic Reflection on Thanabots

Microsoft CSP Briefing Pre-Engagement - Questionnaire
Microsoft CSP Briefing Pre-Engagement - QuestionnaireMicrosoft CSP Briefing Pre-Engagement - Questionnaire
Microsoft CSP Briefing Pre-Engagement - Questionnaire

(Explainable) Data-Centric AI: what are you explaininhg, and to whom?
(Explainable) Data-Centric AI: what are you explaininhg, and to whom?(Explainable) Data-Centric AI: what are you explaininhg, and to whom?
(Explainable) Data-Centric AI: what are you explaininhg, and to whom?

Overview of Hyperledger Foundation
Overview of Hyperledger FoundationOverview of Hyperledger Foundation
Overview of Hyperledger Foundation

How we scaled to 80K users by doing nothing!.pdf
How we scaled to 80K users by doing nothing!.pdfHow we scaled to 80K users by doing nothing!.pdf
How we scaled to 80K users by doing nothing!.pdf

JohnPollard-hybrid-app-RailsConf2024.pptx
JohnPollard-hybrid-app-RailsConf2024.pptxJohnPollard-hybrid-app-RailsConf2024.pptx
JohnPollard-hybrid-app-RailsConf2024.pptx

ChatGPT and Beyond - Elevating DevOps Productivity
ChatGPT and Beyond - Elevating DevOps ProductivityChatGPT and Beyond - Elevating DevOps Productivity
ChatGPT and Beyond - Elevating DevOps Productivity

UiPath manufacturing technology benefits and AI overview
UiPath manufacturing technology benefits and AI overviewUiPath manufacturing technology benefits and AI overview
UiPath manufacturing technology benefits and AI overview

Navigating the Large Language Model choices_Ravi Daparthi
Navigating the Large Language Model choices_Ravi DaparthiNavigating the Large Language Model choices_Ravi Daparthi
Navigating the Large Language Model choices_Ravi Daparthi

Frisco Automating Purchase Orders with MuleSoft IDP- May 10th, 2024.pptx.pdf
Frisco Automating Purchase Orders with MuleSoft IDP- May 10th, 2024.pptx.pdfFrisco Automating Purchase Orders with MuleSoft IDP- May 10th, 2024.pptx.pdf
Frisco Automating Purchase Orders with MuleSoft IDP- May 10th, 2024.pptx.pdf

Immutable Infrastructure & Rethinking Configuration - Interop 2019

  • 1. Immutable Infrastructure Rethinking Configuration in the Age of Easy Redeployment RackN, Inc May, 2019 Note: Graphics mainly from http://pexels.com <<< Shift Left <<< https://u.rackn.io/interop2019
  • 2. 2 RackN, Inc. and Digital Rebar Provision Your Presenter …. Software for Dell “CloudEdge” Hyperscale Hardware effort Learned many DevOps lessons in the field then created first OpenStack installer: “Crowbar” 1) Operations is inconsistent, manual and heterogenous 2) Foundational automation makes many problems go away 3) “Apply, Rinse, Repeat” (aka Immutable Infrastructure) Founding Member, Chief Solutions Architect, and Community Evangelist Shane Gibson
  • 3. 3 RackN, Inc. and Digital Rebar Provision Your Presenter …. Software for Dell “CloudEdge” Hyperscale Hardware effort Learned many DevOps lessons in the field then created first OpenStack installer: “Crowbar” 1) Operations is inconsistent, manual and heterogenous 2) Foundational automation makes many problems go away 3) “Apply, Rinse, Repeat” (aka Immutable Infrastructure) Founding Member, Chief Solutions Architect, and Community Evangelist Shane Gibson But … really, who cares? Let's get to the fun stuff …
  • 4. 4 @rackngo #immutable Storytime! “Self-Bootstrapping Kubernetes” Kubecon in Nov 2017 we created this demo Simple “immutable” Idea: 1) In Memory Boot Machines 2) Install Docker 3) Elect Leader 4) Run Kubeadm on Leader 5) Run Kubeadm on Remainder But….it’s shockingly hard to maintain. Dependencies breaks the installation And they are constantly changing.
  • 5. 5 @rackngo #immutable Storytime! “Self-Bootstrapping Kubernetes” So, while it’s pretty cool, it’s not “real” immutability Presentation & Demo https://youtu.be/OowxF6GqK4I sad!
  • 7. Why is configuration fragile? mutation V
  • 8. 8 @rackngo #immutable But… I 💜 Infrastructure as Code?! Sorry. Mutability adds complexity Traditional “build-in place” approaches ● Have hidden dependency graphs ● Create variation between environments ● Are harder to “lock down” due to config AND OMG… updates and patches are even harder ● Idempotent operations are difficult ● Roll backward is next to impossible! ● Creating indeterminate state
  • 9. 9 @rackngo #immutable Traditional “build-in place” approaches ● Have hidden dependency graphs ● Create variation between environments ● Are harder to “lock down” due to config AND OMG… updates and patches are even harder ● Idempotent operations are difficult ● Roll backward is impossible ● Creating indeterminate state But… I 💜 Infrastructure as code?! Sorry. Mutability adds complexity Let’s lock it down!
  • 10. What is Immutable Infrastructure?
  • 11. What is Immutable Infrastructure? Pre-deploy configured V
  • 12. 12 @rackngo #immutable Traditional Deploy and Configure System is configured in situ from a least common denominator baseline. This can be “immutable-like” under the right conditions. We’ll come back to that... Delivery Pipeline Deployment Code Build Integrate Run Configure
  • 13. 13 @rackngo #immutable Shifting Configuration BEFORE Deployment In our ideal delivery pipeline, configuration is before deployment. Running systems are delivered as a complete runnable unit for deployment. Delivery Pipeline Deployment Code Build Integrate Run Configure
  • 14. 14 @rackngo #immutable Shifting Configuration BEFORE Deployment In reality, it’s very hard to create a distinct artifact for every running instance; instead, we create incremental versions. So we do some initialization of the reusable versioned instance. Cloud init is the most commonly known pattern for this. Delivery Pipeline Deployment Code Build Integrate Run Configure Initialize! V
  • 15. Cloud Native Infrastructure CNIbook.info Justin Garrison & Kris Nova “Infrastructure as software” “Intent-Based Platform”
  • 16. 16 @rackngo #immutable Which Enables… Delegating Operations If you can make your artifacts immutable then you can delegate management of them to a platform like Kubernetes. Kubernetes does not configure infrastructure. It maintains state based on a manifest. StateManager (e.g.Kubernetes) Code Build Integrate Run Configure Delivery Pipeline
  • 17. 17 @rackngo #immutable Which Enables… Delegating Operations If you can make your artifacts immutable then you can delegate management of them to a platform like Kubernetes. Kubernetes does not configure infrastructure. It maintains state based on a manifest. StateManager (e.g.Kubernetes) Code Build Integrate Run Configure Delivery Pipeline Kubernetes? WTF! Is Immutable > K8s?
  • 18. Immutable is a DevOps Pattern <<< Shift Left & Create/Delete
  • 19. 19 @rackngo #immutable The Problem Immutability <<< Shifting Left package server image provision server initial config
  • 20. 20 @rackngo #immutable The Problem Immutability <<< Shifting Left patch 1 package server image provision server initial config
  • 21. 21 @rackngo #immutable The Problem Immutability <<< Shifting Left patch 1 patch 2 package server image provision server initial config
  • 22. 22 @rackngo #immutable The Problem Immutability <<< Shifting Left patch 1 patch 2 the madness doesn't stop at patch 2! package server image provision server initial config
  • 23. 23 @rackngo #immutable The Problem Immutability <<< Shifting Left patch 1 patch 2 the madness doesn't stop at patch 2! What Madness? ● We have to maintain root access ● Patches assume system state ● Patches create dependency graphs ● Coordination? Should we halt work? ● Drift is inevitable! package server image provision server initial config
  • 24. 24 @rackngo #immutable The Problem Immutability <<< Shifting Left patch 1 patch 2 SAD !!package server image provision server initial config
  • 25. 25 @rackngo #immutable Apply cloud and container lessons to our Bare Metal … Immutability <<< Shifting Left package server image provision server initial config destroy!!
  • 26. 26 @rackngo #immutable Apply cloud and container lessons to our Bare Metal … Immutability <<< Shifting Left destroy!! destroy!!patch 1 package server image provision server initial config package server image provision server initial config
  • 27. 27 @rackngo #immutable Apply cloud and container lessons to our Bare Metal … Immutability <<< Shifting Left destroy!! destroy!!patch 1 depatch 2 package server image provision server initial config package server image provision server initial config package server image provision server initial config
  • 28. 28 @rackngo #immutable Apply cloud and container lessons to our Bare Metal … Immutability <<< Shifting Left destroy!! destroy!!patch 1 patch N depatch 2 package server image provision server initial config package server image provision server initial config package server image provision server initial config package server image provision server initial config
  • 30. 30 Immutable Provisioning systems treat infrastructure as a black box Cloud-like Integration and Staged Workflow Provisioning System Requested State Returned State REST API Event Hook
  • 31. 31 Cloud-like Integration and Staged Workflow Immutable Provisioning systems treat infrastructure as a black box Provision requests are for a system state with optional parameters. The intermediate changes to achieve the state are not exposed to the requester. Provisioning System Reset Join Install Config Test Requested State Returned State REST API Event Hook
  • 32. 32 Cloud-like Integration and Staged Workflow Immutable Provisioning systems treat infrastructure as a black box Provision requests are for a system state with optional parameters. The intermediate changes to achieve the state are not exposed to the requester. REMEMBER: Operators of the provisioning system require high transparency, stages and control. Provisioning System Reset Join Install Config Test Requested State Returned State REST API Event Hook No hidden operations!
  • 33. Immutable Patterns 1) Baseline + Configuration 2) Live Boot + Configuration 3) Image Deploy
  • 34. 34 Provision 1: Baseline + Configuration Benefit: Easiest to achieve with current tools, Safer than Patching Challenge: Lots of Post-Configuration, Not Really “Immutable”, Slow Instead of relying on patches, rely on starting from a pristine image ResetBaseline Configure Run Additional Reference https://thenewstack.io/immutable-hardware-ops-hygiene-security-efficiency/
  • 35. 35 Provision 1: Baseline + Configuration Benefit: Easiest to achieve with current tools, Safer than Patching Challenge: Lots of Post-Configuration, Not Really “Immutable”, Slow Instead of relying on patches, rely on starting from a pristine image ResetBaseline Configure Run Additional Reference https://thenewstack.io/immutable-hardware-ops-hygiene-security-efficiency/ You must control ALL of your dependency chain !!!
  • 36. 36 Provision 1: Baseline + Configuration Benefit: Easiest to achieve with current tools, Safer than Patching Challenge: Lots of Post-Configuration, Not Really “Immutable”, Slow Instead of relying on patches, rely on starting from a pristine image ResetBaseline Configure Run Additional Reference https://thenewstack.io/immutable-hardware-ops-hygiene-security-efficiency/ ...every single (!!) package from the base OS on up ...
  • 37. 37 Benefit: Fast reset times, forces good behavior Challenge: Provisioning becomes critical path, still have dependency graph Like #1 but clean-up is simply a reboot. Favors smaller footprint O/S. 2: Live Boot + Configuration Provision RebootBaseline Configure Run
  • 38. 38 How much of OS, Packages, and Application stack is in your Live Boot image will determine how much work you have to do on dependency tracking and version lock down. 2: Live Boot + Configuration Provision RebootBaseline Configure Run
  • 39. 39 3: Image Deploy Benefit: Shorter time to ready, highly controlled (“shift left”), rollback Challenge: Harder to create and deploy images Image is deployed from source instead of Baseline + Configure Provision Deploy Image Run Provision Deploy Image Run
  • 40. 40 3: Image Deploy Benefit: Shorter time to ready, highly controlled (“shift left”), rollback Challenge: Harder to create and deploy images Image is deployed from single artifact instead of Baseline + Configure Provision Deploy Image Run Provision Deploy Image Run Initialize! V Initialize! V
  • 41. 41 So… Let’s talk Image Creation Ideally in an automation build process. You DO THE CONFIGURATION on a live system (so you still need configuration tools) and then capture the image into a portable format. Tools like Hashicorp Packer, Image Builder, WBIC or raw images are used to create source files (e.g. Root FS Tarball, Disk Image, AMI, OVS).
  • 42. 42 So… Let’s talk Image Creation Ideally in an automation build process. You DO THE CONFIGURATION on a live system (so you still need configuration tools) and then capture the image into a portable format. Tools like Hashicorp Packer, Image Builder, WBIC or raw images are used to create source files (e.g. Root FS Tarball, Disk Image, AMI, OVS). That sounds like a lot of work & really slow!
  • 43. Yes, But… It’s faster, safer & more scalable.
  • 44. 44 Build Pipeline Immutable Demo Prep: Image is pre-created from reference system. Reference System
  • 45. 45 Build Pipeline Immutable Demo Prep: Image is pre-created from reference system. Reference System customize
  • 46. 46 Build Pipeline Immutable Demo Prep: Image is pre-created from reference system. Reference System Image Read customize
  • 47. 47 Deploy Pipeline Build Pipeline Immutable Demo Prep: Image is pre-created from reference system. Stage: Boot RAM image and write image to disk(s) Reference System Image Target System RAM BOOT Write Read customize
  • 48. 48 Deploy Pipeline Build Pipeline Immutable Demo Prep: Image is pre-created from reference system. Stage: Boot RAM image and write image to disk(s) Deploy: Reboot and run Reference System Image Target System RAM BOOT Target System RUNNING Write Run Read V Reboot Initialize!customize
  • 49. 49 Build Pipeline Deploy Pipeline Immutable Demo Hopefully (!!): You're pushing your images through a rigorous CI/CD pipeline before you Deploy !! Reference System Image Read customize
  • 50. 50 Build Pipeline Deploy Pipeline Immutable Demo Hopefully (!!): You're pushing your images through a rigorous CI/CD pipeline before you Deploy !! Reference System Image Read CI/CD Pipeline TEST !!
  • 51. 51 Build Pipeline Deploy Pipeline Immutable Demo Hopefully (!!): You're pushing your images through a rigorous CI/CD pipeline before you Deploy !! Reference System Image Read CI/CD Pipeline TEST !! FAIL ???
  • 52. 52 Build Pipeline Deploy Pipeline Immutable Demo Hopefully (!!): You're pushing your images through a rigorous CI/CD pipeline before you Deploy !! Reference System Image Target System RAM BOOT Write Read CI/CD Pipeline TEST !! Pass!
  • 53. 53 Build Pipeline Deploy Pipeline Immutable Demo Hopefully (!!): You're pushing your images through a rigorous CI/CD pipeline before you Deploy !! Reference System Image Target System RAM BOOT Target System RUNNING Write Run Read V Reboot Initialize! CI/CD Pipeline TEST !! Pass!
  • 54. Thank you! Questions? Interested in IMMUTABLE METAL? It’s complicated, but we can get you there. Start at http://portal.rackn.io • Quickstart takes about 30 minutes • Use your own hardware, VirtualBox or Packet.net account – use “RACKN100” on Packet.net for credit
