How to not
shoot
yourself in
the foot with
estimation
neil_killickNeil Killick, 2017, All Rights Reserved
neil_killickNeil Killick, 2017, All Rights Reserved

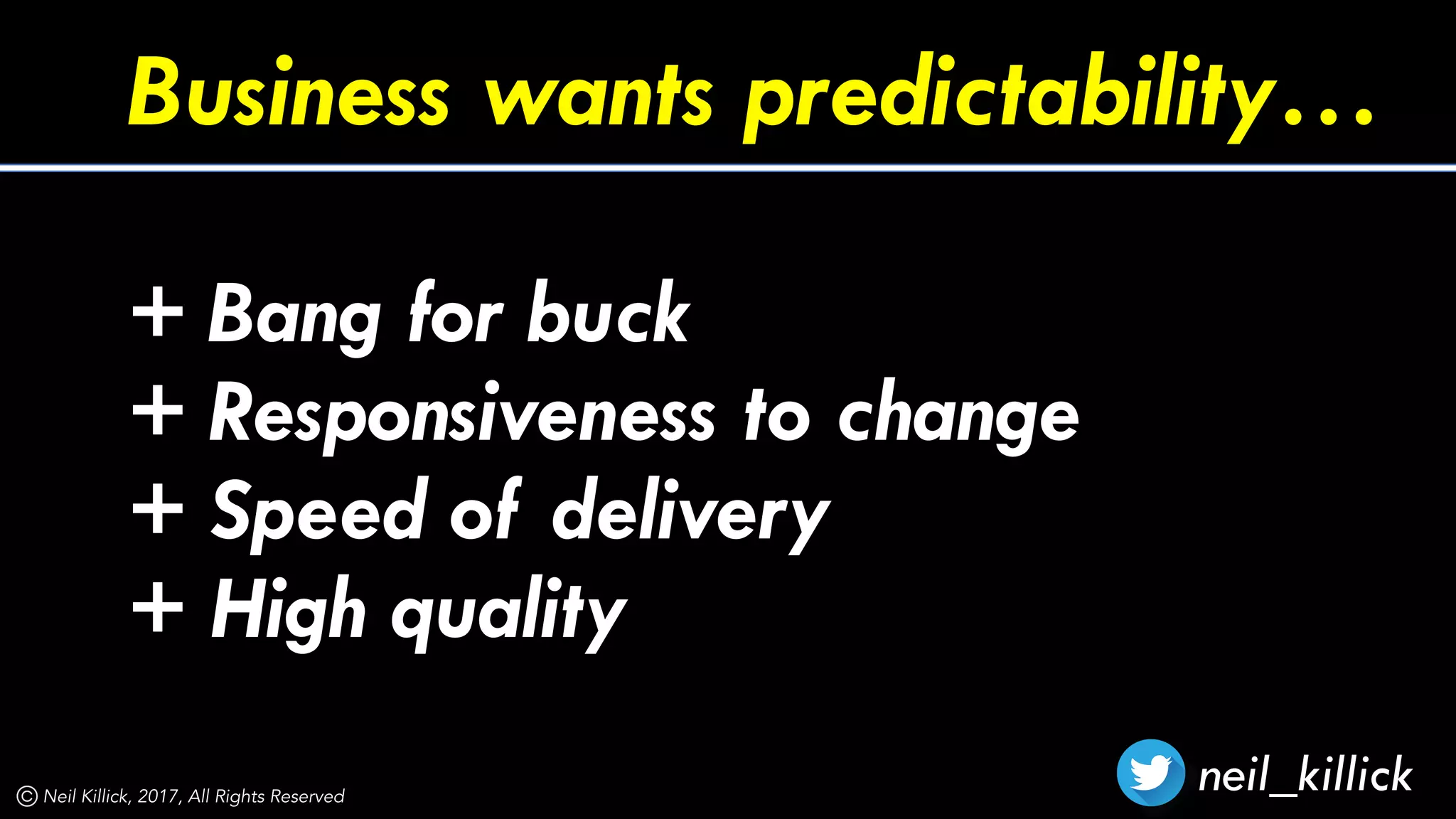

Business wants predictability…
+ Bang for buck
+ Responsiveness to change
+ Speed of delivery
+ High quality
Neil Killick, 2017, All Rights Reserved

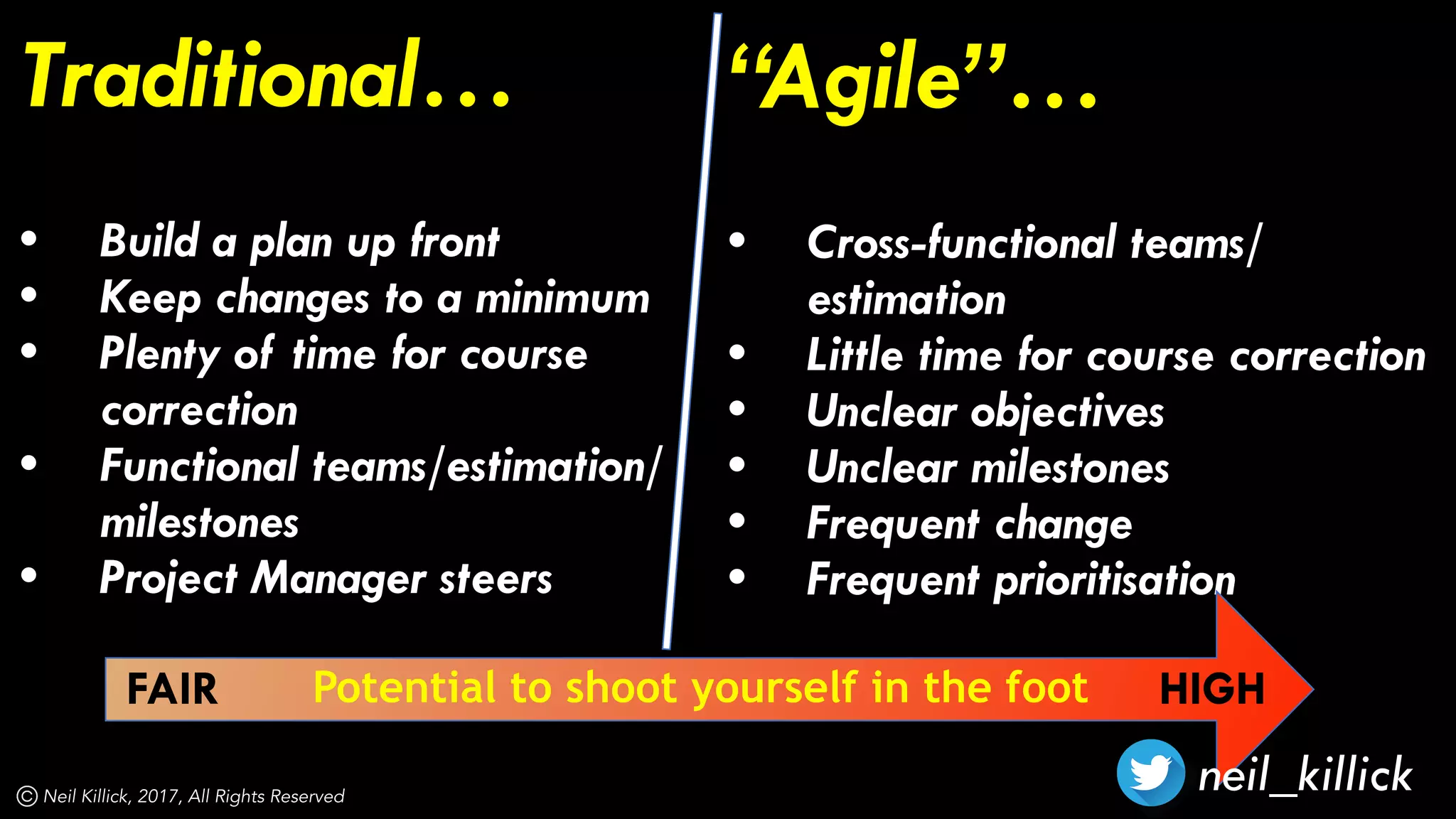

Traditional…
• Build a plan up front
• Keep changes to a minimum
• Plenty of time for course
correction
• Functional teams/estimation/
milestones
• Project Manager steers
“Agile”…
• Cross-functional teams/
estimation
• Little time for course correction
• Unclear objectives
• Unclear milestones
• Frequent change
• Frequent prioritisation
Potential to shoot yourself in the footFAIR HIGH
neil_killick
neil_killickNeil Killick, 2017, All Rights Reserved

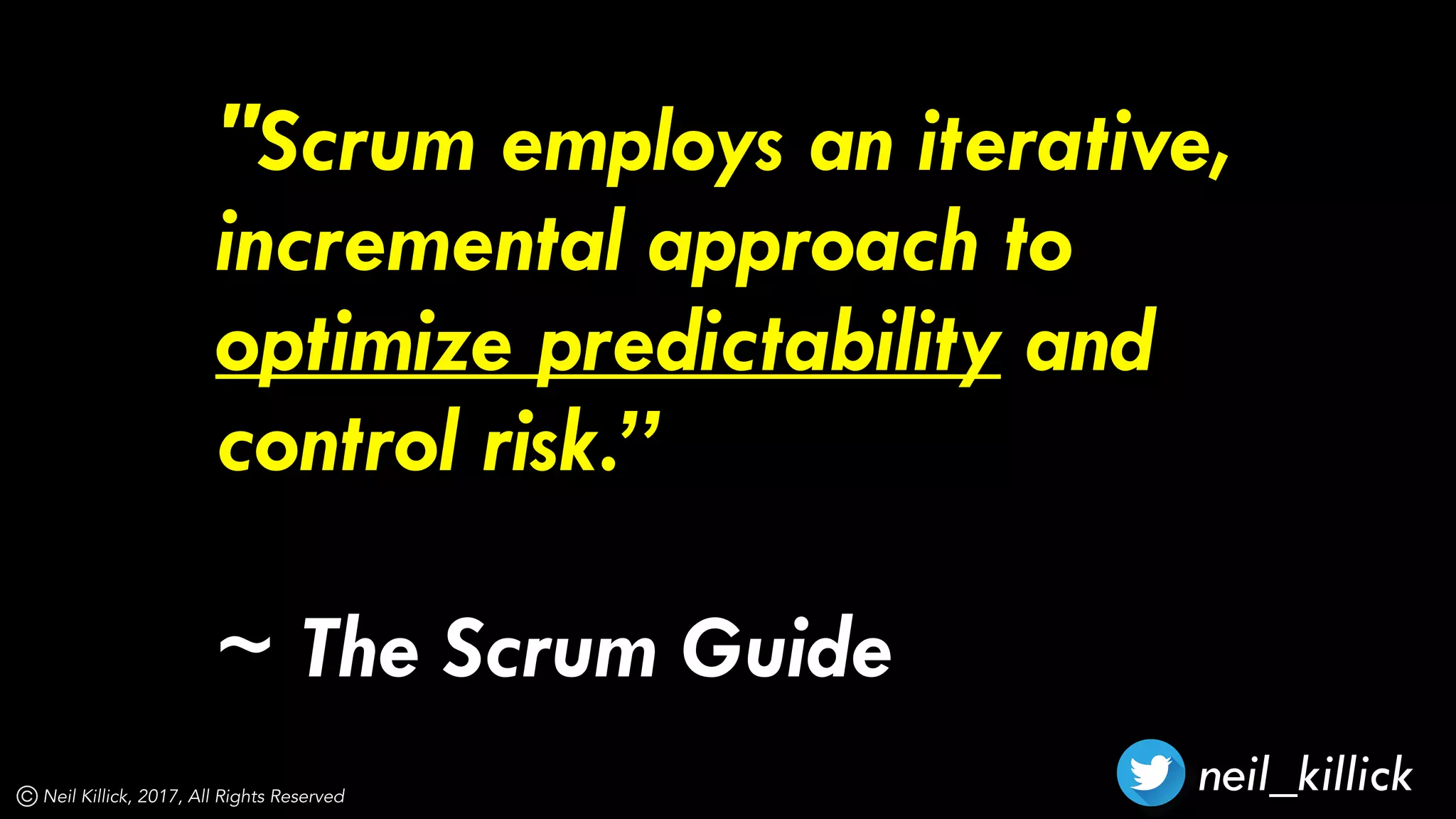

"Scrum employs an iterative,
incremental approach to
optimize predictability and
control risk.”
~ The Scrum Guide
neil_killickNeil Killick, 2017, All Rights Reserved

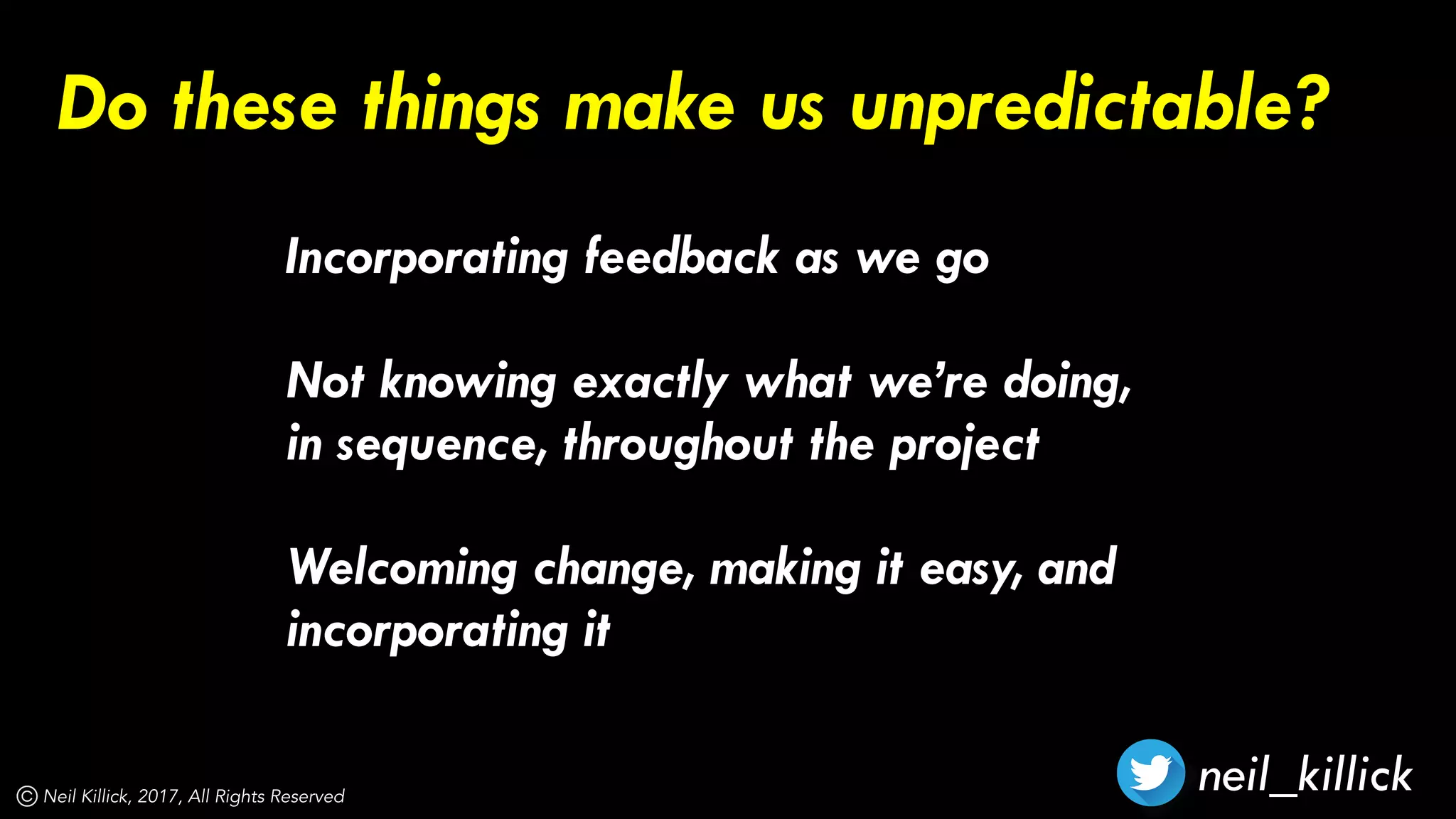

Incorporating feedback as we go

Not knowing exactly what we’re doing,
in sequence, throughout the project

Welcoming change, making it easy, and
incorporating it
Do these things make us unpredictable?
Empirical
predictability
Understand how long we have to
do what we need to do

Create/update the plan

Monitor progress through working
software and other metrics and
observations

neil_killickNeil Killick, 2017, All Rights Reserved

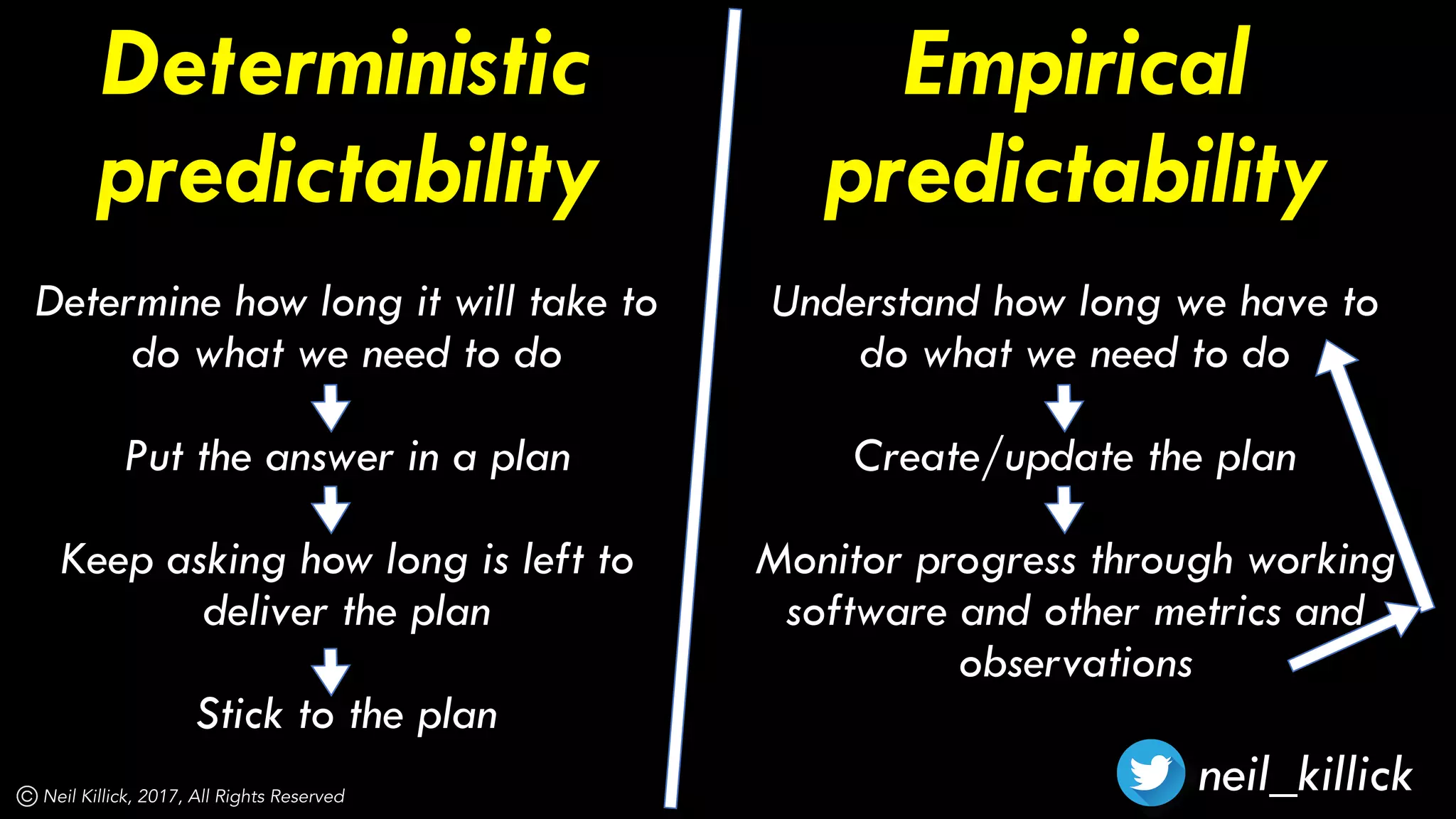

Deterministic
predictability
Determine how long it will take to
do what we need to do

Put the answer in a plan

Keep asking how long is left to
deliver the plan

Stick to the plan
neil_killickNeil Killick, 2017, All Rights Reserved
1
Become predictably
good at delivering
neil_killickNeil Killick, 2017, All Rights Reserved
Predictability is improved by behaving
and delivering more predictably, not
by making predictions
neil_killickNeil Killick, 2017, All Rights Reserved
2
Be transparent —
share your process and
your progress
10

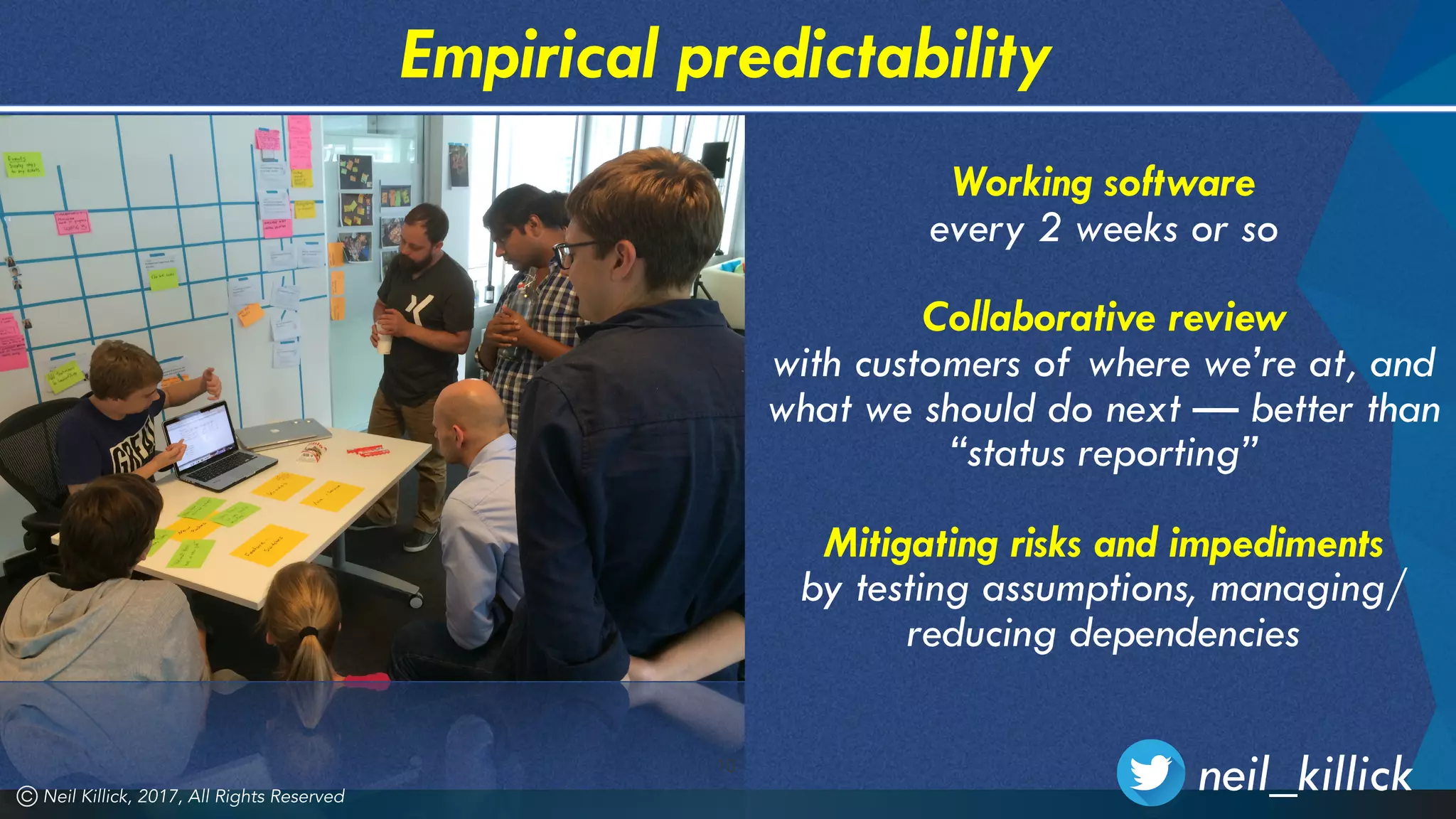

Empirical predictability
Working software
every 2 weeks or so

Collaborative review
with customers of where we’re at, and
what we should do next — better than
“status reporting”

Mitigating risks and impediments

by testing assumptions, managing/
reducing dependencies
Neil Killick, 2017, All Rights Reserved
neil_killick
neil_killickNeil Killick, 2017, All Rights Reserved
3
Find out what type of
estimate is required
neil_killickNeil Killick, 2017, All Rights Reserved
• What will we get, and when?

• Which is quicker/smaller, A or B? (for ROI purposes)

• When will we get X (feature)?

• How much will be done by Y (date)?

• Will X/everything be done by Y?

• Can we deliver X/everything for the time/money
available?

• Are you going to deliver maximum bang for buck?
Do you have a plan?
What are we
actually
estimating?
neil_killickNeil Killick, 2017, All Rights Reserved

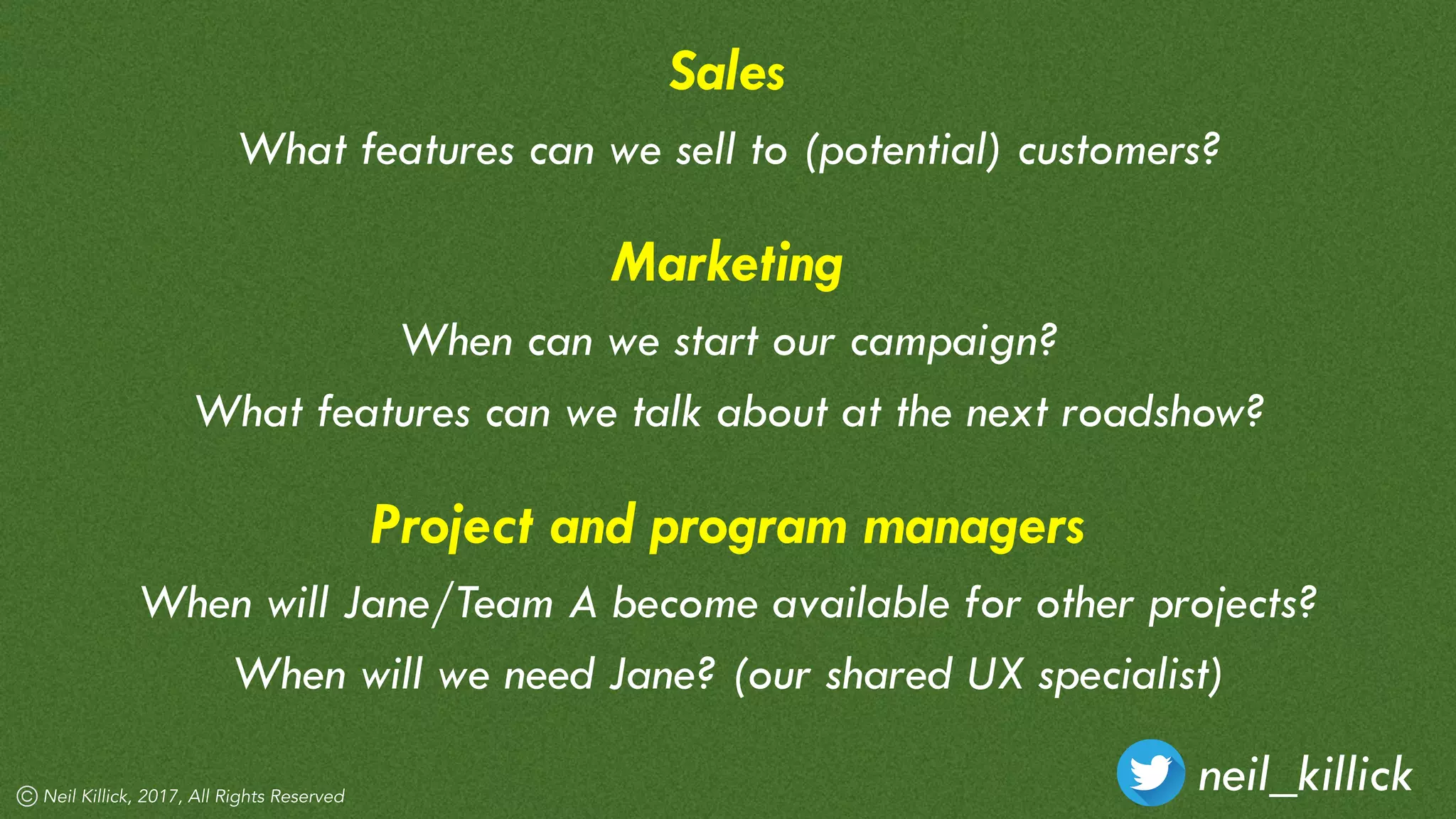

Sales
What features can we sell to (potential) customers?
Marketing
When can we start our campaign?
What features can we talk about at the next roadshow?
Project and program managers
When will Jane/Team A become available for other projects?
When will we need Jane? (our shared UX specialist)
neil_killickNeil Killick, 2017, All Rights Reserved
4
Incorporate appropriate
levels of uncertainty
neil_killickNeil Killick, 2017, All Rights Reserved

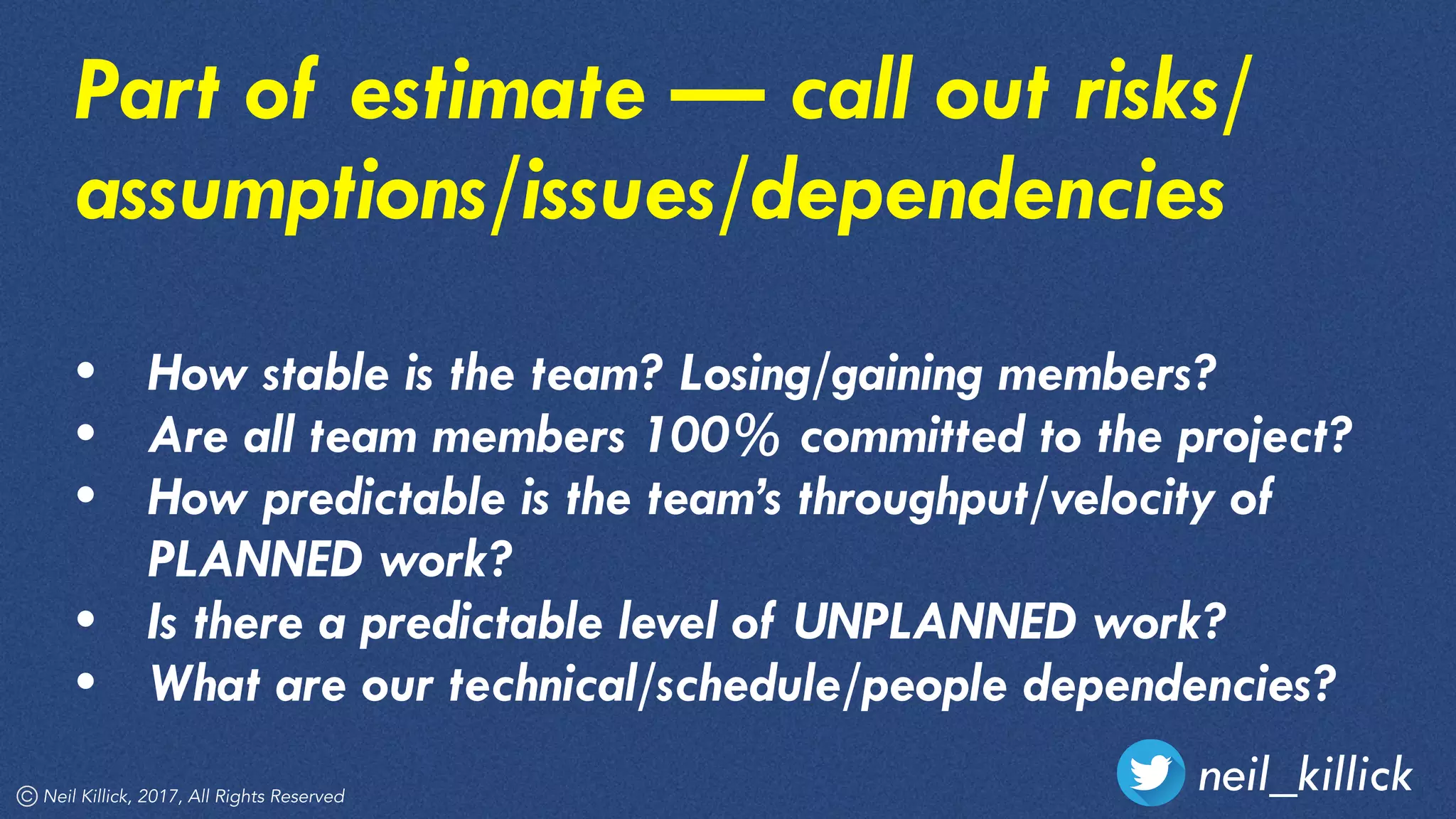

Part of estimate — call out risks/
assumptions/issues/dependencies
• How stable is the team? Losing/gaining members?
• Are all team members 100% committed to the project?
• How predictable is the team’s throughput/velocity of
PLANNED work?
• Is there a predictable level of UNPLANNED work?
• What are our technical/schedule/people dependencies?
neil_killickNeil Killick, 2017, All Rights Reserved

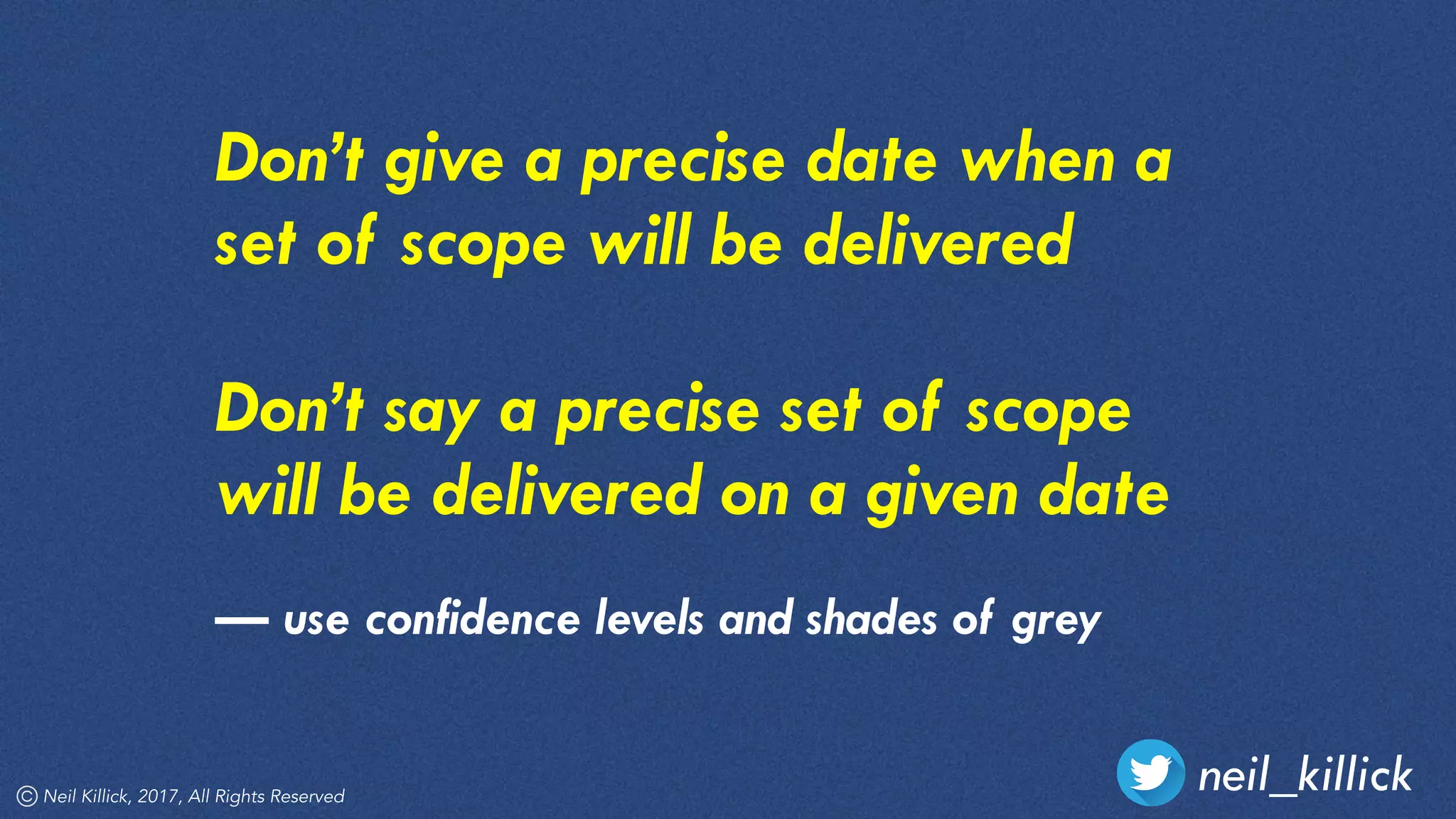

Don’t give a precise date when a
set of scope will be delivered
Don’t say a precise set of scope
will be delivered on a given date
— use confidence levels and shades of grey
neil_killickNeil Killick, 2017, All Rights Reserved
5
Take into account
poor/no prioritisation
— and agility
neil_killickNeil Killick, 2017, All Rights Reserved

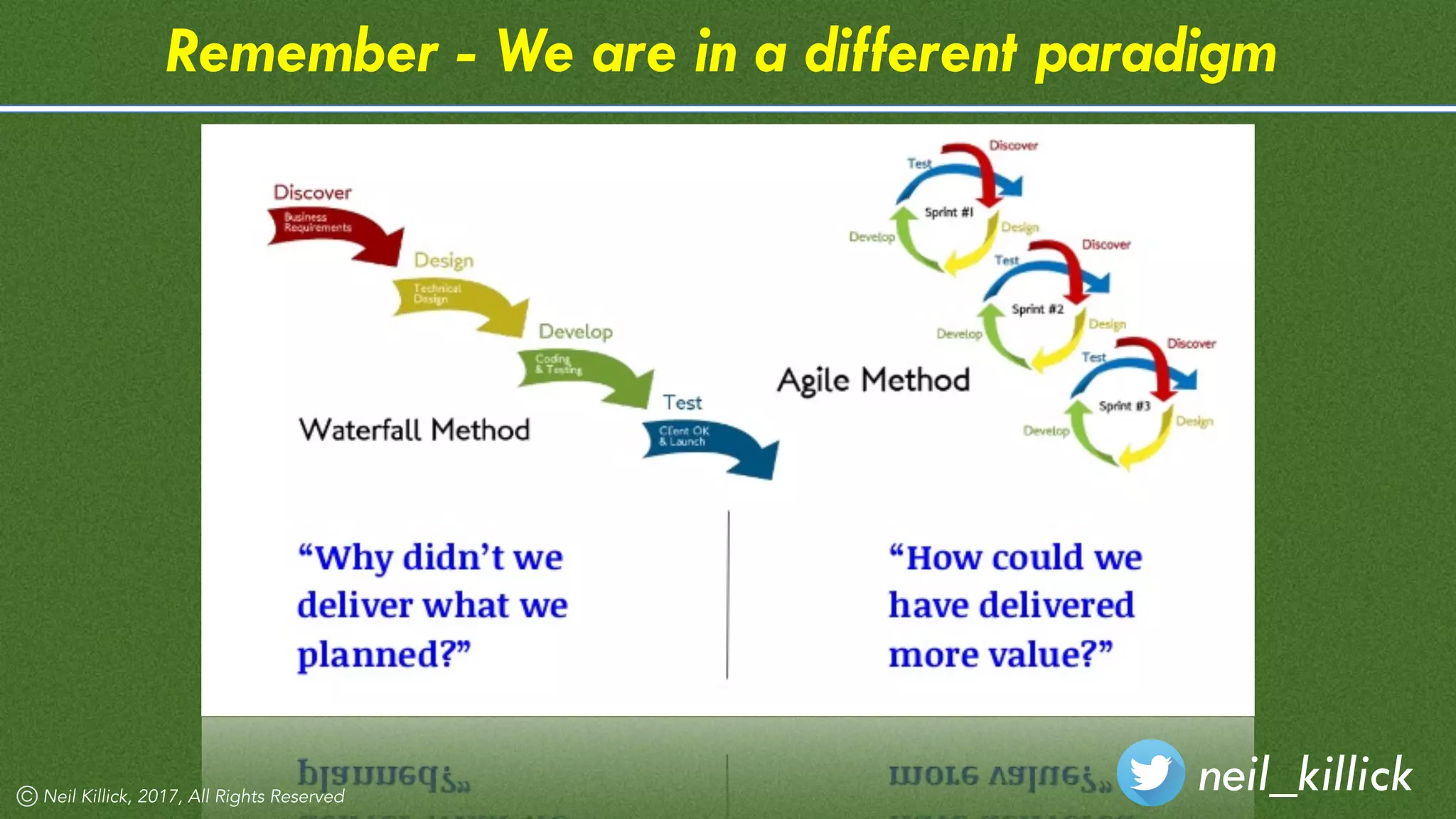

Remember - We are in a different paradigm
neil_killickNeil Killick, 2017, All Rights Reserved
6
Estimate options for
solving problems, not
specific solutions
neil_killickNeil Killick, 2017, All Rights Reserved
We control time rather than predict it
in iterative development
• Minimum effort to solve problem, then iterate

• Iterative/incremental is a different paradigm

• Let’s discuss this, and align expectations
neil_killickNeil Killick, 2017, All Rights Reserved
Problem
We need to be able to contact
dormant customers by email
Solution 1 (~6-8 weeks)
Build an automated customer email system,
integrated with MailChimp
Solution 2 (~2-3 days)
Send manual email with no integration
neil_killickNeil Killick, 2017, All Rights Reserved
7

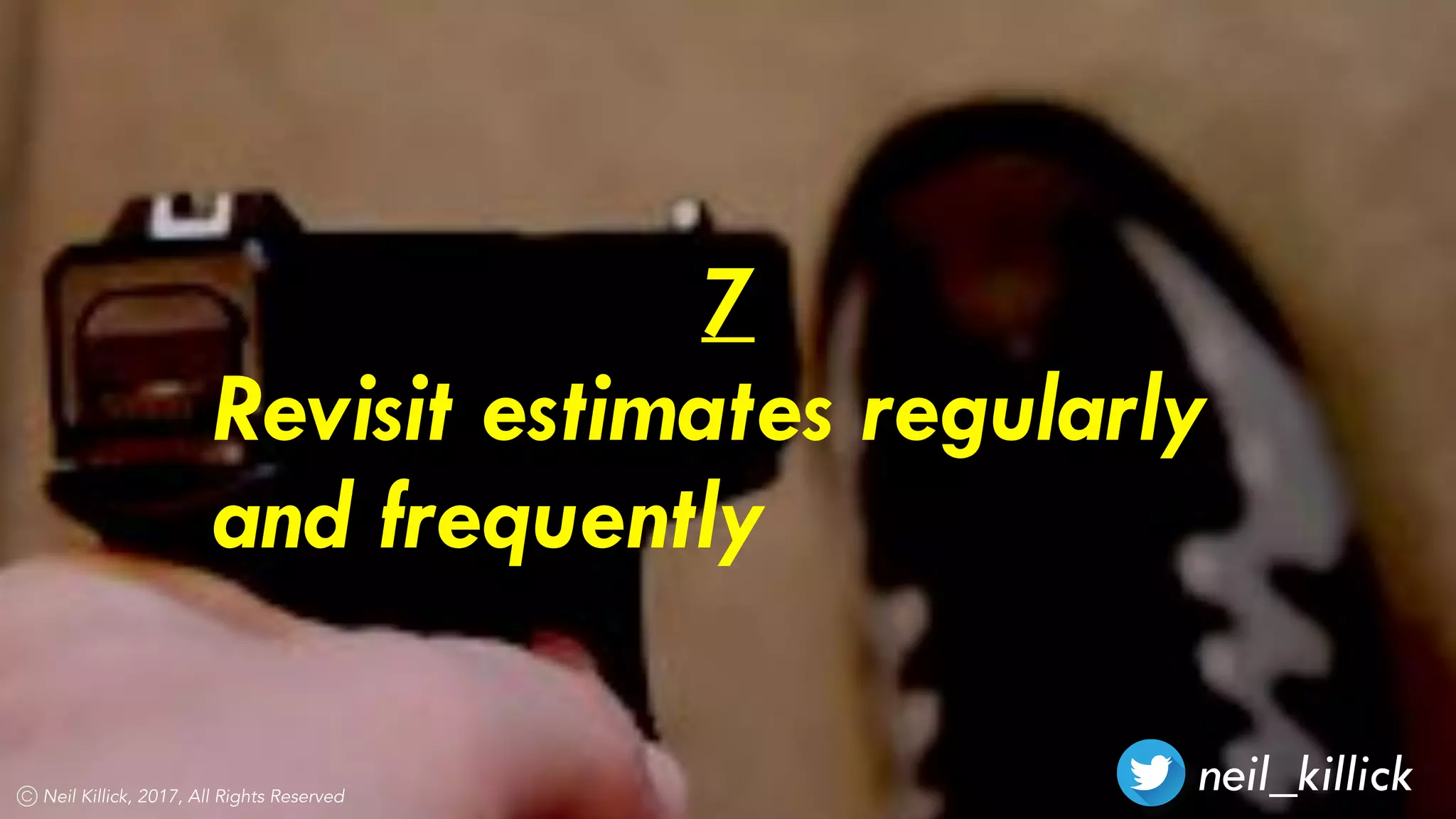

Revisit estimates regularly
and frequently
neil_killickNeil Killick, 2017, All Rights Reserved
8
Estimate cycle times,
not effort
neil_killickNeil Killick, 2017, All Rights Reserved
9
Use data
(yesterday’s weather)
Neil Killick, 2017, All Rights Reserved

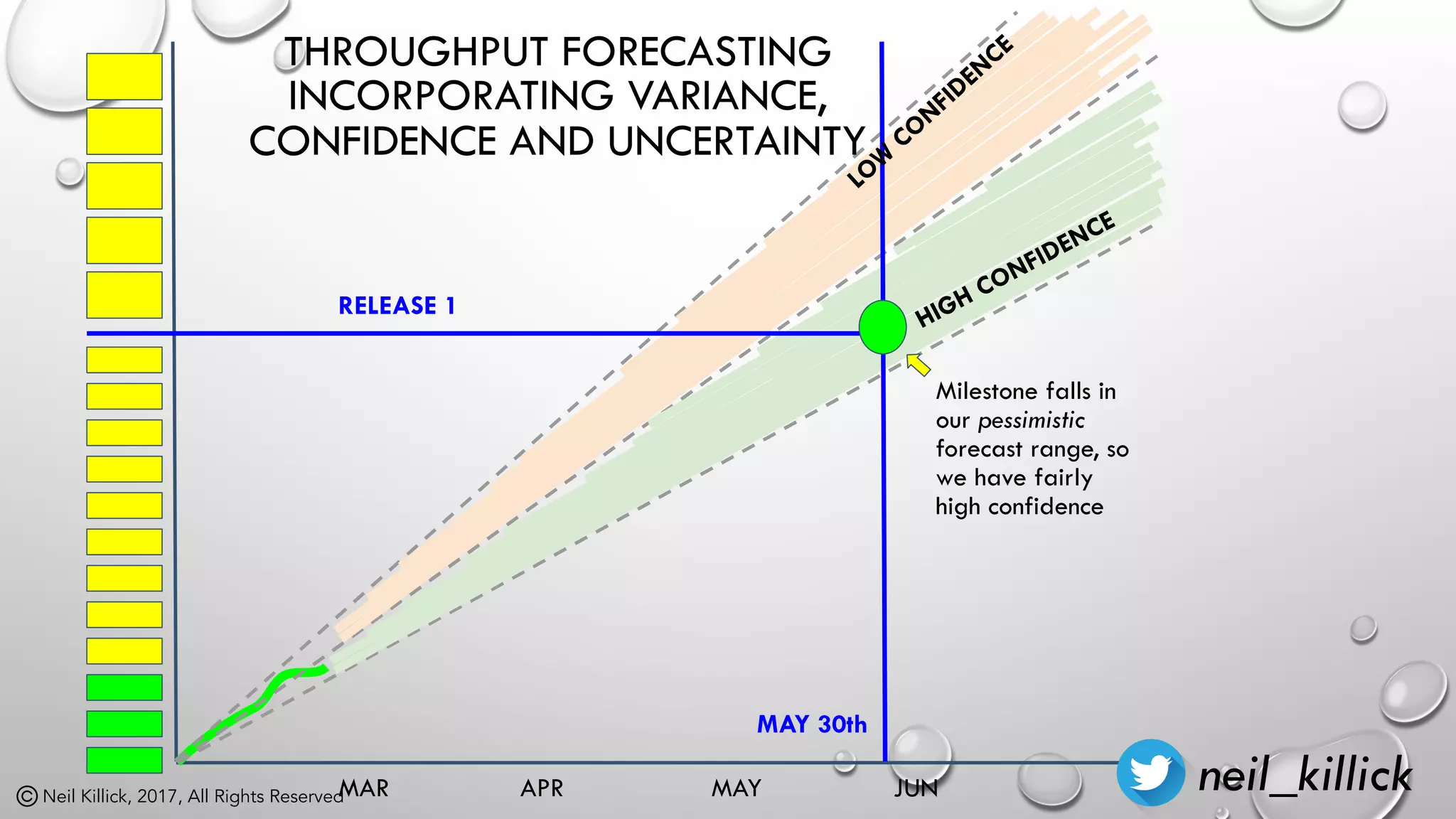

RELEASE 1
HIGH CONFIDENCE
LOW
CONFIDENCE
MAY 30th
MAR APR MAY JUN
THROUGHPUT FORECASTING
INCORPORATING VARIANCE,
CONFIDENCE AND UNCERTAINTY
Milestone falls in
our pessimistic
forecast range, so
we have fairly
high confidence
neil_killick
Neil Killick, 2017, All Rights Reserved

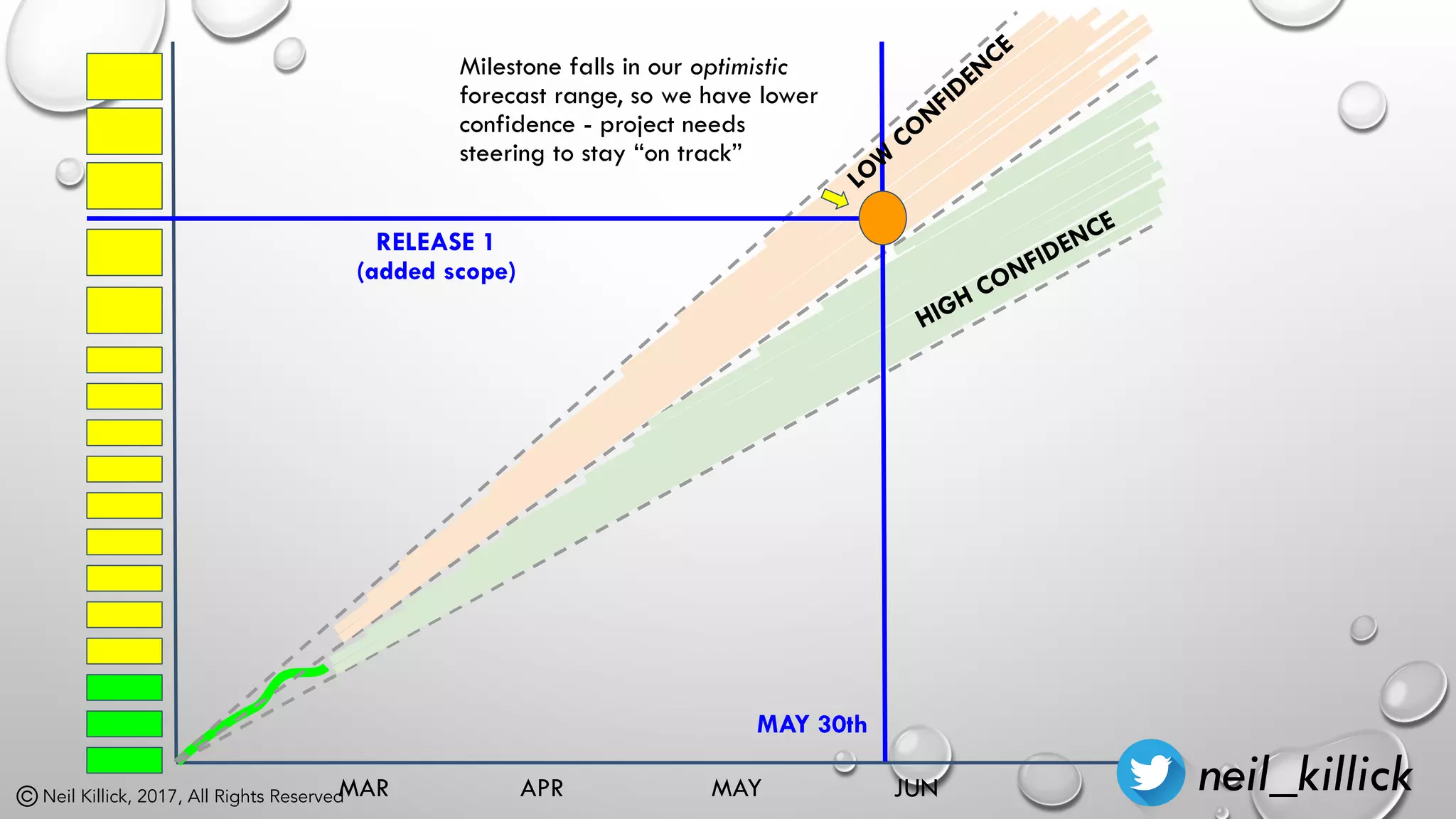

RELEASE 1
(added scope)
HIGH CONFIDENCE
LOW
CONFIDENCE
MAR APR MAY JUN
MAY 30th
Milestone falls in our optimistic
forecast range, so we have lower
confidence - project needs
steering to stay “on track”
neil_killick
Neil Killick, 2017, All Rights Reserved

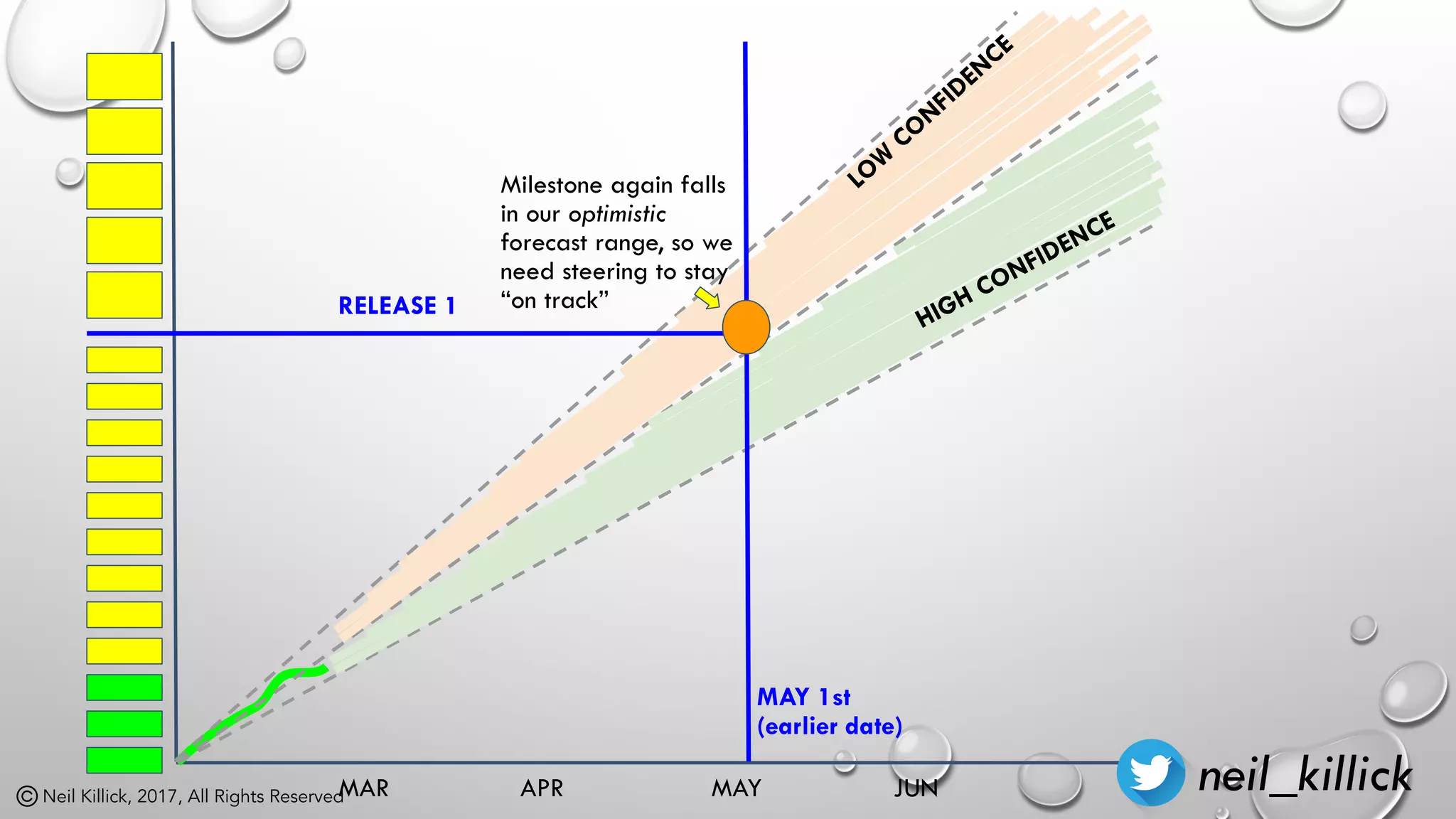

RELEASE 1
HIGH CONFIDENCE
LOW
CONFIDENCE
MAY 1st
(earlier date)
MAR APR MAY JUN
Milestone again falls
in our optimistic
forecast range, so we
need steering to stay
“on track”
neil_killick
Neil Killick, 2017, All Rights Reserved

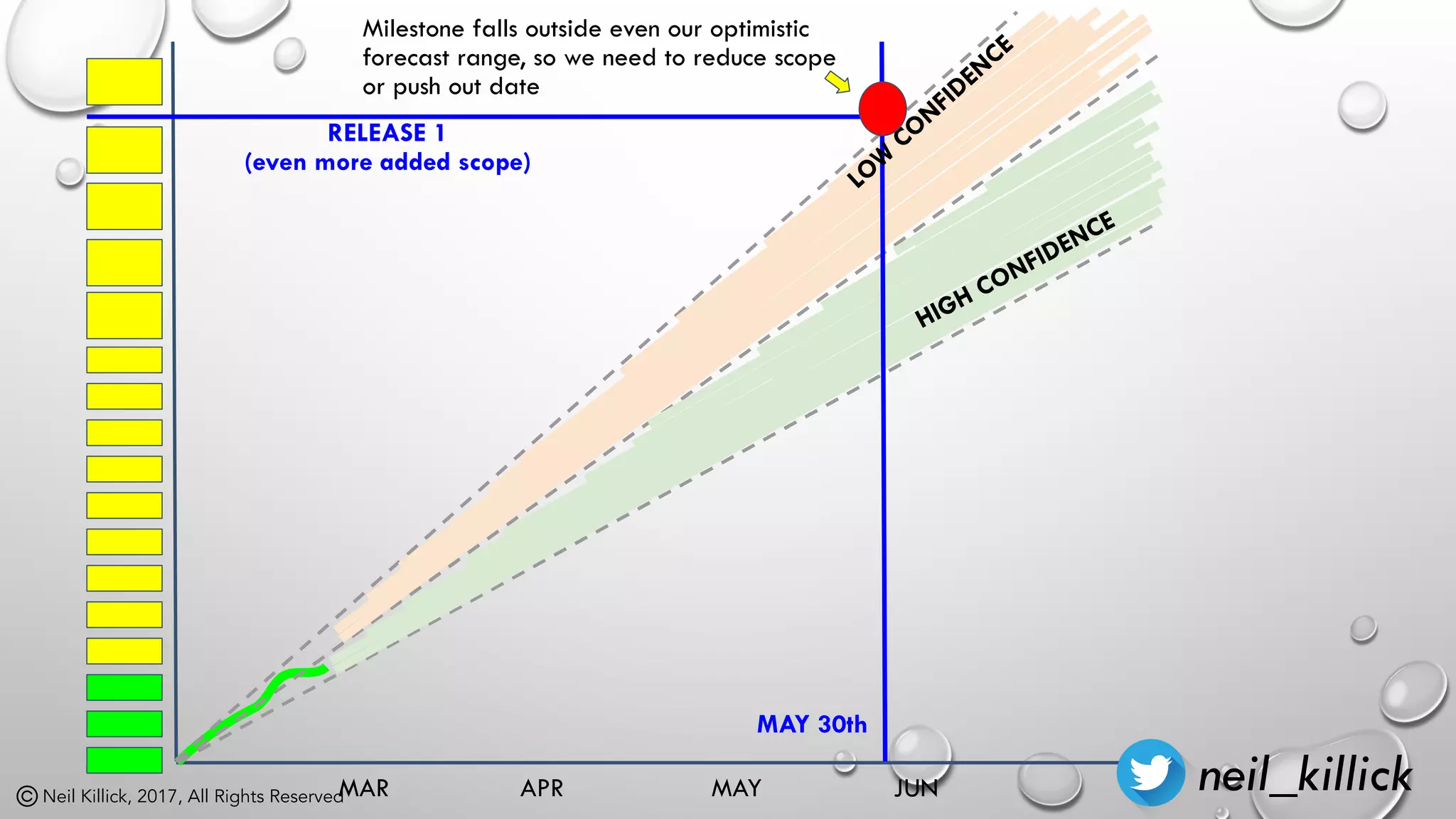

RELEASE 1
(even more added scope)
HIGH CONFIDENCE
LOW
CONFIDENCE
MAR APR MAY JUN
MAY 30th
Milestone falls outside even our optimistic
forecast range, so we need to reduce scope
or push out date
neil_killick
neil_killickNeil Killick, 2017, All Rights Reserved

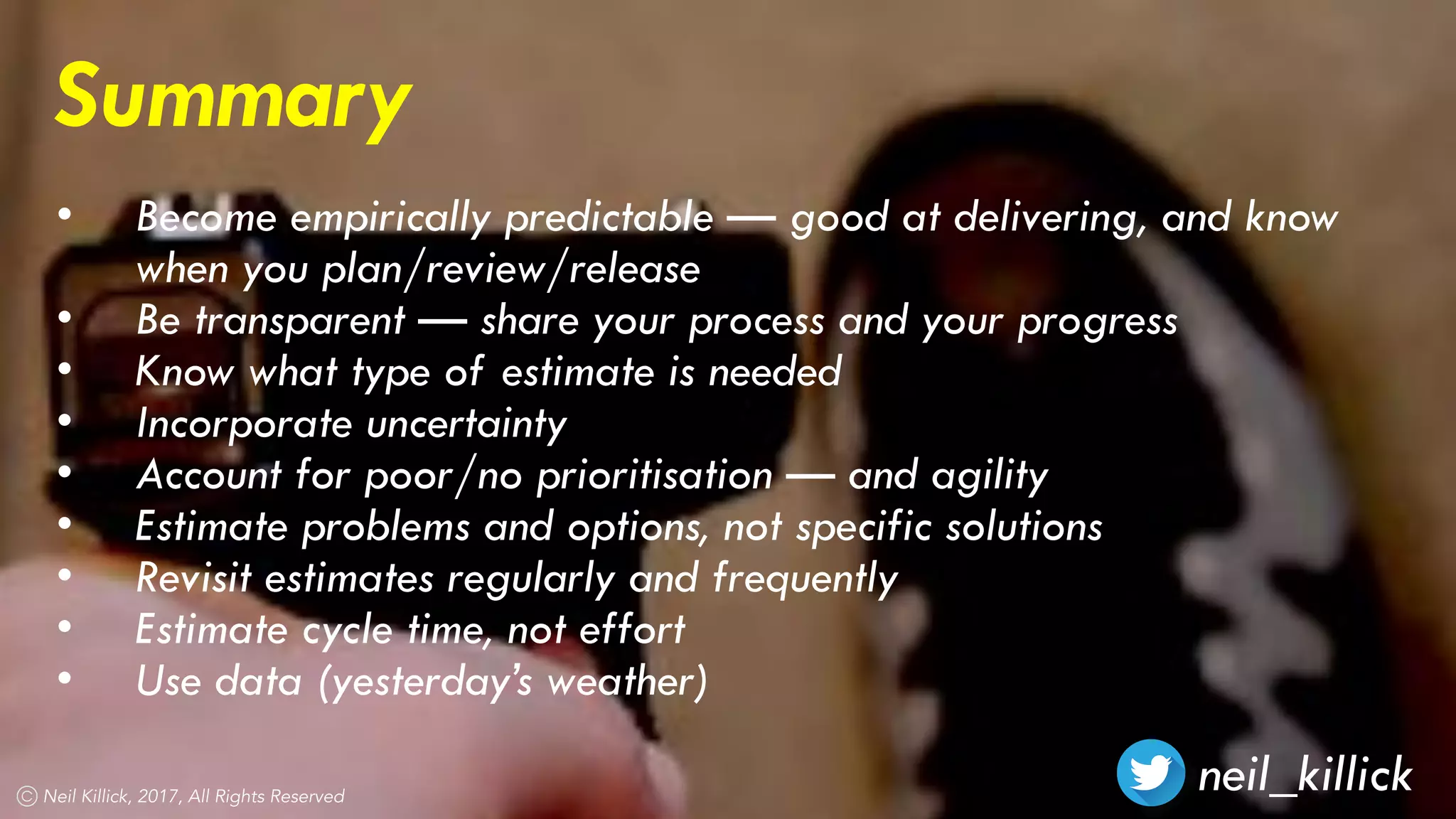

Summary
• Become empirically predictable — good at delivering, and know
when you plan/review/release
• Be transparent — share your process and your progress
• Know what type of estimate is needed
• Incorporate uncertainty
• Account for poor/no prioritisation — and agility
• Estimate problems and options, not specific solutions
• Revisit estimates regularly and frequently
• Estimate cycle time, not effort
• Use data (yesterday’s weather)
neil_killickNeil Killick, 2017, All Rights Reserved
