International Symposium on Global Sustainability
Institute of Sustainable Science

Advanced energy technology for
   sustainable development
         - Analysis of energy for sustainability-
                                     Satoshi Konishi
                              Institute for Sustainability Science,
                     Institute of Advanced Energy, Kyoto University

                                                                                  Aug.12-13, 2011

     Summer School AACIMP-2011
      Kiev Polytechnique Institute, Ukraine

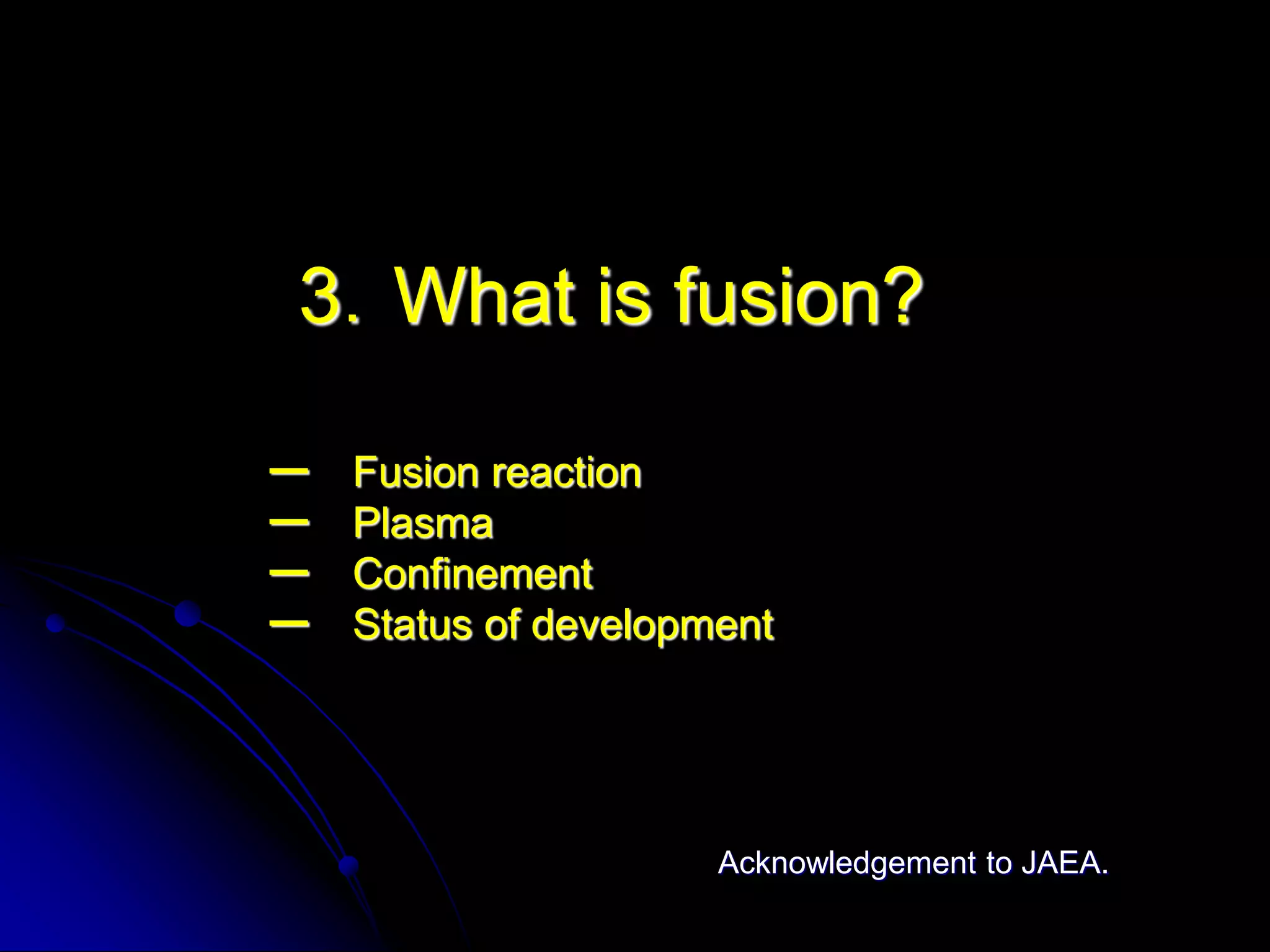

3.What is fusion?

ー   Fusion reaction
ー   Plasma
ー   Confinement
ー   Status of development

                      Acknowledgement to JAEA.

Fusion: Energy of the Sun
Institute of Sustainable Science
                                         International Symposium on Global Sustainability

                                                   Reaction in the sun
                                                     temperature:1,5million degree
                                                     time:10 billion yen
                                                     fuel:hydrogen (proton
                         helium
                            ヘ リ ウ ム

   proton
      陽 子         fusion
                   核融合         neutron
                              中 性 子
                                                        Artifitial sun
                               proton
                                   陽 子
                        陽 電 子
                       positron
                                                       temperature:200 million degree
                                                         time:1second
                                                         fuel:hydrogen isotopes

Deuterium-tritium                                   Helium                neutron
                                                                                            oil   8t
        fuel 1 g

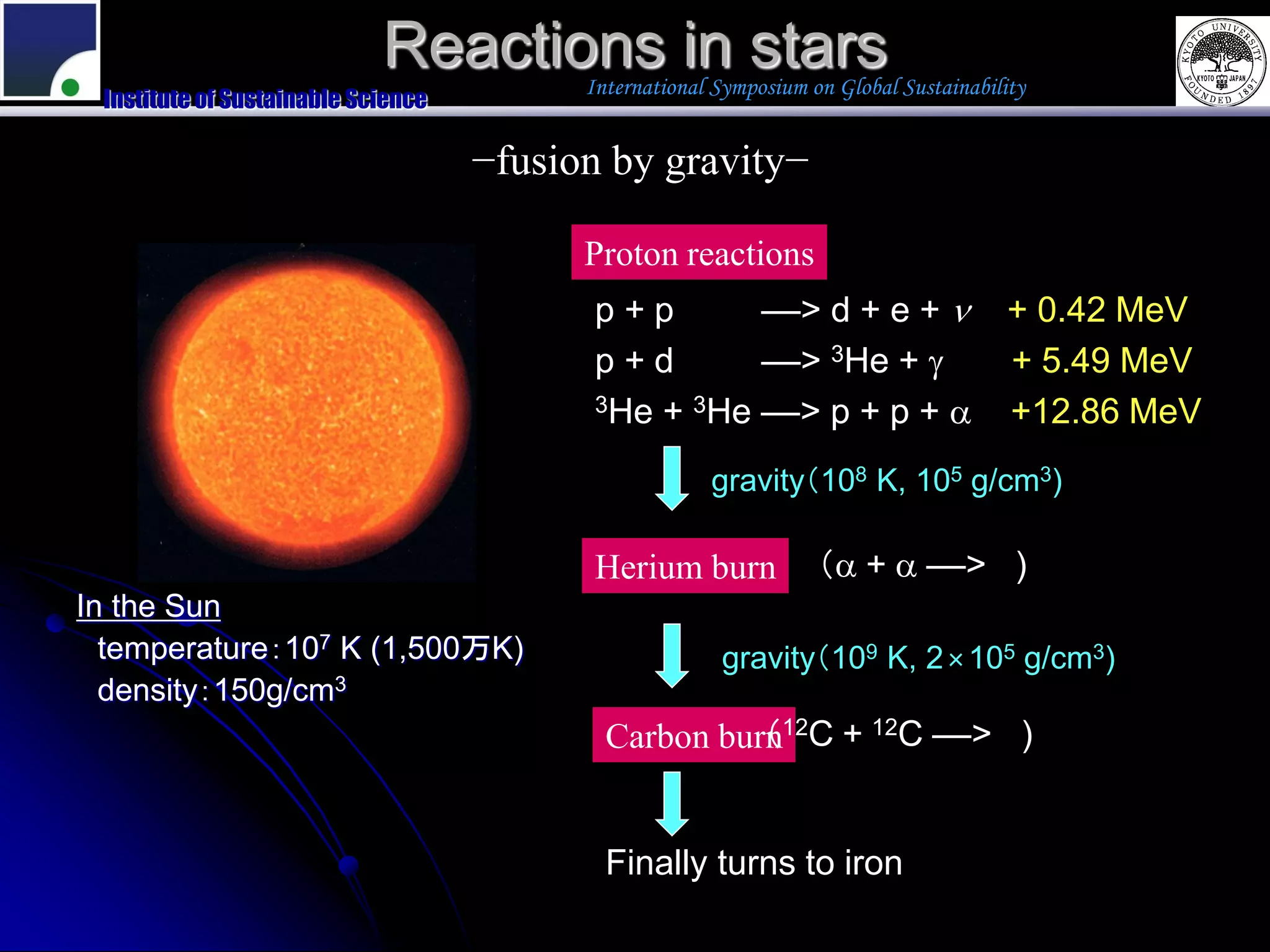

Reactions in stars
                                          International Symposium on Global Sustainability
 Institute of Sustainable Science

                                    −fusion by gravity−

                                          Proton reactions
                                           p+p       ––> d + e + n + 0.42 MeV
                                           p+d       ––> 3He + g   + 5.49 MeV
                                           3He + 3He ––> p + p + a +12.86 MeV
                                                       gravity(108 K, 105 g/cm3)

                                           Herium burn             (a + a ––> )
In the Sun
  temperature:107 K (1,500万K)                           gravity(109 K, 2×105 g/cm3)
  density:150g/cm3
                                            Carbon burn12C + 12C ––> )
                                                      (

                                            Finally turns to iron

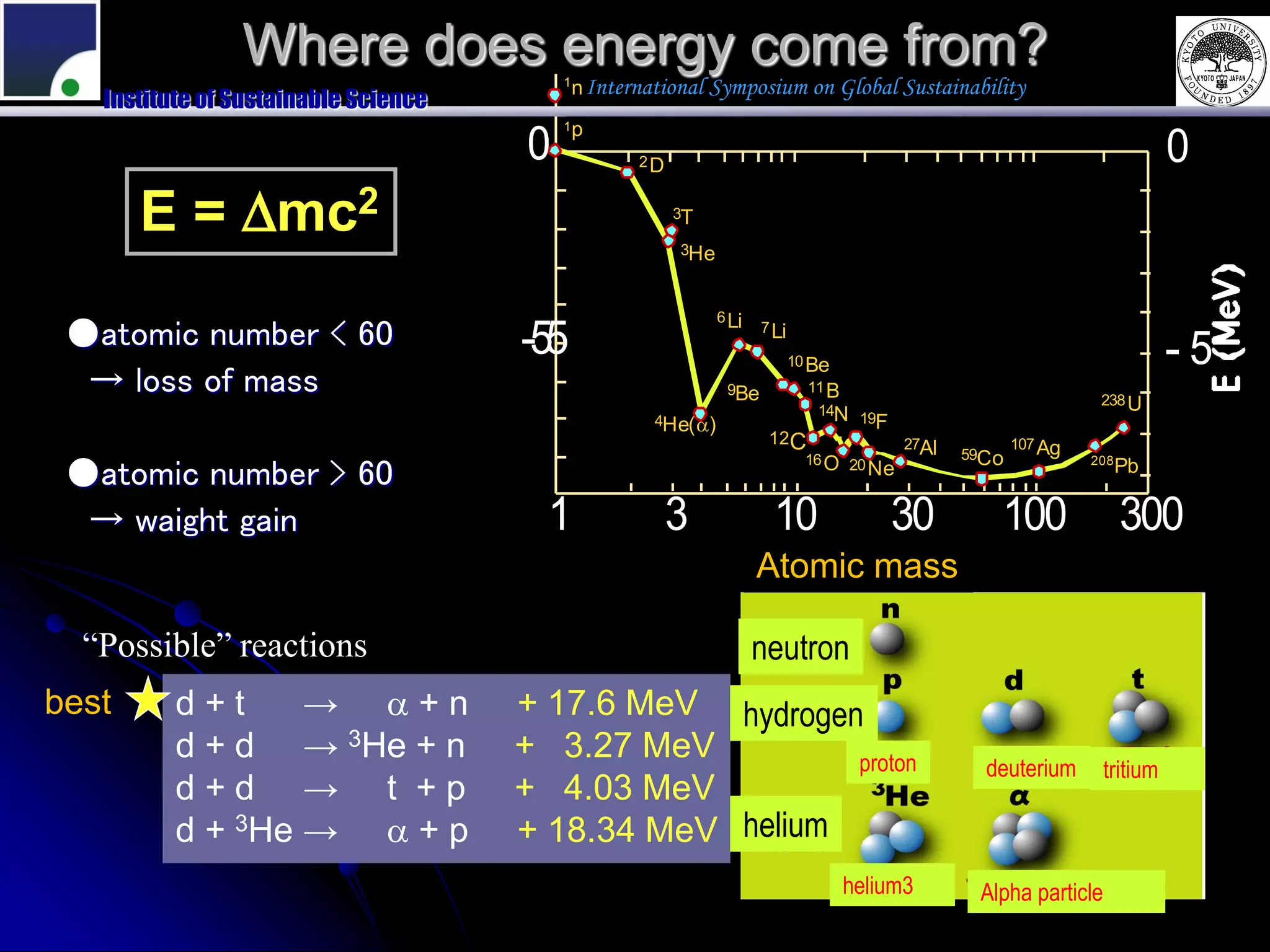

Where does energy come from?
                                          1
                                              n International Symposium on Global Sustainability
   Institute of Sustainable Science
                                          1p

                                      0              2D                                                                         0
       E = Dmc2                                           3T

                                                          3He

                                                                6 Li
 ●atomic number < 60                  -5
                                      5                                7 Li

                                                                              10 Be                                             -5
  → loss of mass                                                 9Be            11 B
                                                                                                                     238 U
                                                                                 14N
                                                       4He(a)                          19F
                                                                        12C                  27Al          107 Ag
                                                                                16 O 20             59Co
 ●atomic number > 60
                                                                                                                    208
                                                                                        Ne                                Pb

  → waight gain                         1                 3              10   30 100                                      300
                                                                       Atomic子
                                                                           原子量
                                                                           原mass
                                                                              量
  “Possible” reactions                                                 neutron
best      d+t     → a+n               + 17.6 MeV hydrogen
          d + d → 3He + n             + 3.27 MeV         proton                                       deuterium       tritium
          d+d → t +p                  + 4.03 MeV
          d + 3He → a + p             + 18.34 MeV helium
                                                                                      helium3        Alpha particle
d-t reaction

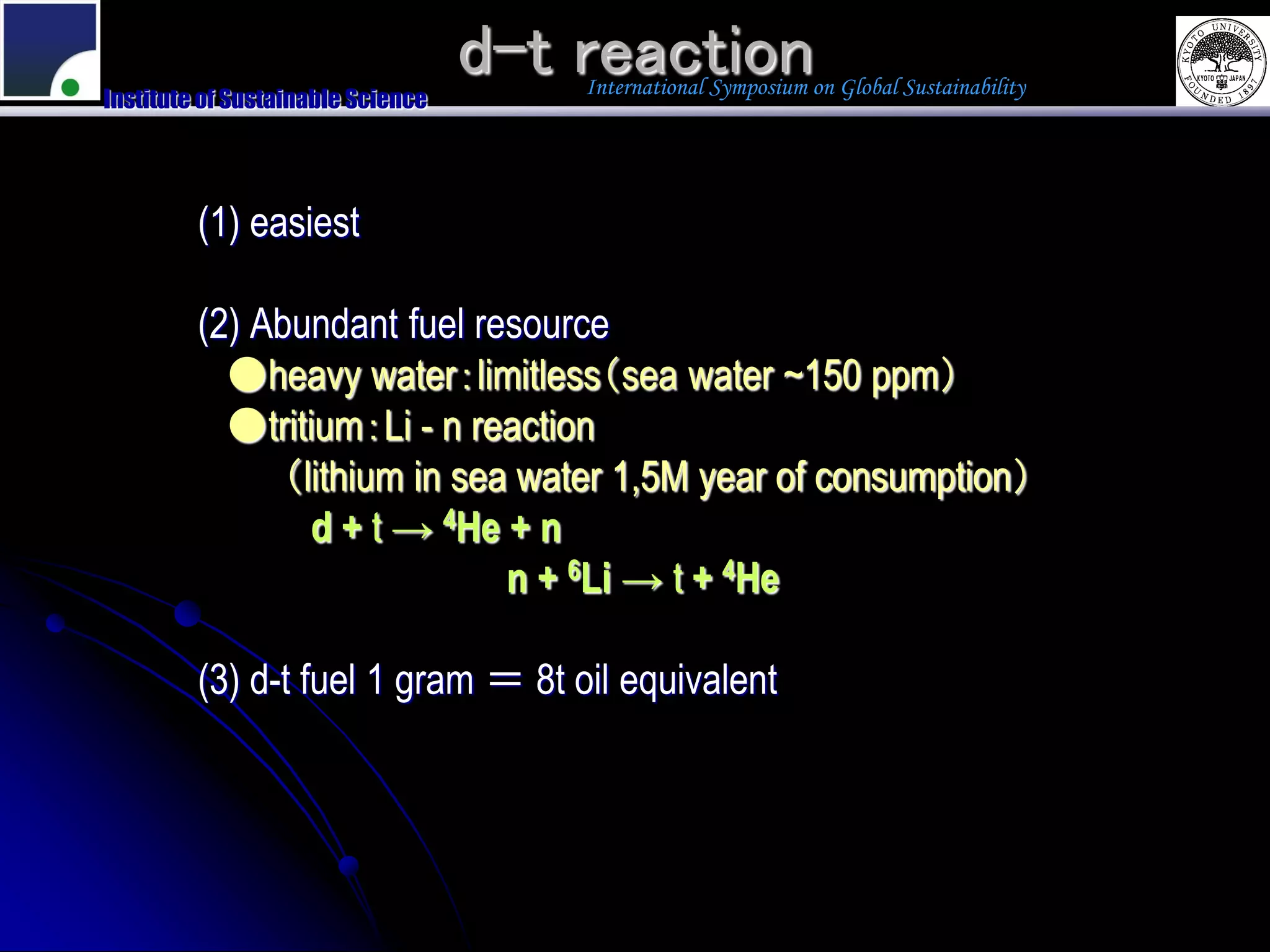

                                       International Symposium on Global Sustainability
Institute of Sustainable Science

         (1) easiest

         (2) Abundant fuel resource
           ●heavy water:limitless(sea water ~150 ppm)
           ●tritium:Li - n reaction
              (lithium in sea water 1,5M year of consumption)
                 d + t → 4He + n
                             n + 6Li → t + 4He

         (3) d-t fuel 1 gram = 8t oil equivalent

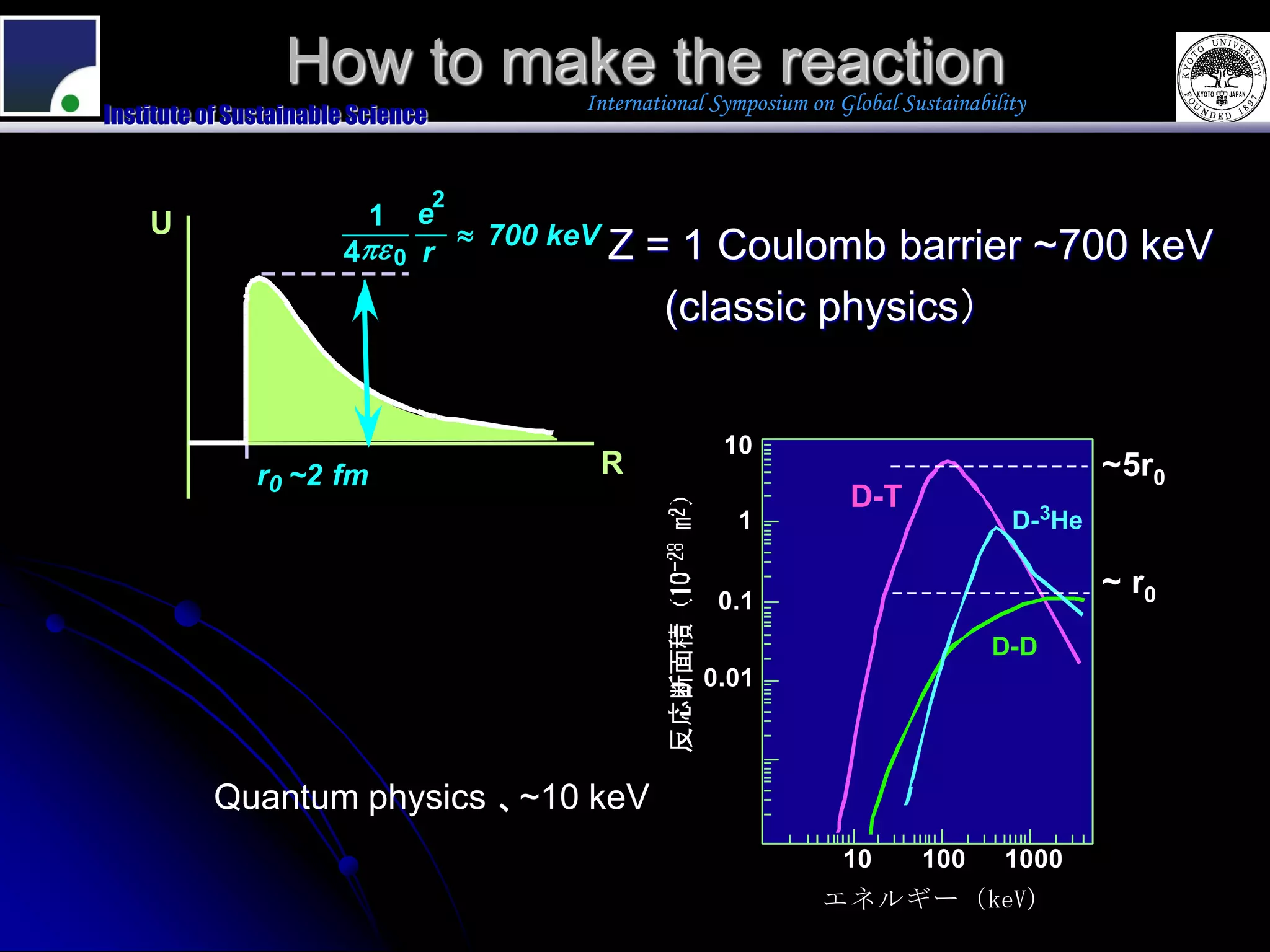

How to make the reaction
                                       International Symposium on Global Sustainability
Institute of Sustainable Science

                                   2
    U                     1  e
                                700 keV
                       4 0 r           Z   = 1 Coulomb barrier ~700 keV
                                              (classic physics)

                                                      10
               r0 ~2 fm                 R                                                    ~5r0
                                                                   D-T
                                                       1                             D-3He

                                                     0.1
                                                                                             ~ r0
                                                                                   D-D
                                                   0.01

          Quantum physics 、~10 keV
                                                                   10      100      1000
                                                                エネルギー(keV)
                                                                      keV)

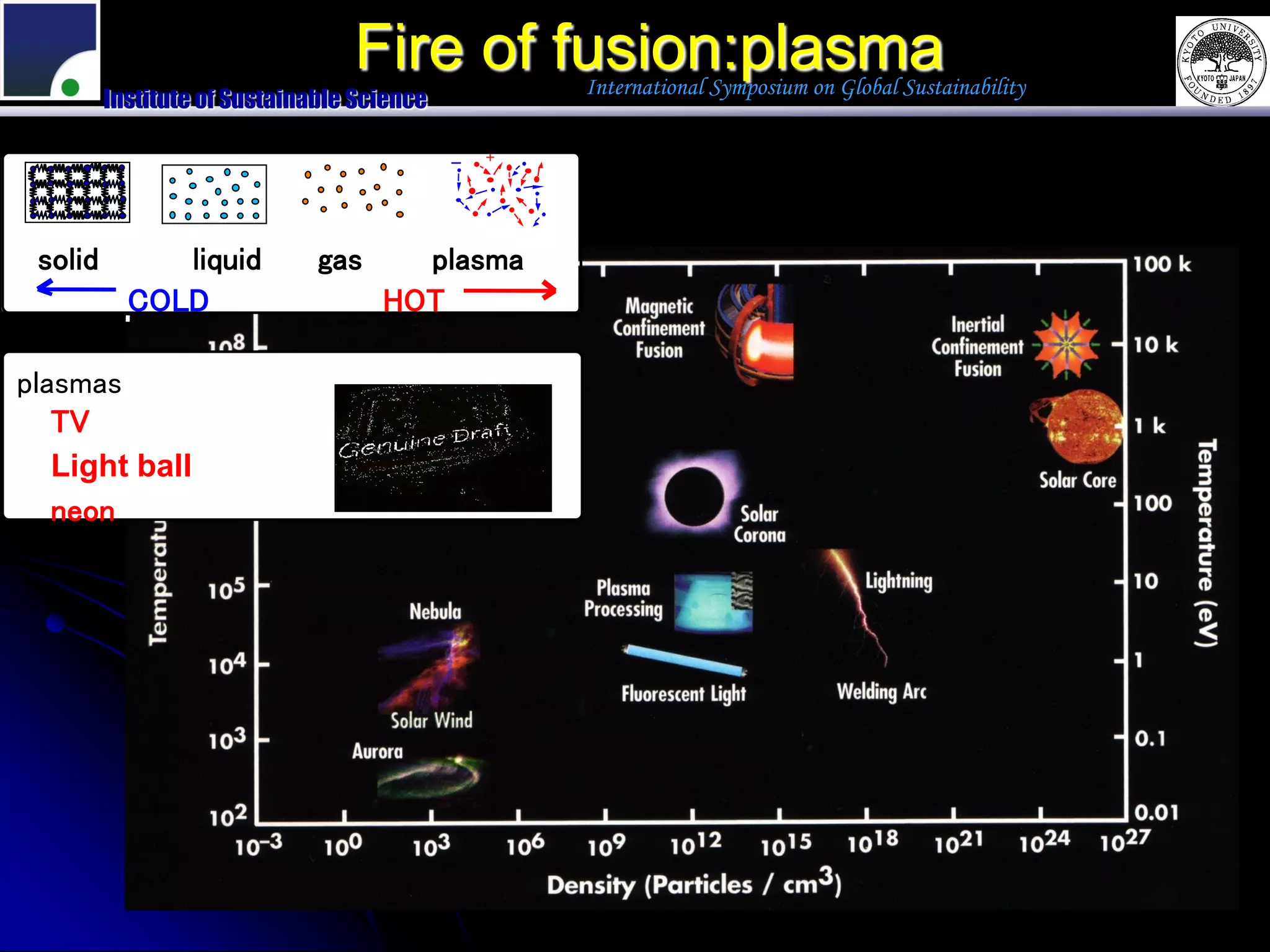

Fire of fusion:plasma
                                                    International Symposium on Global Sustainability
         Institute of Sustainable Science

                                            -
                                            e
                                                +

 solid        liquid          gas     plasma
           COLD                     HOT

plasmas
   TV
   Light ball
   neon

Thermonuclear reaction International Symposium on Global Sustainability
Institute of Sustainable Science

                                                        Power balance
      wall                   Confinement    E
                                                            ●power loss
                             time                                            3                        nT
                                                                     Ppl      (ni Ti  ne Te )  E 
  plasma                                                                     2                        E

             density n                                      ●fusion output
                                   heat
                                                                                2
             temperature T                                         Pfus
                                                                             n
                                                                             i  v  E fus  n2 f(T)
                                                                              4
  efficiency η                                          Fusion power can be recycled to
                                                        heat the plasma again
                                                        

                      pow                                  Criteria is temperature, time and
                      er                                   densitynE, T
Lawson criteria

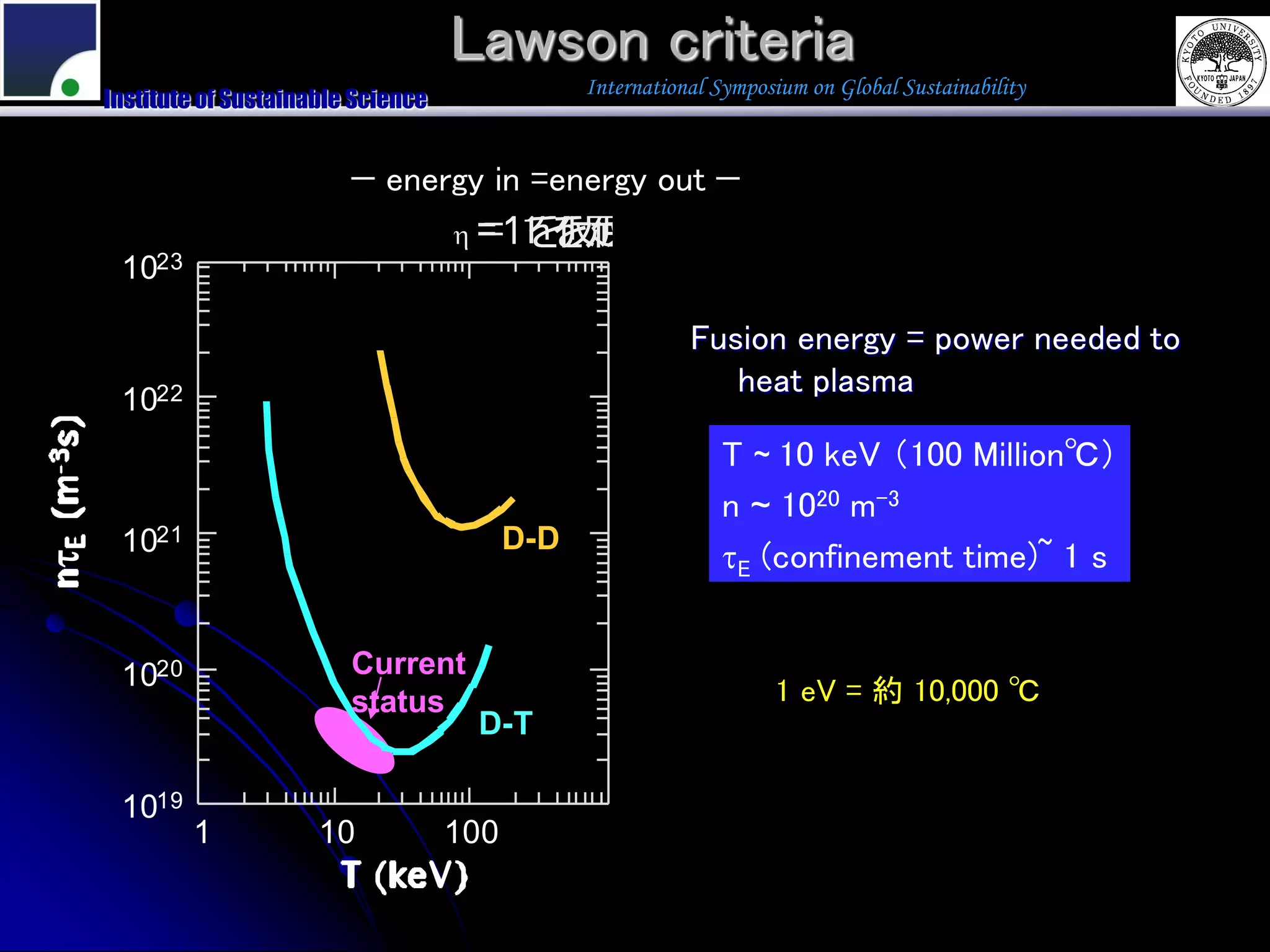

                                                   International Symposium on Global Sustainability
    Institute of Sustainable Science

                            − energy in =energy out −
                                        = 11 を仮定
                                         = を仮  定
     1023

                                                              Fusion energy = power needed to
                                                                 heat plasma
     1022
                                                                 T ~ 10 keV (100 Million℃)
                                                                 n ~ 1020 m-3
     1021                                    D-D
                                                                 E (confinement time)~ 1 s


     1020                   Current
                            status                                     1 eV = 約 10,000 ℃
                                        D-T

     1019
            1            10            100
Institute of Sustainable Science

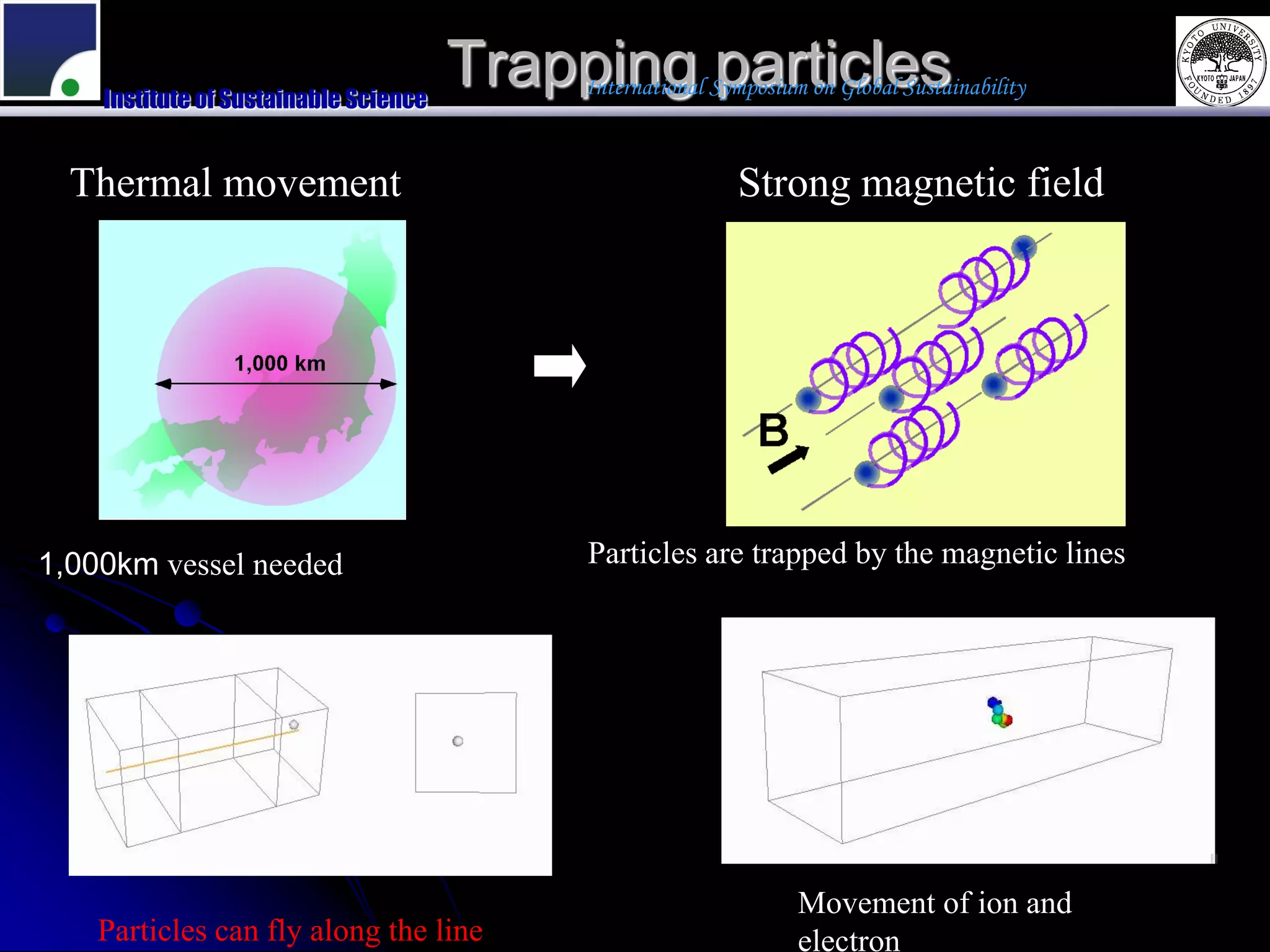

                                       Trapping particles
                                           International Symposium on Global Sustainability

  Thermal movement                                         Strong magnetic field

1,000km vessel needed                       Particles are trapped by the magnetic lines

                                                                  Movement of ion and
    Particles can fly along the line                              electron
Plasma confinement

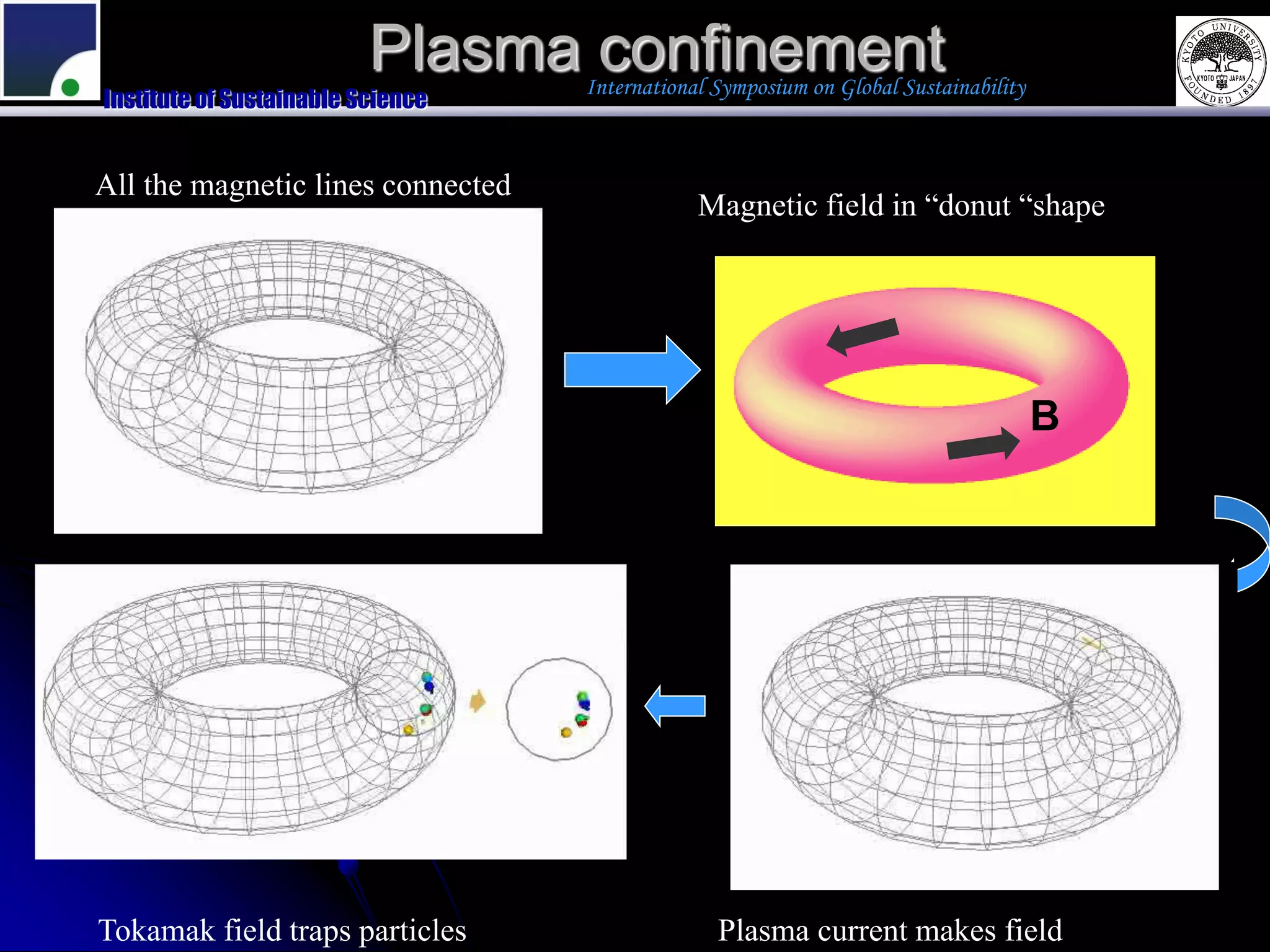

                                   International Symposium on Global Sustainability
Institute of Sustainable Science

All the magnetic lines connected
                                               Magnetic field in “donut “shape

                                                                                      B

Tokamak field traps particles                    Plasma current makes field

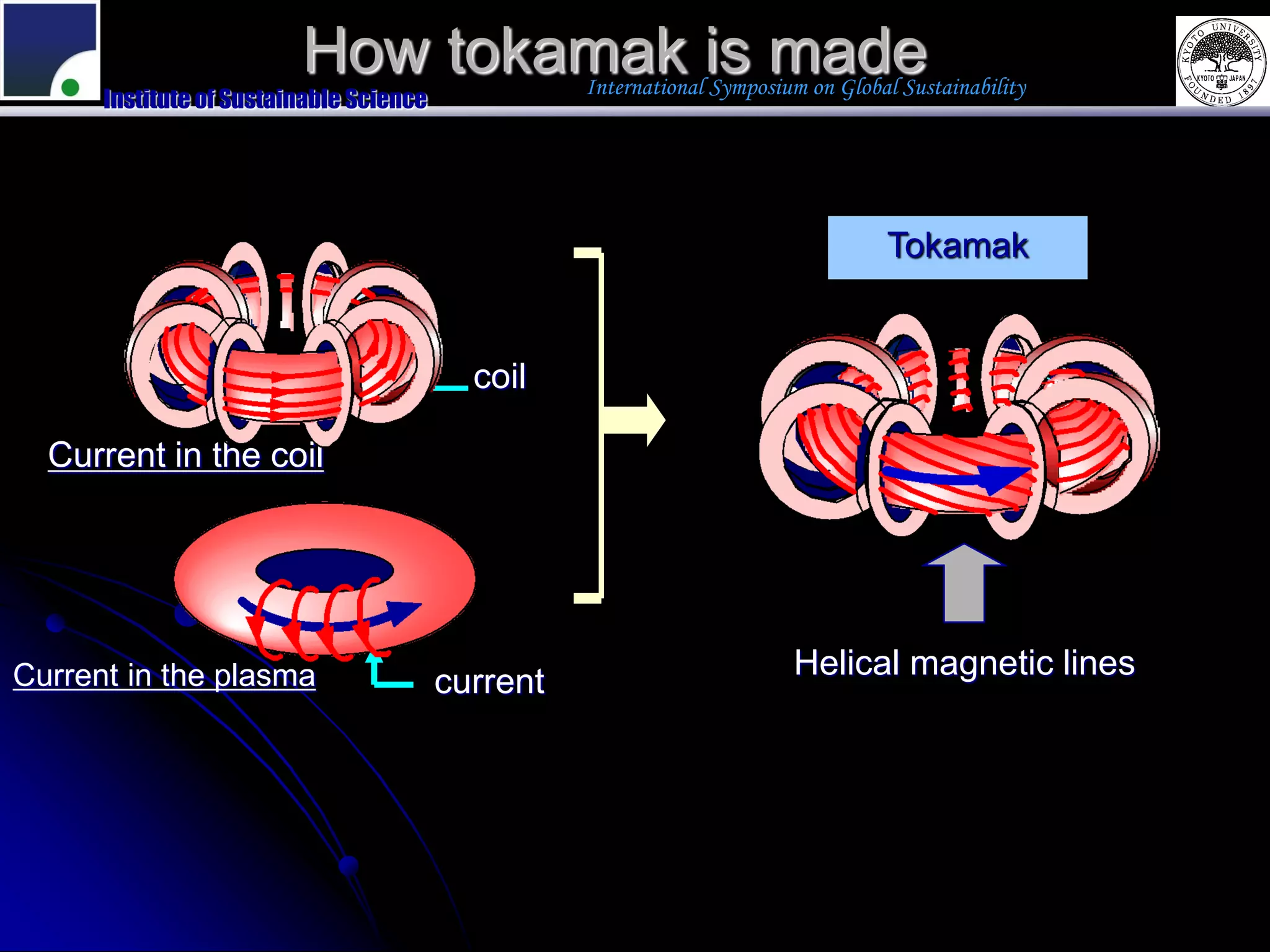

How tokamak is made       International Symposium on Global Sustainability
      Institute of Sustainable Science

                                                                                   Tokamak

                                           coil

  Current in the coil

Current in the plasma                                                    Helical magnetic lines
                                         current

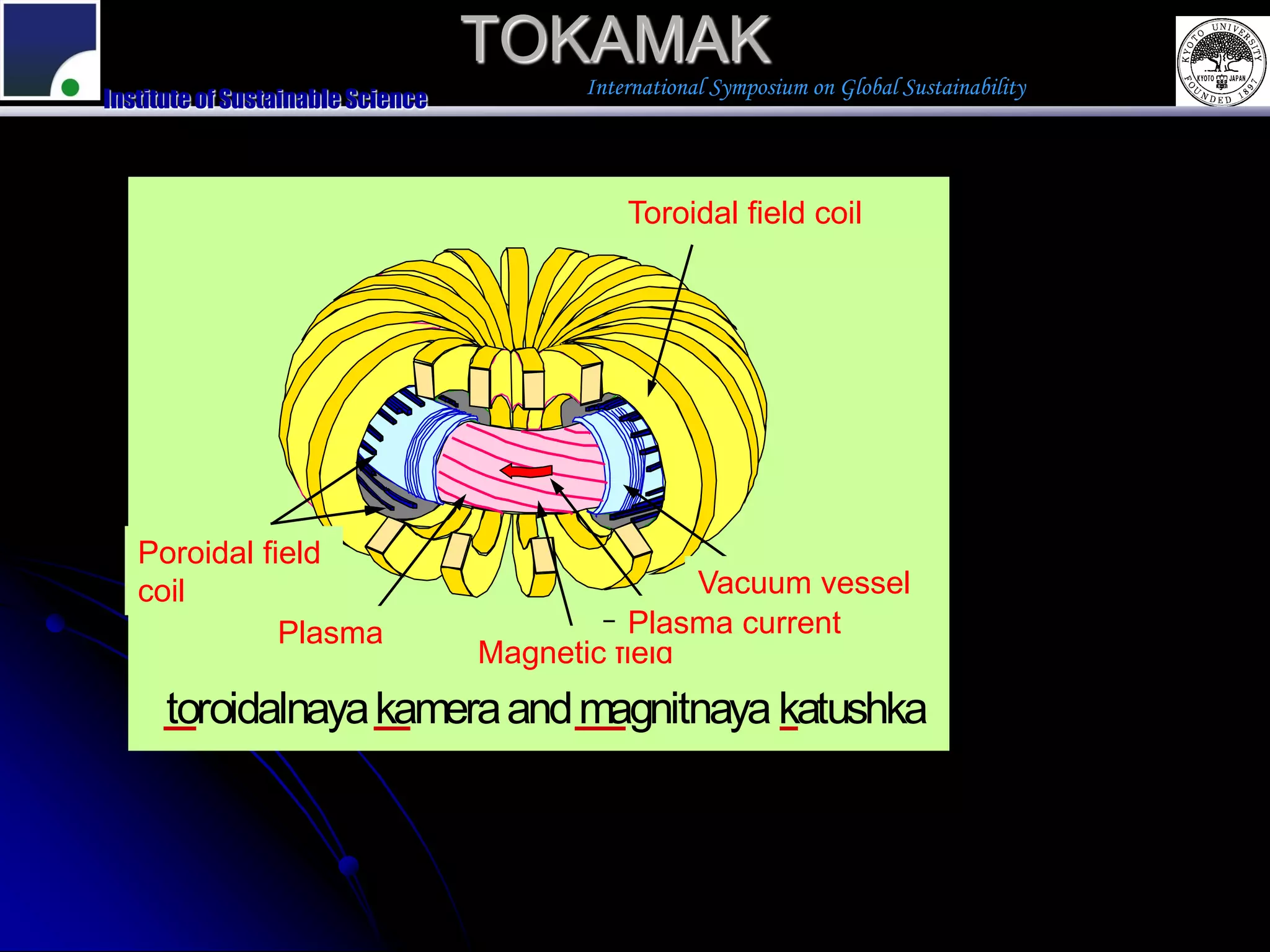

TOKAMAK
                                         International Symposium on Global Sustainability
Institute of Sustainable Science

                                             Toroidal ル 磁 場 コ イ ル
                                             ト ロ イ ダ field coil

   Poroidal field
   ポロ イ ダル
   磁場コ イ ル
   coil                                           Vacuum vessel
                                                      真空容器

                 Plasmaマ
                  プラ ズ                     プ Plasma current
                                              ラ ズマ 電流
                                   Magnetic field
                                     磁力線

      toroidalnaya kamera and magnitnaya katushka

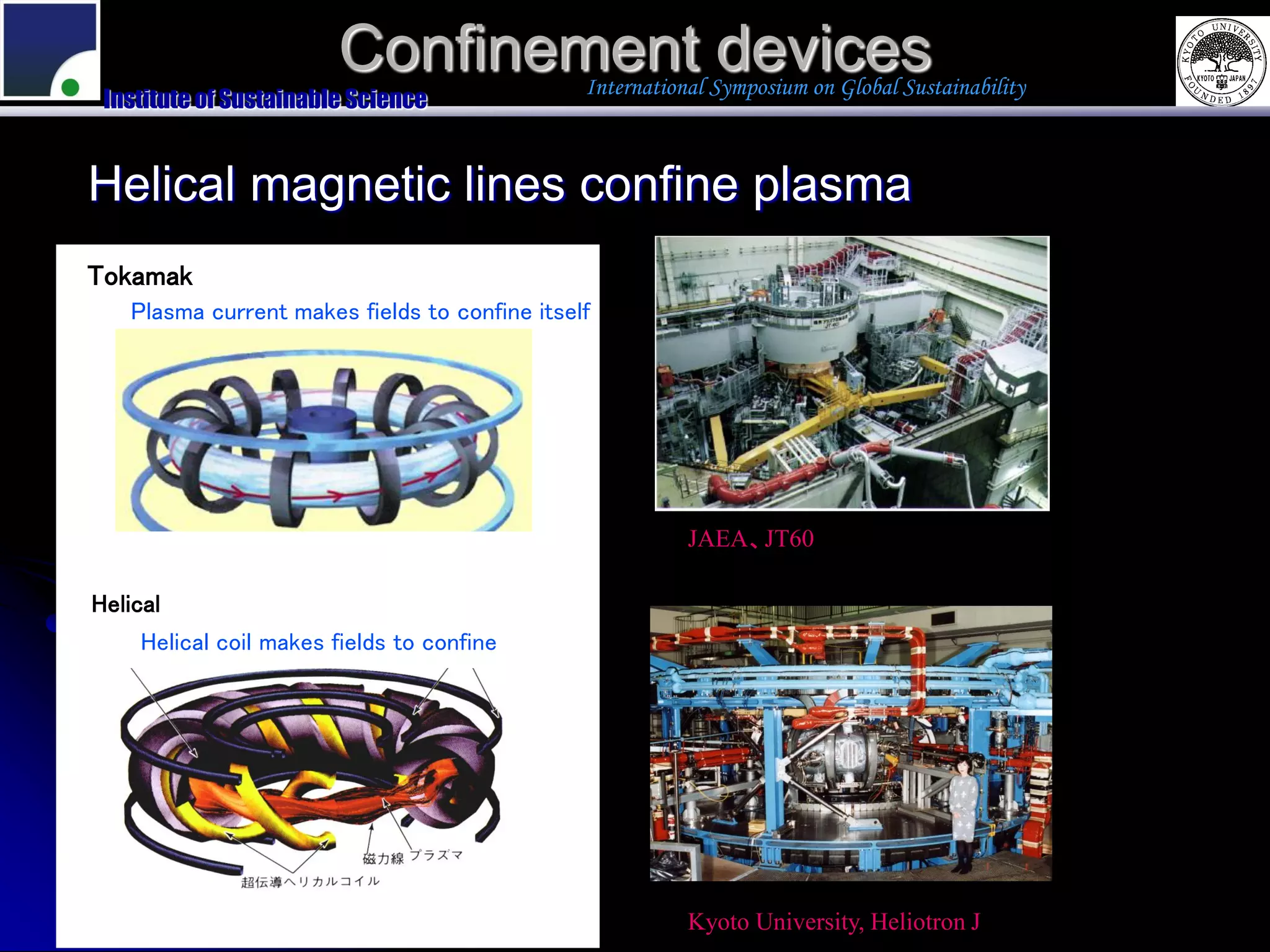

Confinement devices     International Symposium on Global Sustainability
 Institute of Sustainable Science

Helical magnetic lines confine plasma
Tokamak
    Plasma current makes fields to confine itself

                                                           JAEA、JT60

Helical
     Helical coil makes fields to confine

                                                           Kyoto University, Heliotron J

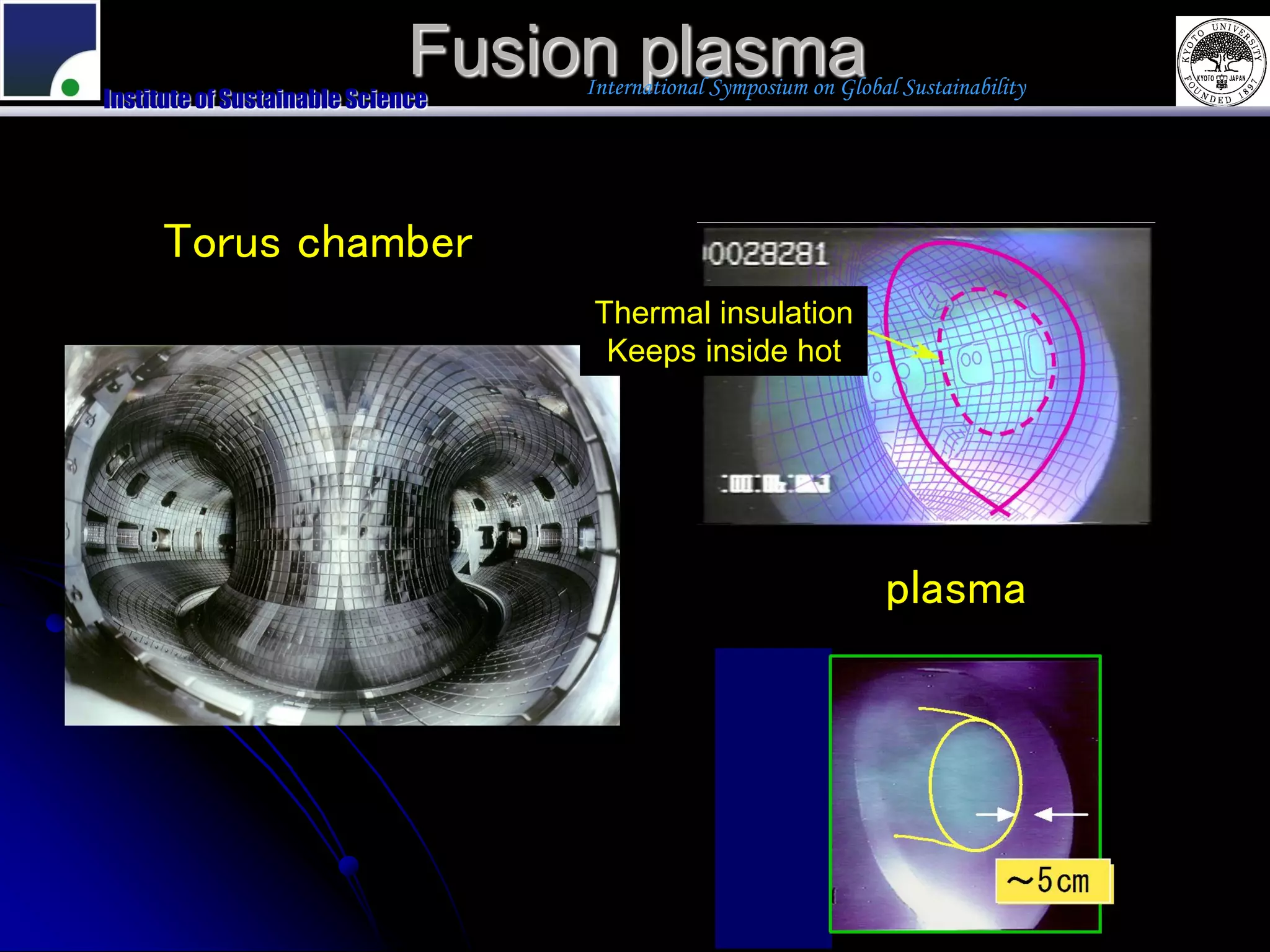

Fusion plasma
Institute of Sustainable Science
                                   International Symposium on Global Sustainability

     Torus chamber
                                    Thermal insulation
                                     Keeps inside hot

                                                                   plasma
Plasma movement
Institute of Sustainable Science
                                   International Symposium on Global Sustainability
Plasma movement
Institute of Sustainable Science
                                   International Symposium on Global Sustainability

            Numerical simulation is needed to “see” it.

              As particles                                          As fluids
4.Fusion development and
   its possible market

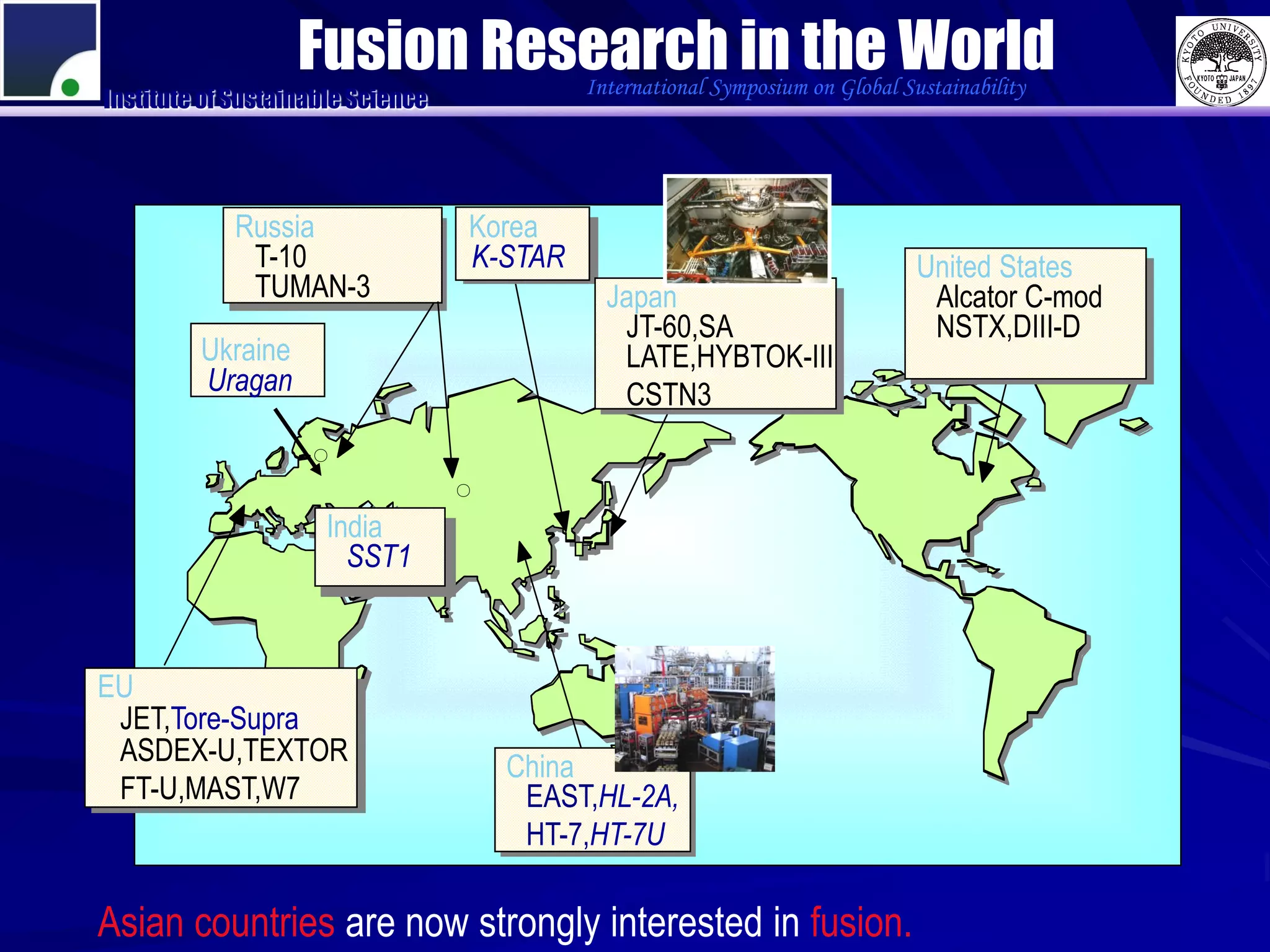

Fusion Research in the World
                                            International Symposium on Global Sustainability
Institute of Sustainable Science

             Russia                Korea
              T-10                 K-STAR                                       United States
              TUMAN-3                         Japan                              Alcator C-mod
                                               JT-60,SA                          NSTX,DIII-D
         Ukraine                               LATE,HYBTOK-III
         Uragan                                CSTN3
                    ○

                                   ○

                      India
                        SST1

EU
 JET,Tore-Supra
 ASDEX-U,TEXTOR
                                       China
 FT-U,MAST,W7                           EAST,HL-2A,
                                        HT-7,HT-7U

Asian countries are now strongly interested in fusion.

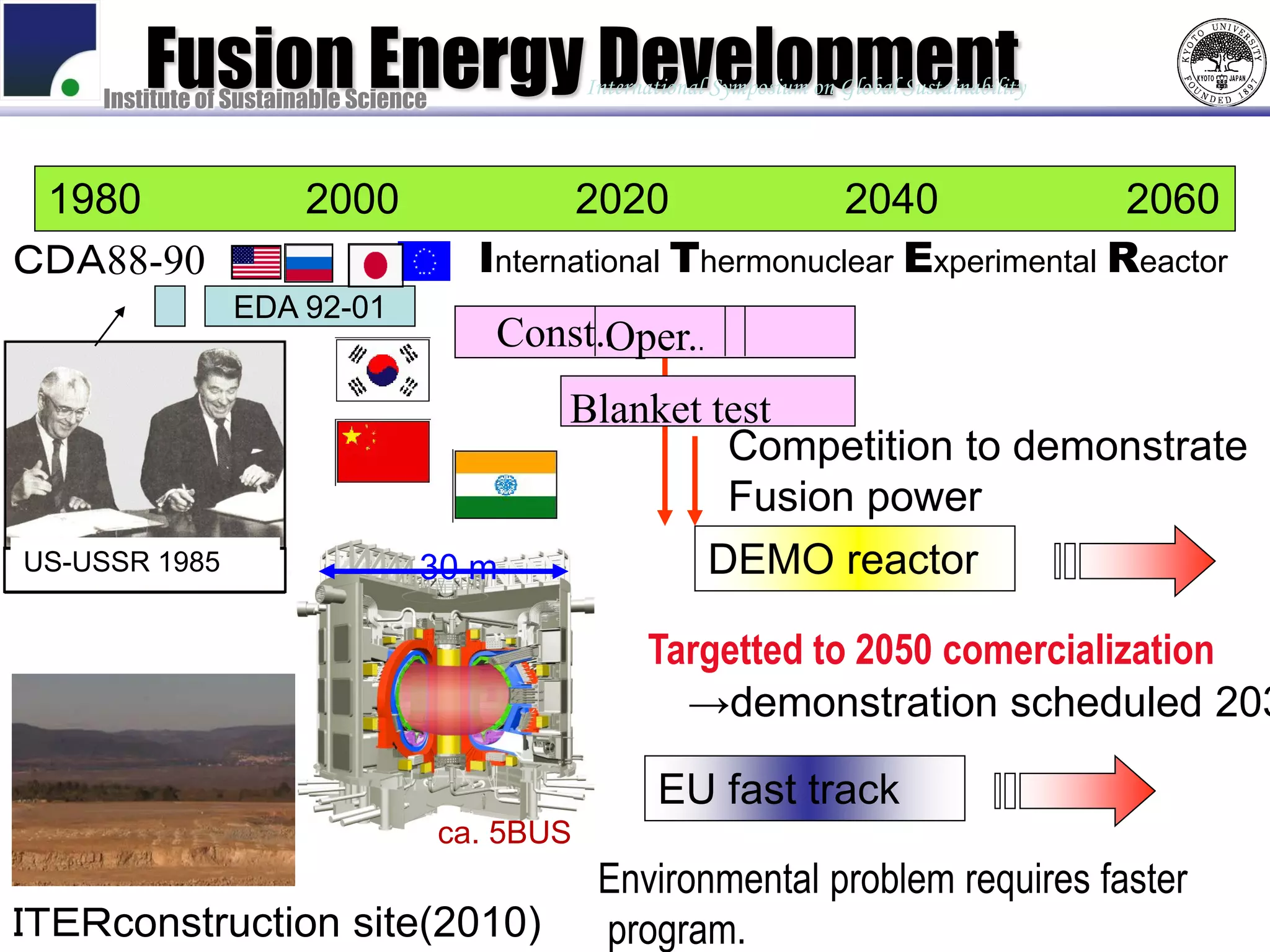

Fusion Energy Development
    Institute of Sustainable Science
                                                                 International Symposium on Global Sustainability

 1980                  2000                                      2020           2040              2060
CDA88-90                                                International Thermonuclear Experimental Reactor
                                          ★
                                      ★       ★
                                  ★               ★
                                  ★
                                                  ★
                                  ★
                                                  ★
                                      ★★ ★

                EDA 92-01
                                                         Const.Oper..
                                                               .

                                                             Blanket test
                                                                      Competition to demonstrate
                                                                      Fusion power
US-USSR 1985                          30 m                           DEMO reactor

                                                                       Targetted to 2050 comercialization
                                                                         →demonstration scheduled 203

                                                                        EU fast track
                                                      ca. 5BUS
                                                                  Environmental problem requires faster
ITERconstruction site(2010)                                       program.

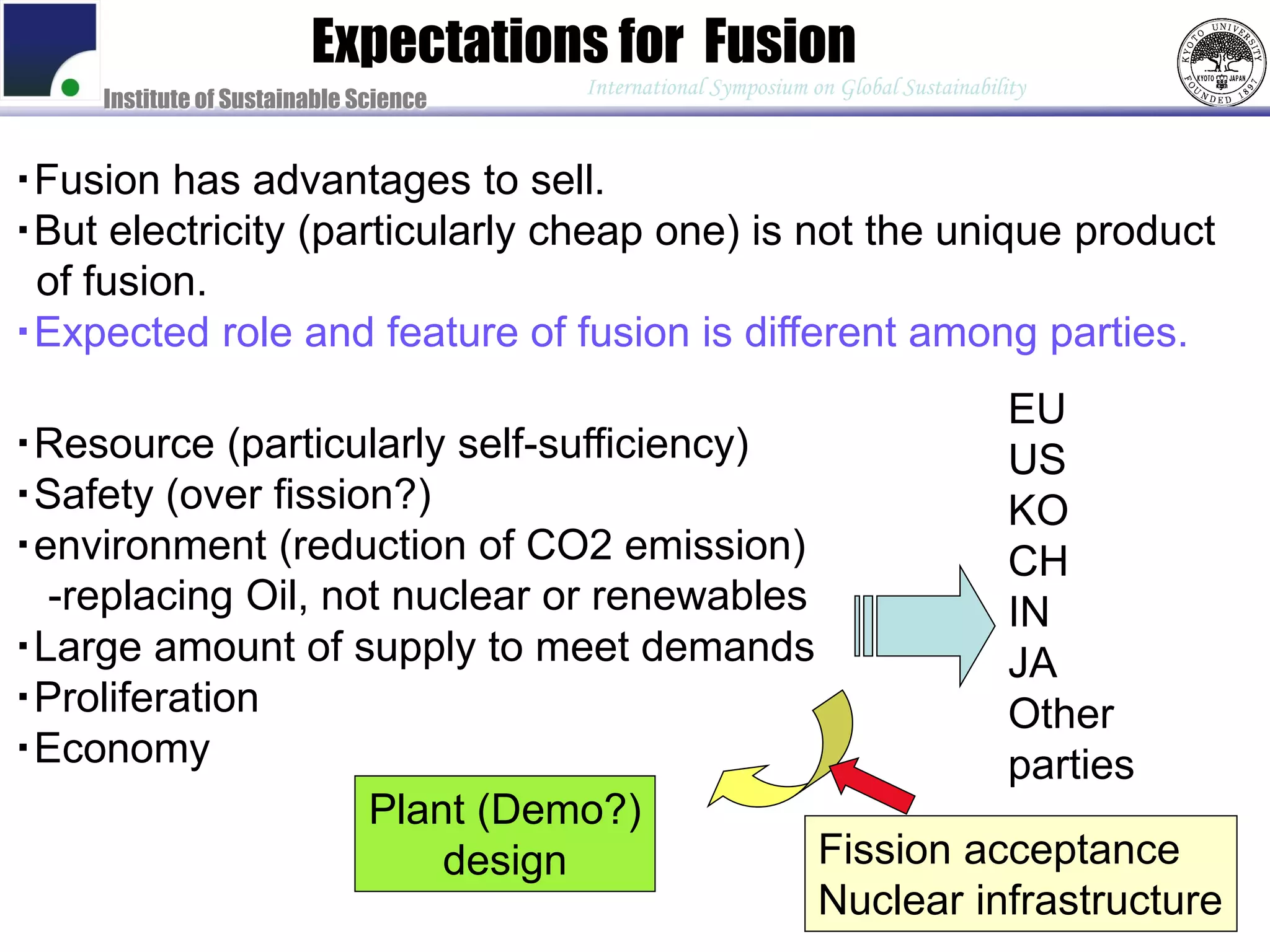

Expectations for Fusion
                                        International Symposium on Global Sustainability
     Institute of Sustainable Science

・Fusion has advantages to sell.
・But electricity (particularly cheap one) is not the unique product
 of fusion.
・Expected role and feature of fusion is different among parties.
                                                                                      EU
・Resource (particularly self-sufficiency)                                             US
・Safety (over fission?)                                                               KO
・environment (reduction of CO2 emission)                                              CH
  -replacing Oil, not nuclear or renewables                                           IN
・Large amount of supply to meet demands                                               JA
・Proliferation                                                                        Other
・Economy                                                                              parties
                    Plant (Demo?)
                        design              Fission acceptance
                                            Nuclear infrastructure

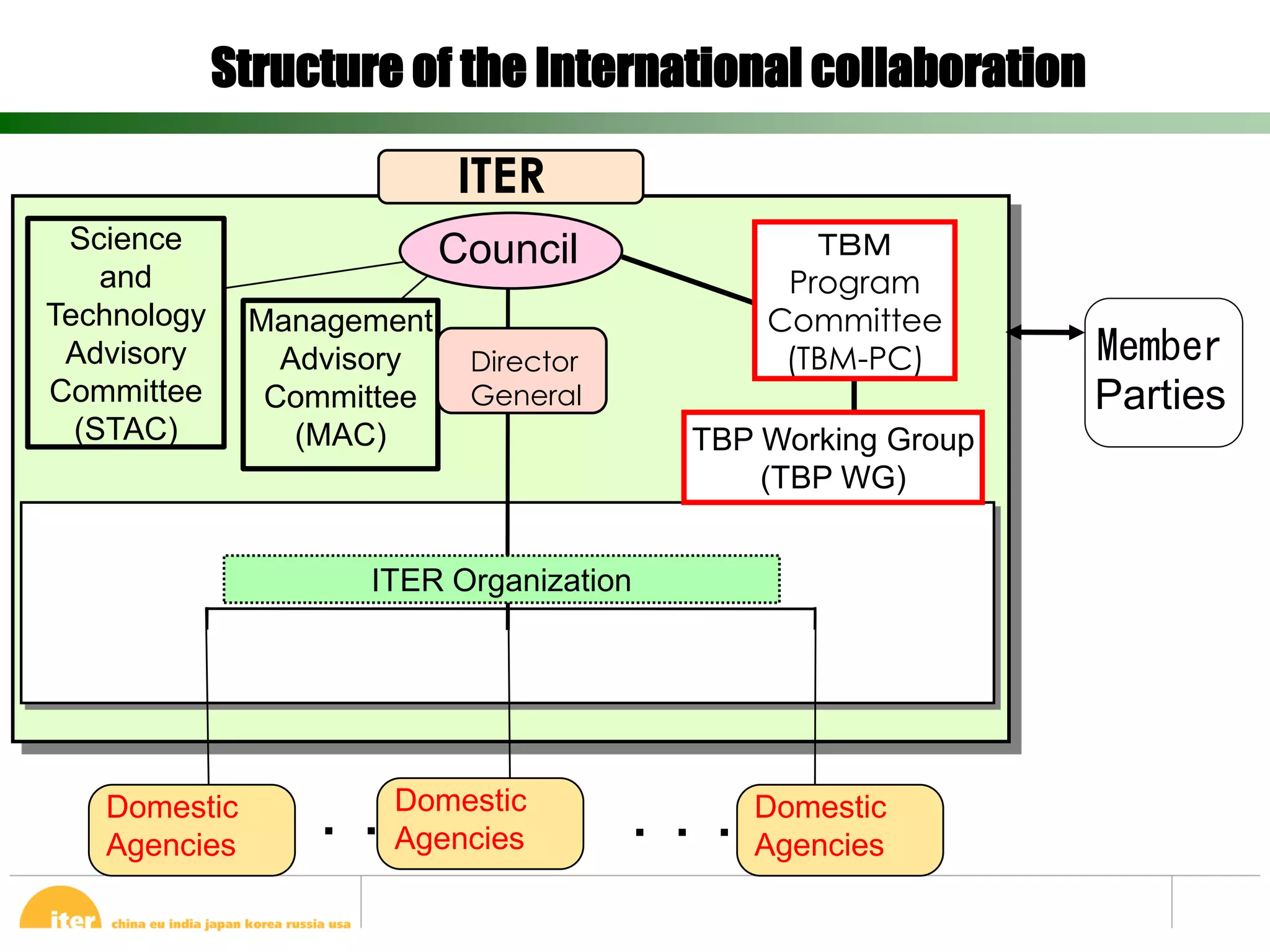

Structure of the International collaboration

                           ITER
 Science                   Council               TBM
    and                                        Program
Technology    Management                      Committee
 Advisory       Advisory    Director           (TBM-PC)       Member
Committee      Committee    General                           Parties
  (STAC)         (MAC)                    TBP Working Group
                                              (TBP WG)

                     ITER Organization

   Domestic        Domestic                Domestic
   Agencies      ・・・
                   Agencies            ・・・ Agencies

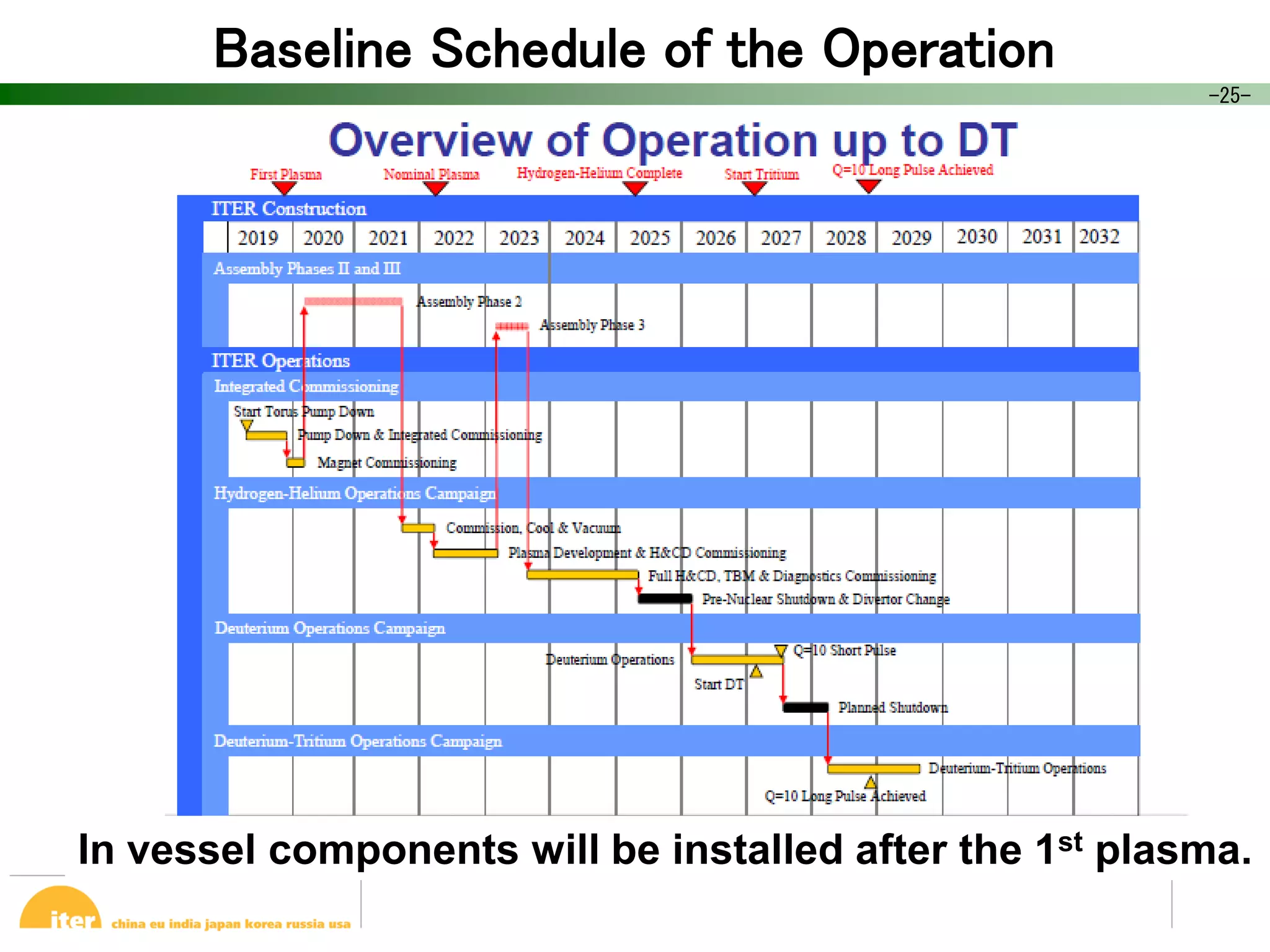

Baseline Schedule of the Operation
                                                         -25-

In vessel components will be installed after the 1st plasma.

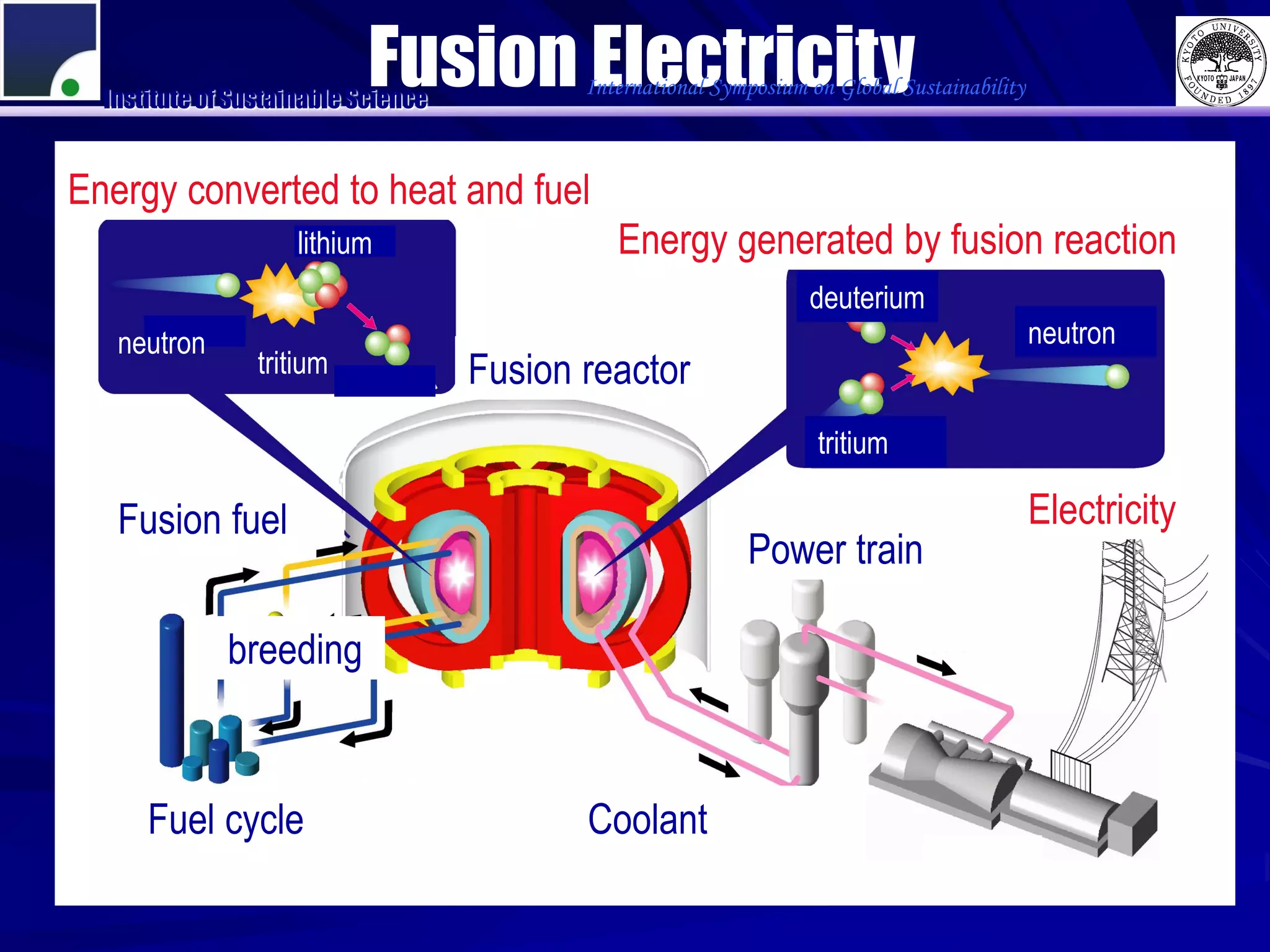

Fusion Electricity
  Institute of Sustainable Science
                                            International Symposium on Global Sustainability

Energy converted to heat and fuel
                     lithium                   Energy generated by fusion reaction
                                                                    deuterium
   neutron                                                                                     neutron
                 tritium             Fusion reactor
                                                                     tritium

   Fusion fuel                                                                                 Electricity
                                                             Power train

              breeding

      Fuel cycle                            Coolant

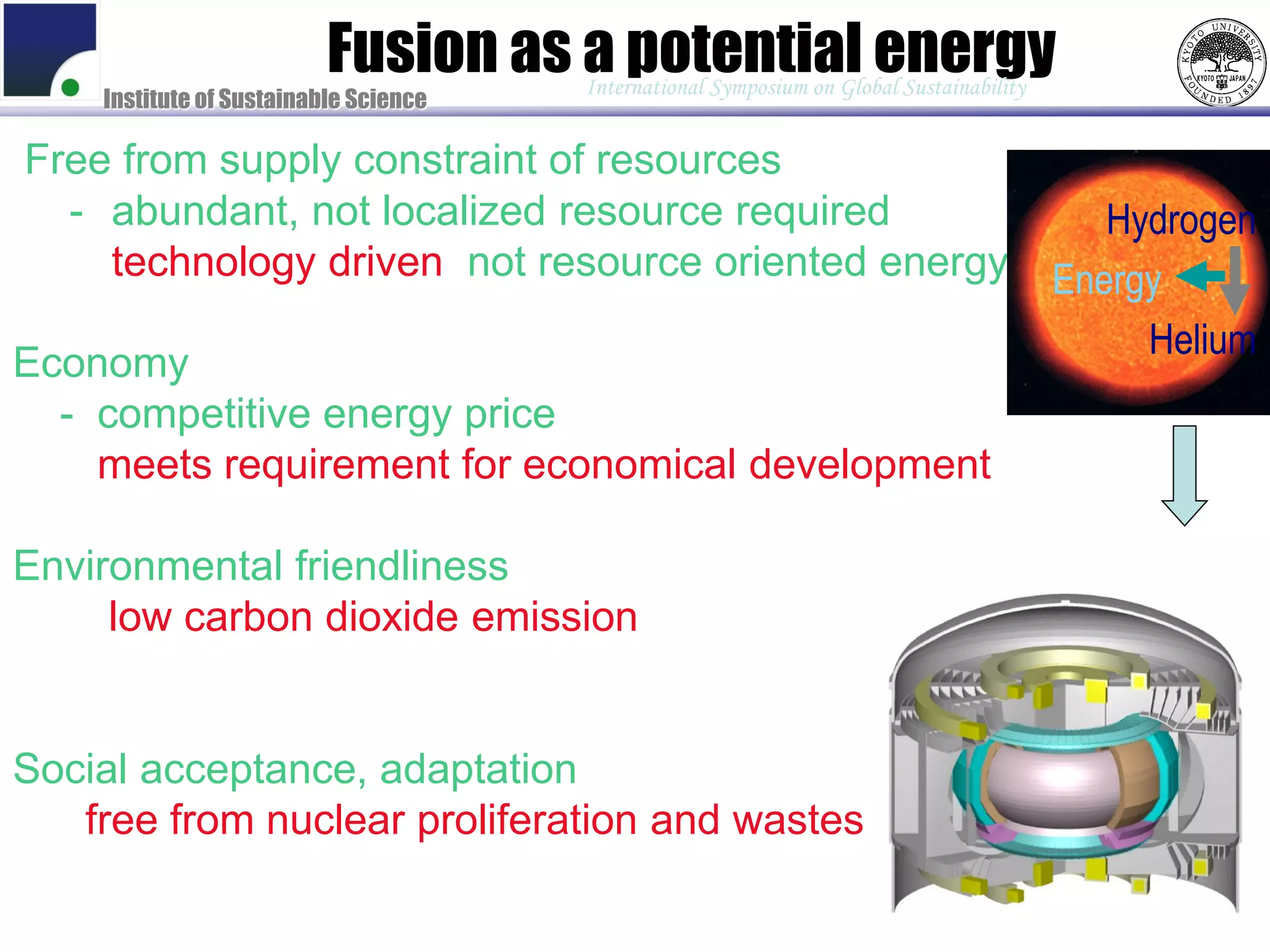

Fusion as a potential energy
                                       International Symposium on Global Sustainability
    Institute of Sustainable Science

Free from supply constraint of resources
  - abundant, not localized resource required                                                Hydrogen
  - technology driven, not resource oriented energy                                       Energy
                                                                                               Helium
Economy
  - competitive energy price
  - meets requirement for economical development

Environmental friendliness
  - low carbon dioxide emission
  - low pollution, impact to environment

Social acceptance, adaptation
 - free from nuclear proliferation and wastes
 - meets market needs (urban demand)
 - supply fuels (hydrogen), transportation.

Advanced energy technology for sustainable development. Part 2

  • 1.
    International Symposium onGlobal Sustainability Institute of Sustainable Science Advanced energy technology for sustainable development - Analysis of energy for sustainability- Satoshi Konishi Institute for Sustainability Science, Institute of Advanced Energy, Kyoto University Aug.12-13, 2011 Summer School AACIMP-2011 Kiev Polytechnique Institute, Ukraine
  • 2.
    3.What is fusion? ー Fusion reaction ー Plasma ー Confinement ー Status of development Acknowledgement to JAEA.
  • 3.
    Fusion: Energy ofthe Sun Institute of Sustainable Science International Symposium on Global Sustainability Reaction in the sun temperature:1,5million degree time:10 billion yen fuel:hydrogen (proton helium ヘ リ ウ ム proton 陽 子 fusion 核融合 neutron 中 性 子 Artifitial sun proton 陽 子 陽 電 子 positron temperature:200 million degree time:1second fuel:hydrogen isotopes Deuterium-tritium Helium neutron oil 8t fuel 1 g
  • 4.
    Reactions in stars International Symposium on Global Sustainability Institute of Sustainable Science −fusion by gravity− Proton reactions p+p ––> d + e + n + 0.42 MeV p+d ––> 3He + g + 5.49 MeV 3He + 3He ––> p + p + a +12.86 MeV gravity(108 K, 105 g/cm3) Herium burn (a + a ––> ) In the Sun temperature:107 K (1,500万K) gravity(109 K, 2×105 g/cm3) density:150g/cm3 Carbon burn12C + 12C ––> ) ( Finally turns to iron
  • 5.
    Where does energycome from? 1 n International Symposium on Global Sustainability Institute of Sustainable Science 1p 0 2D 0 E = Dmc2 3T 3He 6 Li ●atomic number < 60 -5 5 7 Li 10 Be -5 → loss of mass 9Be 11 B 238 U 14N 4He(a) 19F 12C 27Al 107 Ag 16 O 20 59Co ●atomic number > 60 208 Ne Pb → waight gain 1 3 10 30 100 300 Atomic子 原子量 原mass 量 “Possible” reactions neutron best d+t → a+n + 17.6 MeV hydrogen d + d → 3He + n + 3.27 MeV proton deuterium tritium d+d → t +p + 4.03 MeV d + 3He → a + p + 18.34 MeV helium helium3 Alpha particle
  • 6.
    d-t reaction International Symposium on Global Sustainability Institute of Sustainable Science (1) easiest (2) Abundant fuel resource ●heavy water:limitless(sea water ~150 ppm) ●tritium:Li - n reaction (lithium in sea water 1,5M year of consumption) d + t → 4He + n n + 6Li → t + 4He (3) d-t fuel 1 gram = 8t oil equivalent
  • 7.
    How to makethe reaction International Symposium on Global Sustainability Institute of Sustainable Science 2 U 1 e  700 keV 4 0 r Z = 1 Coulomb barrier ~700 keV (classic physics) 10 r0 ~2 fm R ~5r0 D-T 1 D-3He 0.1 ~ r0 D-D 0.01 Quantum physics 、~10 keV 10 100 1000 エネルギー(keV) keV)
  • 8.
    Fire of fusion:plasma International Symposium on Global Sustainability Institute of Sustainable Science - e + solid liquid gas plasma COLD HOT plasmas TV Light ball neon
  • 9.
    Thermonuclear reaction InternationalSymposium on Global Sustainability Institute of Sustainable Science Power balance wall Confinement E ●power loss time 3 nT Ppl  (ni Ti  ne Te )  E  plasma 2 E density n ●fusion output heat 2 temperature T  Pfus n  i  v  E fus  n2 f(T) 4 efficiency η Fusion power can be recycled to heat the plasma again  pow Criteria is temperature, time and er densitynE, T
  • 10.
    Lawson criteria International Symposium on Global Sustainability Institute of Sustainable Science − energy in =energy out −  = 11 を仮定 = を仮 定 1023 Fusion energy = power needed to heat plasma 1022 T ~ 10 keV (100 Million℃) n ~ 1020 m-3 1021 D-D E (confinement time)~ 1 s  1020 Current status 1 eV = 約 10,000 ℃ D-T 1019 1 10 100
  • 11.
    Institute of SustainableScience Trapping particles International Symposium on Global Sustainability Thermal movement Strong magnetic field 1,000km vessel needed Particles are trapped by the magnetic lines Movement of ion and Particles can fly along the line electron
  • 12.
    Plasma confinement International Symposium on Global Sustainability Institute of Sustainable Science All the magnetic lines connected Magnetic field in “donut “shape B Tokamak field traps particles Plasma current makes field
  • 13.
    How tokamak ismade International Symposium on Global Sustainability Institute of Sustainable Science Tokamak coil Current in the coil Current in the plasma Helical magnetic lines current
  • 14.
    TOKAMAK International Symposium on Global Sustainability Institute of Sustainable Science Toroidal ル 磁 場 コ イ ル ト ロ イ ダ field coil Poroidal field ポロ イ ダル 磁場コ イ ル coil Vacuum vessel 真空容器 Plasmaマ プラ ズ プ Plasma current ラ ズマ 電流 Magnetic field 磁力線 toroidalnaya kamera and magnitnaya katushka
  • 15.
    Confinement devices International Symposium on Global Sustainability Institute of Sustainable Science Helical magnetic lines confine plasma Tokamak Plasma current makes fields to confine itself JAEA、JT60 Helical Helical coil makes fields to confine Kyoto University, Heliotron J
  • 16.
    Fusion plasma Institute ofSustainable Science International Symposium on Global Sustainability Torus chamber Thermal insulation Keeps inside hot plasma
  • 17.
    Plasma movement Institute ofSustainable Science International Symposium on Global Sustainability
  • 18.
    Plasma movement Institute ofSustainable Science International Symposium on Global Sustainability Numerical simulation is needed to “see” it. As particles As fluids
  • 20.
    4.Fusion development and its possible market
  • 21.
    Fusion Research inthe World International Symposium on Global Sustainability Institute of Sustainable Science Russia Korea T-10 K-STAR United States TUMAN-3 Japan Alcator C-mod JT-60,SA NSTX,DIII-D Ukraine LATE,HYBTOK-III Uragan CSTN3 ○ ○ India SST1 EU JET,Tore-Supra ASDEX-U,TEXTOR China FT-U,MAST,W7 EAST,HL-2A, HT-7,HT-7U Asian countries are now strongly interested in fusion.
  • 22.
    Fusion Energy Development Institute of Sustainable Science International Symposium on Global Sustainability 1980 2000 2020 2040 2060 CDA88-90 International Thermonuclear Experimental Reactor ★ ★ ★ ★ ★ ★ ★ ★ ★ ★★ ★ EDA 92-01 Const.Oper.. . Blanket test Competition to demonstrate Fusion power US-USSR 1985 30 m DEMO reactor Targetted to 2050 comercialization →demonstration scheduled 203 EU fast track ca. 5BUS Environmental problem requires faster ITERconstruction site(2010) program.
  • 23.
    Expectations for Fusion International Symposium on Global Sustainability Institute of Sustainable Science ・Fusion has advantages to sell. ・But electricity (particularly cheap one) is not the unique product of fusion. ・Expected role and feature of fusion is different among parties. EU ・Resource (particularly self-sufficiency) US ・Safety (over fission?) KO ・environment (reduction of CO2 emission) CH -replacing Oil, not nuclear or renewables IN ・Large amount of supply to meet demands JA ・Proliferation Other ・Economy parties Plant (Demo?) design Fission acceptance Nuclear infrastructure
  • 24.
    Structure of theInternational collaboration ITER Science Council TBM and Program Technology Management Committee Advisory Advisory Director (TBM-PC) Member Committee Committee General Parties (STAC) (MAC) TBP Working Group (TBP WG) ITER Organization Domestic Domestic Domestic Agencies ・・・ Agencies ・・・ Agencies
  • 25.
    Baseline Schedule ofthe Operation -25- In vessel components will be installed after the 1st plasma.
  • 26.
    Fusion Electricity Institute of Sustainable Science International Symposium on Global Sustainability Energy converted to heat and fuel lithium Energy generated by fusion reaction deuterium neutron neutron tritium Fusion reactor tritium Fusion fuel Electricity Power train breeding Fuel cycle Coolant
  • 27.
    Fusion as apotential energy International Symposium on Global Sustainability Institute of Sustainable Science Free from supply constraint of resources - abundant, not localized resource required Hydrogen - technology driven, not resource oriented energy Energy Helium Economy - competitive energy price - meets requirement for economical development Environmental friendliness - low carbon dioxide emission - low pollution, impact to environment Social acceptance, adaptation - free from nuclear proliferation and wastes - meets market needs (urban demand) - supply fuels (hydrogen), transportation.
