Expenditure some topics

  1. 1. 2 By M.Nageswara Rao, Sr.SO(A)/SC

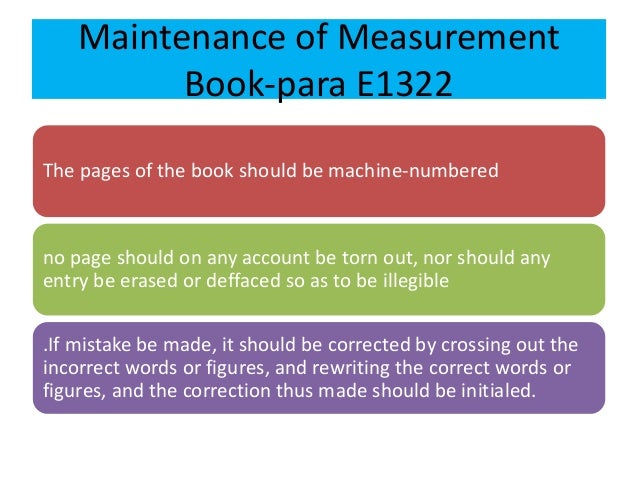

  2. 2. Maintenance of Measurement Book-para E1322 The pages of the book should be machine-numbered no page should on any account be torn out, nor should any entry be erased or deffaced so as to be illegible .If mistake be made, it should be corrected by crossing out the incorrect words or figures, and rewriting the correct words or figures, and the correction thus made should be initialed.

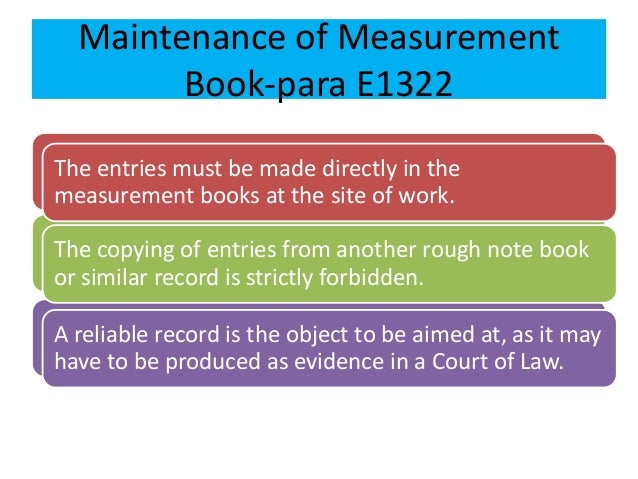

  3. 3. Maintenance of Measurement Book-para E1322 The entries must be made directly in the measurement books at the site of work. The copying of entries from another rough note book or similar record is strictly forbidden. A reliable record is the object to be aimed at, as it may have to be produced as evidence in a Court of Law. The entries must be made directly in the measurement books at the site of work. The copying of entries from another rough note book or similar record is strictly forbidden. A reliable record is the object to be aimed at, as it may have to be produced as evidence in a Court of Law.
  4. 4. Maintenance of Measurement Book-para E1323 The entries in the measurement book should, if possible be made in ink, but when this is not possible, the entries should be recorded with indelible or special copying pencil so as to render it difficult to tamper The entries in the "contents or area" column should, however, be invariably made in ink.

  5. 5. Maintenance of Measurement Book-para E1324 • Entries should be recorded continuously in the measurement book. • No blank pages should be left nor should any page be torn out, the cancellation being attested. •When any measurements are cancelled, the cancellation should be supported by the dated initials of the officer along with the reason for cancellation.

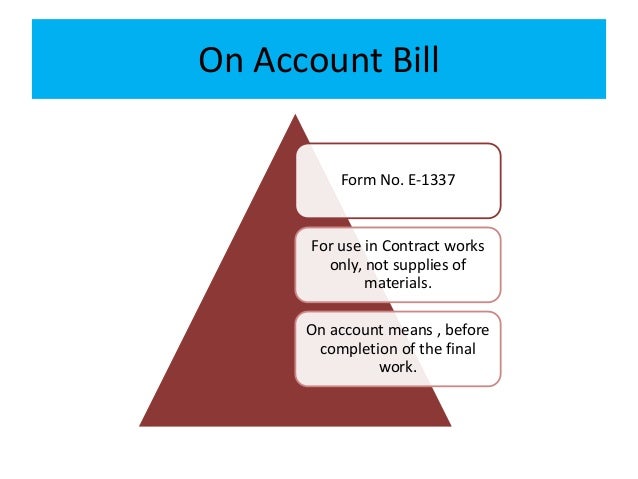

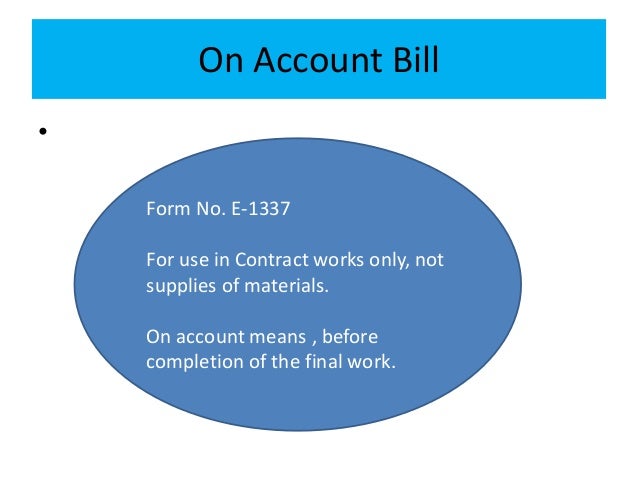

  6. 6. On Account Bill Form No. E-1337 For use in Contract works only, not supplies of materials. On account means , before completion of the final work.
  7. 7. On Account Bill • Form No. E-1337 For use in Contract works only, not supplies of materials. On account means , before completion of the final work.

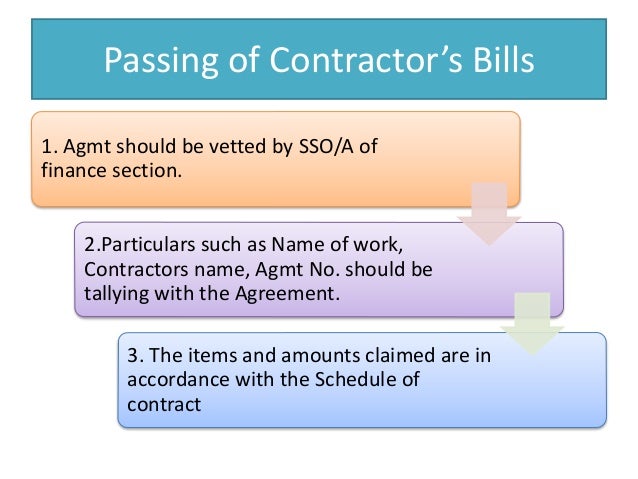

  8. 8. Passing of Contractor’s Bills 1. Agmt should be vetted by SSO/A of finance section. 2.Particulars such as Name of work, Contractors name, Agmt No. should be tallying with the Agreement. 3. The items and amounts claimed are in accordance with the Schedule of contract
  9. 9. Passing of Contractor’s Bills 4.The measurement Book and the Bills are verified and certified by the Divn.Acct.(DA) 5. Contractor has signed duly accepting the measurements recorded. 6. Test check - The measurements recorded by the suboridnates are test checked by the Exe.Engineers.
  10. 10. Passing of Contractor’s Bills 7. Competent authority has approved and signed the Bill. 8. Necessary deductions incl: Income Tax are made in the Bill. 9. Variations in the Schedule quantity(beyond permissible limits) if any are concurred by Finance and sanctioned by Competent authority.

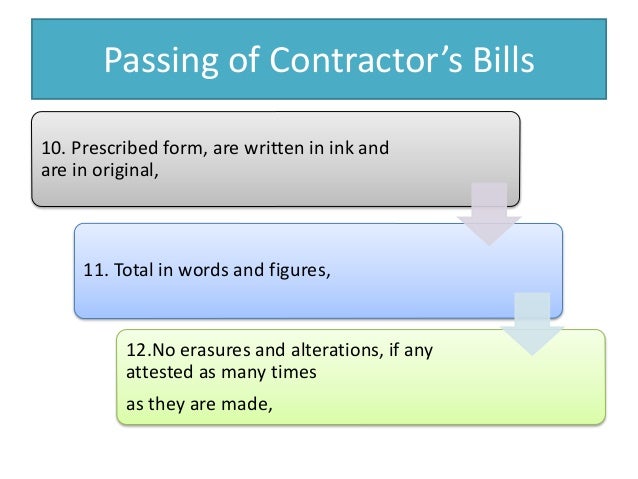

  11. 11. Passing of Contractor’s Bills 10. Prescribed form, are written in ink and are in original, 11. Total in words and figures, 12.No erasures and alterations, if any attested as many times as they are made,
  12. 12. Passing of Contractor’s Bills 13. Certify services for which payment is claimed actually rendered. 14.Correct allocation is furnished in the bill 15.Income tax deductions where applicable
  13. 13. Enclosures to the Bill Orignial W.O./P.O./Agreement/subsidary agt./MOU vetted by Finance MOS – Designation and reference of authority ie item of SOP etc. Copy of finance concurrence, wherever necessary.. Amendment to the purchase order, if any by competent authority.

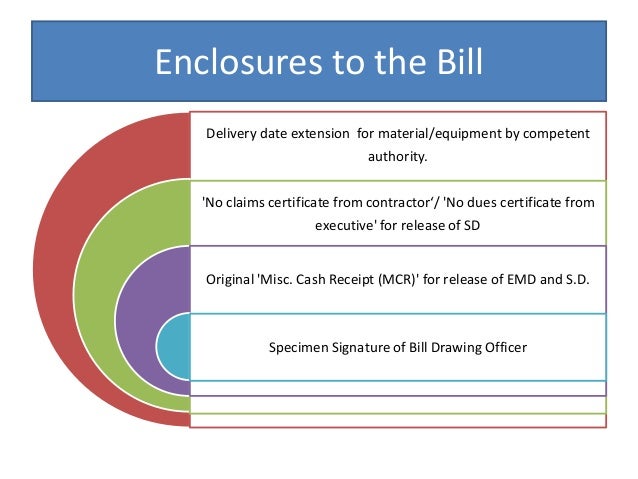

  14. 14. Enclosures to the Bill Delivery date extension for material/equipment by competent authority. 'No claims certificate from contractor‘/ 'No dues certificate from executive' for release of SD Original 'Misc. Cash Receipt (MCR)' for release of EMD and S.D. Specimen Signature of Bill Drawing Officer

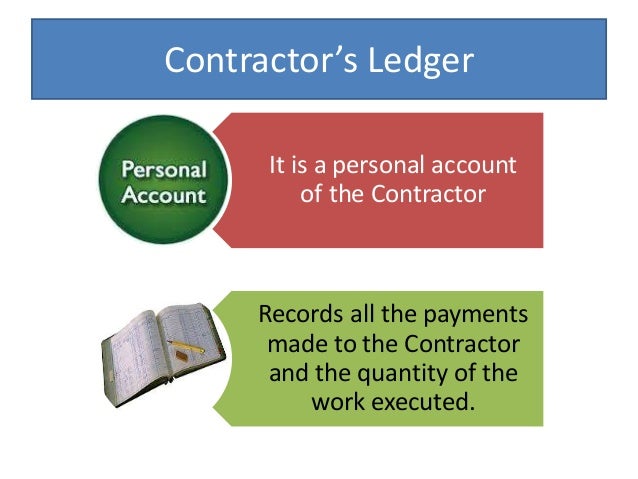

  15. 15. Contractor’s Ledger It is a personal account of the Contractor Records all the payments made to the Contractor and the quantity of the work executed.

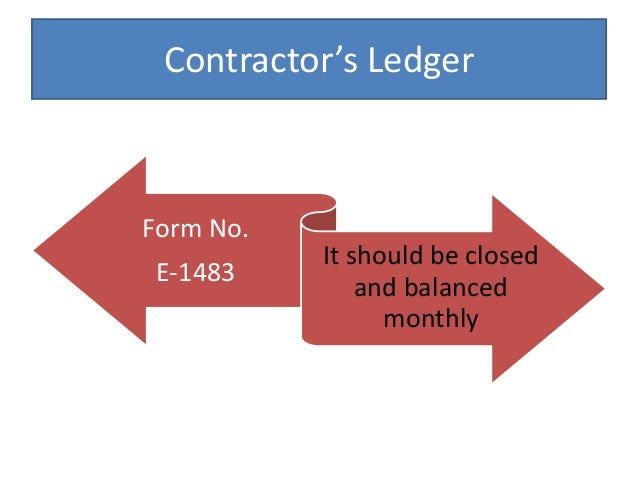

  16. 16. Contractor’s Ledger Form No. E-1483 It should be closed and balanced monthly

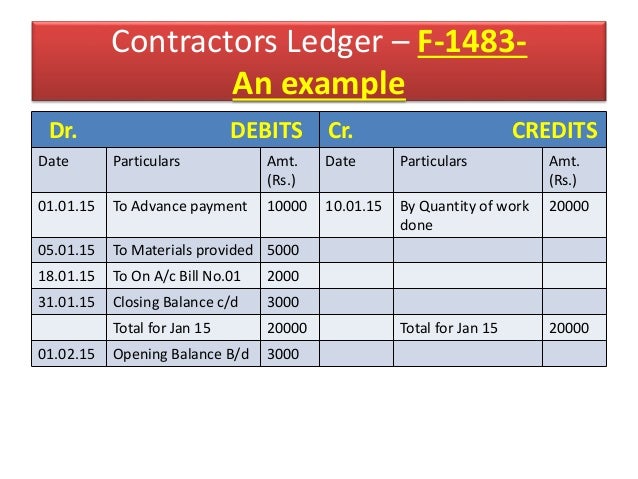

  17. 17. Contractors Ledger – F-1483- An example Dr. DEBITS Cr. CREDITS Date Particulars Amt. (Rs.) Date Particulars Amt. (Rs.) 01.01.15 To Advance payment 10000 10.01.15 By Quantity of work done 20000 05.01.15 To Materials provided 5000 18.01.15 To On A/c Bill No.01 2000 31.01.15 Closing Balance c/d 3000 Total for Jan 15 20000 Total for Jan 15 20000 01.02.15 Opening Balance B/d 3000

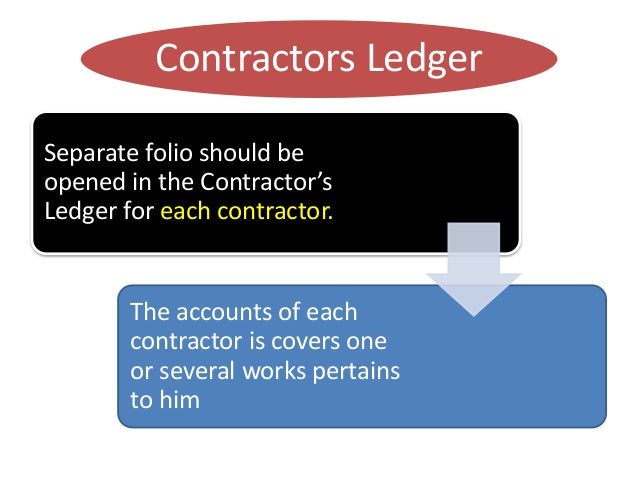

  18. 18. Contractors Ledger Separate folio should be opened in the Contractor’s Ledger for each contractor. The accounts of each contractor is covers one or several works pertains to him

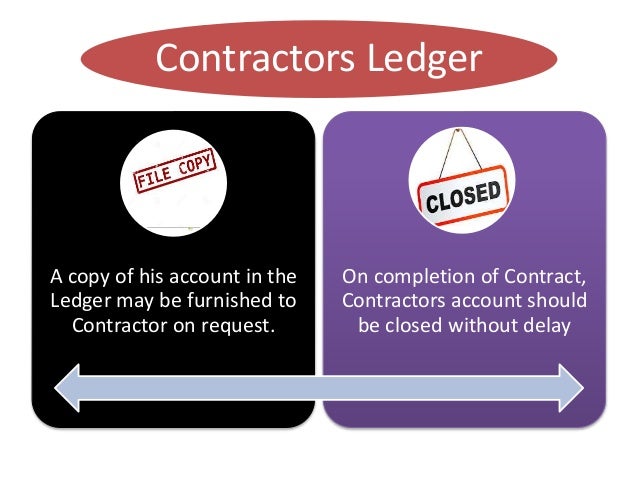

  19. 19. Contractors Ledger A copy of his account in the Ledger may be furnished to Contractor on request. On completion of Contract, Contractors account should be closed without delay

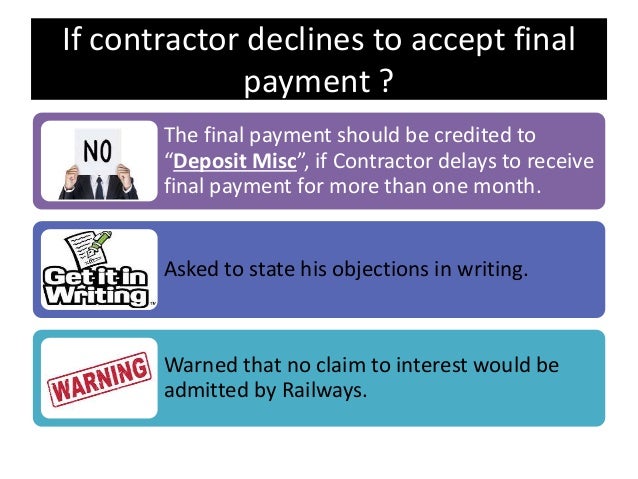

  20. 20. If contractor declines to accept final payment ? The final payment should be credited to “Deposit Misc”, if Contractor delays to receive final payment for more than one month. Asked to state his objections in writing. Warned that no claim to interest would be admitted by Railways.
  21. 21. If contractor declines to accept final payment ? The objections raised or claims put forward by contractors should be investigated and settled with reasonable period. If investigation is prolonged due to obstructive tactics on part of contractor, railways should refer the matter to arbitration as provided in the Contracts.
  22. 22. Works Register Objects Control of Expenditure w.r.t Estimates Budgetary control by comparison between Grant allotted and expenditure incurred To spot any material modification occurred
  23. 23. Works Register - Is a collective record of expenditure At the end of every month, the register should be totalled up the 1.Monthly 2. yearly & 3. “Up-to – date” totals for each work struck.
  24. 24. Works Register - Form No – E-1473 At the end of every month, the register should be totalled up the 1.Monthly 2. yearly & 3. “Up-to –date” totals for each work struck.
  25. 25. Works Register Last column always “TOTAL CHARGES” Last but one column always “ Value of materials recd. In advance of payment to Contractors”
  26. 26. Works Register Last column but two will show the value of the “Materials at site” Last column but three will show” advance payment for supply of materials”
  27. 27. Works Register – F-1473 – pro forma • Form E.1473 • .............................Railway • WORKS REGISTER • Name of work ............... • Authority ................……. • Capital........... .Rs. case……………Rs…………. Budget allotment for the year • Depreciation Fund.............................Rs. Stores.................. Rs. Original Estimate No………….. • Development Fund .......................... Rs. Total ....................Rs. Revised Estimate No.... • Accident Compensation............................ • Passenger Amenities Fund ................... ...... • Open Line Works Revenue ................ • Revenue ................. Rs.
  28. 28. Works Register – F-1473 – pro forma Date of Commencement__________________ Date of completion _____________________ Items of Estimate Head of Accounts Date No. of Vr.. Particu lars Amt. Amt. Amt Capital DRF DF Rev. Advance payment for supply of materials. Materials at site Value of materials received in advance of payment of contractor Total Charge s

×
