Watkins School Modernization Community (November 17, 2015)

XXX

  • Be the first to comment

  • Be the first to like this

Watkins School Modernization Community (November 17, 2015)

  1. 1. District   of   Columbia   Public   Schools     |     1200   First   Street,   NE   |   Washington,   DC   20002   |   T   202.442.4800   |   F   202.442.5517   |   www.k12.dc.us       Watkins                                                       Community  MeeJng     November  17,  2015

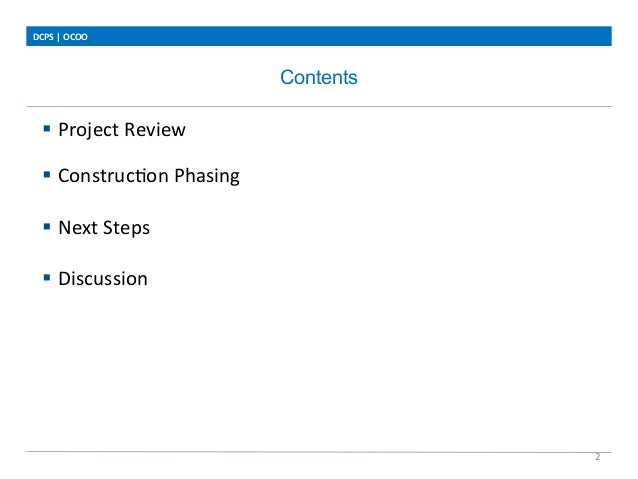

  2. 2. Contents DCPS  |  OCOO   2   §  Project  Review   §  ConstrucJon  Phasing   §  Next  Steps   §  Discussion

  3. 3. Project Overview DCPS  |  OCOO   3   §  Start  Date:    June  2016   §  End  Date:    August  2017     §  Watkins  Elementary  will  receive  a  complete  modernizaJon  to  serve   students  in  grades  1  through  5.     §  All  of  the  classrooms  will  be  “right-­‐sized”  and  upgraded  to  meet   21st  Century  EducaJonal  standards.     §  Windows  were  replaced  during  Summer  2016
  4. 4. Single-Loaded Corridor With Commons DCPS  |  OCOO   4
  5. 5. Modernized Classrooms DCPS  |  OCOO   5
  6. 6. New Gym and Cafeteria Spaces DCPS  |  OCOO   6
  7. 7. ConstrucJon  Phasing

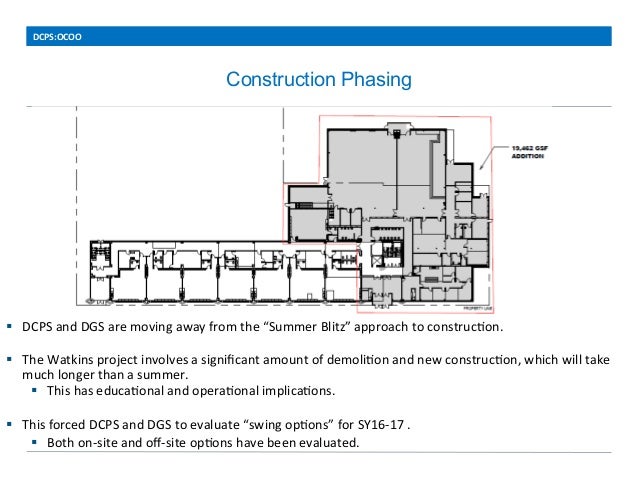

  8. 8. Construction  Phasing   §  DCPS  and  DGS  are  moving  away  from  the  “Summer  Blitz”  approach  to  construcJon.       §  The  Watkins  project  involves  a  significant  amount  of  demoliJon  and  new  construcJon,  which  will  take   much  longer  than  a  summer.   §  This  has  educaJonal  and  operaJonal  implicaJons.     §  This  forced  DCPS  and  DGS  to  evaluate  “swing  opJons”  for  SY16-­‐17  .   §  Both  on-­‐site  and  off-­‐site  opJons  have  been  evaluated.   DCPS:OCOO

  9. 9. Evaluating Swing Options DCPS  |  OCOO   9   §  Evaluated  pros  and  cons  of  swinging  on-­‐site  and  swinging  off-­‐ site   §  Criteria:   1.  Impact  on  educaJonal  environment  and  school  operaJons   2.  Impact  on  student  and  teacher  quality  of  life   3.  Impact  on  school  community  and  logisJcs   4.  Proximity  of  off-­‐site  swing  opJons   5.  Costs  and  impact  on  overall  project  budget.

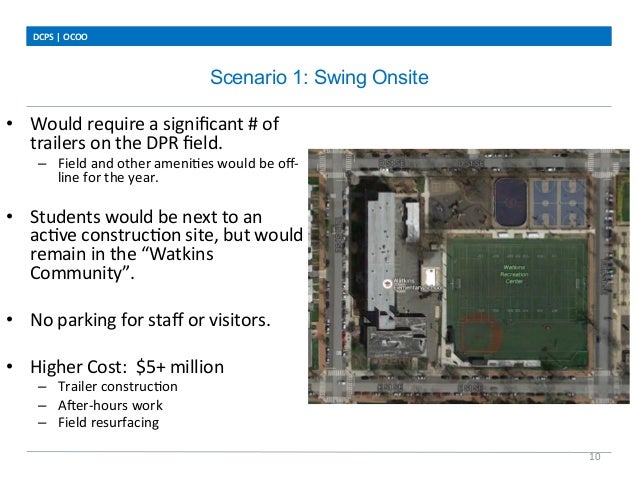

  10. 10. Scenario 1: Swing Onsite DCPS  |  OCOO   10   •  Would  require  a  significant  #  of   trailers  on  the  DPR  field.   –  Field  and  other  ameniJes  would  be  off-­‐ line  for  the  year.     •  Students  would  be  next  to  an   acJve  construcJon  site,  but  would   remain  in  the  “Watkins   Community”.     •  No  parking  for  staff  or  visitors.     •  Higher  Cost:    $5+  million   –  Trailer  construcJon   –  Aeer-­‐hours  work   –  Field  resurfacing

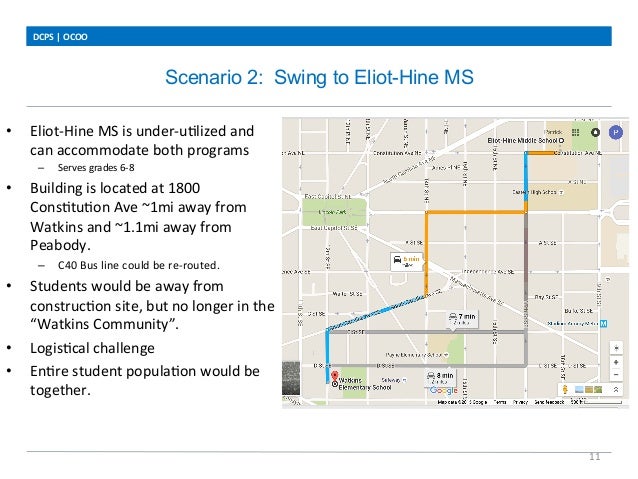

  11. 11. Scenario 2: Swing to Eliot-Hine MS DCPS  |  OCOO   11   •  Eliot-­‐Hine  MS  is  under-­‐uJlized  and   can  accommodate  both  programs   –  Serves  grades  6-­‐8   •  Building  is  located  at  1800   ConsJtuJon  Ave  ~1mi  away  from   Watkins  and  ~1.1mi  away  from   Peabody.   –  C40  Bus  line  could  be  re-­‐routed.   •  Students  would  be  away  from   construcJon  site,  but  no  longer  in  the   “Watkins  Community”.   •  LogisJcal  challenge   •  EnJre  student  populaJon  would  be   together.

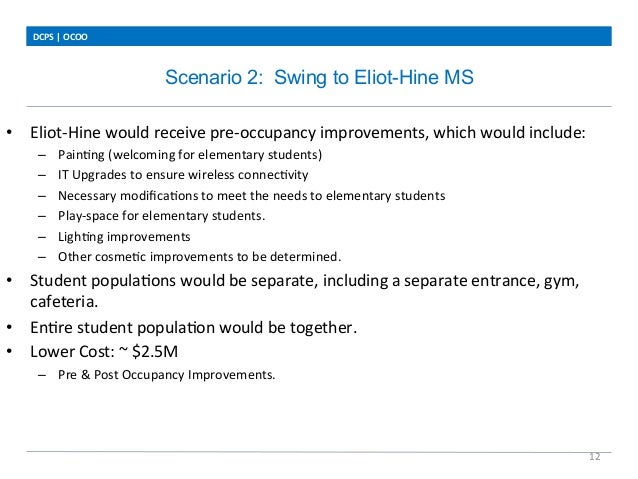

  12. 12. Scenario 2: Swing to Eliot-Hine MS DCPS  |  OCOO   12   •  Eliot-­‐Hine  would  receive  pre-­‐occupancy  improvements,  which  would  include:   –  PainJng  (welcoming  for  elementary  students)   –  IT  Upgrades  to  ensure  wireless  connecJvity   –  Necessary  modificaJons  to  meet  the  needs  to  elementary  students   –  Play-­‐space  for  elementary  students.   –  LighJng  improvements     –  Other  cosmeJc  improvements  to  be  determined.   •  Student  populaJons  would  be  separate,  including  a  separate  entrance,  gym,   cafeteria.   •  EnJre  student  populaJon  would  be  together.   •  Lower  Cost:  ~  $2.5M   –  Pre  &  Post  Occupancy  Improvements.

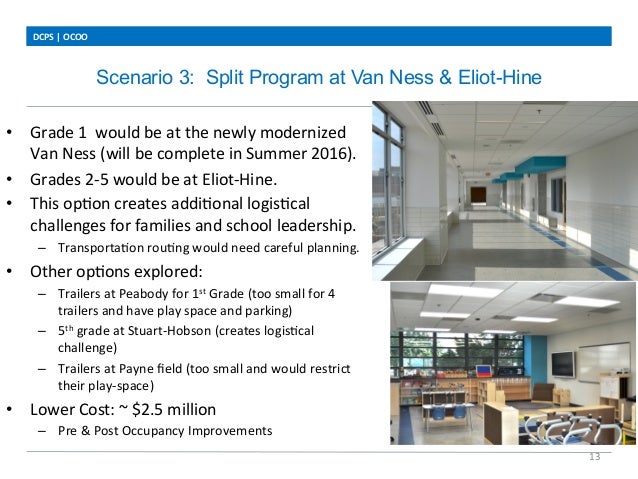

  13. 13. Scenario 3: Split Program at Van Ness & Eliot-Hine DCPS  |  OCOO   13   •  Grade  1    would  be  at  the  newly  modernized   Van  Ness  (will  be  complete  in  Summer  2016).   •  Grades  2-­‐5  would  be  at  Eliot-­‐Hine.   •  This  opJon  creates  addiJonal  logisJcal   challenges  for  families  and  school  leadership.   –  TransportaJon  rouJng  would  need  careful  planning.       •  Other  opJons  explored:   –  Trailers  at  Peabody  for  1st  Grade  (too  small  for  4   trailers  and  have  play  space  and  parking)   –  5th  grade  at  Stuart-­‐Hobson  (creates  logisJcal   challenge)   –  Trailers  at  Payne  field  (too  small  and  would  restrict   their  play-­‐space)   •  Lower  Cost:  ~  $2.5  million   –  Pre  &  Post  Occupancy  Improvements

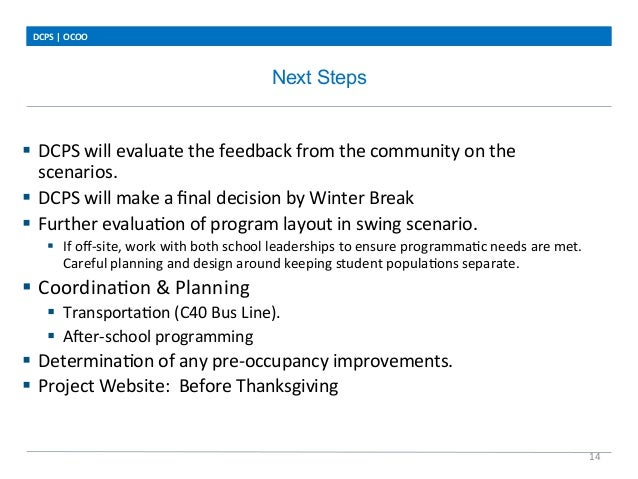

  14. 14. Next Steps DCPS  |  OCOO   14   §  DCPS  will  evaluate  the  feedback  from  the  community  on  the   scenarios.   §  DCPS  will  make  a  final  decision  by  Winter  Break   §  Further  evaluaJon  of  program  layout  in  swing  scenario.   §  If  off-­‐site,  work  with  both  school  leaderships  to  ensure  programmaJc  needs  are  met.     Careful  planning  and  design  around  keeping  student  populaJons  separate.   §  CoordinaJon  &  Planning   §  TransportaJon  (C40  Bus  Line).   §  Aeer-­‐school  programming     §  DeterminaJon  of  any  pre-­‐occupancy  improvements.   §  Project  Website:    Before  Thanksgiving
  15. 15. Contact Information DCPS  |  OCOO   15       Patrick  Davis   DCPS  Facility  Planning  and  Design   Patrick.Davis@dc.gov     Please  submit  comments  to  Patrick.Davis@dc.gov  by  December  4th.

×
