Shepherd Elementary School SIT Presentation (February 17, 2016)

XXX

  • Be the first to comment

  • Be the first to like this

Shepherd Elementary School SIT Presentation (February 17, 2016)

  1. 1. Elevating the Quality of Life in the District

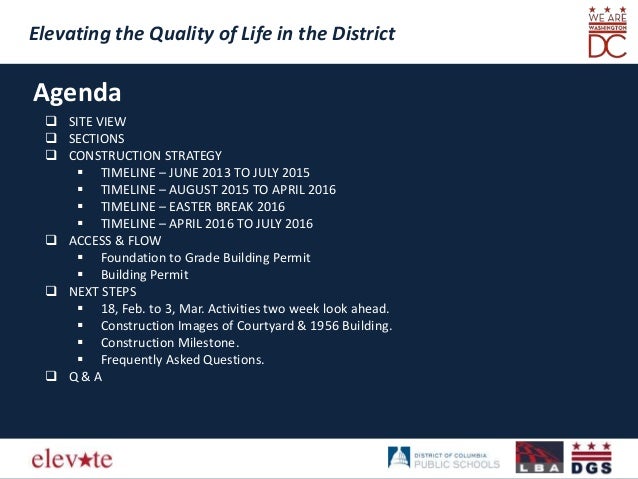

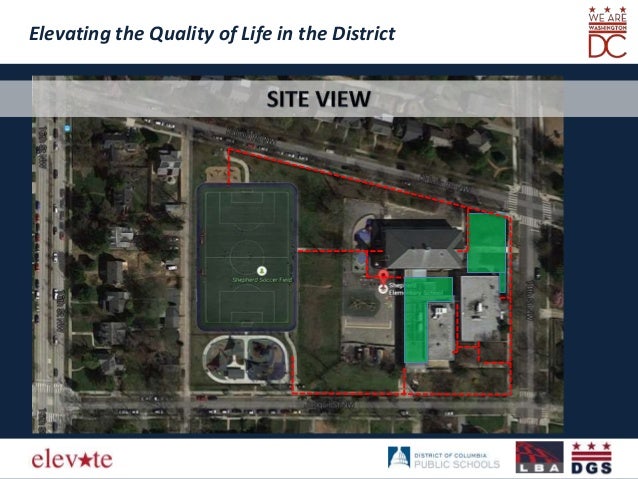

  2. 2. Agenda  SITE VIEW  SECTIONS  CONSTRUCTION STRATEGY  TIMELINE – JUNE 2013 TO JULY 2015  TIMELINE – AUGUST 2015 TO APRIL 2016  TIMELINE – EASTER BREAK 2016  TIMELINE – APRIL 2016 TO JULY 2016  ACCESS & FLOW  Foundation to Grade Building Permit  Building Permit  NEXT STEPS  18, Feb. to 3, Mar. Activities two week look ahead.  Construction Images of Courtyard & 1956 Building.  Construction Milestone.  Frequently Asked Questions.  Q & A Elevating the Quality of Life in the District

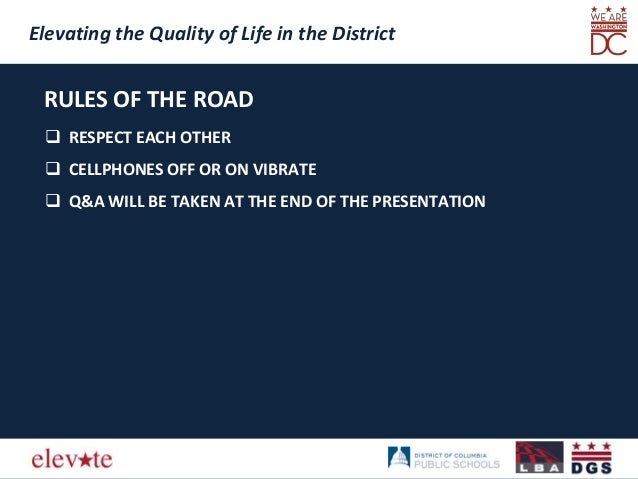

  3. 3. Elevating the Quality of Life in the District Elevating the Quality of Life in the District RULES OF THE ROAD  RESPECT EACH OTHER  CELLPHONES OFF OR ON VIBRATE  Q&A WILL BE TAKEN AT THE END OF THE PRESENTATION

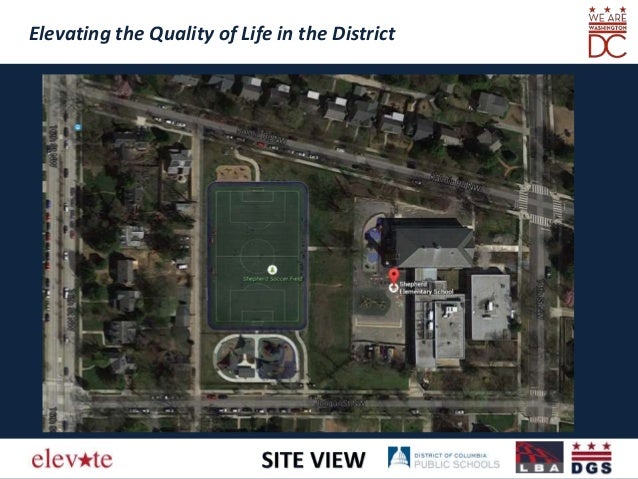

  4. 4. Elevating the Quality of Life in the District Elevating the Quality of Life in the District

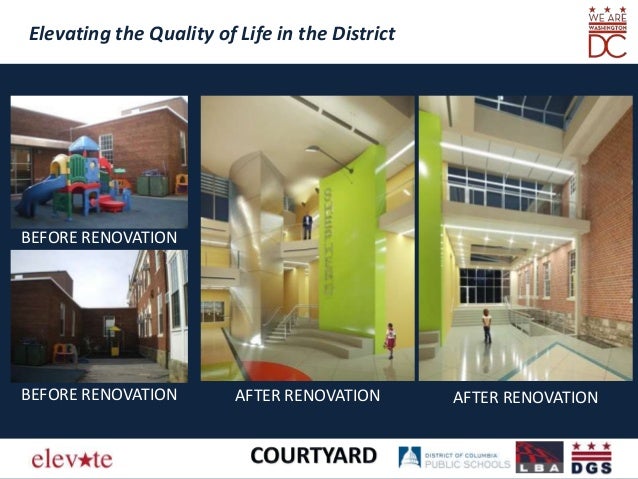

  5. 5. Elevating the Quality of Life in the District Elevating the Quality of Life in the District AFTER RENOVATION AFTER RENOVATIONBEFORE RENOVATION BEFORE RENOVATION

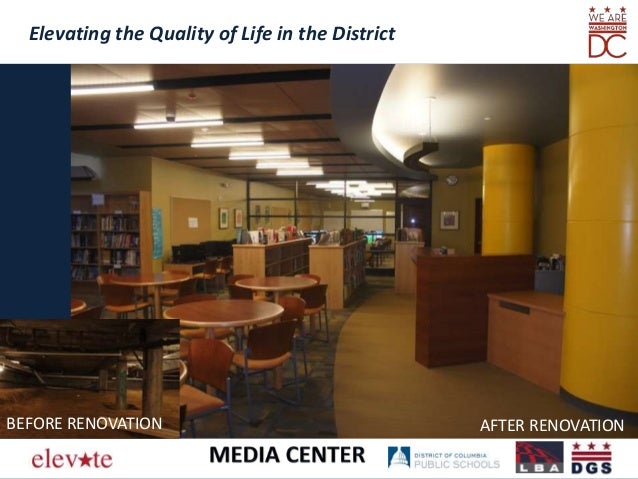

  6. 6. Elevating the Quality of Life in the District AFTER RENOVATIONBEFORE RENOVATION
  7. 7. Elevating the Quality of Life in the District BEFORE RENOVATION AFTER RENOVATION
  8. 8. Elevating the Quality of Life in the District AFTER RENOVATIONBEFORE RENOVATION
  9. 9. Elevating the Quality of Life in the District BEFORE RENOVATION AFTER RENOVATION

  10. 10. Elevating the Quality of Life in the District SECTIONS

  11. 11. Elevating the Quality of Life in the District
  12. 12. Elevating the Quality of Life in the District
  13. 13. Elevating the Quality of Life in the District CONSTRUCTION STRATEGY  TIMELINE – JUNE 2013 TO JULY 2015

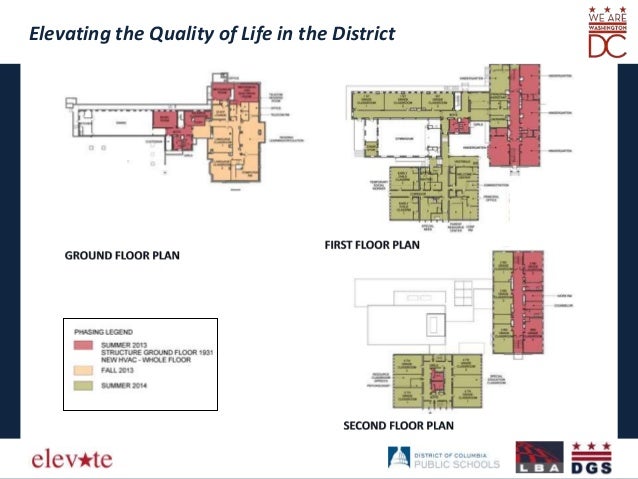

  14. 14. Elevating the Quality of Life in the District
  15. 15. Elevating the Quality of Life in the District CONSTRUCTION STRATEGY  TIMELINE – AUGUST 2015 TO APRIL 2016
  16. 16. Elevating the Quality of Life in the District Elevating the Quality of Life in the District

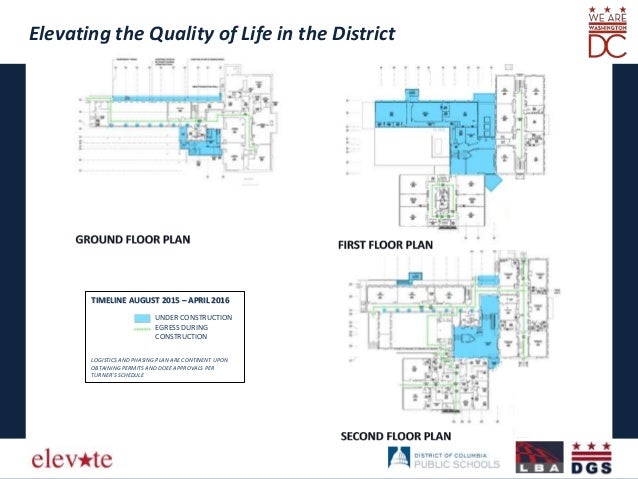

  17. 17. Elevating the Quality of Life in the District TIMELINE AUGUST 2015 – APRIL 2016 UNDER CONSTRUCTION EGRESS DURING CONSTRUCTION LOGISTICS AND PHASING PLAN ARE CONTINENT UPON OBTAINING PERMITS AND DOEE APPROVALS PER TURNER’S SCHEDULE
  18. 18. Elevating the Quality of Life in the District CONSTRUCTION STRATEGY  TIMELINE – EASTER BREAK 2016

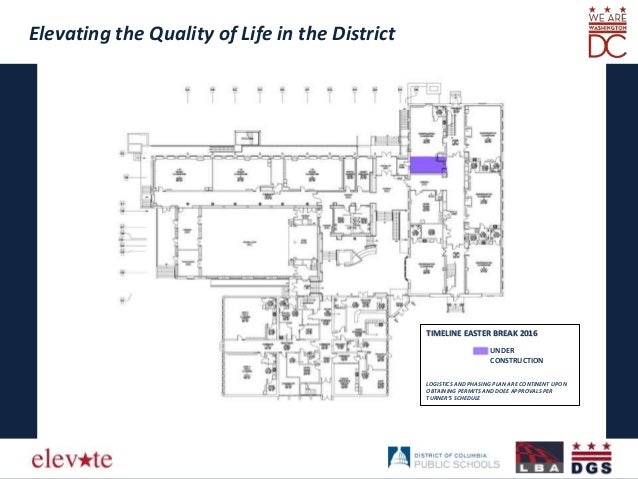

  19. 19. Elevating the Quality of Life in the District TIMELINE EASTER BREAK 2016 UNDER CONSTRUCTION LOGISTICS AND PHASING PLAN ARE CONTINENT UPON OBTAINING PERMITS AND DOEE APPROVALS PER TURNER’S SCHEDULE
  20. 20. Relocation of IT Closet 1970 Building

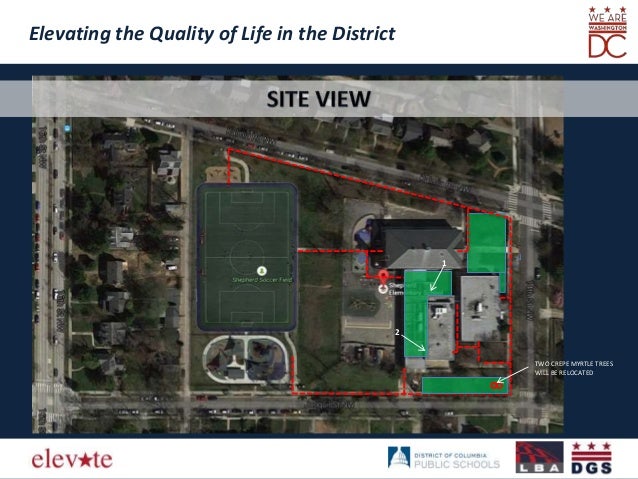

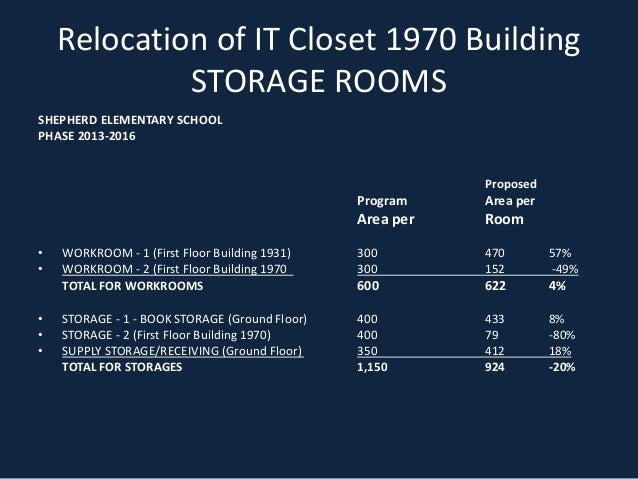

  21. 21. Relocation of IT Closet 1970 Building STORAGE ROOMS SHEPHERD ELEMENTARY SCHOOL PHASE 2013-2016 Proposed Program Area per Area per Room • WORKROOM - 1 (First Floor Building 1931) 300 470 57% • WORKROOM - 2 (First Floor Building 1970 300 152 -49% TOTAL FOR WORKROOMS 600 622 4% • STORAGE - 1 - BOOK STORAGE (Ground Floor) 400 433 8% • STORAGE - 2 (First Floor Building 1970) 400 79 -80% • SUPPLY STORAGE/RECEIVING (Ground Floor) 350 412 18% TOTAL FOR STORAGES 1,150 924 -20%

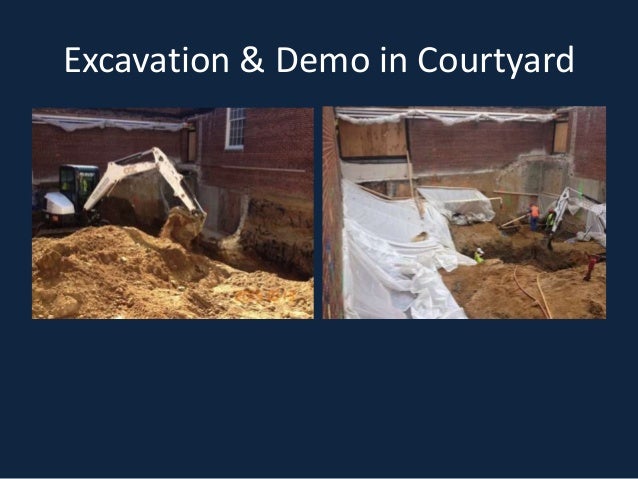

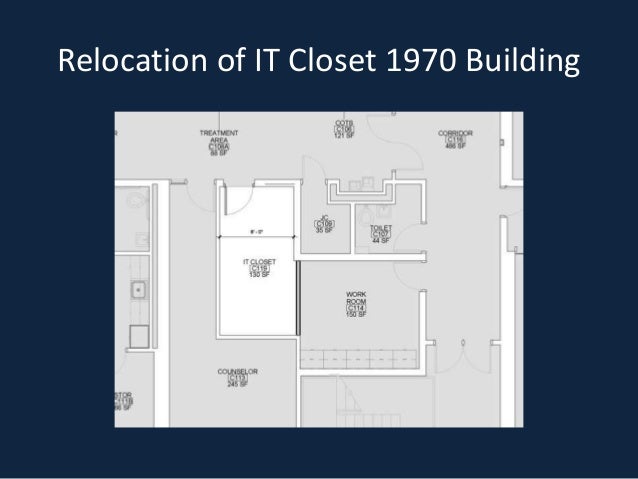

  22. 22. Relocation of IT Closet 1970 Building

  23. 23. Elevating the Quality of Life in the District CONSTRUCTION STRATEGY  TIMELINE – APRIL 2016 TO JULY 2016
  24. 24. Elevating the Quality of Life in the District

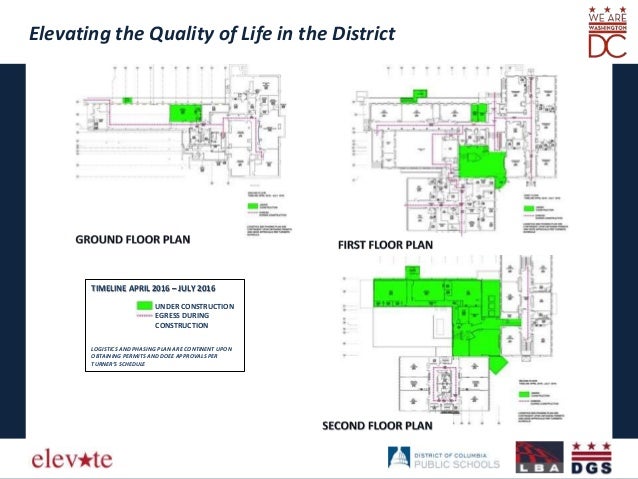

  25. 25. Elevating the Quality of Life in the District TIMELINE APRIL 2016 – JULY 2016 UNDER CONSTRUCTION EGRESS DURING CONSTRUCTION LOGISTICS AND PHASING PLAN ARE CONTINENT UPON OBTAINING PERMITS AND DOEE APPROVALS PER TURNER’S SCHEDULE
  26. 26. Elevating the Quality of Life in the District TWO CREPE MYRTLE TREES WILL BE RELOCATED 1 2
  27. 27. Excavation & Demo in Courtyard

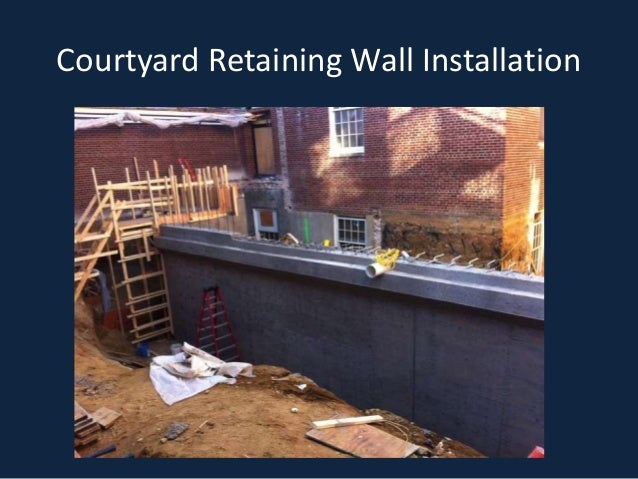

  28. 28. Excavation & Demo in Courtyard

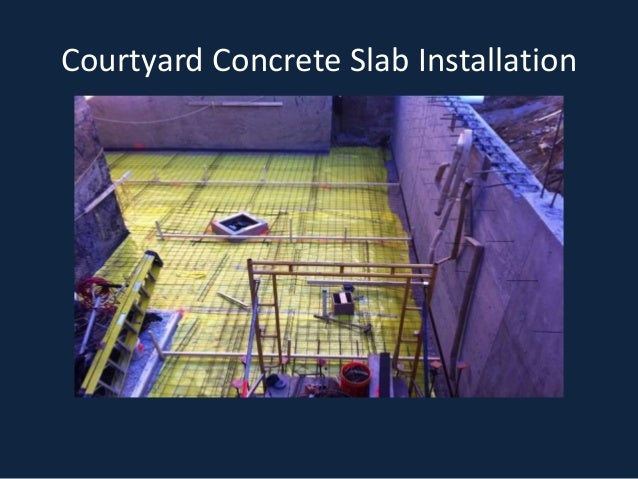

  29. 29. Excavation & Demo in Courtyard

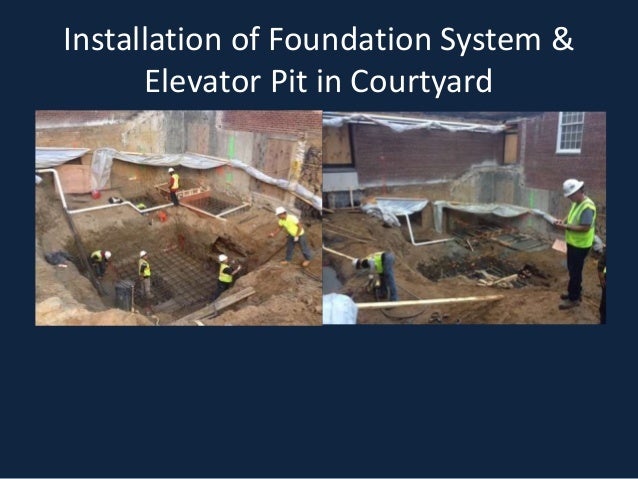

  30. 30. Installation of Foundation System & Elevator Pit in Courtyard
  31. 31. Installation of Foundation System & Elevator Pit in Courtyard

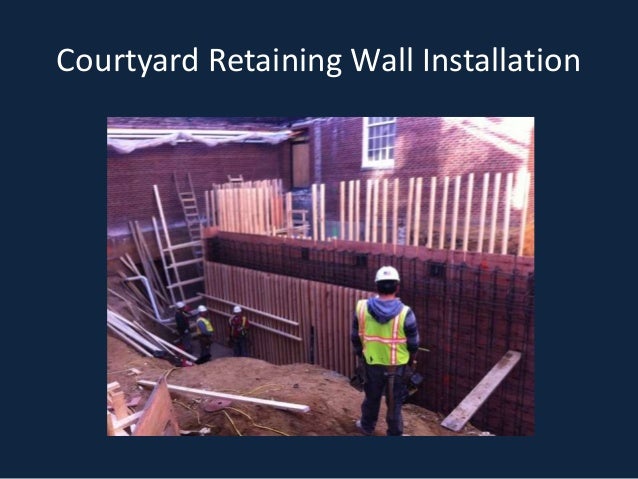

  32. 32. Courtyard Retaining Wall Installation
  33. 33. Courtyard Retaining Wall Installation

  34. 34. Courtyard Concrete Slab Installation

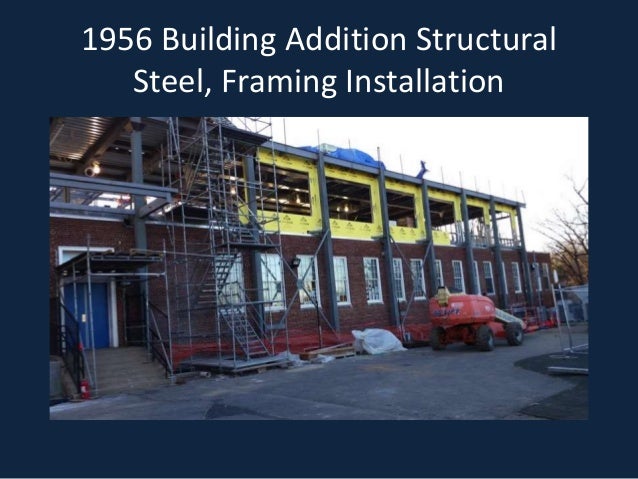

  35. 35. Erection of Structural Steel in Cafeteria & Roof of 1956 Building

  36. 36. Erection of Structural Steel in Cafeteria & Sprinkler of 1956 Building

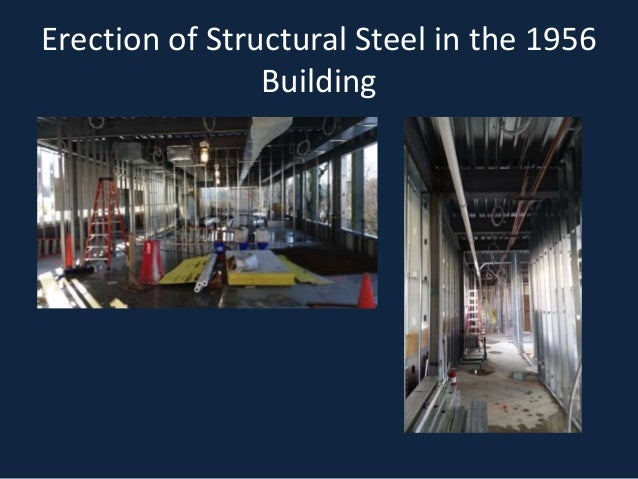

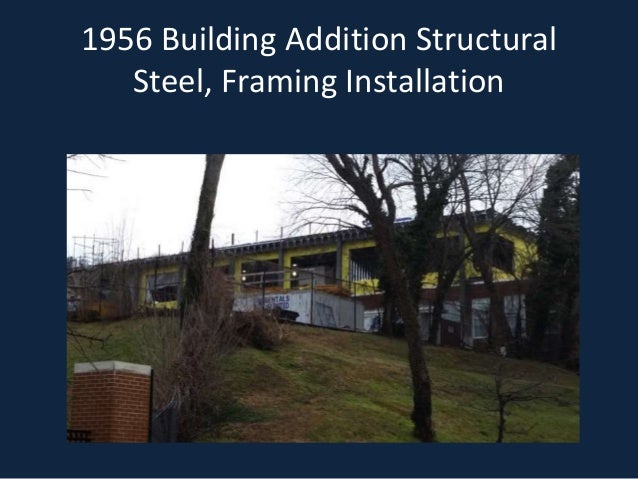

  37. 37. Erection of Structural Steel in the 1956 Building

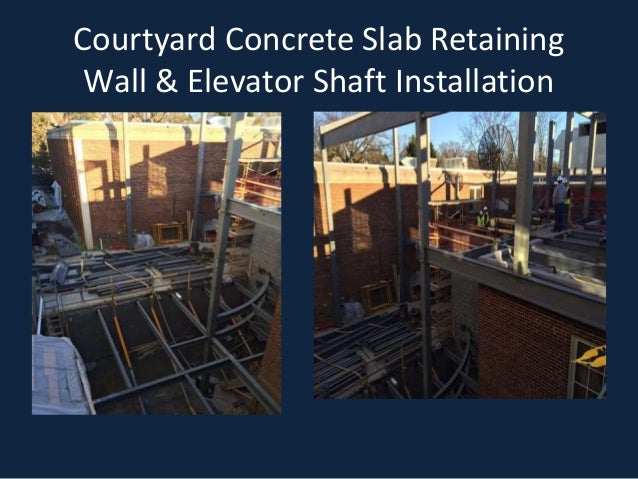

  38. 38. Courtyard Concrete Slab Retaining Wall & Elevator Shaft Installation

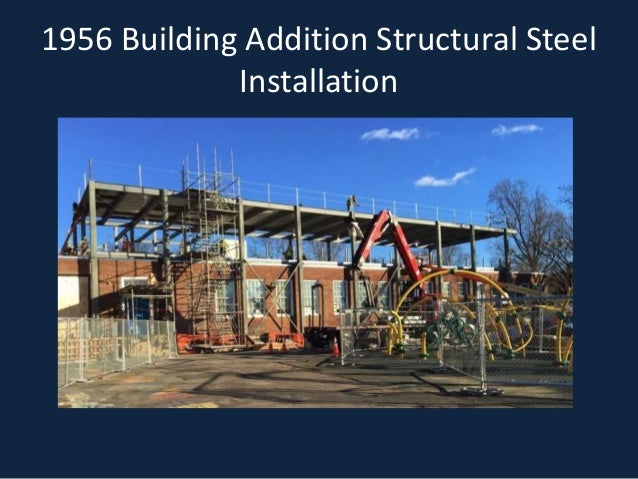

  39. 39. 1956 Building Addition Structural Steel Installation

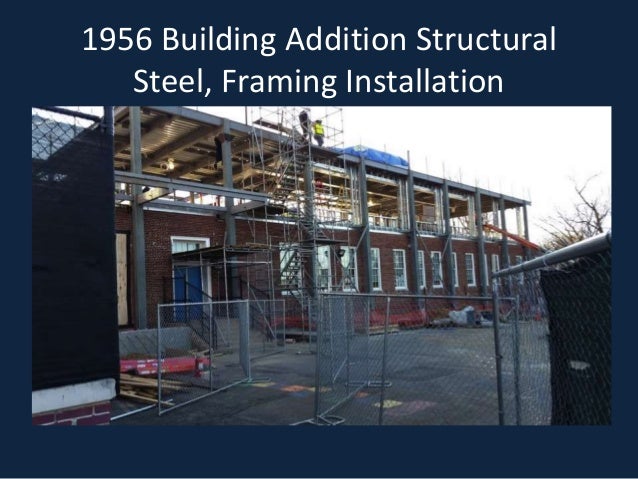

  40. 40. 1956 Building Addition Structural Steel, Framing Installation
  41. 41. 1956 Building Addition Structural Steel, Framing Installation

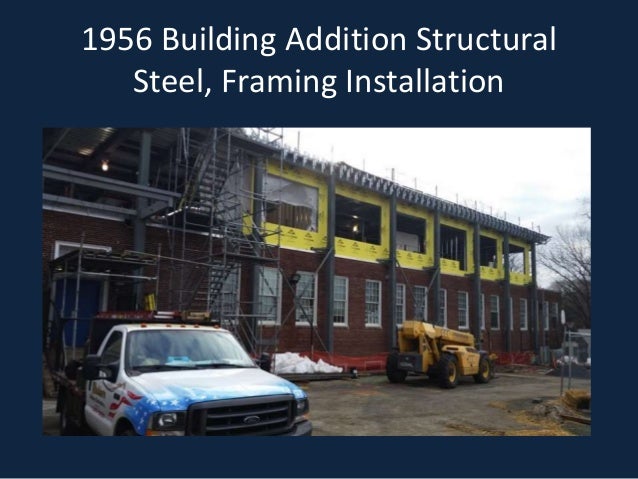

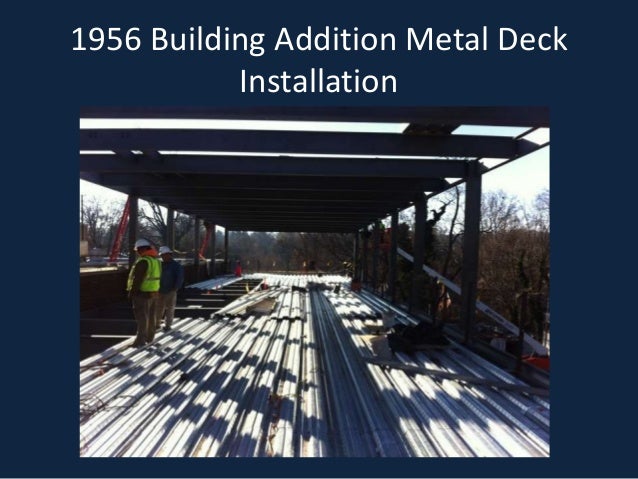

  42. 42. 1956 Building Addition Structural Steel, Framing Installation
  43. 43. 1956 Building Addition Structural Steel, Framing Installation

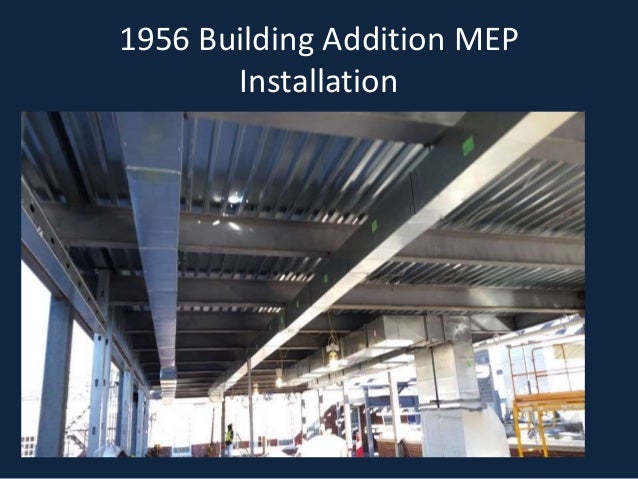

  44. 44. 1956 Building Addition Structural Steel Installation

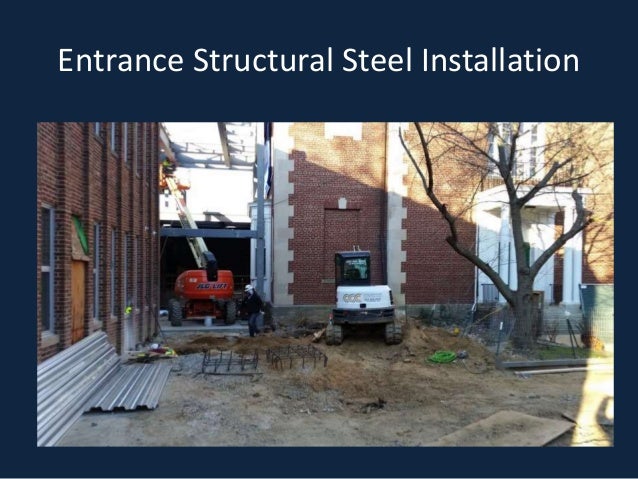

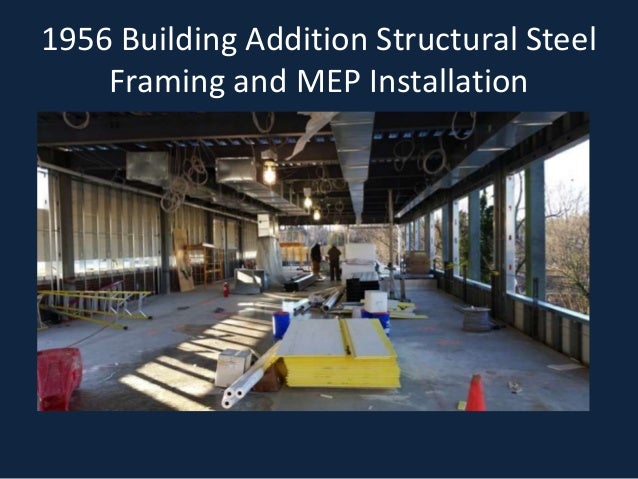

  45. 45. Entrance Structural Steel Installation

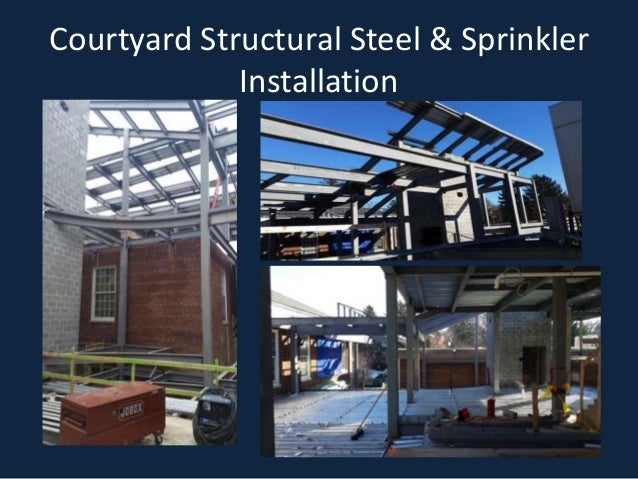

  46. 46. Courtyard Structural Steel & Sprinkler Installation

  47. 47. 1956 Building Addition Metal Deck Installation

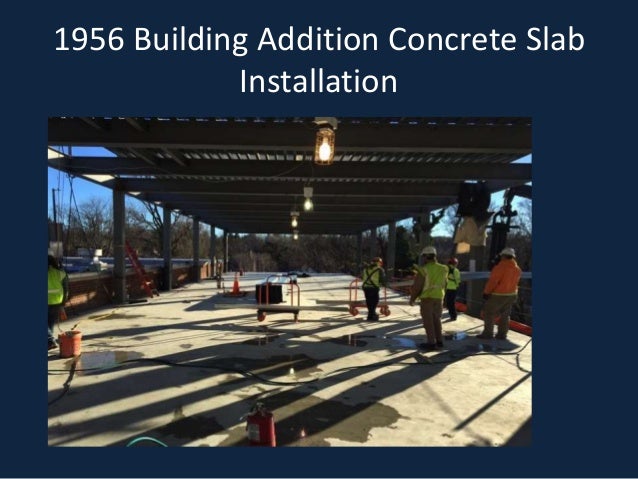

  48. 48. 1956 Building Addition Concrete Slab Installation
  49. 49. 1956 Building Addition MEP Installation
  50. 50. 1956 Building Addition Structural Steel Framing and MEP Installation
  51. 51. Courtyard Steel and Opening Installation

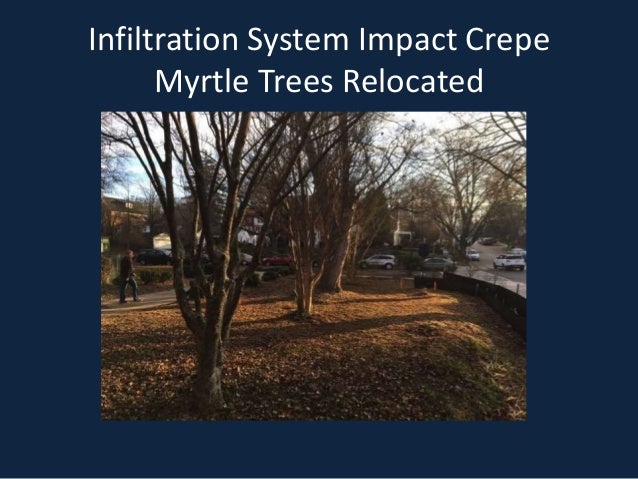

  52. 52. Courtyard Steel and Opening Installation

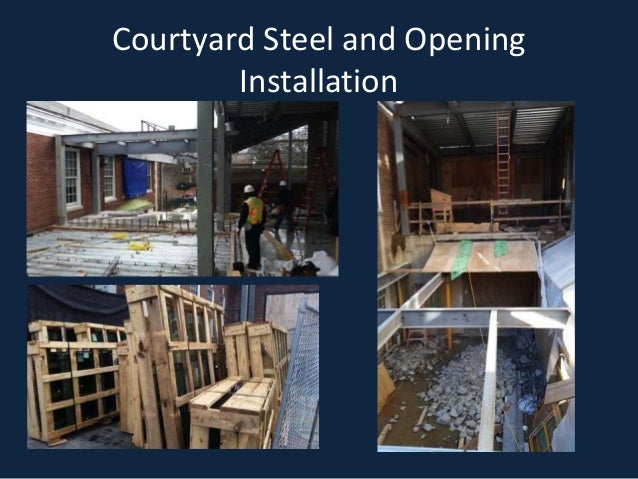

  53. 53. Courtyard Steel and Opening Installation

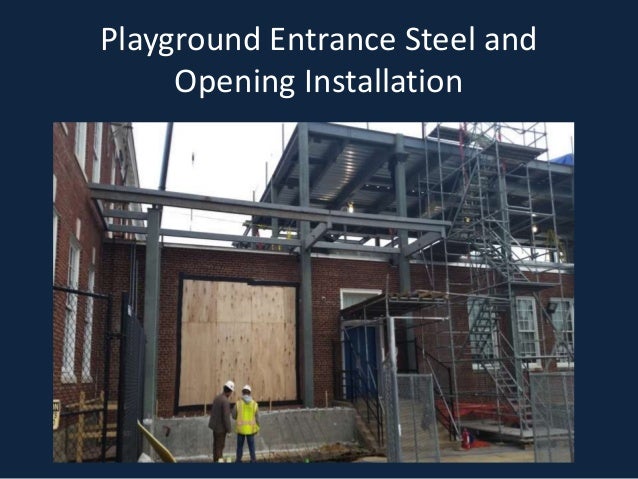

  54. 54. Playground Entrance Steel and Opening Installation
  55. 55. Elevating the Quality of Life in the District TWO CREPE MYRTLE TREES WILL BE RELOCATED 1 2

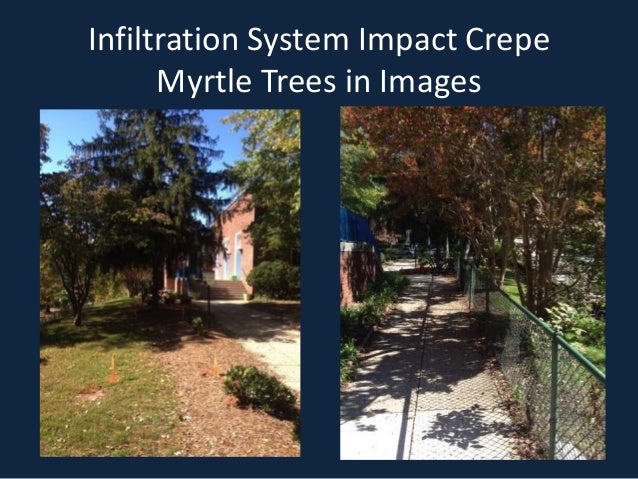

  56. 56. Infiltration System Impact Crepe Myrtle Trees in Images
  57. 57. Infiltration System Impact Crepe Myrtle Trees Relocated

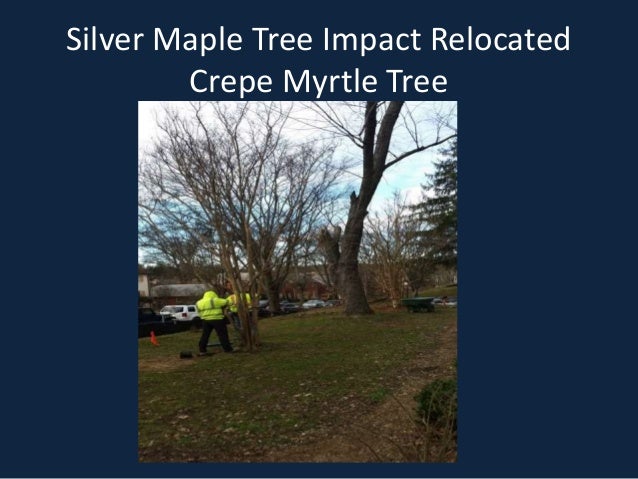

  58. 58. Silver Maple Tree Impact Relocated Crepe Myrtle Tree

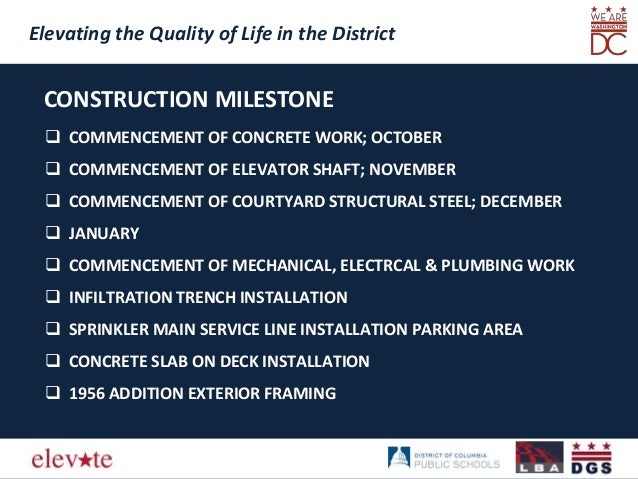

  59. 59. Elevating the Quality of Life in the District Elevating the Quality of Life in the District CONSTRUCTION MILESTONE  COMMENCEMENT OF CONCRETE WORK; OCTOBER  COMMENCEMENT OF ELEVATOR SHAFT; NOVEMBER  COMMENCEMENT OF COURTYARD STRUCTURAL STEEL; DECEMBER  JANUARY  COMMENCEMENT OF MECHANICAL, ELECTRCAL & PLUMBING WORK  INFILTRATION TRENCH INSTALLATION  SPRINKLER MAIN SERVICE LINE INSTALLATION PARKING AREA  CONCRETE SLAB ON DECK INSTALLATION  1956 ADDITION EXTERIOR FRAMING
  60. 60. Shepherd ES Logo in Courtyard & Mural

  61. 61. Frequently Asked Questions 1. Will the asphalt area on the playground be repaired or replaced? Answer:- The asphalt will be repaired 2. The Mural on the concrete wall will not be impacted by the construction Activities. 3. All Egress routes are accessible during Construction Per Building Codes. 4. Air monitoring scheduled to be performed once per month. 5. Memorial Gardens will be restored.

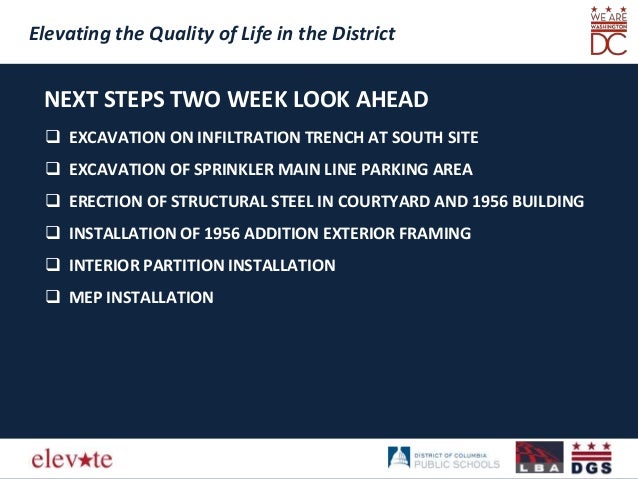

  62. 62. Elevating the Quality of Life in the District Elevating the Quality of Life in the District NEXT STEPS TWO WEEK LOOK AHEAD  EXCAVATION ON INFILTRATION TRENCH AT SOUTH SITE  EXCAVATION OF SPRINKLER MAIN LINE PARKING AREA  ERECTION OF STRUCTURAL STEEL IN COURTYARD AND 1956 BUILDING  INSTALLATION OF 1956 ADDITION EXTERIOR FRAMING  INTERIOR PARTITION INSTALLATION  MEP INSTALLATION
  63. 63. Kenneth Diggs DGS Associate Director DGS Government Affairs & Communications kenneth.diggs@dc.gov (202) 580-9361 Elevating the Quality of Life in the District

×
