MAZIW
A ZAIDI
More Milk in Tanzania (MoreMilkiT) Project
M
a
L
i
Soko la Uhakika ni Mali
Faida Mali Progress Report
Nisefori Mkwama,
Maziwa Zaidi & Steering Committee workshop, 8-
10 October 2014 at Giraffe Ocean View Hotel,
Dar es Salaam, Tanzania
Objective
Develop scalable value chains
approaches with improve organizations
and institutions serving smallholder male
and female households.
Output:
Vibrant, well organized and sustainable
DMHs delivering demand – led inputs
and services developed.
TNA and SSP Methodology
Participatory approach
Tool prepared and shared – IRLI,FM &
HPT
Primary and Secondary data collection.
Focused group discussion, brainstorming,
observation, questions and answers.
Individual interviews.
Achievements:
TNA done in 14 (47%) out
of 30 villages.
554 (Fe -229 – 41.3%) and
325 men (58.7%)
interviewed.
Challenges, opportunities
and capacity needs
identified.
Site specific plans conducted
to all 30 project groups
/coops and their needs
ranked and prioritized.
Challenges
Cattle keepers
Absence of well developed dairy business
hub model .
Inadequate artificial insemination and
associated high cost.
Low and high seasonal milk production.
Inadequate organizational, technical,
business and marketing skills.
Challenges contin….
Cattle keepers Cont…..
Inadequate good governance practices.
Unfavorable weather condition.
Poor milk quality control and hygiene.
Unreliable markets and default payment
to producers.
Challenges Cont…
Cattle keepers Cont…..
Inbreeding of cattle due low knowledge
and lack/inefficient breeding services.
Inadequate information on existing
financial opportunities and other sources
of investment capital.
Challenges Cont…

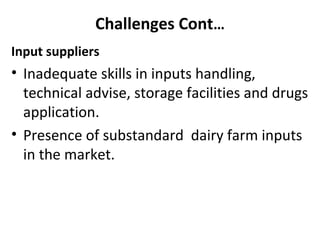

Input suppliers
• Inadequate skills in inputs handling,
technical advise, storage facilities and drugs
application.
• Presence of substandard dairy farm inputs
in the market.
Challenges Cont…
Input suppliers
Poor road network from the milk producers
to the consumers (town) mainly in the rainy
season.
No formalized businesses between milk
producers and the service providers.
Challenges Cont…
Input suppliers
Unreliable power supply resulting to problems to
stock specific drugs e.g. vaccines.
High costs of inputs, vaccines and drugs (e.g. ant-
ECF drugs) which is hardly affordable by most small
holder dairy cattle keepers.
Inadequate investment capital due to lack of ideal
collateral or legality on their business operations.
Challenges Cont…
Milk Vendors
Inadequate business skills in the milk
subsector.
Late or sometimes default payment to
vendors and hence the milk producers.
Unreliable milk transport and storage
facilities.
Challenges Cont…
Milk Vendors Cont…..
Poor road networks and unreliable
transport.
Use of un-standardized weights and
measures in the milk purchase business
which is not fair producers.
Challenges
LGAs
Inadequate skills in dairy sub sector.
Inadequate transport facilities for effective
service provision.
Not tapping into the existing opportunity
in milk revenues as sources of LGAs
income.
Challenges Cont…
Financial institutions
Inadequate information of dairy cattle
keepers’ financial needs.
Low trust and confidence on credit
worthiness to dairy cattle keepers.
No specific banks for small scale Agri-producers
to date.
Lessons learnt
TNA and SSP revealed
precise information for
implementing partners
for optimum services
provision.
Dairy keepers showed
indication of owning the
dairy keeping process.
There is high potential for
B2B to operate.
Next steps Cont…

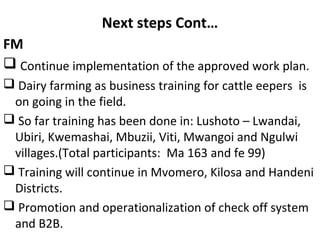

FM
Continue implementation of the approved work plan.
Dairy farming as business training for cattle eepers is
on going in the field.
So far training has been done in: Lushoto – Lwandai,
Ubiri, Kwemashai, Mbuzii, Viti, Mwangoi and Ngulwi
villages.(Total participants: Ma 163 and fe 99)
Training will continue in Mvomero, Kilosa and Handeni
Districts.
Promotion and operationalization of check off system
and B2B.
Next steps Cont…
Access to finance
Sensitize and mobilize individual internal
resources as sources of capital.
Continue mentoring and coaching of B2B –
July – October, 2015 .
Next steps Cont…
LGAs
Make follow up to curb the alleged milk
measurement rigging and fake farm inputs
in the market.
More Milk in Tanzania (MoreMilkiT) Project
END
